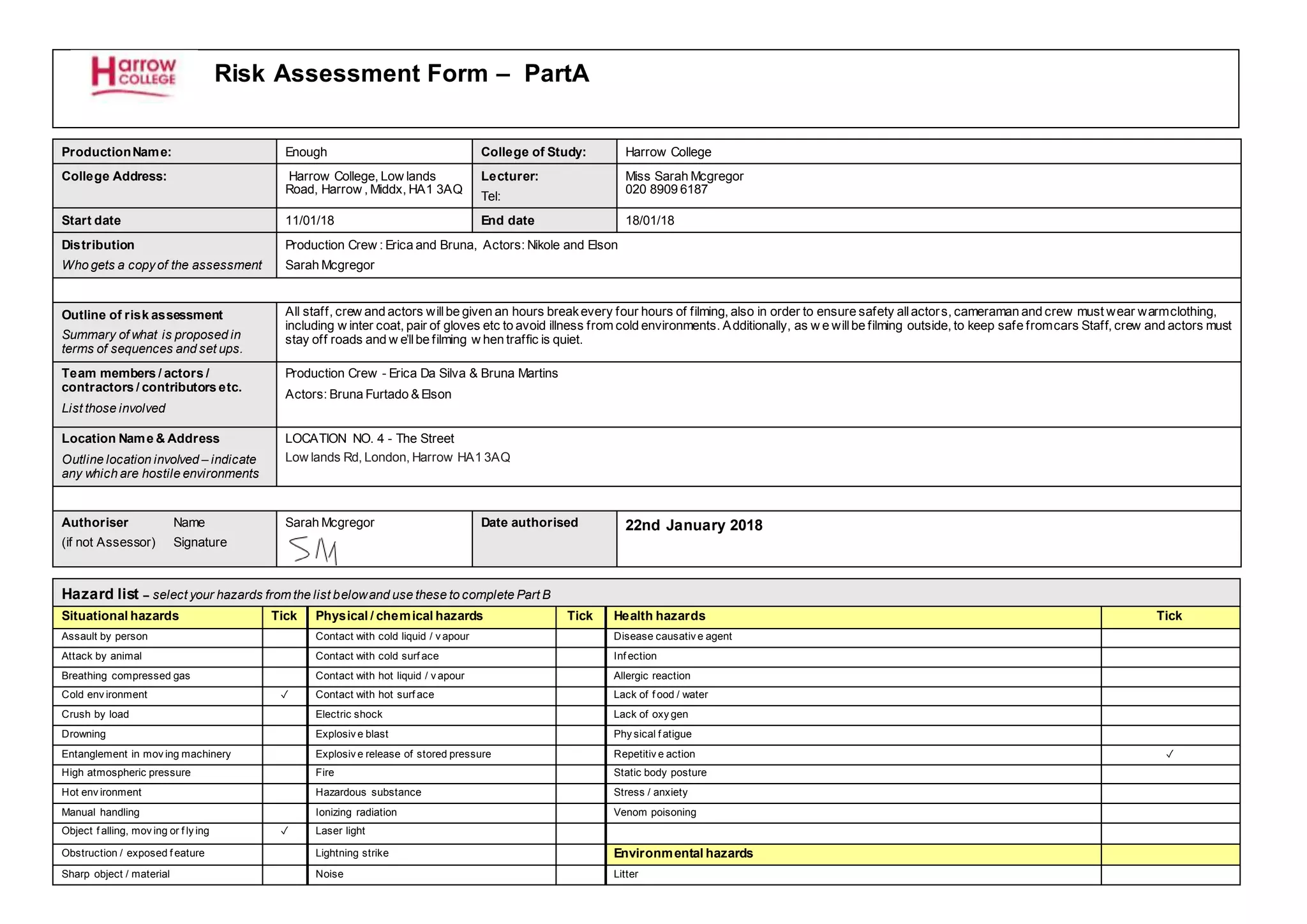

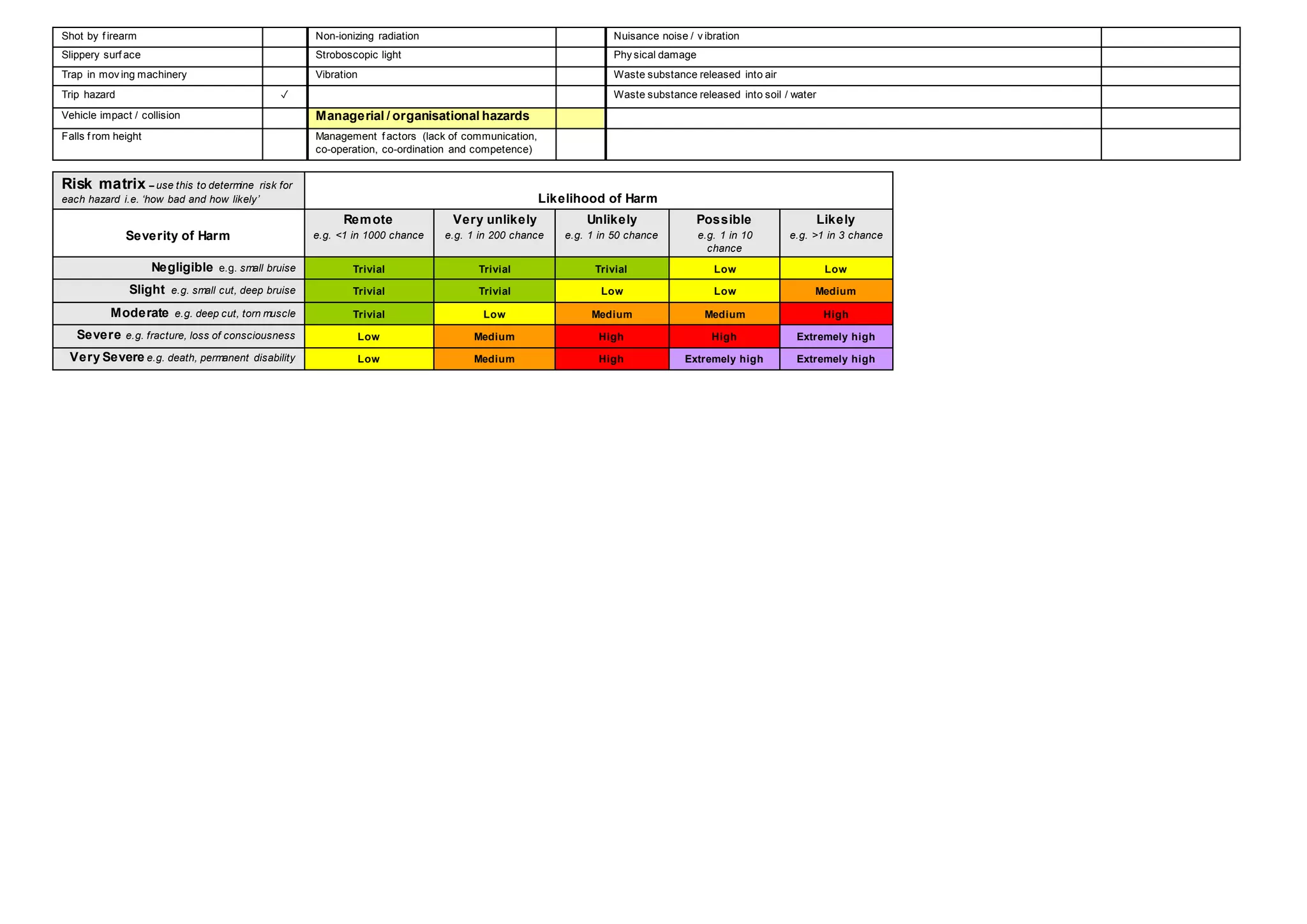

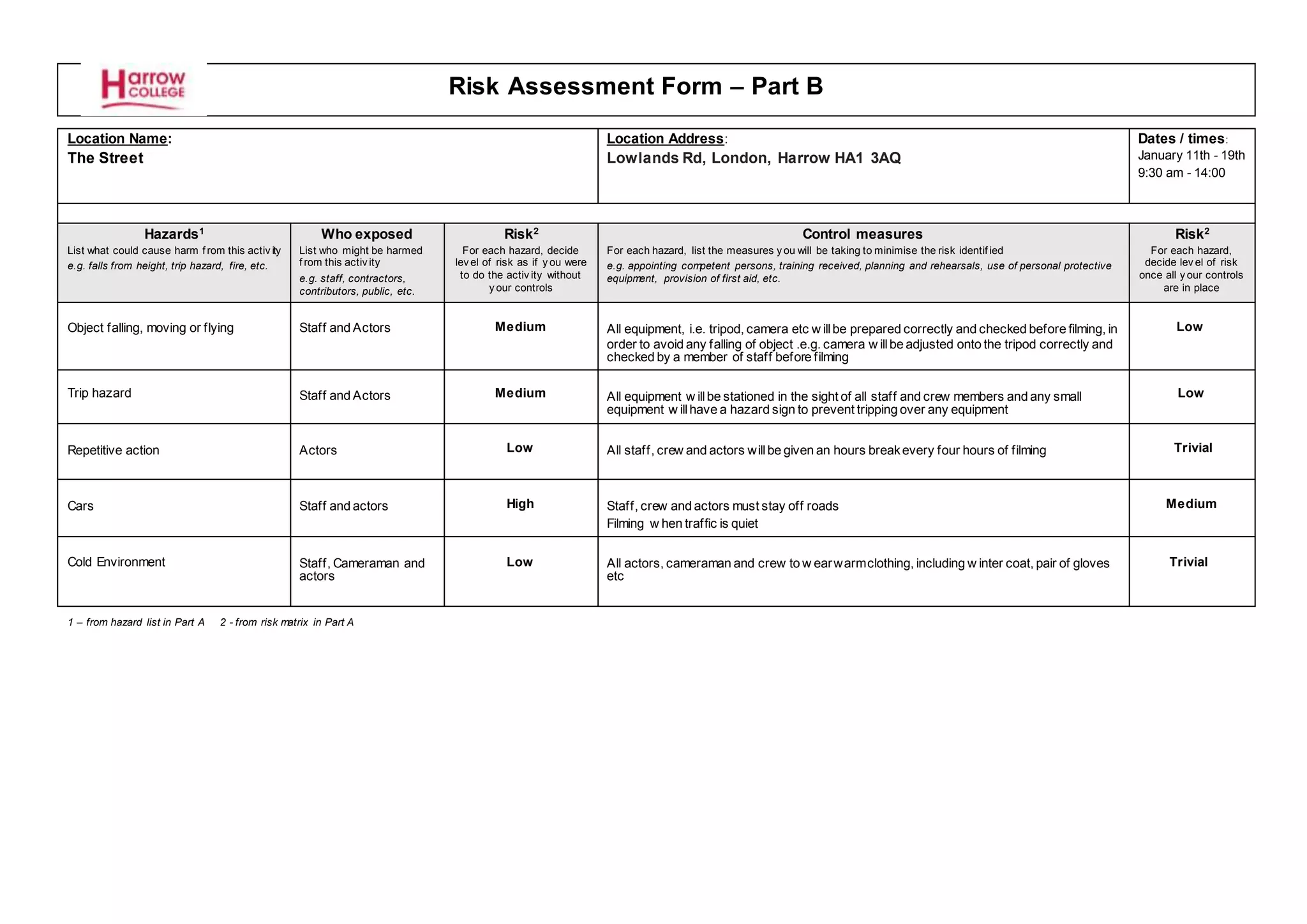

This risk assessment form summarizes the risks involved in filming a production called "Enough" between January 11th-19th on Lowlands Road in Harrow, London. It identifies potential hazards such as objects falling or moving, trip hazards, repetitive actions, cars, and cold environments that could harm the staff, crew, and actors. The controls listed to minimize risks include properly preparing equipment, having hazard signs, providing breaks every 4 hours, filming away from roads and when traffic is quiet, and requiring warm clothing. With these controls in place, the risks are considered low or trivial.
