Risk Management
In Video Game Production
Dino Dini 2014
Cevat Yerli - Founder & CEO of Crytek
The way Yerli talks about discovering programming feels well-practiced, as do
most of his stories. It takes place around 1990, when he was only 12 years old
"I was playing a game called Kick Off, from a programmer called Dino Dini," Yerli
says, pronouncing his name carefully, almost reverently. "It combined my two
passions [soccer and games]. ... I played so long at this friend's place that I forgot
about time. It got [to be] late, late [in the] afternoon. The sun was going down and I
was supposed to be at home.
"I took my [bicycle], drove downhill and [was lost in] a daydream. And I just
snapped and the next thing I remember I was in a hospital."
Yerli was so consumed by thoughts of Kick Off that he smashed headlong into a
brick wall. He has no memory of the crash.
-Polygon interview 11/07/2013
Dino Dini 2014
Tool 1: Map of connected concepts
Risk Probability
Failure to
satisfy
clearly
defined
goals
Non
deterministic
processes
Project
failure
of
Unknowns
Knowns
Certainties Probabilities
Hard To
Measure
Easy To
Measure

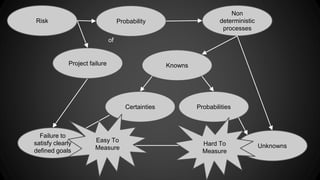

Risk Probability
Failure to
satisfy clearly
defined goals
Non
deterministic
processes
Project failure
of
Unknowns
Knowns
Certainties Probabilities
Hard To
Measure
Easy To
Measure
Hard To
Measure
Easy To
Measure

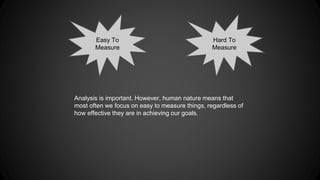

Analysis is important. However, human nature means that
most often we focus on easy to measure things, regardless of
how effective they are in achieving our goals.
Hard To
Measure
Easy To
Measure
Pass Rates
Popularity
Scores
Revenue
Example of "Easy Bias": An educational establishment
Education
What is measured
What Matters
Hard To
Measure
Easy To
Measure
Budget
Features
Time

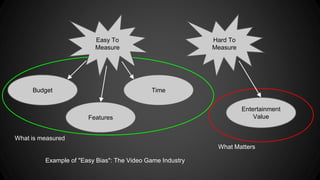

Example of "Easy Bias": The Video Game Industry
Entertainment
Value
What is measured
What Matters
Hard To
Measure
Easy To
Measure

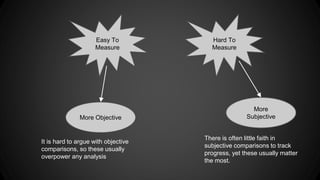

More Objective
More
Subjective
There is often little faith in
subjective comparisons to track
progress, yet these usually matter
the most.
It is hard to argue with objective
comparisons, so these usually
overpower any analysis

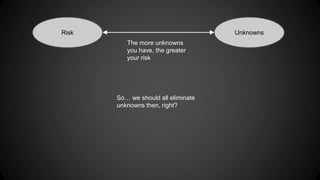

Risk Unknowns
The more unknowns
you have, the greater
your risk
So… we should all eliminate
unknowns then, right?
Risk Unknowns
The more unknowns
you have, the greater
your risk
So… we should all eliminate
unknowns then, right?
Tool 2: Robust Triangles
Risk
Unknowns ?
Risk
The more unknowns
you have, the greater
your risk
Unknowns
This the the video game
industry. An artful
entertainment medium. It must
innovate, and innovation
increases unknowns.

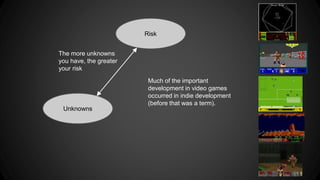

Risk
The more unknowns
you have, the greater
your risk
Unknowns
Much of the important
development in video games
occurred in indie development
(before that was a term).
Risk
The more unknowns
you have, the greater
your risk
Unknowns
How can we compensate for
increasing unknowns?
Risk

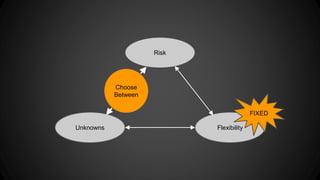

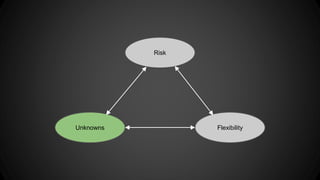

Unknowns Flexibility
Risk
Unknowns Flexibility
FIXED
Choose
Between
Risk

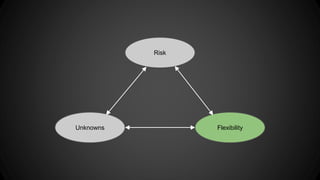

Unknowns Flexibility
FIXED
Choose
Between
Risk
FIXED
Choose
Between
Unknowns Flexibility

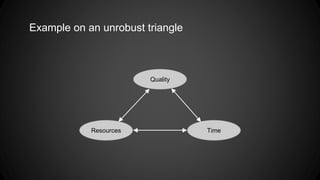

Example on an unrobust triangle
Quality
Resources Time
Risk
Unknowns Flexibility
Often answers why. Groups more concrete concepts
More Abstract
More Abstract
Less AbsLterascst AbLsetrsasc At bstract
Often answers how.
Serves more abstract needs
Tool 3: Abstraction Graph

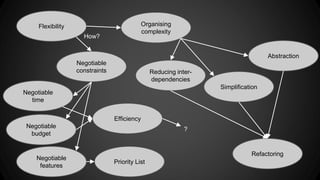

Flexibility Organising
complexity
How?
Negotiable
constraints
Abstraction
Simplification
Negotiable
time
Negotiable
budget
Negotiable
features
Reducing inter-dependencies
Priority List
Refactoring
Efficiency
?
Risk
Unknowns Flexibility
Reduce effect
of Unknowns Experience
How?
Prototyping
Hire
experienced
people
Training
Rapid
Protoyping
Prototyping
Budget
Analysis of
historical data /
Research
Faith in
(research)
process
Good
management
practices
Effective
assessment of
research value
Data driven
decision
making
Effective
procedures and
heuristics
Tools
Tools
Tools
Tools
Tools
Rapid
Prototyping Focus on core
player
experience
Quick and
flexible
development
environment
Develop set of
identifying
constraints Middleware (e.g.
Unity)
Design game
considering
production
issues

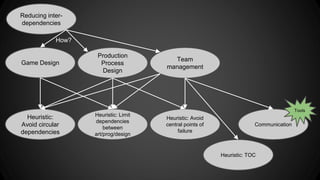

Reducing inter-dependencies
Game Design
Production
Process
Design
How?
Team
management
Heuristic:
Avoid circular
dependencies
Heuristic: Limit
dependencies
between
art/prog/design
Communication
Tools
Heuristic: Avoid
central points of
failure
Heuristic: TOC

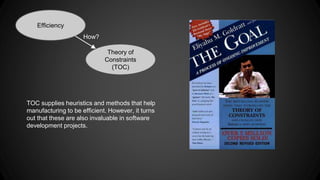

Efficiency
Theory of
Constraints
(TOC)
How?
TOC supplies heuristics and methods that help
manufacturing to be efficient. However, it turns
out that these are also invaluable in software
development projects.

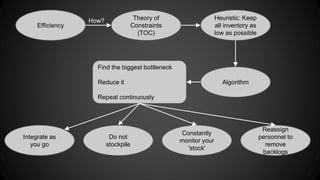

Efficiency
How? Heuristic: Keep
Theory of
Constraints
(TOC)
all inventory as
low as possible
Algorithm
Find the biggest bottleneck
Reduce it
Repeat continuously
Integrate as
you go
Do not
stockpile
Constantly
monitor your
'stock'
Reassign
personnel to
remove
backlogs
Development Process as a factory

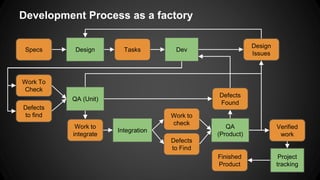

Tool 4: Process Diagram
Process Inventory
Development Process as a factory
Specs Design Tasks Dev
Work To
Check
Finished
Product
Project
tracking
QA (Unit)
Verified
work
Work to
integrate
Work to
check
Defects
to find
Defects
Found
Integration
QA
(Product)
Defects
to Find
Design
Issues
Development Process as a factory
Specs Design Tasks Dev
Work To
Check
Finished
Product
Project
tracking
QA (Unit)
Verified
work
Work to
integrate
Work to
check
Defects
to find
Defects
Found
Integration
QA
(Product)
Defects
to Find
Design
Issues
QA gets harder
when there is
more stuff to
work through
Development Process as a factory
Specs Design Tasks Dev
Work To
Check
Finished
Product
Project
tracking
QA (Unit)
Verified
work
Work to
integrate
Work to
check
Defects
to find
Defects
Found
Integration
QA
(Product)
Defects
to Find
Design
Issues

Imagine the horror after
you have used most of
your time
Development Process as a factory
Specs Design Tasks Dev
Work To
Check
Finished
Product
Project
tracking
QA (Unit)
Verified
work
Work to
integrate
Work to
check
Defects
to find
Defects
Found
Integration
QA
(Product)
Defects
to Find
Design
Issues

What strategy would you use in this case?

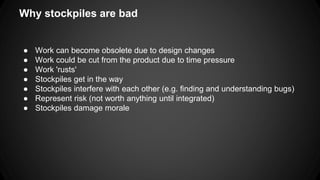

Why stockpiles are bad
● Work can become obsolete due to design changes
● Work could be cut from the product due to time pressure
● Work 'rusts'
● Stockpiles get in the way
● Stockpiles interfere with each other (e.g. finding and understanding bugs)
● Represent risk (not worth anything until integrated)
● Stockpiles damage morale

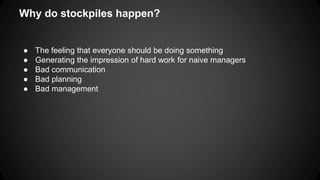

Why do stockpiles happen?
● The feeling that everyone should be doing something
● Generating the impression of hard work for naive managers
● Bad communication
● Bad planning
● Bad management

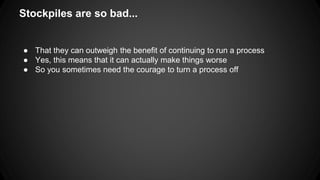

Stockpiles are so bad...
● That they can outweigh the benefit of continuing to run a process
● Yes, this means that it can actually make things worse
● So you sometimes need the courage to turn a process off

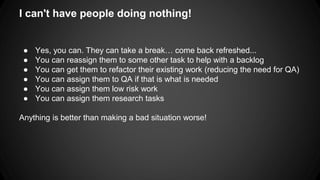

I can't have people doing nothing!
● Yes, you can. They can take a break… come back refreshed...
● You can reassign them to some other task to help with a backlog
● You can get them to refactor their existing work (reducing the need for QA)
● You can assign them to QA if that is what is needed
● You can assign them low risk work
● You can assign them research tasks
Anything is better than making a bad situation worse!

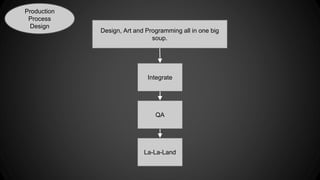

Production
Process
Design
Design, Art and Programming all in one big
soup.
Integrate
QA
La-La-Land

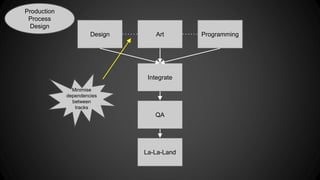

Production
Process
Design
Design Art Programming
Integrate
QA
La-La-Land
Minimise
dependencies
between
tracks
Production
Process
Design

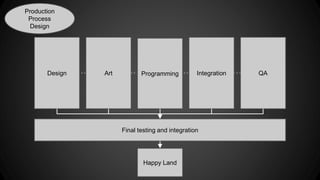

Design Art Programming Integration QA
Final testing and integration
Happy Land
What's Your Biggest Risk?
There now follows an important
heuristic for risk management..

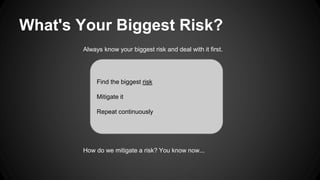

What's Your Biggest Risk?
Always know your biggest risk and deal with it first.
Find the biggest risk
Mitigate it
Repeat continuously
How do we mitigate a risk? You know now...

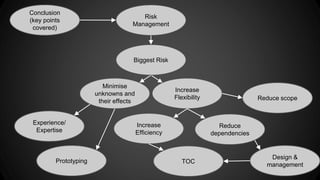

Conclusion
(key points
covered)
Risk
Management
Minimise
unknowns and
their effects
Increase
Flexibility
Reduce
dependencies
Increase
Efficiency
Design &
management
TOC
Experience/
Expertise
Prototyping
Biggest Risk
Reduce scope
Thank you

Risk management

  • 1.
    Risk Management InVideo Game Production Dino Dini 2014
  • 2.
    Cevat Yerli -Founder & CEO of Crytek The way Yerli talks about discovering programming feels well-practiced, as do most of his stories. It takes place around 1990, when he was only 12 years old "I was playing a game called Kick Off, from a programmer called Dino Dini," Yerli says, pronouncing his name carefully, almost reverently. "It combined my two passions [soccer and games]. ... I played so long at this friend's place that I forgot about time. It got [to be] late, late [in the] afternoon. The sun was going down and I was supposed to be at home. "I took my [bicycle], drove downhill and [was lost in] a daydream. And I just snapped and the next thing I remember I was in a hospital." Yerli was so consumed by thoughts of Kick Off that he smashed headlong into a brick wall. He has no memory of the crash. -Polygon interview 11/07/2013 Dino Dini 2014
  • 3.
    Tool 1: Mapof connected concepts Risk Probability Failure to satisfy clearly defined goals Non deterministic processes Project failure of Unknowns Knowns Certainties Probabilities Hard To Measure Easy To Measure
  • 4.
    Risk Probability Failureto satisfy clearly defined goals Non deterministic processes Project failure of Unknowns Knowns Certainties Probabilities Hard To Measure Easy To Measure
  • 5.
    Hard To Measure Easy To Measure Analysis is important. However, human nature means that most often we focus on easy to measure things, regardless of how effective they are in achieving our goals.
  • 6.
    Hard To Measure Easy To Measure Pass Rates Popularity Scores Revenue Example of "Easy Bias": An educational establishment Education What is measured What Matters
  • 7.
    Hard To Measure Easy To Measure Budget Features Time Example of "Easy Bias": The Video Game Industry Entertainment Value What is measured What Matters
  • 8.
    Hard To Measure Easy To Measure More Objective More Subjective There is often little faith in subjective comparisons to track progress, yet these usually matter the most. It is hard to argue with objective comparisons, so these usually overpower any analysis
  • 9.
    Risk Unknowns Themore unknowns you have, the greater your risk So… we should all eliminate unknowns then, right?
  • 10.
    Risk Unknowns Themore unknowns you have, the greater your risk So… we should all eliminate unknowns then, right?
  • 11.
    Tool 2: RobustTriangles Risk Unknowns ?
  • 12.
    Risk The moreunknowns you have, the greater your risk Unknowns This the the video game industry. An artful entertainment medium. It must innovate, and innovation increases unknowns.
  • 13.
    Risk The moreunknowns you have, the greater your risk Unknowns Much of the important development in video games occurred in indie development (before that was a term).
  • 14.
    Risk The moreunknowns you have, the greater your risk Unknowns How can we compensate for increasing unknowns?
  • 15.
  • 16.
    Risk Unknowns Flexibility FIXED Choose Between
  • 17.
    Risk Unknowns Flexibility FIXED Choose Between
  • 18.
    Risk FIXED Choose Between Unknowns Flexibility
  • 19.
    Example on anunrobust triangle Quality Resources Time
  • 20.
  • 21.
    Often answers why.Groups more concrete concepts More Abstract More Abstract Less AbsLterascst AbLsetrsasc At bstract Often answers how. Serves more abstract needs Tool 3: Abstraction Graph
  • 22.
    Flexibility Organising complexity How? Negotiable constraints Abstraction Simplification Negotiable time Negotiable budget Negotiable features Reducing inter-dependencies Priority List Refactoring Efficiency ?
  • 23.
  • 24.
    Reduce effect ofUnknowns Experience How? Prototyping Hire experienced people Training Rapid Protoyping Prototyping Budget Analysis of historical data / Research Faith in (research) process Good management practices Effective assessment of research value Data driven decision making Effective procedures and heuristics Tools Tools Tools Tools Tools
  • 25.
    Rapid Prototyping Focuson core player experience Quick and flexible development environment Develop set of identifying constraints Middleware (e.g. Unity) Design game considering production issues
  • 26.
    Reducing inter-dependencies GameDesign Production Process Design How? Team management Heuristic: Avoid circular dependencies Heuristic: Limit dependencies between art/prog/design Communication Tools Heuristic: Avoid central points of failure Heuristic: TOC
  • 27.
    Efficiency Theory of Constraints (TOC) How? TOC supplies heuristics and methods that help manufacturing to be efficient. However, it turns out that these are also invaluable in software development projects.
  • 28.
    Efficiency How? Heuristic:Keep Theory of Constraints (TOC) all inventory as low as possible Algorithm Find the biggest bottleneck Reduce it Repeat continuously Integrate as you go Do not stockpile Constantly monitor your 'stock' Reassign personnel to remove backlogs
  • 29.
    Development Process asa factory Tool 4: Process Diagram Process Inventory
  • 30.
    Development Process asa factory Specs Design Tasks Dev Work To Check Finished Product Project tracking QA (Unit) Verified work Work to integrate Work to check Defects to find Defects Found Integration QA (Product) Defects to Find Design Issues
  • 31.
    Development Process asa factory Specs Design Tasks Dev Work To Check Finished Product Project tracking QA (Unit) Verified work Work to integrate Work to check Defects to find Defects Found Integration QA (Product) Defects to Find Design Issues QA gets harder when there is more stuff to work through
  • 32.
    Development Process asa factory Specs Design Tasks Dev Work To Check Finished Product Project tracking QA (Unit) Verified work Work to integrate Work to check Defects to find Defects Found Integration QA (Product) Defects to Find Design Issues Imagine the horror after you have used most of your time
  • 33.
    Development Process asa factory Specs Design Tasks Dev Work To Check Finished Product Project tracking QA (Unit) Verified work Work to integrate Work to check Defects to find Defects Found Integration QA (Product) Defects to Find Design Issues What strategy would you use in this case?
  • 34.
    Why stockpiles arebad ● Work can become obsolete due to design changes ● Work could be cut from the product due to time pressure ● Work 'rusts' ● Stockpiles get in the way ● Stockpiles interfere with each other (e.g. finding and understanding bugs) ● Represent risk (not worth anything until integrated) ● Stockpiles damage morale
  • 35.
    Why do stockpileshappen? ● The feeling that everyone should be doing something ● Generating the impression of hard work for naive managers ● Bad communication ● Bad planning ● Bad management
  • 36.
    Stockpiles are sobad... ● That they can outweigh the benefit of continuing to run a process ● Yes, this means that it can actually make things worse ● So you sometimes need the courage to turn a process off
  • 37.
    I can't havepeople doing nothing! ● Yes, you can. They can take a break… come back refreshed... ● You can reassign them to some other task to help with a backlog ● You can get them to refactor their existing work (reducing the need for QA) ● You can assign them to QA if that is what is needed ● You can assign them low risk work ● You can assign them research tasks Anything is better than making a bad situation worse!
  • 38.
    Production Process Design Design, Art and Programming all in one big soup. Integrate QA La-La-Land
  • 39.
    Production Process Design Design Art Programming Integrate QA La-La-Land Minimise dependencies between tracks
  • 40.
    Production Process Design Design Art Programming Integration QA Final testing and integration Happy Land
  • 41.
    What's Your BiggestRisk? There now follows an important heuristic for risk management..
  • 42.
    What's Your BiggestRisk? Always know your biggest risk and deal with it first. Find the biggest risk Mitigate it Repeat continuously How do we mitigate a risk? You know now...
  • 43.
    Conclusion (key points covered) Risk Management Minimise unknowns and their effects Increase Flexibility Reduce dependencies Increase Efficiency Design & management TOC Experience/ Expertise Prototyping Biggest Risk Reduce scope
  • 44.
