In-Flight WiFi
Presented to the RAA-FTC
The Program at a Glance
• This is a Delta Connection program only.
• Installation will occur only on the 2-Class
  configured airplanes:
   – This includes our CRJ700 and CRJ900 airplanes.
   – This does not include our CRJ200 or EMB145
     airplanes.
• The official service kicked off last week with a
  publicized event:
   – Free WiFi for all the people riding our airplane that
     day.
   – Completed 5 legs.
This Presentation
• Mainly from a Flight Operations point of view as I
  didn’t have much to do with Maintenance side of
  this project.
• An overview of the STC process.
• An overview of the production installation plans.
• The WiFi system and its operation.
• The flight tests.
• Operational impact.
STC Prototype - Overview
• Planning for this program has been happening
  for nearly a year.
• N722EV (CRJ700) was designated to be the
  prototype airplane.
• The installation was planned for this airplane at
  the Bombardier facility in Macon, GA.
• The installation occurred during the last 10 days
  or so of the scheduled C-Check.
STC Prototype - Overview
• August 6 (ish): Ship 722 came out of MCN after
  the completed C-Check.
  – It was planned to complete the ground and flight tests
    then, but there were some scheduling issues with the
    AirCell DER/DAR folks.
  – The system was deactivated and the airplane placed
    back into service.
• August 20: Ship 722 was taken out of service in
  Atlanta where the ground tests were completed.
• August 21: Ship 722 completed the two phase
  flight testing required
  – Discuss this in a moment.
STC Prototype - Overview
• August 22: Ship 722 was moved to GLH for new
  Delta paint.
• September 2: The STC was approved.
• September 5: Came out of GLH to ATL.
  – I flew this one and got pictures for the RAA 
• September 7: The Dog & Pony show.
• September 9: AirCell received PMA for the
  installation kits.
• September 11: 10 kits each were shipped to
  IAH and DFW.
Production Installations
• September 12: N708EV was routed to IAH for
  the first production install.
  – AirCell plans on 4 “ramp up” installations:
     • 3 days – 2 days – 2 days – 1 day
• After the first 4, they are planning these
  installations for a 12 to 14 hour overnight.
• All will be done in IAH.
• Comair airplanes are being done during the
  same time period in DFW.
• The other DCI carriers will follow.
The System
Power:  CB Location
CBP2 – E10 (AC Service Bus)
The System

CWAP (Cabin Wireless Access Point)
Location: Left – Forward Closet

                         No idea what this is
                         for.

              ON/OFF switch
The System

CWAP Antenna
Location: Left – Forward Closet
The System

             CWAP 2

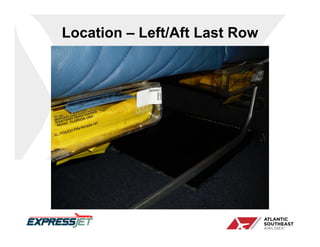

Location – Left/Aft Last Row
The System

         CWAP 2
         Antenna
Location – Left/Aft Last Row
The System

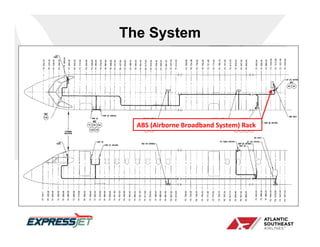

  ABS (Airborne Broadband System) Rack

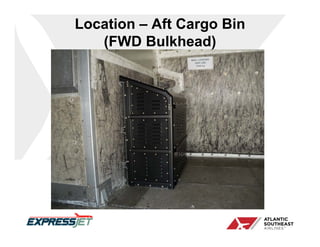

Location – Aft Cargo Bin
   (FWD Bulkhead)
The System

  ABS Antenna 1   ABS Antenna 2
Location: Bottom AFT & FWD
The System

      PCS Antenna
Location: Upper Aft (ish)
Flight Test
• ATL to PIE and back.
• 2 separate tests were performed on the same
  flight:
  – EMI testing
  – Cargo smoke testing
Operational Impacts
• Atlantic Southeast fleet is set for completion by
  November 8th, barring any problems.
   – We canceled one of six paint lines to help meet this
     goal.
• Slight shift aft of the empty CG – less than half a
  percent MAC.
• Aft cargo bin reduced maximum weight by 90
  pounds.
   – 3,740 to 3,650 pounds.
• A bunch of cool WiFi placards in the cabin.
