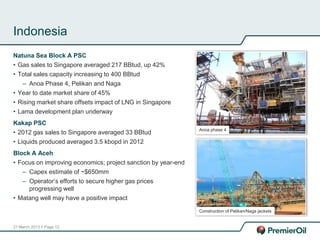

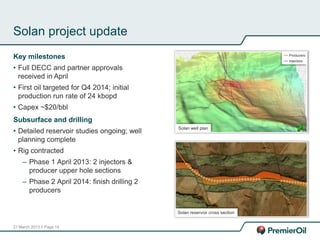

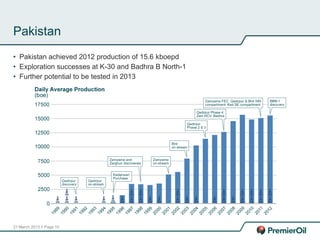

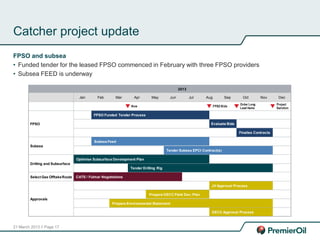

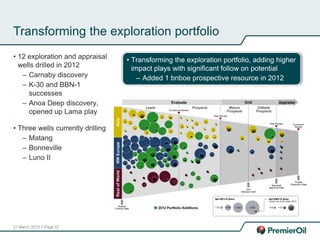

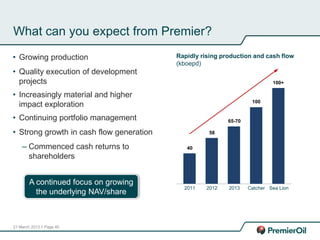

The document provides an annual results presentation for 2012 that summarizes the company's strategy, highlights for the year, reviews performance by business unit, and discusses key developments and exploration activities. The company delivered on its strategy of focusing on high-quality, high-return developments and acquisitions in core areas. Notable achievements in 2012 included sanctioning four major projects, progressing the Catcher development, and adding prospective resources through new exploration acreage. Production increased 43% to 57.7 kboepd, and the portfolio of reserves and resources continued expanding.
