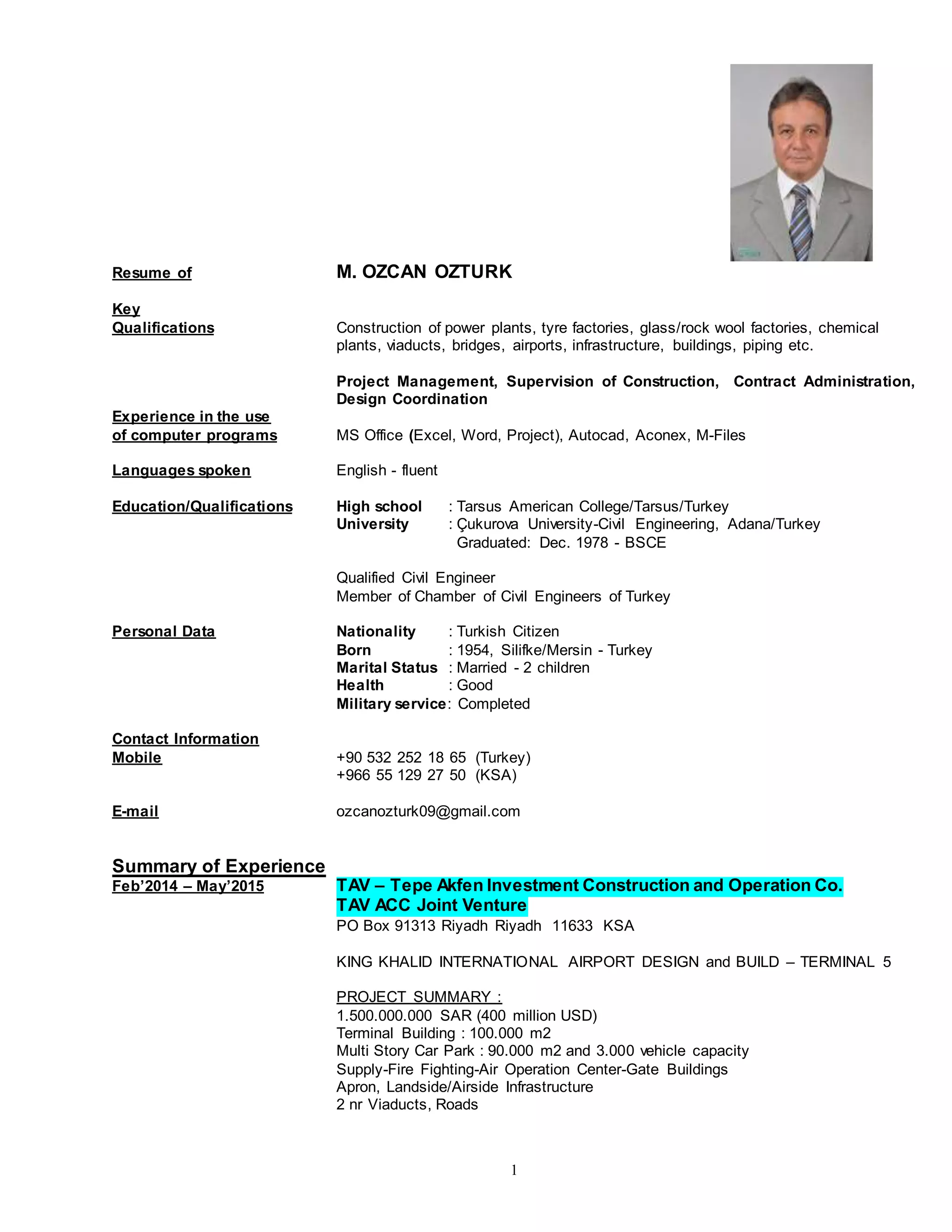

1
Resume of M. OZCAN OZTURK
Key
Qualifications Construction of power plants, tyre factories, glass/rock wool factories, chemical
plants, viaducts, bridges, airports, infrastructure, buildings, piping etc.
Project Management, Supervision of Construction, Contract Administration,
Design Coordination
Experience in the use
of computer programs MS Office (Excel, Word, Project), Autocad, Aconex, M-Files
Languages spoken English - fluent
Education/Qualifications High school : Tarsus American College/Tarsus/Turkey
University : Çukurova University-Civil Engineering, Adana/Turkey
Graduated: Dec. 1978 - BSCE
Qualified Civil Engineer
Member of Chamber of Civil Engineers of Turkey
Personal Data Nationality : Turkish Citizen
Born : 1954, Silifke/Mersin - Turkey
Marital Status : Married - 2 children
Health : Good
Military service: Completed
Contact Information
Mobile +90 532 252 18 65 (Turkey)
+966 55 129 27 50 (KSA)
E-mail ozcanozturk09@gmail.com
Summary of Experience
Feb’2014 – May’2015 TAV – Tepe Akfen Investment Construction and Operation Co.
TAV ACC Joint Venture
PO Box 91313 Riyadh Riyadh 11633 KSA
KING KHALID INTERNATIONAL AIRPORT DESIGN and BUILD – TERMINAL 5
PROJECT SUMMARY :
1.500.000.000 SAR (400 million USD)
Terminal Building : 100.000 m2
Multi Story Car Park : 90.000 m2 and 3.000 vehicle capacity
Supply-Fire Fighting-Air Operation Center-Gate Buildings
Apron, Landside/Airside Infrastructure
2 nr Viaducts, Roads
2

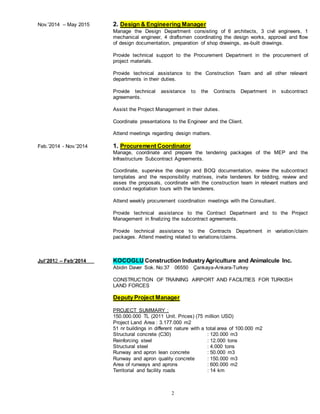

Nov.’2014 – May 2015 2. Design & Engineering Manager
Manage the Design Department consisting of 6 architects, 3 civil engineers, 1
mechanical engineer, 4 draftsmen coordinating the design works, approval and flow
of design documentation, preparation of shop drawings, as-built drawings.
Provide technical support to the Procurement Department in the procurement of
project materials.
Provide technical assistance to the Construction Team and all other relevant
departments in their duties.
Provide technical assistance to the Contracts Department in subcontract
agreements.
Assist the Project Management in their duties.
Coordinate presentations to the Engineer and the Client.
Attend meetings regarding design matters.
Feb.’2014 - Nov.’2014 1. Procurement Coordinator
Manage, coordinate and prepare the tendering packages of the MEP and the
Infrastructure Subcontract Agreements.
Coordinate, supervise the design and BOQ documentation, review the subcontract
templates and the responsibility matrixes, invite tenderers for bidding, review and
asses the proposals, coordinate with the construction team in relevant matters and
conduct negotiation tours with the tenderers.
Attend weekly procurement coordination meetings with the Consultant.
Provide technical assistance to the Contract Department and to the Project
Management in finalizing the subcontract agreements.
Provide technical assistance to the Contracts Department in variation/claim
packages. Attend meeting related to variations/claims.
Jul’2012 – Feb’2014 KOCOGLU Construction IndustryAgriculture and Animalcule Inc.
Abidin Daver Sok. No:37 06550 Çankaya-Ankara-Turkey
CONSTRUCTION OF TRAINING AIRPORT AND FACILITIES FOR TURKISH
LAND FORCES
Deputy Project Manager
PROJECT SUMMARY :
150.000.000 TL (2011 Unit. Prices) (75 million USD)
Project Land Area : 3.177.000 m2
51 nr buildings in different nature with a total area of 100.000 m2
Structural concrete (C30) : 120.000 m3
Reinforcing steel : 12.000 tons
Structural steel : 4.000 tons
Runway and apron lean concrete : 50.000 m3
Runway and apron quality concrete : 150.000 m3
Area of runways and aprons : 600.000 m2
Territorial and facility roads : 14 km
3

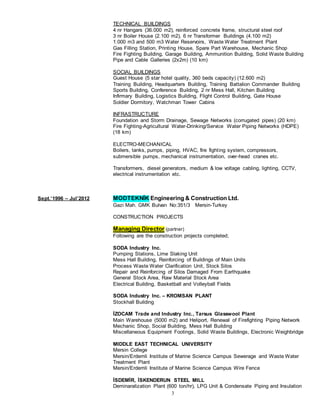

TECHNICAL BUILDINGS
4 nr Hangars (36.000 m2), reinforced concrete frame, structural steel roof
3 nr Boiler House (2.100 m2), 6 nr Transformer Buildings (4.100 m2)
1.000 m3 and 500 m3 Water Reservoirs, Waste Water Treatment Plant
Gas Filling Station, Printing House, Spare Part Warehouse, Mechanic Shop
Fire Fighting Building, Garage Building, Ammunition Building, Solid Waste Building
Pipe and Cable Galleries (2x2m) (10 km)
SOCIAL BUILDINGS
Guest House (5 star hotel quality, 360 beds capacity) (12.600 m2)
Training Building, Headquarters Building, Training Battalion Commander Building
Sports Building, Conference Building, 2 nr Mess Hall, Kitchen Building
Infirmary Building, Logistics Building, Flight Control Building, Gate House
Soldier Dormitory, Watchman Tower Cabins
INFRASTRUCTURE
Foundation and Storm Drainage, Sewage Networks (corrugated pipes) (20 km)
Fire Fighting-Agricultural Water-Drinking/Service Water Piping Networks (HDPE)
(18 km)
ELECTRO-MECHANICAL
Boilers, tanks, pumps, piping, HVAC, fire fighting system, compressors,
submersible pumps, mechanical instrumentation, over-head cranes etc.
Transformers, diesel generators, medium & low voltage cabling, lighting, CCTV,
electrical instrumentation etc.
Sept.’1996 – Jul’2012 MODTEKNİK Engineering & Construction Ltd.
Gazi Mah. GMK Bulvarı No:351/3 Mersin-Turkey
CONSTRUCTION PROJECTS
Managing Director (partner)
Following are the construction projects completed;
SODA Industry Inc.
Pumping Stations, Lime Slaking Unit
Mess Hall Building, Reinforcing of Buildings of Main Units
Process Waste Water Clarification Unit, Stock Silos
Repair and Reinforcing of Silos Damaged From Earthquake
General Stock Area, Raw Material Stock Area
Electrical Building, Basketball and Volleyball Fields
SODA Industry Inc. – KROMSAN PLANT
Stockhall Building
İZOCAM Trade and Industry Inc., Tarsus Glasswool Plant
Main Warehouse (5000 m2) and Heliport, Renewal of Firefighting Piping Network
Mechanic Shop, Social Building, Mess Hall Building
Miscellaneous Equipment Footings, Solid Waste Buildings, Electronic Weighbridge
MIDDLE EAST TECHNICAL UNIVERSITY
Mersin College
Mersin/Erdemli Institute of Marine Science Campus Sewerage and Waste Water
Treatment Plant
Mersin/Erdemli Institute of Marine Science Campus Wire Fence
İSDEMİR, İSKENDERUN STEEL MILL
Deminaralization Plant (600 ton/hr), LPG Unit & Condensate Piping and Insulation
4

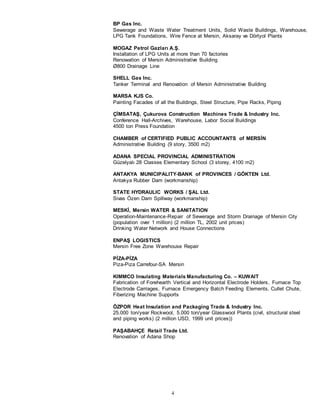

BP Gas Inc.
Sewerage and Waste Water Treatment Units, Solid Waste Buildings, Warehouse,
LPG Tank Foundations, Wire Fence at Mersin, Aksaray ve Dörtyol Plants
MOGAZ Petrol Gazları A.Ş.
Installation of LPG Units at more than 70 factories
Renowation of Mersin Administrative Building
Ø800 Drainage Line
SHELL Gas Inc.
Tanker Terminal and Renovation of Mersin Administrative Building
MARSA KJS Co.
Painting Facades of all the Buildings, Steel Structure, Pipe Racks, Piping
ÇİMSATAŞ, Çukurova Construction Machines Trade & Industry Inc.
Conference Hall-Archives, Warehouse, Labor Social Buildings
4500 ton Press Foundation
CHAMBER of CERTIFIED PUBLIC ACCOUNTANTS of MERSİN
Administrative Building (9 story, 3500 m2)
ADANA SPECIAL PROVINCIAL ADMINISTRATION
Güzelyalı 28 Classes Elementary School (3 storey, 4100 m2)
ANTAKYA MUNICIPALITY-BANK of PROVINCES / GÖKTEN Ltd.
Antakya Rubber Dam (workmanship)
STATE HYDRAULIC WORKS / ŞAL Ltd.
Sivas Özen Dam Spillway (workmanship)
MESKİ, Mersin WATER & SANITATION
Operation-Maintenance-Repair of Sewerage and Storm Drainage of Mersin City
(population over 1 million) (2 million TL, 2002 unit prices)
Drinking Water Network and House Connections
ENPAŞ LOGISTICS
Mersin Free Zone Warehouse Repair
PİZA-PİZA
Piza-Piza Carrefour-SA Mersin
KIMMCO Insulating Materials Manufacturing Co. – KUWAIT
Fabrication of Forehearth Vertical and Horizontal Electrode Holders, Furnace Top
Electrode Carriages, Furnace Emergency Batch Feeding Elements, Cullet Chute,
Fiberizing Machine Supports
ÖZPOR Heat Insulation and Packaging Trade & Industry Inc.
25.000 ton/year Rockwool, 5.000 ton/year Glasswool Plants (civil, structural steel
and piping works) (2 million USD, 1999 unit prices))
PAŞABAHÇE Retail Trade Ltd.
Renovation of Adana Shop
5

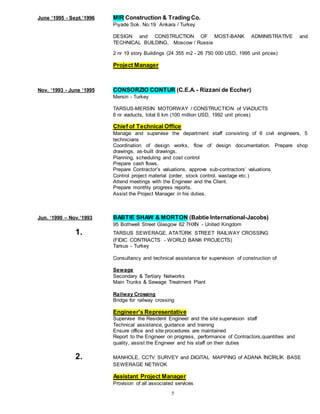

June ‘1995 - Sept.’1996 MIR Construction & Trading Co.
Piyade Sok. No:19 Ankara / Turkey
DESIGN and CONSTRUCTION OF MOST-BANK ADMINISTRATIVE and
TECHNICAL BUILDING, Moscow / Russia
2 nr 19 story Buildings (24 355 m2 - 26 750 000 USD, 1995 unit prices)
Project Manager
Nov. ‘1993 - June ‘1995 CONSORZIO CONTUR (C.E.A. - Rizzani de Eccher)
Mersin - Turkey
TARSUS-MERSIN MOTORWAY / CONSTRUCTION of VIADUCTS
6 nr viaducts, total 6 km (100 million USD, 1992 unit prices)
Chief of Technical Office
Manage and supervise the department staff consisting of 6 civil engineers, 5
technicians
Coordination of design works, flow of design documentation. Prepare shop
drawings, as-built drawings.
Planning, scheduling and cost control
Prepare cash flows.
Prepare Contractor’s valuations, approve sub-contractors’ valuations
Control project material (order, stock control, wastage etc.)
Attend meetings with the Engineer and the Client.
Prepare monthly progress reports.
Assist the Project Manager in his duties.
Jun. ‘1990 – Nov.‘1993 BABTIE SHAW & MORTON (Babtie International-Jacobs)
95 Bothwell Street Glasgow 62 7HXN - United Kingdom
1. TARSUS SEWERAGE, ATATÜRK STREET RAILWAY CROSSING
(FIDIC CONTRACTS - WORLD BANK PROJECTS)
Tarsus - Turkey
Consultancy and technical assistance for supervision of construction of
Sewage
Secondary & Tertiary Networks
Main Trunks & Sewage Treatment Plant
Railway Crossing
Bridge for railway crossing
Engineer's Representative
Supervise the Resident Engineer and the site supervision staff
Technical assistance, guidance and training
Ensure office and site procedures are maintained
Report to the Engineer on progress, performance of Contractors,quantities and
quality, assist the Engineer and his staff on their duties
2. MANHOLE, CCTV SURVEY and DIGITAL MAPPING of ADANA İNCİRLİK BASE
SEWERAGE NETWOK
Assistant Project Manager
Provision of all associated services
6

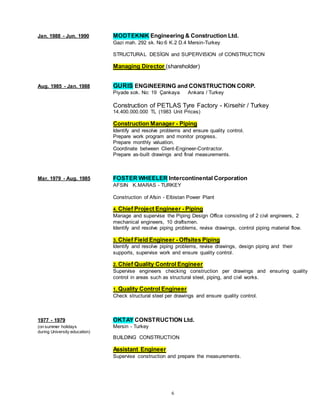

Jan. 1988 - Jun. 1990 MODTEKNIK Engineering & Construction Ltd.
Gazi mah. 292 sk. No:6 K.2 D.4 Mersin-Turkey
STRUCTURAL DESİGN and SUPERVISION of CONSTRUCTION
Managing Director (shareholder)
Aug. 1985 - Jan. 1988 GURIS ENGINEERING and CONSTRUCTION CORP.
Piyade sok. No: 19 Çankaya Ankara / Turkey
Construction of PETLAS Tyre Factory - Kirsehir / Turkey
14.400.000.000 TL (1983 Unit Prices)
Construction Manager - Piping
Identify and resolve problems and ensure quality control.
Prepare work program and monitor progress.
Prepare monthly valuation.
Coordinate between Client-Engineer-Contractor.
Prepare as-built drawings and final measurements.
Mar. 1979 - Aug. 1985 FOSTER WHEELER Intercontinental Corporation
AFSIN K.MARAS - TURKEY
Construction of Afsin - Elbistan Power Plant
4. Chief Project Engineer - Piping
Manage and supervise the Piping Design Office consisting of 2 civil engineers, 2
mechanical engineers, 10 draftsmen.
Identify and resolve piping problems, revise drawings, control piping material flow.
3. Chief Field Engineer - Offsites Piping
Identify and resolve piping problems, revise drawings, design piping and their
supports, supervise work and ensure quality control.
2. Chief Quality Control Engineer
Supervise engineers checking construction per drawings and ensuring quality
control in areas such as structural steel, piping, and civil works.
1. Quality Control Engineer
Check structural steel per drawings and ensure quality control.
1977 - 1979 OKTAY CONSTRUCTION Ltd.
(on summer holidays Mersin - Turkey
during University education)
BUILDING CONSTRUCTION
Assistant Engineer
Supervise construction and prepare the measurements.
7

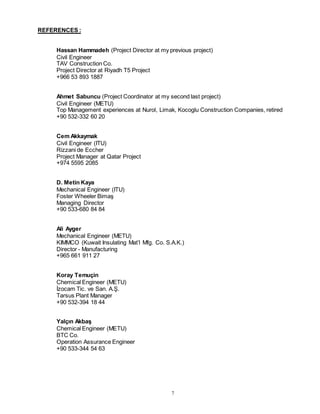

REFERENCES :
Hassan Hammadeh (Project Director at my previous project)
Civil Engineer
TAV Construction Co.
Project Director at Riyadh T5 Project
+966 53 893 1887
Ahmet Sabuncu (Project Coordinator at my second last project)
Civil Engineer (METU)
Top Management experiences at Nurol, Limak, Kocoglu Construction Companies, retired
+90 532-332 60 20
Cem Akkaymak
Civil Engineer (ITU)
Rizzani de Eccher
Project Manager at Qatar Project
+974 5595 2085
D. Metin Kaya
Mechanical Engineer (ITU)
Foster Wheeler Bimaş
Managing Director
+90 533-680 84 84
Ali Ayger
Mechanical Engineer (METU)
KIMMCO (Kuwait Insulating Mat’l Mfg. Co. S.A.K.)
Director - Manufacturing
+965 661 911 27
Koray Temuçin
Chemical Engineer (METU)
İzocam Tic. ve San. A.Ş.
Tarsus Plant Manager
+90 532-394 18 44
Yalçın Akbaş
Chemical Engineer (METU)
BTC Co.
Operation Assurance Engineer
+90 533-344 54 63

ozcan ozturk CV 12may15

  • 1.
    1 Resume of M.OZCAN OZTURK Key Qualifications Construction of power plants, tyre factories, glass/rock wool factories, chemical plants, viaducts, bridges, airports, infrastructure, buildings, piping etc. Project Management, Supervision of Construction, Contract Administration, Design Coordination Experience in the use of computer programs MS Office (Excel, Word, Project), Autocad, Aconex, M-Files Languages spoken English - fluent Education/Qualifications High school : Tarsus American College/Tarsus/Turkey University : Çukurova University-Civil Engineering, Adana/Turkey Graduated: Dec. 1978 - BSCE Qualified Civil Engineer Member of Chamber of Civil Engineers of Turkey Personal Data Nationality : Turkish Citizen Born : 1954, Silifke/Mersin - Turkey Marital Status : Married - 2 children Health : Good Military service: Completed Contact Information Mobile +90 532 252 18 65 (Turkey) +966 55 129 27 50 (KSA) E-mail ozcanozturk09@gmail.com Summary of Experience Feb’2014 – May’2015 TAV – Tepe Akfen Investment Construction and Operation Co. TAV ACC Joint Venture PO Box 91313 Riyadh Riyadh 11633 KSA KING KHALID INTERNATIONAL AIRPORT DESIGN and BUILD – TERMINAL 5 PROJECT SUMMARY : 1.500.000.000 SAR (400 million USD) Terminal Building : 100.000 m2 Multi Story Car Park : 90.000 m2 and 3.000 vehicle capacity Supply-Fire Fighting-Air Operation Center-Gate Buildings Apron, Landside/Airside Infrastructure 2 nr Viaducts, Roads
  • 2.
    2 Nov.’2014 – May2015 2. Design & Engineering Manager Manage the Design Department consisting of 6 architects, 3 civil engineers, 1 mechanical engineer, 4 draftsmen coordinating the design works, approval and flow of design documentation, preparation of shop drawings, as-built drawings. Provide technical support to the Procurement Department in the procurement of project materials. Provide technical assistance to the Construction Team and all other relevant departments in their duties. Provide technical assistance to the Contracts Department in subcontract agreements. Assist the Project Management in their duties. Coordinate presentations to the Engineer and the Client. Attend meetings regarding design matters. Feb.’2014 - Nov.’2014 1. Procurement Coordinator Manage, coordinate and prepare the tendering packages of the MEP and the Infrastructure Subcontract Agreements. Coordinate, supervise the design and BOQ documentation, review the subcontract templates and the responsibility matrixes, invite tenderers for bidding, review and asses the proposals, coordinate with the construction team in relevant matters and conduct negotiation tours with the tenderers. Attend weekly procurement coordination meetings with the Consultant. Provide technical assistance to the Contract Department and to the Project Management in finalizing the subcontract agreements. Provide technical assistance to the Contracts Department in variation/claim packages. Attend meeting related to variations/claims. Jul’2012 – Feb’2014 KOCOGLU Construction IndustryAgriculture and Animalcule Inc. Abidin Daver Sok. No:37 06550 Çankaya-Ankara-Turkey CONSTRUCTION OF TRAINING AIRPORT AND FACILITIES FOR TURKISH LAND FORCES Deputy Project Manager PROJECT SUMMARY : 150.000.000 TL (2011 Unit. Prices) (75 million USD) Project Land Area : 3.177.000 m2 51 nr buildings in different nature with a total area of 100.000 m2 Structural concrete (C30) : 120.000 m3 Reinforcing steel : 12.000 tons Structural steel : 4.000 tons Runway and apron lean concrete : 50.000 m3 Runway and apron quality concrete : 150.000 m3 Area of runways and aprons : 600.000 m2 Territorial and facility roads : 14 km
  • 3.
    3 TECHNICAL BUILDINGS 4 nrHangars (36.000 m2), reinforced concrete frame, structural steel roof 3 nr Boiler House (2.100 m2), 6 nr Transformer Buildings (4.100 m2) 1.000 m3 and 500 m3 Water Reservoirs, Waste Water Treatment Plant Gas Filling Station, Printing House, Spare Part Warehouse, Mechanic Shop Fire Fighting Building, Garage Building, Ammunition Building, Solid Waste Building Pipe and Cable Galleries (2x2m) (10 km) SOCIAL BUILDINGS Guest House (5 star hotel quality, 360 beds capacity) (12.600 m2) Training Building, Headquarters Building, Training Battalion Commander Building Sports Building, Conference Building, 2 nr Mess Hall, Kitchen Building Infirmary Building, Logistics Building, Flight Control Building, Gate House Soldier Dormitory, Watchman Tower Cabins INFRASTRUCTURE Foundation and Storm Drainage, Sewage Networks (corrugated pipes) (20 km) Fire Fighting-Agricultural Water-Drinking/Service Water Piping Networks (HDPE) (18 km) ELECTRO-MECHANICAL Boilers, tanks, pumps, piping, HVAC, fire fighting system, compressors, submersible pumps, mechanical instrumentation, over-head cranes etc. Transformers, diesel generators, medium & low voltage cabling, lighting, CCTV, electrical instrumentation etc. Sept.’1996 – Jul’2012 MODTEKNİK Engineering & Construction Ltd. Gazi Mah. GMK Bulvarı No:351/3 Mersin-Turkey CONSTRUCTION PROJECTS Managing Director (partner) Following are the construction projects completed; SODA Industry Inc. Pumping Stations, Lime Slaking Unit Mess Hall Building, Reinforcing of Buildings of Main Units Process Waste Water Clarification Unit, Stock Silos Repair and Reinforcing of Silos Damaged From Earthquake General Stock Area, Raw Material Stock Area Electrical Building, Basketball and Volleyball Fields SODA Industry Inc. – KROMSAN PLANT Stockhall Building İZOCAM Trade and Industry Inc., Tarsus Glasswool Plant Main Warehouse (5000 m2) and Heliport, Renewal of Firefighting Piping Network Mechanic Shop, Social Building, Mess Hall Building Miscellaneous Equipment Footings, Solid Waste Buildings, Electronic Weighbridge MIDDLE EAST TECHNICAL UNIVERSITY Mersin College Mersin/Erdemli Institute of Marine Science Campus Sewerage and Waste Water Treatment Plant Mersin/Erdemli Institute of Marine Science Campus Wire Fence İSDEMİR, İSKENDERUN STEEL MILL Deminaralization Plant (600 ton/hr), LPG Unit & Condensate Piping and Insulation
  • 4.
    4 BP Gas Inc. Sewerageand Waste Water Treatment Units, Solid Waste Buildings, Warehouse, LPG Tank Foundations, Wire Fence at Mersin, Aksaray ve Dörtyol Plants MOGAZ Petrol Gazları A.Ş. Installation of LPG Units at more than 70 factories Renowation of Mersin Administrative Building Ø800 Drainage Line SHELL Gas Inc. Tanker Terminal and Renovation of Mersin Administrative Building MARSA KJS Co. Painting Facades of all the Buildings, Steel Structure, Pipe Racks, Piping ÇİMSATAŞ, Çukurova Construction Machines Trade & Industry Inc. Conference Hall-Archives, Warehouse, Labor Social Buildings 4500 ton Press Foundation CHAMBER of CERTIFIED PUBLIC ACCOUNTANTS of MERSİN Administrative Building (9 story, 3500 m2) ADANA SPECIAL PROVINCIAL ADMINISTRATION Güzelyalı 28 Classes Elementary School (3 storey, 4100 m2) ANTAKYA MUNICIPALITY-BANK of PROVINCES / GÖKTEN Ltd. Antakya Rubber Dam (workmanship) STATE HYDRAULIC WORKS / ŞAL Ltd. Sivas Özen Dam Spillway (workmanship) MESKİ, Mersin WATER & SANITATION Operation-Maintenance-Repair of Sewerage and Storm Drainage of Mersin City (population over 1 million) (2 million TL, 2002 unit prices) Drinking Water Network and House Connections ENPAŞ LOGISTICS Mersin Free Zone Warehouse Repair PİZA-PİZA Piza-Piza Carrefour-SA Mersin KIMMCO Insulating Materials Manufacturing Co. – KUWAIT Fabrication of Forehearth Vertical and Horizontal Electrode Holders, Furnace Top Electrode Carriages, Furnace Emergency Batch Feeding Elements, Cullet Chute, Fiberizing Machine Supports ÖZPOR Heat Insulation and Packaging Trade & Industry Inc. 25.000 ton/year Rockwool, 5.000 ton/year Glasswool Plants (civil, structural steel and piping works) (2 million USD, 1999 unit prices)) PAŞABAHÇE Retail Trade Ltd. Renovation of Adana Shop
  • 5.
    5 June ‘1995 -Sept.’1996 MIR Construction & Trading Co. Piyade Sok. No:19 Ankara / Turkey DESIGN and CONSTRUCTION OF MOST-BANK ADMINISTRATIVE and TECHNICAL BUILDING, Moscow / Russia 2 nr 19 story Buildings (24 355 m2 - 26 750 000 USD, 1995 unit prices) Project Manager Nov. ‘1993 - June ‘1995 CONSORZIO CONTUR (C.E.A. - Rizzani de Eccher) Mersin - Turkey TARSUS-MERSIN MOTORWAY / CONSTRUCTION of VIADUCTS 6 nr viaducts, total 6 km (100 million USD, 1992 unit prices) Chief of Technical Office Manage and supervise the department staff consisting of 6 civil engineers, 5 technicians Coordination of design works, flow of design documentation. Prepare shop drawings, as-built drawings. Planning, scheduling and cost control Prepare cash flows. Prepare Contractor’s valuations, approve sub-contractors’ valuations Control project material (order, stock control, wastage etc.) Attend meetings with the Engineer and the Client. Prepare monthly progress reports. Assist the Project Manager in his duties. Jun. ‘1990 – Nov.‘1993 BABTIE SHAW & MORTON (Babtie International-Jacobs) 95 Bothwell Street Glasgow 62 7HXN - United Kingdom 1. TARSUS SEWERAGE, ATATÜRK STREET RAILWAY CROSSING (FIDIC CONTRACTS - WORLD BANK PROJECTS) Tarsus - Turkey Consultancy and technical assistance for supervision of construction of Sewage Secondary & Tertiary Networks Main Trunks & Sewage Treatment Plant Railway Crossing Bridge for railway crossing Engineer's Representative Supervise the Resident Engineer and the site supervision staff Technical assistance, guidance and training Ensure office and site procedures are maintained Report to the Engineer on progress, performance of Contractors,quantities and quality, assist the Engineer and his staff on their duties 2. MANHOLE, CCTV SURVEY and DIGITAL MAPPING of ADANA İNCİRLİK BASE SEWERAGE NETWOK Assistant Project Manager Provision of all associated services
  • 6.
    6 Jan. 1988 -Jun. 1990 MODTEKNIK Engineering & Construction Ltd. Gazi mah. 292 sk. No:6 K.2 D.4 Mersin-Turkey STRUCTURAL DESİGN and SUPERVISION of CONSTRUCTION Managing Director (shareholder) Aug. 1985 - Jan. 1988 GURIS ENGINEERING and CONSTRUCTION CORP. Piyade sok. No: 19 Çankaya Ankara / Turkey Construction of PETLAS Tyre Factory - Kirsehir / Turkey 14.400.000.000 TL (1983 Unit Prices) Construction Manager - Piping Identify and resolve problems and ensure quality control. Prepare work program and monitor progress. Prepare monthly valuation. Coordinate between Client-Engineer-Contractor. Prepare as-built drawings and final measurements. Mar. 1979 - Aug. 1985 FOSTER WHEELER Intercontinental Corporation AFSIN K.MARAS - TURKEY Construction of Afsin - Elbistan Power Plant 4. Chief Project Engineer - Piping Manage and supervise the Piping Design Office consisting of 2 civil engineers, 2 mechanical engineers, 10 draftsmen. Identify and resolve piping problems, revise drawings, control piping material flow. 3. Chief Field Engineer - Offsites Piping Identify and resolve piping problems, revise drawings, design piping and their supports, supervise work and ensure quality control. 2. Chief Quality Control Engineer Supervise engineers checking construction per drawings and ensuring quality control in areas such as structural steel, piping, and civil works. 1. Quality Control Engineer Check structural steel per drawings and ensure quality control. 1977 - 1979 OKTAY CONSTRUCTION Ltd. (on summer holidays Mersin - Turkey during University education) BUILDING CONSTRUCTION Assistant Engineer Supervise construction and prepare the measurements.
  • 7.
    7 REFERENCES : Hassan Hammadeh(Project Director at my previous project) Civil Engineer TAV Construction Co. Project Director at Riyadh T5 Project +966 53 893 1887 Ahmet Sabuncu (Project Coordinator at my second last project) Civil Engineer (METU) Top Management experiences at Nurol, Limak, Kocoglu Construction Companies, retired +90 532-332 60 20 Cem Akkaymak Civil Engineer (ITU) Rizzani de Eccher Project Manager at Qatar Project +974 5595 2085 D. Metin Kaya Mechanical Engineer (ITU) Foster Wheeler Bimaş Managing Director +90 533-680 84 84 Ali Ayger Mechanical Engineer (METU) KIMMCO (Kuwait Insulating Mat’l Mfg. Co. S.A.K.) Director - Manufacturing +965 661 911 27 Koray Temuçin Chemical Engineer (METU) İzocam Tic. ve San. A.Ş. Tarsus Plant Manager +90 532-394 18 44 Yalçın Akbaş Chemical Engineer (METU) BTC Co. Operation Assurance Engineer +90 533-344 54 63
