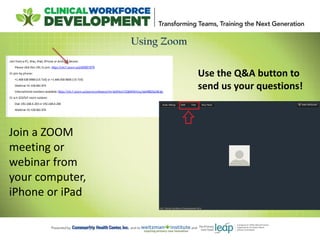

Using Zoom
Join a ZOOM
meeting or
webinar from
your computer,
iPhone or iPad
Use the Q&A button to
send us your questions!

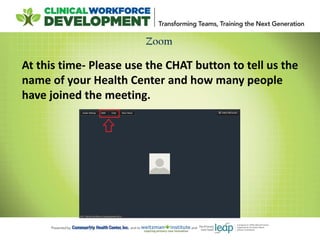

Zoom
At this time- Please use the CHAT button to tell us the
name of your Health Center and how many people
have joined the meeting.
4
Community Health Center, Inc.
Foundational Pillars
1. Clinical Excellence- fully Integrated teams, fully
integrated EMR, PCMH Level 3
2. Research & Development- CHC’s Weitzman Institute
is the home of formal research, quality improvement, and R&D
3. Training the Next Generation: Postgraduate training
programs for nurse practitioners and postdoctoral clinical
psychologists as well as training for all health professions
students
CHC Profile:
•Founding Year - 1972
•203 delivery sites
•145k patients
The Community Health Center, Inc. and its Weitzman Institute will provide
education, information, and training to interested health centers in Transforming
Teams and Training the Next Generation
• National Webinars on advancing team based care, implementing post-
graduate residency programs, and health professions students in FQHCs.
• Invited participation in Learning Collaboratives to advance team based care
or implement a post-graduate residency program at your health center.
CHC’s NCA on Clinical Workforce Development
The National Training and Technical Assistance Cooperative Agreements (NCAs) provide
free training and technical assistance that is data driven, cutting edge and focused on
quality and operational improvement to support health centers and look-alikes.

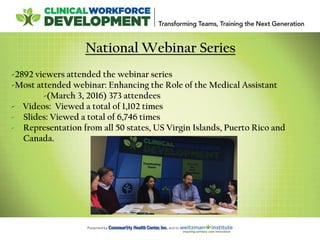

National Webinar Series
-2892 viewers attended the webinar series
-Most attended webinar: Enhancing the Role of the Medical Assistant
-(March 3, 2016) 373 attendees
- Videos: Viewed a total of 1,102 times
- Slides: Viewed a total of 6,746 times
- Representation from all 50 states, US Virgin Islands, Puerto Rico and
Canada.
The LC Teams

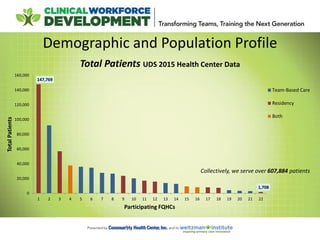

147,769
1,708
0
20,000
40,000
60,000
80,000
100,000
120,000
140,000
160,000
1 2 3 4 5 6 7 8 9 10 11 12 13 14 15 16 17 18 19 20 21 22
TotalPatients
Participating FQHCs
Total Patients UDS 2015 Health Center Data
Team-Based Care
Residency
Both

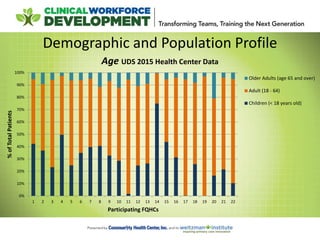

Demographic and Population Profile
Collectively, we serve over 607,884 patients
Demographic and Population Profile
0%
10%
20%
30%
40%
50%
60%
70%
80%
90%
100%
1 2 3 4 5 6 7 8 9 10 11 12 13 14 15 16 17 18 19 20 21 22
%ofTotalPatients
Participating FQHCs
Age UDS 2015 Health Center Data
Older Adults (age 65 and over)
Adult (18 - 64)
Children (< 18 years old)
Patient Characteristics
Uninsured
18%
Medicaid/
CHIP
57%
Medicare
9%
Other
Third Party
16%
Payor Data UDS 2015 Health
Center Data

Almost all health centers offer
Medical, Dental and Mental
Health services.
Staffing and Utilization: UDS
Table 5 – We encourage you
to look at your data!
Quality Improvement Education
Patti Feeney
Manager, Quality Improvement Education

Effective Meeting Skills
Providing meeting and team structure for coaches
I. AGENDA
II. MEETING ROLES
III. ACTION PLAN

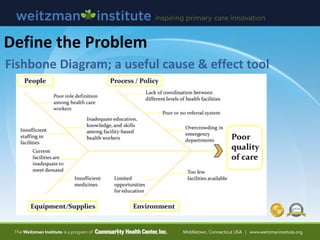

Define the Problem
Fishbone Diagram; a useful cause & effect tool

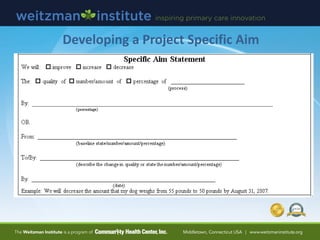

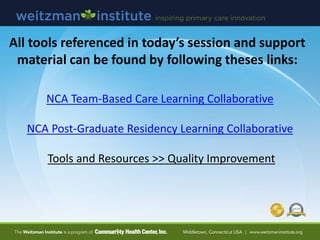

Developing a Project Specific Aim
All tools referenced in today’s session and support
material can be found by following theses links:
NCA Team-Based Care Learning Collaborative
NCA Post-Graduate Residency Learning Collaborative
Tools and Resources >> Quality Improvement
We will begin shortly…
Welcome
20
Team Based Care (TBC)
Learning Collaborative
Session One
September 21, 2016
3:35 - 4:30 EST

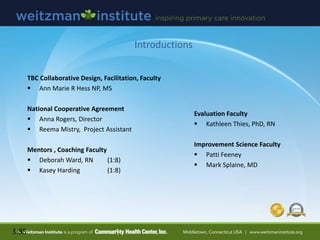

Introductions
TBC Collaborative Design, Facilitation, Faculty
 Ann Marie R Hess NP, MS
National Cooperative Agreement
 Anna Rogers, Director
 Reema Mistry, Project Assistant
Mentors , Coaching Faculty
 Deborah Ward, RN (1:8)
 Kasey Harding (1:8)
3:35
Evaluation Faculty
 Kathleen Thies, PhD, RN
Improvement Science Faculty
 Patti Feeney
 Mark Splaine, MD

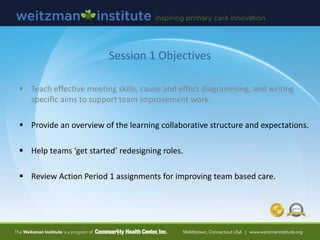

Session 1 Objectives
 Teach effective meeting skills, cause and effect diagramming, and writing
specific aims to support team improvement work.
 Provide an overview of the learning collaborative structure and expectations.
 Help teams ‘get started’ redesigning roles.
 Review Action Period 1 assignments for improving team based care.

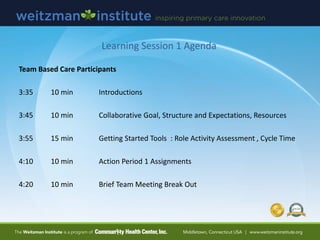

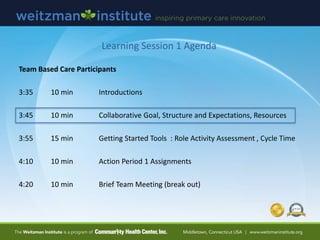

Learning Session 1 Agenda
Team Based Care Participants
3:35 10 min Introductions
3:45 10 min Collaborative Goal, Structure and Expectations, Resources

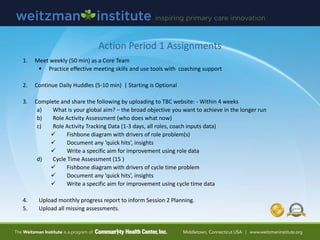

3:55 15 min Getting Started Tools : Role Activity Assessment , Cycle Time
4:10 10 min Action Period 1 Assignments
4:20 10 min Brief Team Meeting Break Out
Interviews : General Impressions
 Many asked for clarification of team and coach definitions
 Lots of recent growth and change in many organizations
 Many reported EHR challenges re: data, documentation, duplication, and getting
actionable reports
 Few have depth of experience with primary care redesign models and QI methods
(e.g Wagner, Bodenheimer, Nuka Alaska, PCMH, IHI)
 Most are familiar with term PDSA
 Most not meeting weekly to focus on QI, ‘fit into’ day of back to back visits
 All have been evolving their team based model of care over time, multiple starts,
looking for “refresh”
 Many working on PCMH certification, recertification
 Few practices have experience with coaching model
Introductions

Interviews : Goals and Expectations
 Want structure, guidance, resources from the Collaborative: how-to’s vs concepts
 Learn from others’ and their mistakes
 Common Goals | Global Aims
• better efficiency, improved workflows
• staff working at top of license, includes standing orders and protocols
• team role clarity and standardization (care management, documentation)
• improve quality outcome measures (e.g. UDS outcomes)
• improve patient and team satisfaction
 Reduce stress and “put the joy back into practice, need “relief from the chaos”
 We have a cohesive, good team but we “all work in our silos to get the work done”
Introductions
Introductions

Name of FQHC Coach Team
Carolina Family Health Centers ,
Inc.
Chasity Godwin
1 MD, 1 NP, 2 LPN, 1 Care Coordinator, 1 Front Desk, 1 Interpreter,
1 CNA
Community Health Initiatives Zlata Vainstein 1 Medical Director, 1 Physician, 2 MA, 1 Front Desk
Daughters of Charity Grace Mena 1 Area Practice Manager, 1 MD, 3 FNP, 2 Care Coordinator, 4 MA
Healthcare for the Homeless Carlie Brown Need new team
Holyoke Health Center Megan T. Wechsler (Primary)
1 Director of Quality and Compliance, 1 Physician, 3 RN, 1 MA, 1
Front Desk
Johnson City Community
Health Center
Flo Weierbach 1 front Desk, 1 PNP, 1 LCSW, 1 RN, 1 Interpreter
Sumter Family Health Center
Sandra Sturkie
1 Director of Patient Services, 1 Clinical Manager, 1 BH Clinical
Manager, 1 BH RN, 1 Physician, 2 Case Managers, 1 MA, 1 Dental
Services Coordinator, 1 Patient Financial Coordinator, 1 Clinical IT,
1 Pharmacist, 1 Call Center Rep, 1 Referrals Manager
Syracuse Community Health
Center, Inc.
Cathy Brigden
1 Physician, 1 FNP, 1 LPN, 2 RN, 3 MA, 1 Office Manager
Tyler Family Circle of Care Sherri Gould
1 CMO, 1 COO, 1 LVN, 1 OA, 1 PNP, 1 Process Improvement
Manager
Name of FQHC Coach Team
Avenal Community Health Center John Kalfayan 1 BH, 1 Physician, 1 MA, 1 Medical Director, 1 Front Desk
Educational Health Center of Wyoming Brenda Burnett
1 Provider, 2 RN, 1 Radiologic Technologist, 1 EMR Manager, 1
MA, 1 Clinical Manager
El Rio Santa Cruz Josh Carzoli
1 MA, 1 RN, 1 BH, 1 Chief Clinical Officer, 1 LPN, 2 Physician, 1
Front Desk, 1 COO, 3 RN Clinic Manager, 1 IT
Peach Tree Healthcare Ruben Ruiz
1 Chief Quality Officer, 1 Quality Coordinator, 1 Dir of
Operations, 1 Site Manager, 1 Dir of HR, 1 NP, 3 MA, 1 Data
Analyst, 1 Ops Specialist, 1 Clinical Support Services Manager
Pecos Valley Medical Center L. David Young 2 RN, 1 NP, 1 MA
The Children’s Clinic Karla Rodriguez 1 Provider, 1 MA, 1 Care Team Rep
Via Care Community Health Center Kimberly McFerguson
1 FNP, 1 MA, 1 Outreach & Enrollment Specialist, 1 MSW, 1
Front Office Lead MA
Introductions

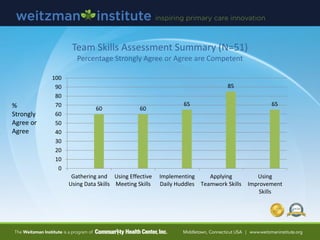

Team Skills Assessment Summary (N=51)
Percentage Strongly Agree or Agree are Competent
%
Strongly
Agree or
Agree
60 60
65
85
65
0
10
20
30
40
50
60
70
80
90
100
Gathering and
Using Data Skills
Using Effective
Meeting Skills
Implementing
Daily Huddles
Applying
Teamwork Skills
Using
Improvement
Skills

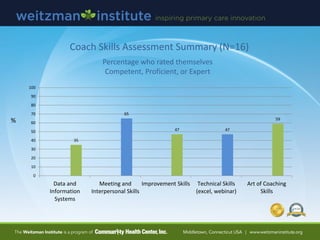

Coach Skills Assessment Summary (N=16)
Percentage who rated themselves
Competent, Proficient, or Expert
35
65
47 47
59
0
10
20
30
40
50
60
70
80
90
100
Data and
Information
Systems
Meeting and
Interpersonal Skills
Improvement Skills Technical Skills
(excel, webinar)
Art of Coaching
Skills
%

Level D: Just Getting Started
Level C: Early Stages of Change
Level B: Implemented Basic Changes
Level A: Achieved Most or All of the Important Change Required
Team Based Practice Assessment (LEAP)
0
1
2
3
4
5
6
7
Level A Level B Level C Level D
Self-Management Support
Planned Care
Care Management
Medication Management

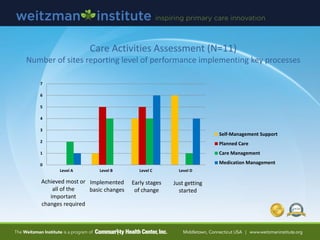

Care Activities Assessment (N=11)
Number of sites reporting level of performance implementing key processes
Just getting
started
Early stages
of change
Implemented
basic changes
Achieved most or
all of the
important
changes required
0
1
2
3
4
5
6
7
Level A Level B Level C Level D
Medical Assistant (MA)
Registered Nurse (RN)
Laypersons
Pharmacist

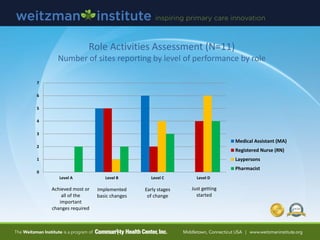

Role Activities Assessment (N=11)
Number of sites reporting by level of performance by role
Just getting
started
Early stages
of change
Implemented
basic changes
Achieved most or
all of the
important
changes required

Transformational Team Based Care Improves Outcomes
Learning Session 1 Agenda
Team Based Care Participants
3:35 10 min Introductions
3:45 10 min Collaborative Goal, Structure and Expectations, Resources
3:55 15 min Getting Started Tools : Role Activity Assessment , Cycle Time
4:10 10 min Action Period 1 Assignments
4:20 10 min Brief Team Meeting (break out)

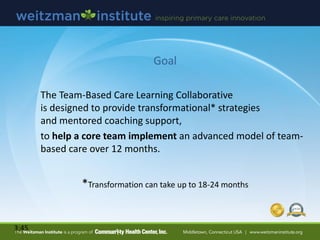

Goal
The Team-Based Care Learning Collaborative
is designed to provide transformational* strategies
and mentored coaching support,
to help a core team implement an advanced model of team-
based care over 12 months.
*Transformation can take up to 18-24 months
3:45
 Achieve multiple TBC
specific aims
 Standardize (SDSAs)
roles and key processes
(Playbook, Spread Plan)
 Improve team and coach
skills (improvement
science, team work,
coaching)
 Develop a post
collaborative team
action plan
How is the Collaborative Structured?
90 min
Learning
Sessions
Between Session Action Periods (6 weeks)
Complete Assignments
Weekly Team Meetings (5-6), Daily Huddles
Monthly Reporting
Implementation Tools and Skills
Change Concept Resources
Learning From Each Other

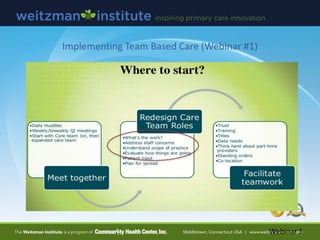

Team Based Care
Webinars (8)
Core Team
Team Based
Practice
Assessment (LEAP)
Coach and
Team Skills
Assessment
Practice
Outcomes Data
(UDS, Other)
Interviews
Coach Prep
Session
Technology
Session
Between Session Mentoring and Faculty Support
7
Sept 21 Nov 2 Dec 14 Jan 25 Mar 15 Apr 26 June 14

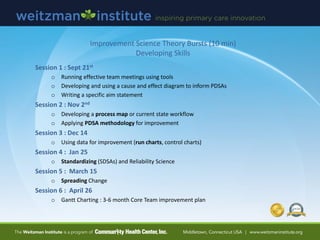

Improvement Science Theory Bursts (10 min)
Developing Skills
Session 1 : Sept 21st
o Running effective team meetings using tools
o Developing and using a cause and effect diagram to inform PDSAs
o Writing a specific aim statement
Session 2 : Nov 2nd
o Developing a process map or current state workflow
o Applying PDSA methodology for improvement
Session 3 : Dec 14
o Using data for improvement (run charts, control charts)
Session 4 : Jan 25
o Standardizing (SDSAs) and Reliability Science
Session 5 : March 15
o Spreading Change
Session 6 : April 26
o Gantt Charting : 3-6 month Core Team improvement plan

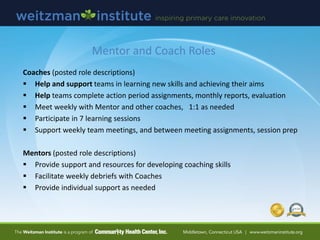

Mentor and Coach Roles
Coaches (posted role descriptions)
 Help and support teams in learning new skills and achieving their aims
 Help teams complete action period assignments, monthly reports, evaluation
 Meet weekly with Mentor and other coaches, 1:1 as needed
 Participate in 7 learning sessions
 Support weekly team meetings, and between meeting assignments, session prep
Mentors (posted role descriptions)
 Provide support and resources for developing coaching skills
 Facilitate weekly debriefs with Coaches
 Provide individual support as needed
NCA Online Learning Network
Find material for download, TBC
webinars, and team folders for
sharing your work...
Improvingprimarycare.org
Discussion Board
Ask questions or make requests
of teams, faculty….
Any Questions?

Before “Getting Started”….
3:55
Implementing Team Based Care (Webinar #1)
Webinar 1
Defining Structure and Staff Responsibilities
Practice Managers and Leaders : must stay involved, engaged in your work
Start with Core Team, Then Expanded Team

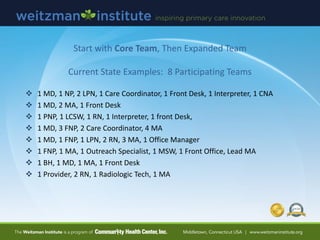

Current State Examples: 8 Participating Teams
 1 MD, 1 NP, 2 LPN, 1 Care Coordinator, 1 Front Desk, 1 Interpreter, 1 CNA
 1 MD, 2 MA, 1 Front Desk
 1 PNP, 1 LCSW, 1 RN, 1 Interpreter, 1 front Desk,
 1 MD, 3 FNP, 2 Care Coordinator, 4 MA
 1 MD, 1 FNP, 1 LPN, 2 RN, 3 MA, 1 Office Manager
 1 FNP, 1 MA, 1 Outreach Specialist, 1 MSW, 1 Front Office, Lead MA
 1 BH, 1 MD, 1 MA, 1 Front Desk
 1 Provider, 2 RN, 1 Radiologic Tech, 1 MA

TBC Concept Resource (webinar #1 and #2)
Principle
 Patients want to receive their care from smaller teams (PODS) and know them personally
Physical
 Wall colors differentiate pods in practice , match business cards
 Central open area surrounded by exam rooms
 Co location of pod members, all carry laptops
 3 exam rooms per provider – all care comes to patient
 2 pods share procedure room - standardized
TBC Structure
 Break down large systems into PODS (care teams)
 4 “Empaneled” Providers (3FTEs), 3 MAs dedicated to provider (dyad)
 1 BH, 1 RN, 1 Case Coordinator (navigator, health coach), 1 front desk,
 Patient empaneled both to a pod and to a Dyad
 Flow Coordinator and Team Manager rotating roles (RN, MA)
 Medical Records staff – input electronic data
Roles and Responsibilities
 Defining and Training, Standing Orders and Protocols
Standardizing Workflows
• Making ‘hundreds’ accessible to all
Teams Need to Meet
• Daily Huddles : 8am and 2pm
• Weekly Meetings : Improvement Work, Population Health Management
Poll Question
Would you say that you have ‘significant’ work to do
defining your “core” and “extended” team structure?
Yes
No
Role Activity Assessment
Who Does What Now?
4:08

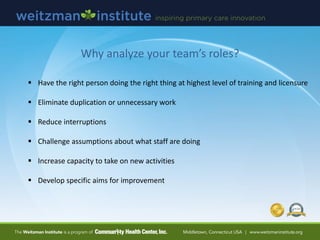

Why analyze your team’s roles?
 Have the right person doing the right thing at highest level of training and licensure
 Eliminate duplication or unnecessary work
 Reduce interruptions
 Challenge assumptions about what staff are doing
 Increase capacity to take on new activities
 Develop specific aims for improvement
Implementing Team Based Care (Webinar #1)
Webinar 1
Role Assessment of ‘the work’: Webinars 1-8

Role Activity Assessment (customizable)
Role Tracking Worksheet
Consider
Tracking
Interruptions
Role Activity Analysis
Position:
Tic Marks
(each time
activity done,
may add AM,
PM)
Total Tic
Marks
Estimated
Time per
Activity in
minutes
Total Time
Access and Communication Processes Activity
1. Schedules patients with a personal clinician for
continuity of care ||||| ||||| ||||| 15 4 min 60 min
2. Coordinates visits with multiple clinicians and/or
diagnostic tests and procedures
3. Triages how soon a patient needs to be seen
including a process for after-hours care
4. Monitors access to appointment, backlog and wait
time using telephone and email requests
5. Monitors and triages secure patient portal
messages
6. Provides advice on clinical issues via telephone or
portal messaging
7. Identifies and arranges for language services
8. Collects patient demographic and insurance
information, including preferred method of
communication
9. Helps patients activate their Personal Health
Record by signing up during office visit
10. Identifies and refers patients who might benefit from
care management support, other practice resources,
community services
Population Health Management Activity
1. Uses population registries and clinical quality
reports to monitor a panel of patient’s health and
risk status and close care gaps.
2. Communicates with many patients at once via bulk
outreach letters and portal messaging (e.g.
reminders for preventive care visits ,testing,
screening gaps)
3. Provides outreach services to patients overdue for
visit to follow up management of chronic
SampleData.Hess.2009
Worksheet.clinicalmicrosystem.org
IHI.org Poster
25%
75%

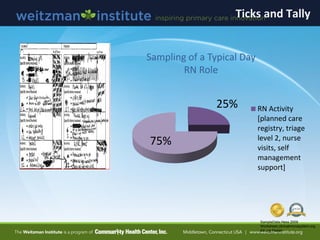

RN Activity
[planned care
registry, triage
level 2, nurse
visits, self
management
support]
Sampling of a Typical Day
RN Role
Ticks and Tally
55
33%
67%
Non-Physician Tasks Physician Tasks
Non-Physician Tasks
-immunizations
-obtaining consults
-obtaining MR
-setting up room
-filling out clerical fms
-finding interpreter
-bringing pt to room
-data entry
-finding information
Webinar #1

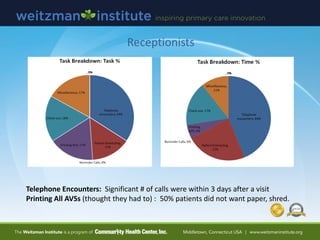

Receptionists
Telephone Encounters: Significant # of calls were within 3 days after a visit
Printing All AVSs (thought they had to) : 50% patients did not want paper, shred.

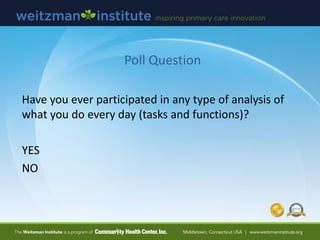

Poll Question
Have you ever participated in any type of analysis of
what you do every day (tasks and functions)?
YES
NO
Using Cycle Time
to Improve Efficiency
and Office Flow
15 Patients (1-2 weeks)
Use Clipboard with Clock
Select One Appointment Type
Random Selection Patients
AM and PM
Target 1.5 X Appt Time
15 min Appt = 23 min cycle time
20 min Appt = 35 min cycle time
30 min Appt = 45 min cycle time
45 min Appt = 68 min cycle time
SampleData.Hess.2009
Worksheet.clinicalmicrosystem.org
Note: scheduled appoint time
What if early arrival?

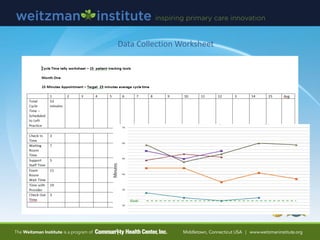

Data Collection Worksheet
Efficiency and Role Optimization

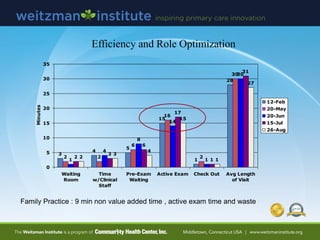

3
4
5
15
1
28
2 2
6
16
2
30
1
4
8
14
1
30
2
3
6
17
1
31
2
3
4
15
1
27
0
5
10
15
20
25
30
35
Waiting
Room
Time
w/Clinical
Staff
Pre-Exam
Waiting
Active Exam Check Out Avg Length
of Visit
Minutes
12-Feb
20-May
20-Jun
15-Jul
26-Aug
Family Practice : 9 min non value added time , active exam time and waste
Hess.CPM.2010
Example:
Assessment data
(long cycle time) is
analyzed using
Fishbone Diagram
Problems that have
high leverage for
improving results,
inform your PDSAs
(session 2).
Top of the Ramp –
Specific Aim
Putting It Together for Action Period 1
Action Period 1 Assignments
1. Meet weekly (50 min) as a Core Team
 Practice effective meeting skills and use tools with coaching support
2. Continue Daily Huddles (5-10 min) | Starting is Optional
3. Complete and share the following by uploading to TBC website: - Within 4 weeks
a) What is your global aim? – the broad objective you want to achieve in the longer run
b) Role Activity Assessment (who does what now)
c) Role Activity Tracking Data (1-3 days, all roles, coach inputs data)
 Fishbone diagram with drivers of role problem(s)
 Document any ‘quick hits’, insights
 Write a specific aim for improvement using role data
d) Cycle Time Assessment (15 )
 Fishbone diagram with drivers of cycle time problem
 Document any ‘quick hits’, insights
 Write a specific aim for improvement using cycle time data
4. Upload monthly progress report to inform Session 2 Planning.
5. Upload all missing assessments.
Monthly
Reporting
Tool

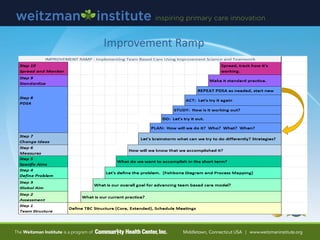

Improvement Ramp
Wrap Up and Questions

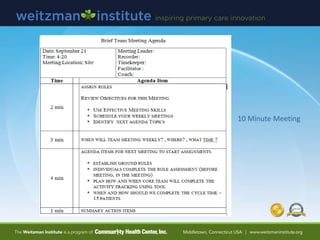

Set Up Brief Team Meeting
10 Minute Meeting
Thank Your
Colleagues

NCA - TBC - Session 1 Slides

  • 1.
    We will beginshortly… Welcome 1
  • 2.
    Using Zoom Join aZOOM meeting or webinar from your computer, iPhone or iPad Use the Q&A button to send us your questions!
  • 3.
    Zoom At this time-Please use the CHAT button to tell us the name of your Health Center and how many people have joined the meeting.
  • 4.
    4 Community Health Center,Inc. Foundational Pillars 1. Clinical Excellence- fully Integrated teams, fully integrated EMR, PCMH Level 3 2. Research & Development- CHC’s Weitzman Institute is the home of formal research, quality improvement, and R&D 3. Training the Next Generation: Postgraduate training programs for nurse practitioners and postdoctoral clinical psychologists as well as training for all health professions students CHC Profile: •Founding Year - 1972 •203 delivery sites •145k patients
  • 5.
    The Community HealthCenter, Inc. and its Weitzman Institute will provide education, information, and training to interested health centers in Transforming Teams and Training the Next Generation • National Webinars on advancing team based care, implementing post- graduate residency programs, and health professions students in FQHCs. • Invited participation in Learning Collaboratives to advance team based care or implement a post-graduate residency program at your health center. CHC’s NCA on Clinical Workforce Development The National Training and Technical Assistance Cooperative Agreements (NCAs) provide free training and technical assistance that is data driven, cutting edge and focused on quality and operational improvement to support health centers and look-alikes.
  • 6.
    National Webinar Series -2892viewers attended the webinar series -Most attended webinar: Enhancing the Role of the Medical Assistant -(March 3, 2016) 373 attendees - Videos: Viewed a total of 1,102 times - Slides: Viewed a total of 6,746 times - Representation from all 50 states, US Virgin Islands, Puerto Rico and Canada.
  • 7.
  • 8.
    147,769 1,708 0 20,000 40,000 60,000 80,000 100,000 120,000 140,000 160,000 1 2 34 5 6 7 8 9 10 11 12 13 14 15 16 17 18 19 20 21 22 TotalPatients Participating FQHCs Total Patients UDS 2015 Health Center Data Team-Based Care Residency Both Demographic and Population Profile Collectively, we serve over 607,884 patients
  • 9.
    Demographic and PopulationProfile 0% 10% 20% 30% 40% 50% 60% 70% 80% 90% 100% 1 2 3 4 5 6 7 8 9 10 11 12 13 14 15 16 17 18 19 20 21 22 %ofTotalPatients Participating FQHCs Age UDS 2015 Health Center Data Older Adults (age 65 and over) Adult (18 - 64) Children (< 18 years old)
  • 10.
  • 11.
    Almost all healthcenters offer Medical, Dental and Mental Health services. Staffing and Utilization: UDS Table 5 – We encourage you to look at your data!
  • 12.
    Quality Improvement Education PattiFeeney Manager, Quality Improvement Education
  • 13.
    Effective Meeting Skills Providingmeeting and team structure for coaches I. AGENDA II. MEETING ROLES III. ACTION PLAN
  • 17.
    Define the Problem FishboneDiagram; a useful cause & effect tool
  • 18.
  • 19.
    All tools referencedin today’s session and support material can be found by following theses links: NCA Team-Based Care Learning Collaborative NCA Post-Graduate Residency Learning Collaborative Tools and Resources >> Quality Improvement
  • 20.
    We will beginshortly… Welcome 20
  • 21.
    Team Based Care(TBC) Learning Collaborative Session One September 21, 2016 3:35 - 4:30 EST
  • 22.
    Introductions TBC Collaborative Design,Facilitation, Faculty  Ann Marie R Hess NP, MS National Cooperative Agreement  Anna Rogers, Director  Reema Mistry, Project Assistant Mentors , Coaching Faculty  Deborah Ward, RN (1:8)  Kasey Harding (1:8) 3:35 Evaluation Faculty  Kathleen Thies, PhD, RN Improvement Science Faculty  Patti Feeney  Mark Splaine, MD
  • 23.
    Session 1 Objectives Teach effective meeting skills, cause and effect diagramming, and writing specific aims to support team improvement work.  Provide an overview of the learning collaborative structure and expectations.  Help teams ‘get started’ redesigning roles.  Review Action Period 1 assignments for improving team based care.
  • 24.
    Learning Session 1Agenda Team Based Care Participants 3:35 10 min Introductions 3:45 10 min Collaborative Goal, Structure and Expectations, Resources 3:55 15 min Getting Started Tools : Role Activity Assessment , Cycle Time 4:10 10 min Action Period 1 Assignments 4:20 10 min Brief Team Meeting Break Out
  • 26.
    Interviews : GeneralImpressions  Many asked for clarification of team and coach definitions  Lots of recent growth and change in many organizations  Many reported EHR challenges re: data, documentation, duplication, and getting actionable reports  Few have depth of experience with primary care redesign models and QI methods (e.g Wagner, Bodenheimer, Nuka Alaska, PCMH, IHI)  Most are familiar with term PDSA  Most not meeting weekly to focus on QI, ‘fit into’ day of back to back visits  All have been evolving their team based model of care over time, multiple starts, looking for “refresh”  Many working on PCMH certification, recertification  Few practices have experience with coaching model Introductions
  • 27.
    Interviews : Goalsand Expectations  Want structure, guidance, resources from the Collaborative: how-to’s vs concepts  Learn from others’ and their mistakes  Common Goals | Global Aims • better efficiency, improved workflows • staff working at top of license, includes standing orders and protocols • team role clarity and standardization (care management, documentation) • improve quality outcome measures (e.g. UDS outcomes) • improve patient and team satisfaction  Reduce stress and “put the joy back into practice, need “relief from the chaos”  We have a cohesive, good team but we “all work in our silos to get the work done” Introductions
  • 28.
    Introductions Name of FQHCCoach Team Carolina Family Health Centers , Inc. Chasity Godwin 1 MD, 1 NP, 2 LPN, 1 Care Coordinator, 1 Front Desk, 1 Interpreter, 1 CNA Community Health Initiatives Zlata Vainstein 1 Medical Director, 1 Physician, 2 MA, 1 Front Desk Daughters of Charity Grace Mena 1 Area Practice Manager, 1 MD, 3 FNP, 2 Care Coordinator, 4 MA Healthcare for the Homeless Carlie Brown Need new team Holyoke Health Center Megan T. Wechsler (Primary) 1 Director of Quality and Compliance, 1 Physician, 3 RN, 1 MA, 1 Front Desk Johnson City Community Health Center Flo Weierbach 1 front Desk, 1 PNP, 1 LCSW, 1 RN, 1 Interpreter Sumter Family Health Center Sandra Sturkie 1 Director of Patient Services, 1 Clinical Manager, 1 BH Clinical Manager, 1 BH RN, 1 Physician, 2 Case Managers, 1 MA, 1 Dental Services Coordinator, 1 Patient Financial Coordinator, 1 Clinical IT, 1 Pharmacist, 1 Call Center Rep, 1 Referrals Manager Syracuse Community Health Center, Inc. Cathy Brigden 1 Physician, 1 FNP, 1 LPN, 2 RN, 3 MA, 1 Office Manager Tyler Family Circle of Care Sherri Gould 1 CMO, 1 COO, 1 LVN, 1 OA, 1 PNP, 1 Process Improvement Manager
  • 29.
    Name of FQHCCoach Team Avenal Community Health Center John Kalfayan 1 BH, 1 Physician, 1 MA, 1 Medical Director, 1 Front Desk Educational Health Center of Wyoming Brenda Burnett 1 Provider, 2 RN, 1 Radiologic Technologist, 1 EMR Manager, 1 MA, 1 Clinical Manager El Rio Santa Cruz Josh Carzoli 1 MA, 1 RN, 1 BH, 1 Chief Clinical Officer, 1 LPN, 2 Physician, 1 Front Desk, 1 COO, 3 RN Clinic Manager, 1 IT Peach Tree Healthcare Ruben Ruiz 1 Chief Quality Officer, 1 Quality Coordinator, 1 Dir of Operations, 1 Site Manager, 1 Dir of HR, 1 NP, 3 MA, 1 Data Analyst, 1 Ops Specialist, 1 Clinical Support Services Manager Pecos Valley Medical Center L. David Young 2 RN, 1 NP, 1 MA The Children’s Clinic Karla Rodriguez 1 Provider, 1 MA, 1 Care Team Rep Via Care Community Health Center Kimberly McFerguson 1 FNP, 1 MA, 1 Outreach & Enrollment Specialist, 1 MSW, 1 Front Office Lead MA Introductions
  • 30.
    Team Skills AssessmentSummary (N=51) Percentage Strongly Agree or Agree are Competent % Strongly Agree or Agree 60 60 65 85 65 0 10 20 30 40 50 60 70 80 90 100 Gathering and Using Data Skills Using Effective Meeting Skills Implementing Daily Huddles Applying Teamwork Skills Using Improvement Skills
  • 31.
    Coach Skills AssessmentSummary (N=16) Percentage who rated themselves Competent, Proficient, or Expert 35 65 47 47 59 0 10 20 30 40 50 60 70 80 90 100 Data and Information Systems Meeting and Interpersonal Skills Improvement Skills Technical Skills (excel, webinar) Art of Coaching Skills %
  • 32.
    Level D: JustGetting Started Level C: Early Stages of Change Level B: Implemented Basic Changes Level A: Achieved Most or All of the Important Change Required Team Based Practice Assessment (LEAP)
  • 33.
    0 1 2 3 4 5 6 7 Level A LevelB Level C Level D Self-Management Support Planned Care Care Management Medication Management Care Activities Assessment (N=11) Number of sites reporting level of performance implementing key processes Just getting started Early stages of change Implemented basic changes Achieved most or all of the important changes required
  • 34.
    0 1 2 3 4 5 6 7 Level A LevelB Level C Level D Medical Assistant (MA) Registered Nurse (RN) Laypersons Pharmacist Role Activities Assessment (N=11) Number of sites reporting by level of performance by role Just getting started Early stages of change Implemented basic changes Achieved most or all of the important changes required
  • 35.
    Transformational Team BasedCare Improves Outcomes
  • 36.
    Learning Session 1Agenda Team Based Care Participants 3:35 10 min Introductions 3:45 10 min Collaborative Goal, Structure and Expectations, Resources 3:55 15 min Getting Started Tools : Role Activity Assessment , Cycle Time 4:10 10 min Action Period 1 Assignments 4:20 10 min Brief Team Meeting (break out)
  • 37.
    Goal The Team-Based CareLearning Collaborative is designed to provide transformational* strategies and mentored coaching support, to help a core team implement an advanced model of team- based care over 12 months. *Transformation can take up to 18-24 months 3:45
  • 38.
     Achieve multipleTBC specific aims  Standardize (SDSAs) roles and key processes (Playbook, Spread Plan)  Improve team and coach skills (improvement science, team work, coaching)  Develop a post collaborative team action plan How is the Collaborative Structured? 90 min Learning Sessions Between Session Action Periods (6 weeks) Complete Assignments Weekly Team Meetings (5-6), Daily Huddles Monthly Reporting Implementation Tools and Skills Change Concept Resources Learning From Each Other Team Based Care Webinars (8) Core Team Team Based Practice Assessment (LEAP) Coach and Team Skills Assessment Practice Outcomes Data (UDS, Other) Interviews Coach Prep Session Technology Session Between Session Mentoring and Faculty Support 7 Sept 21 Nov 2 Dec 14 Jan 25 Mar 15 Apr 26 June 14
  • 39.
    Improvement Science TheoryBursts (10 min) Developing Skills Session 1 : Sept 21st o Running effective team meetings using tools o Developing and using a cause and effect diagram to inform PDSAs o Writing a specific aim statement Session 2 : Nov 2nd o Developing a process map or current state workflow o Applying PDSA methodology for improvement Session 3 : Dec 14 o Using data for improvement (run charts, control charts) Session 4 : Jan 25 o Standardizing (SDSAs) and Reliability Science Session 5 : March 15 o Spreading Change Session 6 : April 26 o Gantt Charting : 3-6 month Core Team improvement plan
  • 40.
    Mentor and CoachRoles Coaches (posted role descriptions)  Help and support teams in learning new skills and achieving their aims  Help teams complete action period assignments, monthly reports, evaluation  Meet weekly with Mentor and other coaches, 1:1 as needed  Participate in 7 learning sessions  Support weekly team meetings, and between meeting assignments, session prep Mentors (posted role descriptions)  Provide support and resources for developing coaching skills  Facilitate weekly debriefs with Coaches  Provide individual support as needed
  • 41.
    NCA Online LearningNetwork Find material for download, TBC webinars, and team folders for sharing your work... Improvingprimarycare.org Discussion Board Ask questions or make requests of teams, faculty….
  • 42.
  • 43.

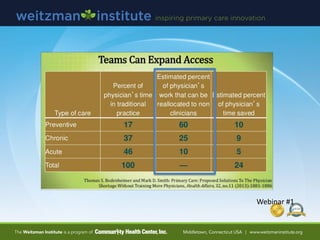

    Implementing Team BasedCare (Webinar #1) Webinar 1
  • 44.
    Defining Structure andStaff Responsibilities Practice Managers and Leaders : must stay involved, engaged in your work
  • 45.
    Start with CoreTeam, Then Expanded Team Current State Examples: 8 Participating Teams  1 MD, 1 NP, 2 LPN, 1 Care Coordinator, 1 Front Desk, 1 Interpreter, 1 CNA  1 MD, 2 MA, 1 Front Desk  1 PNP, 1 LCSW, 1 RN, 1 Interpreter, 1 front Desk,  1 MD, 3 FNP, 2 Care Coordinator, 4 MA  1 MD, 1 FNP, 1 LPN, 2 RN, 3 MA, 1 Office Manager  1 FNP, 1 MA, 1 Outreach Specialist, 1 MSW, 1 Front Office, Lead MA  1 BH, 1 MD, 1 MA, 1 Front Desk  1 Provider, 2 RN, 1 Radiologic Tech, 1 MA
  • 46.
    TBC Concept Resource(webinar #1 and #2) Principle  Patients want to receive their care from smaller teams (PODS) and know them personally Physical  Wall colors differentiate pods in practice , match business cards  Central open area surrounded by exam rooms  Co location of pod members, all carry laptops  3 exam rooms per provider – all care comes to patient  2 pods share procedure room - standardized TBC Structure  Break down large systems into PODS (care teams)  4 “Empaneled” Providers (3FTEs), 3 MAs dedicated to provider (dyad)  1 BH, 1 RN, 1 Case Coordinator (navigator, health coach), 1 front desk,  Patient empaneled both to a pod and to a Dyad  Flow Coordinator and Team Manager rotating roles (RN, MA)  Medical Records staff – input electronic data Roles and Responsibilities  Defining and Training, Standing Orders and Protocols Standardizing Workflows • Making ‘hundreds’ accessible to all Teams Need to Meet • Daily Huddles : 8am and 2pm • Weekly Meetings : Improvement Work, Population Health Management
  • 47.
    Poll Question Would yousay that you have ‘significant’ work to do defining your “core” and “extended” team structure? Yes No
  • 48.
    Role Activity Assessment WhoDoes What Now? 4:08
  • 49.
    Why analyze yourteam’s roles?  Have the right person doing the right thing at highest level of training and licensure  Eliminate duplication or unnecessary work  Reduce interruptions  Challenge assumptions about what staff are doing  Increase capacity to take on new activities  Develop specific aims for improvement
  • 50.
    Implementing Team BasedCare (Webinar #1) Webinar 1
  • 51.
    Role Assessment of‘the work’: Webinars 1-8
  • 52.
  • 53.
    Role Tracking Worksheet Consider Tracking Interruptions RoleActivity Analysis Position: Tic Marks (each time activity done, may add AM, PM) Total Tic Marks Estimated Time per Activity in minutes Total Time Access and Communication Processes Activity 1. Schedules patients with a personal clinician for continuity of care ||||| ||||| ||||| 15 4 min 60 min 2. Coordinates visits with multiple clinicians and/or diagnostic tests and procedures 3. Triages how soon a patient needs to be seen including a process for after-hours care 4. Monitors access to appointment, backlog and wait time using telephone and email requests 5. Monitors and triages secure patient portal messages 6. Provides advice on clinical issues via telephone or portal messaging 7. Identifies and arranges for language services 8. Collects patient demographic and insurance information, including preferred method of communication 9. Helps patients activate their Personal Health Record by signing up during office visit 10. Identifies and refers patients who might benefit from care management support, other practice resources, community services Population Health Management Activity 1. Uses population registries and clinical quality reports to monitor a panel of patient’s health and risk status and close care gaps. 2. Communicates with many patients at once via bulk outreach letters and portal messaging (e.g. reminders for preventive care visits ,testing, screening gaps) 3. Provides outreach services to patients overdue for visit to follow up management of chronic
  • 54.
    SampleData.Hess.2009 Worksheet.clinicalmicrosystem.org IHI.org Poster 25% 75% RN Activity [plannedcare registry, triage level 2, nurse visits, self management support] Sampling of a Typical Day RN Role Ticks and Tally
  • 55.
    55 33% 67% Non-Physician Tasks PhysicianTasks Non-Physician Tasks -immunizations -obtaining consults -obtaining MR -setting up room -filling out clerical fms -finding interpreter -bringing pt to room -data entry -finding information
  • 56.
  • 57.
    Receptionists Telephone Encounters: Significant# of calls were within 3 days after a visit Printing All AVSs (thought they had to) : 50% patients did not want paper, shred.
  • 58.
    Poll Question Have youever participated in any type of analysis of what you do every day (tasks and functions)? YES NO
  • 59.
    Using Cycle Time toImprove Efficiency and Office Flow
  • 60.
    15 Patients (1-2weeks) Use Clipboard with Clock Select One Appointment Type Random Selection Patients AM and PM Target 1.5 X Appt Time 15 min Appt = 23 min cycle time 20 min Appt = 35 min cycle time 30 min Appt = 45 min cycle time 45 min Appt = 68 min cycle time SampleData.Hess.2009 Worksheet.clinicalmicrosystem.org Note: scheduled appoint time What if early arrival?
  • 61.
  • 62.
    Efficiency and RoleOptimization 3 4 5 15 1 28 2 2 6 16 2 30 1 4 8 14 1 30 2 3 6 17 1 31 2 3 4 15 1 27 0 5 10 15 20 25 30 35 Waiting Room Time w/Clinical Staff Pre-Exam Waiting Active Exam Check Out Avg Length of Visit Minutes 12-Feb 20-May 20-Jun 15-Jul 26-Aug Family Practice : 9 min non value added time , active exam time and waste
  • 63.
    Hess.CPM.2010 Example: Assessment data (long cycletime) is analyzed using Fishbone Diagram Problems that have high leverage for improving results, inform your PDSAs (session 2). Top of the Ramp – Specific Aim Putting It Together for Action Period 1
  • 64.
    Action Period 1Assignments 1. Meet weekly (50 min) as a Core Team  Practice effective meeting skills and use tools with coaching support 2. Continue Daily Huddles (5-10 min) | Starting is Optional 3. Complete and share the following by uploading to TBC website: - Within 4 weeks a) What is your global aim? – the broad objective you want to achieve in the longer run b) Role Activity Assessment (who does what now) c) Role Activity Tracking Data (1-3 days, all roles, coach inputs data)  Fishbone diagram with drivers of role problem(s)  Document any ‘quick hits’, insights  Write a specific aim for improvement using role data d) Cycle Time Assessment (15 )  Fishbone diagram with drivers of cycle time problem  Document any ‘quick hits’, insights  Write a specific aim for improvement using cycle time data 4. Upload monthly progress report to inform Session 2 Planning. 5. Upload all missing assessments.
  • 65.
  • 66.
  • 67.
    Wrap Up andQuestions Set Up Brief Team Meeting
  • 68.
  • 69.
