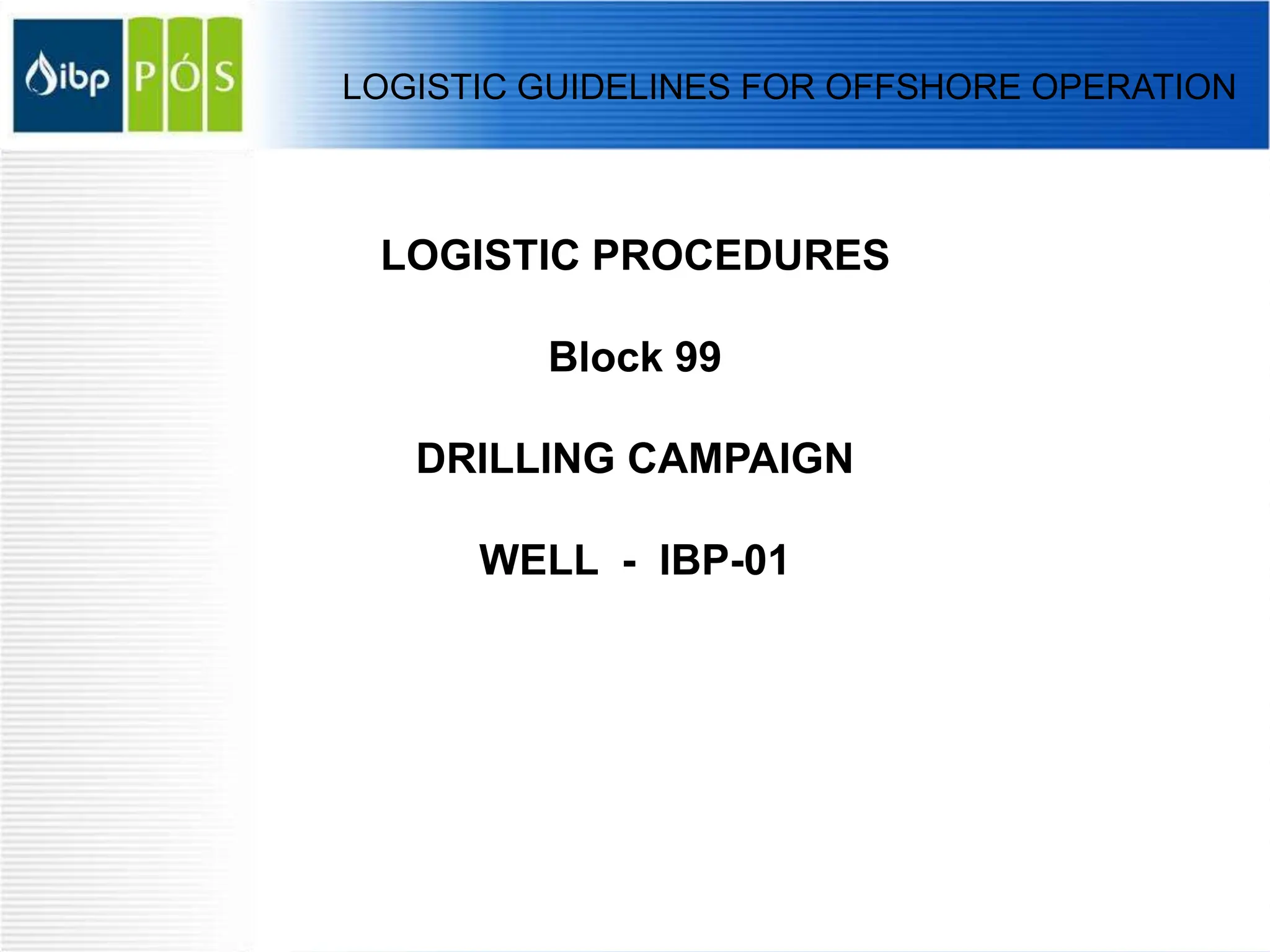

LOGISTIC PROCEDURES
Block 99
DRILLING CAMPAIGN
WELL - IBP-01
LOGISTIC GUIDELINES FOR OFFSHORE OPERATION

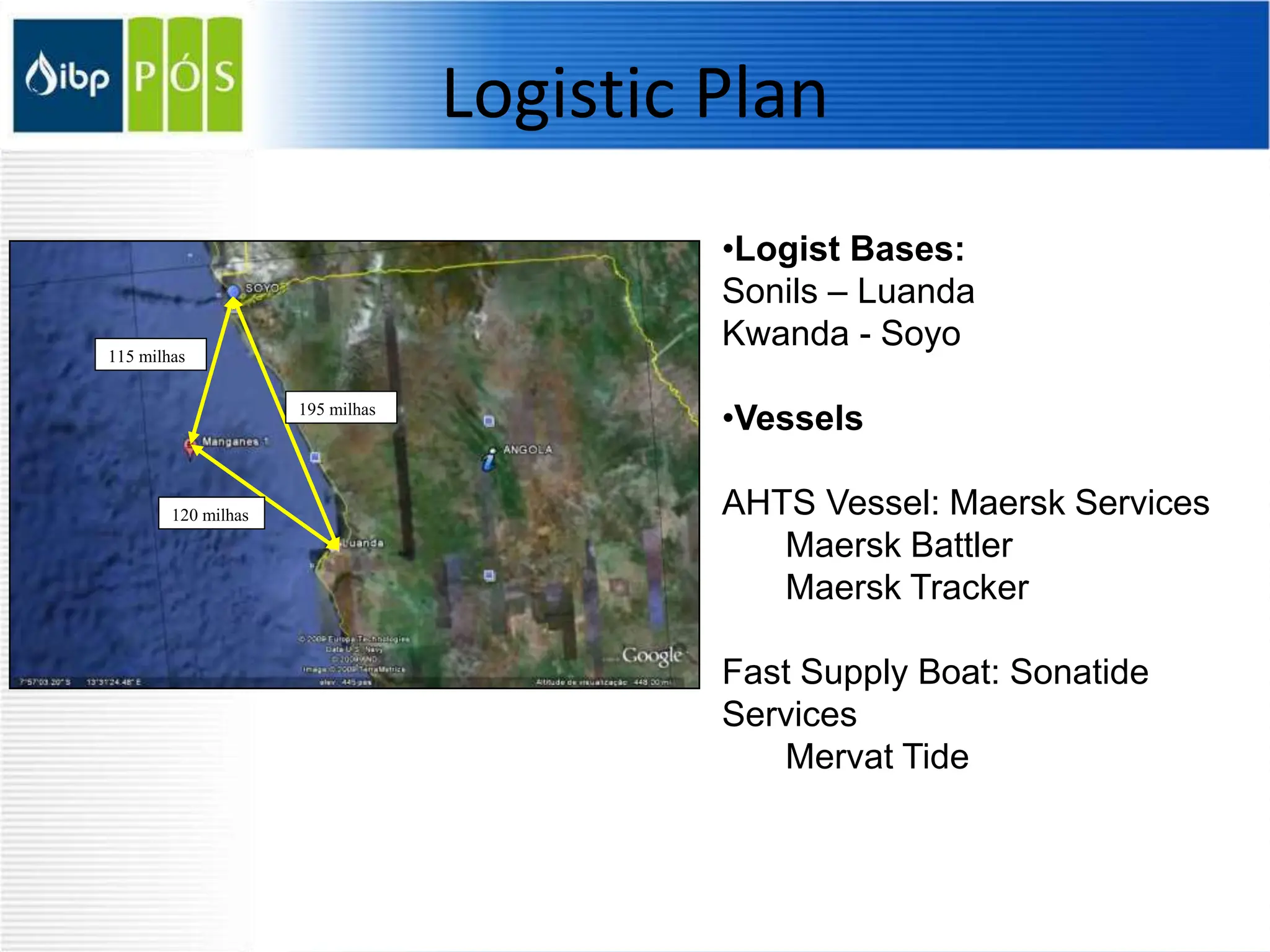

Logistic Plan
120 milhas
195 milhas
115 milhas
•Logist Bases:
Sonils – Luanda
Kwanda - Soyo
•Vessels
AHTS Vessel: Maersk Services
Maersk Battler
Maersk Tracker
Fast Supply Boat: Sonatide
Services
Mervat Tide

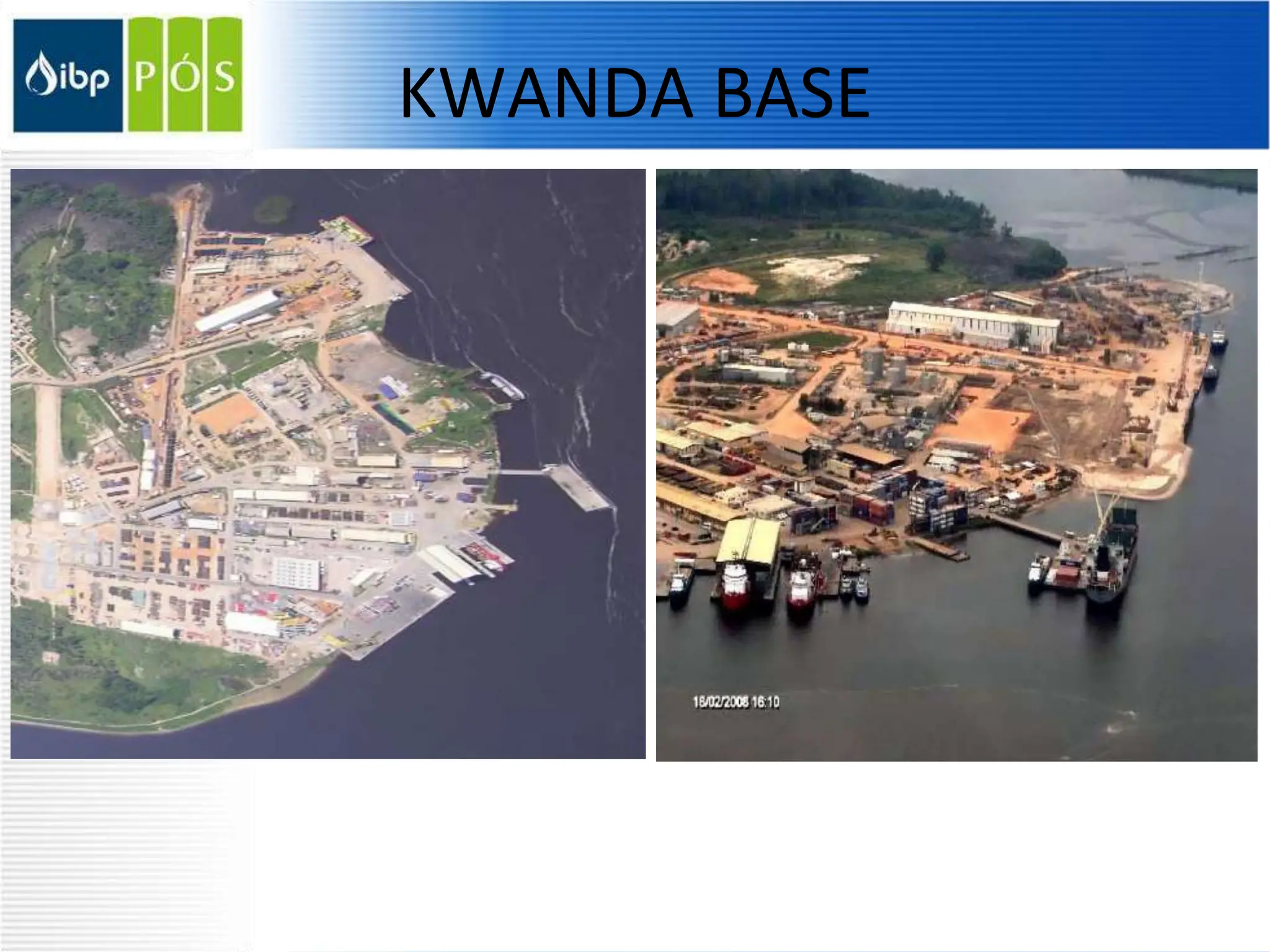

KWANDA BASE

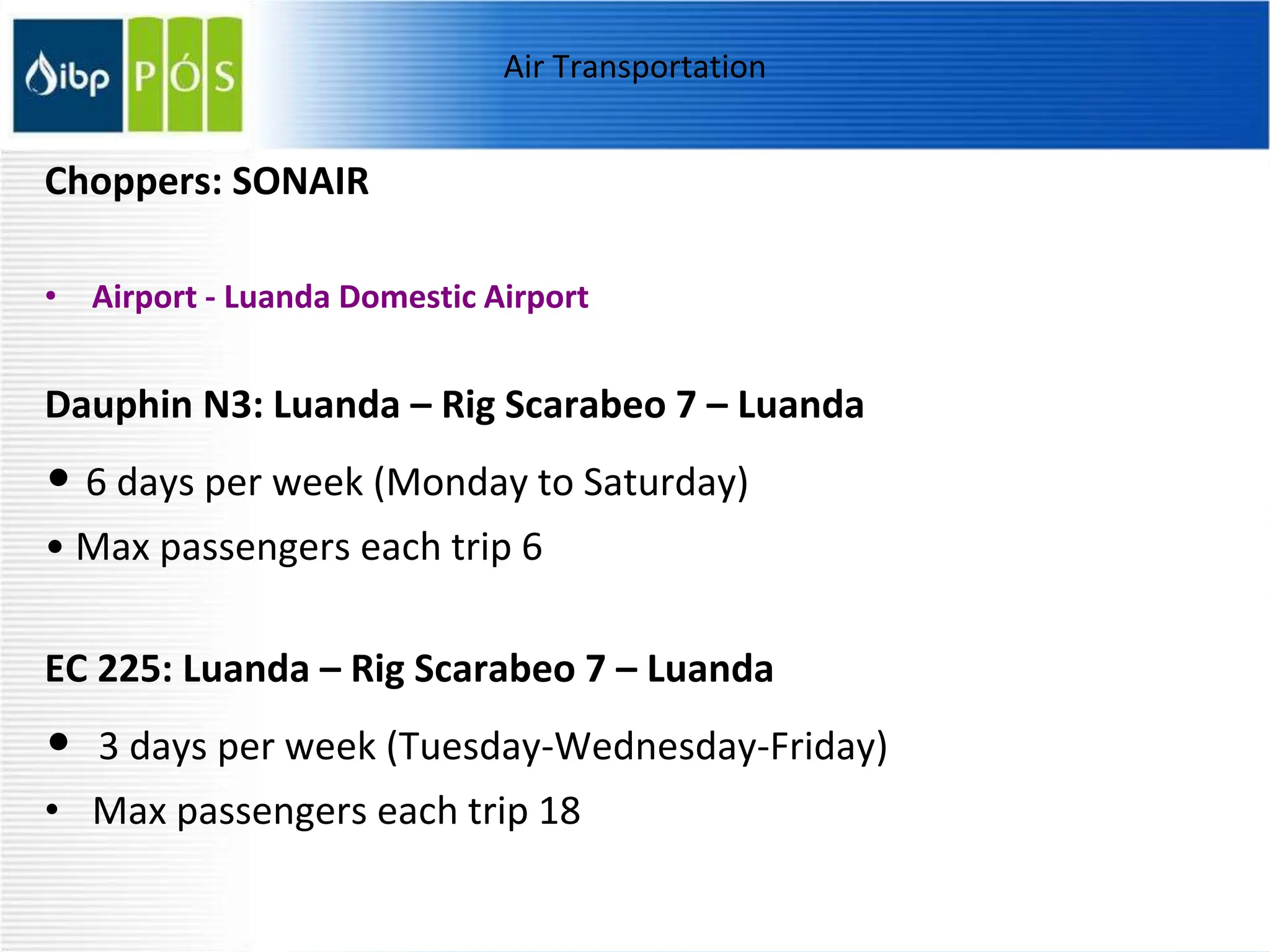

Air Transportation
Choppers: SONAIR
• Airport - Luanda Domestic Airport
Dauphin N3: Luanda – Rig Scarabeo 7 – Luanda
• 6 days per week (Monday to Saturday)
• Max passengers each trip 6
EC 225: Luanda – Rig Scarabeo 7 – Luanda
• 3 days per week (Tuesday-Wednesday-Friday)
• Max passengers each trip 18

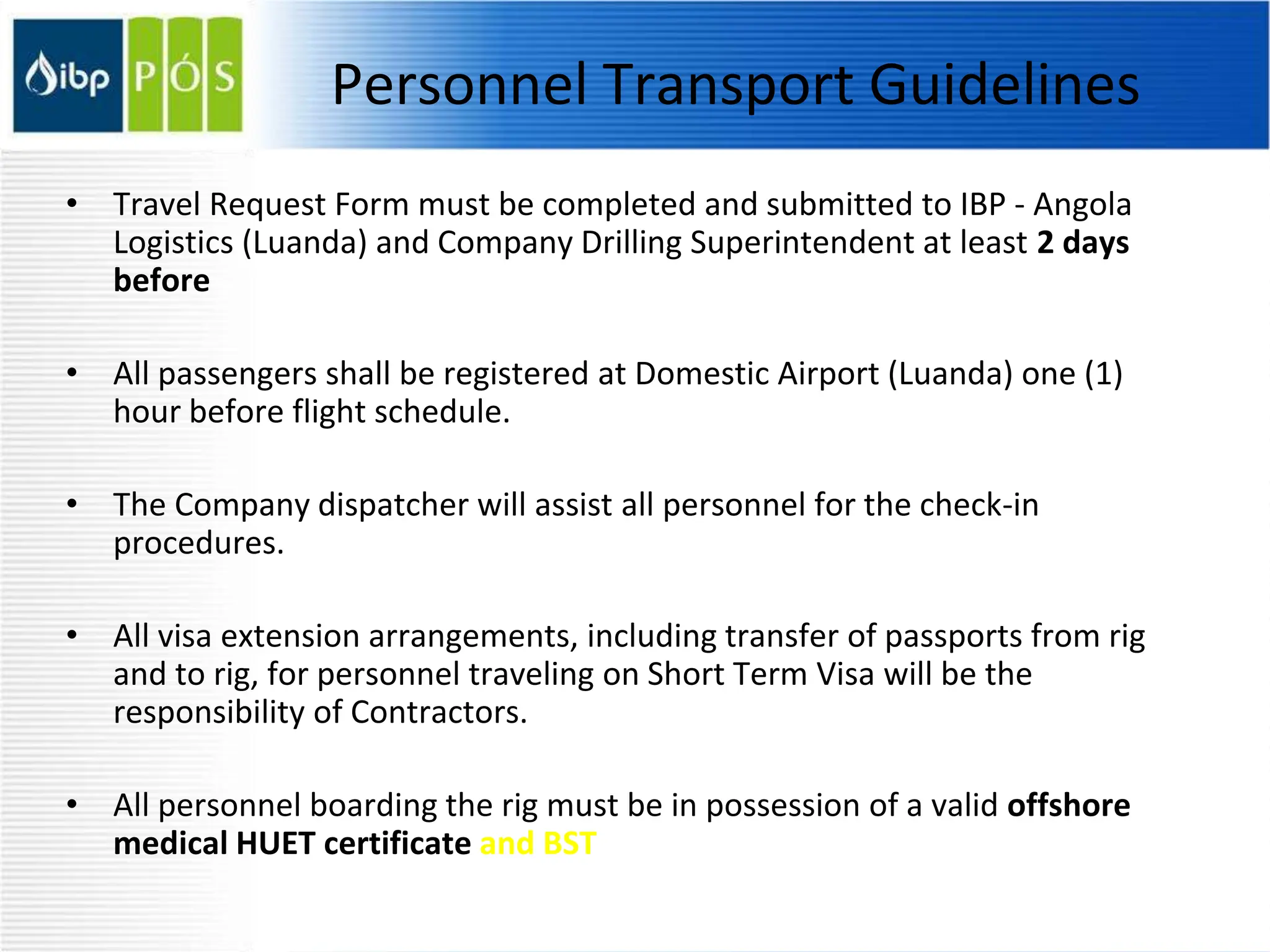

Personnel Transport Guidelines
• Travel Request Form must be completed and submitted to IBP - Angola
Logistics (Luanda) and Company Drilling Superintendent at least 2 days
before
• All passengers shall be registered at Domestic Airport (Luanda) one (1)
hour before flight schedule.
• The Company dispatcher will assist all personnel for the check-in
procedures.
• All visa extension arrangements, including transfer of passports from rig
and to rig, for personnel traveling on Short Term Visa will be the
responsibility of Contractors.
• All personnel boarding the rig must be in possession of a valid offshore
medical HUET certificate and BST

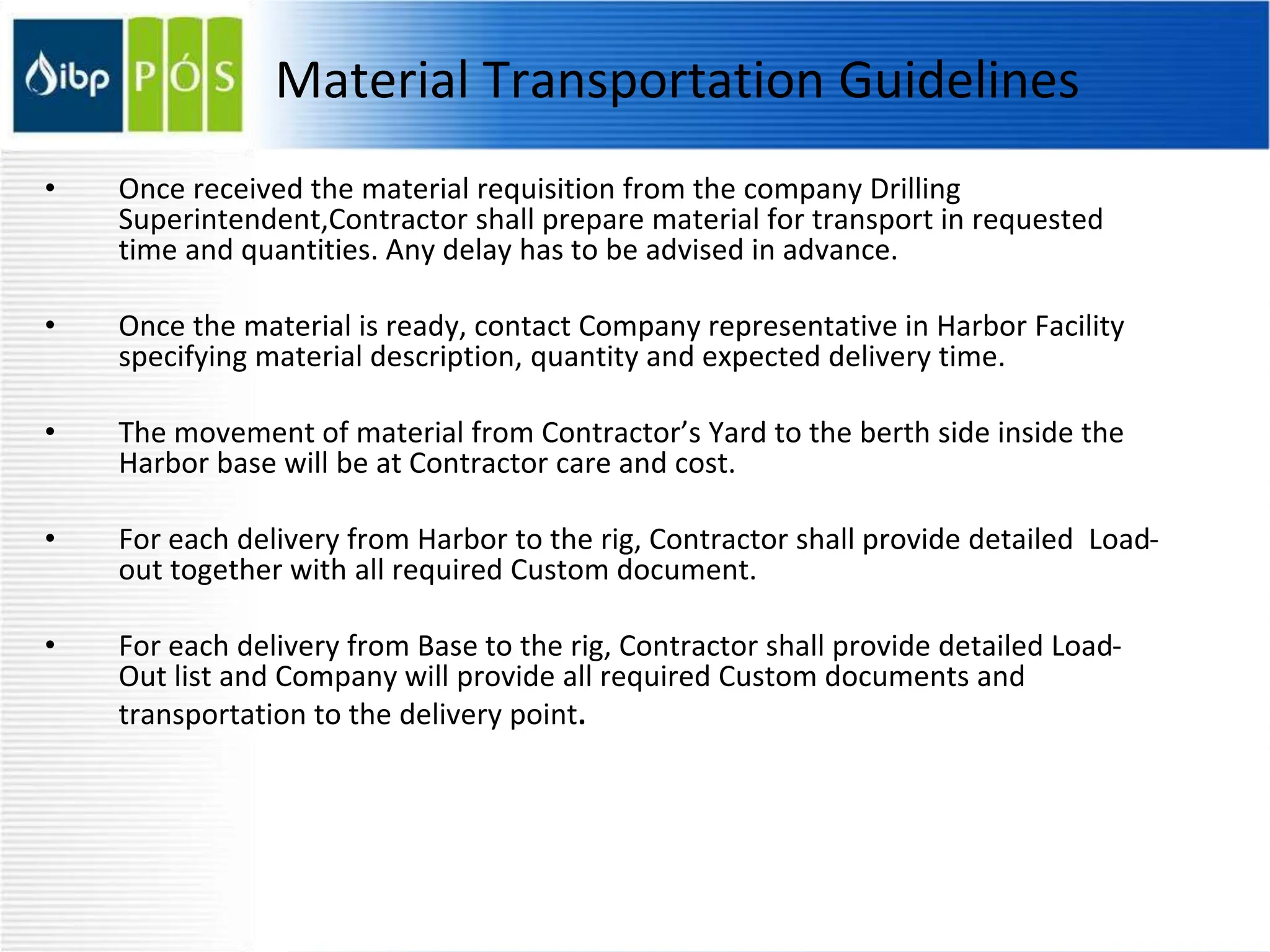

Material Transportation Guidelines
• Once received the material requisition from the company Drilling
Superintendent,Contractor shall prepare material for transport in requested
time and quantities. Any delay has to be advised in advance.
• Once the material is ready, contact Company representative in Harbor Facility
specifying material description, quantity and expected delivery time.
• The movement of material from Contractor’s Yard to the berth side inside the
Harbor base will be at Contractor care and cost.
• For each delivery from Harbor to the rig, Contractor shall provide detailed Load-
out together with all required Custom document.
• For each delivery from Base to the rig, Contractor shall provide detailed Load-
Out list and Company will provide all required Custom documents and
transportation to the delivery point.

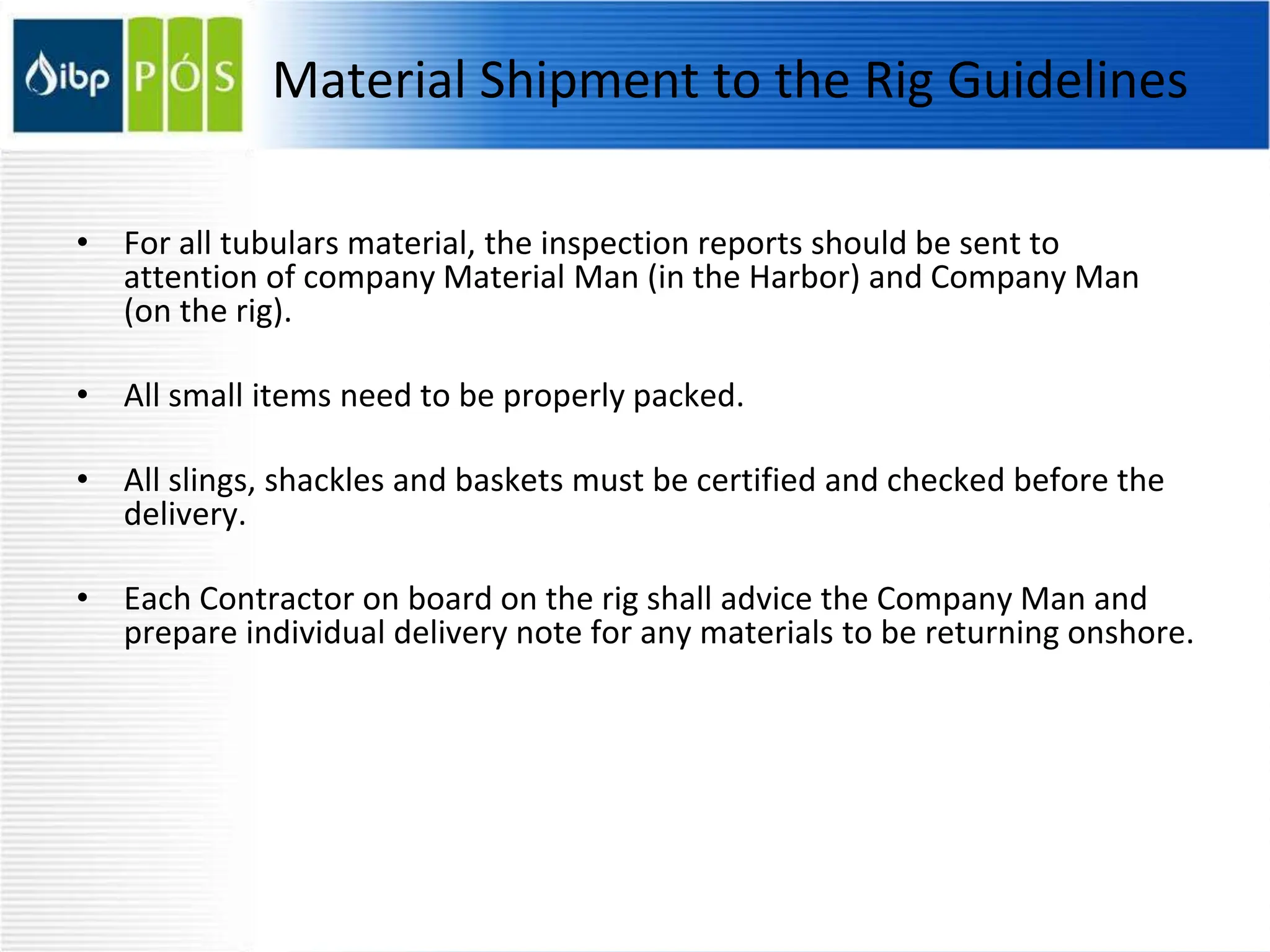

Material Shipment to the Rig Guidelines
• For all tubulars material, the inspection reports should be sent to
attention of company Material Man (in the Harbor) and Company Man
(on the rig).
• All small items need to be properly packed.
• All slings, shackles and baskets must be certified and checked before the
delivery.
• Each Contractor on board on the rig shall advice the Company Man and
prepare individual delivery note for any materials to be returning onshore.
Logistic Contacts
Drilling Superintendent
• e-mail: Mobile: +244XXXXXXXX
• Office: +244 XXXXXX
Operations Logistic
• e-mail:
• Mobile: +244 XXXXXXX
• Office: +244 XXXXXXX
Thanks
