The document provides details about how Andy O'Dell managed a data migration project through the challenges presented by the COVID-19 pandemic. Some key points:

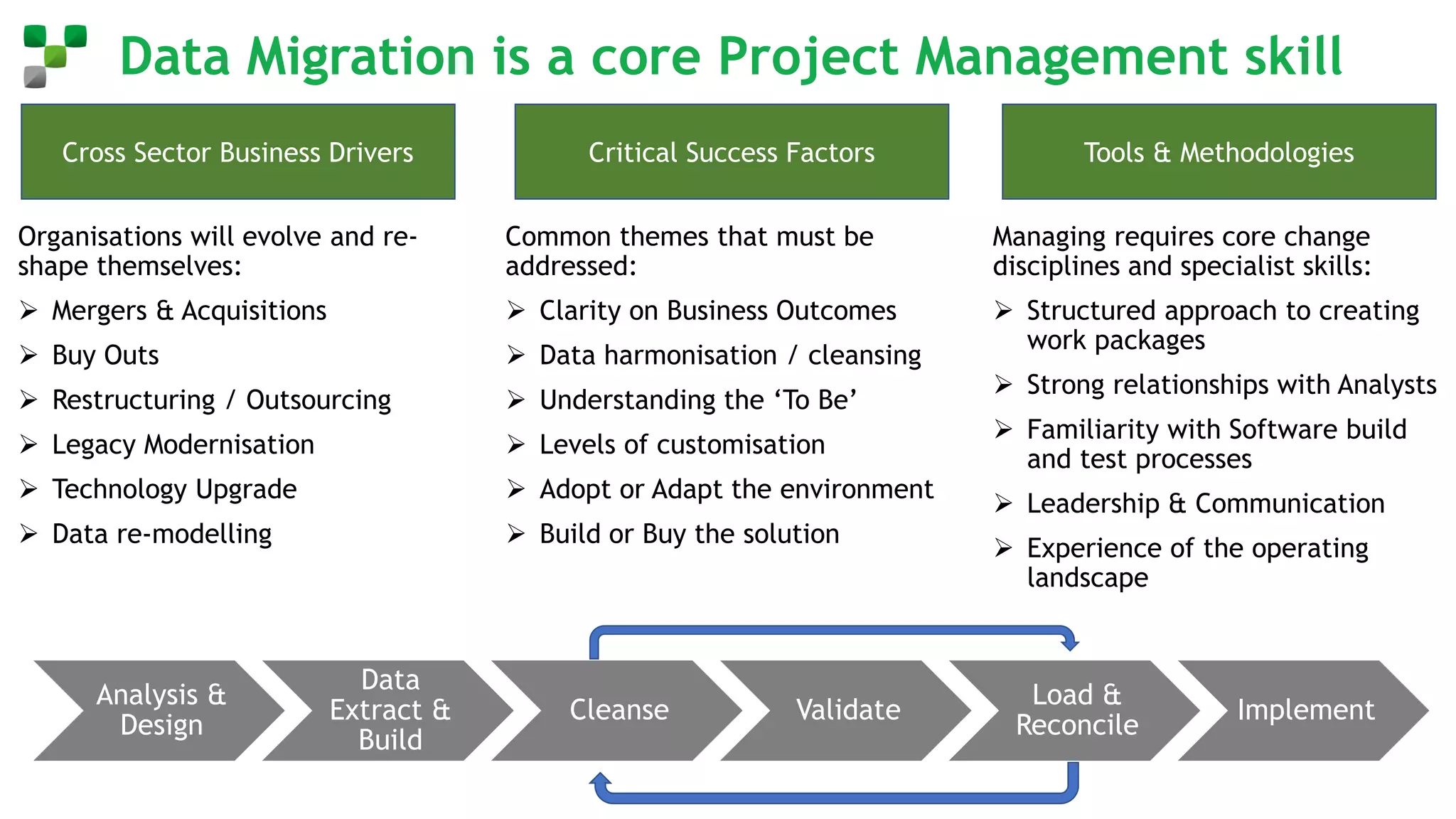

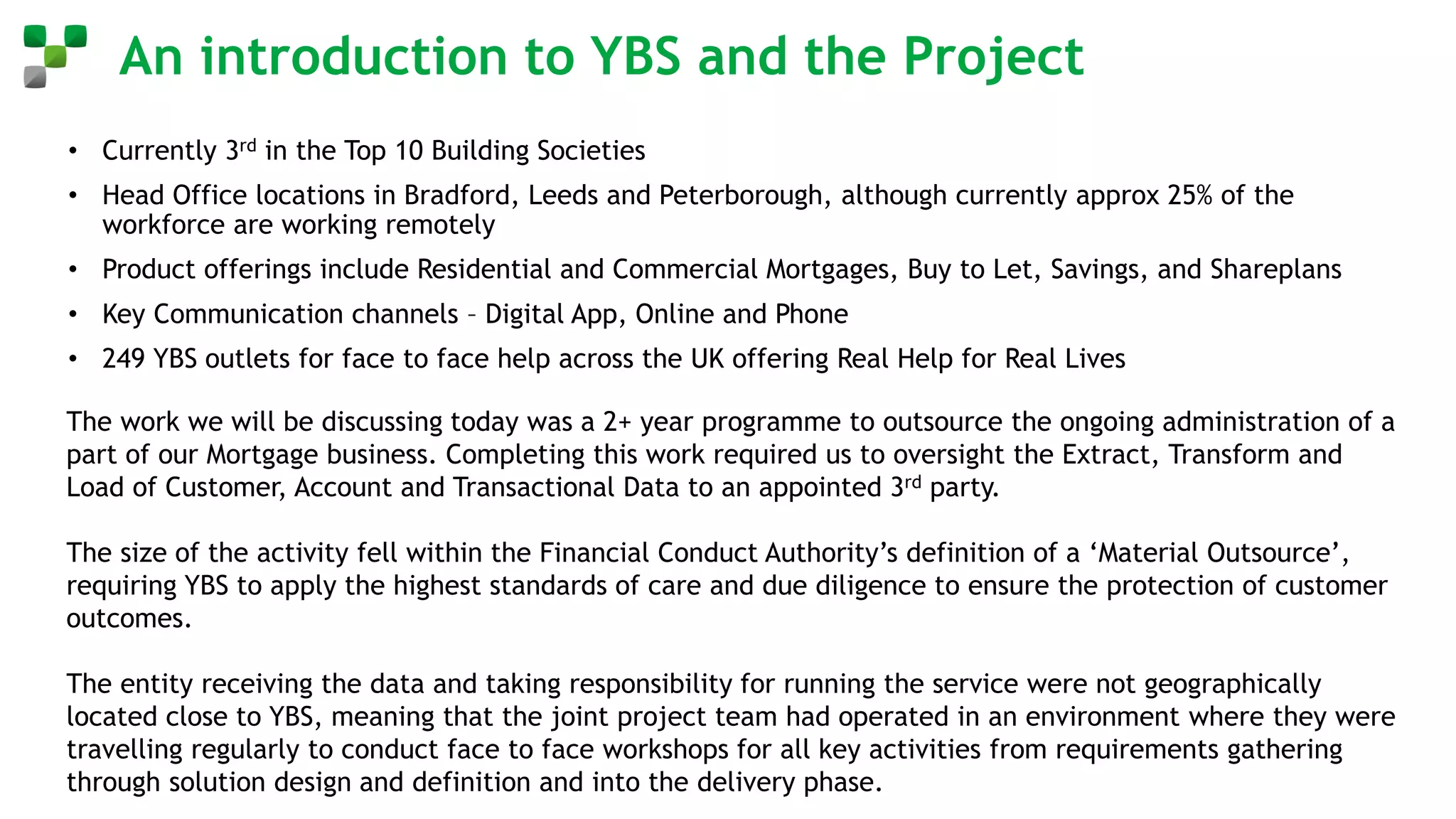

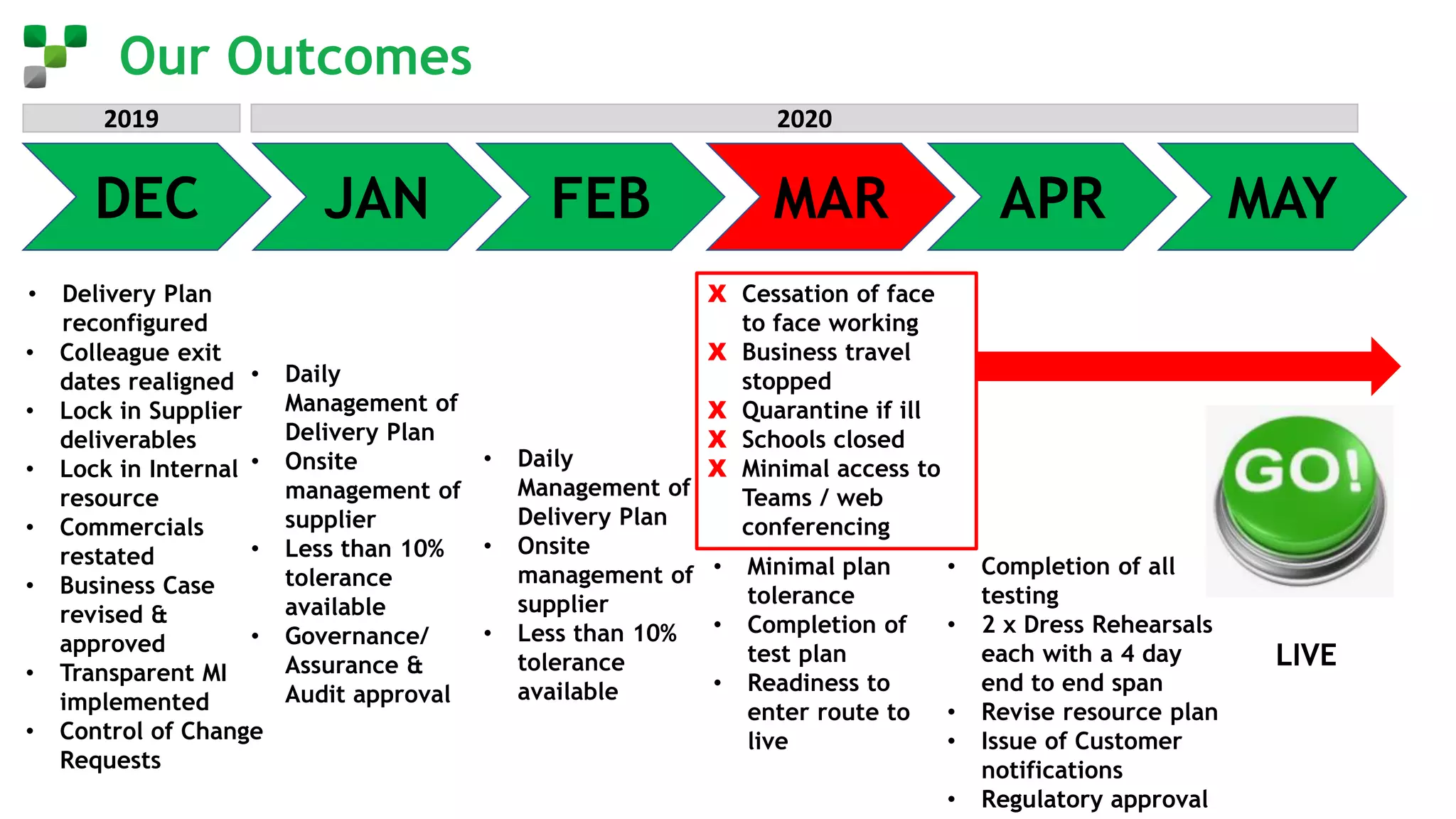

- The project involved migrating customer, account, and transactional data from YBS to a third-party provider during a two-year outsourcing program.

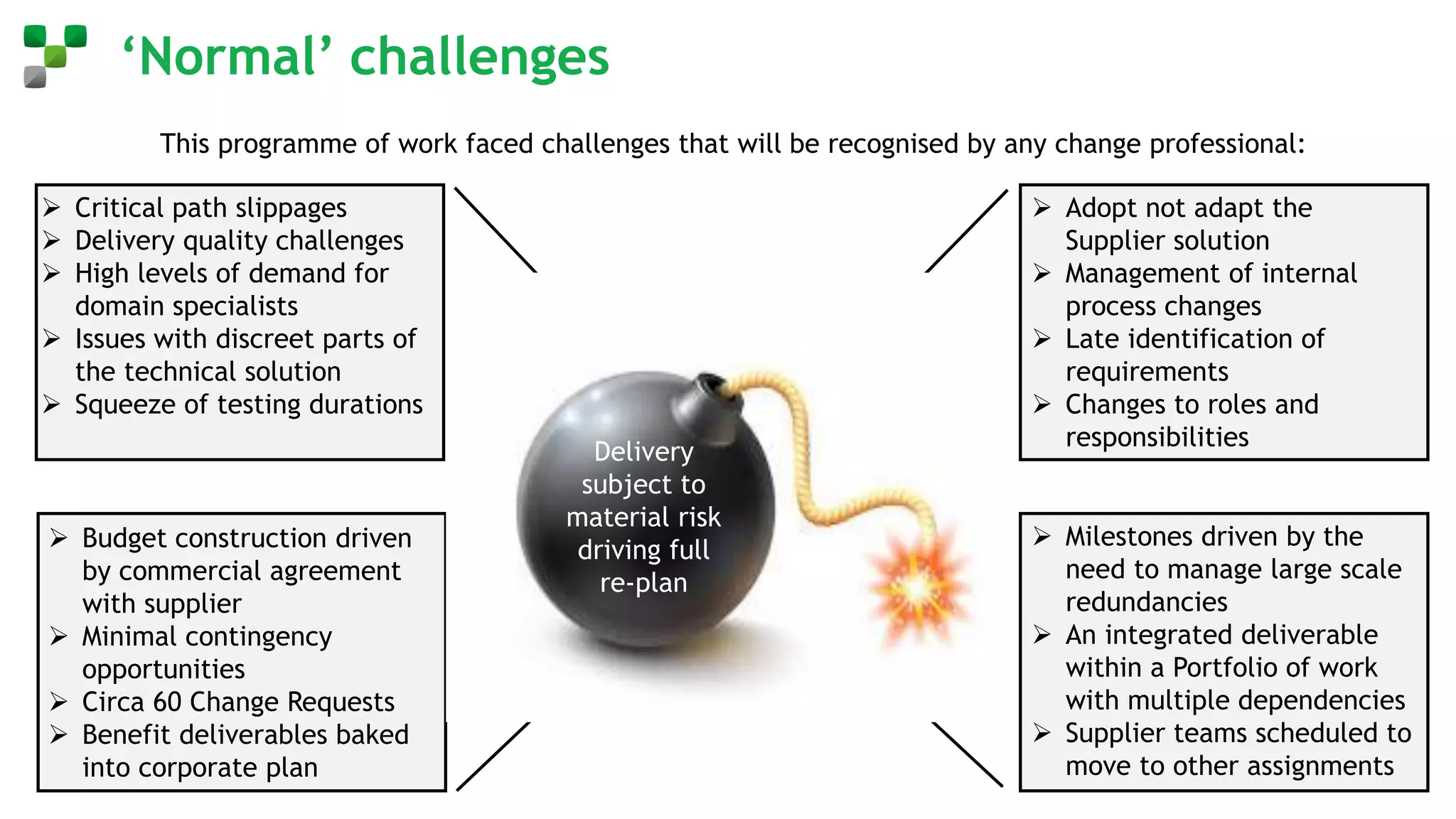

- Lockdowns and travel restrictions disrupted plans for an on-site "big bang" data transfer weekend and required remote work.

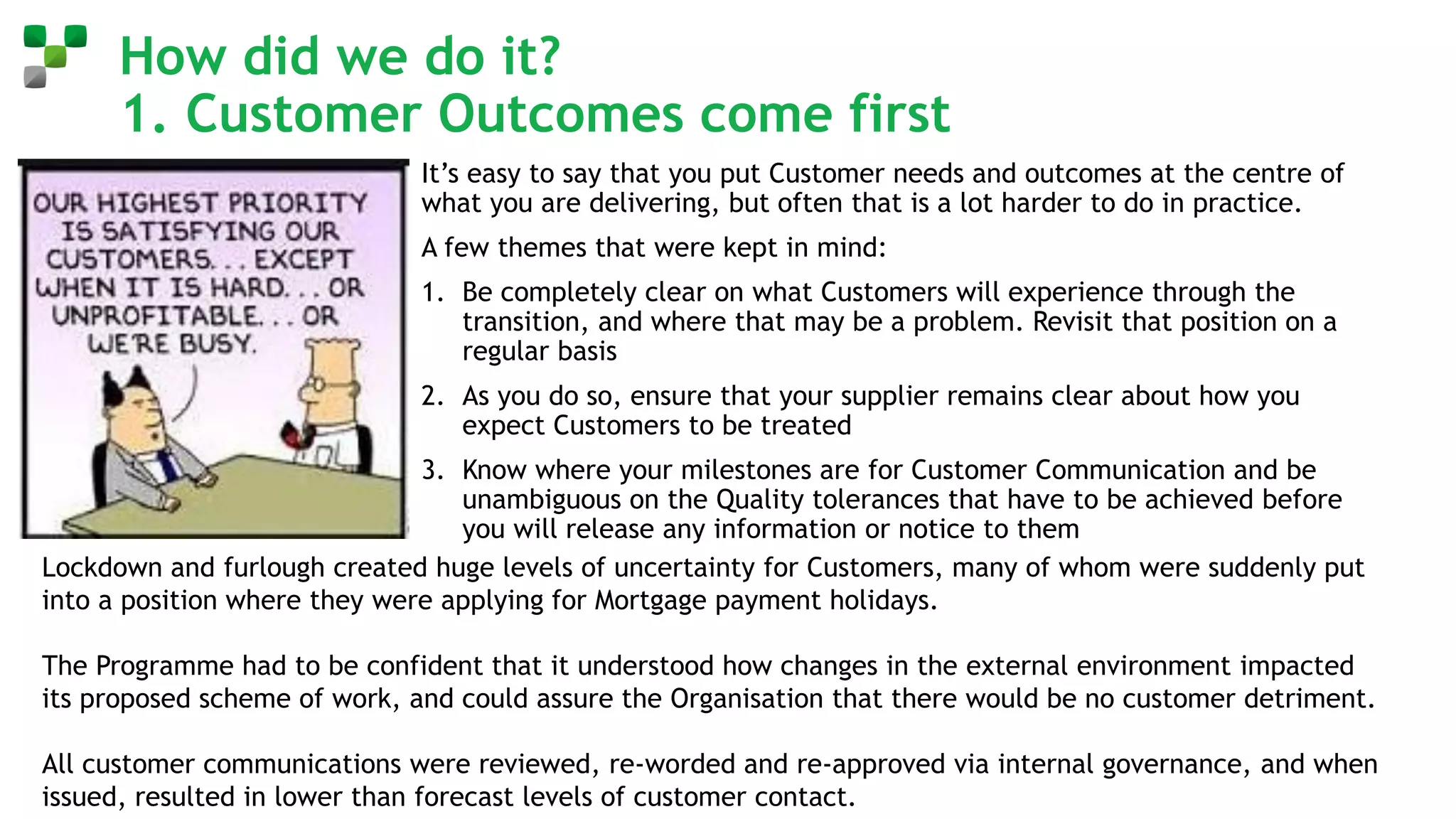

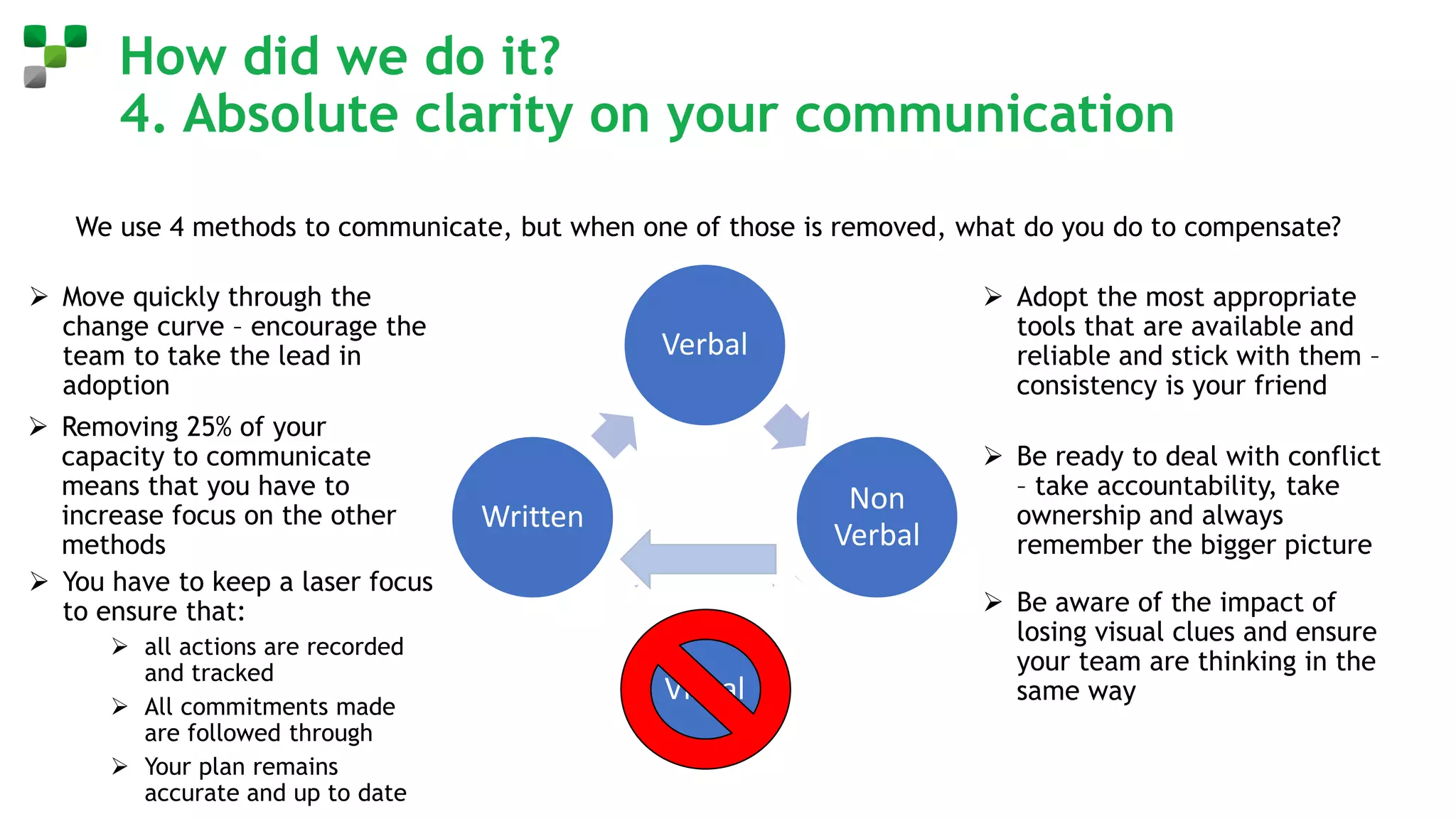

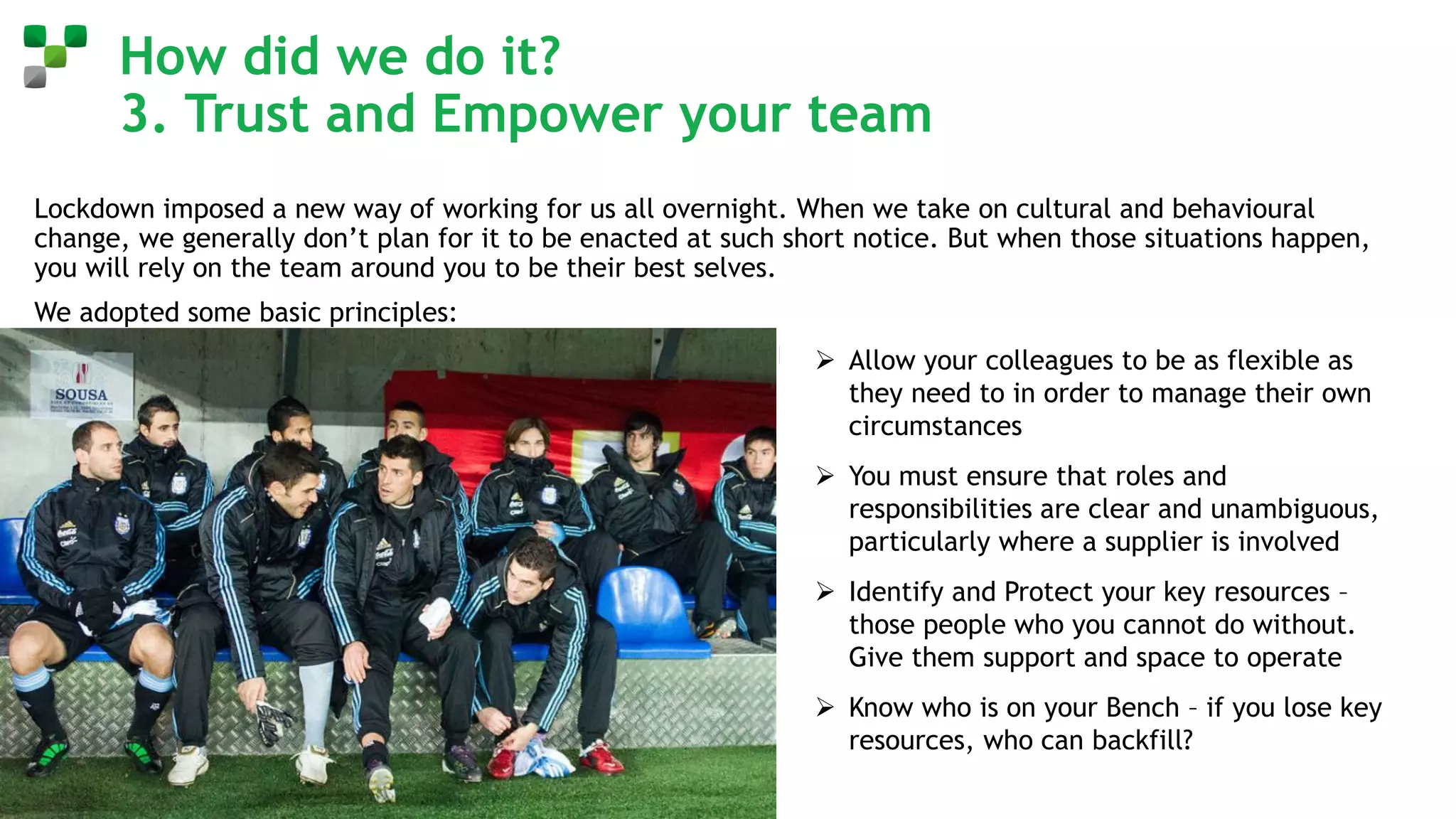

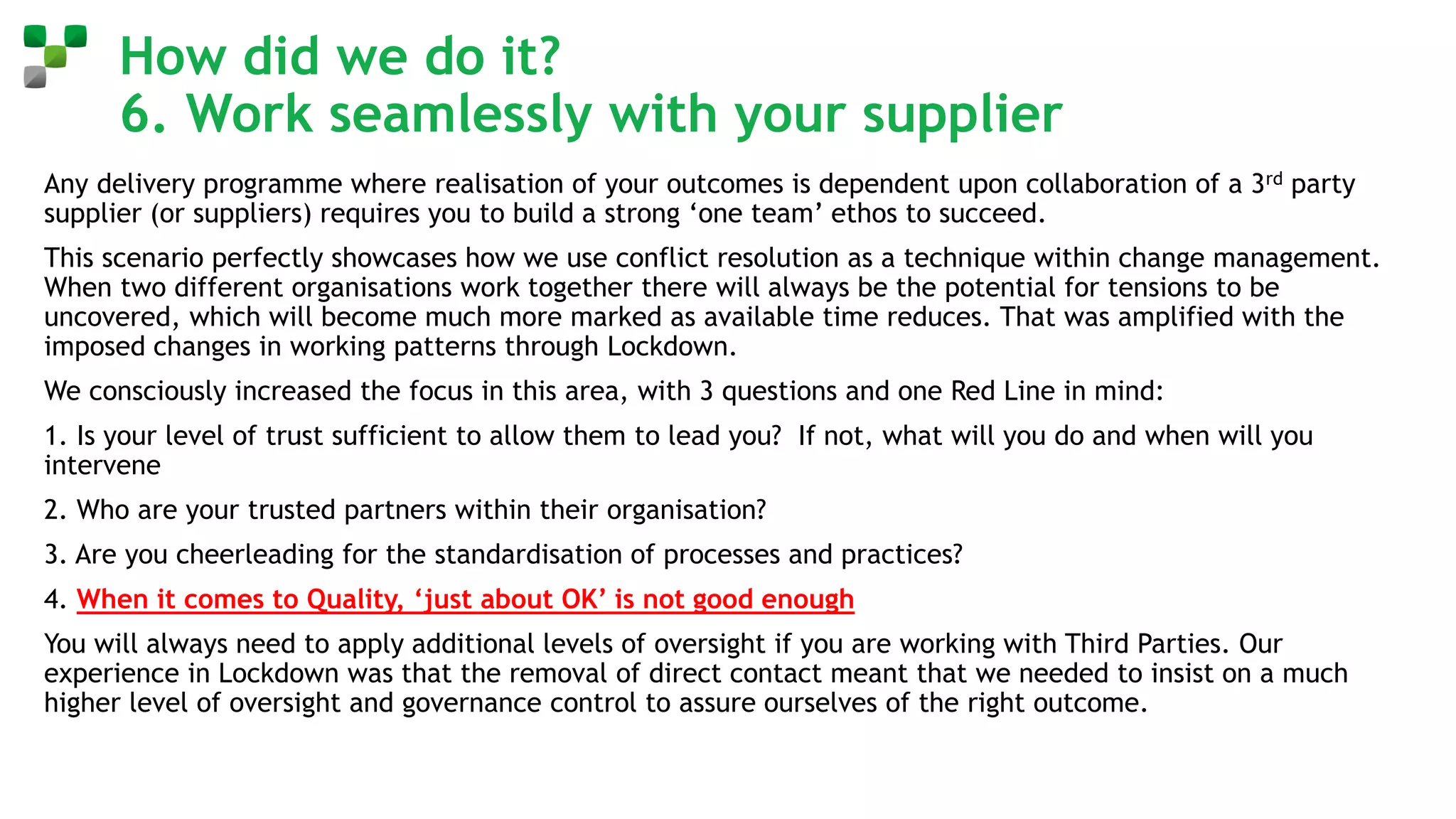

- To succeed, the team focused on customer outcomes, managed plans rigorously, empowered team members, improved communication, gained organizational support, and worked seamlessly with suppliers.

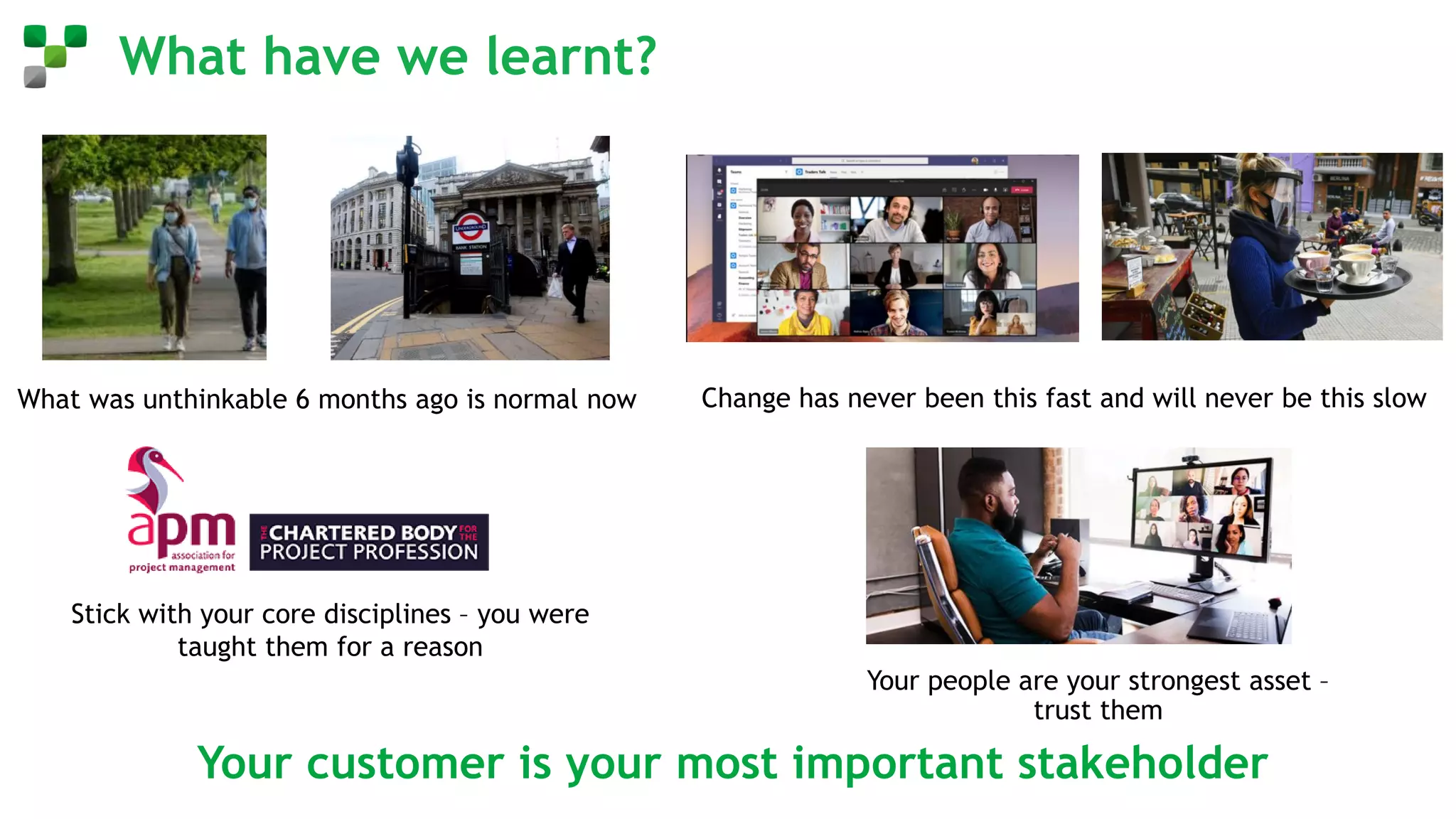

- Lessons included prioritizing customers, adapting to unprecedented change,
