Kanban Overview and
 Experience Report

      David Joyce
     BBC Worldwide

           1
Kanban Overview
Kanban is a transparent, work-limited,
        value pulling system.

                             Eric Willeke - Kanbandev Yahoo! group
                   2
Start with what you do now.
                                       Modify it slightly to implement
                                                     pull

                                     Use a transparent method for
                                   viewing work, and organising the
                                                 team

 Limit WIP and pull work when
     the team has capacity.
                                       Evolve from there by recognising
                                            bottlenecks, waste and
Stop Starting - Start Finishing!
                                            variability that affect
                                                 performance

                                                                  David Anderson
                                   3
Work in Process

        Because we want to deliver new value quickly,
        we want to limit the amount of work that we
        take on at one time

We want to finish items before starting others

                                  4
Pull Work not Push

    There is a queue of work, which goes through
    a number of stages until its done.

                5

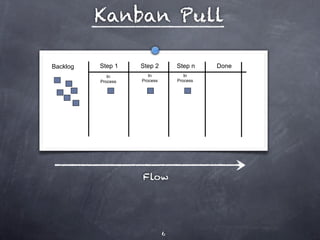

Kanban Pull

Backlog   Step 1    Step 2        Step n    Done
             In        In            In
          Process   Process       Process

                    Flow

                              6
Kanban Pull With Limits

That looks very like a typical Agile Task Board.

However, there is one more important element which
really defines a Kanban system - limits.

 There are two basic limits
 WIP limits and Queue limits

                                  7
WIP Limits

Governs the maximum number of work items
that can be in that state at any instant

                             8
Queues and Queue Limits

A queue distinguishes work that is eligible to
be pulled, from work that is still in process.

The queue allows for slack

                                9
Queues and Limits

Backlog      Step 1            Step 2         …        Step n        Done
          Queue      In                In                     In
                  Process   Queue   Process       Queue    Process
           (3)      (2)

                                              …

                                                  10

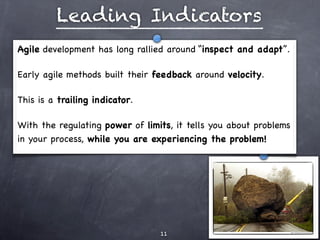

Leading Indicators
Agile development has long rallied around “inspect and adapt”.

Early agile methods built their feedback around velocity.

This is a trailing indicator.

With the regulating power of limits, it tells you about problems
in your process, while you are experiencing the problem!

                                 11

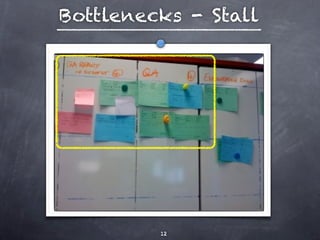

Bottlenecks - Stall

         12

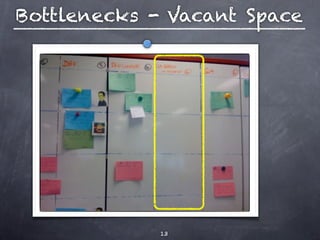

Bottlenecks - Vacant Space

             13
Kanban Workflow

We ensure the right work is done at the right time,
rather than who is doing the work.

                         14
New Kind of Standup

         15
A New Kind of Planning

Planning can be ‘de-coupled’

                               16
Releasing

Releasing can be ‘de-coupled’

                                17

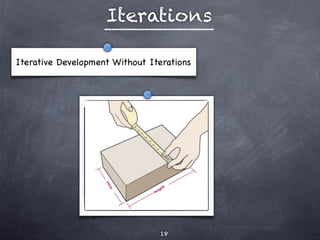

Iterations

Iterative Development Without Iterations

                    tim

                                   gth
                     e

                               len

                                   18
Retrospectives

We have more choice on when and how to reflect and improve

                              19
De-Coupling

     20
Metrics

    Metrics are a tool for everybody
 The team is responsible for its metrics
Metrics allow for continuous improvement
   Red, Amber, Green is not enough.

                           21

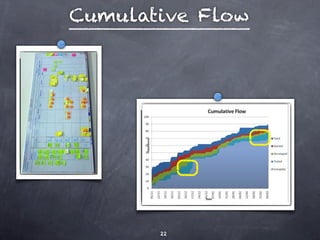

Cumulative Flow

       22
Work Breakdown

       23
Kanban for Everyone

         24

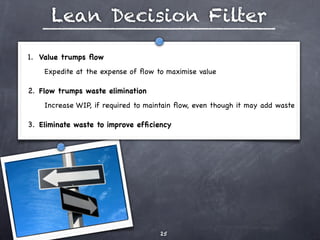

Lean Decision Filter

1. Value trumps flow
    Expedite at the expense of flow to maximise value

2. Flow trumps waste elimination
    Increase WIP, if required to maintain flow, even though it may add waste

3. Eliminate waste to improve efficiency

                                    25
Kanban Usage

      26
Kanban

Summary

         John Seddon - Freedom from Command & Control
   27
Experience Report

              Eric Willeke - Kanbandev Yahoo! group
        28
Kanban began
    in one product
  team in mid 2008

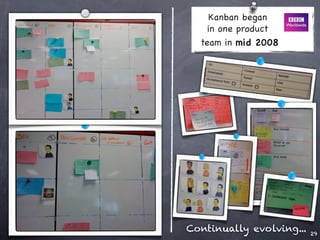

Continually evolving...   29
Kanban began
    in one product
  team in mid 2008

Continually evolving...   30
The Kanban “flu”
 soon spreads to
   other teams

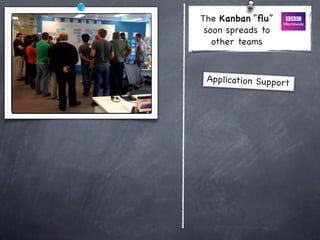

 Application Support
The Kanban “flu”
 soon spreads to
   other teams

 Application Support

         Pro duct Teams

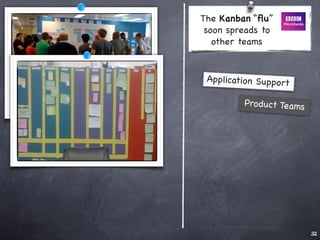

                          32

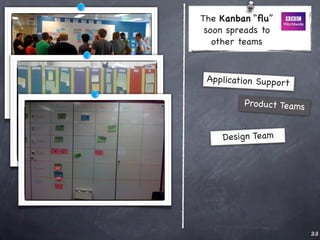

The Kanban “flu”
 soon spreads to
   other teams

 Application Support

         Pro duct Teams

    Design Team

                          33

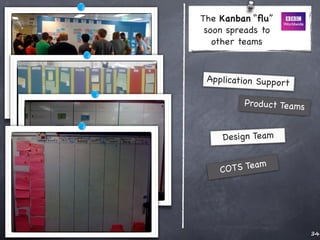

The Kanban “flu”
 soon spreads to
   other teams

 Application Support

         Pro duct Teams

    Design Team

    CO TS Team

                          34

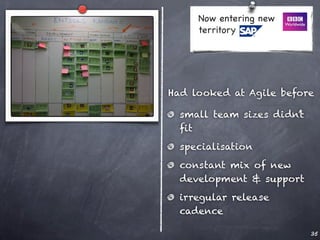

Now entering new
     territory

Had looked at Agile before

  small team sizes didn’t
  fit
  specialisation
  constant mix of new
  development & support
  irregular release
  cadence

                            35

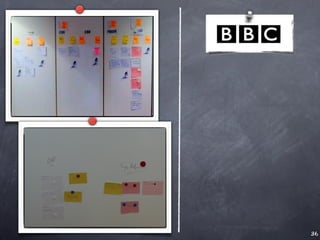

Future Media & Technology!

                             36

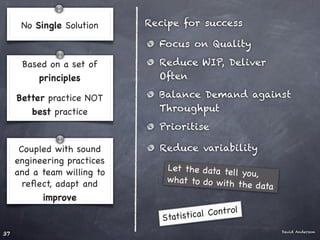

No Single Solution     Recipe for success

                               Focus on Quality

      Based on a set of        Reduce WIP, Deliver
         principles            Often

     Better practice NOT       Balance Demand against
        best practice          Throughput
                               Prioritise

      Coupled with sound       Reduce variability
     engineering practices
     and a team willing to       Let the data tel
                                                  l yo u,
       reflect, adapt and         what to do w ith
                                                   the data
           improve
                                            Control
                                Statistical
                                                              David Anderson
37
Mean reduced from 22 to 14 days (33%)
     Lead Time   50% drop in the spread in variation.
                 Each of the outliers were proved to be special cause.

38                                          Data split at financial year end and in July

Mean reduced from 9 to 3 days (67%)
                        77% drop in the spread in variation.
     Development Time   The major reduction factor has been to limit work in
                        process.

39                                                 Data split at financial year end and in July

Reduction in lead and cycle times, and increase in
                      throughput are not at the expense of quality.
     # Live Defects   Number of live bugs is within statistical control, and
                      seeing a reduction since July.

40                                                          Data split at end and in July

Mean reduced from 25 to 5 days (81%)
                      Large drop in the spread in variation.
     # Days Blocked   The outliers was proved to be special cause, waiting
                      for a 3rd party. # blockers actually increased.

41                                               Data split at financial year end and in July
Upward trend. Rising to almost every working day.
Throughput   Expected as code base is decoupled, work items
             broken into MMFs, and cycle time reduces.
43
Scrum to Kanban
                                                     Data split at end and in July

                    Mean reduced from 10 to 4 days (60%)
 Engineering Time   64% drop in the spread in variation.
Kanban

Summary

         John Seddon - Freedom from Command & Control
Scrumban

 Scrumban is useful for existing Scrum
teams, who are looking to improve their
          scale or capability

                               45

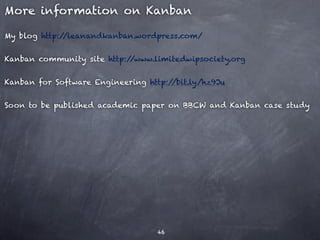

More information on Kanban

My blog http://leanandkanban.wordpress.com/

Kanban community site http://www.limitedwipsociety.org

Kanban for Software Engineering http://bit.ly/hz9Ju

Soon to be published academic paper on BBCW and Kanban case study

                                   46
Thank you

Questions?

        John Seddon - Freedom from Command & Control
