CFD, SPC & KANBAN ON UK GOV IT PROJECTS

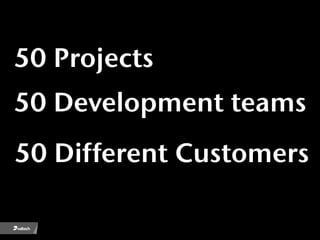

50 Projects
50 Development teams
50 Different Customers
Background

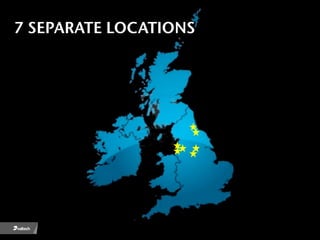

7 SEPARATE LOCATIONS

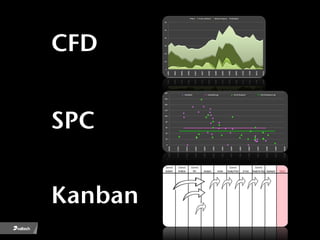

CFD

SPC

Kanban

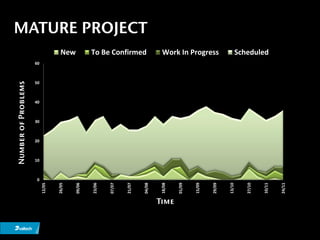

CUMULATIVE FLOW DIAGRAMS
Number of Problems

                    50

               0
                         100
                               150
                                     200
                                           250
       12/05

       26/05
                                                 New

       09/06

       23/06

       07/07

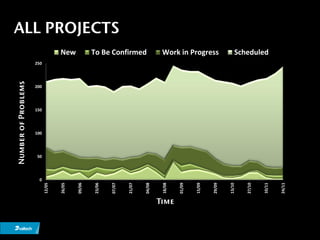

                                                                    ALL PROJECTS

       21/07
                                                 To Be Confirmed

       04/08

       18/08

Time
       01/09

       15/09

       29/09
                                                 Work in Progress

       13/10

       27/10
                                                 Scheduled

       10/11

       24/11
Number of Problems

                   10
                        20
                             30
                                  40
                                       50
                                            60

               0
       12/05

       26/05
                                                 New

       09/06

       23/06

       07/07

       21/07
                                                 To Be Confirmed
                                                                    MATURE PROJECT

       04/08

       18/08

Time
       01/09

       15/09

       29/09
                                                 Work In Progress

       13/10

       27/10

       10/11
                                                 Scheduled

       24/11
Number of Problems

                   10
                        20
                             30
                                  40
                                       50
                                            60

               0
       12/05

       26/05
                                                 New

       09/06

       23/06

       07/07

       21/07
                                                 To Be Confrimed

       04/08

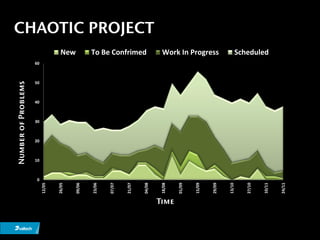

                                                                    CHAOTIC PROJECT

       18/08

Time
       01/09

       15/09

       29/09
                                                 Work In Progress

       13/10

       27/10

       10/11
                                                 Scheduled

       24/11

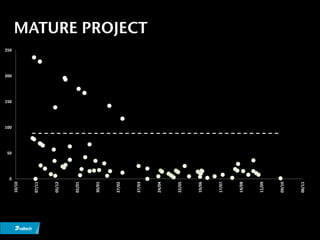

STATISTICAL PROCESS CONTROL CHARTS
50

        0
                 100
                       150
                             200
                                   250
                                         300
12/09

10/10

07/11

05/12

02/01

30/01

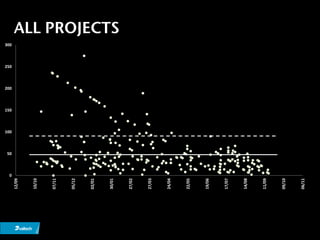

                                               ALL PROJECTS

27/02

27/03

24/04

22/05

19/06

17/07

14/08

11/09

09/10

06/11

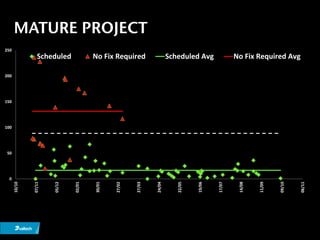

MATURE PROJECT
250
                Scheduled             No Fix Required                 Scheduled Avg              No Fix Required Avg

200

150

100

 50

  0

                                                                                                  14/08
      10/10

              07/11

                      05/12

                              02/01

                                      30/01

                                              27/02

                                                      27/03

                                                              24/04

                                                                         22/05

                                                                                 19/06

                                                                                         17/07

                                                                                                          11/09

                                                                                                                  09/10

                                                                                                                          06/11
MATURE PROJECT
250
                Scheduled             No Fix Required                 Scheduled Avg              No Fix Required Avg

200

150

100

 50

  0

                                                                                                  14/08
      10/10

              07/11

                      05/12

                              02/01

                                      30/01

                                              27/02

                                                      27/03

                                                              24/04

                                                                         22/05

                                                                                 19/06

                                                                                         17/07

                                                                                                          11/09

                                                                                                                  09/10

                                                                                                                          06/11

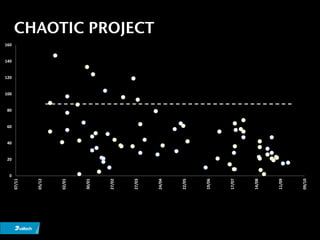

CHAOTIC PROJECT
160
              Scheduled               No Fix Required              Scheduled Avg          No Fix Required Avg
140

120

100

 80

 60

 40

 20

  0
              05/12
      07/11

                      02/01

                              30/01

                                           27/02

                                                   27/03

                                                           24/04

                                                                       22/05

                                                                               19/06

                                                                                       17/07

                                                                                               14/08

                                                                                                       11/09

                                                                                                                09/10
CHAOTIC PROJECT
160
              Scheduled               No Fix Required              Scheduled Avg          No Fix Required Avg
140

120

100

 80

 60

 40

 20

  0
              05/12
      07/11

                      02/01

                              30/01

                                           27/02

                                                   27/03

                                                           24/04

                                                                       22/05

                                                                               19/06

                                                                                       17/07

                                                                                               14/08

                                                                                                       11/09

                                                                                                                09/10

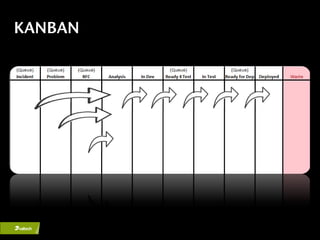

KANBAN

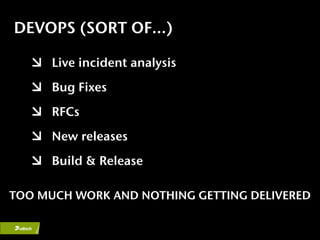

DEVOPS (SORT OF…)

      Live incident analysis
      Bug Fixes
      RFCs
      New releases
      Build & Release

TOO MUCH WORK AND NOTHING GETTING DELIVERED
CUSTOMER COULDN’T PRIORITISE
Order, don’t prioritise
COST OF DELAY

e.g. Additional work caused by workaround
COST OF DELAY

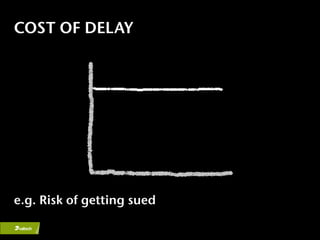

e.g. Risk of getting sued
COST OF DELAY

e.g. Legislative date
KANBAN

VISIBLE IMPROVEMENT
180
                      Scheduled            Scheduled avg            No Fix Required            No Fix Required avg
160

140

120

100

80

60

40

20

 0
      10/10

              07/11

                           05/12

                                   02/01

                                            30/01

                                                    27/02

                                                            27/03

                                                                     24/04

                                                                             22/05

                                                                                      19/06

                                                                                              17/07

                                                                                                      14/08

                                                                                                              11/09

                                                                                                                      09/10
