How service management best practice can be applied beyond IT

                      Reinoud Martens CERN GS/SMS
                                                    Maienfeld 15/11/2012

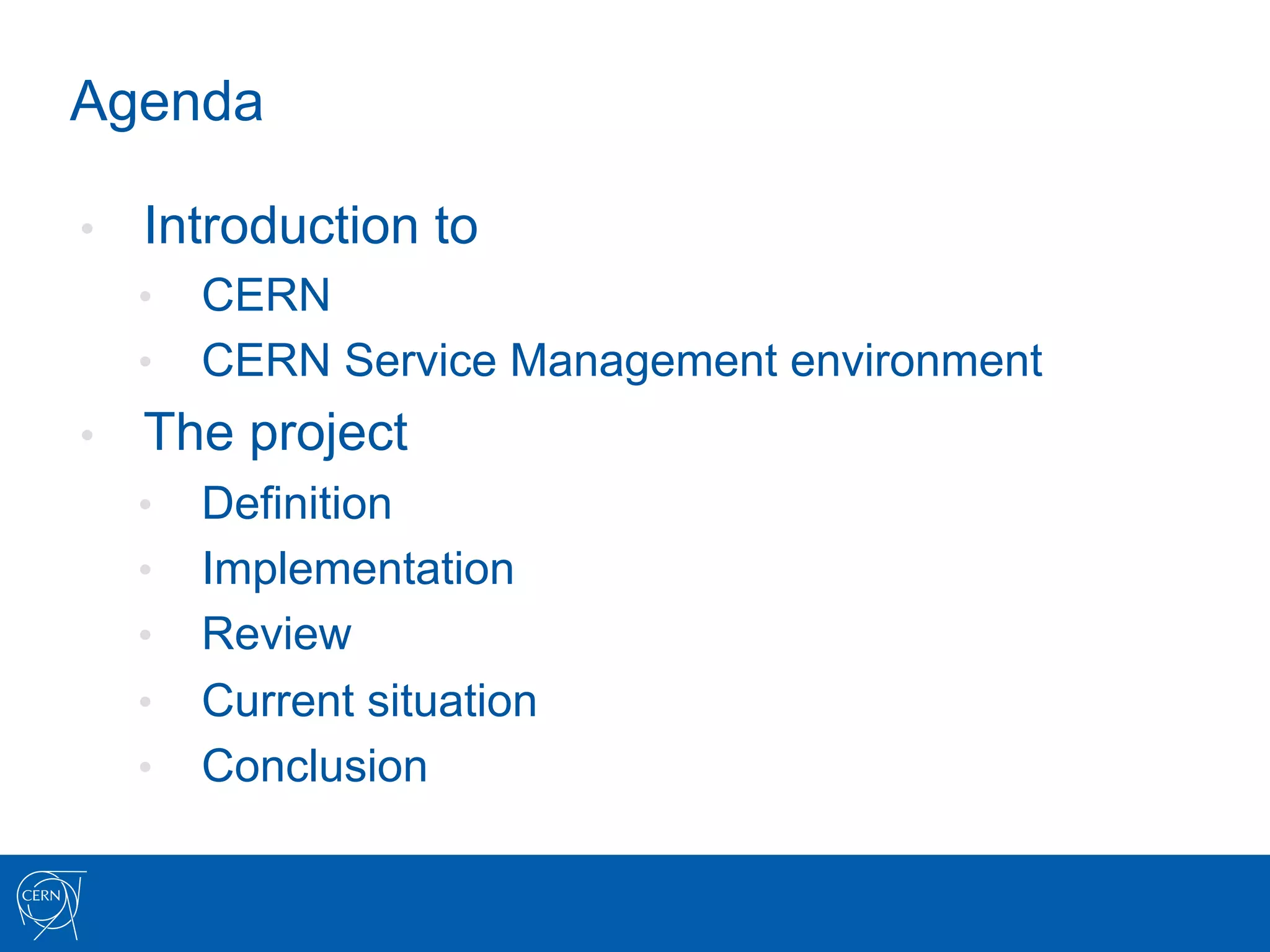

Agenda

•    Introduction to
     •  CERN
     •  CERN Service Management environment
•    The project
     •    Definition
     •    Implementation
     •    Review
     •    Current situation
     •    Conclusion
About CERN
•    World’s largest particle physics centre
•    World’s largest scientific instrument
•    1954 - Europe’s first joint venture
•    2012 - 20 member states
           - 2 associate members & 7 observers
•    1.2 bn CHF budget
•    ~ 2300 staff
•    >1000 fellows, students                   LHC
      & project associates
•    >10000 visiting scientists
       over 100 nationalities
       (half of world’s
        particle physicists)

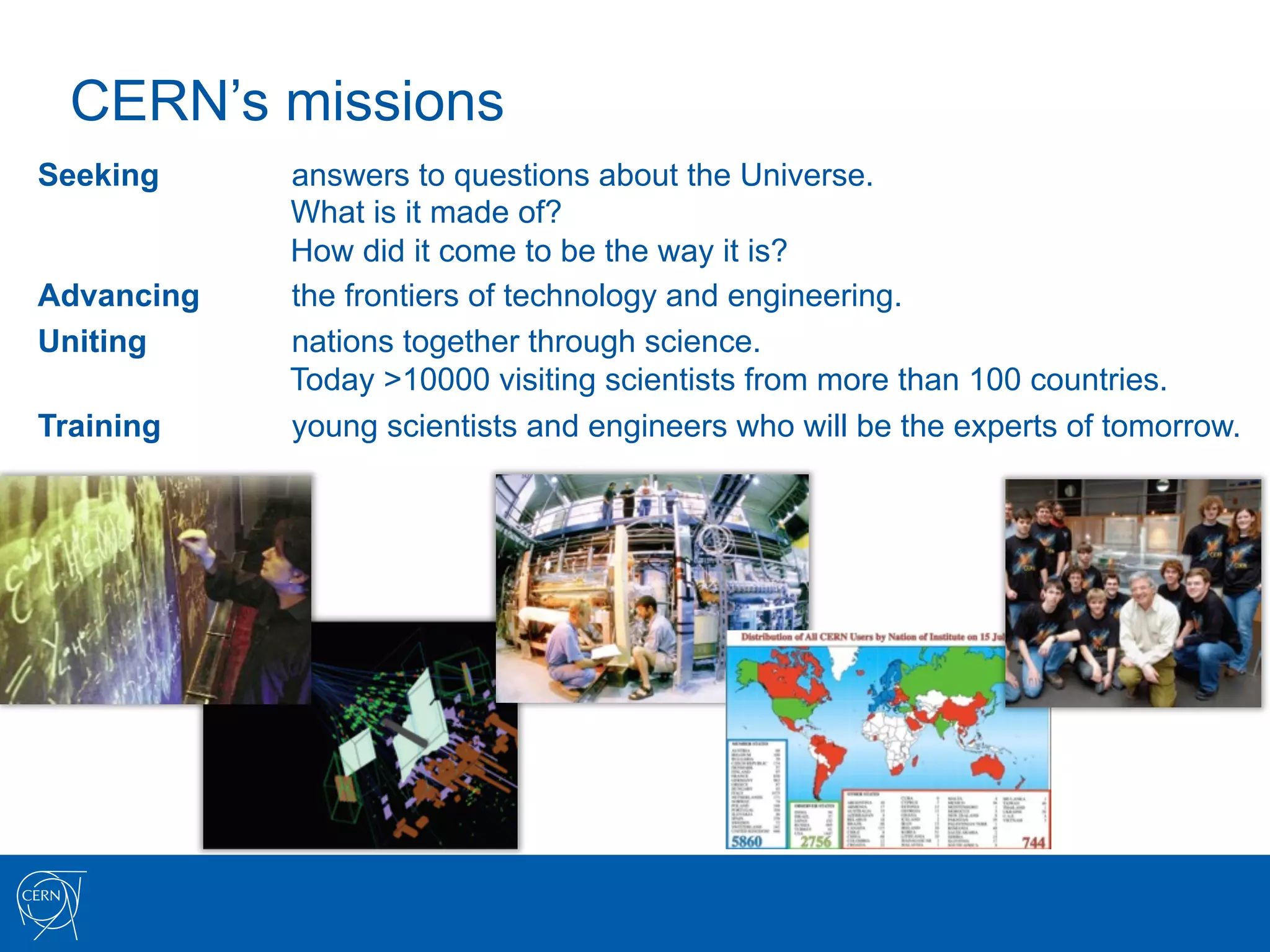

CERN’s missions
Seeking     answers to questions about the Universe.
            What is it made of?
            How did it come to be the way it is?
Advancing   the frontiers of technology and engineering.
Uniting     nations together through science.
            Today >10000 visiting scientists from more than 100 countries.
Training    young scientists and engineers who will be the experts of tomorrow.
CERN : Facts & Fiction
•    The World Wide Web was invented at CERN in 1989
     by the British scientist Tim Berners-Lee.
•    Some of the spin-offs: Improving cancer therapy technology,
     medical and industrial imaging, radiation processing, electronics,
     measuring instruments, new manufacturing processes and
     materials,..
•    CERN does unfortunately not own an X-33 aircraft as it was
     suggested in Dan Brown’s book “Angels and Demons”.
The Physics Challenge
      The Large Hadron Collider (LHC) helps to find answers to fundamental
      questions

•     The LHC, allows us to look at microscopic big bangs to
      understand the fundamental laws of nature

•     Which questions:
      •         Why do particles have mass?
           •     Newton could not explain it
                 and neither can we…
      •         What is 96% of the Universe made of?
           •     We only ‘know’ 4% of it!
      •         Why is there no antimatter left in the Universe?
           •     Nature should be symmetrical
      •         What was matter like during the first second of the Universe’s life, right
                after the "Big Bang"?
           •     A journey towards the beginning of the Universe will gives us deeper insight
The Physics Challenge

The universe is a tough nut to crack.

By smashing pieces of matter together, creating energies and
temperatures not seen since the universe's earliest moments, the LHC
could reveal the particles and forces that wrote the rules for everything that
followed. It could help answer one of the most basic questions for any
being in our universe: What is this place?
The particle physicist’s toolbox

                                      collisions

                                      events
 Particle accelerator   Experiments

                                                      Data

                                                   Analysis
The particle physicist’s toolbox

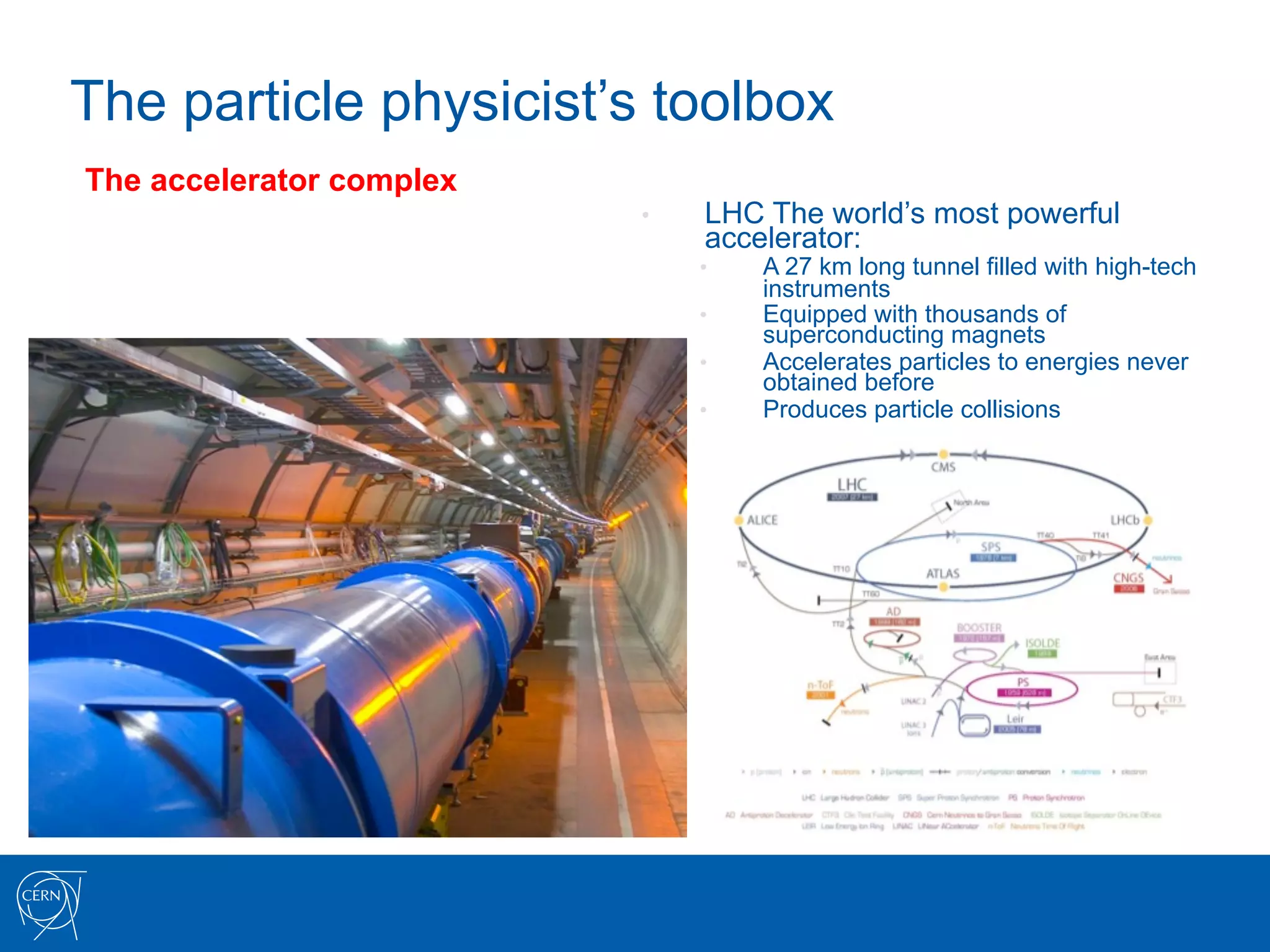

The accelerator complex
                          •    LHC The world’s most powerful
                               accelerator:
                               •    A 27 km long tunnel filled with high-tech
                                    instruments
                               •    Equipped with thousands of
                                    superconducting magnets
                               •    Accelerates particles to energies never
                                    obtained before
                               •    Produces particle collisions
The particle physicist’s toolbox

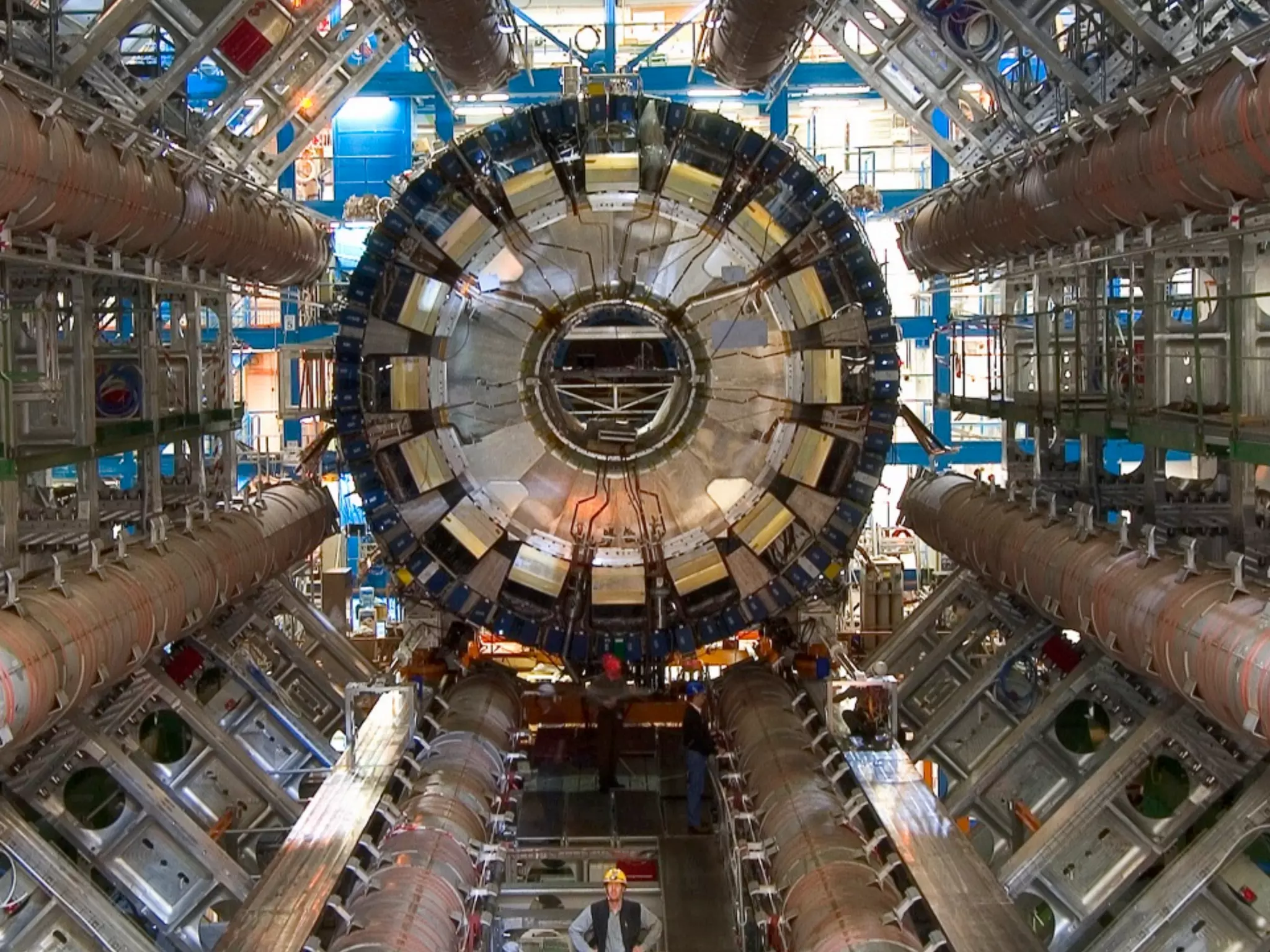

4 Experiments : Very large sophisticated detectors

           §  Atlas experiment during construction : 7000 tons
               §  Hundred million measurement channels
               §  Data acquisition systems treating Petabytes per second
The particle physicist’s toolbox

•    Computing infrastructure to
     store, distribute and analyse the
     data
     •    A Computing Grid linking ~200
          computer centres around the globe
     •    Sufficient computing power and
          storage to handle 15 Petabytes per
          year, making them available to
          thousands of physicists for analysis
CERN, a place of extremes

The fastest racetrack on the planet…

                      Trillions
  of
  protons
  race
  around
  the
  27km
  ring
  in

                       opposite
  direc7ons
  over
  11,000
  7mes
  a
  second,

                travelling
  at
  99.999999991
  per
  cent
  the
  speed
  of
  light.

CERN, a place of extremes

The emptiest space in the solar system…

               To
  accelerate
  protons
  to
  almost
  the
  speed
  of
  light
  requires
  a

                vacuum
  as
  empty
  as
  interplanetary
  space.
  There
  is
  10
  7mes

                      more
  atmosphere
  on
  the
  moon
  than
  there
  is
  in
  the
  LHC.

CERN, a place of extremes

One of the coldest places in the universe..

                 With
  an
  opera7ng
  temperature
  of
  about
  -­‐271
  degrees

                               Celsius,
  just
  1.9
  degrees
  above
  absolute
  zero,

                                              the
  LHC
  is
  colder
  than
  outer
  space.

CERN, a place of extremes

 The hottest spots in the galaxy…

                  When
  two
  beams
  of
  protons
  collide,
  they
  generate

                   temperatures
  1000
  million
  7mes
  hoIer
  than
  the

                            heart
  of
  the
  sun,
  but
  in
  a
  minuscule
  space.

CERN, a place of extremes
The biggest most sophisticated detectors
ever built…
    ALICE

            To
  sample
  and
  record
  the
  debris
  from
  up
  to
  600
  million
  proton

                     collisions
  per
  second,
  scien7sts
  are
  building
  gargantuan

                       devices
  that
  measure
  par7cles
  with
  micron
  precision.

CERN, a place of extremes

One of the most extensive computer
      systems in the world…

      To
  analyze
  the
  data,
  tens
  of
  thousands
  of
  computers
  around
  the
  world

      are
  being
  harnessed
  in
  the
  Grid.
  The
  laboratory
  that
  gave
  the
  world

      the
  web,
  is
  now
  taking
  distributed
  compu7ng
  a
  big
  step
  further.

CERN latest events

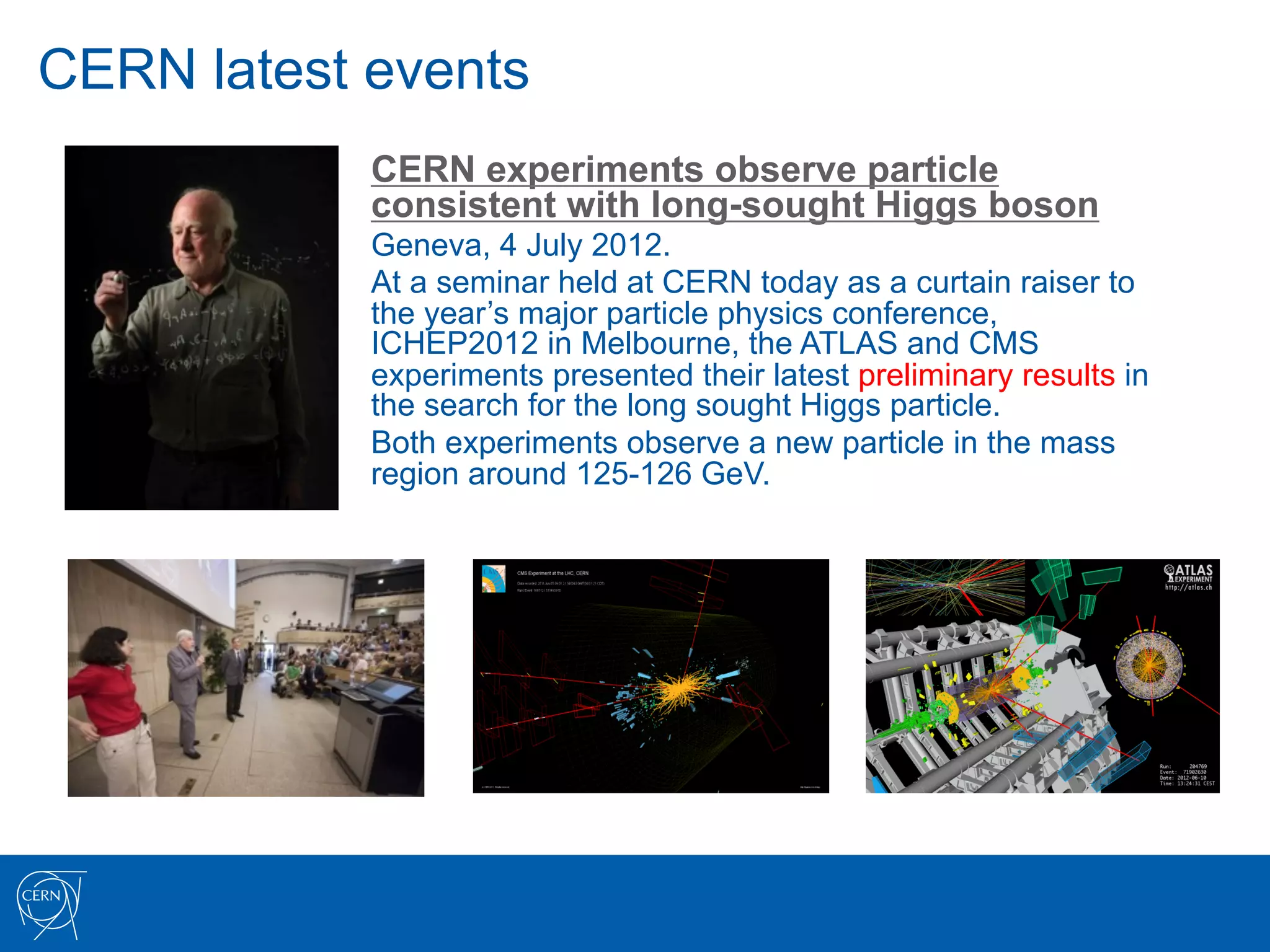

            CERN experiments observe particle
            consistent with long-sought Higgs boson
            Geneva, 4 July 2012.
            At a seminar held at CERN today as a curtain raiser to
            the year’s major particle physics conference,
            ICHEP2012 in Melbourne, the ATLAS and CMS
            experiments presented their latest preliminary results in
            the search for the long sought Higgs particle.
            Both experiments observe a new particle in the mass
            region around 125-126 GeV.

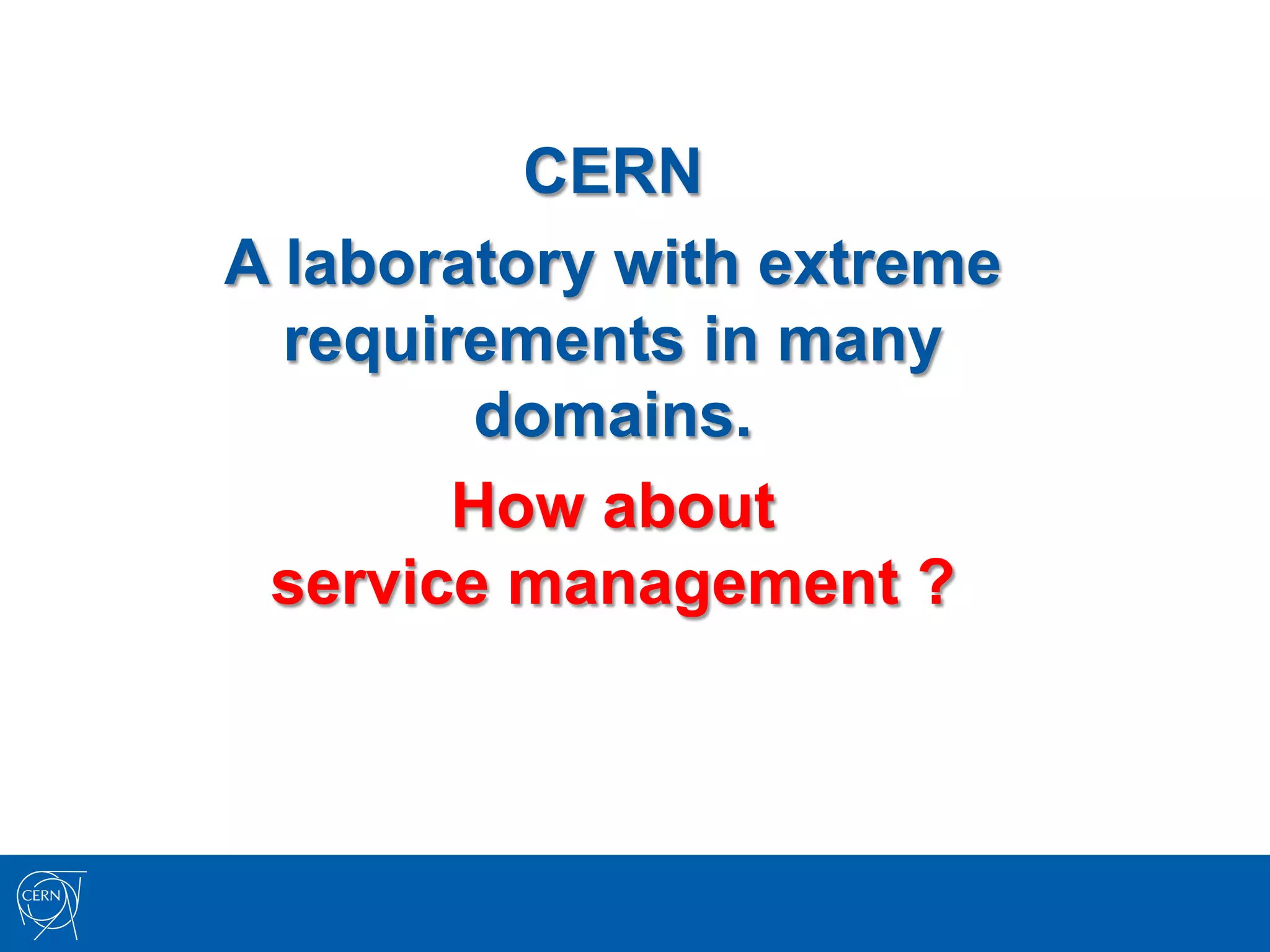

CERN
A laboratory with extreme
  requirements in many
        domains.
        How about
 service management ?

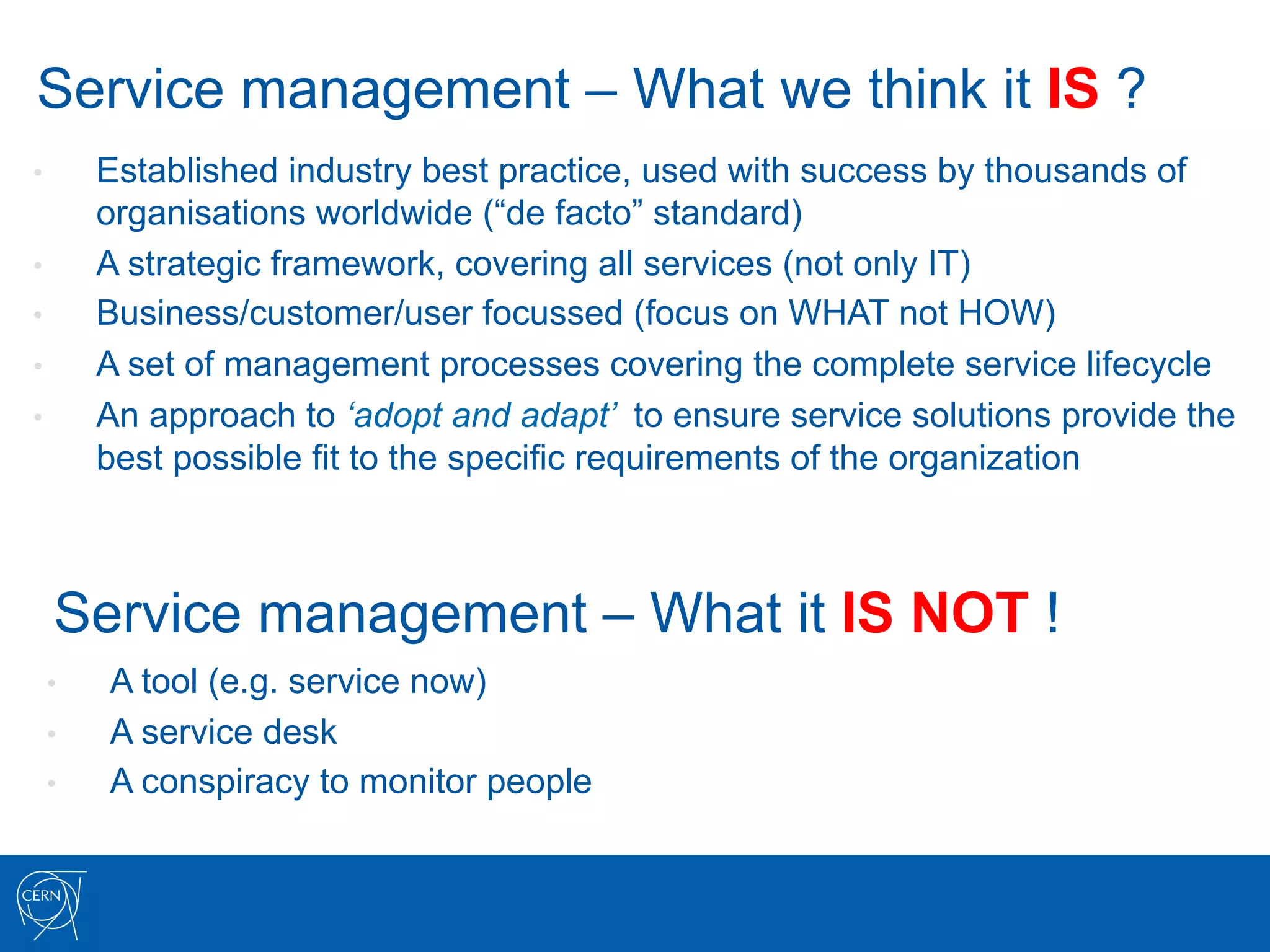

Service management – What we think it IS ?
•     Established industry best practice, used with success by thousands of
      organisations worldwide (“de facto” standard)
•     A strategic framework, covering all services (not only IT)
•     Business/customer/user focussed (focus on WHAT not HOW)
•     A set of management processes covering the complete service lifecycle
•     An approach to ‘adopt and adapt’ to ensure service solutions provide the
      best possible fit to the specific requirements of the organization

     Service management – What it IS NOT !
 •     A tool (e.g. service now)
 •     A service desk
 •     A conspiracy to monitor people
CERN Service Management Environment
     The Particle Physics community is bringing the world together …

•    Our users!
     •    engineers
     •    physicists
     •    technicians
     •    administrators
     •    computer scientists
     •    craftspeople
     •    mechanics
     •    support personnel
     •    …
CERN Service Management Environment
 The freedom of science…

•     … is providing us every type of user!
CERN Service Management Environment
Services
  we
  are
  covering
  (1)
  :

   §  General IT services
   §  Physics specific IT services
       (including Grid)
   §  Medical Services & Fire Protection
       Services
   §  Civil Engineering & Facility
       Management
   §  Registration, Access & Safety
       Services
   §  Alarm System Services
CERN Service Management Environment
Services
  we
  are
  covering
  (2)
  :

 §  Visits & Outreach
     Services
 §  Material & Storage Services
 §  Mail & Shipping Services
 §  Library & Archive Services
 §  Housing Services
 §  HR, Finance & Legal Services
CERN Service Management Environment

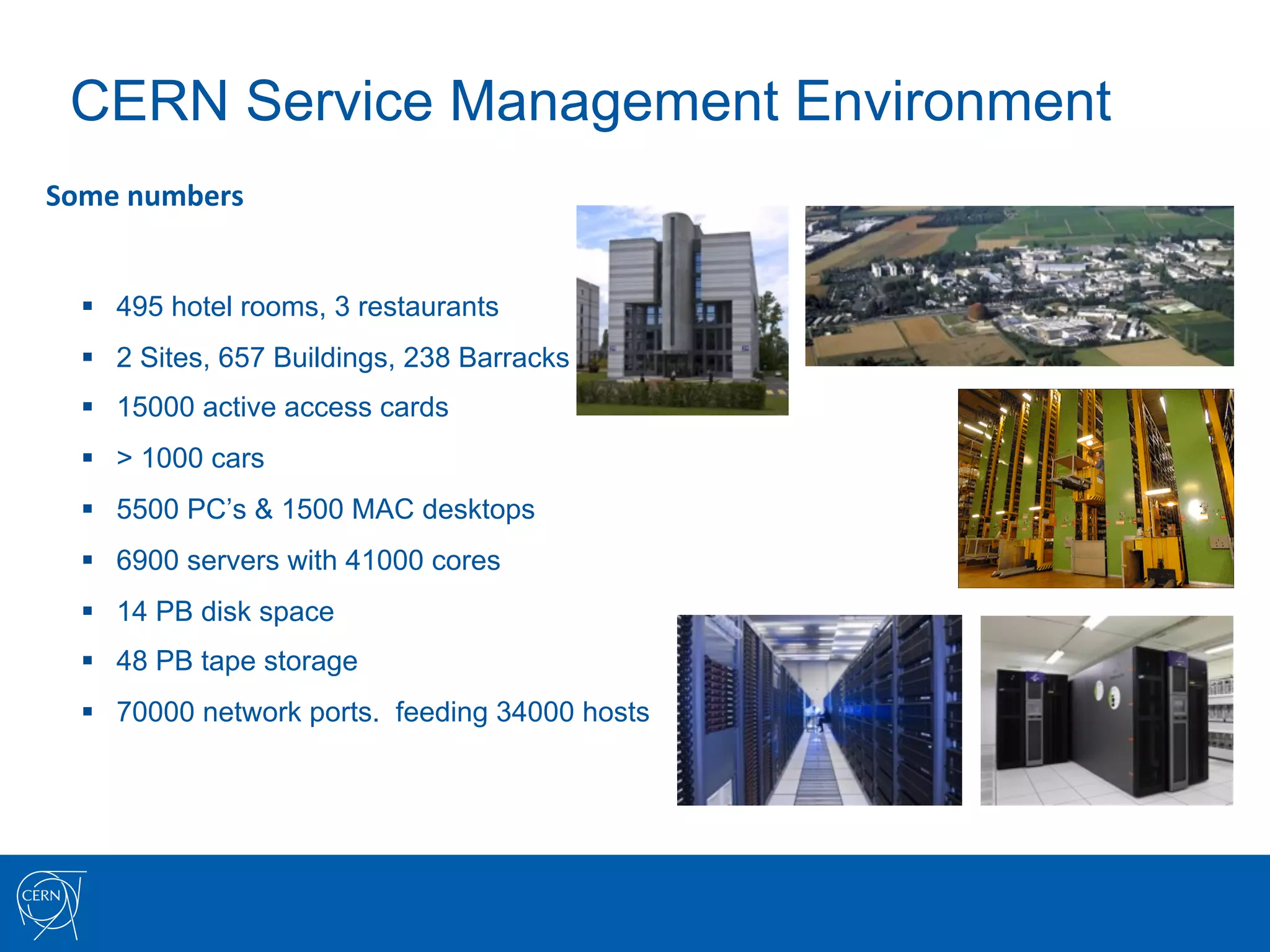

Some
  numbers

   §  495 hotel rooms, 3 restaurants
   §  2 Sites, 657 Buildings, 238 Barracks
   §  15000 active access cards
   §  > 1000 cars
   §  5500 PC’s & 1500 MAC desktops
   §  6900 servers with 41000 cores
   §  14 PB disk space
   §  48 PB tape storage
   §  70000 network ports. feeding 34000 hosts

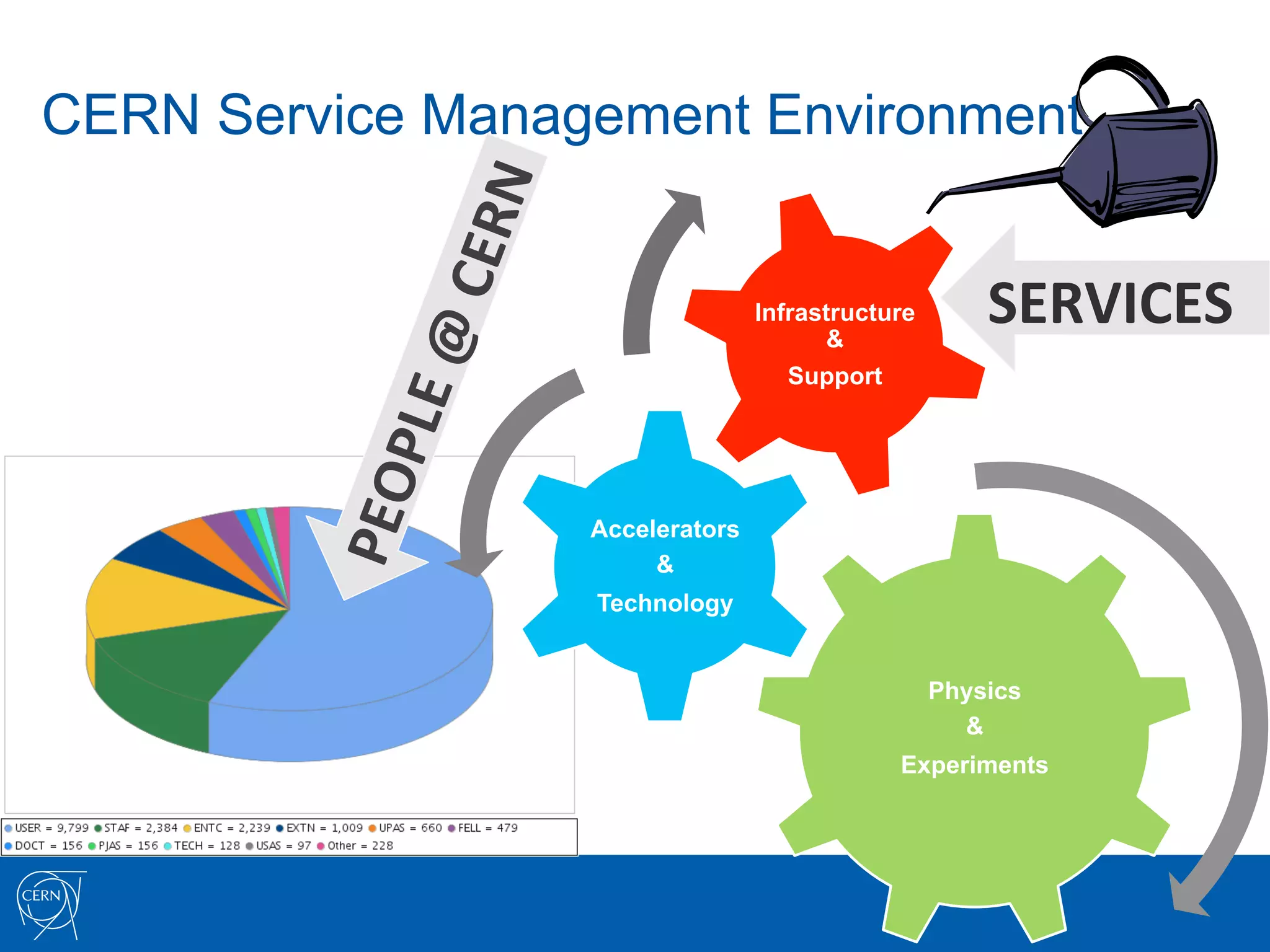

CERN Service Management Environment

                                 Infrastructure
                                       &
                                                      SERVICES

                                    Support

                  Accelerators
                       &
                  Technology

                                                  Physics
                                                    &
                                             Experiments

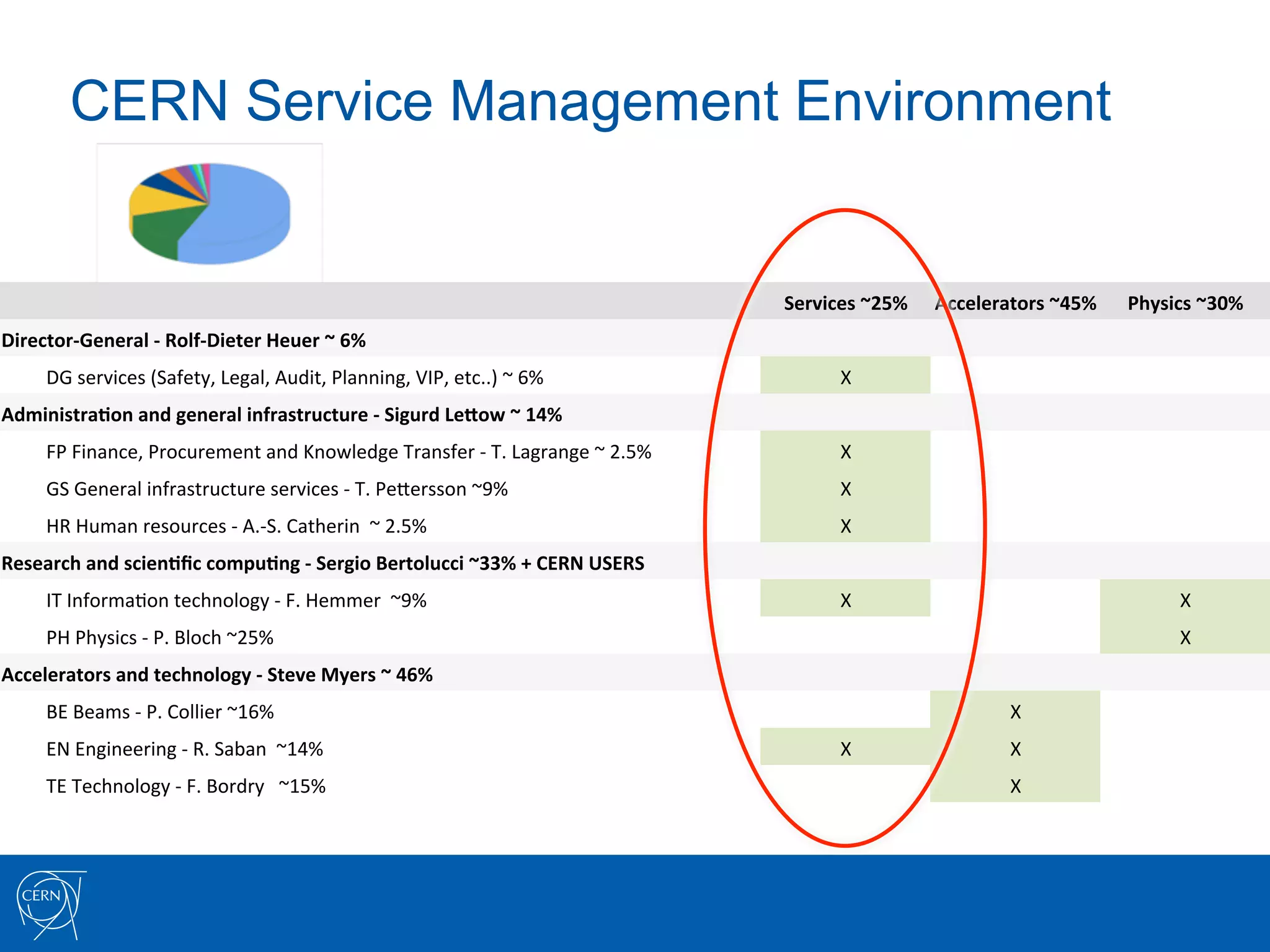

CERN Service Management Environment

                                                                                                    Services
  ~25%
     Accelerators
  ~45%
     Physics
  ~30%

Director-­‐General
  -­‐
  Rolf-­‐Dieter
  Heuer
  ~
  6%

           DG
  services
  (Safety,
  Legal,
  Audit,
  Planning,
  VIP,
  etc..)
  ~
  6%
                        X

AdministraNon
  and
  general
  infrastructure
  -­‐
  Sigurd
  LePow
  ~
  14%

           FP
  Finance,
  Procurement
  and
  Knowledge
  Transfer
  -­‐
  T.
  Lagrange
  ~
  2.5%
             X

           GS
  General
  infrastructure
  services
  -­‐
  T.
  PeIersson
  ~9%
                                    X

           HR
  Human
  resources
  -­‐
  A.-­‐S.
  Catherin

  ~
  2.5%
                                         X

Research
  and
  scienNfic
  compuNng
  -­‐
  Sergio
  Bertolucci
  ~33%
  +
  CERN
  USERS

           IT
  Informa7on
  technology
  -­‐
  F.
  Hemmer

  ~9%
                                                X
                                               X

           PH
  Physics
  -­‐
  P.
  Bloch
  ~25%
                                                                                                                       X

Accelerators
  and
  technology
  -­‐
  Steve
  Myers
  ~
  46%

           BE
  Beams
  -­‐
  P.
  Collier
  ~16%
                                                                                              X

           EN
  Engineering
  -­‐
  R.
  Saban

  ~14%
                                                             X
                      X

           TE
  Technology
  -­‐
  F.
  Bordry

  ~15%
                                                                                  X

CERN Service Management Environment

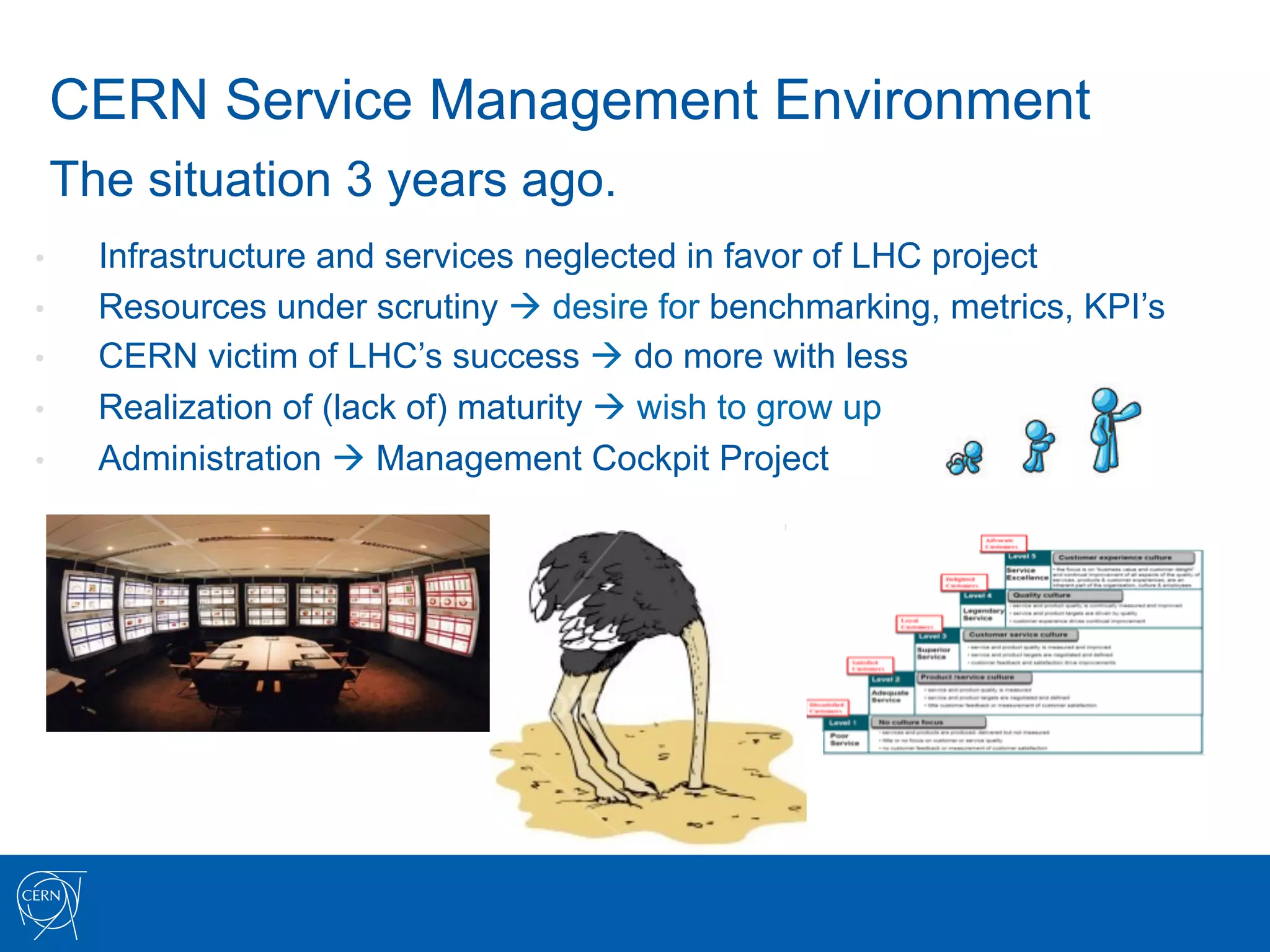

     The situation 3 years ago.
•      Infrastructure and services neglected in favor of LHC project
•      Resources under scrutiny à desire for benchmarking, metrics, KPI’s
•      CERN victim of LHC’s success à do more with less
•      Realization of (lack of) maturity à wish to grow up
•      Administration à Management Cockpit Project

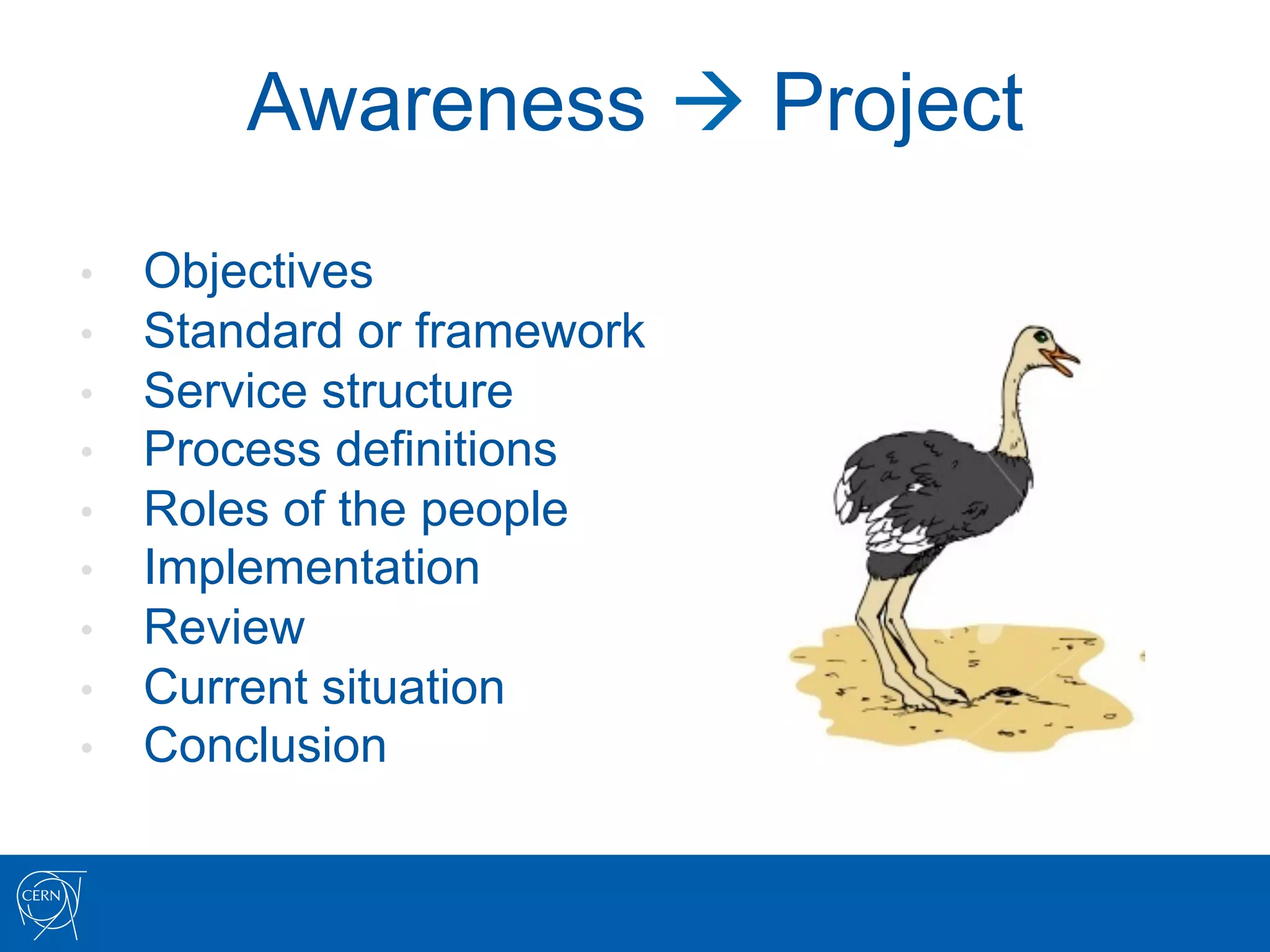

Awareness à Project
•    Objectives
•    Standard or framework
•    Service structure

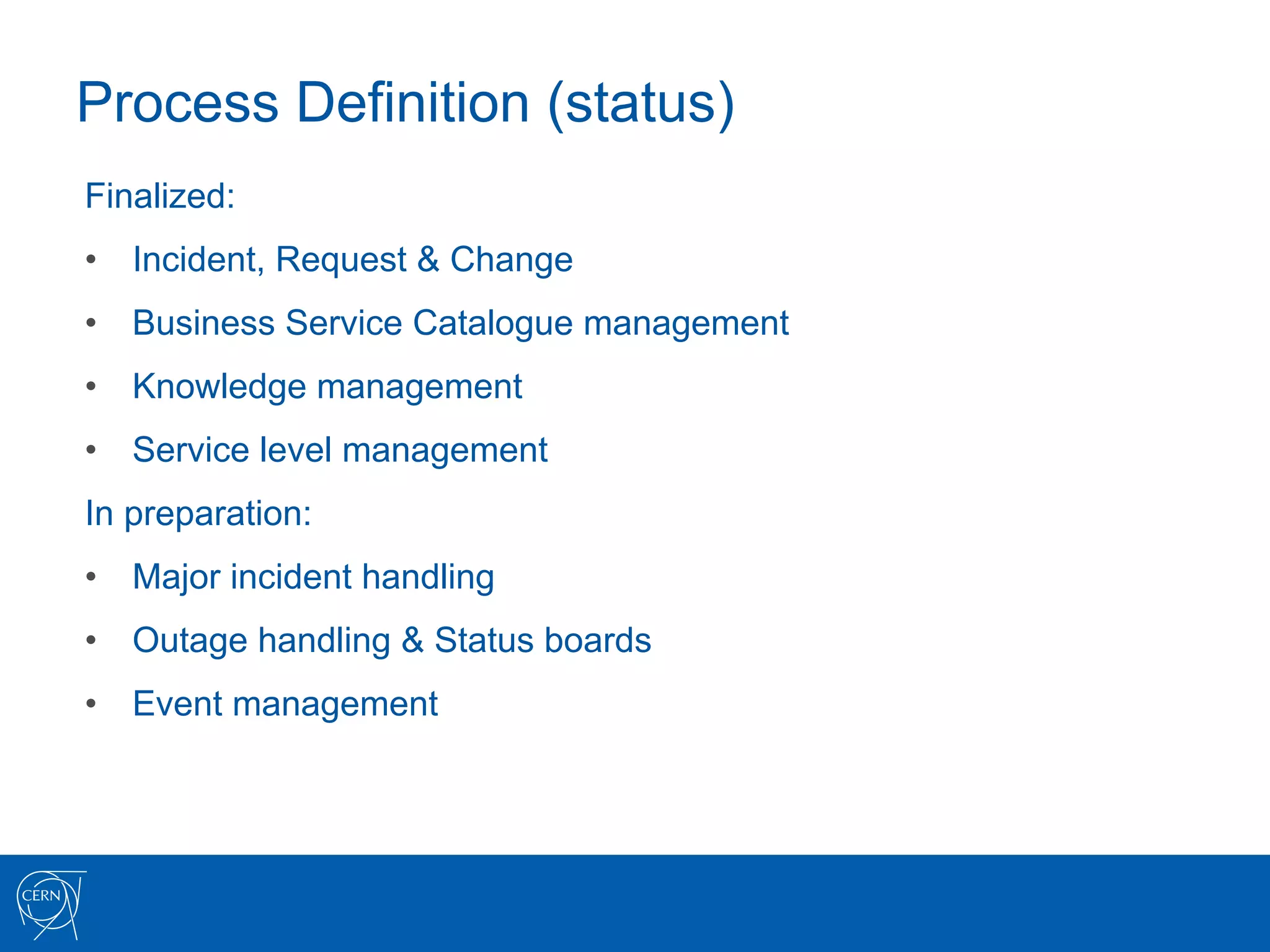

•    Process definitions
•    Roles of the people
•    Implementation

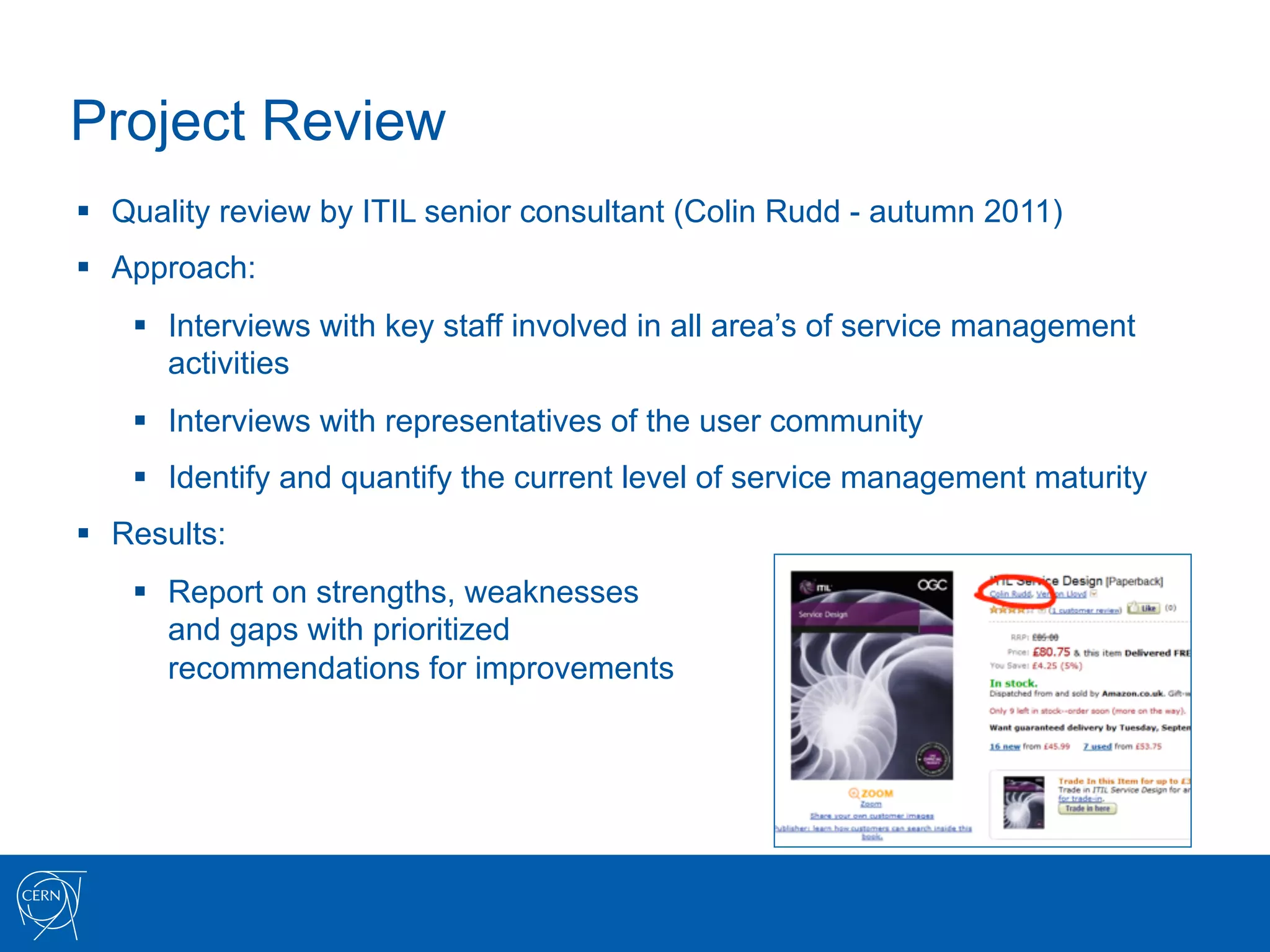

•    Review
•    Current situation
•    Conclusion

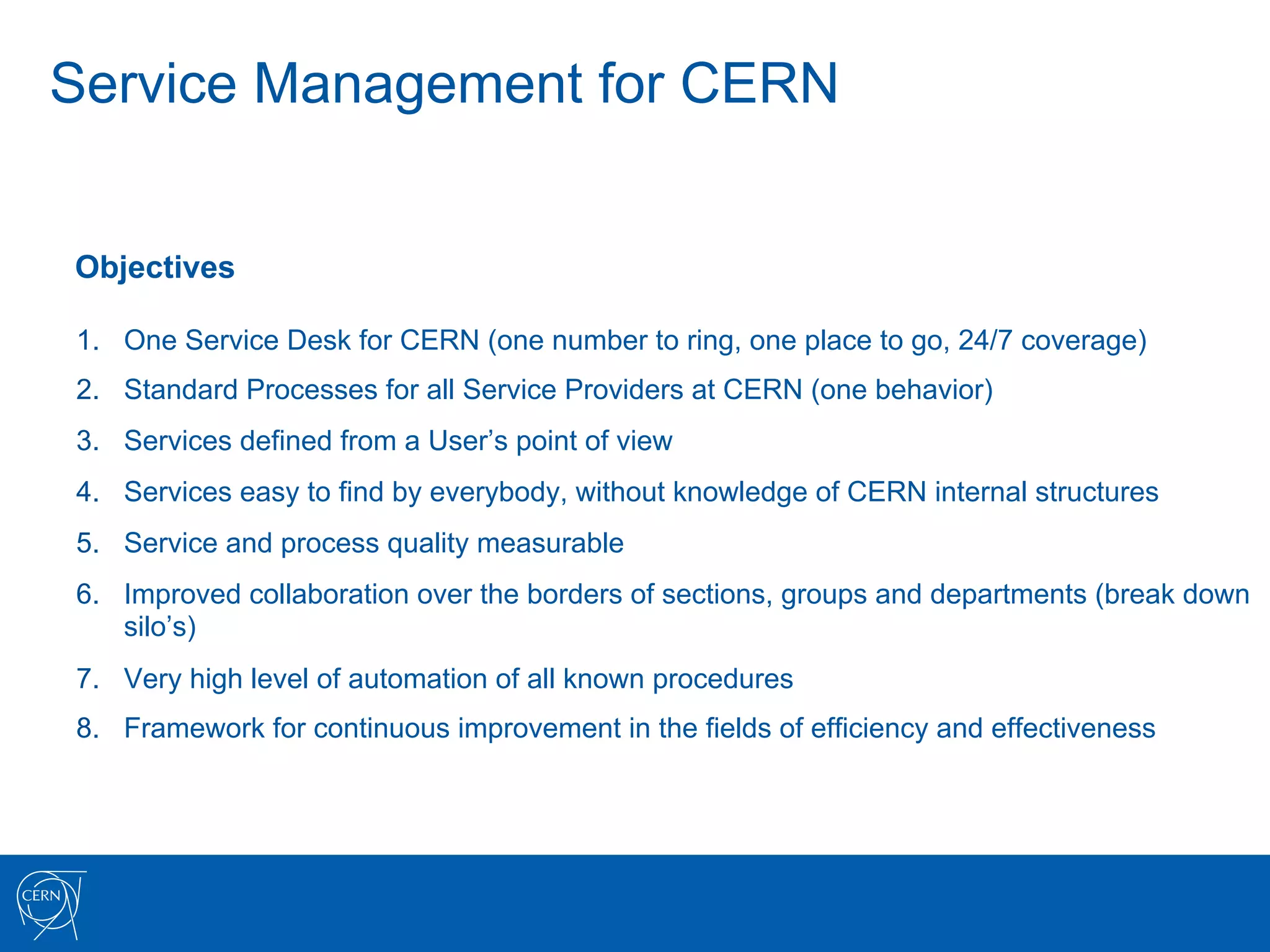

Service Management for CERN

Objectives

1.  One Service Desk for CERN (one number to ring, one place to go, 24/7 coverage)
2.  Standard Processes for all Service Providers at CERN (one behavior)
3.  Services defined from a User’s point of view
4.  Services easy to find by everybody, without knowledge of CERN internal structures
5.  Service and process quality measurable
6.  Improved collaboration over the borders of sections, groups and departments (break down
    silo’s)

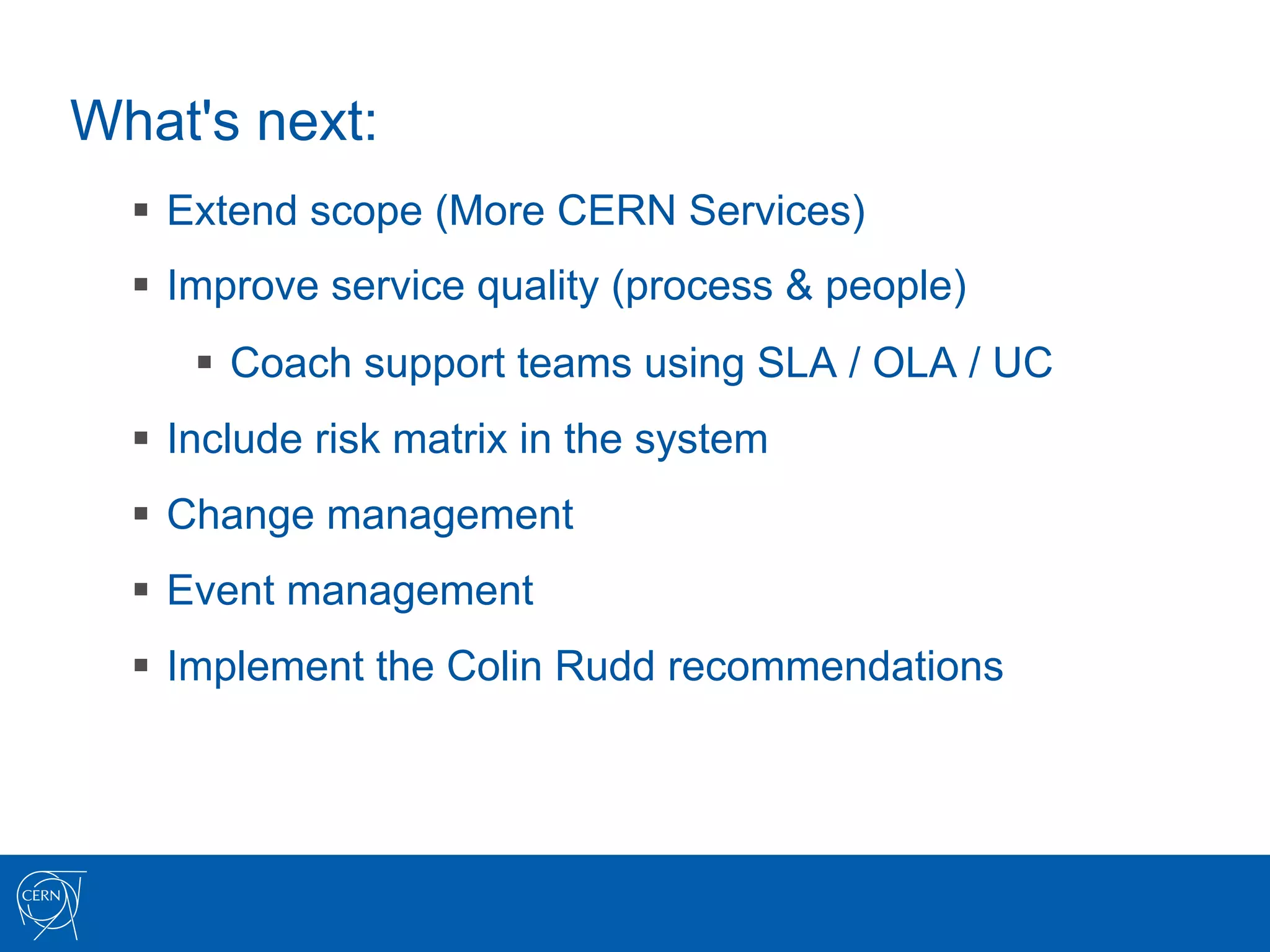

7.  Very high level of automation of all known procedures
8.  Framework for continuous improvement in the fields of efficiency and effectiveness
Which Standard / Framework ?

                                               ISO
   Different best practice for IT and NON IT
     services doesn’t look a brilliant idea

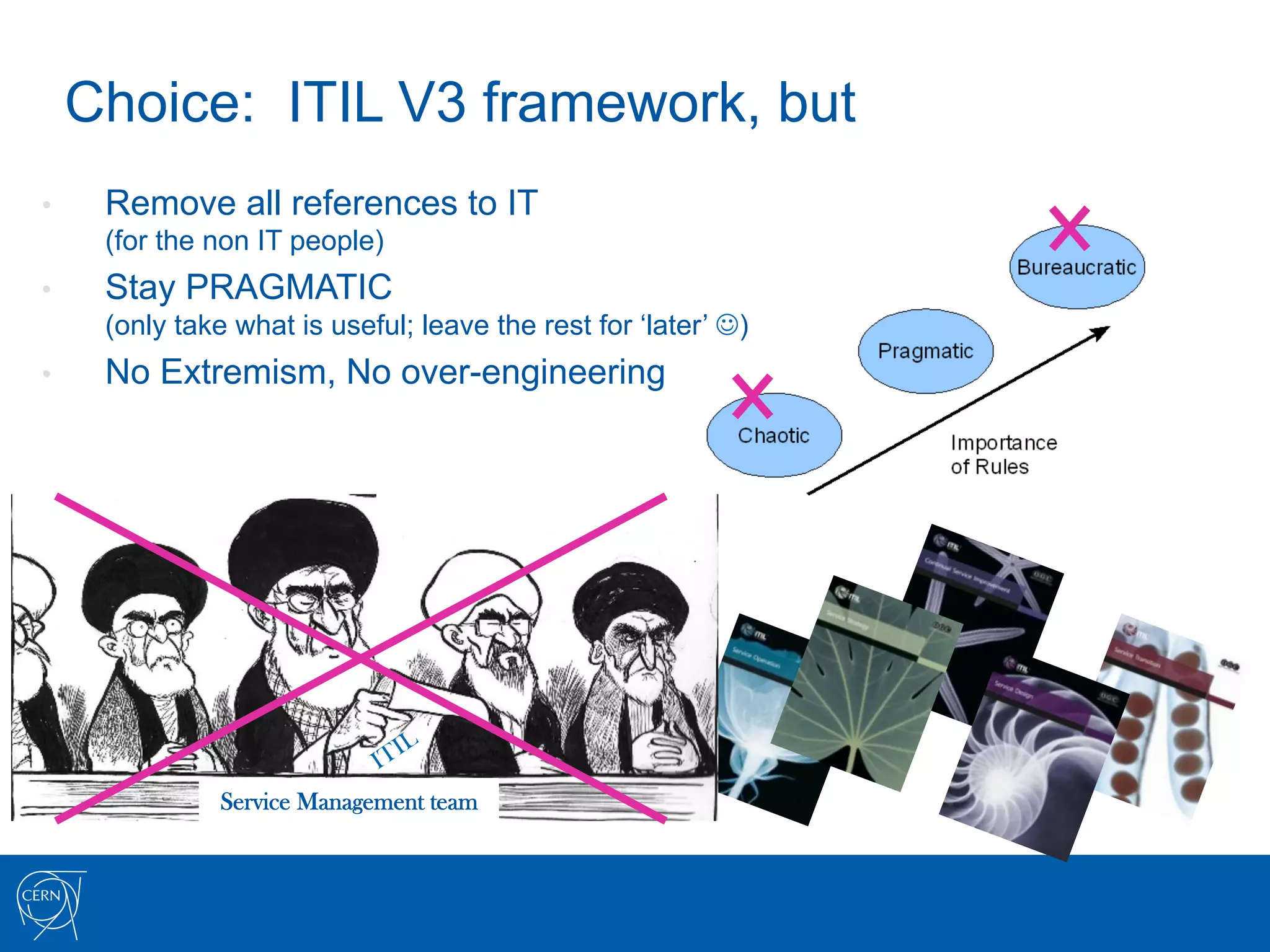

Choice: ITIL V3 framework, but
•     Remove all references to IT
      (for the non IT people)
•     Stay PRAGMATIC
      (only take what is useful; leave the rest for ‘later’ J)
•     No Extremism, No over-engineering

                Service Management team

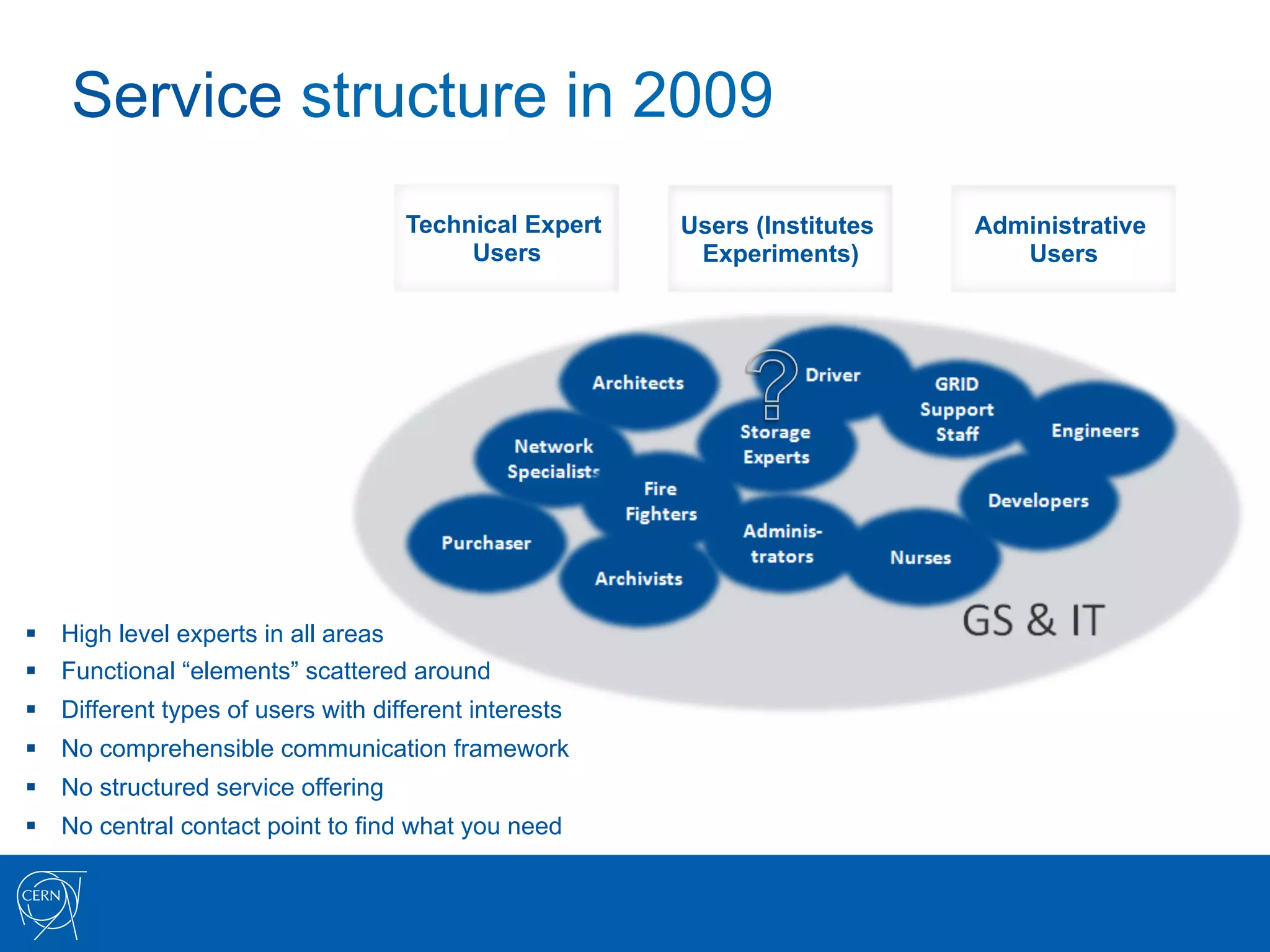

Service structure in 2009
                                      Technical Expert   Users (Institutes   Administrative
                                           Users          Experiments)          Users

§  High level experts in all areas
§  Functional “elements” scattered around
§  Different types of users with different interests
§  No comprehensible communication framework
§  No structured service offering
§  No central contact point to find what you need

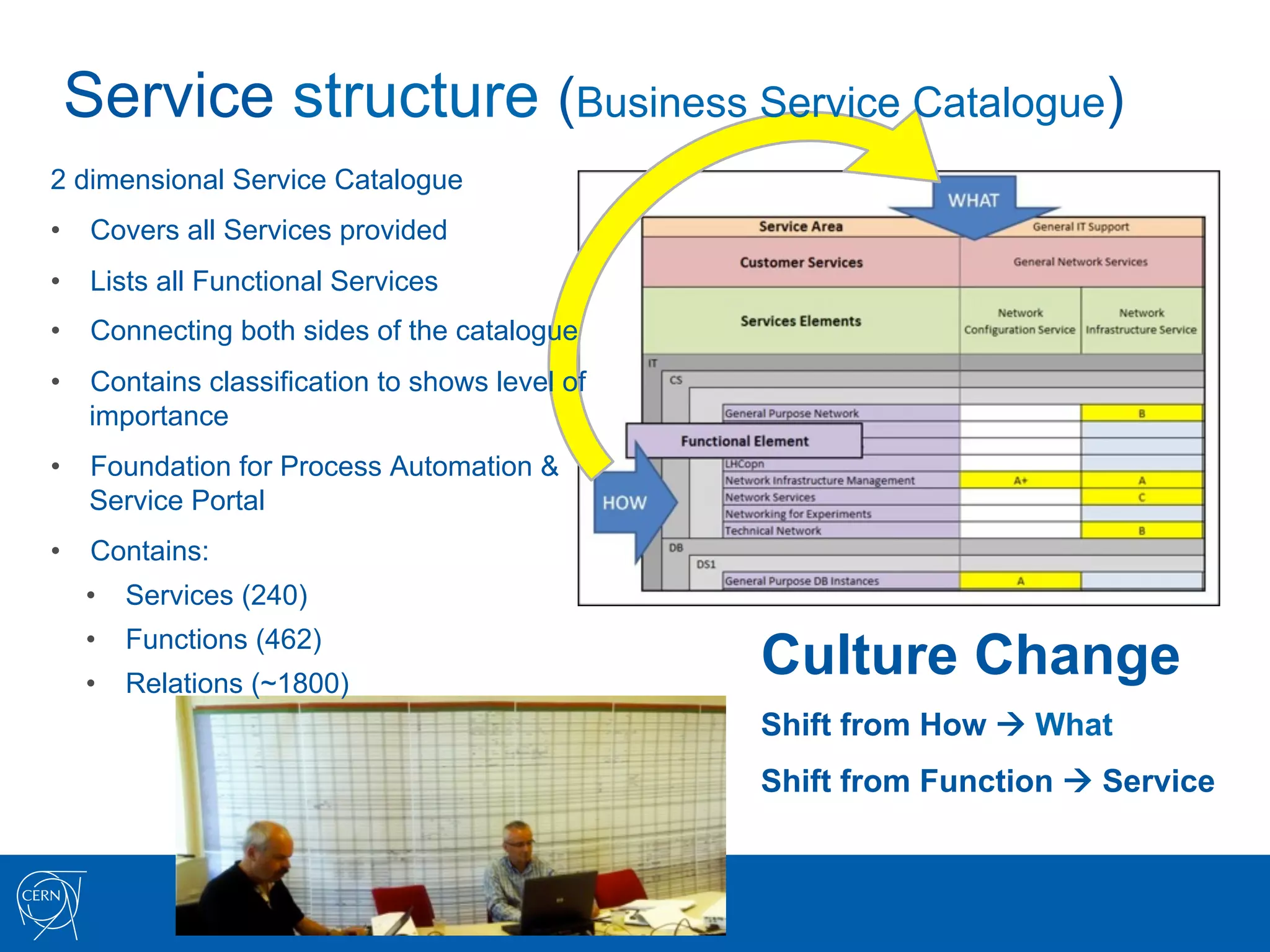

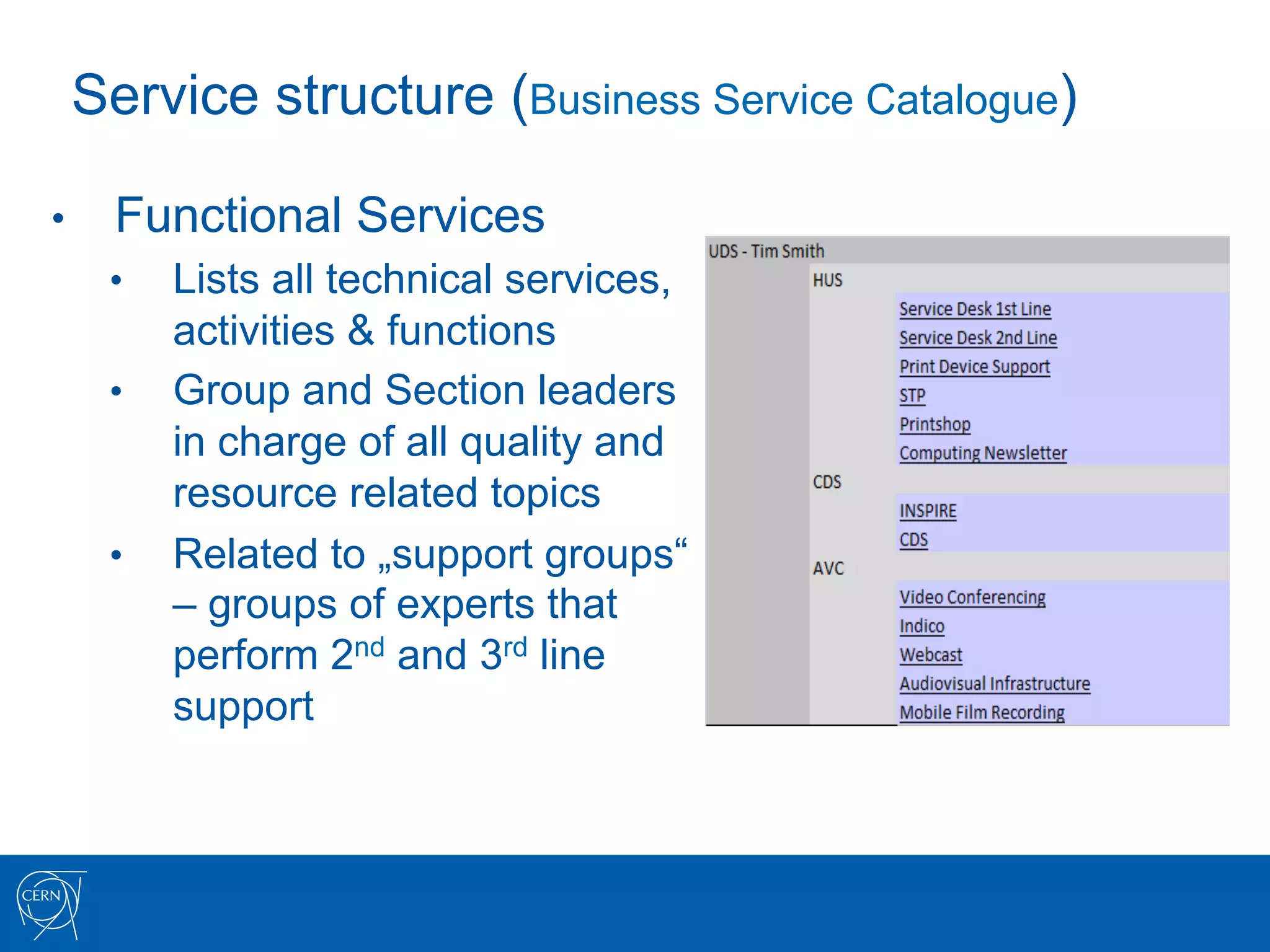

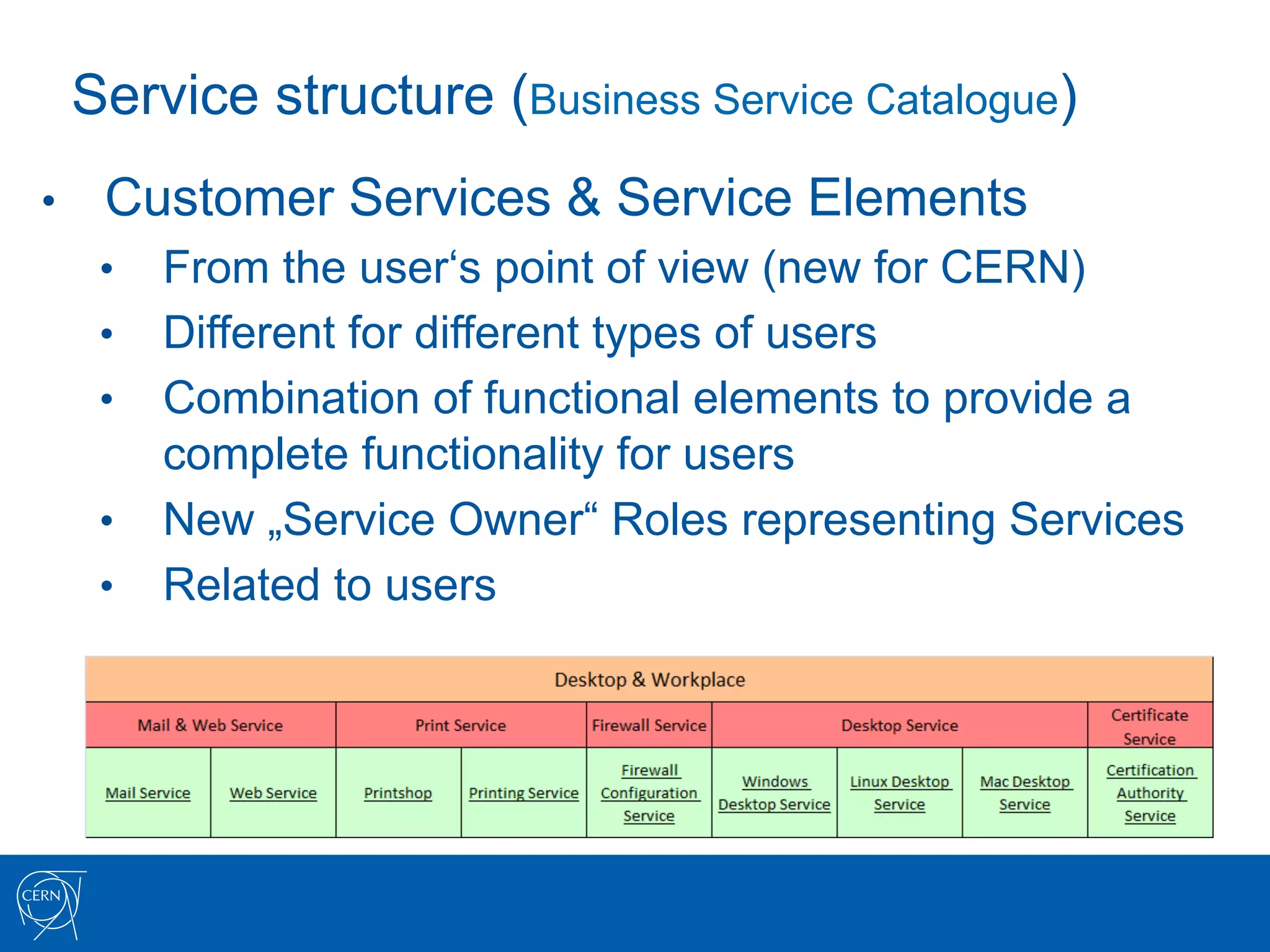

Service structure (Business Service Catalogue)
•     Customer Services & Service Elements
      •    From the user‘s point of view (new for CERN)
      •    Different for different types of users
      •    Combination of functional elements to provide a
           complete functionality for users
      •    New „Service Owner“ Roles representing Services
      •    Related to users
Service structure (Business Service Catalogue)

•     Functional Services
      •    Lists all technical services,
           activities & functions
      •    Group and Section leaders
           in charge of all quality and
           resource related topics
      •    Related to „support groups“
           – groups of experts that
           perform 2nd and 3rd line
           support
Service structure (Business Service Catalogue)
2 dimensional Service Catalogue
•  Covers all Services provided
•  Lists all Functional Services
•  Connecting both sides of the catalogue
•  Contains classification to shows level of
   importance
•  Foundation for Process Automation &
   Service Portal
•  Contains:
  •  Services (240)
  •  Functions (462)
  •  Relations (~1800)
                                               Culture Change
                                               Shift from How à What
                                               Shift from Function à Service

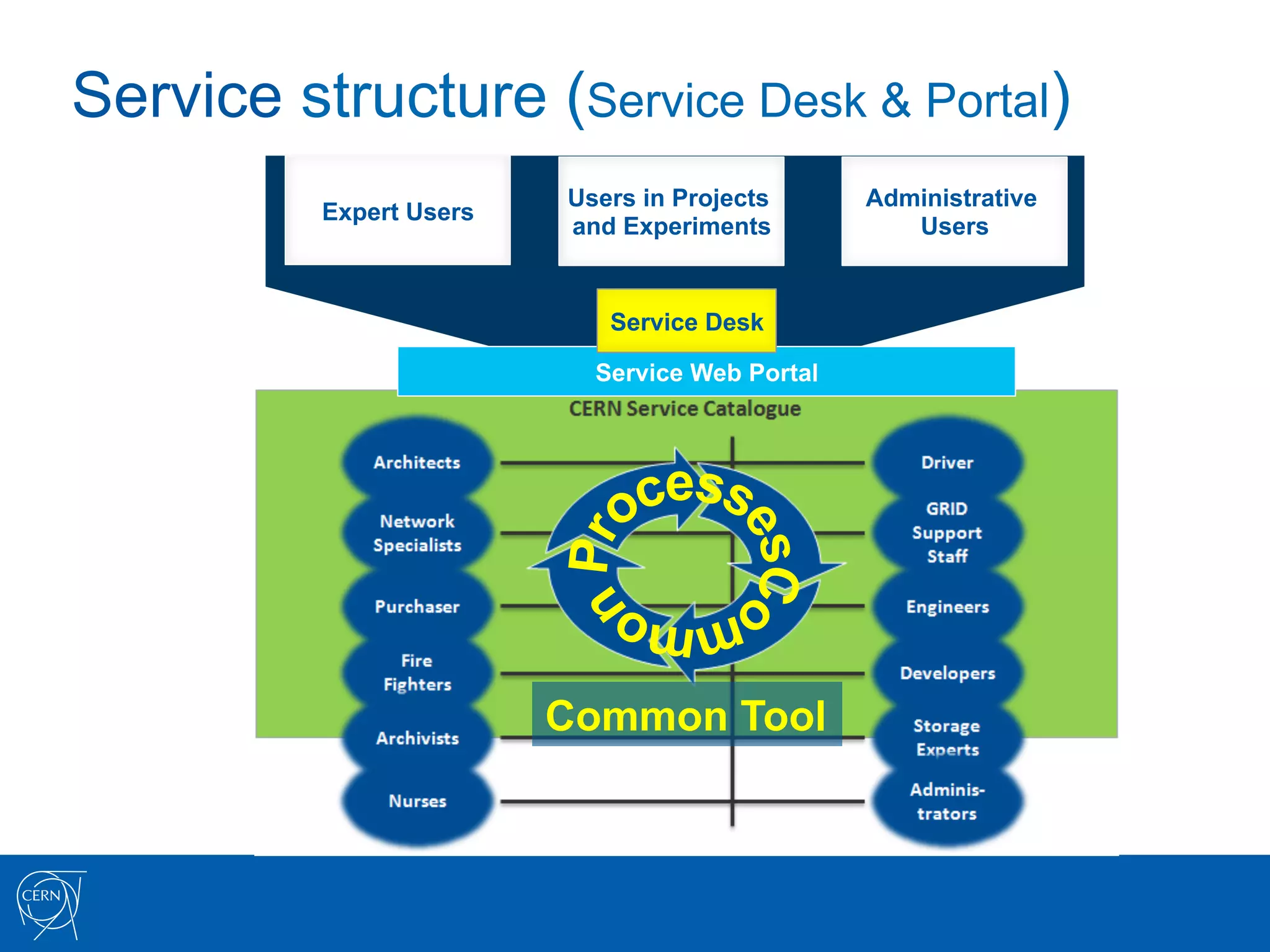

Service structure (Service Desk & Portal)
                         Users in Projects      Administrative
          Expert Users
                         and Experiments           Users

                            Service Desk

                           Service Web Portal

                         Common Tool

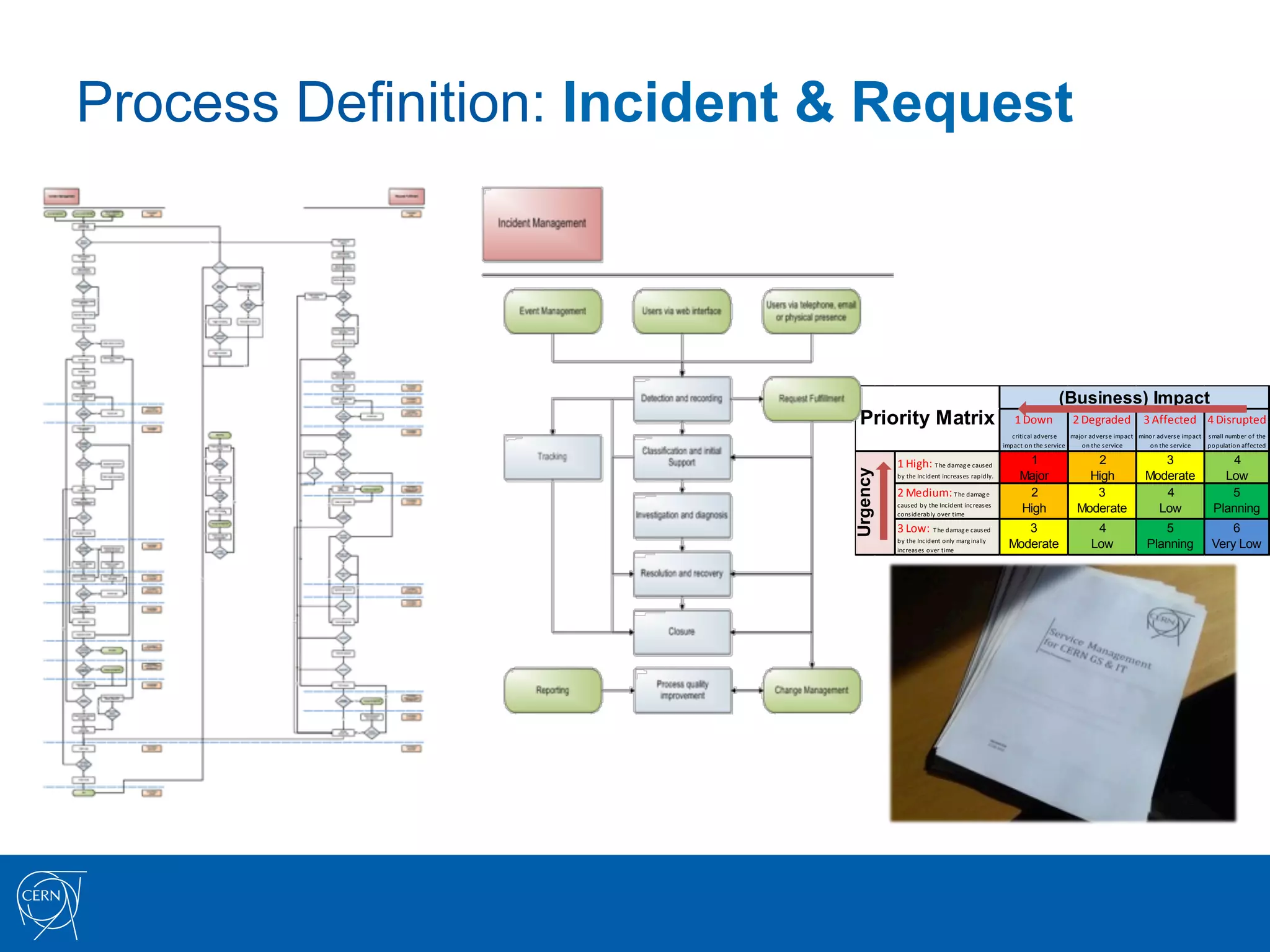

Process Definition: Incident & Request

                                                                                                                           (Business) Impact
                               Priority Matrix                                                      1
  Down                     2
  Degraded                      3
  Affected 4
  Disrupted
                                                                                                  critical
  advers e
         major
  advers e
  impact
   minor
  advers e
  impact
   s mall
  number
  o f
  t he

                                                                                               impact
  o n
  t he
  s ervice    on
  t he
  s ervice          on
  t he
  s ervice       population
  affected

                                       1
  High:
  T he
  d amag e
  c aus ed
                     1                              2                                 3                                  4

                             Urgency
                                       by
  t he
  Incident
  increas es
  rapidly.               Major                          High                            Moderate                            Low
                                       2
  Medium:
  T he
  d amag e
                               2                              3                                 4                                 5
                                       caus ed
  b y
  t he
  Incident
  increas es

                                       cons iderably
  o ver
  t ime
                                                                                                       High                         Moderate                            Low                             Planning
                                       3
  Low: T he
  d amag e
  c aus ed
                     3                                       4                             5                                 6
                                       by
  t he
  Incident
  o nly
  marg inally

                                       increas es
  o ver
  t ime
                                                                                                 Moderate                                  Low                         Planning                         Very Low

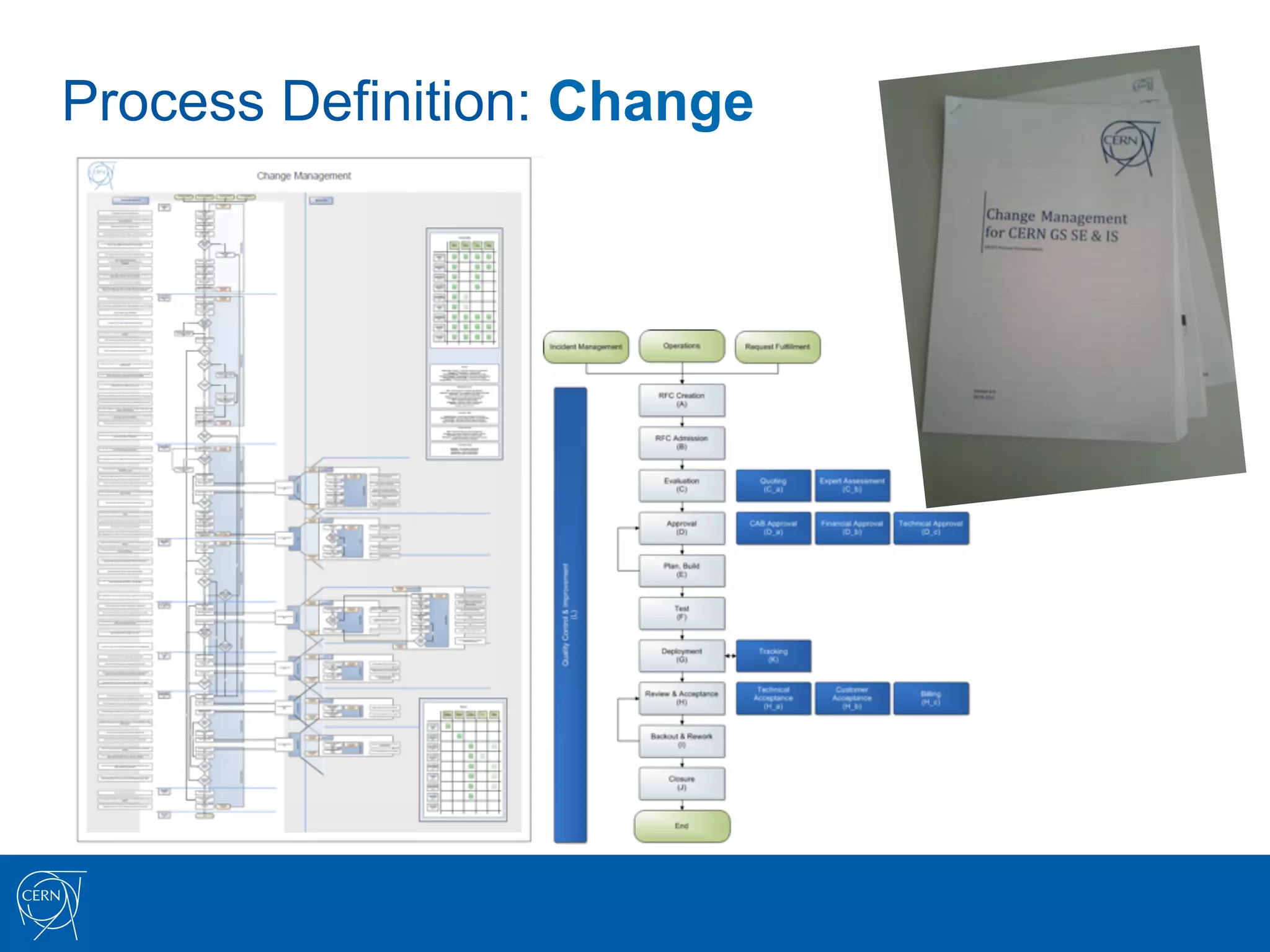

Process Definition: Change
Process Definition (status)
Finalized:
•  Incident, Request & Change
•  Business Service Catalogue management
•  Knowledge management
•  Service level management
In preparation:
•  Major incident handling
•  Outage handling & Status boards
•  Event management
Service Management Role definitions
  Service Desk                                            User
  Manager                                                                              Assistance
                      Supervis
                                                                                                    Service
                                 es                                                                 Manager
                                                                                                    On Duty
                                                                 Use
                                                                                     Customer
                             Service Desk
                                                                                                Services
                                      Ass
                                       igns
                                        To

                                                                       Coordinates
 Support
 Groups                               functions
             Supe
              rvise

Functional
               d

Service
Manager                                     Coordinates
                                                                                      Service Owner

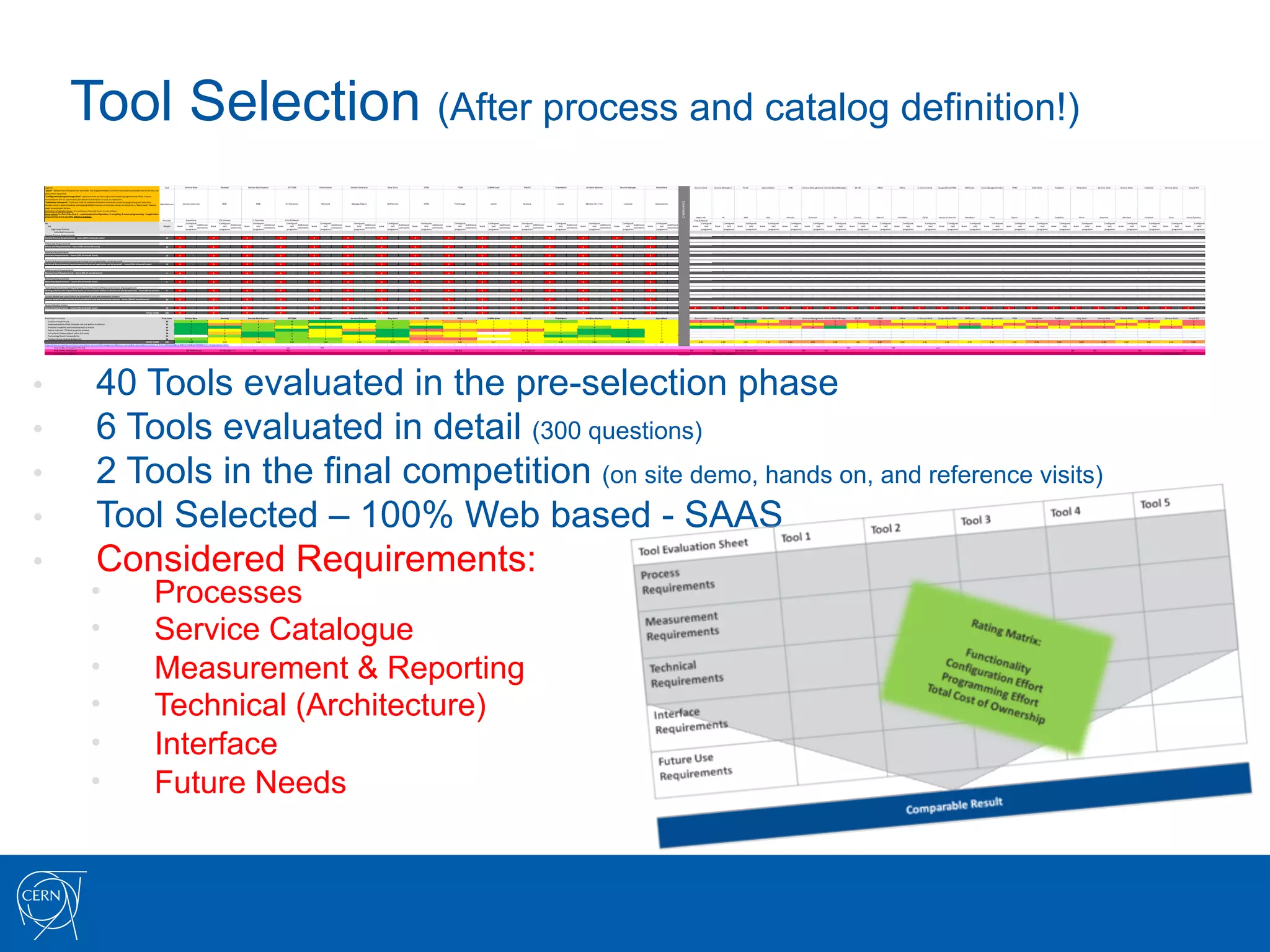

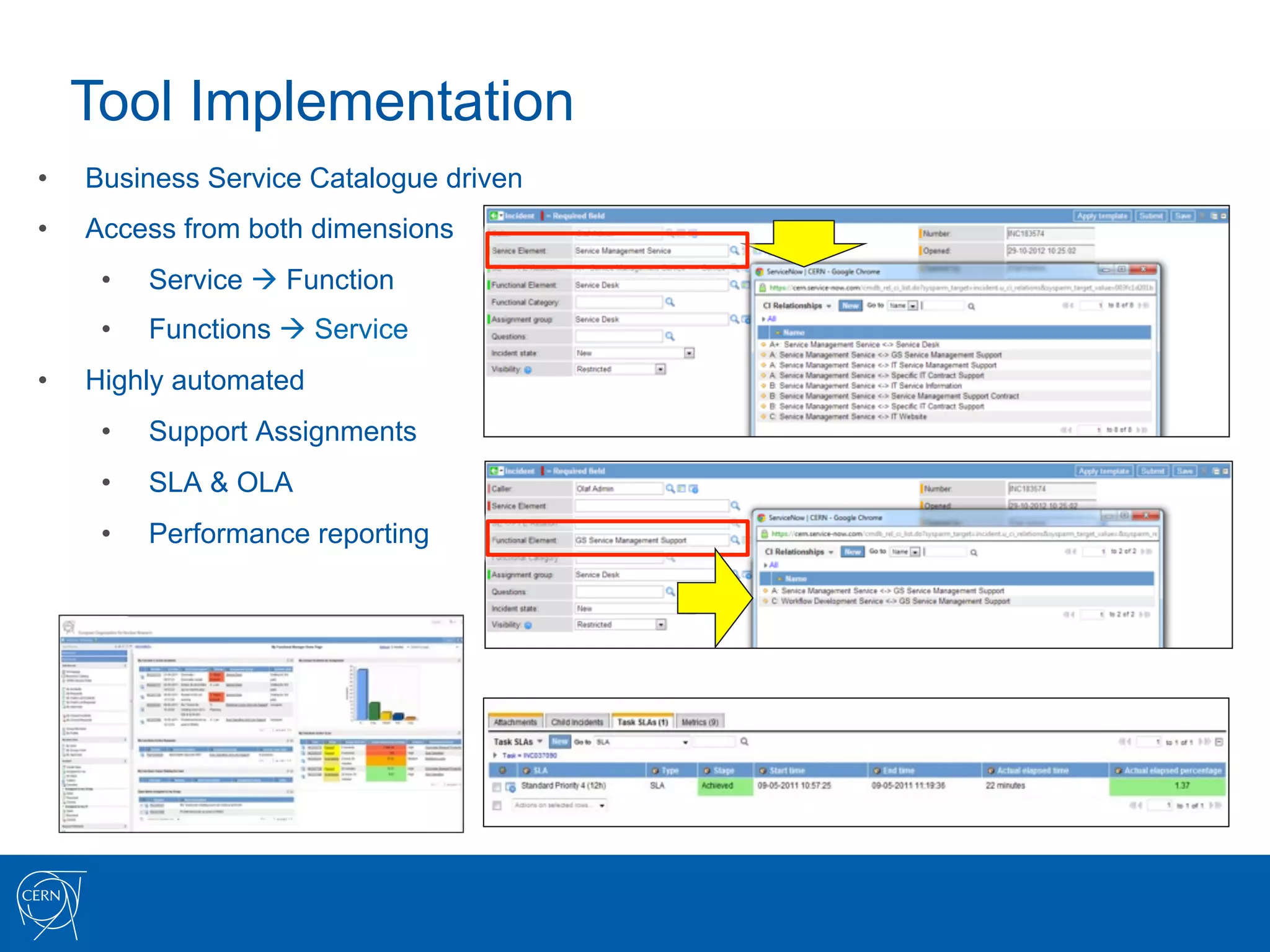

Tool Selection (After process and catalog definition!)
 Legend:                                                                                                                                                                              Tool                    Service
  Now                                                      Remedy                                                     Service
  Desk
  Express                                                 iET
  ITSM                                                  Omnitracker                                                     Service
  Desk
  plus                                              Easy
  V ista                                                                  OTRS                                                             ITSM                                           S-­‐BPM
  Suite                                                               TrackIT                                                 TicketXpert                                                           Incident
  Monitor                                                       Service
  Manager                                                       ExpertDesk                                                                       Service
  Desk                                                     Service
  Manager
  7                                                    Tivoli                                                      Valuemation                                                                     POB                                                       Service
  Management Service
  Desk
  Manager                                                                                                     20
  /20                                                               MSM                                                                    iWise                                                             e-­‐Service
  Desk                                                 SupportDesk
  ITSM                                                              SMI
  Suite                                                  Service
  Management
  Suite                                                            ITSM                                                                  Help
  Desk                                                              TopDesk                                                                Help
  Desk                                                        Service
  Desk                                                        Service
  Desk                                                            helpLine                                                          Service
  Desk                                                             Assyst
  7.5
 "Score":
  Rating
  from
  0
  ( feature
  not
  available,
  not
  programmable)
  to
  5
  ( full
  functionality
  provided
  out
  of
  the
  box,
  no

 extra
  e ffort
  required).
 "Configuration/programming
  e ffort":
  Optional
  field
  for
  defining
  customization/programming
  e ffort.
  V alues

 entered
  here
  will
  be
  used
  mainly
  for
  detailed
  distinction
  i n
  case
  of
  undecision.
 "Additional
  comments":
  Optional
  field
  for
  additional
  helpful
  comments
  aimed
  at
  progressing
  tool
  selection.

                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                        Downselect
                                                                                                                                                                                   Manufacturer             service-­‐now.com                                                                  BMC
                                                                 BMC                                           iET
  Solutions                                                   Omninet                                                         Manage
  Engine                                                   Staff
  &
  Line                                                               OTRS                                            Frontrange                                                                         jcom1                                                   Numara                                                                       isonet                                             Monitor
  24
  -­‐
  7
  i nc.                                                     Livetime                                                      Mansystems
 Overall
  score
  i s
  determined
  by
  multiplying
  Weight
  and
  out-­‐of-­‐the-­‐box
  rating;
  a
  0
  rating
  for
  a
  "Must-­‐have"
  feature

 leads
  to
  automatic
  failure.
 Definition
  of
  Weight
  values
  :
  5=must
  have,
  3=should
  have,
  1=nice
  to
  have
 Score
  values:
  5
  =
  Out
  of
  the
  box,
  4
  =
  customisation/configuration,
  3=
  scripting,
  2=minor
  programming,

  1=application

 programming
  0=not
  possible,
  Effort
  in
  mandays                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                Matrix
  42                                                               HP                                                                IBM                                                                USU                                                                   Wendia                                                                 Cherwell                                                              CA                                                                   Sunrise                                                                 Marvel                                                                InfraWise                                                                  ICCM                                                        House
  on
  the
  Hill                                                       Westbury                                                                       Priox                                                                 Epicor                                                                      iNet                                                                   TopDesk                                                                  Nilex                                                                 Naumen                                                                 LAN
  Desk                                                            helpLine                                                                Easit                                                             Axios
  Systems
                                                                                                                                                                                         Provider              Aspediens                                                       IT
  Concepts                                                     IT
  Concepts                                                   Fritz
  &
  Maciol                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                    Fritz
  &
  Maciol
 Main
  Category                                                                                                                                                                                              Configurat                                                       Configurat                                                         Configurat                                                       Configurat                                                       Configurat                                                          Configurat                                                      Configurat                                                       Configurat                                                      Configurat                                                       Configurat                                                            Configurat                                                      Configurat                                                                Configurat                                                               Configurat                                                            Configurat                                                                                     Configurat                                                       Configurat                                                         Configurat                                                        Configurat                                                               Configurat                                                            Configurat                                                          Configurat                                                              Configurat                                                            Configurat                                                             Configurat                                                               Configurat                                                             Configurat                                                                Configurat                                                                 Configurat                                                               Configurat                                                                Configurat                                                               Configurat                                                              Configurat                                                           Configurat                                                               Configurat                                                            Configurat                                                             Configurat                                                               Configurat
                                                                                                                                                                                                                           Additional
                                                        Additional
                                                       Additional
                                                        Additional
                                               Additional
                                                        Additional
                                                    Additional
                                                     Additional
                                                    Additional
                                                     Additional
                                                          Additional
                                                    Additional
                                                              Additional
                                                             Additional
                                                          Additional

    Sub-­‐category                                                                                                                                                                        Weight    Score         ion/
                                               Score          ion/
                                           Score             ion/
                                            Score          ion/
                                             Score      ion/
                                               Score          ion/
                                               Score      ion/
                                                Score      ion/
                                               Score      ion/
                                               Score       ion/
                                                     Score      ion/
                                               Score      ion/
                                                     Score          ion/
                                                     Score         ion/
                                                     Score      ion/
                                                                    Score                ion/
                                              Score        ion/
                                               Score         ion/
                                               Score        ion/
                                                      Score        ion/
                                                 Score          ion/
                                                 Score        ion/
                                                  Score           ion/
                                                  Score         ion/
                                                  Score          ion/
                                                      Score        ion/
                                                  Score          ion/
                                                      Score         ion/
                                                        Score        ion/
                                                      Score        ion/
                                                      Score         ion/
                                                      Score        ion/
                                                 Score            ion/
                                                 Score         ion/
                                                      Score        ion/
                                                 Score          ion/
                                                  Score          ion/
                                                  Score            ion/

                                                                                                                                                                                                                           comments                                                            comments                                                           comments                                                            comments                                                   comments                                                            comments                                                        comments                                                         comments                                                        comments                                                         comments                                                              comments                                                        comments                                                                  comments                                                                 comments                                                              comments
          High-­‐level
  Criteria                                                                                                                                                                             programm                                                         programm                                                           programm                                                          programm                                                        programm                                                            programm                                                        programm                                                         programm                                                        programm                                                         programm                                                              programm                                                        programm                                                                  programm                                                                 programm                                                              programm                                                                                       programm                                                         programm                                                           programm                                                          programm                                                                 programm                                                              programm                                                            programm                                                                programm                                                              programm                                                               programm                                                                 programm                                                               programm                                                                  programm                                                                   programm                                                                 programm                                                                  programm                                                                 programm                                                                programm                                                             programm                                                                 programm                                                              programm                                                               programm                                                                 programm
             Individual
  e lements
 Current
  Process
  Requirements
 Current
  Process
  Requirements

  -­‐
  Score
  (35%
  of
  overall
  score)                                                                                                    35     0

  -­‐

       0

  -­‐

       0

  -­‐

       0

  -­‐

       0

  -­‐

       0

  -­‐

       0

  -­‐

       0

  -­‐

       0

  -­‐

       0

  -­‐

       0

  -­‐

       0

  -­‐

       0

  -­‐

       0

  -­‐

       0

  -­‐

 Future
  Use
  Requirements
 Future
  Use
  Requirements

  -­‐
  Score
  (10%
  of
  overall
  score)                                                                                                         10     0

  -­‐

       0

  -­‐

       0

  -­‐

       0

  -­‐

       0

  -­‐

       0

  -­‐

       0

  -­‐

       0

  -­‐

       0

  -­‐

       0

  -­‐

       0

  -­‐

       0

  -­‐

       0

  -­‐

       0

  -­‐

       0

  -­‐

 Interface
  Requirements
 Interface
  Requirements

  -­‐
  Score
  (15%
  of
  overall
  score)                                                                                                             15     0

  -­‐

       0

  -­‐

       0

  -­‐

       0

  -­‐

       0

  -­‐

       0

  -­‐

       0

  -­‐

       0

  -­‐

       0

  -­‐

       0

  -­‐

       0

  -­‐

       0

  -­‐

       0

  -­‐

       0

  -­‐

       0

  -­‐

 Technical
  Requirements
  ( requirements
  that
  are
  not
  applicable
  can
  be
  i gnored)
 Technical
  Requirements
  (requirements
  that
  are
  not
  applicable
  can
  be
  ignored)

  -­‐
  Score
  (10%
  of
  overall
  score)                               10     0

  -­‐

       0

  -­‐

       0

  -­‐

       0

  -­‐

       0

  -­‐

       0

  -­‐

       0

  -­‐

       0

  -­‐

       0

  -­‐

       0

  -­‐

       0

  -­‐

       0

  -­‐

       0

  -­‐

       0

  -­‐

       0

  -­‐

 Measurement
  Requirements
 Measurement
  Requirements

  -­‐
  Score
  (5%
  of
  overall
  score)                                                                                                             5     0

  -­‐

       0

  -­‐

       0

  -­‐

       0

  -­‐

       0

  -­‐

       0

  -­‐

       0

  -­‐

       0

  -­‐

       0

  -­‐

       0

  -­‐

       0

  -­‐

       0

  -­‐

       0

  -­‐

       0

  -­‐

       0

  -­‐

 Reporting
  Requirements
 Reporting
  Requirements

  -­‐
  Score
  (5%
  of
  overall
  score)                                                                                                               5     0

  -­‐

       0

  -­‐

       0

  -­‐

       0

  -­‐

       0

  -­‐

       0

  -­‐

       0

  -­‐

       0

  -­‐

       0

  -­‐

       0

  -­‐

       0

  -­‐

       0

  -­‐

       0

  -­‐

       0

  -­‐

       0

  -­‐

 Hosting
  schemes
  ( no
  i mpact
  final
  score,
  as
  one
  or
  more
  of
  these
  schemes
  are
  always
  present)
 Hosting
  schemes
  (no
  impact
  final
  score,
  as
  one
  or
  more
  of
  these
  schemes
  are
  always
  present)

  -­‐
  Score
  (0%
  of
  overall
  score) 0    0

  -­‐

       0

  -­‐

       0

  -­‐

       0

  -­‐

       0

  -­‐

       0

  -­‐

       0

  -­‐

       0

  -­‐

       0

  -­‐

       0

  -­‐

       0

  -­‐

       0

  -­‐

       0

  -­‐

       0

  -­‐

       0

  -­‐

 Licence
  Model
  and
  costs
  ( Info
  to
  be
  provided
  i n
  cost
  and
  comments
  column)
 Licence
  Model
  and
  costs
  (Info
  to
  be
  provided
  in
  cost
  and
  comments
  column)

  -­‐
  Score
  (10%
  of
  overall
  score)                         10     0

  -­‐

       0

  -­‐

       0

  -­‐

       0

  -­‐

       0

  -­‐

       0

  -­‐

       0

  -­‐

       0

  -­‐

       0

  -­‐

       0

  -­‐

       0

  -­‐

       0

  -­‐

       0

  -­‐

       0

  -­‐

       0

  -­‐

 General
  Quality
  Factors
 General
  Quality
  Factors

  -­‐
  Score
  (10%
  of
  overall
  score)                                                                                                         10     0

  -­‐

       0

  -­‐

       0

  -­‐

       0

  -­‐

       0

  -­‐

       0

  -­‐

       0

  -­‐

       0

  -­‐

       0

  -­‐

       0

  -­‐

       0

  -­‐

       0

  -­‐

       0

  -­‐

       0

  -­‐

       0

  -­‐

                        0

  -­‐

          0

  -­‐

      0

  -­‐

      0

  -­‐

             0

  -­‐

           0

  -­‐

           0

  -­‐

            0

  -­‐

            0

  -­‐

            0

  -­‐

             0

  -­‐

            0

  -­‐

             0

  -­‐

               0

  -­‐

             0

  -­‐

             0

  -­‐

             0

  -­‐

           0

  -­‐

           0

  -­‐

             0

  -­‐

           0

  -­‐

           0

  -­‐

           0

  -­‐

                                                                                                                                                               TOTAL
  SCORE                100     0

  -­‐

       0

  -­‐

       0

  -­‐

       0

  -­‐

       0

  -­‐

       0

  -­‐

       0

  -­‐

       0

  -­‐

       0

  -­‐

       0

  -­‐

       0

  -­‐

       0

  -­‐

       0

  -­‐

       0

  -­‐

       0

  -­‐

 Preselection
  criteria                                                                                 %
  of
  score      Service
  Now                 Remedy                                                                                                                                                                        Service
  Desk
  Express                                                 iET
  ITSM                                                  Omnitracker                                                     Service
  Desk
  plus                                              Easy
  Vista                                                                   OTRS                                                            ITSM                                            S-­‐BPM
  Suite                                                               TrackIT                                                 TicketXpert                                                           Incident
  Monitor                                                       Service
  Manager                                                       ExpertDesk                                                                       Service
  Desk                                                     Service
  Manager
  7                                                    Tivoli                                                      Valuemation                                                                     POB                                                       Service
  Management Service
  Desk
  Manager                                                                                                     20
  /20                                                               MSM                                                                    iWise                                                             e-­‐Service
  Desk                                                 SupportDesk
  ITSM                                                              SMI
  Suite                                                  Service
  Management
  Suite                                                            ITSM                                                                  Help
  Desk                                                              TopDesk                                                                Help
  Desk                                                        Service
  Desk                                                        Service
  Desk                                                            helpLine                                                          Service
  Desk                                                             Assyst
  7.5
    Customer
  e xperience                                                                                      20                      4                            3                                                                                                                                                                                   2                                                                    4                                                         5                                                                      5                                                             4                                                                             2                                                               1                                                   3                                                                           3                                                          4                                                                       3                                                                            3                                                                  3                                                                                 0                                                                        0                                                                 5                                                              3                                                                           0                                                                    0                      0                                                                                                                    0                                                                     0                                                                       3                                                                        3                                                                 3                                                                              3                                                                       3                                                                            3                                                                       0                                                                        0                                                                       0                                                                     0                                                                      3                                                                       0                                                                    3                                                                         0
    Implementation
  e ffort
  ( feasible
  roll
  out
  within
  4
  months)                             15                      5                            1                                                                                                                                                                                   4                                                                    4                                                         3                                                                      3                                                             4                                                                             3                                                               3                                                   3                                                                           3                                                          3                                                                       3                                                                            3                                                                  3                                                                                 3                                                                        3                                                                 0                                                              0                                                                           0                                                                    3                      0                                                                                                                    3                                                                     0                                                                       0                                                                        0                                                                 3                                                                              0                                                                       3                                                                            0                                                                       3                                                                        0                                                                       3                                                                     3                                                                      0                                                                       3                                                                    3                                                                         0
    Provider's
  viability
  and
  completeness
  of
  vision                                               15                      5                            5                                                                                                                                                                                   4                                                                    3                                                         5                                                                      3                                                             4                                                                             5                                                               3                                                   3                                                                           3                                                          3                                                                       4                                                                            3                                                                  3                                                                                 5                                                                        5                                                                 3                                                              3                                                                           3                                                                    0                      5                                                                                                                    3                                                                     3                                                                       3                                                                        3                                                                 0                                                                              5                                                                       0                                                                            3                                                                       0                                                                        3                                                                       0                                                                     0                                                                      3                                                                       3                                                                    0                                                                         3
    Native
  relevant

  ITIL
  best-­‐practice
  content                                                 10                      5                            3                                                                                                                                                                                   4                                                                    5                                                         3                                                                      1                                                             5                                                                             0                                                               1                                                   0                                                                           0                                                          3                                                                       5                                                                            5                                                                  3
    Fully
  Web
  2.0
  based
  ( Back
  office
  &
  Portal)                                             10                      5                            2                                                                                                                                                                                   5                                                                    4                                                         3                                                                      5                                                             5                                                                             3                                                               3                                                                                                                               3                                                          4                                                                       5                                                                            5                                                                  3
    Technology
  Stack
  Compatability                                                                         10                                                   4                                                                                                                                                                                   5                                                                    4                                                         3                                                                      3                                                             5                                                                             1                                                               3                                                                                   3                                           3                                                          5                                                                       4                                                                            5                                                                  3
    Product
  Design
  Quality
  &
  Maturity                                                                20                      4                            3                                                                                                                                                                                   2                                                                    4                                                         4                                                                      3                                                             3                                                                             0                                                               0                                                                                                                               3                                                          3                                                                       3                                                                            3                                                                  3
                                                                                           TOTAL
  SCORE       100                 4.56                         3.00                                                                                                                                                                                   3.40                                                              3.95                                                         3.90                                                                3.40                                                             4.10                                                                          2.00                                                            1.80                                                                     2.57                                                   2.70                                                       3.50                                                                    3.65                                                                      3.60                                                                  3.00                                                                                2.40                                                                   2.40                                                              2.90                                                               2.10                                                                     0.90                                                                  0.90                                                                1.50                                                                  1.80                                                                    0.90                                                                   2.10                                                                     2.10                                                                 2.10                                                                       2.70                                                                        2.10                                                                     2.10                                                                     0.90                                                                      0.90                                                                   0.90                                                                  0.90                                                                     2.10                                                                 1.80                                                                   2.10                                                                     0.90
 http://www.itsmportal.com/tools?searchtext=service%20management&action=search&op=Search&form_build_id=form-­‐963bb6a68bcce30357e7bd0ba6c94292&form_id=querytools_form
         Pink
  V erify
  2.0
  toolsets
  ( ITIL
  V 2)                                                                                                                                                                                                                                                                                                                                                        yes                                                             YES                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                  YES                                                                     yes                                                                   YES                                                                                                                                             yes
         Pink
  V erify
  3.0
  toolsets                                                                                      YES
  2009
  release       YES
  Remedy
  7.0                                                                                                                                                                 YES                                                               NO                                                                                                                                                                                                  yes                                                              YES
  2.0                                                      YES
  9.0
                                                                    YES
  Footprint

                                                                         YES                                                                     YES
                         YES
  SERVICE-­‐MANAGFEMENT
  7.0

                                                                       YES                                                                   YES

                                                                       YES                                                                     YES
                                                                       YES
                                                                      YES
         Pink
  V erify
  3.1
  toolsets                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                  YES
  Service-­‐manager
  7.1                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                YES
  SERVICE
  DESK
  4

•                                                                                 40 Tools evaluated in the pre-selection phase
•                                                                                 6 Tools evaluated in detail (300 questions)
•                                                                                 2 Tools in the final competition (on site demo, hands on, and reference visits)
•                                                                                 Tool Selected – 100% Web based - SAAS
•                                                                                 Considered Requirements:
                                                                          •                                                                                                 Processes
                                                                          •                                                                                                 Service Catalogue
                                                                          •                                                                                                 Measurement & Reporting
                                                                          •                                                                                                 Technical (Architecture)
                                                                          •                                                                                                 Interface
                                                                          •                                                                                                 Future Needs
Tool Implementation
Phase 1 – Do the basics to get operational (autumn 2010) :
•    Business Service catalogue ( CERN design & implementation )
•    Incident & Request ( existing basic processes – CERN catalogue automation )
•    Service portal ( CERN design & implementation)
Phase 2 – Grow the system while acquiring experience (2011) :
•    Service level management (out of the box for incident / CERN build fro request)
•    Reporting ( ok for operational reports disappointing for
•    Functional improvements (many requirements /
•    Interfaces to other “ticket” systems ( GRID computing, Assed management ..)
•    Knowledge management (adapted to the business service catalogue)
•    Change management ( CERN build simplified process )
Phase 3 (2012)
•  Process & tool improvements
•  Event management (CERN implementation)
Tool Implementation
•    Business Service Catalogue driven
•    Access from both dimensions
      •    Service à Function
      •    Functions à Service
•    Highly automated
      •    Support Assignments
      •    SLA & OLA
      •    Performance reporting

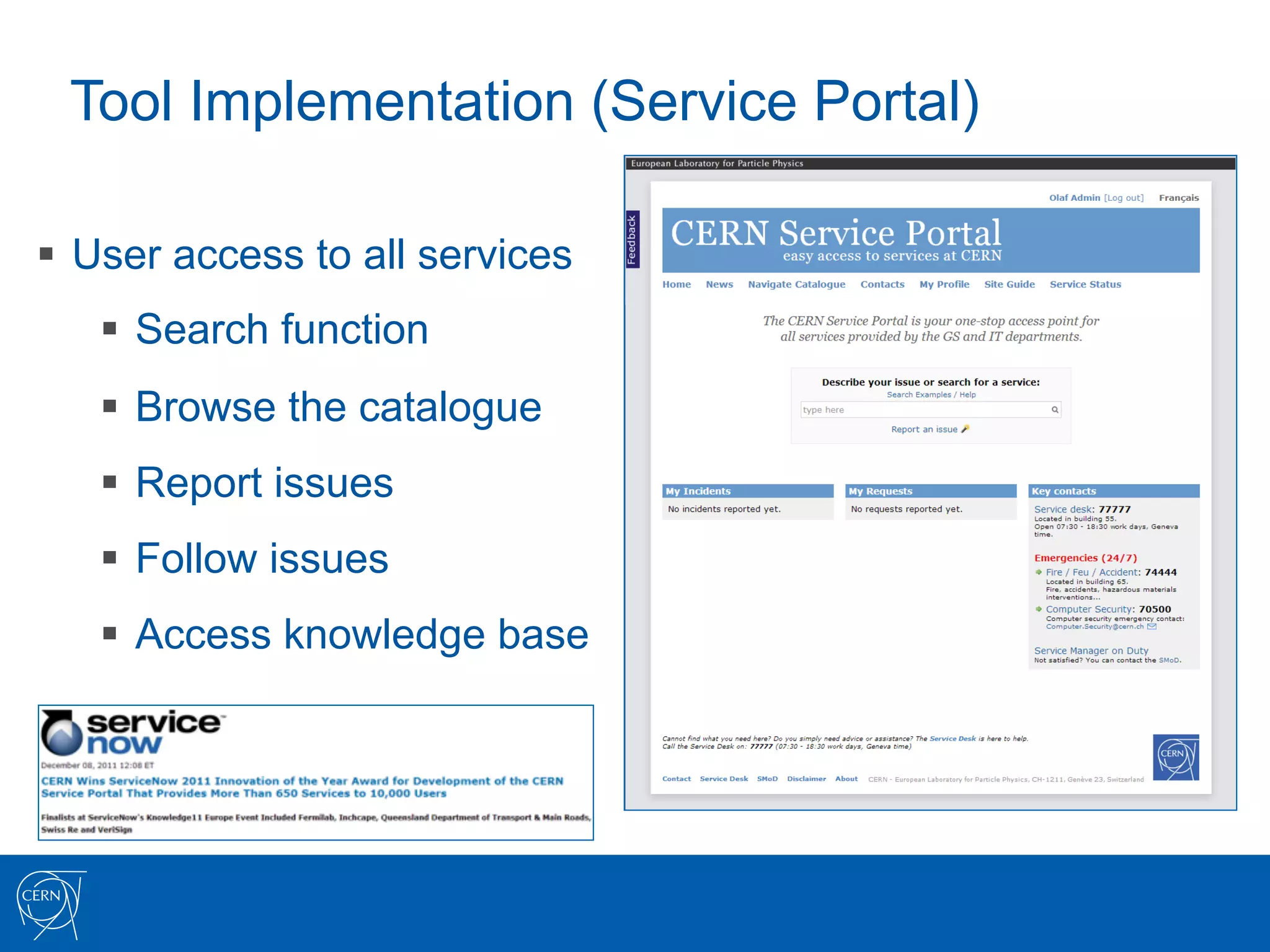

Tool Implementation (Service Portal)

§  User access to all services
   §  Search function
   §  Browse the catalogue
   §  Report issues
   §  Follow issues
   §  Access knowledge base
Service Management for CERN
How did we go about it?
 §  External ITIL expert knowledge and experience
   §  Ncc Management Consultants
       (Experts in ITIL applied to non IT)
   §  2 dimensional Service Matrix proven in practice
   §  Specific experience in huge organizations
 §  Tool implementation
   §  Aspediens: expert coaching
   §  ServiceNow: good relations with the tool manufacturer
 §  Initially 2 Departments (IT & General Services)
 §  Initially 2 Processes (Incident, Request)
 §  Grow and Improve gradually
   §  More departments (Finance, Human Resources)
   §  More processes (Change, Problem, Event, Knowledge, …)

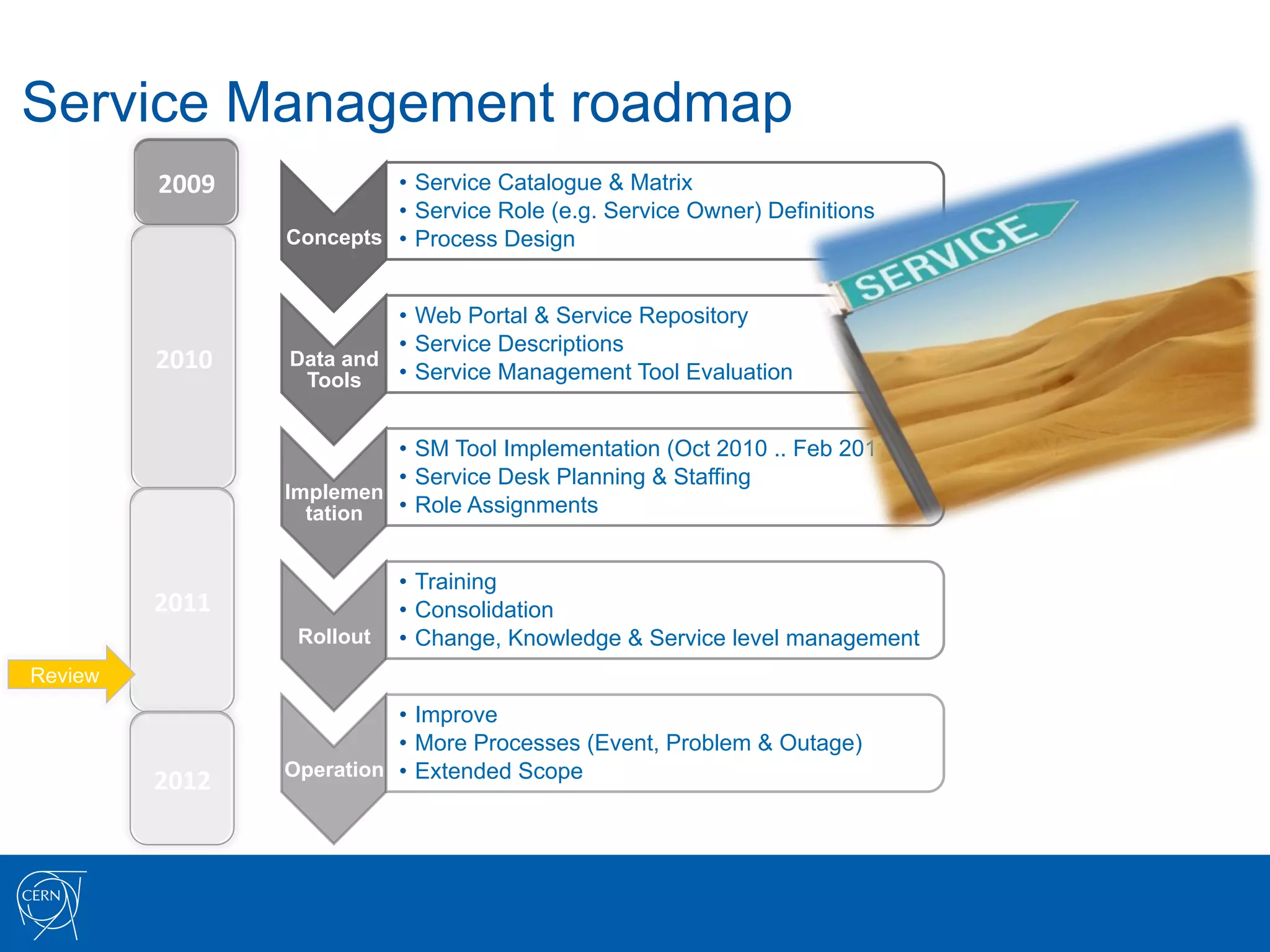

Service Management roadmap
         2009
              •  Service Catalogue & Matrix
                             •  Service Role (e.g. Service Owner) Definitions
                    Concepts •  Process Design

                             •  Web Portal & Service Repository
                             •  Service Descriptions
         2010
     Data and
                             •  Service Management Tool Evaluation
                     Tools

                             •  SM Tool Implementation (Oct 2010 .. Feb 2011)
                             •  Service Desk Planning & Staffing
                    Implemen
                      tation •  Role Assignments

                               •  Training
         2011
                •  Consolidation
                     Rollout   •  Change, Knowledge & Service level management
Review
                              •  Improve
                              •  More Processes (Event, Problem & Outage)
                    Operation •  Extended Scope
         2012

Project Review
§  Quality review by ITIL senior consultant (Colin Rudd - autumn 2011)
§  Approach:
    §  Interviews with key staff involved in all area’s of service management
        activities
    §  Interviews with representatives of the user community
    §  Identify and quantify the current level of service management maturity
§  Results:
    §  Report on strengths, weaknesses
        and gaps with prioritized
        recommendations for improvements

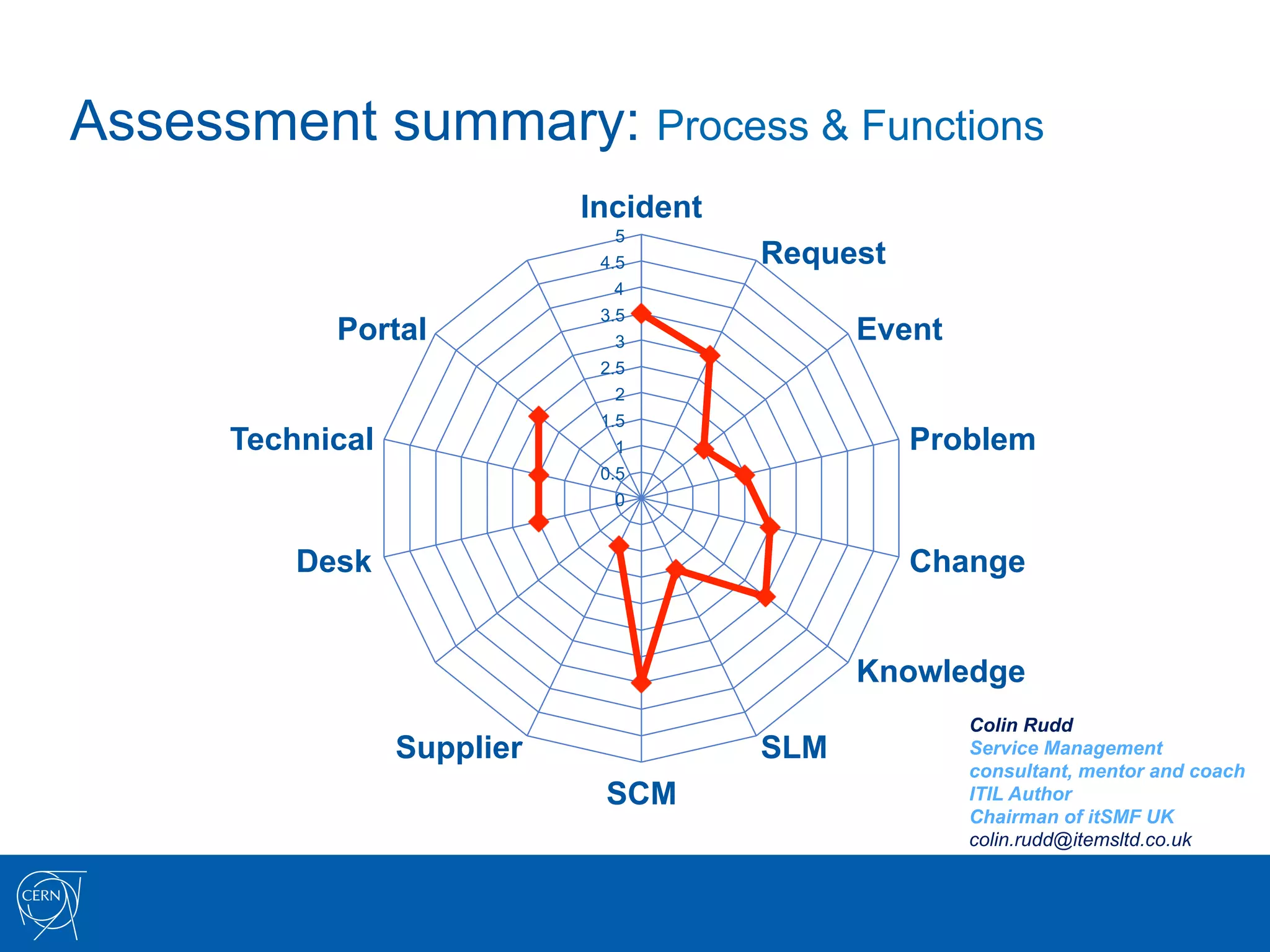

Assessment summary: Process & Functions
                             Incident
                                5
                              4.5       Request
                                4
                              3.5
            Portal              3             Event
                              2.5
                                2
                              1.5
      Technical                 1                 Problem
                              0.5
                                0

          Desk                                    Change

                                              Knowledge
                                                      Colin Rudd
                  Supplier              SLM           Service Management
                                                      consultant, mentor and coach
                              SCM                     ITIL Author
                                                      Chairman of itSMF UK
                                                      colin.rudd@itemsltd.co.uk

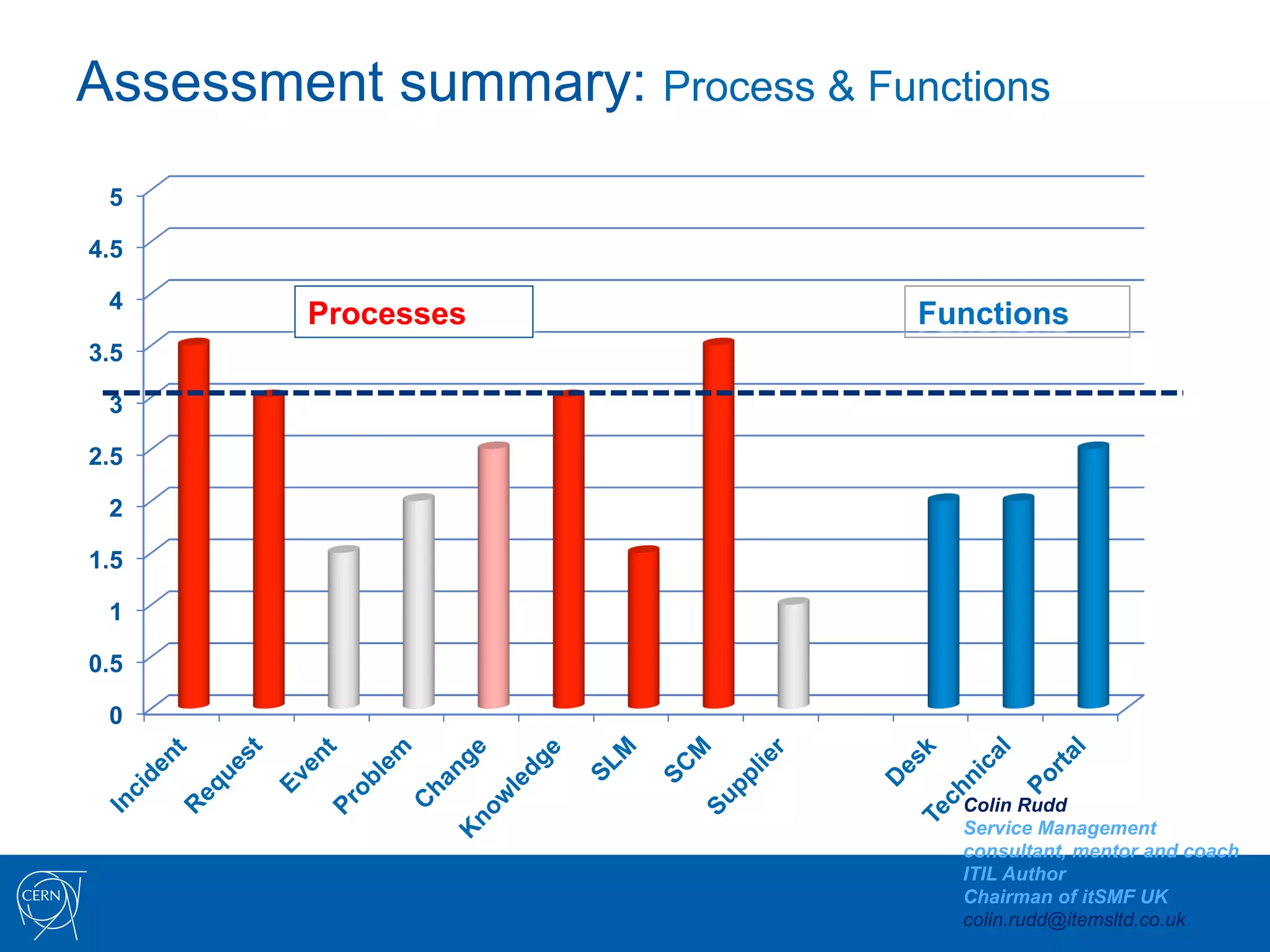

Assessment summary: Process & Functions
 5

4.5

 4
         Processes               Functions
3.5

 3

2.5

 2

1.5

 1

0.5

 0

                                   Colin Rudd
                                   Service Management
                                   consultant, mentor and coach
                                   ITIL Author
                                   Chairman of itSMF UK
                                   colin.rudd@itemsltd.co.uk

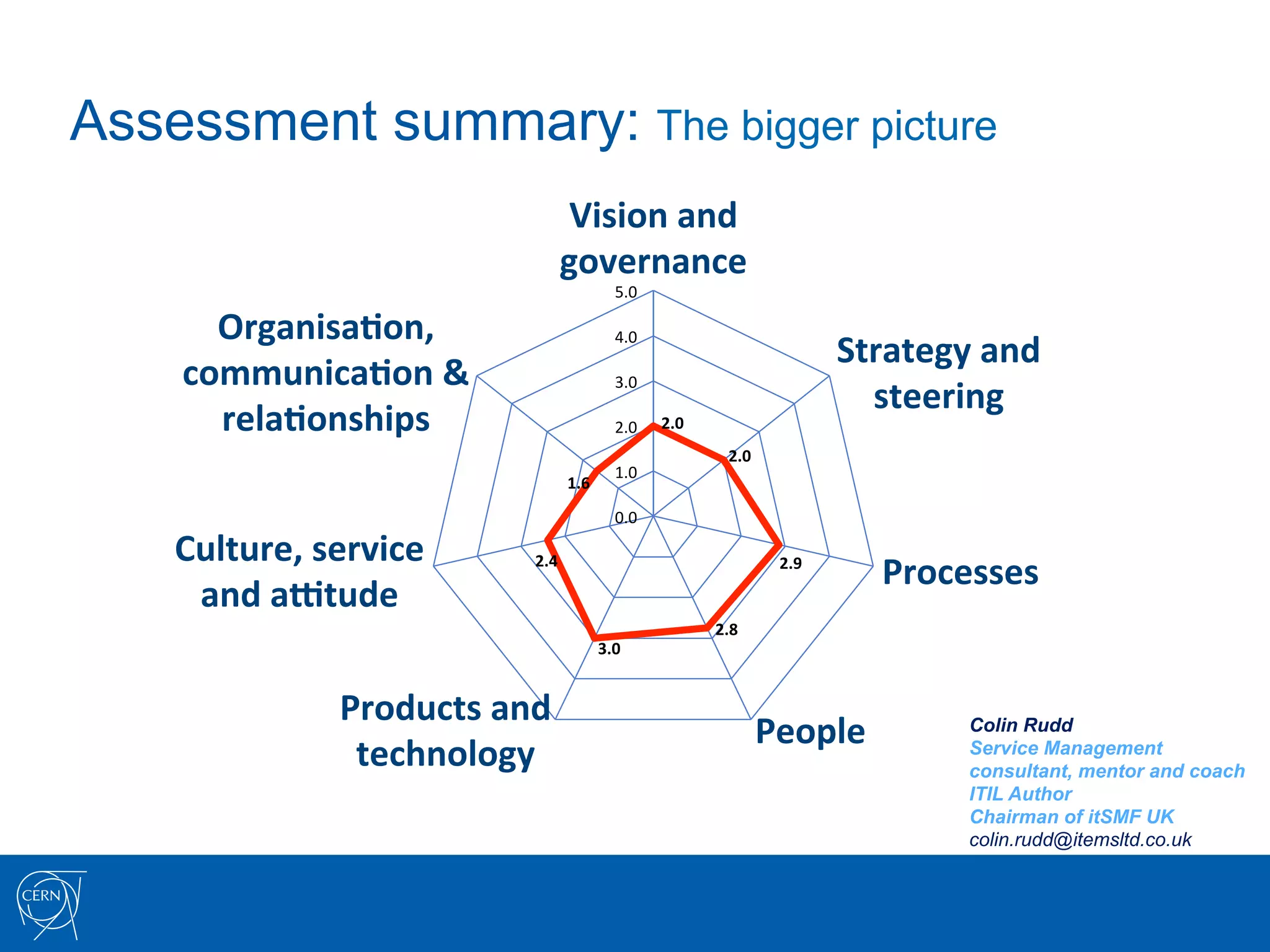

Assessment summary: The bigger picture
                                         Vision
  and

                                        governance

                                                          5.0

      OrganisaNon,

                                                                                                     Strategy
  and

                                                          4.0

    communicaNon
  &
                                   3.0

                                                                                                       steering

      relaNonships
                                      2.0
     2.0

                                                                                 2.0

                                                          1.0

                                            1.6

                                                          0.0

    Culture,
  service
         2.4
                                                    2.9

                                                                                                         Processes

     and
  atude

                                                                              2.8

                                                      3.0

                  Products
  and

                                                                                        People
                Colin Rudd
                   technology
                                                                                 Service Management
                                                                                                                consultant, mentor and coach
                                                                                                                ITIL Author
                                                                                                                Chairman of itSMF UK
                                                                                                                colin.rudd@itemsltd.co.uk

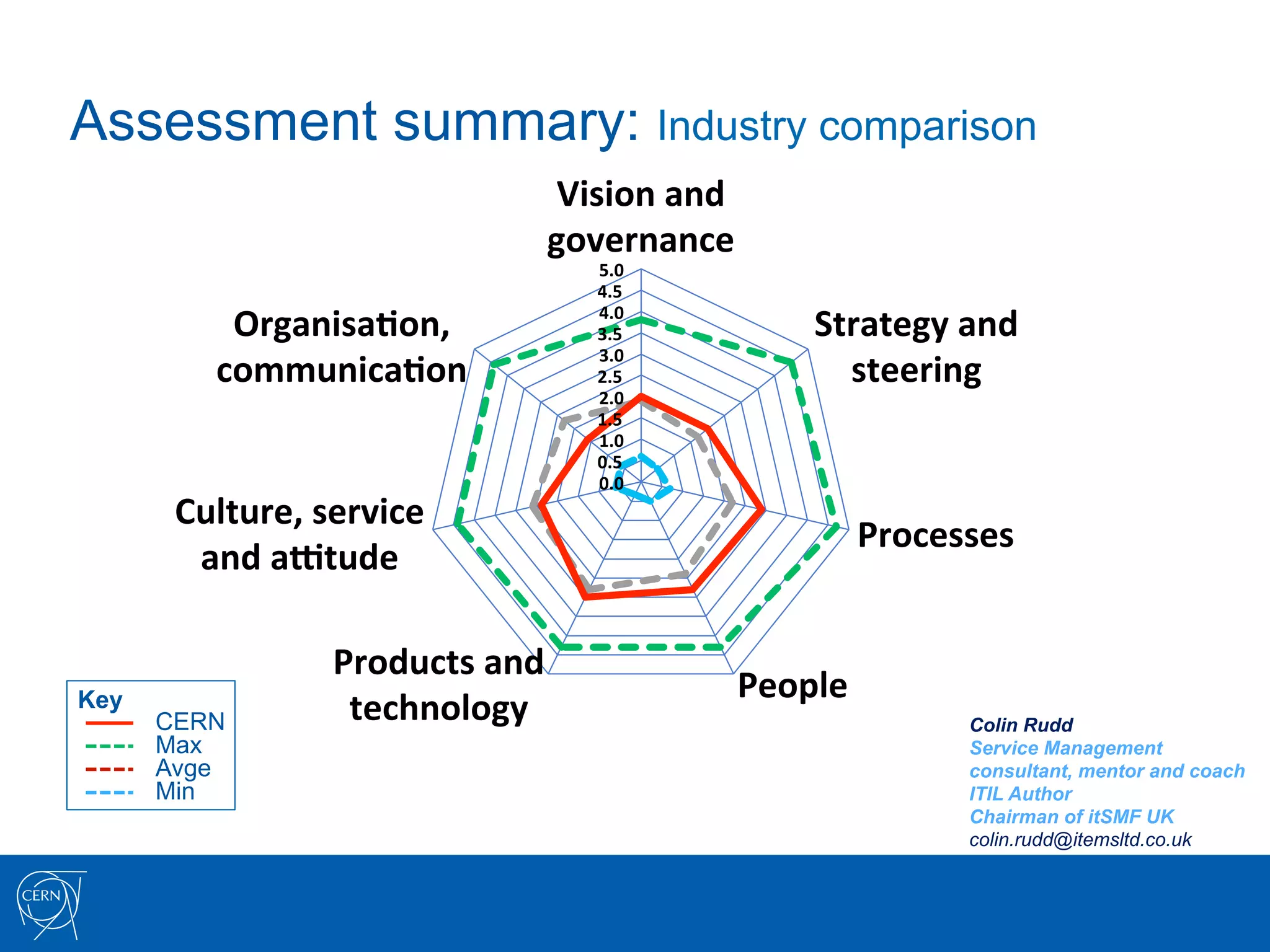

Assessment summary: Industry comparison
                                        Vision
  and

                                       governance

                                           5.0

                                           4.5

           OrganisaNon,
                  4.0

                                           3.5
              Strategy
  and

                                           3.0

          communicaNon
                   2.5
                steering

                                           2.0

                                           1.5

                                           1.0

                                           0.5

                                           0.0

       Culture,
  service

                                                                     Processes

        and
  atude

                     Products
  and

                                                        People

Key
      CERN            technology
                                           Colin Rudd
      Max                                                                    Service Management
      Avge                                                                   consultant, mentor and coach
      Min                                                                    ITIL Author
                                                                             Chairman of itSMF UK
                                                                             colin.rudd@itemsltd.co.uk

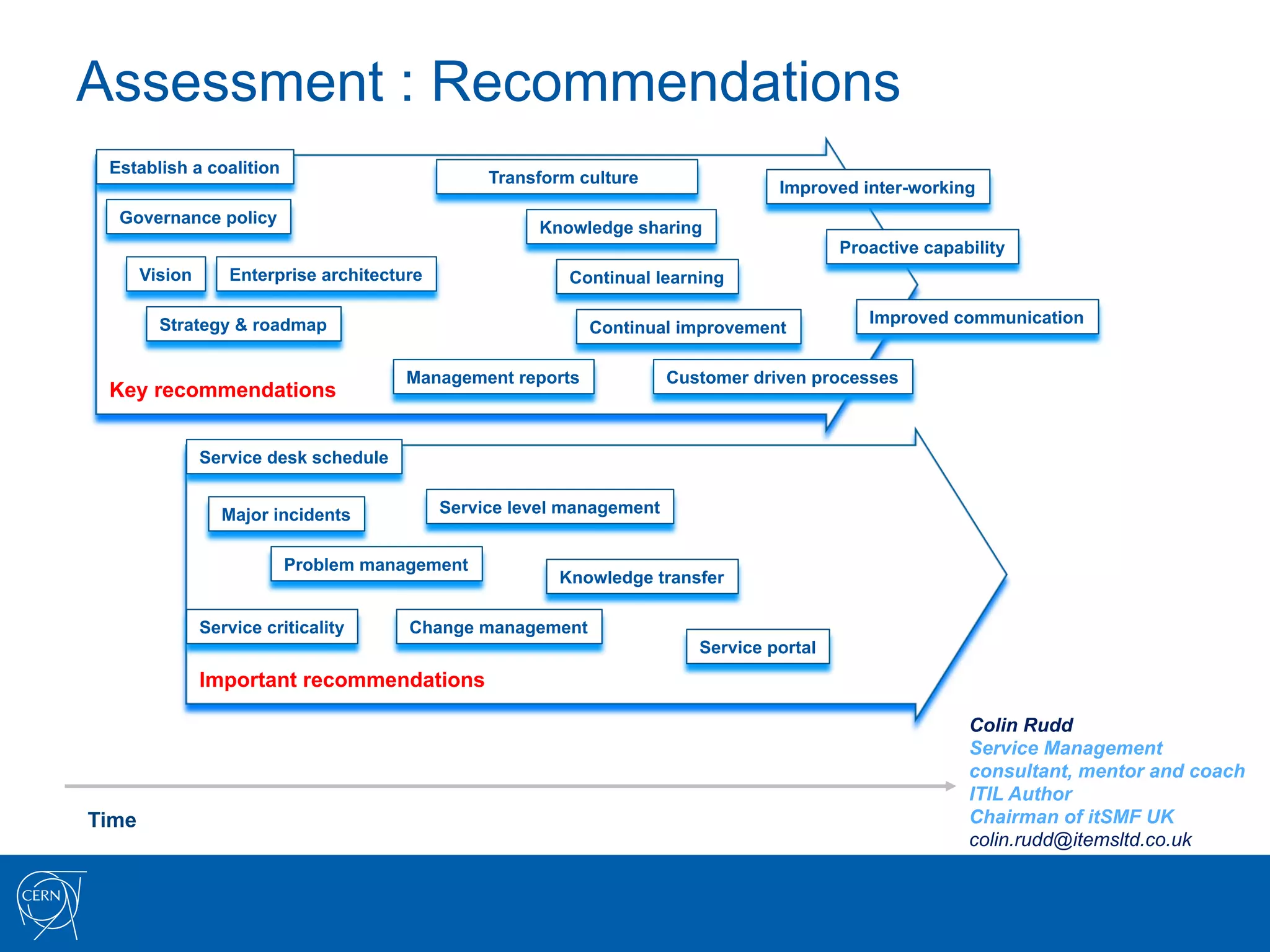

Assessment : Recommendations
 Establish a coalition
                                                  Transform culture
                                                                                    Improved inter-working
  Governance policy
                                                       Knowledge sharing
                                                                                            Proactive capability
       Vision      Enterprise architecture                 Continual learning

         Strategy & roadmap                                                                    Improved communication
                                                             Continual improvement

                                        Management reports              Customer driven processes
 Key recommendations

                Service desk schedule

                  Major incidents            Service level management

                           Problem management
                                                          Knowledge transfer

                Service criticality     Change management
                                                                           Service portal
                Important recommendations

                                                                                                           Colin Rudd
                                                                                                           Service Management
                                                                                                           consultant, mentor and coach
                                                                                                           ITIL Author
Time                                                                                                       Chairman of itSMF UK
                                                                                                           colin.rudd@itemsltd.co.uk

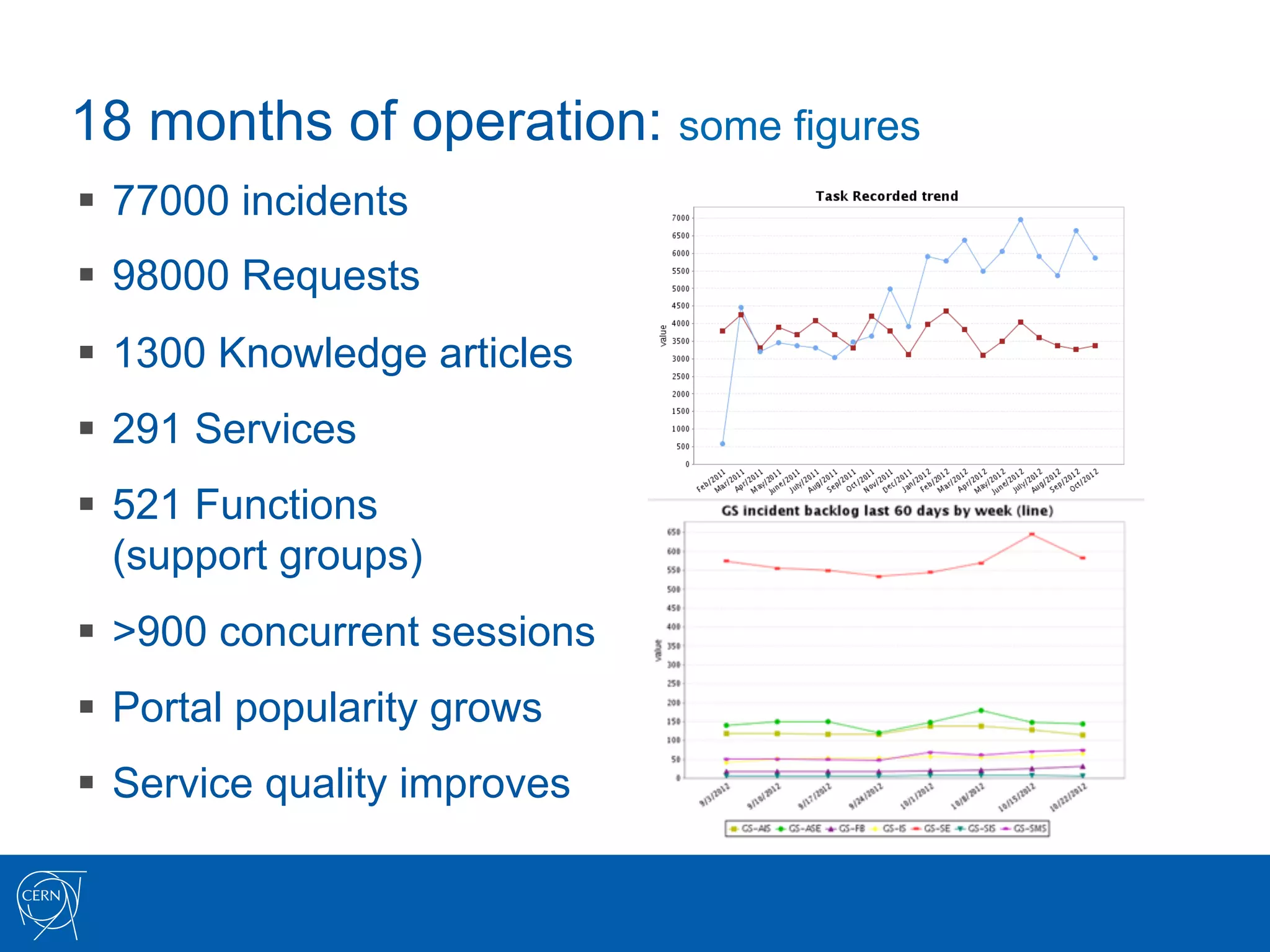

18 months of operation: some figures
§  77000 incidents
§  98000 Requests
§  1300 Knowledge articles
§  291 Services
§  521 Functions
    (support groups)
§  >900 concurrent sessions
§  Portal popularity grows
§  Service quality improves
What's next:
  §  Extend scope (More CERN Services)
  §  Improve service quality (process & people)
     §  Coach support teams using SLA / OLA / UC
  §  Include risk matrix in the system
  §  Change management
  §  Event management
  §  Implement the Colin Rudd recommendations

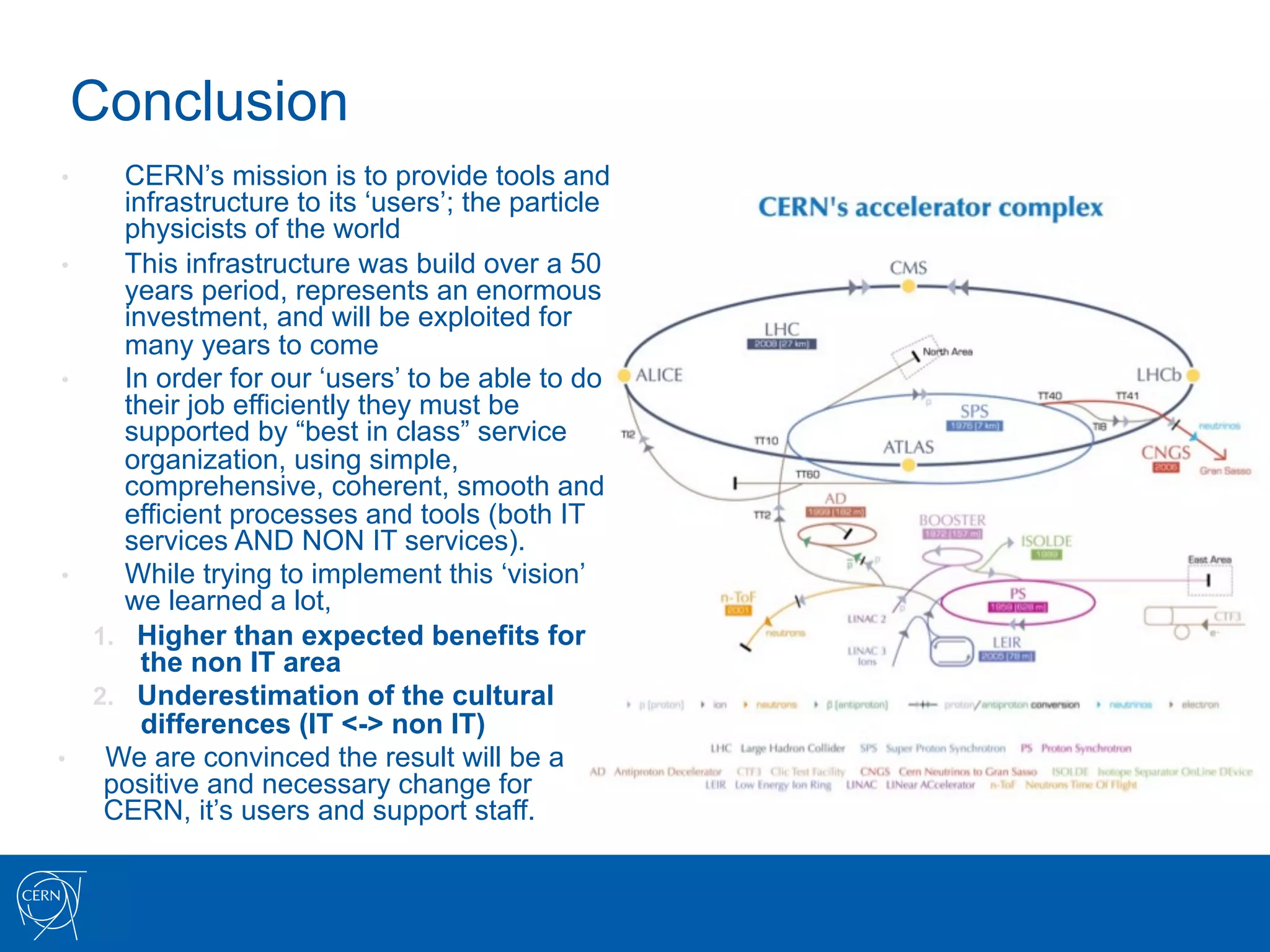

Conclusion
•       CERN’s mission is to provide tools and
        infrastructure to its ‘users’; the particle
        physicists of the world
•       This infrastructure was build over a 50
        years period, represents an enormous
        investment, and will be exploited for
        many years to come
•       In order for our ‘users’ to be able to do
        their job efficiently they must be
        supported by “best in class” service
        organization, using simple,
        comprehensive, coherent, smooth and
        efficient processes and tools (both IT
        services AND NON IT services).
•       While trying to implement this ‘vision’
        we learned a lot,
     1.  Higher than expected benefits for
          the non IT area
     2.  Underestimation of the cultural
          differences (IT <-> non IT)
•     We are convinced the result will be a
      positive and necessary change for
      CERN, it’s users and support staff.
Questions

            reinoud.martens@cern.ch

ServiceNow Event 15.11.2012 / ITIL for the Enterprise @CERN

  • 2.
    How service managementbest practice can be applied beyond IT Reinoud Martens CERN GS/SMS Maienfeld 15/11/2012
  • 3.
    Agenda •  Introduction to •  CERN •  CERN Service Management environment •  The project •  Definition •  Implementation •  Review •  Current situation •  Conclusion
  • 4.
    About CERN •  World’s largest particle physics centre •  World’s largest scientific instrument •  1954 - Europe’s first joint venture •  2012 - 20 member states - 2 associate members & 7 observers •  1.2 bn CHF budget •  ~ 2300 staff •  >1000 fellows, students LHC & project associates •  >10000 visiting scientists over 100 nationalities (half of world’s particle physicists)
  • 5.
    CERN’s missions Seeking answers to questions about the Universe. What is it made of? How did it come to be the way it is? Advancing the frontiers of technology and engineering. Uniting nations together through science. Today >10000 visiting scientists from more than 100 countries. Training young scientists and engineers who will be the experts of tomorrow.
  • 6.
    CERN : Facts& Fiction •  The World Wide Web was invented at CERN in 1989 by the British scientist Tim Berners-Lee. •  Some of the spin-offs: Improving cancer therapy technology, medical and industrial imaging, radiation processing, electronics, measuring instruments, new manufacturing processes and materials,.. •  CERN does unfortunately not own an X-33 aircraft as it was suggested in Dan Brown’s book “Angels and Demons”.
  • 7.
    The Physics Challenge The Large Hadron Collider (LHC) helps to find answers to fundamental questions •  The LHC, allows us to look at microscopic big bangs to understand the fundamental laws of nature •  Which questions: •  Why do particles have mass? •  Newton could not explain it and neither can we… •  What is 96% of the Universe made of? •  We only ‘know’ 4% of it! •  Why is there no antimatter left in the Universe? •  Nature should be symmetrical •  What was matter like during the first second of the Universe’s life, right after the "Big Bang"? •  A journey towards the beginning of the Universe will gives us deeper insight
  • 8.
    The Physics Challenge Theuniverse is a tough nut to crack. By smashing pieces of matter together, creating energies and temperatures not seen since the universe's earliest moments, the LHC could reveal the particles and forces that wrote the rules for everything that followed. It could help answer one of the most basic questions for any being in our universe: What is this place?
  • 9.
    The particle physicist’stoolbox collisions events Particle accelerator Experiments Data Analysis
  • 10.
    The particle physicist’stoolbox The accelerator complex •  LHC The world’s most powerful accelerator: •  A 27 km long tunnel filled with high-tech instruments •  Equipped with thousands of superconducting magnets •  Accelerates particles to energies never obtained before •  Produces particle collisions
  • 11.
    The particle physicist’stoolbox 4 Experiments : Very large sophisticated detectors §  Atlas experiment during construction : 7000 tons §  Hundred million measurement channels §  Data acquisition systems treating Petabytes per second
  • 12.
    The particle physicist’stoolbox •  Computing infrastructure to store, distribute and analyse the data •  A Computing Grid linking ~200 computer centres around the globe •  Sufficient computing power and storage to handle 15 Petabytes per year, making them available to thousands of physicists for analysis
  • 13.
    CERN, a placeof extremes The fastest racetrack on the planet… Trillions  of  protons  race  around  the  27km  ring  in     opposite  direc7ons  over  11,000  7mes  a  second,     travelling  at  99.999999991  per  cent  the  speed  of  light.
  • 14.
    CERN, a placeof extremes The emptiest space in the solar system… To  accelerate  protons  to  almost  the  speed  of  light  requires  a     vacuum  as  empty  as  interplanetary  space.  There  is  10  7mes     more  atmosphere  on  the  moon  than  there  is  in  the  LHC.
  • 15.
    CERN, a placeof extremes One of the coldest places in the universe.. With  an  opera7ng  temperature  of  about  -­‐271  degrees     Celsius,  just  1.9  degrees  above  absolute  zero,     the  LHC  is  colder  than  outer  space.
  • 16.
    CERN, a placeof extremes The hottest spots in the galaxy… When  two  beams  of  protons  collide,  they  generate   temperatures  1000  million  7mes  hoIer  than  the     heart  of  the  sun,  but  in  a  minuscule  space.
  • 17.
    CERN, a placeof extremes The biggest most sophisticated detectors ever built… ALICE To  sample  and  record  the  debris  from  up  to  600  million  proton     collisions  per  second,  scien7sts  are  building  gargantuan     devices  that  measure  par7cles  with  micron  precision.
  • 18.
    CERN, a placeof extremes One of the most extensive computer systems in the world… To  analyze  the  data,  tens  of  thousands  of  computers  around  the  world   are  being  harnessed  in  the  Grid.  The  laboratory  that  gave  the  world     the  web,  is  now  taking  distributed  compu7ng  a  big  step  further.
  • 19.
    CERN latest events CERN experiments observe particle consistent with long-sought Higgs boson Geneva, 4 July 2012. At a seminar held at CERN today as a curtain raiser to the year’s major particle physics conference, ICHEP2012 in Melbourne, the ATLAS and CMS experiments presented their latest preliminary results in the search for the long sought Higgs particle. Both experiments observe a new particle in the mass region around 125-126 GeV.
  • 20.
    CERN A laboratory withextreme requirements in many domains. How about service management ?
  • 21.
    Service management –What we think it IS ? •  Established industry best practice, used with success by thousands of organisations worldwide (“de facto” standard) •  A strategic framework, covering all services (not only IT) •  Business/customer/user focussed (focus on WHAT not HOW) •  A set of management processes covering the complete service lifecycle •  An approach to ‘adopt and adapt’ to ensure service solutions provide the best possible fit to the specific requirements of the organization Service management – What it IS NOT ! •  A tool (e.g. service now) •  A service desk •  A conspiracy to monitor people
  • 22.
    CERN Service ManagementEnvironment The Particle Physics community is bringing the world together … •  Our users! •  engineers •  physicists •  technicians •  administrators •  computer scientists •  craftspeople •  mechanics •  support personnel •  …
  • 23.
    CERN Service ManagementEnvironment The freedom of science… •  … is providing us every type of user!
  • 24.
    CERN Service ManagementEnvironment Services  we  are  covering  (1)  :   §  General IT services §  Physics specific IT services (including Grid) §  Medical Services & Fire Protection Services §  Civil Engineering & Facility Management §  Registration, Access & Safety Services §  Alarm System Services
  • 25.
    CERN Service ManagementEnvironment Services  we  are  covering  (2)  :   §  Visits & Outreach Services §  Material & Storage Services §  Mail & Shipping Services §  Library & Archive Services §  Housing Services §  HR, Finance & Legal Services
  • 26.
    CERN Service ManagementEnvironment Some  numbers   §  495 hotel rooms, 3 restaurants §  2 Sites, 657 Buildings, 238 Barracks §  15000 active access cards §  > 1000 cars §  5500 PC’s & 1500 MAC desktops §  6900 servers with 41000 cores §  14 PB disk space §  48 PB tape storage §  70000 network ports. feeding 34000 hosts
  • 27.
    CERN Service ManagementEnvironment Infrastructure & SERVICES   Support Accelerators & Technology Physics & Experiments
  • 28.
    CERN Service ManagementEnvironment         Services  ~25%   Accelerators  ~45%   Physics  ~30%   Director-­‐General  -­‐  Rolf-­‐Dieter  Heuer  ~  6%         DG  services  (Safety,  Legal,  Audit,  Planning,  VIP,  etc..)  ~  6%   X   AdministraNon  and  general  infrastructure  -­‐  Sigurd  LePow  ~  14%         FP  Finance,  Procurement  and  Knowledge  Transfer  -­‐  T.  Lagrange  ~  2.5%   X   GS  General  infrastructure  services  -­‐  T.  PeIersson  ~9%   X   HR  Human  resources  -­‐  A.-­‐S.  Catherin    ~  2.5%   X   Research  and  scienNfic  compuNng  -­‐  Sergio  Bertolucci  ~33%  +  CERN  USERS         IT  Informa7on  technology  -­‐  F.  Hemmer    ~9%   X   X   PH  Physics  -­‐  P.  Bloch  ~25%   X   Accelerators  and  technology  -­‐  Steve  Myers  ~  46%         BE  Beams  -­‐  P.  Collier  ~16%   X   EN  Engineering  -­‐  R.  Saban    ~14%   X   X   TE  Technology  -­‐  F.  Bordry      ~15%   X
  • 29.
    CERN Service ManagementEnvironment The situation 3 years ago. •  Infrastructure and services neglected in favor of LHC project •  Resources under scrutiny à desire for benchmarking, metrics, KPI’s •  CERN victim of LHC’s success à do more with less •  Realization of (lack of) maturity à wish to grow up •  Administration à Management Cockpit Project
  • 30.
    Awareness à Project •  Objectives •  Standard or framework •  Service structure •  Process definitions •  Roles of the people •  Implementation •  Review •  Current situation •  Conclusion
  • 31.
    Service Management forCERN Objectives 1.  One Service Desk for CERN (one number to ring, one place to go, 24/7 coverage) 2.  Standard Processes for all Service Providers at CERN (one behavior) 3.  Services defined from a User’s point of view 4.  Services easy to find by everybody, without knowledge of CERN internal structures 5.  Service and process quality measurable 6.  Improved collaboration over the borders of sections, groups and departments (break down silo’s) 7.  Very high level of automation of all known procedures 8.  Framework for continuous improvement in the fields of efficiency and effectiveness
  • 32.
    Which Standard /Framework ? ISO Different best practice for IT and NON IT services doesn’t look a brilliant idea
  • 33.
    Choice: ITIL V3framework, but •  Remove all references to IT (for the non IT people) •  Stay PRAGMATIC (only take what is useful; leave the rest for ‘later’ J) •  No Extremism, No over-engineering Service Management team
  • 34.
    Service structure in2009 Technical Expert Users (Institutes Administrative Users Experiments) Users §  High level experts in all areas §  Functional “elements” scattered around §  Different types of users with different interests §  No comprehensible communication framework §  No structured service offering §  No central contact point to find what you need
  • 35.
    Service structure (BusinessService Catalogue) •  Customer Services & Service Elements •  From the user‘s point of view (new for CERN) •  Different for different types of users •  Combination of functional elements to provide a complete functionality for users •  New „Service Owner“ Roles representing Services •  Related to users
  • 36.
    Service structure (BusinessService Catalogue) •  Functional Services •  Lists all technical services, activities & functions •  Group and Section leaders in charge of all quality and resource related topics •  Related to „support groups“ – groups of experts that perform 2nd and 3rd line support
  • 37.
    Service structure (BusinessService Catalogue) 2 dimensional Service Catalogue •  Covers all Services provided •  Lists all Functional Services •  Connecting both sides of the catalogue •  Contains classification to shows level of importance •  Foundation for Process Automation & Service Portal •  Contains: •  Services (240) •  Functions (462) •  Relations (~1800) Culture Change Shift from How à What Shift from Function à Service
  • 38.
    Service structure (ServiceDesk & Portal) Users in Projects Administrative Expert Users and Experiments Users Service Desk Service Web Portal Common Tool
  • 39.
    Process Definition: Incident& Request (Business) Impact Priority Matrix 1  Down 2  Degraded 3  Affected 4  Disrupted critical  advers e   major  advers e  impact   minor  advers e  impact   s mall  number  o f  t he   impact  o n  t he  s ervice on  t he  s ervice on  t he  s ervice population  affected 1  High:  T he  d amag e  c aus ed   1 2 3 4 Urgency by  t he  Incident  increas es  rapidly. Major High Moderate Low 2  Medium:  T he  d amag e   2 3 4 5 caus ed  b y  t he  Incident  increas es   cons iderably  o ver  t ime High Moderate Low Planning 3  Low: T he  d amag e  c aus ed   3 4 5 6 by  t he  Incident  o nly  marg inally   increas es  o ver  t ime Moderate Low Planning Very Low
  • 40.
  • 41.
    Process Definition (status) Finalized: • Incident, Request & Change •  Business Service Catalogue management •  Knowledge management •  Service level management In preparation: •  Major incident handling •  Outage handling & Status boards •  Event management
  • 42.
    Service Management Roledefinitions Service Desk User Manager Assistance Supervis Service es Manager On Duty Use Customer Service Desk Services Ass igns To Coordinates Support Groups functions Supe rvise Functional d Service Manager Coordinates Service Owner
  • 43.
    Tool Selection (Afterprocess and catalog definition!) Legend: Tool Service  Now Remedy Service  Desk  Express iET  ITSM Omnitracker Service  Desk  plus Easy  V ista OTRS ITSM S-­‐BPM  Suite TrackIT TicketXpert Incident  Monitor Service  Manager ExpertDesk Service  Desk Service  Manager  7 Tivoli Valuemation POB Service  Management Service  Desk  Manager 20  /20 MSM iWise e-­‐Service  Desk SupportDesk  ITSM SMI  Suite Service  Management  Suite ITSM Help  Desk TopDesk Help  Desk Service  Desk Service  Desk helpLine Service  Desk Assyst  7.5 "Score":  Rating  from  0  ( feature  not  available,  not  programmable)  to  5  ( full  functionality  provided  out  of  the  box,  no   extra  e ffort  required). "Configuration/programming  e ffort":  Optional  field  for  defining  customization/programming  e ffort.  V alues   entered  here  will  be  used  mainly  for  detailed  distinction  i n  case  of  undecision. "Additional  comments":  Optional  field  for  additional  helpful  comments  aimed  at  progressing  tool  selection. Downselect Manufacturer service-­‐now.com BMC   BMC iET  Solutions Omninet Manage  Engine Staff  &  Line OTRS Frontrange jcom1 Numara isonet Monitor  24  -­‐  7  i nc. Livetime Mansystems Overall  score  i s  determined  by  multiplying  Weight  and  out-­‐of-­‐the-­‐box  rating;  a  0  rating  for  a  "Must-­‐have"  feature   leads  to  automatic  failure. Definition  of  Weight  values  :  5=must  have,  3=should  have,  1=nice  to  have Score  values:  5  =  Out  of  the  box,  4  =  customisation/configuration,  3=  scripting,  2=minor  programming,    1=application   programming  0=not  possible,  Effort  in  mandays Matrix  42 HP IBM USU Wendia Cherwell CA Sunrise Marvel InfraWise ICCM House  on  the  Hill Westbury Priox Epicor iNet TopDesk Nilex Naumen LAN  Desk helpLine Easit Axios  Systems Provider Aspediens IT  Concepts IT  Concepts Fritz  &  Maciol Fritz  &  Maciol Main  Category Configurat Configurat Configurat Configurat Configurat Configurat Configurat Configurat Configurat Configurat Configurat Configurat Configurat Configurat Configurat Configurat Configurat Configurat Configurat Configurat Configurat Configurat Configurat Configurat Configurat Configurat Configurat Configurat Configurat Configurat Configurat Configurat Configurat Configurat Configurat Configurat Configurat Configurat Additional   Additional   Additional   Additional   Additional   Additional   Additional   Additional   Additional   Additional   Additional   Additional   Additional   Additional   Additional   Sub-­‐category Weight Score ion/   Score ion/   Score ion/   Score ion/   Score ion/   Score ion/   Score ion/   Score ion/   Score ion/   Score ion/   Score ion/   Score ion/   Score ion/   Score ion/   Score ion/   Score ion/   Score ion/   Score ion/   Score ion/   Score ion/   Score ion/   Score ion/   Score ion/   Score ion/   Score ion/   Score ion/   Score ion/   Score ion/   Score ion/   Score ion/   Score ion/   Score ion/   Score ion/   Score ion/   Score ion/   Score ion/   Score ion/   Score ion/   comments comments comments comments comments comments comments comments comments comments comments comments comments comments comments High-­‐level  Criteria programm programm programm programm programm programm programm programm programm programm programm programm programm programm programm programm programm programm programm programm programm programm programm programm programm programm programm programm programm programm programm programm programm programm programm programm programm programm Individual  e lements Current  Process  Requirements Current  Process  Requirements    -­‐  Score  (35%  of  overall  score) 35 0                        -­‐   0                        -­‐   0                        -­‐   0                        -­‐   0                        -­‐   0                        -­‐   0                        -­‐   0                        -­‐   0                        -­‐   0                        -­‐   0                        -­‐   0                        -­‐   0                        -­‐   0                        -­‐   0                        -­‐   Future  Use  Requirements Future  Use  Requirements    -­‐  Score  (10%  of  overall  score) 10 0                        -­‐   0                        -­‐   0                        -­‐   0                        -­‐   0                        -­‐   0                        -­‐   0                        -­‐   0                        -­‐   0                        -­‐   0                        -­‐   0                        -­‐   0                        -­‐   0                        -­‐   0                        -­‐   0                        -­‐   Interface  Requirements Interface  Requirements    -­‐  Score  (15%  of  overall  score) 15 0                        -­‐   0                        -­‐   0                        -­‐   0                        -­‐   0                        -­‐   0                        -­‐   0                        -­‐   0                        -­‐   0                        -­‐   0                        -­‐   0                        -­‐   0                        -­‐   0                        -­‐   0                        -­‐   0                        -­‐   Technical  Requirements  ( requirements  that  are  not  applicable  can  be  i gnored) Technical  Requirements  (requirements  that  are  not  applicable  can  be  ignored)    -­‐  Score  (10%  of  overall  score) 10 0                        -­‐   0                        -­‐   0                        -­‐   0                        -­‐   0                        -­‐   0                        -­‐   0                        -­‐   0                        -­‐   0                        -­‐   0                        -­‐   0                        -­‐   0                        -­‐   0                        -­‐   0                        -­‐   0                        -­‐   Measurement  Requirements Measurement  Requirements    -­‐  Score  (5%  of  overall  score) 5 0                        -­‐   0                        -­‐   0                        -­‐   0                        -­‐   0                        -­‐   0                        -­‐   0                        -­‐   0                        -­‐   0                        -­‐   0                        -­‐   0                        -­‐   0                        -­‐   0                        -­‐   0                        -­‐   0                        -­‐   Reporting  Requirements Reporting  Requirements    -­‐  Score  (5%  of  overall  score) 5 0                        -­‐   0                        -­‐   0                        -­‐   0                        -­‐   0                        -­‐   0                        -­‐   0                        -­‐   0                        -­‐   0                        -­‐   0                        -­‐   0                        -­‐   0                        -­‐   0                        -­‐   0                        -­‐   0                        -­‐   Hosting  schemes  ( no  i mpact  final  score,  as  one  or  more  of  these  schemes  are  always  present) Hosting  schemes  (no  impact  final  score,  as  one  or  more  of  these  schemes  are  always  present)    -­‐  Score  (0%  of  overall  score) 0 0                        -­‐   0                        -­‐   0                        -­‐   0                        -­‐   0                        -­‐   0                        -­‐   0                        -­‐   0                        -­‐   0                        -­‐   0                        -­‐   0                        -­‐   0                        -­‐   0                        -­‐   0                        -­‐   0                        -­‐   Licence  Model  and  costs  ( Info  to  be  provided  i n  cost  and  comments  column) Licence  Model  and  costs  (Info  to  be  provided  in  cost  and  comments  column)    -­‐  Score  (10%  of  overall  score) 10 0                        -­‐   0                        -­‐   0                        -­‐   0                        -­‐   0                        -­‐   0                        -­‐   0                        -­‐   0                        -­‐   0                        -­‐   0                        -­‐   0                        -­‐   0                        -­‐   0                        -­‐   0                        -­‐   0                        -­‐   General  Quality  Factors General  Quality  Factors    -­‐  Score  (10%  of  overall  score) 10 0                        -­‐   0                        -­‐   0                        -­‐   0                        -­‐   0                        -­‐   0                        -­‐   0                        -­‐   0                        -­‐   0                        -­‐   0                        -­‐   0                        -­‐   0                        -­‐   0                        -­‐   0                        -­‐   0                        -­‐   0                        -­‐   0                        -­‐   0                        -­‐   0                        -­‐   0                        -­‐   0                        -­‐   0                        -­‐   0                        -­‐   0                        -­‐   0                        -­‐   0                        -­‐   0                        -­‐   0                        -­‐   0                        -­‐   0                        -­‐   0                        -­‐   0                        -­‐   0                        -­‐   0                        -­‐   0                        -­‐   0                        -­‐   0                        -­‐   0                        -­‐   TOTAL  SCORE 100 0                        -­‐   0                        -­‐   0                        -­‐   0                        -­‐   0                        -­‐   0                        -­‐   0                        -­‐   0                        -­‐   0                        -­‐   0                        -­‐   0                        -­‐   0                        -­‐   0                        -­‐   0                        -­‐   0                        -­‐   Preselection  criteria %  of  score Service  Now Remedy Service  Desk  Express iET  ITSM Omnitracker Service  Desk  plus Easy  Vista OTRS ITSM S-­‐BPM  Suite TrackIT TicketXpert Incident  Monitor Service  Manager ExpertDesk Service  Desk Service  Manager  7 Tivoli Valuemation POB Service  Management Service  Desk  Manager 20  /20 MSM iWise e-­‐Service  Desk SupportDesk  ITSM SMI  Suite Service  Management  Suite ITSM Help  Desk TopDesk Help  Desk Service  Desk Service  Desk helpLine Service  Desk Assyst  7.5 Customer  e xperience 20 4 3 2 4 5 5 4 2 1 3 3 4 3 3 3 0 0 5 3 0 0 0 0 0 3 3 3 3 3 3 0 0 0 0 3 0 3 0 Implementation  e ffort  ( feasible  roll  out  within  4  months) 15 5 1 4 4 3 3 4 3 3 3 3 3 3 3 3 3 3 0 0 0 3 0 3 0 0 0 3 0 3 0 3 0 3 3 0 3 3 0 Provider's  viability  and  completeness  of  vision 15 5 5 4 3 5 3 4 5 3 3 3 3 4 3 3 5 5 3 3 3 0 5 3 3 3 3 0 5 0 3 0 3 0 0 3 3 0 3 Native  relevant    ITIL  best-­‐practice  content 10 5 3 4 5 3 1 5 0 1 0 0 3 5 5 3 Fully  Web  2.0  based  ( Back  office  &  Portal) 10 5 2 5 4 3 5 5 3 3 3 4 5 5 3 Technology  Stack  Compatability 10 4 5 4 3 3 5 1 3 3 3 5 4 5 3 Product  Design  Quality  &  Maturity 20 4 3 2 4 4 3 3 0 0 3 3 3 3 3 TOTAL  SCORE 100 4.56 3.00 3.40 3.95 3.90 3.40 4.10 2.00 1.80 2.57 2.70 3.50 3.65 3.60 3.00 2.40 2.40 2.90 2.10 0.90 0.90 1.50 1.80 0.90 2.10 2.10 2.10 2.70 2.10 2.10 0.90 0.90 0.90 0.90 2.10 1.80 2.10 0.90 http://www.itsmportal.com/tools?searchtext=service%20management&action=search&op=Search&form_build_id=form-­‐963bb6a68bcce30357e7bd0ba6c94292&form_id=querytools_form Pink  V erify  2.0  toolsets  ( ITIL  V 2) yes YES YES yes YES yes Pink  V erify  3.0  toolsets YES  2009  release YES  Remedy  7.0 YES NO yes YES  2.0 YES  9.0   YES  Footprint           YES YES   YES  SERVICE-­‐MANAGFEMENT  7.0     YES YES                     YES YES   YES   YES Pink  V erify  3.1  toolsets YES  Service-­‐manager  7.1 YES  SERVICE  DESK  4 •  40 Tools evaluated in the pre-selection phase •  6 Tools evaluated in detail (300 questions) •  2 Tools in the final competition (on site demo, hands on, and reference visits) •  Tool Selected – 100% Web based - SAAS •  Considered Requirements: •  Processes •  Service Catalogue •  Measurement & Reporting •  Technical (Architecture) •  Interface •  Future Needs
  • 44.
    Tool Implementation Phase 1– Do the basics to get operational (autumn 2010) : •  Business Service catalogue ( CERN design & implementation ) •  Incident & Request ( existing basic processes – CERN catalogue automation ) •  Service portal ( CERN design & implementation) Phase 2 – Grow the system while acquiring experience (2011) : •  Service level management (out of the box for incident / CERN build fro request) •  Reporting ( ok for operational reports disappointing for •  Functional improvements (many requirements / •  Interfaces to other “ticket” systems ( GRID computing, Assed management ..) •  Knowledge management (adapted to the business service catalogue) •  Change management ( CERN build simplified process ) Phase 3 (2012) •  Process & tool improvements •  Event management (CERN implementation)
  • 45.
    Tool Implementation •  Business Service Catalogue driven •  Access from both dimensions •  Service à Function •  Functions à Service •  Highly automated •  Support Assignments •  SLA & OLA •  Performance reporting
  • 46.
    Tool Implementation (ServicePortal) §  User access to all services §  Search function §  Browse the catalogue §  Report issues §  Follow issues §  Access knowledge base
  • 47.
    Service Management forCERN How did we go about it? §  External ITIL expert knowledge and experience §  Ncc Management Consultants (Experts in ITIL applied to non IT) §  2 dimensional Service Matrix proven in practice §  Specific experience in huge organizations §  Tool implementation §  Aspediens: expert coaching §  ServiceNow: good relations with the tool manufacturer §  Initially 2 Departments (IT & General Services) §  Initially 2 Processes (Incident, Request) §  Grow and Improve gradually §  More departments (Finance, Human Resources) §  More processes (Change, Problem, Event, Knowledge, …)
  • 48.
    Service Management roadmap 2009   •  Service Catalogue & Matrix •  Service Role (e.g. Service Owner) Definitions Concepts •  Process Design •  Web Portal & Service Repository •  Service Descriptions 2010   Data and •  Service Management Tool Evaluation Tools •  SM Tool Implementation (Oct 2010 .. Feb 2011) •  Service Desk Planning & Staffing Implemen tation •  Role Assignments •  Training 2011   •  Consolidation Rollout •  Change, Knowledge & Service level management Review •  Improve •  More Processes (Event, Problem & Outage) Operation •  Extended Scope 2012
  • 49.
    Project Review §  Qualityreview by ITIL senior consultant (Colin Rudd - autumn 2011) §  Approach: §  Interviews with key staff involved in all area’s of service management activities §  Interviews with representatives of the user community §  Identify and quantify the current level of service management maturity §  Results: §  Report on strengths, weaknesses and gaps with prioritized recommendations for improvements
  • 50.
    Assessment summary: Process& Functions Incident 5 4.5 Request 4 3.5 Portal 3 Event 2.5 2 1.5 Technical 1 Problem 0.5 0 Desk Change Knowledge Colin Rudd Supplier SLM Service Management consultant, mentor and coach SCM ITIL Author Chairman of itSMF UK colin.rudd@itemsltd.co.uk
  • 51.
    Assessment summary: Process& Functions 5 4.5 4 Processes Functions 3.5 3 2.5 2 1.5 1 0.5 0 Colin Rudd Service Management consultant, mentor and coach ITIL Author Chairman of itSMF UK colin.rudd@itemsltd.co.uk
  • 52.
    Assessment summary: Thebigger picture Vision  and   governance   5.0   OrganisaNon,   Strategy  and   4.0   communicaNon  &   3.0   steering   relaNonships   2.0   2.0   2.0   1.0   1.6   0.0   Culture,  service   2.4   2.9   Processes   and  atude   2.8   3.0   Products  and   People   Colin Rudd technology   Service Management consultant, mentor and coach ITIL Author Chairman of itSMF UK colin.rudd@itemsltd.co.uk
  • 53.
    Assessment summary: Industrycomparison Vision  and   governance   5.0   4.5   OrganisaNon,   4.0   3.5   Strategy  and   3.0   communicaNon   2.5   steering   2.0   1.5   1.0   0.5   0.0   Culture,  service   Processes   and  atude   Products  and   People   Key CERN technology   Colin Rudd Max Service Management Avge consultant, mentor and coach Min ITIL Author Chairman of itSMF UK colin.rudd@itemsltd.co.uk
  • 54.
    Assessment : Recommendations Establish a coalition Transform culture Improved inter-working Governance policy Knowledge sharing Proactive capability Vision Enterprise architecture Continual learning Strategy & roadmap Improved communication Continual improvement Management reports Customer driven processes Key recommendations Service desk schedule Major incidents Service level management Problem management Knowledge transfer Service criticality Change management Service portal Important recommendations Colin Rudd Service Management consultant, mentor and coach ITIL Author Time Chairman of itSMF UK colin.rudd@itemsltd.co.uk
  • 55.
    18 months ofoperation: some figures §  77000 incidents §  98000 Requests §  1300 Knowledge articles §  291 Services §  521 Functions (support groups) §  >900 concurrent sessions §  Portal popularity grows §  Service quality improves
  • 56.
    What's next: §  Extend scope (More CERN Services) §  Improve service quality (process & people) §  Coach support teams using SLA / OLA / UC §  Include risk matrix in the system §  Change management §  Event management §  Implement the Colin Rudd recommendations
  • 57.
    Conclusion •  CERN’s mission is to provide tools and infrastructure to its ‘users’; the particle physicists of the world •  This infrastructure was build over a 50 years period, represents an enormous investment, and will be exploited for many years to come •  In order for our ‘users’ to be able to do their job efficiently they must be supported by “best in class” service organization, using simple, comprehensive, coherent, smooth and efficient processes and tools (both IT services AND NON IT services). •  While trying to implement this ‘vision’ we learned a lot, 1.  Higher than expected benefits for the non IT area 2.  Underestimation of the cultural differences (IT <-> non IT) •  We are convinced the result will be a positive and necessary change for CERN, it’s users and support staff.
  • 58.
    Questions reinoud.martens@cern.ch
