Case Study: Toward Building
a New Intranet
Teach for All

August 1, 2012

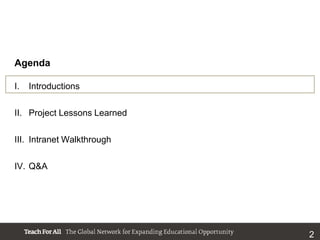

Agenda

I.   Introductions

II. Project Lessons Learned

III. Intranet Walkthrough

IV. Q&A

                              2
About Us

           Andy Ho, Senior Director, Information Technology
              – Leads the IT team at Teach For All
              – Background in IT management and consulting
                with Crestron Electronics, Deloitte
                Consulting, and American Management Systems

           Amy Grandov, Director, Business Analysis
             – Manages enterprise application projects
             – Previously with McKinsey, focusing on knowledge
                management, collaboration and business
                intelligence systems

                                                                 3
About Teach for All

          “Teach for All is a global network of
    independent social enterprises that are working
       to expand educational opportunity in their
    nations by enlisting their most promising future
    leaders in the effort. We aspire to the vision that
    one day, all children will have the opportunity to
             attain an excellent education”

                                                          4
About Teach for All

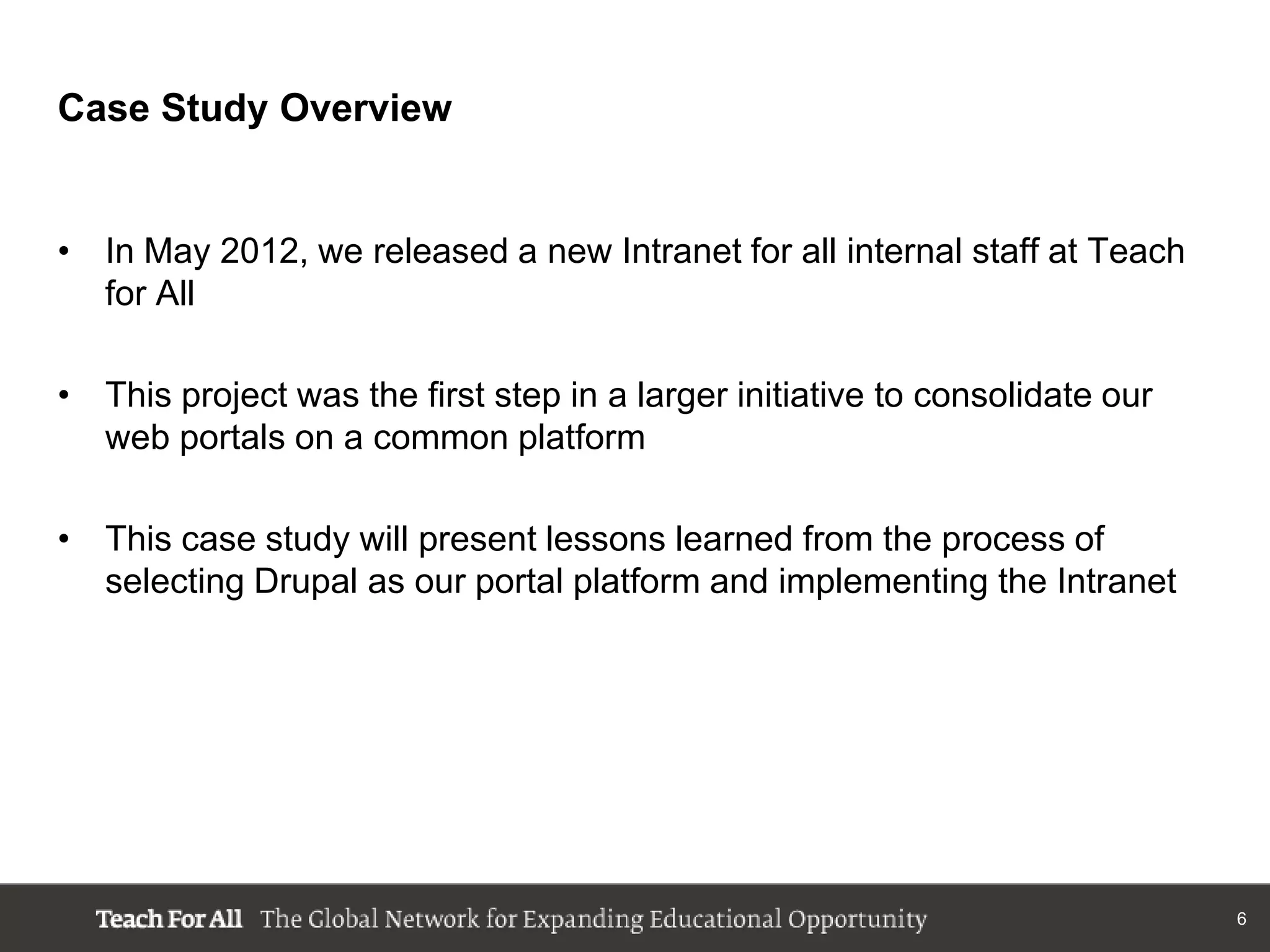

Case Study Overview

• In May 2012, we released a new Intranet for all internal staff at Teach
  for All

• This project was the first step in a larger initiative to consolidate our
  web portals on a common platform

• This case study will present lessons learned from the process of
  selecting Drupal as our portal platform and implementing the Intranet

                                                                              6

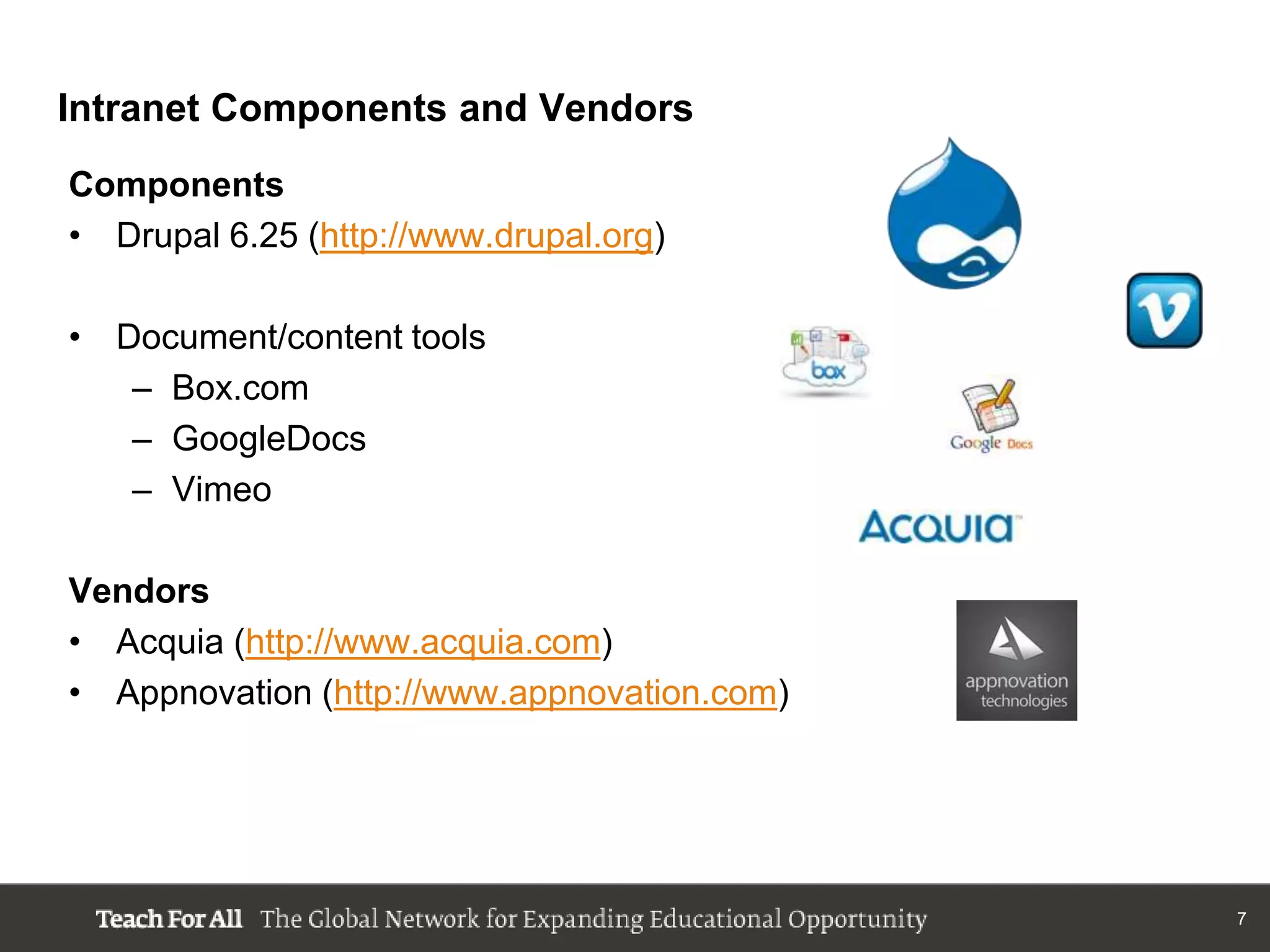

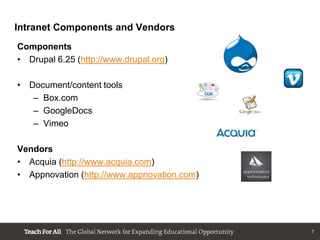

Intranet Components and Vendors
Components
• Drupal 6.25 (http://www.drupal.org)

• Document/content tools
   – Box.com
   – GoogleDocs
   – Vimeo

Vendors
• Acquia (http://www.acquia.com)
• Appnovation (http://www.appnovation.com)

                                             7

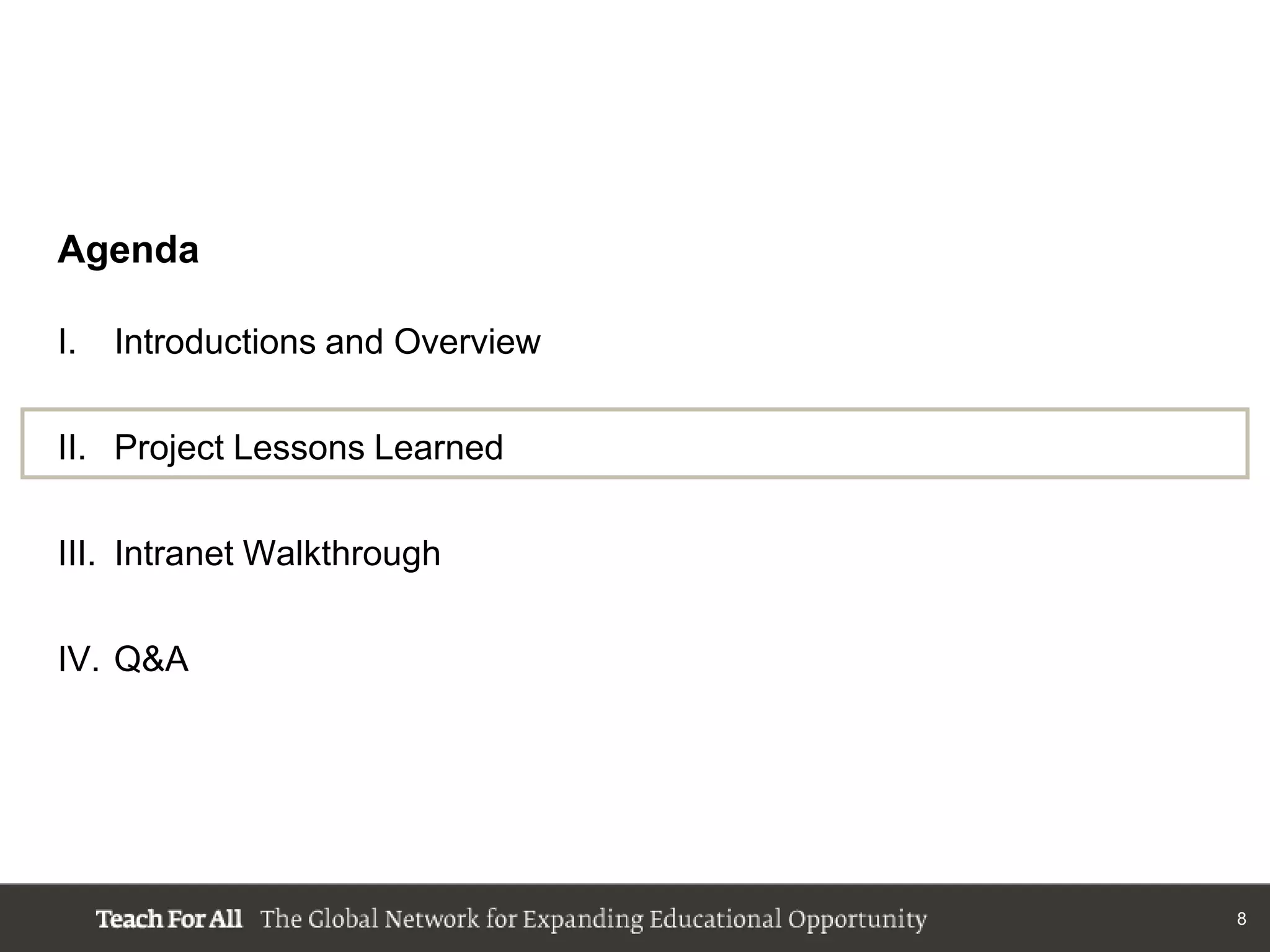

Agenda

I.   Introductions and Overview

II. Project Lessons Learned

III. Intranet Walkthrough

IV. Q&A

                                  8
Project Lessons Learned

     Define business objectives before discussing technology

  Understand your unique requirements when selecting a platform

                Get user feedback early and often

                                                                  9

Project Lessons Learned

     Define business objectives before discussing technology

  Understand your unique requirements when selecting a platform

                Get user feedback early and often

                                                                  10
Defining the Problem

 "Would you tell me, please, which way I ought to go from here?”
 "That depends a good deal on where you want to get to," said the
 Cat.
 "I don’t much care where--" said Alice.
 "Then it doesn’t matter which way you go," said the Cat.
 "--so long as I get SOMEWHERE," Alice added as an explanation.
 "Oh, you’re sure to do that," said the Cat, "if you only walk long
 enough.”
 (Alice's Adventures in Wonderland)

                                                                      11

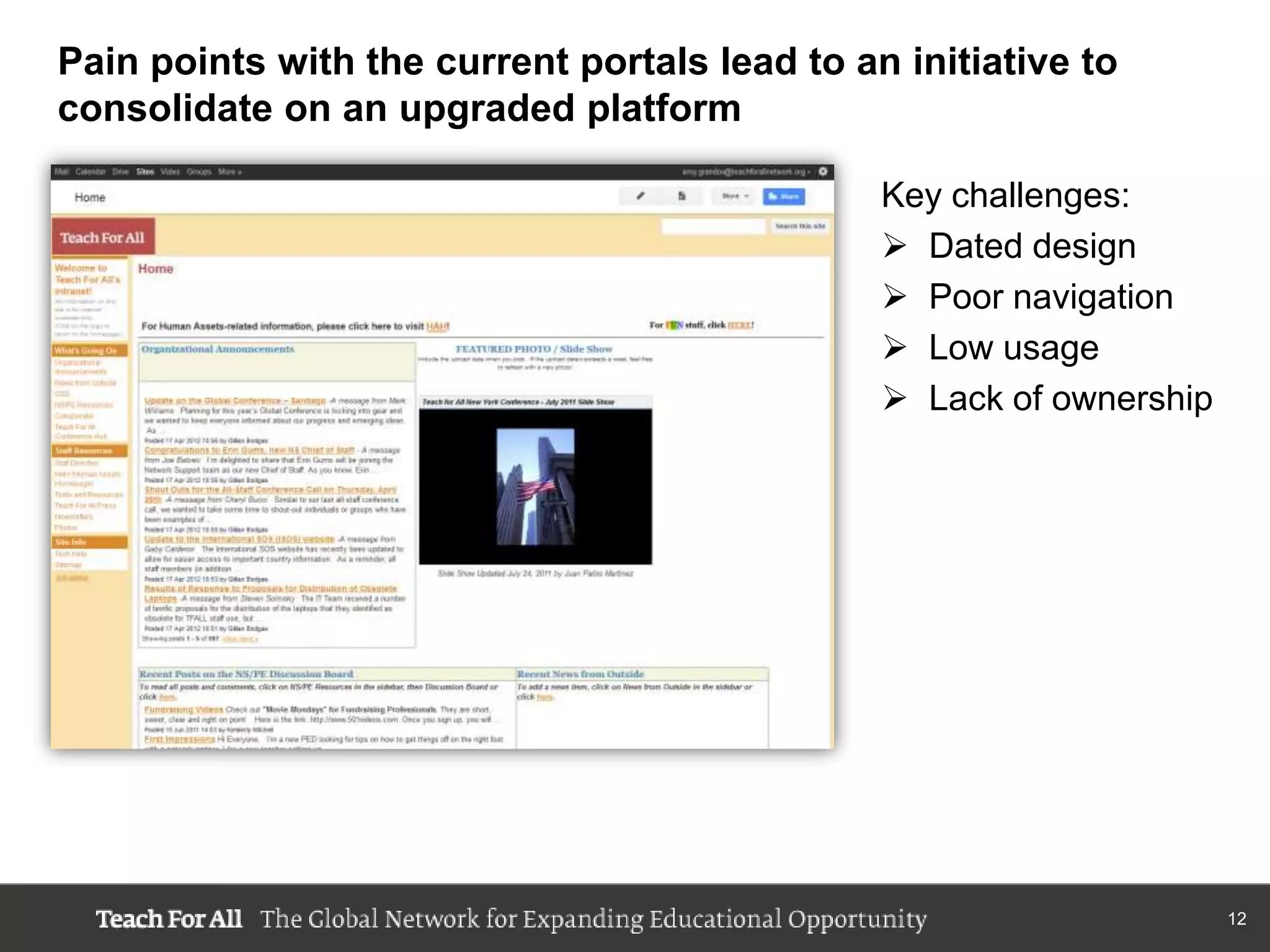

Pain points with the current portals lead to an initiative to
consolidate on an upgraded platform

                                               Key challenges:
                                                Dated design
                                                Poor navigation
                                                Low usage
                                                Lack of ownership

                                                                     12

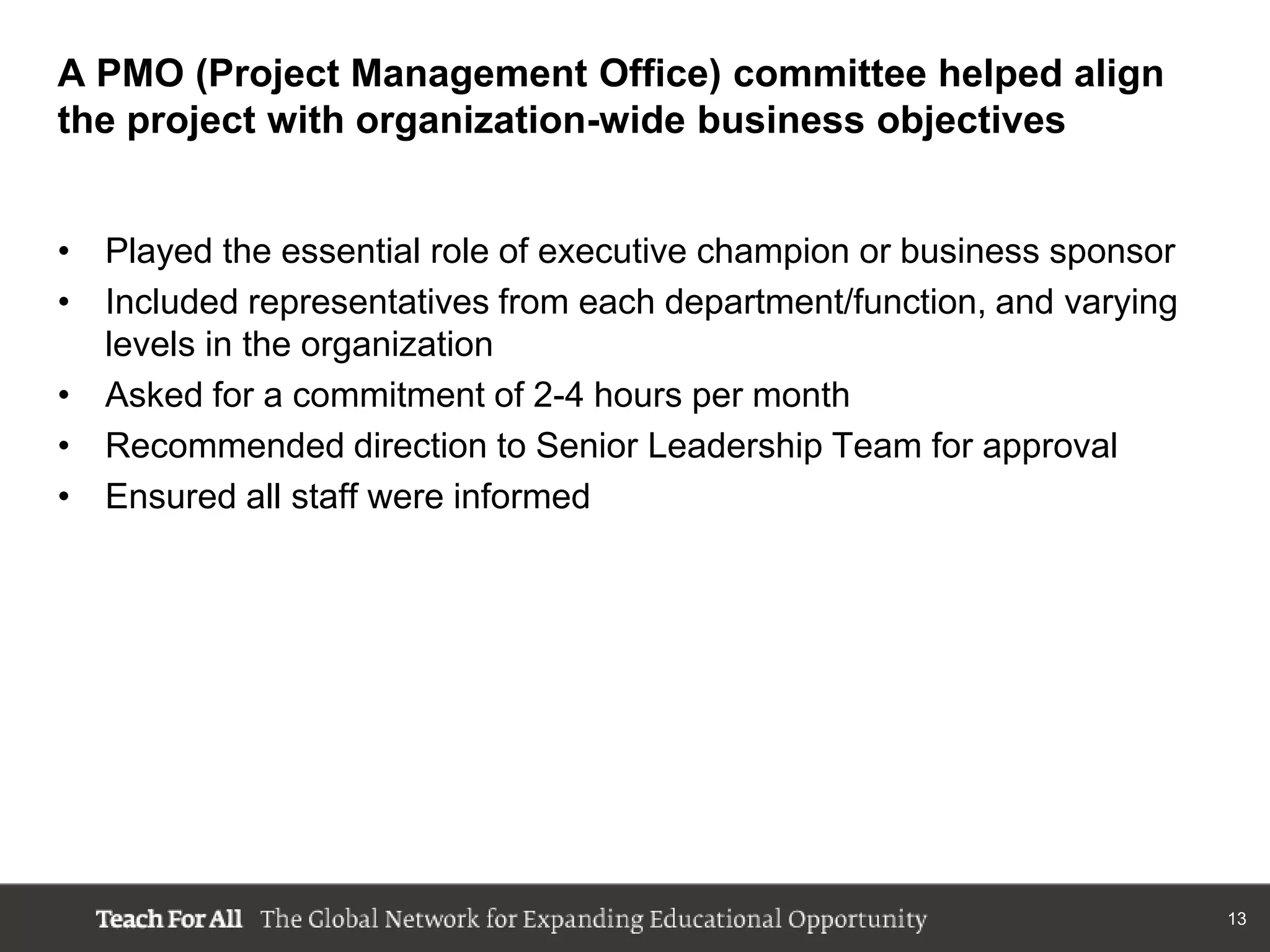

A PMO (Project Management Office) committee helped align
the project with organization-wide business objectives

• Played the essential role of executive champion or business sponsor
• Included representatives from each department/function, and varying
  levels in the organization
• Asked for a commitment of 2-4 hours per month
• Recommended direction to Senior Leadership Team for approval
• Ensured all staff were informed

                                                                        13

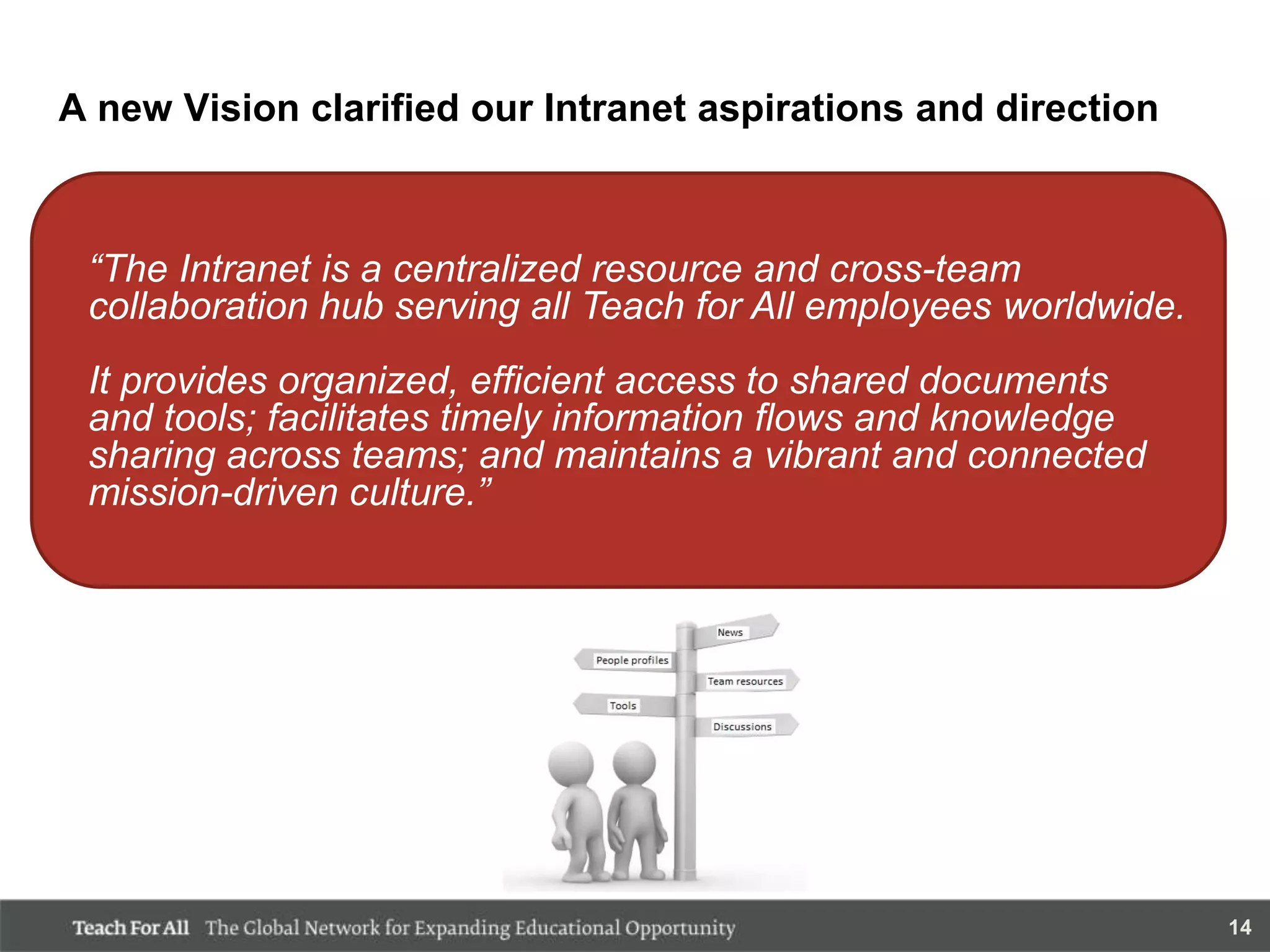

A new Vision clarified our Intranet aspirations and direction

 “The Intranet is a centralized resource and cross-team
 collaboration hub serving all Teach for All employees worldwide.
 It provides organized, efficient access to shared documents
 and tools; facilitates timely information flows and knowledge
 sharing across teams; and maintains a vibrant and connected
 mission-driven culture.”

                                                                    14

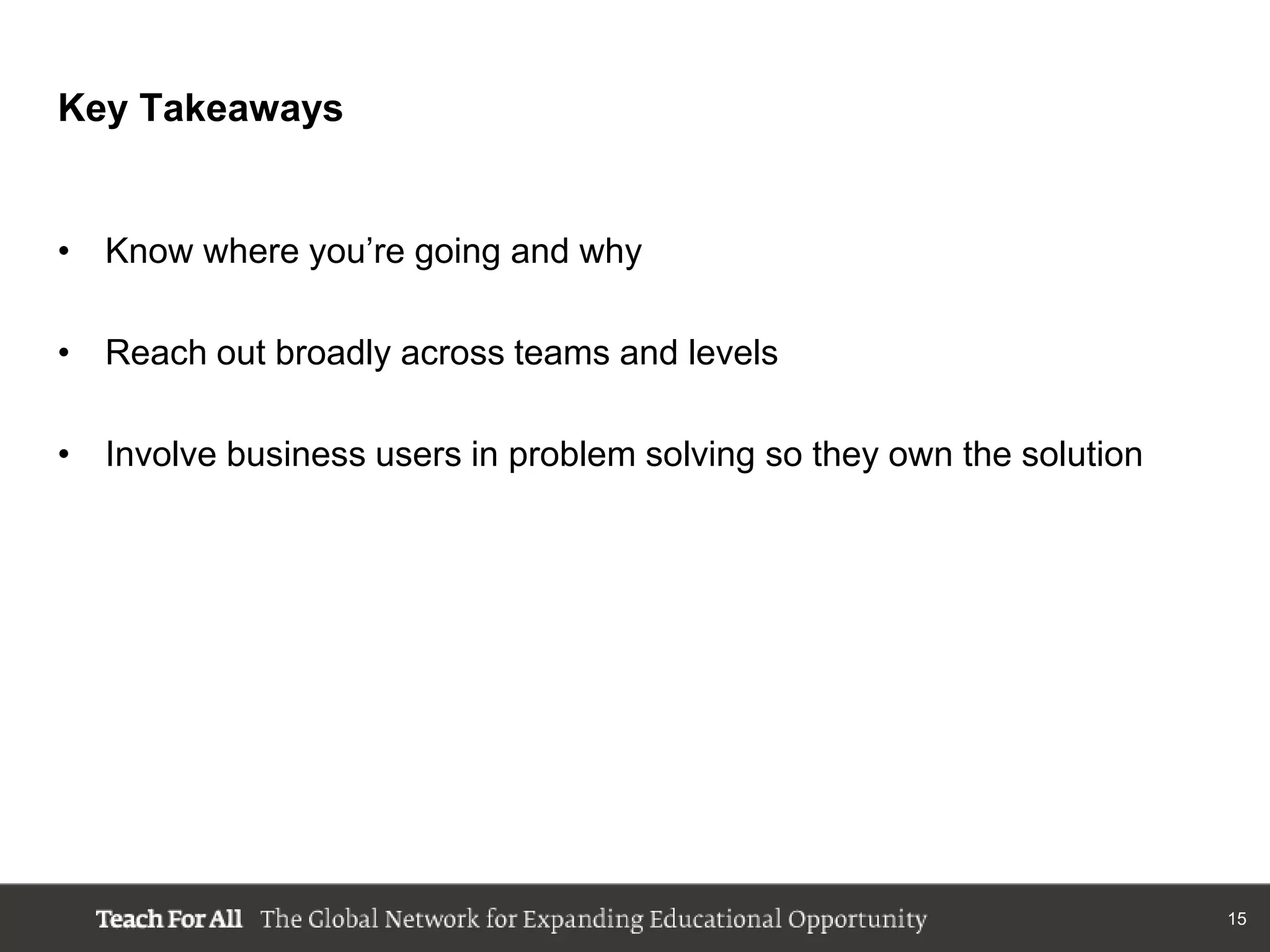

Key Takeaways

• Know where you‟re going and why

• Reach out broadly across teams and levels

• Involve business users in problem solving so they own the solution

                                                                       15

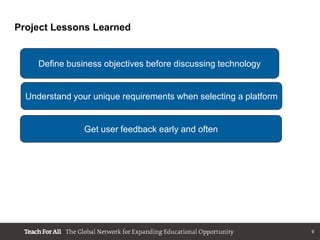

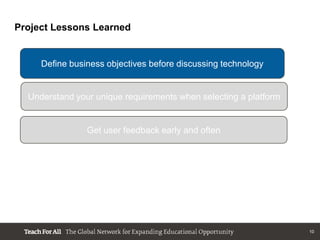

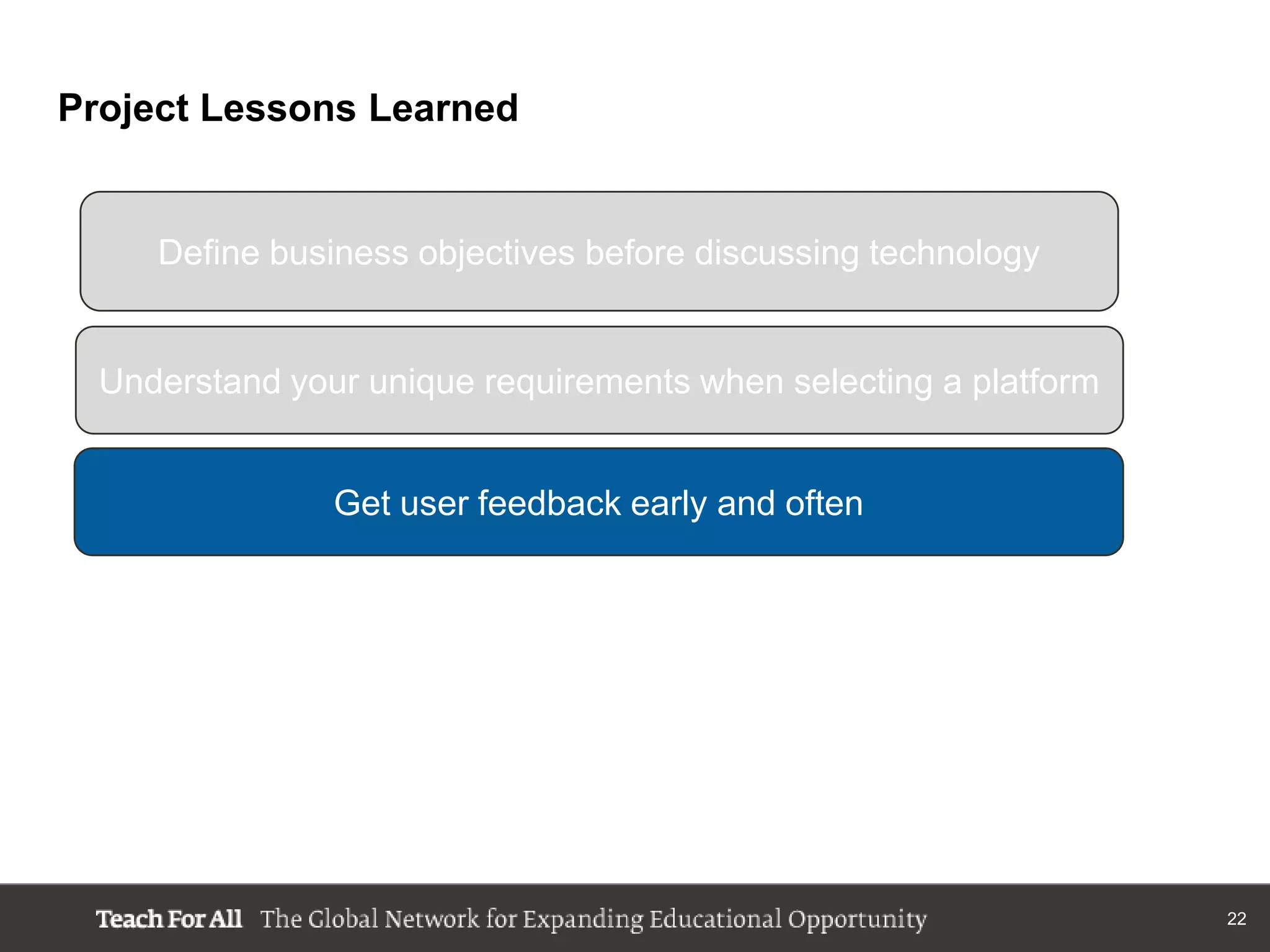

Project Lessons Learned

     Define business objectives before discussing technology

  Understand your unique requirements when selecting a platform

                Get user feedback early and often

                                                                  16

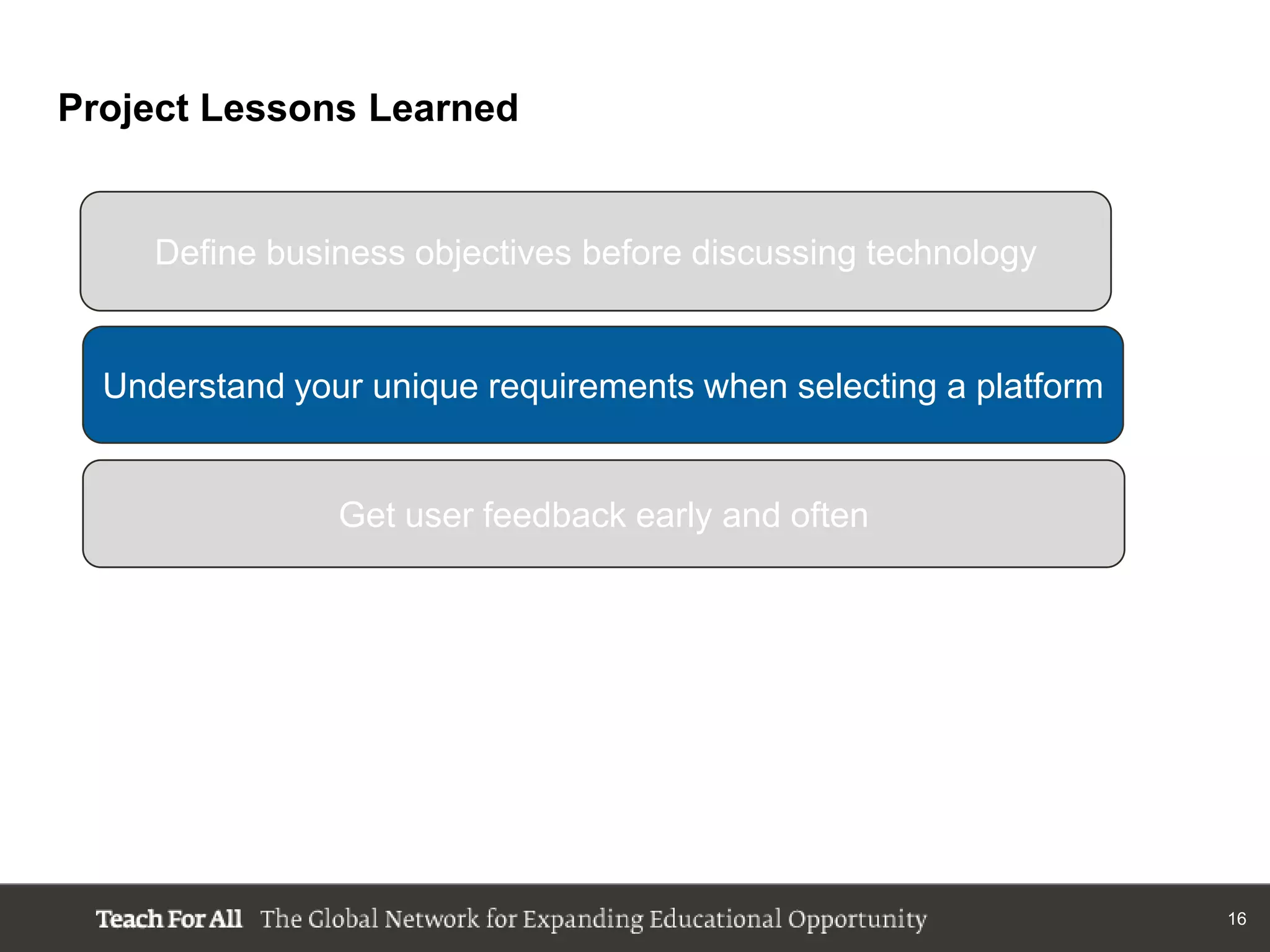

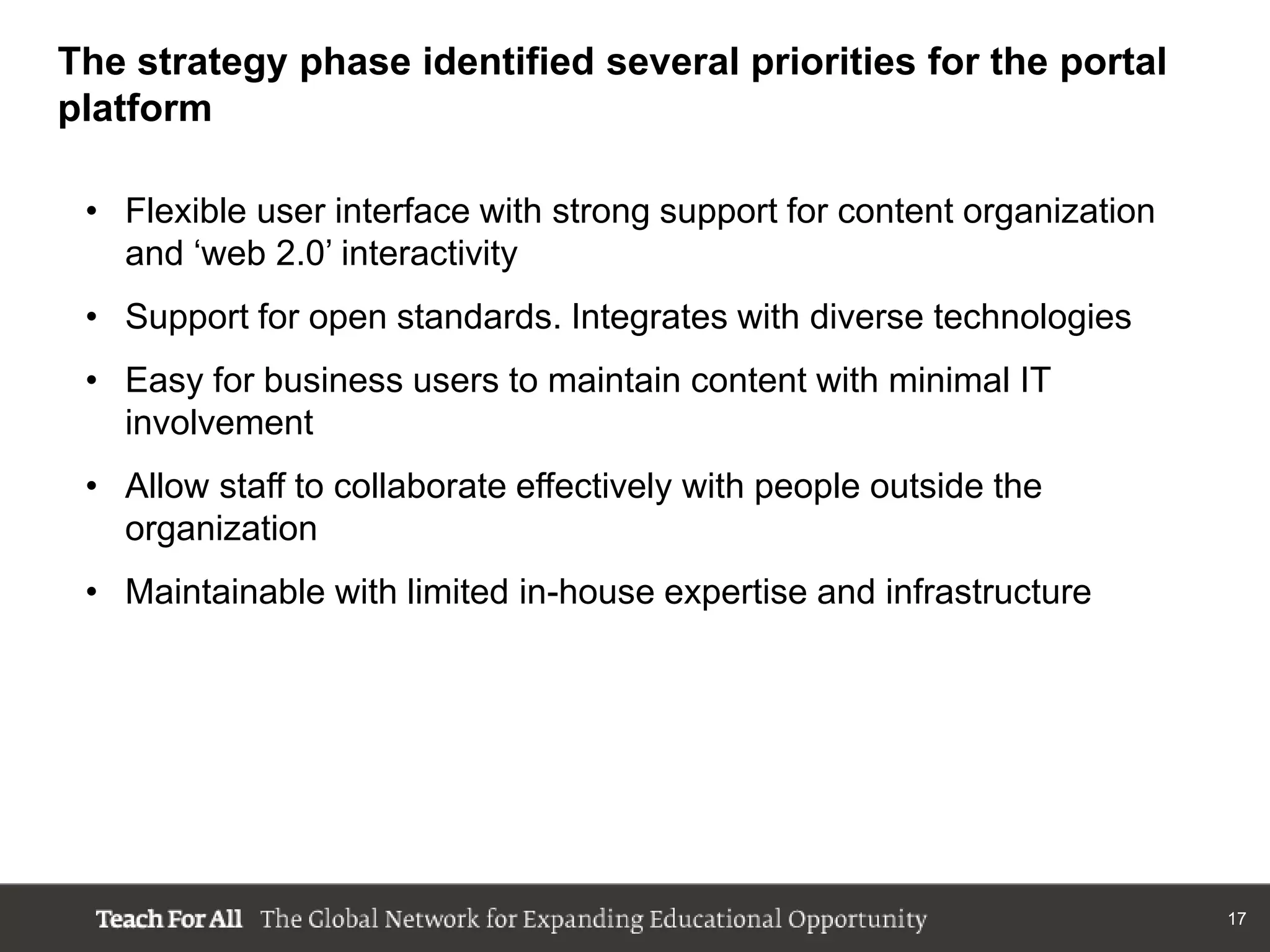

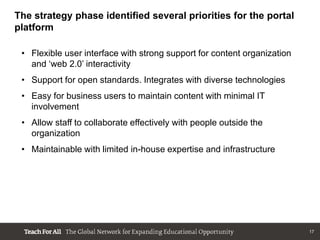

The strategy phase identified several priorities for the portal
platform

 • Flexible user interface with strong support for content organization
   and „web 2.0‟ interactivity
 • Support for open standards. Integrates with diverse technologies
 • Easy for business users to maintain content with minimal IT
   involvement
 • Allow staff to collaborate effectively with people outside the
   organization
 • Maintainable with limited in-house expertise and infrastructure

                                                                          17

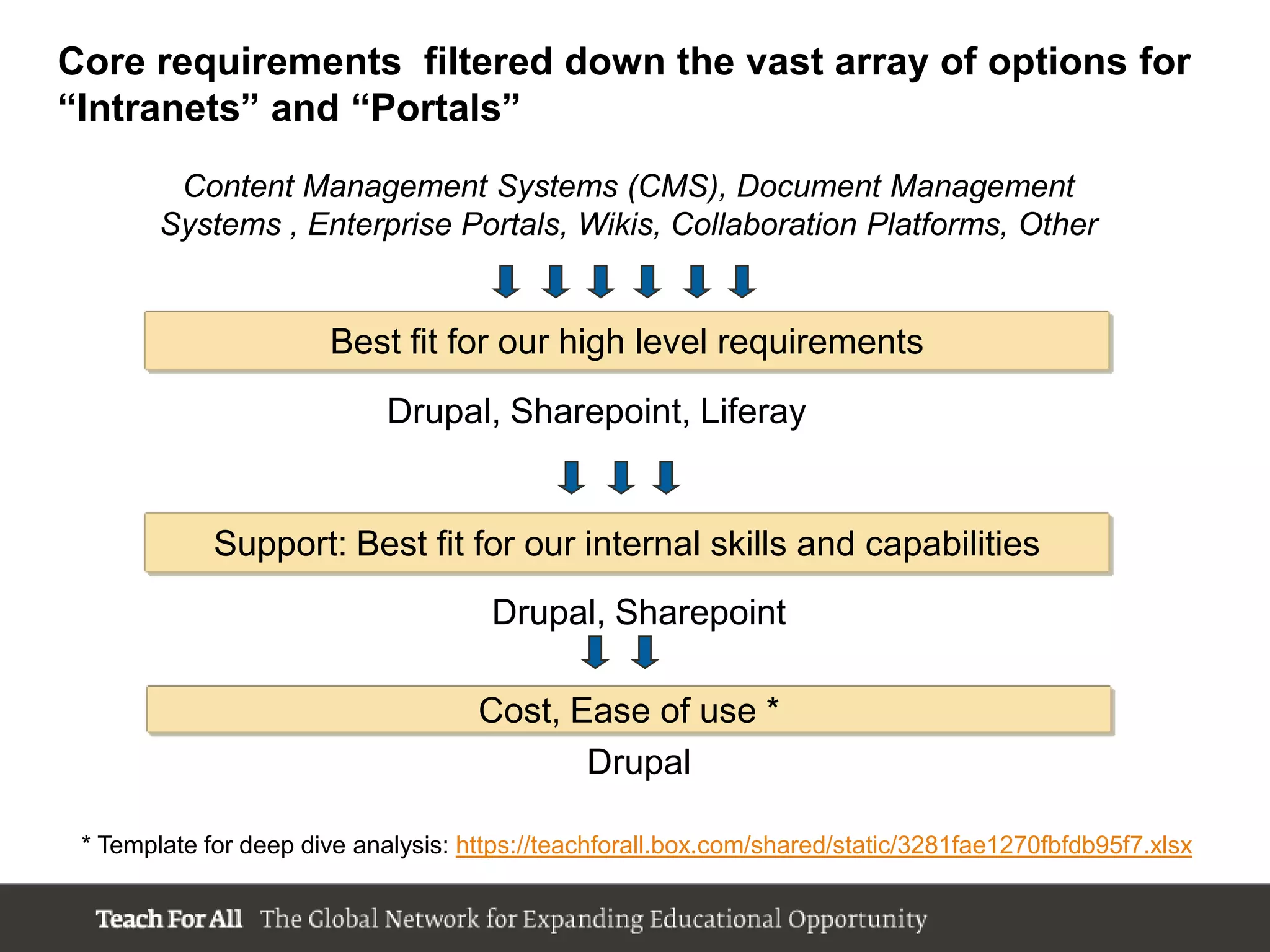

Core requirements filtered down the vast array of options for
“Intranets” and “Portals”
         Content Management Systems (CMS), Document Management
        Systems , Enterprise Portals, Wikis, Collaboration Platforms, Other

                       Best fit for our high level requirements
                             Drupal, Sharepoint, Liferay

             Support: Best fit for our internal skills and capabilities
                                      Drupal, Sharepoint

                                     Cost, Ease of use *
                                            Drupal

 * Template for deep dive analysis: https://teachforall.box.com/shared/static/3281fae1270fbfdb95f7.xlsx

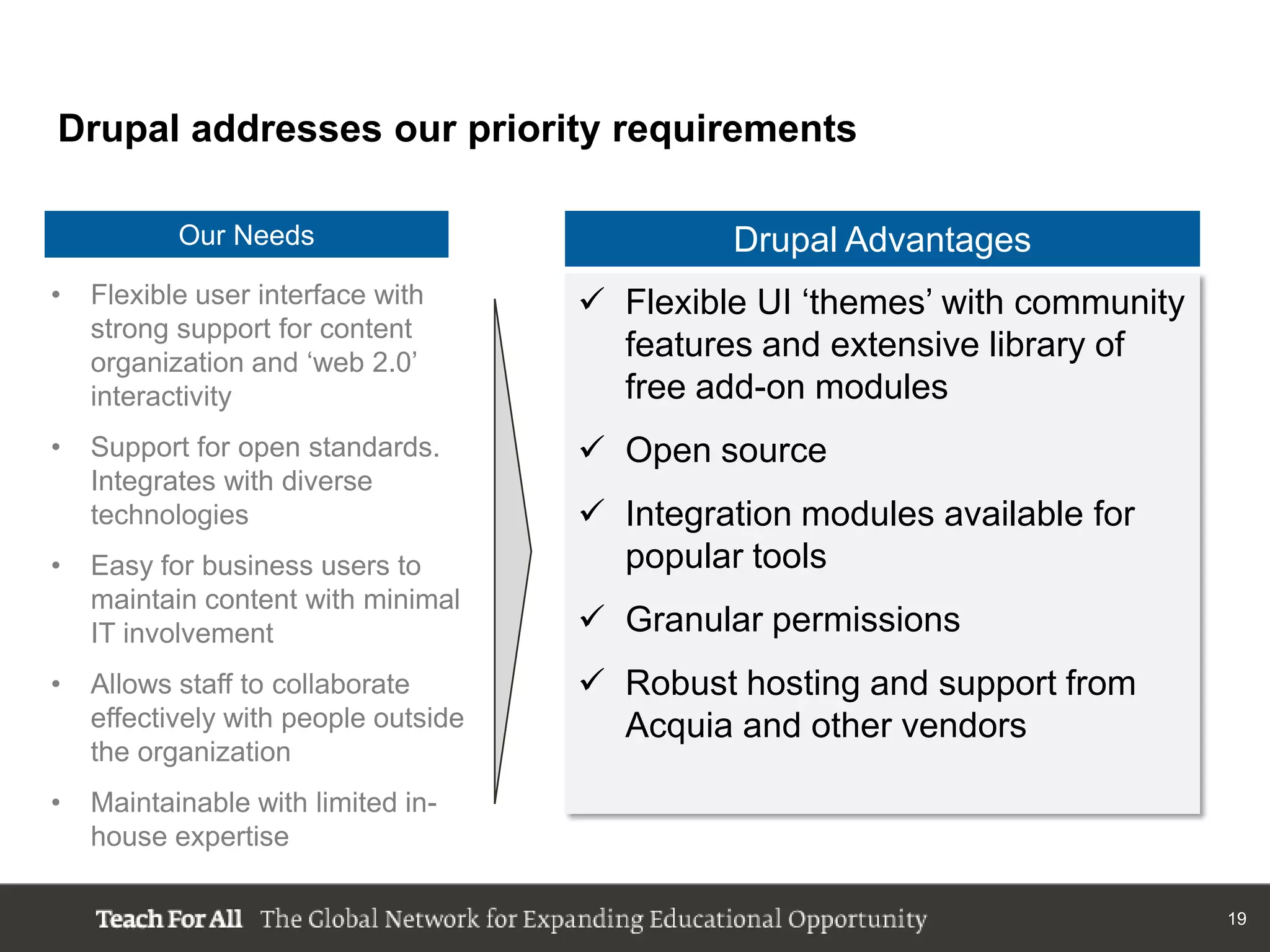

Drupal addresses our priority requirements

           Our Needs                           Drupal Advantages
•   Flexible user interface with       Flexible UI „themes‟ with community
    strong support for content
    organization and „web 2.0‟
                                        features and extensive library of
    interactivity                       free add-on modules
•   Support for open standards.        Open source
    Integrates with diverse
    technologies                       Integration modules available for
•   Easy for business users to          popular tools
    maintain content with minimal
    IT involvement                     Granular permissions
•   Allows staff to collaborate        Robust hosting and support from
    effectively with people outside     Acquia and other vendors
    the organization
•   Maintainable with limited in-
    house expertise

                                                                              19

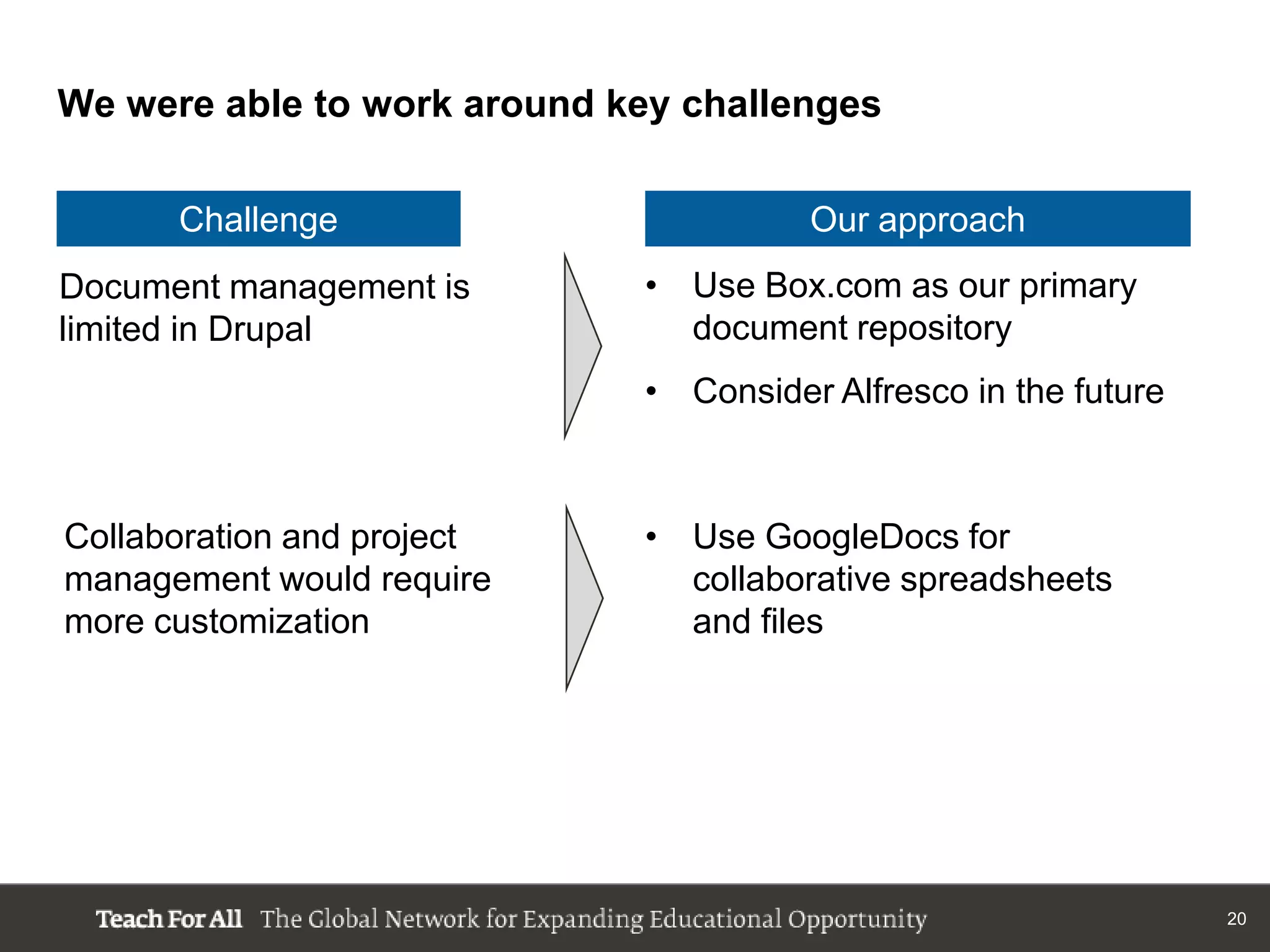

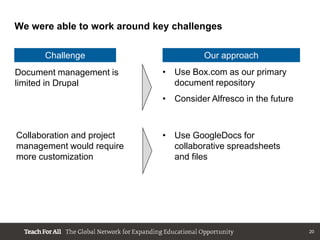

We were able to work around key challenges

      Challenge                        Our approach
Document management is       • Use Box.com as our primary
limited in Drupal              document repository
                             • Consider Alfresco in the future

Collaboration and project    • Use GoogleDocs for
management would require       collaborative spreadsheets
more customization             and files

                                                                 20
Key Takeaways

               r another organization may not be right for you
• Analyze specifics and try out solutions to get beyond vendor marketing
  messages.

• What works well for another organization may not be right for you

                                                                           21
Project Lessons Learned

     Define business objectives before discussing technology

  Understand your unique requirements when selecting a platform

                Get user feedback early and often

                                                                  22

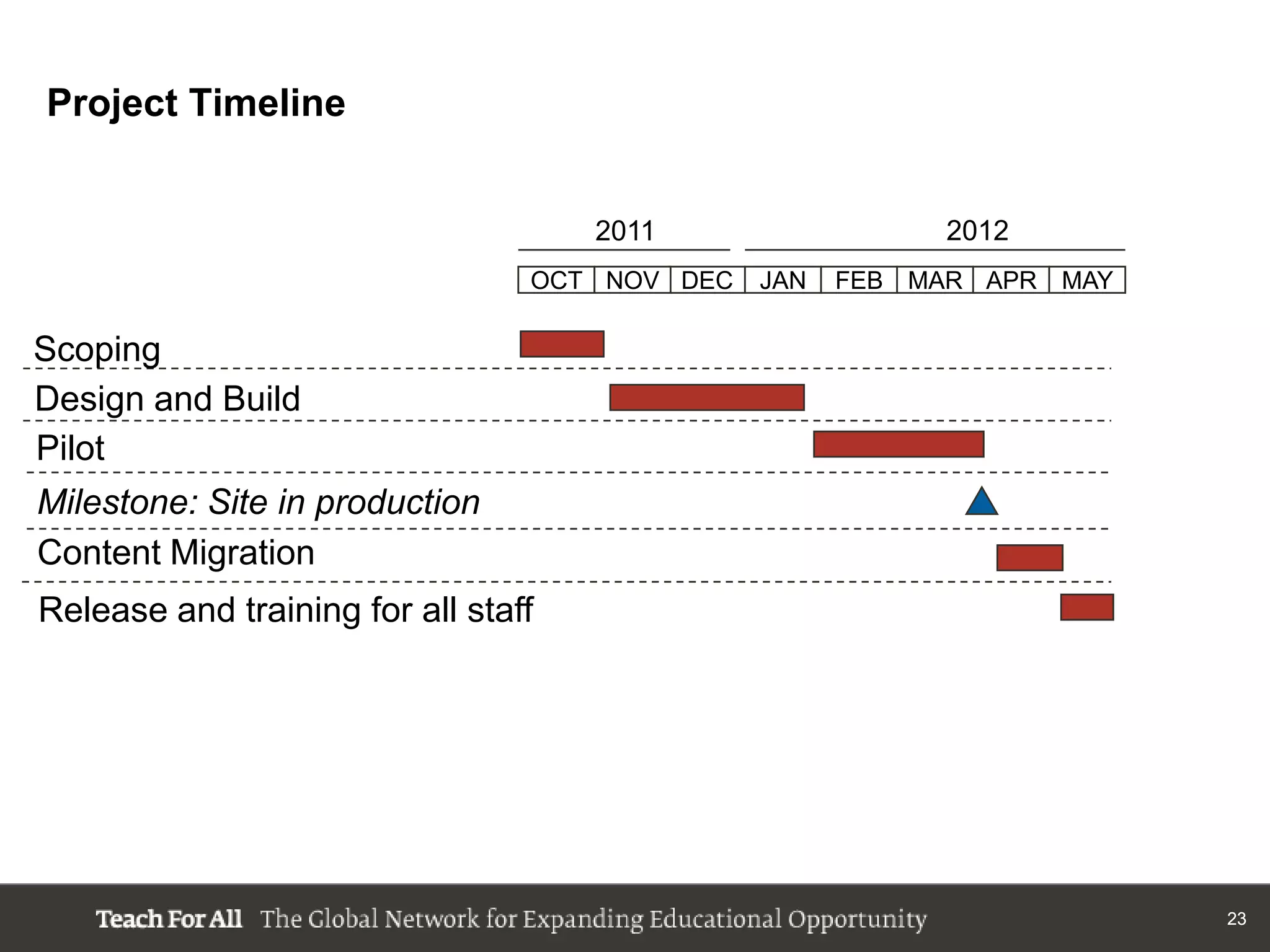

Project Timeline

                                     2011                 2012
                                 OCT NOV DEC   JAN   FEB MAR APR MAY

Scoping
Design and Build
Pilot
Milestone: Site in production
Content Migration
Release and training for all staff

                                                                       23

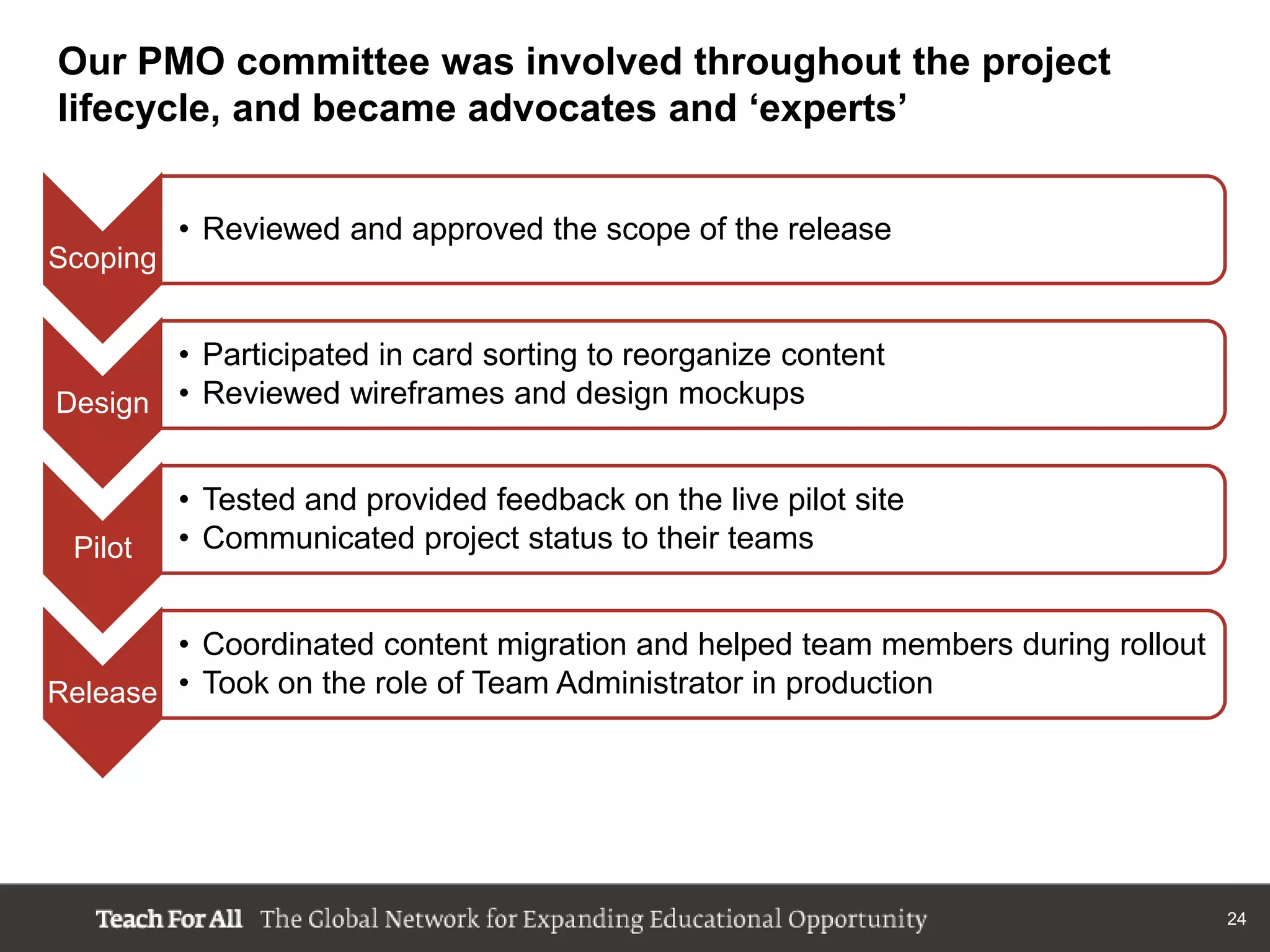

Our PMO committee was involved throughout the project
lifecycle, and became advocates and „experts‟

          • Reviewed and approved the scope of the release
Scoping

       • Participated in card sorting to reorganize content
Design • Reviewed wireframes and design mockups

          • Tested and provided feedback on the live pilot site
 Pilot    • Communicated project status to their teams

        • Coordinated content migration and helped team members during rollout
Release • Took on the role of Team Administrator in production

                                                                                 24
Online tools helped engage remote staff

Card sorting: www.websort.net    Wireframes: www.balsamiq.com

                                                                25

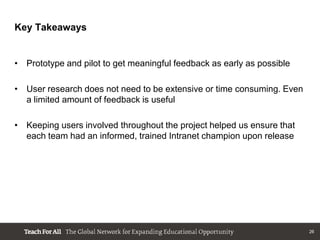

Key Takeaways

• Prototype and pilot to get meaningful feedback as early as possible

• User research does not need to be extensive or time consuming. Even
  a limited amount of feedback is useful

• Keeping users involved throughout the project helped us ensure that
  each team had an informed, trained Intranet champion upon release

                                                                        26

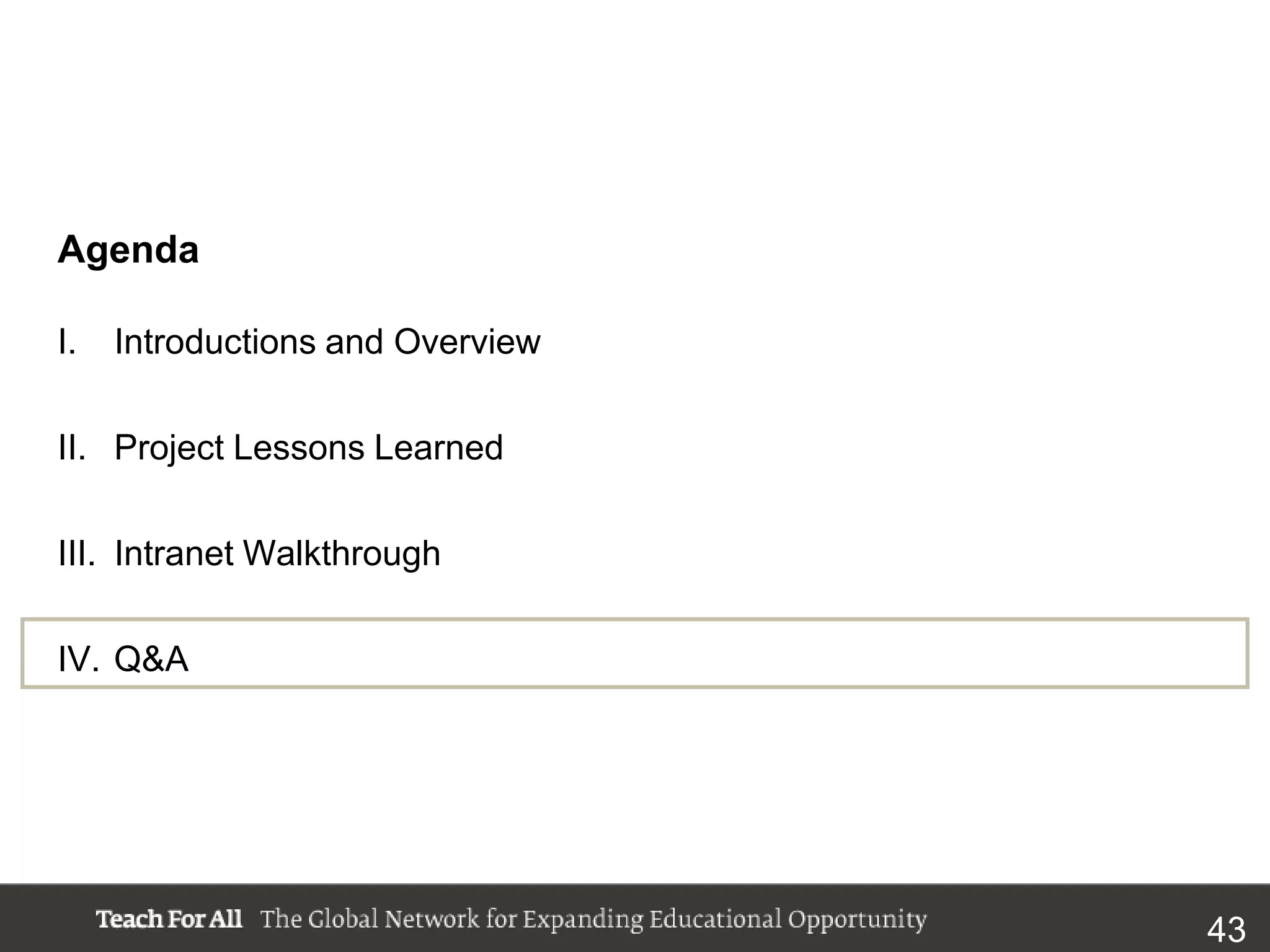

Agenda

I.   Introductions and Overview

II. Project Lessons Learned

III. Intranet Walkthrough

IV. Q&A

                                  27
The new Intranet delivered several key benefits

•   Updated design reflects our culture and „brand‟ identity
•   Organized access to diverse tools and information sources
•   Easier to find and share information across teams
•   Opportunities to connect with colleagues
•   Human Assets team became the official Business Owner

                                                                28

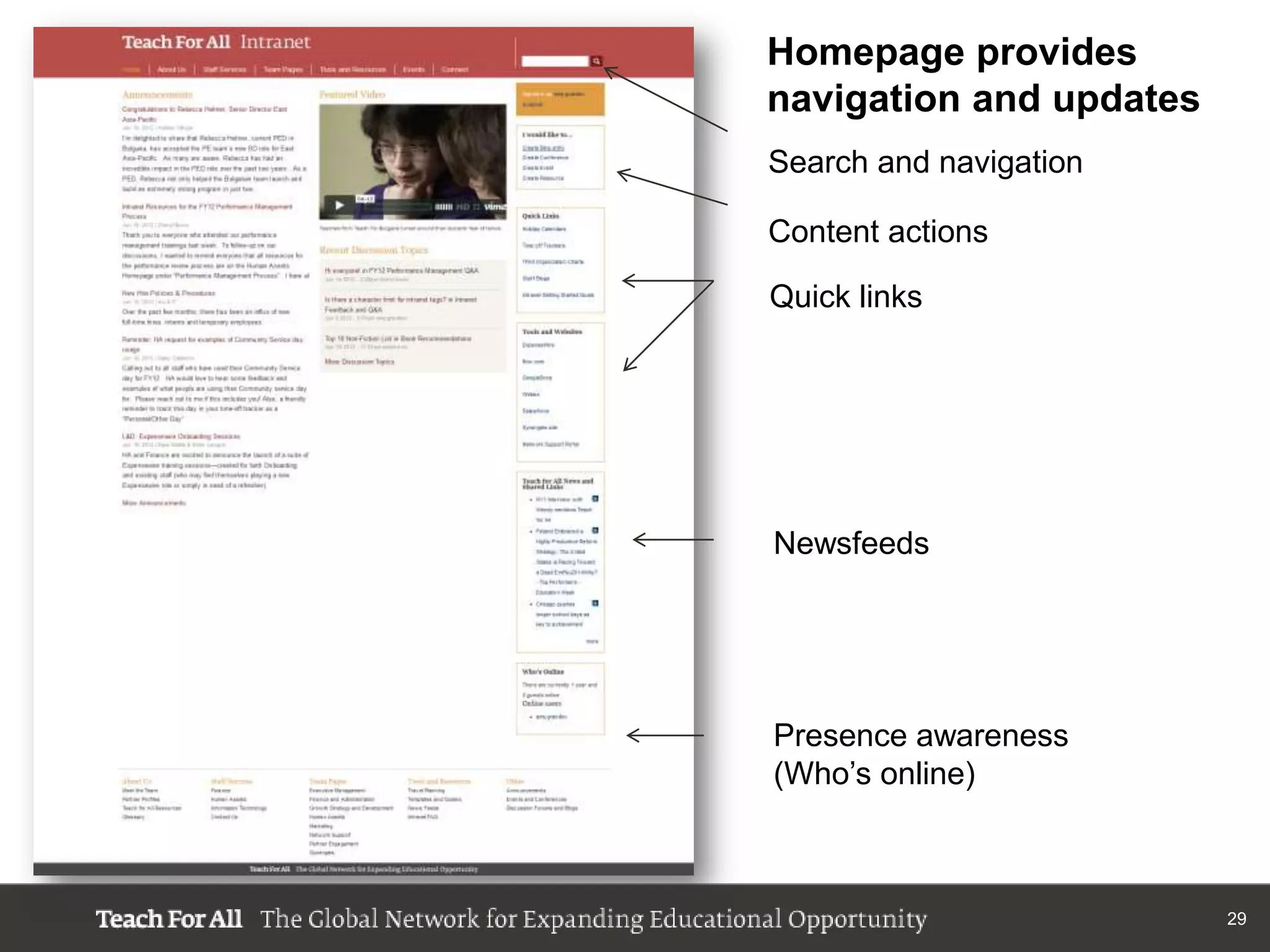

Homepage provides
navigation and updates
Search and navigation

Content actions

Quick links

Newsfeeds

Presence awareness
(Who‟s online)

                         29

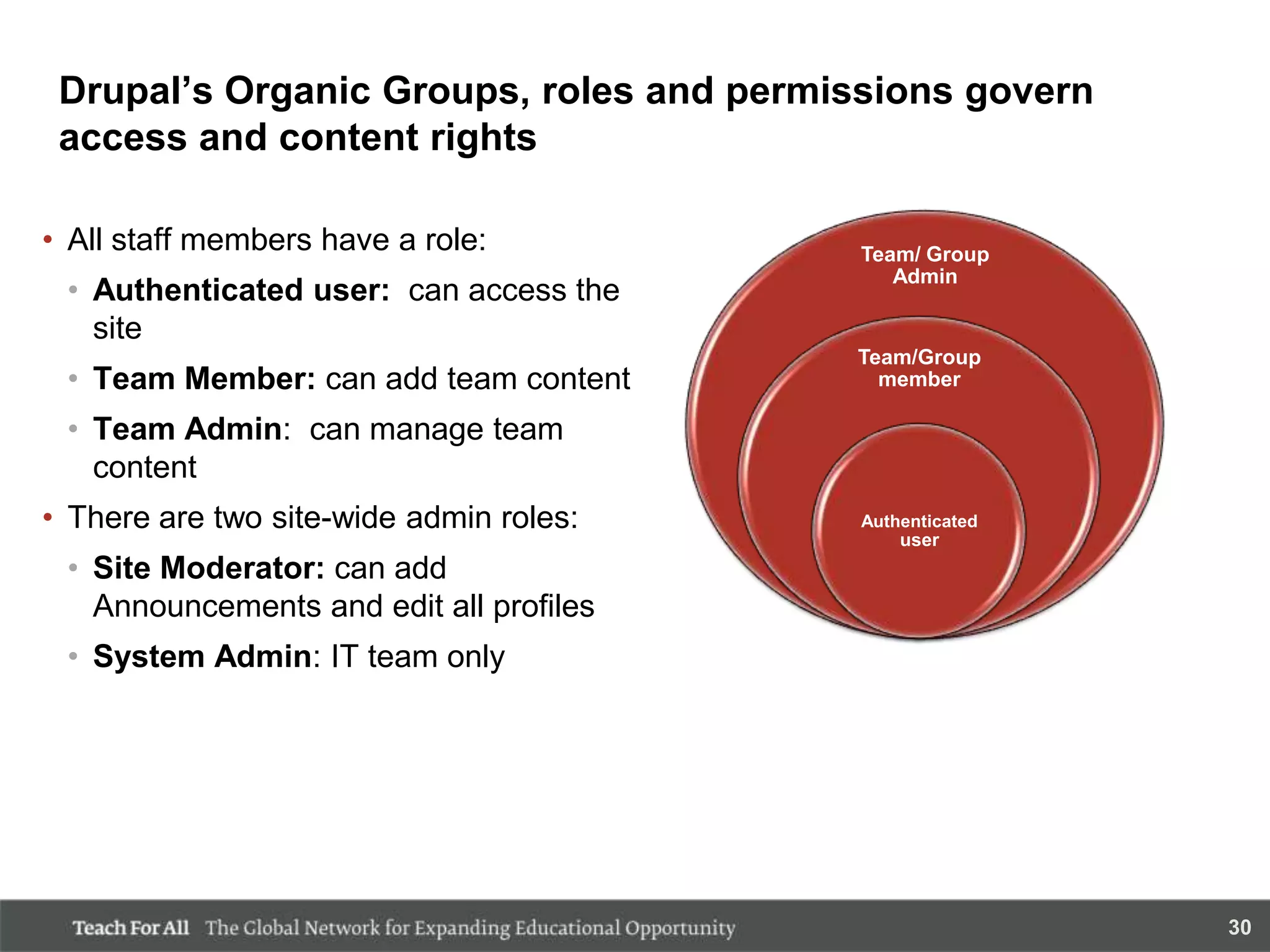

Drupal‟s Organic Groups, roles and permissions govern
 access and content rights

• All staff members have a role:          Team/ Group
                                             Admin
 • Authenticated user: can access the
   site
                                         Team/Group
 • Team Member: can add team content       member

 • Team Admin: can manage team
   content
• There are two site-wide admin roles:    Authenticated
                                              user
 • Site Moderator: can add
   Announcements and edit all profiles
 • System Admin: IT team only

                                                          30

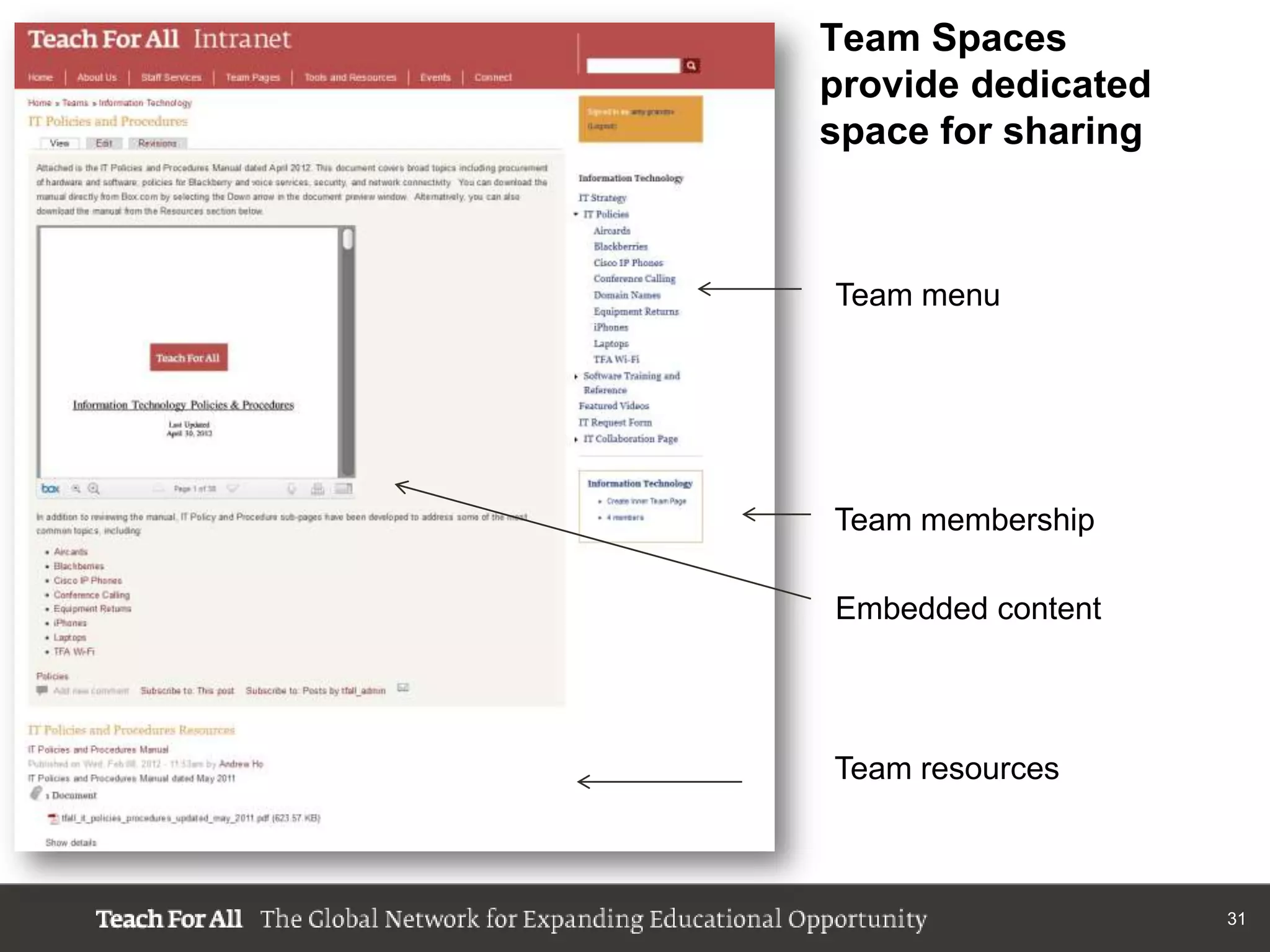

Team Spaces
provide dedicated
space for sharing

Team menu

Team membership

Embedded content

Team resources

                    31

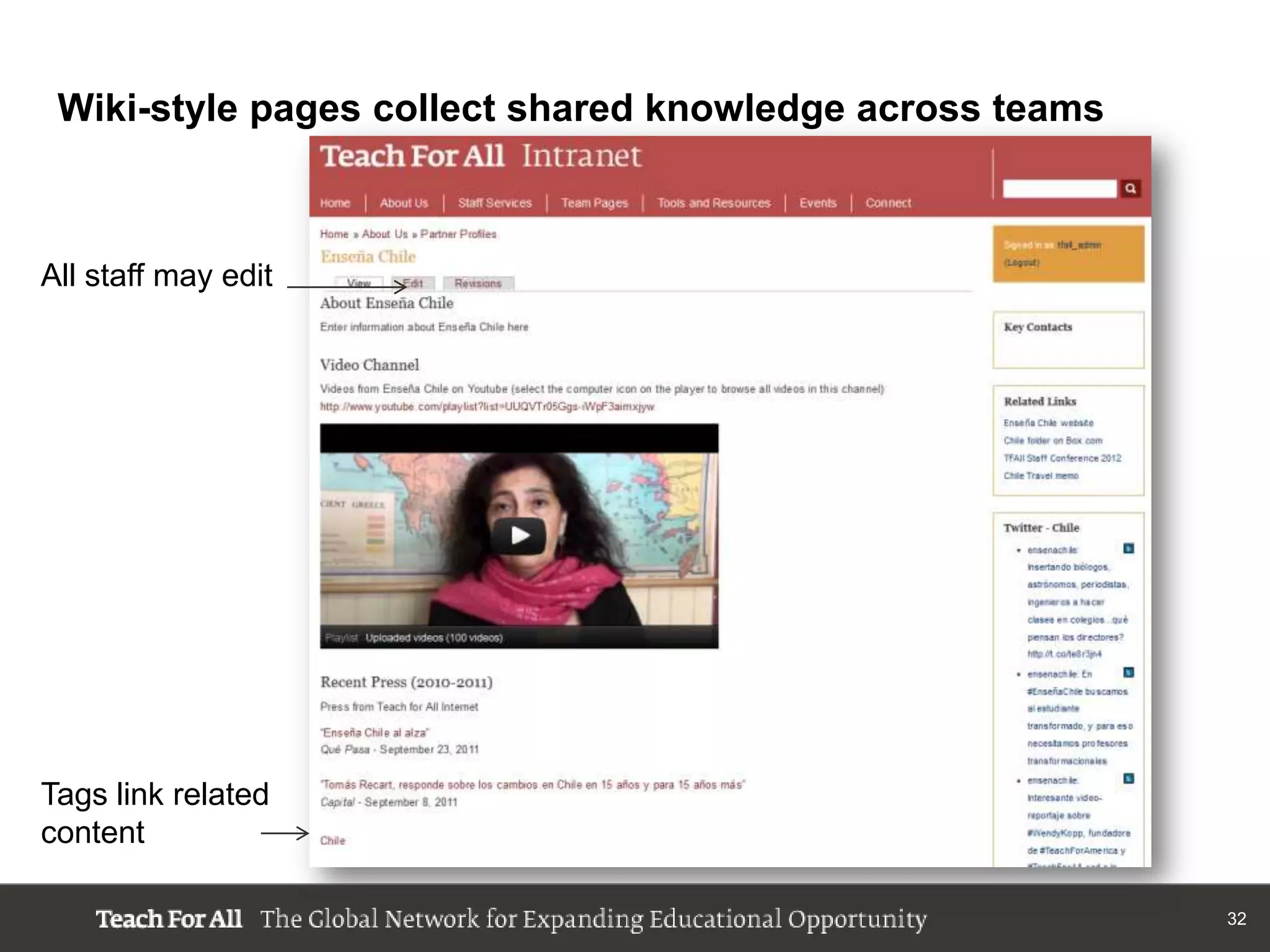

Wiki-style pages collect shared knowledge across teams

All staff may edit

Tags link related
content

                                                          32

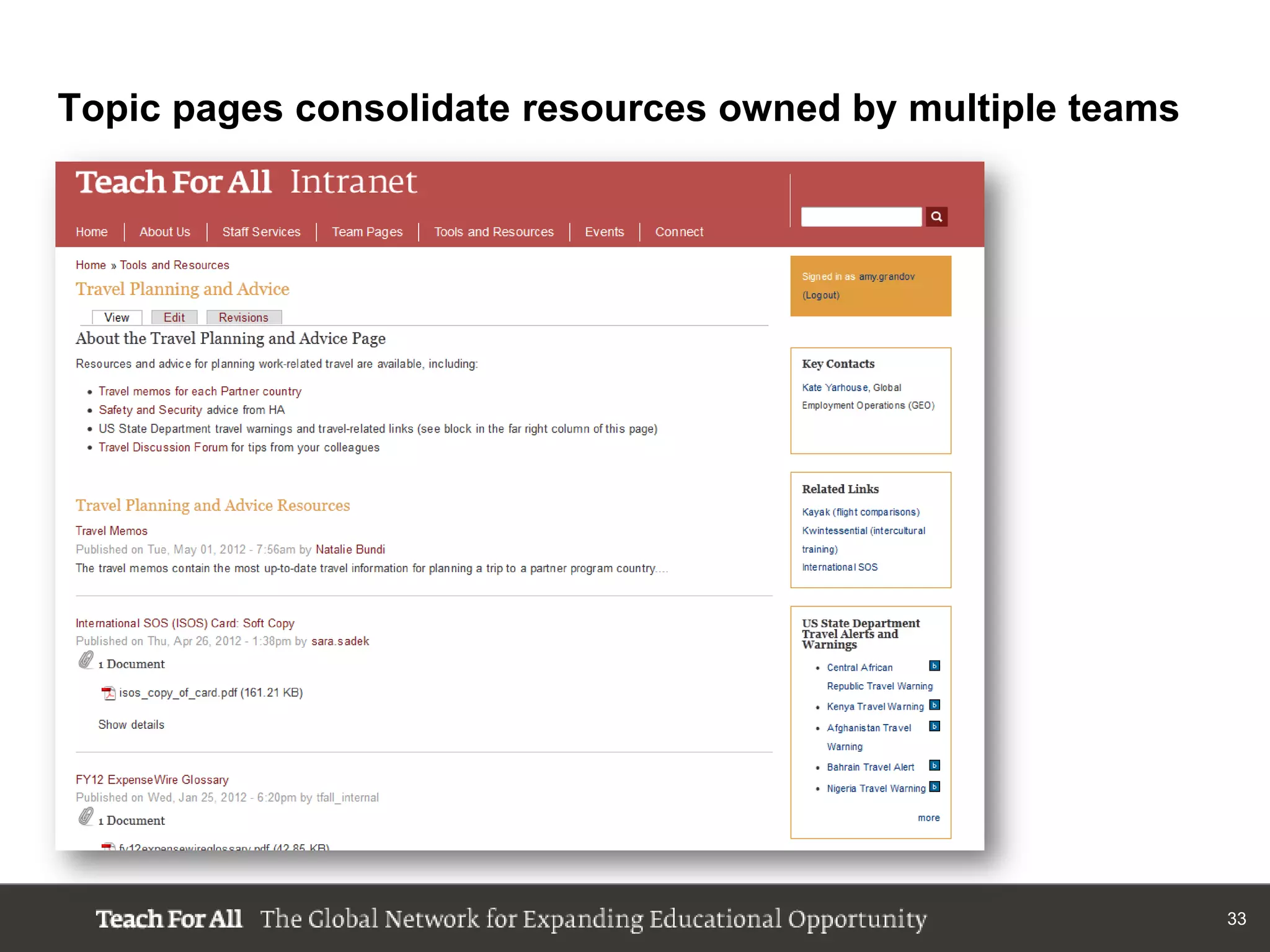

Topic pages consolidate resources owned by multiple teams

                                                            33

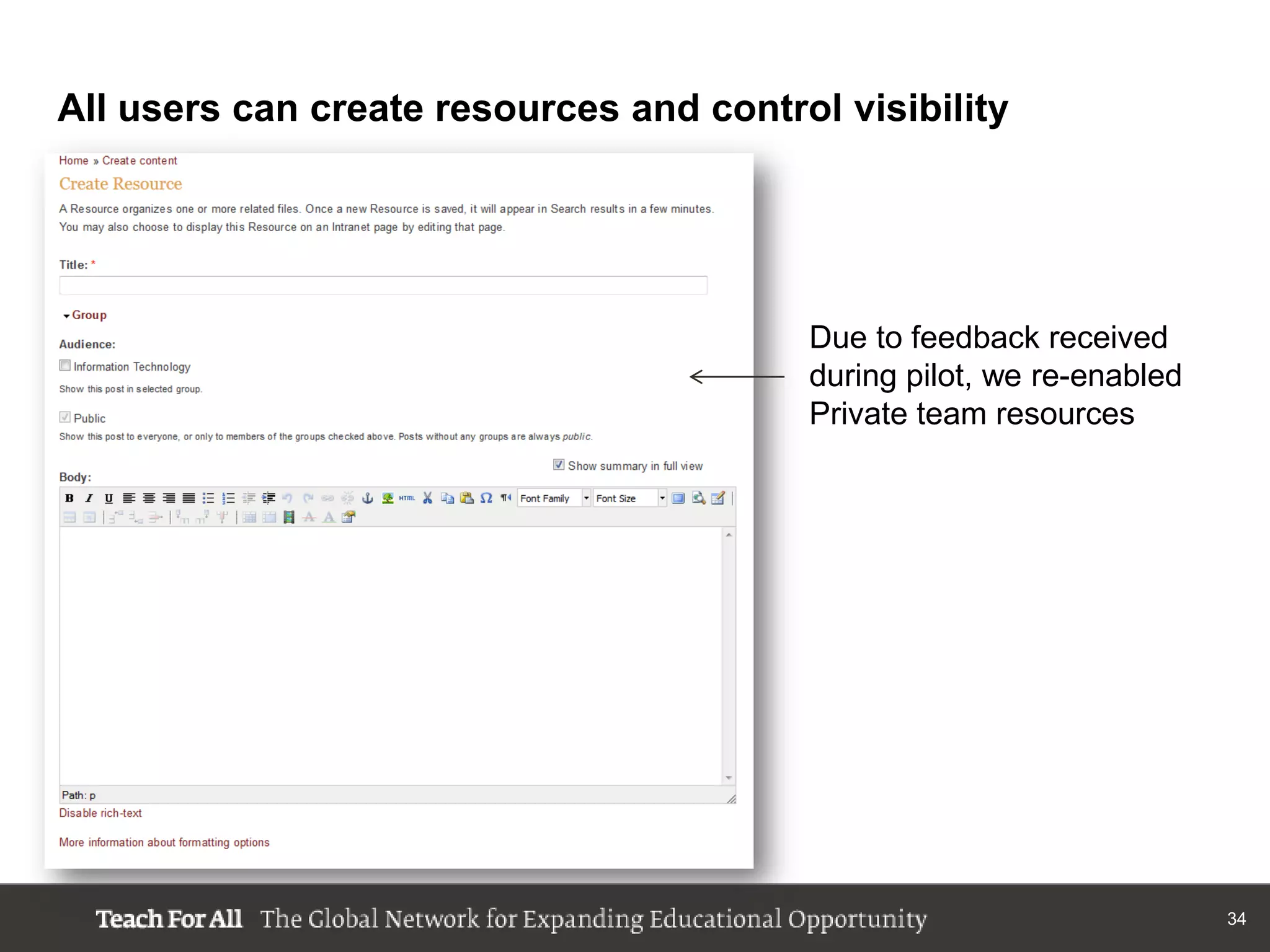

All users can create resources and control visibility

                                         Due to feedback received
                                         during pilot, we re-enabled
                                         Private team resources

                                                                       34

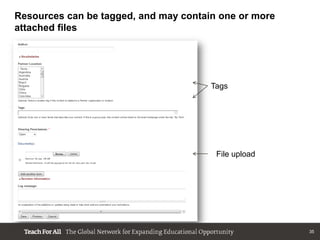

Resources can be tagged, and may contain one or more
attached files

                                       Tags

                                        File upload

                                                       35

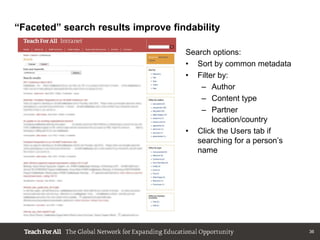

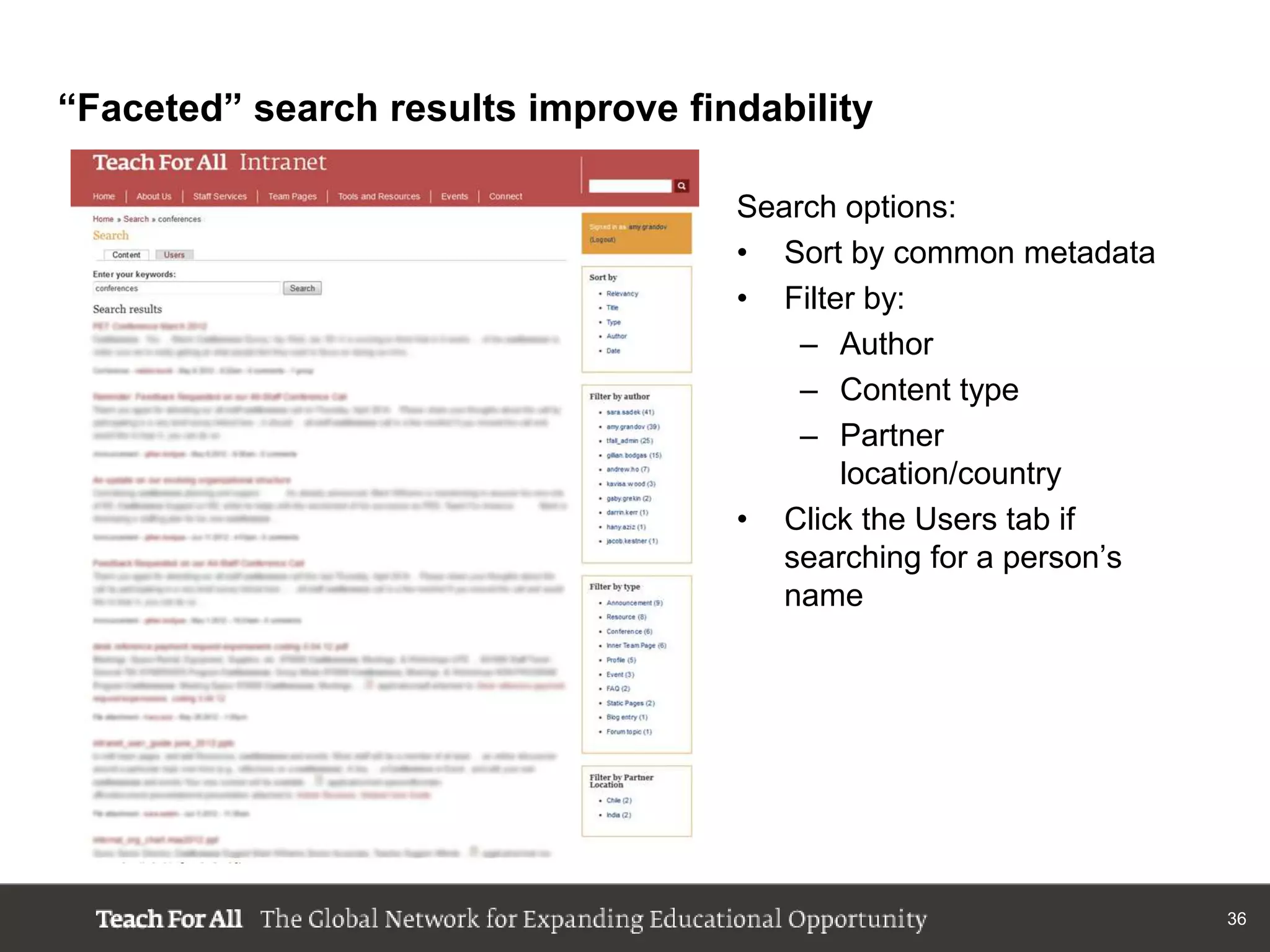

“Faceted” search results improve findability

                                    Search options:
                                    • Sort by common metadata
                                    • Filter by:
                                        – Author
                                        – Content type
                                        – Partner
                                           location/country
                                    • Click the Users tab if
                                       searching for a person‟s
                                       name

                                                                  36
Events and conferences keep staff informed

                                       Events from our community
                                       portal (via RSS)

                                                                   37

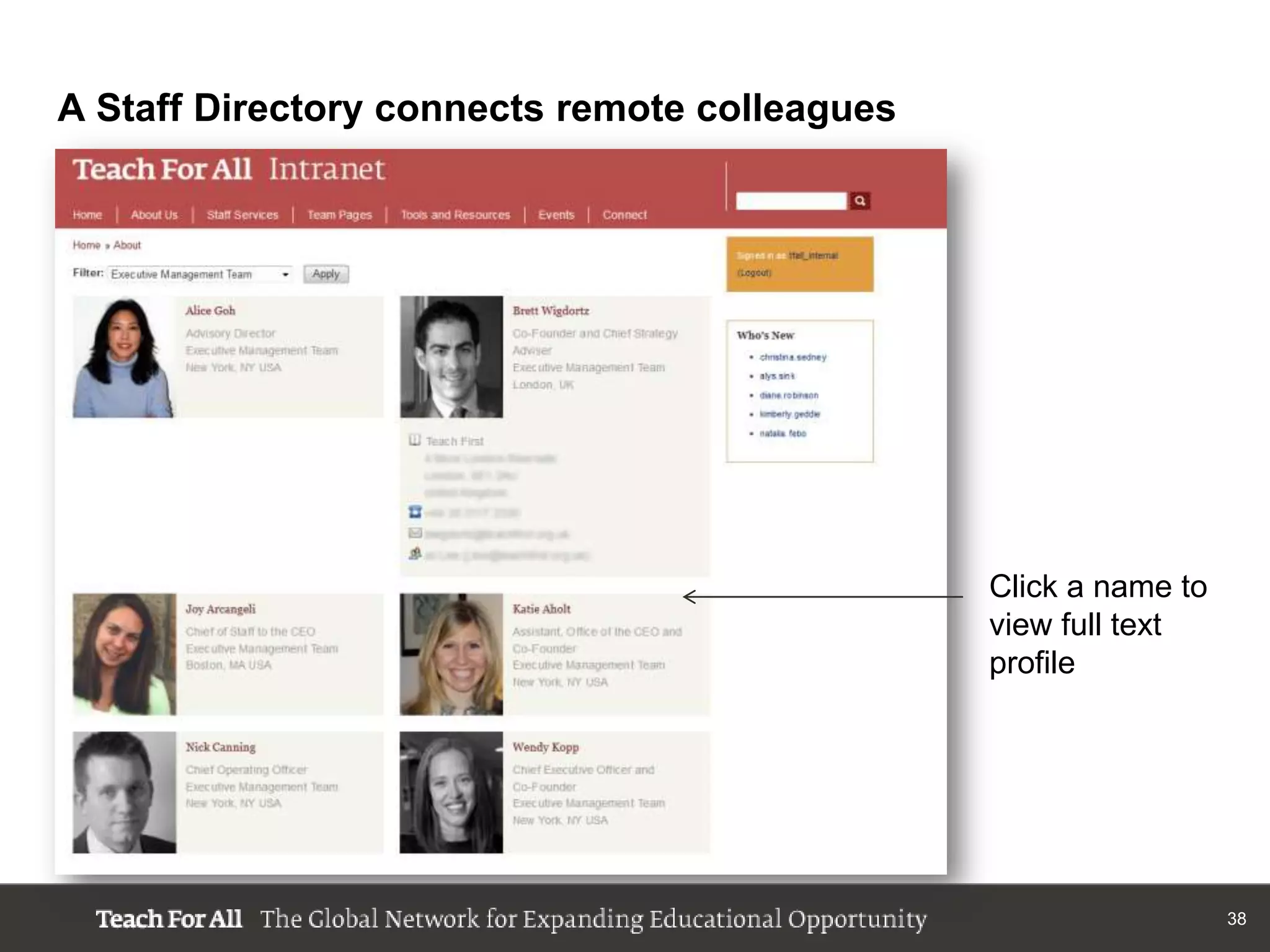

A Staff Directory connects remote colleagues

                                               Click a name to
                                               view full text
                                               profile

                                                                 38

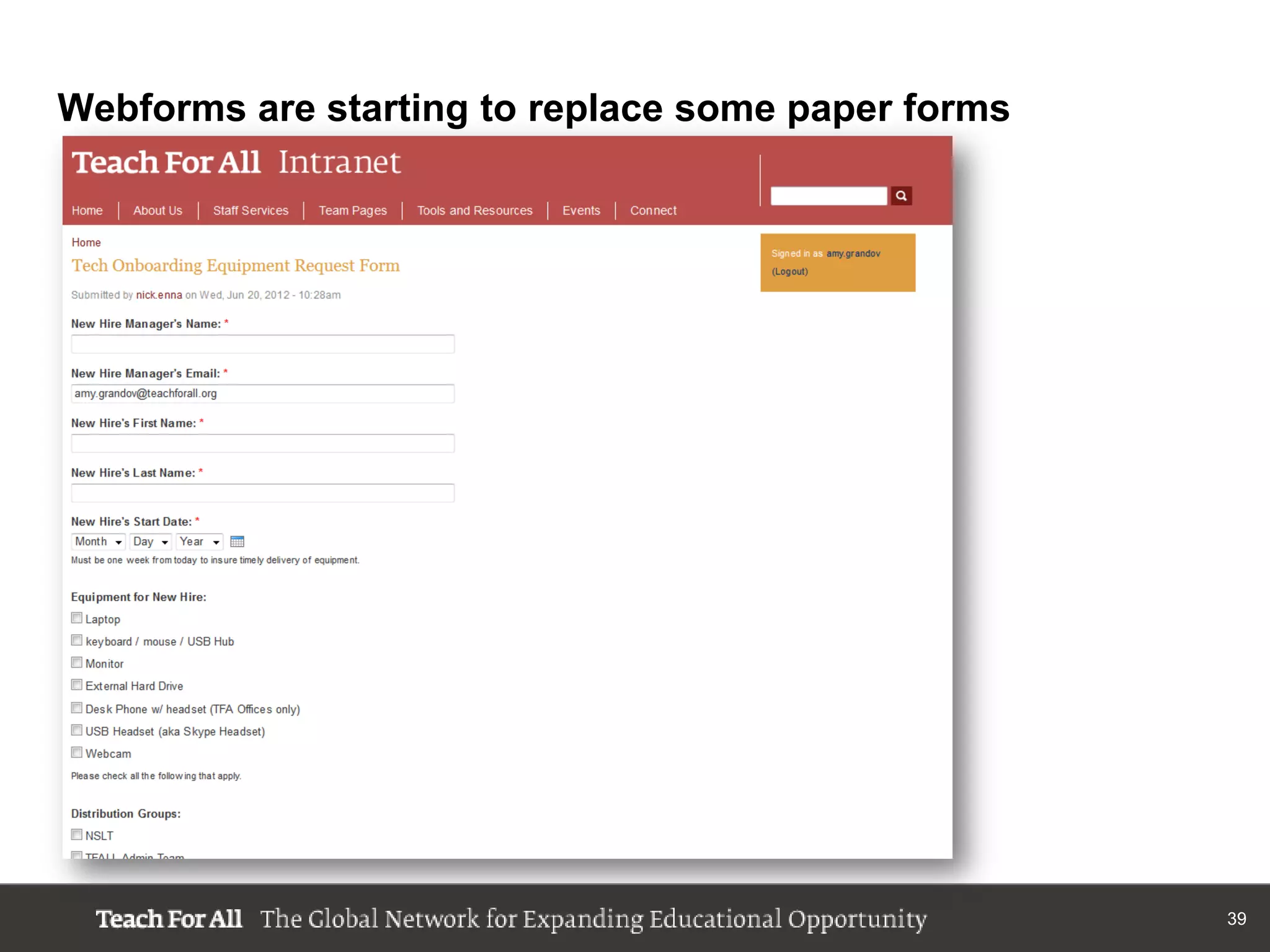

Webforms are starting to replace some paper forms

                                                    39

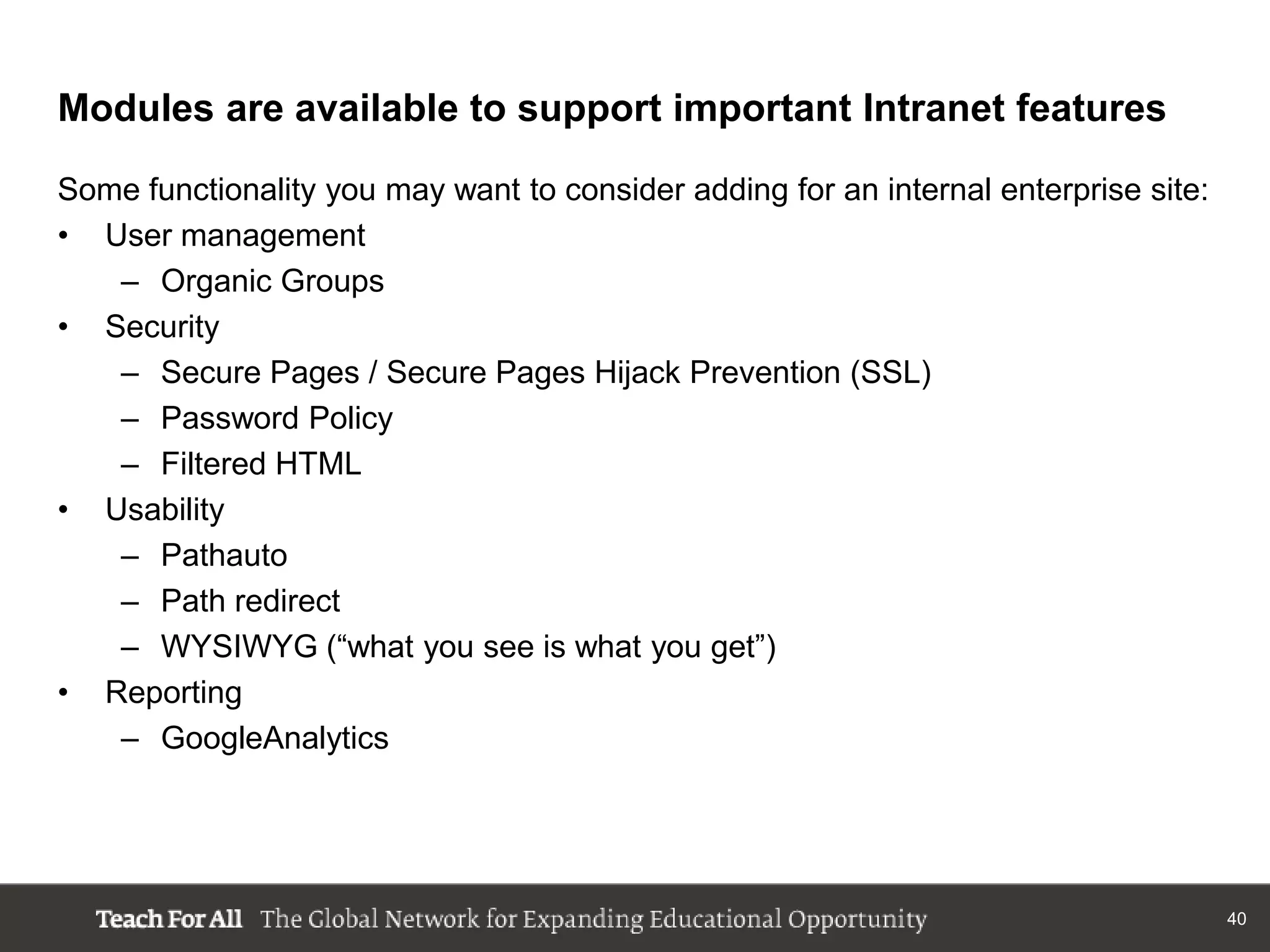

Modules are available to support important Intranet features

Some functionality you may want to consider adding for an internal enterprise site:
• User management
   – Organic Groups
• Security
   – Secure Pages / Secure Pages Hijack Prevention (SSL)
   – Password Policy
   – Filtered HTML
• Usability
   – Pathauto
   – Path redirect
   – WYSIWYG (“what you see is what you get”)
• Reporting
   – GoogleAnalytics

                                                                                      40

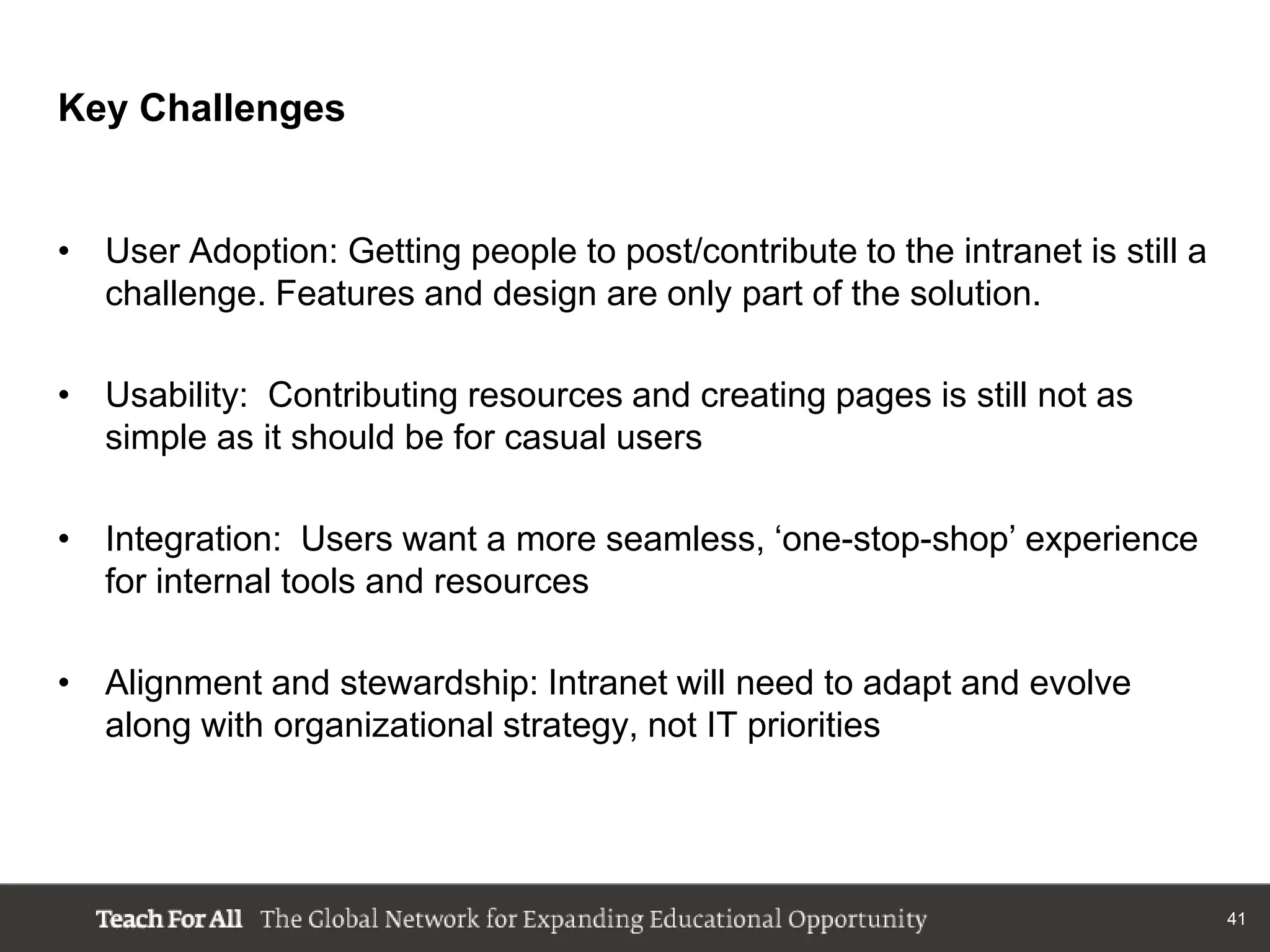

Key Challenges

• User Adoption: Getting people to post/contribute to the intranet is still a
  challenge. Features and design are only part of the solution.

• Usability: Contributing resources and creating pages is still not as
  simple as it should be for casual users

• Integration: Users want a more seamless, „one-stop-shop‟ experience
  for internal tools and resources

• Alignment and stewardship: Intranet will need to adapt and evolve
  along with organizational strategy, not IT priorities

                                                                                41

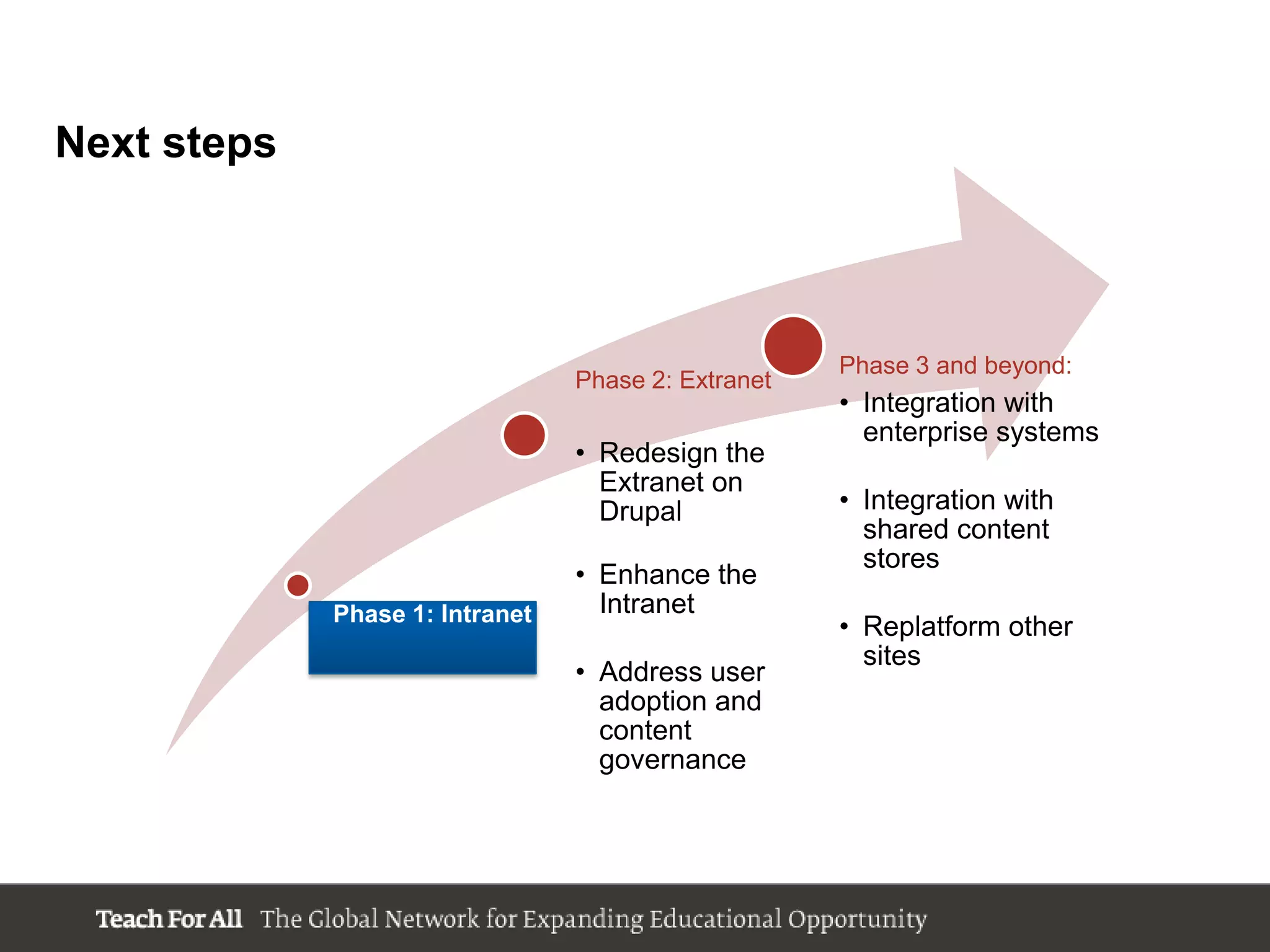

Next steps

                                                     Phase 3 and beyond:
                                 Phase 2: Extranet
                                                     • Integration with
                                                       enterprise systems
                                 • Redesign the
                                   Extranet on
                                   Drupal            • Integration with
                                                       shared content
                                                       stores
                                 • Enhance the
             Phase 1: Intranet     Intranet
                                                     • Replatform other
                                                       sites
                                 • Address user
                                   adoption and
                                   content
                                   governance
Agenda

I.   Introductions and Overview

II. Project Lessons Learned

III. Intranet Walkthrough

IV. Q&A

                                  43

Case Study: Toward Building a New Intranet

  • 1.
    Case Study: TowardBuilding a New Intranet Teach for All August 1, 2012
  • 2.
    Agenda I. Introductions II. Project Lessons Learned III. Intranet Walkthrough IV. Q&A 2
  • 3.
    About Us Andy Ho, Senior Director, Information Technology – Leads the IT team at Teach For All – Background in IT management and consulting with Crestron Electronics, Deloitte Consulting, and American Management Systems Amy Grandov, Director, Business Analysis – Manages enterprise application projects – Previously with McKinsey, focusing on knowledge management, collaboration and business intelligence systems 3
  • 4.
    About Teach forAll “Teach for All is a global network of independent social enterprises that are working to expand educational opportunity in their nations by enlisting their most promising future leaders in the effort. We aspire to the vision that one day, all children will have the opportunity to attain an excellent education” 4
  • 5.
  • 6.
    Case Study Overview •In May 2012, we released a new Intranet for all internal staff at Teach for All • This project was the first step in a larger initiative to consolidate our web portals on a common platform • This case study will present lessons learned from the process of selecting Drupal as our portal platform and implementing the Intranet 6
  • 7.
    Intranet Components andVendors Components • Drupal 6.25 (http://www.drupal.org) • Document/content tools – Box.com – GoogleDocs – Vimeo Vendors • Acquia (http://www.acquia.com) • Appnovation (http://www.appnovation.com) 7
  • 8.
    Agenda I. Introductions and Overview II. Project Lessons Learned III. Intranet Walkthrough IV. Q&A 8
  • 9.
    Project Lessons Learned Define business objectives before discussing technology Understand your unique requirements when selecting a platform Get user feedback early and often 9
  • 10.
    Project Lessons Learned Define business objectives before discussing technology Understand your unique requirements when selecting a platform Get user feedback early and often 10
  • 11.
    Defining the Problem "Would you tell me, please, which way I ought to go from here?” "That depends a good deal on where you want to get to," said the Cat. "I don’t much care where--" said Alice. "Then it doesn’t matter which way you go," said the Cat. "--so long as I get SOMEWHERE," Alice added as an explanation. "Oh, you’re sure to do that," said the Cat, "if you only walk long enough.” (Alice's Adventures in Wonderland) 11
  • 12.
    Pain points withthe current portals lead to an initiative to consolidate on an upgraded platform Key challenges:  Dated design  Poor navigation  Low usage  Lack of ownership 12
  • 13.
    A PMO (ProjectManagement Office) committee helped align the project with organization-wide business objectives • Played the essential role of executive champion or business sponsor • Included representatives from each department/function, and varying levels in the organization • Asked for a commitment of 2-4 hours per month • Recommended direction to Senior Leadership Team for approval • Ensured all staff were informed 13
  • 14.
    A new Visionclarified our Intranet aspirations and direction “The Intranet is a centralized resource and cross-team collaboration hub serving all Teach for All employees worldwide. It provides organized, efficient access to shared documents and tools; facilitates timely information flows and knowledge sharing across teams; and maintains a vibrant and connected mission-driven culture.” 14
  • 15.
    Key Takeaways • Knowwhere you‟re going and why • Reach out broadly across teams and levels • Involve business users in problem solving so they own the solution 15
  • 16.
    Project Lessons Learned Define business objectives before discussing technology Understand your unique requirements when selecting a platform Get user feedback early and often 16
  • 17.
    The strategy phaseidentified several priorities for the portal platform • Flexible user interface with strong support for content organization and „web 2.0‟ interactivity • Support for open standards. Integrates with diverse technologies • Easy for business users to maintain content with minimal IT involvement • Allow staff to collaborate effectively with people outside the organization • Maintainable with limited in-house expertise and infrastructure 17
  • 18.
    Core requirements filtereddown the vast array of options for “Intranets” and “Portals” Content Management Systems (CMS), Document Management Systems , Enterprise Portals, Wikis, Collaboration Platforms, Other Best fit for our high level requirements Drupal, Sharepoint, Liferay Support: Best fit for our internal skills and capabilities Drupal, Sharepoint Cost, Ease of use * Drupal * Template for deep dive analysis: https://teachforall.box.com/shared/static/3281fae1270fbfdb95f7.xlsx
  • 19.
    Drupal addresses ourpriority requirements Our Needs Drupal Advantages • Flexible user interface with  Flexible UI „themes‟ with community strong support for content organization and „web 2.0‟ features and extensive library of interactivity free add-on modules • Support for open standards.  Open source Integrates with diverse technologies  Integration modules available for • Easy for business users to popular tools maintain content with minimal IT involvement  Granular permissions • Allows staff to collaborate  Robust hosting and support from effectively with people outside Acquia and other vendors the organization • Maintainable with limited in- house expertise 19
  • 20.
    We were ableto work around key challenges Challenge Our approach Document management is • Use Box.com as our primary limited in Drupal document repository • Consider Alfresco in the future Collaboration and project • Use GoogleDocs for management would require collaborative spreadsheets more customization and files 20
  • 21.
    Key Takeaways r another organization may not be right for you • Analyze specifics and try out solutions to get beyond vendor marketing messages. • What works well for another organization may not be right for you 21
  • 22.
    Project Lessons Learned Define business objectives before discussing technology Understand your unique requirements when selecting a platform Get user feedback early and often 22
  • 23.
    Project Timeline 2011 2012 OCT NOV DEC JAN FEB MAR APR MAY Scoping Design and Build Pilot Milestone: Site in production Content Migration Release and training for all staff 23
  • 24.
    Our PMO committeewas involved throughout the project lifecycle, and became advocates and „experts‟ • Reviewed and approved the scope of the release Scoping • Participated in card sorting to reorganize content Design • Reviewed wireframes and design mockups • Tested and provided feedback on the live pilot site Pilot • Communicated project status to their teams • Coordinated content migration and helped team members during rollout Release • Took on the role of Team Administrator in production 24
  • 25.
    Online tools helpedengage remote staff Card sorting: www.websort.net Wireframes: www.balsamiq.com 25
  • 26.
    Key Takeaways • Prototypeand pilot to get meaningful feedback as early as possible • User research does not need to be extensive or time consuming. Even a limited amount of feedback is useful • Keeping users involved throughout the project helped us ensure that each team had an informed, trained Intranet champion upon release 26
  • 27.
    Agenda I. Introductions and Overview II. Project Lessons Learned III. Intranet Walkthrough IV. Q&A 27
  • 28.
    The new Intranetdelivered several key benefits • Updated design reflects our culture and „brand‟ identity • Organized access to diverse tools and information sources • Easier to find and share information across teams • Opportunities to connect with colleagues • Human Assets team became the official Business Owner 28
  • 29.
    Homepage provides navigation andupdates Search and navigation Content actions Quick links Newsfeeds Presence awareness (Who‟s online) 29
  • 30.
    Drupal‟s Organic Groups,roles and permissions govern access and content rights • All staff members have a role: Team/ Group Admin • Authenticated user: can access the site Team/Group • Team Member: can add team content member • Team Admin: can manage team content • There are two site-wide admin roles: Authenticated user • Site Moderator: can add Announcements and edit all profiles • System Admin: IT team only 30
  • 31.
    Team Spaces provide dedicated spacefor sharing Team menu Team membership Embedded content Team resources 31
  • 32.
    Wiki-style pages collectshared knowledge across teams All staff may edit Tags link related content 32
  • 33.
    Topic pages consolidateresources owned by multiple teams 33
  • 34.
    All users cancreate resources and control visibility Due to feedback received during pilot, we re-enabled Private team resources 34
  • 35.
    Resources can betagged, and may contain one or more attached files Tags File upload 35
  • 36.
    “Faceted” search resultsimprove findability Search options: • Sort by common metadata • Filter by: – Author – Content type – Partner location/country • Click the Users tab if searching for a person‟s name 36
  • 37.
    Events and conferenceskeep staff informed Events from our community portal (via RSS) 37
  • 38.
    A Staff Directoryconnects remote colleagues Click a name to view full text profile 38
  • 39.
    Webforms are startingto replace some paper forms 39
  • 40.
    Modules are availableto support important Intranet features Some functionality you may want to consider adding for an internal enterprise site: • User management – Organic Groups • Security – Secure Pages / Secure Pages Hijack Prevention (SSL) – Password Policy – Filtered HTML • Usability – Pathauto – Path redirect – WYSIWYG (“what you see is what you get”) • Reporting – GoogleAnalytics 40
  • 41.
    Key Challenges • UserAdoption: Getting people to post/contribute to the intranet is still a challenge. Features and design are only part of the solution. • Usability: Contributing resources and creating pages is still not as simple as it should be for casual users • Integration: Users want a more seamless, „one-stop-shop‟ experience for internal tools and resources • Alignment and stewardship: Intranet will need to adapt and evolve along with organizational strategy, not IT priorities 41
  • 42.
    Next steps Phase 3 and beyond: Phase 2: Extranet • Integration with enterprise systems • Redesign the Extranet on Drupal • Integration with shared content stores • Enhance the Phase 1: Intranet Intranet • Replatform other sites • Address user adoption and content governance
  • 43.
    Agenda I. Introductions and Overview II. Project Lessons Learned III. Intranet Walkthrough IV. Q&A 43
