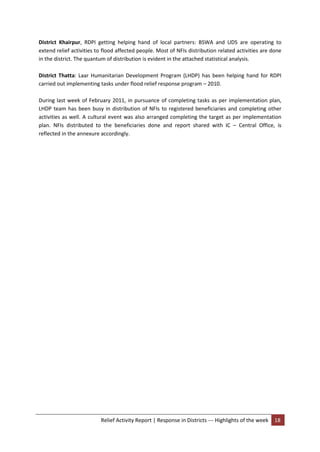

This document provides a progress report on flood emergency response activities conducted between August 2010 to March 2011 across six districts in Punjab and Sindh provinces. Key activities included:

- Distributing food, tents, and non-food items to over 292,711 registered individuals
- Establishing 301 child friendly spaces engaging over 20,000 children
- Distributing health and hygiene kits, conducting health trainings, and raising awareness through posters/banners reaching over 46,000 people
- Installing water infrastructure like hand pumps and latrines to improve access to water and sanitation for over 100,000 people
The report summarizes progress against targets for each activity and notes over 96% completion of overall objectives. District teams
