SlideShare a Scribd company logo
1

ESTIMATION
Author: Nguyen Phuc Hai
Created date: 1/9/2008

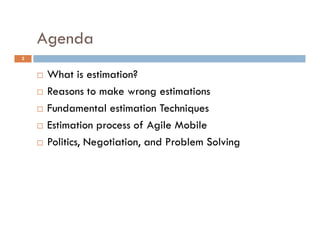

Agenda
2

     What is estimation?
     Reasons to make wrong estimations
     Fundamental estimation Techniques
     Estimation process of Agile Mobile
     Politics, Negotiation, and Problem Solving
What is estimation
3

    Estimates, Target and Commitments
    Good estimation

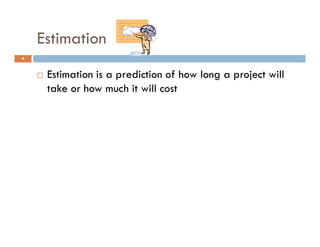

Estimation
4

     Estimation is a prediction of how long a project will
     take or how much it will cost
Target
5

     A Target is a statement of a desirable business
     objective.
     Examples:
       quot;We need to have Version 2.1 ready to demonstrate at a
       trade show in May.quot;
       quot;We need to have this release stabilized in time for the
       holiday sales cycle.“
     Businesses have important reasons to establish targets
     independent of software estimates. But the fact that a
     target is desirable or even mandatory does not
     necessarily mean that it is achievable.

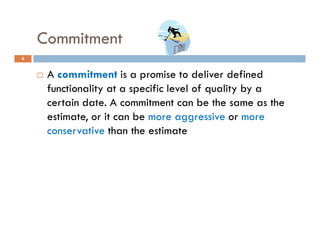

Commitment
6

     A commitment is a promise to deliver defined
     functionality at a specific level of quality by a
     certain date. A commitment can be the same as the
     estimate, or it can be more aggressive or more
     conservative than the estimate
Distinguish between estimates, targets, and commitments.

7
What is an estimation
8

    Estimate, Target and Commitments

    Good estimation
Good estimation
9

     A good estimation approach should provide
     estimates that are within 25% of the actual results
     75% of the time.
     However, accurate estimation results cannot be
     accomplished through estimation practices alone.
     They must also be supported by effective project
     control.

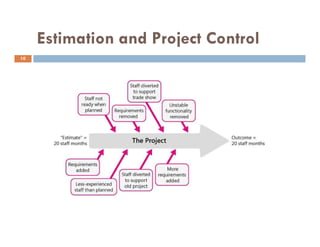

Estimation and Project Control
10

Estimation Track Record
11

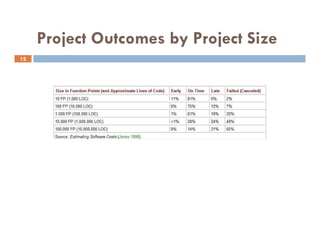

Project Outcomes by Project Size
12
Estimation and Project Control
13

      The criteria for a quot;goodquot; estimate cannot be based
      on its predictive capability, which is impossible to
      assess, but on the estimate's ability to support
      project success
Reasons to make incorrect
14
     estimation
Source of estimation Uncertainly
15

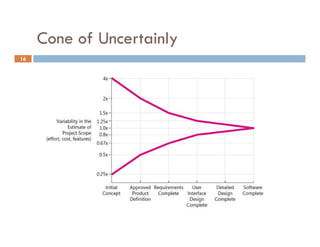

Cone of Uncertainly
16

The cone doesn’t narrow itself
17

     Don't assume that the Cone of Uncertainty will narrow itself. You must force the Cone
     to narrow by removing sources of variability from your project.
The cone doesn’t narrow itself
18

             Estimation Error by Software-Development Activity
The cone doesn’t narrow itself

19

      Relationship Between the Cone of Uncertainty and
      Commitment
        Meaningful commitments are not possible in the early,
        wide part of the Cone. Effective organizations delay
        their commitments until they have done the work to
        force the Cone to narrow.
        Meaningful commitments in the early-middle part of the
        project (about 30% of the way in) are possible and
        appropriate.
Chaotic Development Process
20
Common examples of project

     chaotic
21

      Requirements that weren't investigated very well
      in the first place
      Lack of end-user involvement in requirements
      validation
      Poor designs that lead to numerous errors in the
      code
      Poor coding practices that give rise to extensive
      bug fixing
      Inexperienced personnel
      Incomplete or unskilled project planning
      Abandoning planning under pressure
      Developer gold-plating
Unstable requirements

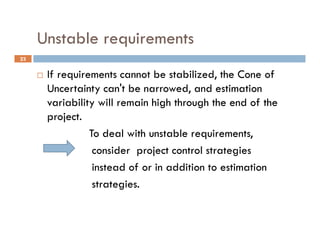

22
Unstable requirements
23

      If requirements cannot be stabilized, the Cone of
      Uncertainty can't be narrowed, and estimation
      variability will remain high through the end of the
      project.
                To deal with unstable requirements,
                 consider project control strategies
                 instead of or in addition to estimation
                 strategies.
Omitted activities
24
Software-Development Activities
     Commonly Missing
25

      Ramp-up time for new team members
      Mentoring of new team members
      Management coordination/manager meetings
       Requirements clarifications
      Maintaining the revision control system
      Review of technical documentation
      Coordination with team members
Software-Development Activities
     Commonly Missing
26

      Technical support of existing systems during the
      project
      Maintenance work on previous systems during the
      project
      Integration work
      Reviewing plans, estimates, architecture, detailed
      designs, stage plans, code, test cases, and so on
      Input to user documentation and review of user
      documentation

Non-Software-Development
     Activities Commonly Missing
27

      Vacations and Holidays
      Sick days
      Company/Department meetings
      Hardware and Software problems
      Setting up new Workstations
Unfounded optimism

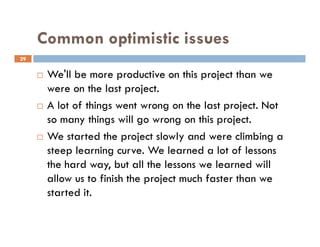

28
Common optimistic issues
29

      We'll be more productive on this project than we
      were on the last project.
      A lot of things went wrong on the last project. Not
      so many things will go wrong on this project.
      We started the project slowly and were climbing a
      steep learning curve. We learned a lot of lessons
      the hard way, but all the lessons we learned will
      allow us to finish the project much faster than we
      started it.

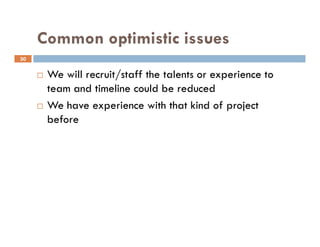

Common optimistic issues
30

      We will recruit/staff the talents or experience to
      team and timeline could be reduced
      We have experience with that kind of project
      before
Subjectivity and Bias
31
Off-The-Cuff Estimates
32
Avoid Off-The-Cuff Estimation
33

           Average error of estimates in these 24 groups of estimators for
           off-the-cuff estimates versus estimates that go through a group
           review process.
Unwarranted Precision
34

                                           VS
                  Accuracy                                  Precision

     Accuracy refers to how close to the real value a number is. Precision refers merely to how
     exact a number is. In software estimation, this amounts to how many significant digits an
     estimate has. A measurement can be precise without being accurate, and it can be accurate
      without being precise.

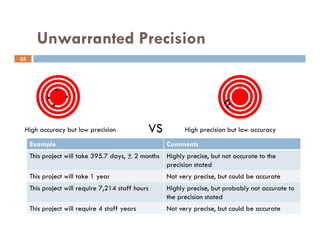

Unwarranted Precision
35

                                               VS
 High accuracy but low precision                          High precision but low accuracy

     Example                                        Comments
     This project will take 395.7 days, ± 2 months Highly precise, but not accurate to the
                                                   precision stated
     This project will take 1 year                  Not very precise, but could be accurate
     This project will require 7,214 staff hours    Highly precise, but probably not accurate to
                                                    the precision stated
     This project will require 4 staff years        Not very precise, but could be accurate
Other sources of error

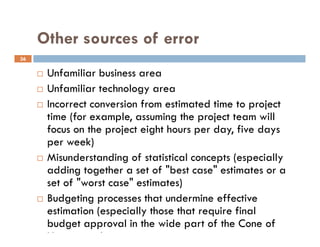

36

      Unfamiliar business area
      Unfamiliar technology area
      Incorrect conversion from estimated time to project
      time (for example, assuming the project team will
      focus on the project eight hours per day, five days
      per week)
      Misunderstanding of statistical concepts (especially
      adding together a set of quot;best casequot; estimates or a
      set of quot;worst casequot; estimates)
      Budgeting processes that undermine effective
      estimation (especially those that require final
      budget approval in the wide part of the Cone of
      Uncertainty)
Other sources of error (cont.)
37

      Having an accurate size estimate, but introducing
      errors when converting the size estimate to an effort
      estimate
      Having accurate size and effort estimates, but
      introducing errors when converting those to a
      schedule estimate
      Overstated savings from new development tools or
      methods
      Simplification of the estimate as it's reported up
      layers of management, fed into the budgeting
      process, and so on
Estimate Influences
38
Determinate factors to estimate
39

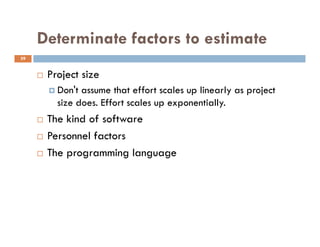

      Project size
        Don't assume that effort scales up linearly as project
        size does. Effort scales up exponentially.
      The kind of software
      Personnel factors
      The programming language
Fundamental Estimation Techniques
40
Choosing Estimation Techniques
41

      Project size
      Software Development Style
      Development Stage
      Accuracy Possible

Fundamental Estimation Techniques
42

         Count, Compute, Judge
     •
         Calibration and Historical Data
     •
Applicability

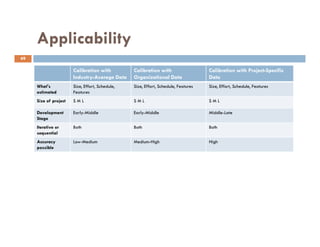

43

                               Count            Compute
     What's estimated          Size, Features   Size, Effort, Schedule, Features
     Size of project           SML              SML
     Development Stage         Early-Late       Early-Middle
     Iterative or sequential   Both             Both
     Accuracy possible         High             High

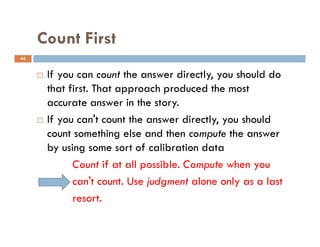

Count First
44

      If you can count the answer directly, you should do
      that first. That approach produced the most
      accurate answer in the story.
      If you can't count the answer directly, you should
      count something else and then compute the answer
      by using some sort of calibration data
            Count if at all possible. Compute when you
            can't count. Use judgment alone only as a last
            resort.

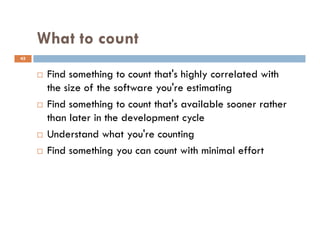

What to count
45

      Find something to count that's highly correlated with
      the size of the software you're estimating
      Find something to count that's available sooner rather
      than later in the development cycle
      Understand what you're counting
      Find something you can count with minimal effort

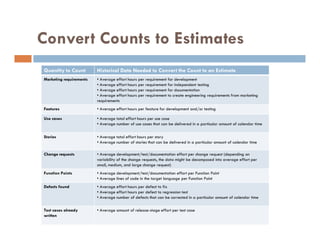

Convert Counts to Estimates
Quantity to Count        Historical Data Needed to Convert the Count to an Estimate
Marketing requirements   • Average effort hours per requirement for development
                         • Average effort hours per requirement for independent testing
                         • Average effort hours per requirement for documentation
                         • Average effort hours per requirement to create engineering requirements from marketing
                         requirements
Features                 • Average effort hours per feature for development and/or testing

Use cases                • Average total effort hours per use case
                         • Average number of use cases that can be delivered in a particular amount of calendar time

Stories                  • Average total effort hours per story
                         • Average number of stories that can be delivered in a particular amount of calendar time

Change requests          • Average development/test/documentation effort per change request (depending on
                         variability of the change requests, the data might be decomposed into average effort per
                         small, medium, and large change request)
Function Points          • Average development/test/documentation effort per Function Point
                         • Average lines of code in the target language per Function Point
Defects found            • Average effort hours per defect to fix
                                                                                      46
                         • Average effort hours per defect to regression test
                         • Average number of defects that can be corrected in a particular amount of calendar time

Test cases already       • Average amount of release-stage effort per test case
written

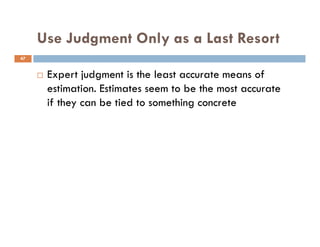

Use Judgment Only as a Last Resort
47

      Expert judgment is the least accurate means of
      estimation. Estimates seem to be the most accurate
      if they can be tied to something concrete
Fundamental Estimation Techniques
48

         Count, Compute, Judge
     •

         Calibration and Historical Data
     •
Applicability
49

                       Calibration with          Calibration with                   Calibration with Project-Specific
                       Industry-Average Data     Organizational Data                Data
     What's            Size, Effort, Schedule,   Size, Effort, Schedule, Features   Size, Effort, Schedule, Features
     estimated         Features
     Size of project   SML                       SML                                SML

     Development       Early-Middle              Early-Middle                       Middle-Late
     Stage
     Iterative or      Both                      Both                               Both
     sequential
     Accuracy          Low-Medium                Medium-High                        High
     possible
Data to collect
50

      Size (lines of code or something else you can count
      after the software has been released)
      Effort (staff months)
      Time (calendar months)
      Defects (classified by severity)

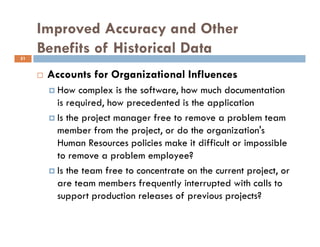

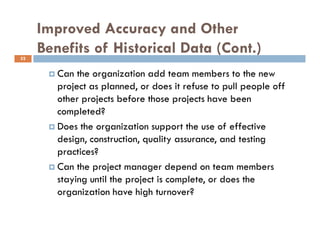

Improved Accuracy and Other
     Benefits of Historical Data
51

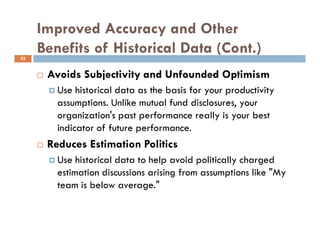

      Accounts for Organizational Influences
        How complex is the software, how much documentation
        is required, how precedented is the application
        Is the project manager free to remove a problem team
        member from the project, or do the organization's
        Human Resources policies make it difficult or impossible
        to remove a problem employee?
        Is the team free to concentrate on the current project, or
        are team members frequently interrupted with calls to
        support production releases of previous projects?
Improved Accuracy and Other
     Benefits of Historical Data (Cont.)
52

        Can the organization add team members to the new
        project as planned, or does it refuse to pull people off
        other projects before those projects have been
        completed?
        Does the organization support the use of effective
        design, construction, quality assurance, and testing
        practices?
        Can the project manager depend on team members
        staying until the project is complete, or does the
        organization have high turnover?
Improved Accuracy and Other
     Benefits of Historical Data (Cont.)
53

      Avoids Subjectivity and Unfounded Optimism
        Use historical data as the basis for your productivity
        assumptions. Unlike mutual fund disclosures, your
        organization's past performance really is your best
        indicator of future performance.
      Reduces Estimation Politics
        Use historical data to help avoid politically charged
        estimation discussions arising from assumptions like quot;My
        team is below average.quot;
How to calibrate
54

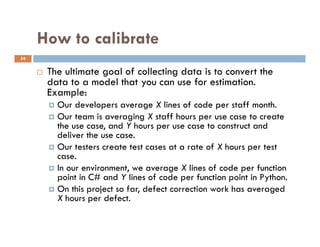

      The ultimate goal of collecting data is to convert the
      data to a model that you can use for estimation.
      Example:
        Our developers average X lines of code per staff month.
        Our team is averaging X staff hours per use case to create
        the use case, and Y hours per use case to construct and
        deliver the use case.
        Our testers create test cases at a rate of X hours per test
        case.
        In our environment, we average X lines of code per function
        point in C# and Y lines of code per function point in Python.
        On this project so far, defect correction work has averaged
        X hours per defect.
Using Project Data to Refine Your
     Estimates
55

      Even if you don't have historical data from past
      projects, you can collect data from your current
      project and use that as a basis for estimating the
      remainder of your project.
      Your goal should be to switch from using
      organizational data or industry-average data to
      project data as soon as you can. The more iterative
      your project is, the sooner you'll be able to do this.
Estimation process of Agile Mobile
56
What is story point?
57

      Story point is a random measure used by Scrum teams. This
      is used to measure the effort required to implement a story.
      Story points do give some indication of how much time was
      spent in a sprint.
      Example:
      At the end of a 10 day sprint a team of 4 covers 40 story
      points.
      10 days = 10 * 8 working hours = 80 hours. = 320 total
      hours as there are 4 developers. That equated to 160
      pairing hours.
      160 divided by 40 = 4 hours pair hours per story point.
Agile Mobile estimation method
58

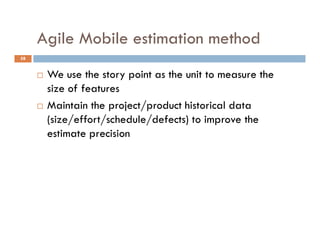

      We use the story point as the unit to measure the
      size of features
      Maintain the project/product historical data
      (size/effort/schedule/defects) to improve the
      estimate precision
Politics, Negotiation, and Problem Solving
59
Attributes of Executives
60

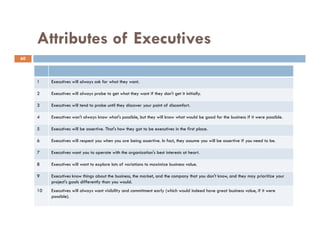

     1    Executives will always ask for what they want.

     2    Executives will always probe to get what they want if they don't get it initially.

     3    Executives will tend to probe until they discover your point of discomfort.

     4    Executives won't always know what's possible, but they will know what would be good for the business if it were possible.

     5    Executives will be assertive. That's how they got to be executives in the first place.

     6    Executives will respect you when you are being assertive. In fact, they assume you will be assertive if you need to be.

     7    Executives want you to operate with the organization's best interests at heart.

     8    Executives will want to explore lots of variations to maximize business value.

     9    Executives know things about the business, the market, and the company that you don't know, and they may prioritize your
          project's goals differently than you would.
     10   Executives will always want visibility and commitment early (which would indeed have great business value, if it were
          possible).
Political Influences on Estimates
61

      External Constraints

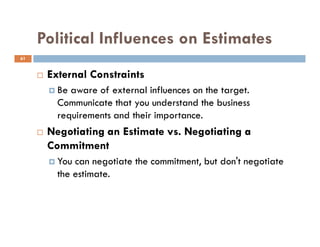

        Be aware of external influences on the target.
        Communicate that you understand the business
        requirements and their importance.
      Negotiating an Estimate vs. Negotiating a
      Commitment
        You can negotiate the commitment, but don't negotiate
        the estimate.
Political Influences on Estimates
62

      What to Do if Your Estimate Doesn't Get Accepted
        Let it be
      Responsibility of Technical Staff to Educate
      Nontechnical Stakeholders
        Educate nontechnical stakeholders about effective
        software estimation practices.
Problem Solving and Principled
     Negotiation
63

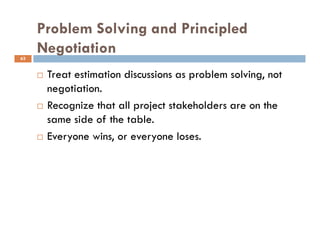

      Treat estimation discussions as problem solving, not
      negotiation.
      Recognize that all project stakeholders are on the
      same side of the table.
      Everyone wins, or everyone loses.
References
64
References
65

      Steve McConnell, Software Estimation: Demystifying
      the Black Art – Microsoft Press
      Mike Cohn, Agile Estimating and Planning – Prentice
      Hall

More Related Content

What's hot

Software Process Models
Software Process ModelsSoftware Process Models
Software Process Models
Atul Karmyal

Software Cost Estimation in Software Engineering SE23
Software Cost Estimation in Software Engineering SE23Software Cost Estimation in Software Engineering SE23
Software Cost Estimation in Software Engineering SE23koolkampus

Software quality assurance
Software quality assuranceSoftware quality assurance
Software quality assurance
Aman Adhikari

Capability maturity model cmm lecture 8
Capability maturity model cmm lecture 8Capability maturity model cmm lecture 8
Capability maturity model cmm lecture 8Abdul Basit

Risk management(software engineering)
Risk management(software engineering)Risk management(software engineering)
Risk management(software engineering)
Priya Tomar

Software project management Software economics
Software project management Software economicsSoftware project management Software economics
Software project management Software economics
REHMAT ULLAH

Staffing level estimation
Staffing level estimation Staffing level estimation
Staffing level estimation
kavitha muneeshwaran

Agile Vs Traditional Models
Agile Vs Traditional ModelsAgile Vs Traditional Models
Agile Vs Traditional Models
Sabir Ali Khuhro

Chapter 7 software reliability
Chapter 7 software reliabilityChapter 7 software reliability
Chapter 7 software reliability
despicable me

Lecture6
Lecture6Lecture6
Lecture6
soloeng

Resource Allocation In Software Project Management
Resource Allocation In Software Project ManagementResource Allocation In Software Project Management
Resource Allocation In Software Project Management
Syed Hassan Ali

Function Points
Function PointsFunction Points
Function Points
LuxoftAgilePractice

Software Development Life Cycle
Software Development Life CycleSoftware Development Life Cycle
Software Development Life Cycle
university of education,Lahore

Software cost estimation
Software cost estimationSoftware cost estimation
Software cost estimation
Dr. C.V. Suresh Babu

Software Measurement and Metrics.pptx
Software Measurement and Metrics.pptxSoftware Measurement and Metrics.pptx
Software Measurement and Metrics.pptx
ubaidullah75790

Software Project Management( lecture 1)
Software Project Management( lecture 1)Software Project Management( lecture 1)
Software Project Management( lecture 1)Syed Muhammad Hammad

software-effort_estimation(updated)9 ch05
 software-effort_estimation(updated)9 ch05 software-effort_estimation(updated)9 ch05
software-effort_estimation(updated)9 ch05
Shahid Riaz

Software complexity
Software complexitySoftware complexity
Software complexity
University of St Andrews

Risk management in software engineering
Risk management in software engineeringRisk management in software engineering
Risk management in software engineering
deep sharma

COCOMO MODEL 1 And 2
COCOMO MODEL 1 And 2COCOMO MODEL 1 And 2
COCOMO MODEL 1 And 2
Awais Siddique

What's hot (20)

Software Process Models
Software Process ModelsSoftware Process Models
Software Process Models

Software Cost Estimation in Software Engineering SE23
Software Cost Estimation in Software Engineering SE23Software Cost Estimation in Software Engineering SE23
Software Cost Estimation in Software Engineering SE23

Software quality assurance
Software quality assuranceSoftware quality assurance
Software quality assurance

Capability maturity model cmm lecture 8
Capability maturity model cmm lecture 8Capability maturity model cmm lecture 8
Capability maturity model cmm lecture 8

Risk management(software engineering)
Risk management(software engineering)Risk management(software engineering)
Risk management(software engineering)

Software project management Software economics
Software project management Software economicsSoftware project management Software economics
Software project management Software economics

Staffing level estimation
Staffing level estimation Staffing level estimation
Staffing level estimation

Agile Vs Traditional Models
Agile Vs Traditional ModelsAgile Vs Traditional Models
Agile Vs Traditional Models

Chapter 7 software reliability
Chapter 7 software reliabilityChapter 7 software reliability
Chapter 7 software reliability

Lecture6
Lecture6Lecture6
Lecture6

Resource Allocation In Software Project Management
Resource Allocation In Software Project ManagementResource Allocation In Software Project Management
Resource Allocation In Software Project Management

Function Points
Function PointsFunction Points
Function Points

Software Development Life Cycle
Software Development Life CycleSoftware Development Life Cycle
Software Development Life Cycle

Software cost estimation
Software cost estimationSoftware cost estimation
Software cost estimation

Software Measurement and Metrics.pptx
Software Measurement and Metrics.pptxSoftware Measurement and Metrics.pptx
Software Measurement and Metrics.pptx

Software Project Management( lecture 1)
Software Project Management( lecture 1)Software Project Management( lecture 1)
Software Project Management( lecture 1)

software-effort_estimation(updated)9 ch05
 software-effort_estimation(updated)9 ch05 software-effort_estimation(updated)9 ch05
software-effort_estimation(updated)9 ch05

Software complexity
Software complexitySoftware complexity
Software complexity

Risk management in software engineering
Risk management in software engineeringRisk management in software engineering
Risk management in software engineering

COCOMO MODEL 1 And 2
COCOMO MODEL 1 And 2COCOMO MODEL 1 And 2
COCOMO MODEL 1 And 2

Viewers also liked

Introduction to Software Cost Estimation
Introduction to Software Cost EstimationIntroduction to Software Cost Estimation
Introduction to Software Cost Estimation
Hemanth Raj

Test effort estimation
Test effort estimationTest effort estimation
Test effort estimationramesh kumar

Software estimation
Software estimationSoftware estimation
Software estimationMd Shakir

eSoftHead Service Introduction
eSoftHead Service IntroductioneSoftHead Service Introduction
eSoftHead Service Introduction
Nguyen Hai

Software testing
Software testingSoftware testing
Software testing
ankityadav.ec

Cost and time estimation methods pros and cons
Cost and time estimation methods pros and consCost and time estimation methods pros and cons
Cost and time estimation methods pros and cons
Pragnendra Rahevar

Estimation techniques and software metrics
Estimation techniques and software metricsEstimation techniques and software metrics
Estimation techniques and software metrics
Mae Abigail Banquil

Chap 5 Estimating Project Times
Chap 5 Estimating Project TimesChap 5 Estimating Project Times
Chap 5 Estimating Project Times
project management

Estimating Time & Costs
 Estimating Time & Costs Estimating Time & Costs
Estimating Time & Costs
mairemic

00 Introduction of project scheduling
00 Introduction of project scheduling00 Introduction of project scheduling
00 Introduction of project scheduling
Soe Naing Win

AN EMPIRICAL STUDY ON SOFTWARE TEST EFFORT ESTIMATION
AN EMPIRICAL STUDY ON SOFTWARE TEST EFFORT  ESTIMATIONAN EMPIRICAL STUDY ON SOFTWARE TEST EFFORT  ESTIMATION
AN EMPIRICAL STUDY ON SOFTWARE TEST EFFORT ESTIMATION
Lava Kafle

time-management-ppt
time-management-ppttime-management-ppt
time-management-ppt
Agrima

Viewers also liked (12)

Introduction to Software Cost Estimation
Introduction to Software Cost EstimationIntroduction to Software Cost Estimation
Introduction to Software Cost Estimation

Test effort estimation
Test effort estimationTest effort estimation
Test effort estimation

Software estimation
Software estimationSoftware estimation
Software estimation

eSoftHead Service Introduction
eSoftHead Service IntroductioneSoftHead Service Introduction
eSoftHead Service Introduction

Software testing
Software testingSoftware testing
Software testing

Cost and time estimation methods pros and cons
Cost and time estimation methods pros and consCost and time estimation methods pros and cons
Cost and time estimation methods pros and cons

Estimation techniques and software metrics
Estimation techniques and software metricsEstimation techniques and software metrics
Estimation techniques and software metrics

Chap 5 Estimating Project Times
Chap 5 Estimating Project TimesChap 5 Estimating Project Times
Chap 5 Estimating Project Times

Estimating Time & Costs
 Estimating Time & Costs Estimating Time & Costs
Estimating Time & Costs

00 Introduction of project scheduling
00 Introduction of project scheduling00 Introduction of project scheduling
00 Introduction of project scheduling

AN EMPIRICAL STUDY ON SOFTWARE TEST EFFORT ESTIMATION
AN EMPIRICAL STUDY ON SOFTWARE TEST EFFORT  ESTIMATIONAN EMPIRICAL STUDY ON SOFTWARE TEST EFFORT  ESTIMATION
AN EMPIRICAL STUDY ON SOFTWARE TEST EFFORT ESTIMATION

time-management-ppt
time-management-ppttime-management-ppt
time-management-ppt

Similar to Software Estimation

Estimation - web software development estimation DrupalCon and DrupalCamp pre...
Estimation - web software development estimation DrupalCon and DrupalCamp pre...Estimation - web software development estimation DrupalCon and DrupalCamp pre...
Estimation - web software development estimation DrupalCon and DrupalCamp pre...
Andy Kucharski

2015 drupalcampcebu estimation_jrf
2015 drupalcampcebu estimation_jrf2015 drupalcampcebu estimation_jrf
2015 drupalcampcebu estimation_jrf
Johnnie Fox

Software Estimation - part 1 of 2
Software Estimation - part 1 of 2Software Estimation - part 1 of 2
Software Estimation - part 1 of 2
Adi Dancu

Estimations: hit the target. Tips & Technics
Estimations: hit the target. Tips & TechnicsEstimations: hit the target. Tips & Technics
Estimations: hit the target. Tips & Technics
Alex Tymokhovsky

Gestión de Proyectos y mejores practicas
Gestión de Proyectos y mejores practicas Gestión de Proyectos y mejores practicas
Gestión de Proyectos y mejores practicas
✔Alejandro J. Román

Project management best practices
Project management best practicesProject management best practices
Project management best practices
Jackson Chan

Project management 02112009
Project management 02112009Project management 02112009
Project management 02112009
Manish Chaurasia

significance_of_test_estimating_in_the_software_development.pptx
significance_of_test_estimating_in_the_software_development.pptxsignificance_of_test_estimating_in_the_software_development.pptx
significance_of_test_estimating_in_the_software_development.pptx
sarah david

Adam Suchley - Predictive Delivery Assurance - APM Assurance SIG Conference 2018
Adam Suchley - Predictive Delivery Assurance - APM Assurance SIG Conference 2018Adam Suchley - Predictive Delivery Assurance - APM Assurance SIG Conference 2018
Adam Suchley - Predictive Delivery Assurance - APM Assurance SIG Conference 2018
Association for Project Management

Project Plan Development - A FlackVentures Training Example
Project Plan Development - A FlackVentures Training ExampleProject Plan Development - A FlackVentures Training Example
Project Plan Development - A FlackVentures Training Example
Kate Pynn

The Good, The Bad, and The Metrics
 The Good, The Bad, and The Metrics The Good, The Bad, and The Metrics
The Good, The Bad, and The Metrics
TeamQualityPro

IT Demand Management and Capacity Planning: Why Estimation Is Vital to Balanc...
IT Demand Management and Capacity Planning: Why Estimation Is Vital to Balanc...IT Demand Management and Capacity Planning: Why Estimation Is Vital to Balanc...
IT Demand Management and Capacity Planning: Why Estimation Is Vital to Balanc...
Quantitative Software Management, Inc.

Capacity Planning and Demand Management
Capacity Planning and Demand ManagementCapacity Planning and Demand Management
Capacity Planning and Demand ManagementLawrence Putnam Jr

Breaking the Project Failure Cycle
Breaking the Project Failure CycleBreaking the Project Failure Cycle
Breaking the Project Failure Cycle
Glen Alleman

Software Metrics: Taking the Guesswork Out of Software Projects
Software Metrics: Taking the Guesswork Out of Software ProjectsSoftware Metrics: Taking the Guesswork Out of Software Projects
Software Metrics: Taking the Guesswork Out of Software Projects
TechWell

significance_of_test_estimating_in_the_software_development.pptx
significance_of_test_estimating_in_the_software_development.pptxsignificance_of_test_estimating_in_the_software_development.pptx
significance_of_test_estimating_in_the_software_development.pptx
sarah david

Lecture 5 Estimation techniques.ppt
Lecture 5 Estimation techniques.pptLecture 5 Estimation techniques.ppt
Lecture 5 Estimation techniques.ppt
MaryamShah29

Why Do So Many Software Projects Fail?
Why Do So Many Software Projects Fail?Why Do So Many Software Projects Fail?
Why Do So Many Software Projects Fail?
Phil Comelio

Agile metrics at-pmi bangalore
Agile metrics at-pmi bangaloreAgile metrics at-pmi bangalore
Agile metrics at-pmi bangalore
Aguai Solutions Pvt Ltd

Similar to Software Estimation (20)

Estimation - web software development estimation DrupalCon and DrupalCamp pre...
Estimation - web software development estimation DrupalCon and DrupalCamp pre...Estimation - web software development estimation DrupalCon and DrupalCamp pre...
Estimation - web software development estimation DrupalCon and DrupalCamp pre...

2015 drupalcampcebu estimation_jrf
2015 drupalcampcebu estimation_jrf2015 drupalcampcebu estimation_jrf
2015 drupalcampcebu estimation_jrf

Software Estimation - part 1 of 2
Software Estimation - part 1 of 2Software Estimation - part 1 of 2
Software Estimation - part 1 of 2

Estimations: hit the target. Tips & Technics
Estimations: hit the target. Tips & TechnicsEstimations: hit the target. Tips & Technics
Estimations: hit the target. Tips & Technics

Gestión de Proyectos y mejores practicas
Gestión de Proyectos y mejores practicas Gestión de Proyectos y mejores practicas
Gestión de Proyectos y mejores practicas

Project management best practices
Project management best practicesProject management best practices
Project management best practices

Project management 02112009
Project management 02112009Project management 02112009
Project management 02112009

significance_of_test_estimating_in_the_software_development.pptx
significance_of_test_estimating_in_the_software_development.pptxsignificance_of_test_estimating_in_the_software_development.pptx
significance_of_test_estimating_in_the_software_development.pptx

Adam Suchley - Predictive Delivery Assurance - APM Assurance SIG Conference 2018
Adam Suchley - Predictive Delivery Assurance - APM Assurance SIG Conference 2018Adam Suchley - Predictive Delivery Assurance - APM Assurance SIG Conference 2018
Adam Suchley - Predictive Delivery Assurance - APM Assurance SIG Conference 2018

Project Plan Development - A FlackVentures Training Example
Project Plan Development - A FlackVentures Training ExampleProject Plan Development - A FlackVentures Training Example
Project Plan Development - A FlackVentures Training Example

Estimation
EstimationEstimation
Estimation

The Good, The Bad, and The Metrics
 The Good, The Bad, and The Metrics The Good, The Bad, and The Metrics
The Good, The Bad, and The Metrics

IT Demand Management and Capacity Planning: Why Estimation Is Vital to Balanc...
IT Demand Management and Capacity Planning: Why Estimation Is Vital to Balanc...IT Demand Management and Capacity Planning: Why Estimation Is Vital to Balanc...
IT Demand Management and Capacity Planning: Why Estimation Is Vital to Balanc...

Capacity Planning and Demand Management
Capacity Planning and Demand ManagementCapacity Planning and Demand Management
Capacity Planning and Demand Management

Breaking the Project Failure Cycle
Breaking the Project Failure CycleBreaking the Project Failure Cycle
Breaking the Project Failure Cycle

Software Metrics: Taking the Guesswork Out of Software Projects
Software Metrics: Taking the Guesswork Out of Software ProjectsSoftware Metrics: Taking the Guesswork Out of Software Projects
Software Metrics: Taking the Guesswork Out of Software Projects

significance_of_test_estimating_in_the_software_development.pptx
significance_of_test_estimating_in_the_software_development.pptxsignificance_of_test_estimating_in_the_software_development.pptx
significance_of_test_estimating_in_the_software_development.pptx

Lecture 5 Estimation techniques.ppt
Lecture 5 Estimation techniques.pptLecture 5 Estimation techniques.ppt
Lecture 5 Estimation techniques.ppt

Why Do So Many Software Projects Fail?
Why Do So Many Software Projects Fail?Why Do So Many Software Projects Fail?
Why Do So Many Software Projects Fail?

Agile metrics at-pmi bangalore
Agile metrics at-pmi bangaloreAgile metrics at-pmi bangalore
Agile metrics at-pmi bangalore

Recently uploaded

To Graph or Not to Graph Knowledge Graph Architectures and LLMs
To Graph or Not to Graph Knowledge Graph Architectures and LLMsTo Graph or Not to Graph Knowledge Graph Architectures and LLMs
To Graph or Not to Graph Knowledge Graph Architectures and LLMs
Paul Groth

AI for Every Business: Unlocking Your Product's Universal Potential by VP of ...
AI for Every Business: Unlocking Your Product's Universal Potential by VP of ...AI for Every Business: Unlocking Your Product's Universal Potential by VP of ...
AI for Every Business: Unlocking Your Product's Universal Potential by VP of ...
Product School

JMeter webinar - integration with InfluxDB and Grafana
JMeter webinar - integration with InfluxDB and GrafanaJMeter webinar - integration with InfluxDB and Grafana
JMeter webinar - integration with InfluxDB and Grafana
RTTS

Designing Great Products: The Power of Design and Leadership by Chief Designe...
Designing Great Products: The Power of Design and Leadership by Chief Designe...Designing Great Products: The Power of Design and Leadership by Chief Designe...
Designing Great Products: The Power of Design and Leadership by Chief Designe...
Product School

How world-class product teams are winning in the AI era by CEO and Founder, P...
How world-class product teams are winning in the AI era by CEO and Founder, P...How world-class product teams are winning in the AI era by CEO and Founder, P...
How world-class product teams are winning in the AI era by CEO and Founder, P...
Product School

FIDO Alliance Osaka Seminar: Passkeys and the Road Ahead.pdf
FIDO Alliance Osaka Seminar: Passkeys and the Road Ahead.pdfFIDO Alliance Osaka Seminar: Passkeys and the Road Ahead.pdf
FIDO Alliance Osaka Seminar: Passkeys and the Road Ahead.pdf
FIDO Alliance

Neuro-symbolic is not enough, we need neuro-*semantic*
Neuro-symbolic is not enough, we need neuro-*semantic*Neuro-symbolic is not enough, we need neuro-*semantic*
Neuro-symbolic is not enough, we need neuro-*semantic*
Frank van Harmelen

Elevating Tactical DDD Patterns Through Object Calisthenics
Elevating Tactical DDD Patterns Through Object CalisthenicsElevating Tactical DDD Patterns Through Object Calisthenics
Elevating Tactical DDD Patterns Through Object Calisthenics
Dorra BARTAGUIZ

UiPath Test Automation using UiPath Test Suite series, part 4
UiPath Test Automation using UiPath Test Suite series, part 4UiPath Test Automation using UiPath Test Suite series, part 4
UiPath Test Automation using UiPath Test Suite series, part 4
DianaGray10

Builder.ai Founder Sachin Dev Duggal's Strategic Approach to Create an Innova...
Builder.ai Founder Sachin Dev Duggal's Strategic Approach to Create an Innova...Builder.ai Founder Sachin Dev Duggal's Strategic Approach to Create an Innova...
Builder.ai Founder Sachin Dev Duggal's Strategic Approach to Create an Innova...
Ramesh Iyer

Kubernetes & AI - Beauty and the Beast !?! @KCD Istanbul 2024
Kubernetes & AI - Beauty and the Beast !?! @KCD Istanbul 2024Kubernetes & AI - Beauty and the Beast !?! @KCD Istanbul 2024
Kubernetes & AI - Beauty and the Beast !?! @KCD Istanbul 2024
Tobias Schneck

The Art of the Pitch: WordPress Relationships and Sales
The Art of the Pitch: WordPress Relationships and SalesThe Art of the Pitch: WordPress Relationships and Sales
The Art of the Pitch: WordPress Relationships and Sales
Laura Byrne

Monitoring Java Application Security with JDK Tools and JFR Events
Monitoring Java Application Security with JDK Tools and JFR EventsMonitoring Java Application Security with JDK Tools and JFR Events
Monitoring Java Application Security with JDK Tools and JFR Events
Ana-Maria Mihalceanu

PCI PIN Basics Webinar from the Controlcase Team
PCI PIN Basics Webinar from the Controlcase TeamPCI PIN Basics Webinar from the Controlcase Team
PCI PIN Basics Webinar from the Controlcase Team
ControlCase

Unsubscribed: Combat Subscription Fatigue With a Membership Mentality by Head...
Unsubscribed: Combat Subscription Fatigue With a Membership Mentality by Head...Unsubscribed: Combat Subscription Fatigue With a Membership Mentality by Head...
Unsubscribed: Combat Subscription Fatigue With a Membership Mentality by Head...
Product School

Accelerate your Kubernetes clusters with Varnish Caching
Accelerate your Kubernetes clusters with Varnish CachingAccelerate your Kubernetes clusters with Varnish Caching
Accelerate your Kubernetes clusters with Varnish Caching
Thijs Feryn

Slack (or Teams) Automation for Bonterra Impact Management (fka Social Soluti...
Slack (or Teams) Automation for Bonterra Impact Management (fka Social Soluti...Slack (or Teams) Automation for Bonterra Impact Management (fka Social Soluti...
Slack (or Teams) Automation for Bonterra Impact Management (fka Social Soluti...
Jeffrey Haguewood

Connector Corner: Automate dynamic content and events by pushing a button
Connector Corner: Automate dynamic content and events by pushing a buttonConnector Corner: Automate dynamic content and events by pushing a button
Connector Corner: Automate dynamic content and events by pushing a button
DianaGray10

De-mystifying Zero to One: Design Informed Techniques for Greenfield Innovati...
De-mystifying Zero to One: Design Informed Techniques for Greenfield Innovati...De-mystifying Zero to One: Design Informed Techniques for Greenfield Innovati...
De-mystifying Zero to One: Design Informed Techniques for Greenfield Innovati...
Product School

Encryption in Microsoft 365 - ExpertsLive Netherlands 2024
Encryption in Microsoft 365 - ExpertsLive Netherlands 2024Encryption in Microsoft 365 - ExpertsLive Netherlands 2024
Encryption in Microsoft 365 - ExpertsLive Netherlands 2024
Albert Hoitingh

Recently uploaded (20)

To Graph or Not to Graph Knowledge Graph Architectures and LLMs
To Graph or Not to Graph Knowledge Graph Architectures and LLMsTo Graph or Not to Graph Knowledge Graph Architectures and LLMs
To Graph or Not to Graph Knowledge Graph Architectures and LLMs

AI for Every Business: Unlocking Your Product's Universal Potential by VP of ...
AI for Every Business: Unlocking Your Product's Universal Potential by VP of ...AI for Every Business: Unlocking Your Product's Universal Potential by VP of ...
AI for Every Business: Unlocking Your Product's Universal Potential by VP of ...

JMeter webinar - integration with InfluxDB and Grafana
JMeter webinar - integration with InfluxDB and GrafanaJMeter webinar - integration with InfluxDB and Grafana
JMeter webinar - integration with InfluxDB and Grafana

Designing Great Products: The Power of Design and Leadership by Chief Designe...
Designing Great Products: The Power of Design and Leadership by Chief Designe...Designing Great Products: The Power of Design and Leadership by Chief Designe...
Designing Great Products: The Power of Design and Leadership by Chief Designe...

How world-class product teams are winning in the AI era by CEO and Founder, P...
How world-class product teams are winning in the AI era by CEO and Founder, P...How world-class product teams are winning in the AI era by CEO and Founder, P...
How world-class product teams are winning in the AI era by CEO and Founder, P...

FIDO Alliance Osaka Seminar: Passkeys and the Road Ahead.pdf
FIDO Alliance Osaka Seminar: Passkeys and the Road Ahead.pdfFIDO Alliance Osaka Seminar: Passkeys and the Road Ahead.pdf
FIDO Alliance Osaka Seminar: Passkeys and the Road Ahead.pdf

Neuro-symbolic is not enough, we need neuro-*semantic*
Neuro-symbolic is not enough, we need neuro-*semantic*Neuro-symbolic is not enough, we need neuro-*semantic*
Neuro-symbolic is not enough, we need neuro-*semantic*

Elevating Tactical DDD Patterns Through Object Calisthenics
Elevating Tactical DDD Patterns Through Object CalisthenicsElevating Tactical DDD Patterns Through Object Calisthenics
Elevating Tactical DDD Patterns Through Object Calisthenics

UiPath Test Automation using UiPath Test Suite series, part 4
UiPath Test Automation using UiPath Test Suite series, part 4UiPath Test Automation using UiPath Test Suite series, part 4
UiPath Test Automation using UiPath Test Suite series, part 4

Builder.ai Founder Sachin Dev Duggal's Strategic Approach to Create an Innova...
Builder.ai Founder Sachin Dev Duggal's Strategic Approach to Create an Innova...Builder.ai Founder Sachin Dev Duggal's Strategic Approach to Create an Innova...
Builder.ai Founder Sachin Dev Duggal's Strategic Approach to Create an Innova...

Kubernetes & AI - Beauty and the Beast !?! @KCD Istanbul 2024
Kubernetes & AI - Beauty and the Beast !?! @KCD Istanbul 2024Kubernetes & AI - Beauty and the Beast !?! @KCD Istanbul 2024
Kubernetes & AI - Beauty and the Beast !?! @KCD Istanbul 2024

The Art of the Pitch: WordPress Relationships and Sales
The Art of the Pitch: WordPress Relationships and SalesThe Art of the Pitch: WordPress Relationships and Sales
The Art of the Pitch: WordPress Relationships and Sales

Monitoring Java Application Security with JDK Tools and JFR Events
Monitoring Java Application Security with JDK Tools and JFR EventsMonitoring Java Application Security with JDK Tools and JFR Events
Monitoring Java Application Security with JDK Tools and JFR Events

PCI PIN Basics Webinar from the Controlcase Team
PCI PIN Basics Webinar from the Controlcase TeamPCI PIN Basics Webinar from the Controlcase Team
PCI PIN Basics Webinar from the Controlcase Team

Unsubscribed: Combat Subscription Fatigue With a Membership Mentality by Head...
Unsubscribed: Combat Subscription Fatigue With a Membership Mentality by Head...Unsubscribed: Combat Subscription Fatigue With a Membership Mentality by Head...
Unsubscribed: Combat Subscription Fatigue With a Membership Mentality by Head...

Accelerate your Kubernetes clusters with Varnish Caching
Accelerate your Kubernetes clusters with Varnish CachingAccelerate your Kubernetes clusters with Varnish Caching
Accelerate your Kubernetes clusters with Varnish Caching

Slack (or Teams) Automation for Bonterra Impact Management (fka Social Soluti...
Slack (or Teams) Automation for Bonterra Impact Management (fka Social Soluti...Slack (or Teams) Automation for Bonterra Impact Management (fka Social Soluti...
Slack (or Teams) Automation for Bonterra Impact Management (fka Social Soluti...

Connector Corner: Automate dynamic content and events by pushing a button
Connector Corner: Automate dynamic content and events by pushing a buttonConnector Corner: Automate dynamic content and events by pushing a button
Connector Corner: Automate dynamic content and events by pushing a button

De-mystifying Zero to One: Design Informed Techniques for Greenfield Innovati...
De-mystifying Zero to One: Design Informed Techniques for Greenfield Innovati...De-mystifying Zero to One: Design Informed Techniques for Greenfield Innovati...
De-mystifying Zero to One: Design Informed Techniques for Greenfield Innovati...

Encryption in Microsoft 365 - ExpertsLive Netherlands 2024
Encryption in Microsoft 365 - ExpertsLive Netherlands 2024Encryption in Microsoft 365 - ExpertsLive Netherlands 2024
Encryption in Microsoft 365 - ExpertsLive Netherlands 2024

Software Estimation

  • 1. 1 ESTIMATION Author: Nguyen Phuc Hai Created date: 1/9/2008
  • 2. Agenda 2 What is estimation? Reasons to make wrong estimations Fundamental estimation Techniques Estimation process of Agile Mobile Politics, Negotiation, and Problem Solving
  • 3. What is estimation 3 Estimates, Target and Commitments Good estimation
  • 4. Estimation 4 Estimation is a prediction of how long a project will take or how much it will cost
  • 5. Target 5 A Target is a statement of a desirable business objective. Examples: quot;We need to have Version 2.1 ready to demonstrate at a trade show in May.quot; quot;We need to have this release stabilized in time for the holiday sales cycle.“ Businesses have important reasons to establish targets independent of software estimates. But the fact that a target is desirable or even mandatory does not necessarily mean that it is achievable.
  • 6. Commitment 6 A commitment is a promise to deliver defined functionality at a specific level of quality by a certain date. A commitment can be the same as the estimate, or it can be more aggressive or more conservative than the estimate
  • 7. Distinguish between estimates, targets, and commitments. 7
  • 8. What is an estimation 8 Estimate, Target and Commitments Good estimation
  • 9. Good estimation 9 A good estimation approach should provide estimates that are within 25% of the actual results 75% of the time. However, accurate estimation results cannot be accomplished through estimation practices alone. They must also be supported by effective project control.
  • 12. Project Outcomes by Project Size 12
  • 13. Estimation and Project Control 13 The criteria for a quot;goodquot; estimate cannot be based on its predictive capability, which is impossible to assess, but on the estimate's ability to support project success
  • 14. Reasons to make incorrect 14 estimation
  • 15. Source of estimation Uncertainly 15
  • 17. The cone doesn’t narrow itself 17 Don't assume that the Cone of Uncertainty will narrow itself. You must force the Cone to narrow by removing sources of variability from your project.
  • 18. The cone doesn’t narrow itself 18 Estimation Error by Software-Development Activity
  • 19. The cone doesn’t narrow itself 19 Relationship Between the Cone of Uncertainty and Commitment Meaningful commitments are not possible in the early, wide part of the Cone. Effective organizations delay their commitments until they have done the work to force the Cone to narrow. Meaningful commitments in the early-middle part of the project (about 30% of the way in) are possible and appropriate.
  • 21. Common examples of project chaotic 21 Requirements that weren't investigated very well in the first place Lack of end-user involvement in requirements validation Poor designs that lead to numerous errors in the code Poor coding practices that give rise to extensive bug fixing Inexperienced personnel Incomplete or unskilled project planning Abandoning planning under pressure Developer gold-plating
  • 23. Unstable requirements 23 If requirements cannot be stabilized, the Cone of Uncertainty can't be narrowed, and estimation variability will remain high through the end of the project. To deal with unstable requirements, consider project control strategies instead of or in addition to estimation strategies.
  • 25. Software-Development Activities Commonly Missing 25 Ramp-up time for new team members Mentoring of new team members Management coordination/manager meetings Requirements clarifications Maintaining the revision control system Review of technical documentation Coordination with team members
  • 26. Software-Development Activities Commonly Missing 26 Technical support of existing systems during the project Maintenance work on previous systems during the project Integration work Reviewing plans, estimates, architecture, detailed designs, stage plans, code, test cases, and so on Input to user documentation and review of user documentation
  • 27. Non-Software-Development Activities Commonly Missing 27 Vacations and Holidays Sick days Company/Department meetings Hardware and Software problems Setting up new Workstations
  • 29. Common optimistic issues 29 We'll be more productive on this project than we were on the last project. A lot of things went wrong on the last project. Not so many things will go wrong on this project. We started the project slowly and were climbing a steep learning curve. We learned a lot of lessons the hard way, but all the lessons we learned will allow us to finish the project much faster than we started it.
  • 30. Common optimistic issues 30 We will recruit/staff the talents or experience to team and timeline could be reduced We have experience with that kind of project before
  • 33. Avoid Off-The-Cuff Estimation 33 Average error of estimates in these 24 groups of estimators for off-the-cuff estimates versus estimates that go through a group review process.
  • 34. Unwarranted Precision 34 VS Accuracy Precision Accuracy refers to how close to the real value a number is. Precision refers merely to how exact a number is. In software estimation, this amounts to how many significant digits an estimate has. A measurement can be precise without being accurate, and it can be accurate without being precise.
  • 35. Unwarranted Precision 35 VS High accuracy but low precision High precision but low accuracy Example Comments This project will take 395.7 days, ± 2 months Highly precise, but not accurate to the precision stated This project will take 1 year Not very precise, but could be accurate This project will require 7,214 staff hours Highly precise, but probably not accurate to the precision stated This project will require 4 staff years Not very precise, but could be accurate
  • 36. Other sources of error 36 Unfamiliar business area Unfamiliar technology area Incorrect conversion from estimated time to project time (for example, assuming the project team will focus on the project eight hours per day, five days per week) Misunderstanding of statistical concepts (especially adding together a set of quot;best casequot; estimates or a set of quot;worst casequot; estimates) Budgeting processes that undermine effective estimation (especially those that require final budget approval in the wide part of the Cone of Uncertainty)
  • 37. Other sources of error (cont.) 37 Having an accurate size estimate, but introducing errors when converting the size estimate to an effort estimate Having accurate size and effort estimates, but introducing errors when converting those to a schedule estimate Overstated savings from new development tools or methods Simplification of the estimate as it's reported up layers of management, fed into the budgeting process, and so on
  • 39. Determinate factors to estimate 39 Project size Don't assume that effort scales up linearly as project size does. Effort scales up exponentially. The kind of software Personnel factors The programming language
  • 41. Choosing Estimation Techniques 41 Project size Software Development Style Development Stage Accuracy Possible
  • 42. Fundamental Estimation Techniques 42 Count, Compute, Judge • Calibration and Historical Data •
  • 43. Applicability 43 Count Compute What's estimated Size, Features Size, Effort, Schedule, Features Size of project SML SML Development Stage Early-Late Early-Middle Iterative or sequential Both Both Accuracy possible High High
  • 44. Count First 44 If you can count the answer directly, you should do that first. That approach produced the most accurate answer in the story. If you can't count the answer directly, you should count something else and then compute the answer by using some sort of calibration data Count if at all possible. Compute when you can't count. Use judgment alone only as a last resort.
  • 45. What to count 45 Find something to count that's highly correlated with the size of the software you're estimating Find something to count that's available sooner rather than later in the development cycle Understand what you're counting Find something you can count with minimal effort
  • 46. Convert Counts to Estimates Quantity to Count Historical Data Needed to Convert the Count to an Estimate Marketing requirements • Average effort hours per requirement for development • Average effort hours per requirement for independent testing • Average effort hours per requirement for documentation • Average effort hours per requirement to create engineering requirements from marketing requirements Features • Average effort hours per feature for development and/or testing Use cases • Average total effort hours per use case • Average number of use cases that can be delivered in a particular amount of calendar time Stories • Average total effort hours per story • Average number of stories that can be delivered in a particular amount of calendar time Change requests • Average development/test/documentation effort per change request (depending on variability of the change requests, the data might be decomposed into average effort per small, medium, and large change request) Function Points • Average development/test/documentation effort per Function Point • Average lines of code in the target language per Function Point Defects found • Average effort hours per defect to fix 46 • Average effort hours per defect to regression test • Average number of defects that can be corrected in a particular amount of calendar time Test cases already • Average amount of release-stage effort per test case written
  • 47. Use Judgment Only as a Last Resort 47 Expert judgment is the least accurate means of estimation. Estimates seem to be the most accurate if they can be tied to something concrete
  • 48. Fundamental Estimation Techniques 48 Count, Compute, Judge • Calibration and Historical Data •
  • 49. Applicability 49 Calibration with Calibration with Calibration with Project-Specific Industry-Average Data Organizational Data Data What's Size, Effort, Schedule, Size, Effort, Schedule, Features Size, Effort, Schedule, Features estimated Features Size of project SML SML SML Development Early-Middle Early-Middle Middle-Late Stage Iterative or Both Both Both sequential Accuracy Low-Medium Medium-High High possible
  • 50. Data to collect 50 Size (lines of code or something else you can count after the software has been released) Effort (staff months) Time (calendar months) Defects (classified by severity)
  • 51. Improved Accuracy and Other Benefits of Historical Data 51 Accounts for Organizational Influences How complex is the software, how much documentation is required, how precedented is the application Is the project manager free to remove a problem team member from the project, or do the organization's Human Resources policies make it difficult or impossible to remove a problem employee? Is the team free to concentrate on the current project, or are team members frequently interrupted with calls to support production releases of previous projects?
  • 52. Improved Accuracy and Other Benefits of Historical Data (Cont.) 52 Can the organization add team members to the new project as planned, or does it refuse to pull people off other projects before those projects have been completed? Does the organization support the use of effective design, construction, quality assurance, and testing practices? Can the project manager depend on team members staying until the project is complete, or does the organization have high turnover?
  • 53. Improved Accuracy and Other Benefits of Historical Data (Cont.) 53 Avoids Subjectivity and Unfounded Optimism Use historical data as the basis for your productivity assumptions. Unlike mutual fund disclosures, your organization's past performance really is your best indicator of future performance. Reduces Estimation Politics Use historical data to help avoid politically charged estimation discussions arising from assumptions like quot;My team is below average.quot;
  • 54. How to calibrate 54 The ultimate goal of collecting data is to convert the data to a model that you can use for estimation. Example: Our developers average X lines of code per staff month. Our team is averaging X staff hours per use case to create the use case, and Y hours per use case to construct and deliver the use case. Our testers create test cases at a rate of X hours per test case. In our environment, we average X lines of code per function point in C# and Y lines of code per function point in Python. On this project so far, defect correction work has averaged X hours per defect.
  • 55. Using Project Data to Refine Your Estimates 55 Even if you don't have historical data from past projects, you can collect data from your current project and use that as a basis for estimating the remainder of your project. Your goal should be to switch from using organizational data or industry-average data to project data as soon as you can. The more iterative your project is, the sooner you'll be able to do this.
  • 56. Estimation process of Agile Mobile 56
  • 57. What is story point? 57 Story point is a random measure used by Scrum teams. This is used to measure the effort required to implement a story. Story points do give some indication of how much time was spent in a sprint. Example: At the end of a 10 day sprint a team of 4 covers 40 story points. 10 days = 10 * 8 working hours = 80 hours. = 320 total hours as there are 4 developers. That equated to 160 pairing hours. 160 divided by 40 = 4 hours pair hours per story point.
  • 58. Agile Mobile estimation method 58 We use the story point as the unit to measure the size of features Maintain the project/product historical data (size/effort/schedule/defects) to improve the estimate precision
  • 59. Politics, Negotiation, and Problem Solving 59
  • 60. Attributes of Executives 60 1 Executives will always ask for what they want. 2 Executives will always probe to get what they want if they don't get it initially. 3 Executives will tend to probe until they discover your point of discomfort. 4 Executives won't always know what's possible, but they will know what would be good for the business if it were possible. 5 Executives will be assertive. That's how they got to be executives in the first place. 6 Executives will respect you when you are being assertive. In fact, they assume you will be assertive if you need to be. 7 Executives want you to operate with the organization's best interests at heart. 8 Executives will want to explore lots of variations to maximize business value. 9 Executives know things about the business, the market, and the company that you don't know, and they may prioritize your project's goals differently than you would. 10 Executives will always want visibility and commitment early (which would indeed have great business value, if it were possible).
  • 61. Political Influences on Estimates 61 External Constraints Be aware of external influences on the target. Communicate that you understand the business requirements and their importance. Negotiating an Estimate vs. Negotiating a Commitment You can negotiate the commitment, but don't negotiate the estimate.
  • 62. Political Influences on Estimates 62 What to Do if Your Estimate Doesn't Get Accepted Let it be Responsibility of Technical Staff to Educate Nontechnical Stakeholders Educate nontechnical stakeholders about effective software estimation practices.
  • 63. Problem Solving and Principled Negotiation 63 Treat estimation discussions as problem solving, not negotiation. Recognize that all project stakeholders are on the same side of the table. Everyone wins, or everyone loses.
  • 65. References 65 Steve McConnell, Software Estimation: Demystifying the Black Art – Microsoft Press Mike Cohn, Agile Estimating and Planning – Prentice Hall
