ERP lmplementation Failure
at Hershey Foods Corporation
INTRODUCTION

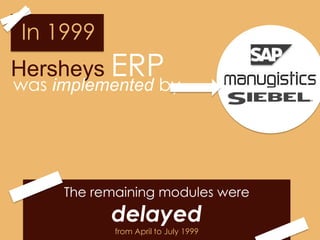

In 1999
Hersheys ERP
was implemented by

     The remaining modules were
           delayed
            from April to July 1999
IMPLEMENTATION…
       …to QUICKEN
    the implementation
          process!
Simultaneous
               implementation
                 of modules lead to

IMPLEMENTATION…
       …to QUICKEN
    the implementation
          process!

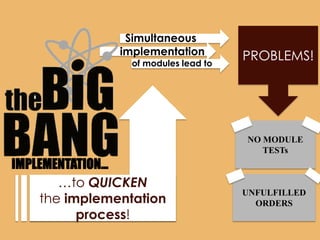

Simultaneous
               implementation         PROBLEMS!
                 of modules lead to

                                      NO MODULE
                                         TESTs
IMPLEMENTATION…
       …to QUICKEN
                                      UNFULFILLED
    the implementation                  ORDERS
          process!

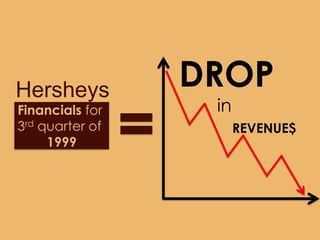

Hersheys
Financials for
3rd quarter of
     1999
Hersheys         DROP
Financials for    in
3rd quarter of         REVENUE$
     1999
Founded
            by Milton
            Hershey in

1 st                      known for several
                             innovations
                                  +
 company to make         chocolate variations
IMPLEMENTING
         ERP
Hershey
price$ its
             low
Hershey
price$ its
             low

                   Efficient IT
                    systems
 HUGE              necessary
quantities           to support
                    logistics and
                    supply chain

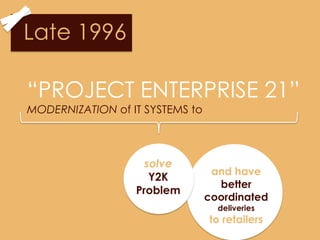

Late 1996

“PROJECT ENTERPRISE 21”
MODERNIZATION of IT SYSTEMS to

                    solve
                                  and have
                     Y2K
                                   better
                  Problem
                                 coordinated
                                   deliveries
                                 to retailers
ERP software
to help reorganize
business
    PROBLEMS!
processes!

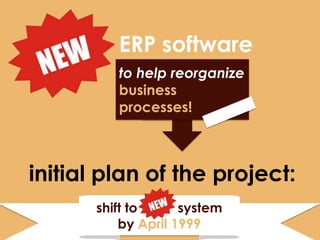

ERP software
          to help reorganize
          business
              PROBLEMS!
          processes!

initial plan of the project:
       shift to      system
           by April 1999
other
  modules
   were
  BEHIND
 SCHEDULE

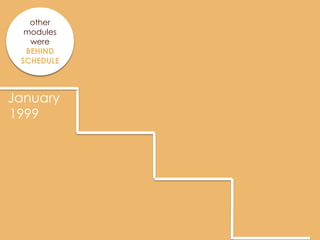

January
1999
other
  modules
   were
  BEHIND
 SCHEDULE

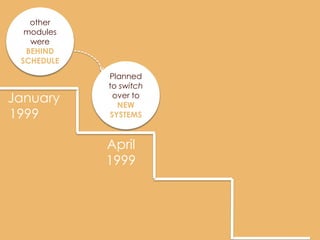

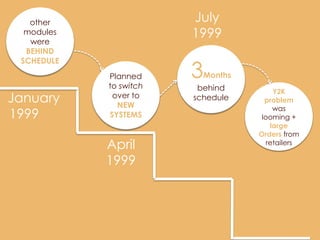

            Planned
            to switch
January      over to
              NEW
1999        SYSTEMS

            April
            1999
other
                        July
  modules
   were
                        1999
  BEHIND
 SCHEDULE                Planned

            Planned
            to switch
                        3
                        to switch
                           Months
                          over to
                          behind
                           NEW
January      over to
              NEW
                        schedule
                         SYSTEMS

1999        SYSTEMS

            April
            1999
other
                        July
  modules
   were
                        1999
  BEHIND
 SCHEDULE                Planned

            Planned
            to switch
                        3
                        to switch
                           Months
                          over to
                          behind
                           NEW           Y2K
January      over to
              NEW
                        schedule
                         SYSTEMS      problem
                                         was
1999        SYSTEMS                  looming +
                                        large
                                    Orders from
            April                      retailers

            1999
other                July
  modules
   were
                        1999
  BEHIND
 SCHEDULE
            Planned
            to switch
                        3 Months
                         behind         Y2K
January      over to
              NEW
                        schedule     problem
                                        was
1999        SYSTEMS                 looming +
                                       large
                                   Orders from
            April                     retailers

            1999

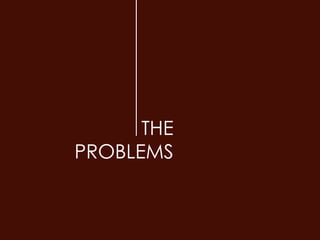

THE
PROBLEMS

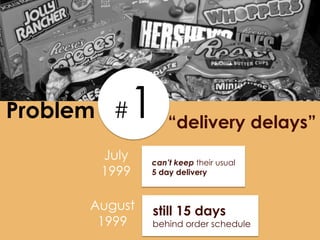

Problem #  1       “delivery delays”
       July    can’t keep their usual
       1999    5 day delivery

      August   still 15 days
       1999    behind order schedule
Problem #                    2
    “Loss in Credibility”
       because they failed to
       supply products in time

 “Loss of Market Share”
because suppliers looked for reliable
           alternatives
“  lf you don't have my toothpaste,
I'm walking out. But for a chocolate bar,
I'll pick another one.
                                  ”
Problem # 3

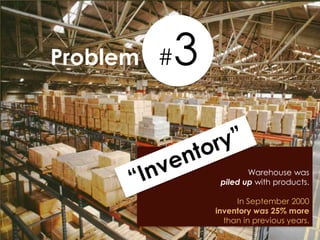

                          Warehouse was
                   piled up with products.

    “Inventory”        In September 2000
                  inventory was 25% more
                    than in previous years.
Analysts say
       the cause
         of the
        problem
          was…

MISSING INVENTORY
DATABASE in
SAP R/3 ERP software

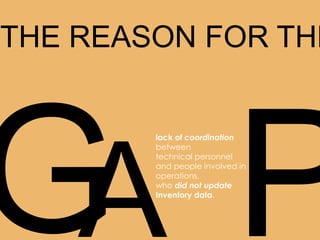

THE REASON FOR THE

        lack of coordination
        between
        technical personnel
        and people involved in
        operations,
        who did not update
        Inventory data.
WHAT WENT

            WRONG

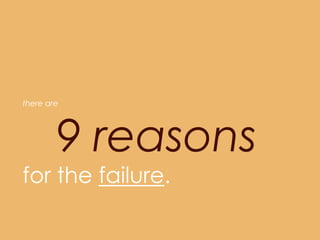

there are

        9 reasons
for the failure.
reason #1
NO BUFFER planned
for the systems to be tested
                               NOT sticking to
                               the deadlines
reason #2

Hershey implemented the
ERP during a peak season and
couldn’t rectify the implementation
3 VENDORS
reason

# 3       It was not possible to
         test each component
                                                IMPLEMENTATION…

                                         Roll out each system
                                       successively and then
                      carefully    check the integration issues
Inevitable implementation
related problems due to high
number of interfaces of the
software packages

Problems integrating
SAP R/3 with the
software from Siebel
and Manugistics

                       reason #4
       “ERP Suite Complexity”
IT Department
                  No CIO appointed

reason #5
                                    +
             the board did not have
            any representative with IT
                       competence
Inexperience
 Top management
  did not conduct
enough groundwork
       before
 implementing the
    ERP solution

                        #6
                    reason
Employees
     Training

         #7
reason
Lack of
               technological
               Right processes werethe in place
                  savviness at not top
           To keep senior management informed

       8
reason #             Top management failed to
             understand the scope of the project
reason #9
 “Lack of Evaluation”

               Hershey
             …was missing the
             infrastructure to support
             the project

         …did not check the impact
         on their network
         to identify potential problems

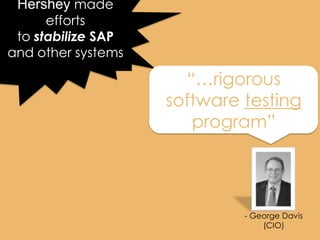

Hershey made
      efforts
 to stabilize SAP
and other systems

                      “…rigorous
                    software testing
                       program”

                             - George Davis
                                 (CIO)

SEPTEMBER 1999
     Most of the initial problems
     with the ERP systems
     were fixed
SEPTEMBER 1999
     Most of the initial problems
     with the ERP systems
     were fixed

     2000

                          $ales reaching

              US$ 4.2
SEPTEMBER 1999
     Most of the initial problems
     with the ERP systems
     were fixed

                               July 2001
                                           Redesign of the
                                           process and start to
                                           work with SAP N3 4.6

     2000

                          $ales reaching

              US$ 4.2
SEPTEMBER 1999
     Most of the initial problems
     with the ERP systems
     were fixed

                               July 2001
                                           Redesign of the
                                           process and start to
                                           work with SAP N3 4.6

     2000                                         June 2002
                                                          began using SAP for
                                                          marketing analysis an
                          $ales reaching                  brand management
                                                          order management

              US$ 4.2
Hersheys new distribution center

ERP and the new
distribution center reduce
the order cycle times by
half

                             1.2 million sq. ft.
                             = 14 Football fields

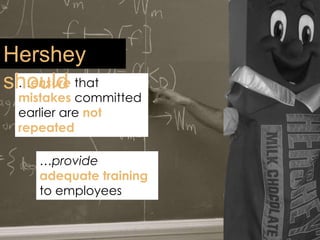

Hershey
should that
 …ensure
 mistakes committed
 earlier are not
 repeated

    …provide
    adequate training
    to employees
Thank you for
   listening.
Any questions?
