1
FINAL REPORT OF NGO “ASSOCIATION OF PARENTS OF CHILDREN WITH
DISABILITIES” (ARDI)
Prepared by: Seinep Dyikanbaeva, Program Coordinator, lawyer of ARDI and
mobilizer of the Network’s first project.
This report reflects only project activities of ARDI, objectives and events implemented
by the organization.
ACKNOWLEDGEMENTS
ARDI is grateful to ICCO Cooperation/Kerk in Actie, Gulzat Temirova (ICCO
Cooperation), Shaten Toktogaziev, first National Project Manager, Gulnur Saparkulova,
Ministry of Labour and Social Development of the Kyrgyz Republic, personally Minister
Bazarbaev K.B., Suyunalieva B.Sh., Alybaeva Janyl, Head of Department for the Elderly
and Disabled People, project partners of PF "Family to Every Child" in Osh, personally
Zeinep Eshmuratova, NGO "Nur Bala" in Talas, personally Jyldyz Turdugulova, PF
"Institute of Childhood", personally invited expert Dzhakubova N.I., expert group of
Tatyana Arhipova, PhD, associate professor in IUCA, Alieva Ainura, Amerkhanova Sania,
acting associate professor in INDO under Bishkek Humanitarian University named after K.
Karasaev, inclusive education expert of the WB project "Global Partnership for Education"
in MES KR, expert Dzhumabaeva Janyl, Head of Family and Children Office at MLSD KR,
expert Kydykbaeva Svetlana, PhD, Eshenkulova Karakoz, social worker of ARDI, ARDI staff
and PR-specialist Ainura Chotueva.
Also to parents of children with disabilities and members of the network and to all the
people who contributed to the project activities. It is thanks to your help and support, the
project has achieved its objectives and we believe that the initiative launched will be
continued.
"The words "invalid" and "LOVZ" are still used in the report, since in national
legislation these terms are used and applied in many normative legal acts (NLAs) in the
Kyrgyz Republic.
Abbreviations:
KR - Kyrgyz Republic
JK KR - Jogorku Kenesh of the Kyrgyz Republic (Parliament)
MSD KR - Ministry of Social Development of the Kyrgyz Republic1
Project - "Empowering parents of children with disabilities"
ARDI - NGO Association of Parents of Children with Disabilities (ARDI)
1
At the time of the project implementation, the Ministry of Labour and Social Development of the Kyrgyz Republic was
named the Ministry of Social Development of the Kyrgyz Republic (MSD KR).
2
IMC ARDI – Information and Methodical Center of NGO Association of Parents of
Children with Disabilities (ARDI)
LOVZ children – Disabled children2
DCC - Day Care Centers
RC – Rehabilitation Centers
NGO – Non-Governmental Organization
PF - Public Foundation
Abbreviations are not used throughout the report due to the impossibility of
abbreviating, to preserve the semantic and logical connective.
BRIEF OVERVIEW OF THE NETWORK
The Janyryk National Network (hereinafter referred to as the "Network") was formed in
2010 on the initiative of ARDI, with financial and technical support from ICCO
Cooperation/Kerk in Actie.
Turdubu (Tamara) Kanaevna was elected the first chairperson of the network –
chairperson of ARDI, who led the Network up to 1 July 2015, during this time the Network
had developed a strategy, Regulations, there were established three committees:
Committee for Network Capacity Development of Fundraising, Committee for Legal Affairs
and External Relations, Committee for Monitoring and Evaluation. At the regular meeting
of the Network held from 28 June to 1 July 2015, the Committees were renamed: Legal
Committee for Advocacy and Lobby, Committee for Network Capacity Development and
Fundraising, Committee for Information Policy.
All network members took part in the development of documents and programs of the
network. Currently, the network consists of 32 organizations.
ICCO Cooperation/Kerk in Actie has played an important role in the
creation and its development of the network as well as in the
implementation of the first project by providing financial and technical
assistance.
On 28June - 1 July 2015 at the regular meeting of the network Sadykova Jyldyz
Seyitbekovna, head of the NGO "Hand in Hand" was elected a chairperson.
HISTORY OF THE CREATION OF THE NETWORK
In 2006 ICCO Cooperation/Kerk in Actie decided to introduce a model of
multilateral cooperation in all programs implemented in Central Asia.
Thus, in 2008 the project HealthProm (United Kingdom) implemented with financial
support from Big Lottery Fund became the basis for creating a program platform with
the involvement of local NGOs and parent associations working with disabled children,
HealthProm project was implemented in partnership with NGO "Association of Parents
of Children with Disabilities", Bishkek and NGO "Shoola Kol", Bokonbaevo, Issyk-Kul
region.
2
The terminology is used in national legislation and by the Network, ARDI adheres to the international term - persons
with disabilities.
3
As part of the project in 2011 there was held an international conference on the
rights of children with disabilities and their parents, where NGO "Association of Parents
of Children with Disabilities" made a presentation on the creation of the first joint
informal network of organizations working for the protection of the rights of children
with disabilities and their families, rehabilitation, education, socialization, employment,
moral and psychological support, the main purpose of which was to work together to
achieve the above goals.
In 2011 and 2012 started an intensive process of creating a program platform and a
strategic planning process for the platform, in 2012 there were identified, developed and
approved Regulations and Strategy of the Janyryk network for 2013-2015 with the
financial support from ICCO Cooperation/Kerk in Actie, thanks to which started the
process of activation, training and consolidation of organizations, members of the
Janyryk network.
In 2013 there was launched the first network project implemented by three
organizations - NGO "Association of Parents of Children with Disabilities" in Bishkek,
NGO "Nur-Bala" in Talas and PF "Family for every child" in Osh and 10 Day Care
Centers for children with disabilities in all 7 regions of Kyrgyzstan. The main objective of
the project was to improve the provision of social services provided by Day
Rehabilitation Centers for children with disabilities and their families. According to the
results of the project the set objectives were achieved, namely in accordance with the
Decree of the Government of the Kyrgyz Republic No.381 dated 8 July 2014 "On
approving state minimum social standards of social services provided to persons with
disabilities, including children, in semi stationary organizations and social service
institutions" the state minimum social standards of social services provided to persons
with disabilities, including children, in semi stationary organizations and social service
institutions were taken to approval, which proves the strong collaboration of the
Ministry of Labor and Social Protection of the Kyrgyz Republic with members of the
Janyryk network. Also, there were developed methodical and didactic materials,
provisions on the activities of DCC and provision on the approbation of the above
standards. These results were achieved in the framework of the Memorandum of
Cooperation signed between NGO "Association of Parents of Children with Disabilities"
and the Ministry of Social Protection of the Kyrgyz Republic.
FRUITFUL COOPERATION OF THE MINISTRY OF SOCIAL DEVELOPMENT
OF THE KYRGYZ REPUBLIC WITH THE NETWORK 3
Jumabekova Turdubu Kanaevna, Chairperson of the Network received a letter No.
/61/18 dated 08.01.2013 from the MSD KR saying that "in 2013 the MSD will continue to
support the rights and legitimate interests of persons with disabilities and will rely on close
cooperation with the Network led by you".
The first issue of the newsletter of the Network, Bazarbaev Kudaibergen, Minister of
Social Development of the Kyrgyz Republic. "Dear parents of children with disabilities, dear
initiators and organizers of the Janyryk National Network, let me, first of all,
congratulate everyone with the start of the good deed. It is important to realize that with
joint efforts and constructive cooperation we can solve many problems, encourage society
to look at the lives of children with disabilities and their families from a different, more
human, point of view, see and appreciate the life of every child, especially those in difficult
3
Since November 2015, the Ministry of Social Development of the Kyrgyz Republic is named as the Ministry of Labour
and Social Development of the Kyrgyz Republic (MLSD KR).
For this reason, there are two names in the report: the Ministry of Social Development of the Kyrgyz Republic (MSD
KR) and the Ministry of Labour and Social Development of the Kyrgyz Republic (MLSD KR).
4
situation. On 6 March this year we signed an Agreement on Mutual Cooperation between
our organizations and plan to unite the experiences of parents who face daily challenges to
improve the health and development of children with disabilities and experts of our
Ministry for the development and improvement of the system of providing rehabilitation
assistance in supporting our children to become full members of society, as well to help
those parents who have not abandoned their children, who continue to love them and care
for them. I think it is no coincidence that one of the leaders of Janyryl National Network is
Tamara Jumabekova, who represents all parents-members of the network. Tamara
Kanaevna has proven with her life, her work, love and care for children that our children
can achieve good results in life, work for the good of society as a whole and just be happy
with their families".
As for the first project of the Network "Empowering parents of children with
disabilities", in partnership with the MSD KR, ARDI Bishkek, PF "Family for every child" in
Osh and NGO "Nur-Bala" in Talas, implemented with financial and technical support from
ICCO Cooperation/Kerk in Actie, ARDI has committed itself to develop standards, carry
out activities for their adopting, implementing and testing. Colleagues from PF "Family for
every child" and NGO "Nur-Bala" performed the following project activities: transferring
RCs and DCCs to the balance of local budgets, training and working with governments and
parents, etc. in southern Kyrgyzstan and in Talas region.
Change in societal attitudes towards children with disabilities is a long process and
one project cannot achieve complete positive change, it needs years and continuous
activities in this area.
The work to create a positive image of disability and change existing
stereotypes was carried out at all stages of the project.
GOAL OF THE PROJECT
Standards to guarantee the access of children with disabilities and their parents to
quality habilitation and rehabilitation services on the basis of day care centers
(hereinafter referred to as the "standards") funded from the state budget are developed
and approved in Kyrgyzstan by 2015;
OBJECTIVES OF THE PROJECT
To develop together with the state agencies common standards for the provision of
services for children with disabilities in day care centers;
1. Change the public attitude toward children with disabilities and increase the
capacity of parents;
2. Ensure sustainability of day care centers through funding from the state budget.
BENEFICIARIES OF THE PROJECT:
- Children with disabilities;
- Parents (families) of children with disabilities;
- Staff of day care centers for children with disabilities.
EXPECTED PROJECT RESULTS
1. Standards for the provision of habilitation and rehabilitation services at DCC
and mechanisms of their implementation are developed;
5
2. Stakeholder capacity in promotion of developed standards at all decision-
making levels is increased;
3. Governments at the national and local levels provide financial support for the
functioning of RCs and DCCs.
1. Conduct of a baseline study to review the situation before starting to
implement the project and after its completion, in order to achieve a
qualitative analysis of the results of the project.
ARDI announced a tender among experts to conduct a baseline study and after
receipt of offers there was chosen Dzhakubova N.I., who had experience in the field of
disability and met the requirements of the tender.

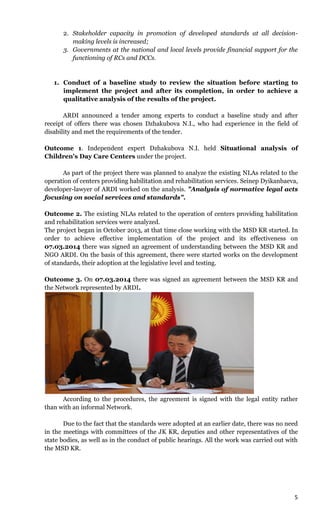

Outcome 1. Independent expert Dzhakubova N.I. held Situational analysis of
Children's Day Care Centers under the project.
As part of the project there was planned to analyze the existing NLAs related to the
operation of centers providing habilitation and rehabilitation services. Seinep Dyikanbaeva,
developer-lawyer of ARDI worked on the analysis. "Analysis of normative legal acts
focusing on social services and standards".
Outcome 2. The existing NLAs related to the operation of centers providing habilitation
and rehabilitation services were analyzed.
The project began in October 2013, at that time close working with the MSD KR started. In
order to achieve effective implementation of the project and its effectiveness on
07.03.2014 there was signed an agreement of understanding between the MSD KR and
NGO ARDI. On the basis of this agreement, there were started works on the development
of standards, their adoption at the legislative level and testing.
Outcome 3. On 07.03.2014 there was signed an agreement between the MSD KR and
the Network represented by ARDI.
According to the procedures, the agreement is signed with the legal entity rather
than with an informal Network.
Due to the fact that the standards were adopted at an earlier date, there was no need
in the meetings with committees of the JK KR, deputies and other representatives of the
state bodies, as well as in the conduct of public hearings. All the work was carried out with
the MSD KR.
6
2. NETWORK MEMBERS CAPACITY BUILDING ACTIVITIES, TRAININGS
ON LEGAL ISSUES, LOBBYING AND ADVOCACY FOR PARENTS OF
CHILDREN WITH DISABILITIES
There were conducted trainings on the rights for parents of children with disabilities at
the IMC ARDI. Training developer: Seinep Dyikanbaeva, lawyer of ARDI (trainer). The
number of planned participants: 25 persons, participated 54 persons.
Training goal: to train participants to protect the rights that will allow parents to defend
the rights of children with disabilities and their own rights in practice.
Outcome 1. Training participants gained practical skills to protect the rights of the
child and their own rights, received legal advice on matters of interest, namely benefits,
allowance, treatment, social services, education, etc.
Subsequently, some of the participants of the workshop turned to ARDI for legal,
consulting and other assistance.
STANDARD-RELATED ACTIVITIES
There were held working meetings to develop draft standards, with the conclusion of
the involved experts and the MSD KR.
Primary outcome. Standards were adopted by Decree No. 381 of the Government
of the Kyrgyz Republic, Bishkek on 8 July 2014 "On approving state minimum social
standards of social services provided to persons with disabilities, including children, in
semi-permanent organizations and social service institutions". On the basis of the
7
minimum standards there was developed the draft guidance manual "Regulation on testing
the minimum standards of social services".
"Regulation on testing the minimum standards of social services" was developed on
the adopted standards.
The expert cards for the selection of social institutions to conduct testing, the form of a plan
for testing, the expert assessment of compliance of material and technical resources as
required by minimum standards and other materials are attached to the guidance manual.
(page 15, Documents developed within the project).
NATIONAL ROUNDTABLES
28.03.2014. Held a national roundtable to discuss "Standards of social services for
children with disabilities" in hotel "Dostuk".
Purpose: Improve the quality of services provided by non-governmental day care centers
through the introduction of minimum quality standards.
12.02.2015. National roundtable on the implementation of state minimum social
standards of social services provided for persons with disabilities, including children, in
semi-permanent organizations and social service institutions, through testing.
Purpose: Implement minimum standards of social services through the cooperation of
state agencies and social service centers.
8
Discussion of a working group with the participation of parents of children
with disabilities (testing)
09.06.-11.06.2014. Held training "Institutional and legislative framework for the
operation of DCCs. The training was conducted for 40 persons. It was suggested to develop
some additional provisions for non-diversified semi-permanent organizations, for example,
semi-permanent organizations working with children with autism.
FINAL STANDARD-RELATED EVENTS
At the beginning of March 2014 ARDI with invited expert Tatyana Arhipova in
conjunction with the MSD KR developed and proposed its draft minimum standards of
social services.
In accordance with the objectives of the project there was developed a model
regulation on semi-permanent services for children with disabilities. The regulation was
developed in two versions: an abridged and full version. The abridged version was based on
the model designed by the MSD KR for hospitals. The full version is more detailed and
covers all aspects of semi-permanent organizations. These two versions were proposed for
consideration and making additions to members of the Network. All additions and changes
were taken into account and introduced in the Regulation.
Outcome 1. It was decided to focus on the full version of the Regulation. The
Regulation was presented and discussed at the training on testing minimum standards.
9
3. TESTING AND PILOTING OF STANDARDS
29.12.2014. A representative of the MSD KR and ARDI held in Bishkek a review
workshop on piloting state minimum social standards of social services.
Outcome 1. ARDI organized testing in 4 organizations, including ARDI. Piloting
was held in the Center of early intervention and rehabilitation of children with special
needs, RC "Ornok" in Karakol, Issyk-Kul region (26-28.07.2015), RC "Kadam" in
Naryn, Naryn non-governmental organization of parents to protect and support
children (NOORZPD).
(29-31.07.2015), DCC under NGO "Dream of Child" in Leninskoe village, Alamudun
district, Chui region (06.08.2015) and IMC ARDI Bishkek (05.08.2015).
4. MOBILIZATION AND ORGANIZATION OF PARENTS
Training experts of IMC ARDI4 01-02.04.2014
There were held workshops in Belovodsk Psychoneurologic Dispensary (BPNDI) on
the theme "Social adaptation and rehabilitation of children with disabilities". The workshop
was held by Torobekova Saltanat, educator of ARDI, and was attended by 20 persons,
including specialists of BPNDI, parents and students.
Challenges: Many experts and parents had no idea about the methods of training and
development of children with disabilities. There was a presentation of the activities of IMC
ARDI, talks about the methods of working with children, demonstration of educational
toys, teaching aids and books made using the BoardMaker software.
Outcome 1. The workshop was held successfully. Experts, parents and students were very
interested in ARDI methodology. Member of the Republican Psycho-Medical and
Pedagogical Consultation (PMPC), Tatiana Romanova noted that the teaching methodology
of IMC ARDI - a curative education. Students and some parents received contact details of
IMC ARDI in to visit it in the future.
On 25 June 2014 in Naryn conducted training "Development and education of children
with disabilities aged 3 to 10" under the project of the Network. Trainer: educators of IMC
ARDI Torobekova S.D., Chylpakova S.U. There were 16 persons from among the parents of
children with disabilities.
On 26 June 2014 IMC ARDI held one-day training on legal issues, methods for training
and development of children with disabilities aged 3 to 10 in Karakol in NGO Union of
Disabled "Ravenstvo".
Training objective: Increase the capacity of parents on rights; attract
professionals and parents to correctional and educational process.
Outcome: Training held by ARDI specialists facilitated the opening of the Center.
Thus, on 03.12.1014 NGO "Ravenstvo" opened the RC to work with children with
4
(The report is provided by an educator Torobekova Saltanat who worked in ARDI as an educator from 2009 to June
2015). Currently she headed the NGO "Special Child".
10
disabilities titled "Center of early intervention and rehabilitation of children with special
needs "Ornok" in Karakol, Issyk-Kul region.
21-22.10.2013. There was held training for parents of children with disabilities.
Trainers: Tamara Balkibekova, Torobekova Saltanat and Chylpakova Svetlana.
Participants: Parents of children with disabilities.
Objectives:
 Identify the problems and needs of children with disabilities;
 Provide information about the medical and social model of disability and show the
difference between them;
 Demonstrate the work with children with disabilities and their parents based on
experience of ARDI and other foreign countries.
04.07.2014. NGO "Dream of Child" held a roundtable in the framework of the
partnership project "Sustainability of DCC for children with disabilities", implemented with
financial support from ICCO Cooperation/Kerk in Actie and Kelechek HealthProm project
"Support of children with disabilities" (currently PF "Kelechek plus") with the financial
support from Big Lottery.
Roundtable objective: Discussion of issues of sustainable development and
institutionalization of the Day Care Center "Dream of Child".
The roundtable participants were informed about the beginning of the activities of NGO
"Dream of Child, the opening of a day care center in the framework of project of PF
"Kelechek HealthProm" (now PF "Kelechek plus") with the financial support from Big
Lottery.
The next step should be strengthening of the center through the support of local authorities
and government agencies, as maintaining a day care center is not a one-time work, but
constant and consistent work.
Also, the issue of space for the center was voiced, at this time the center is located in rented
premises, which requires a constant search for funding.
There was sent a letter to the deputies of the local government requesting to allocate
premises for the Center and its partial financing.
The network is looking for opportunities to maintain DCCs and RCs included in the
Network for the development of alternative services in the field.
28.08. 2014. At 10:00 am in Leninskoe village, Chui region the NGO "Dream of
Child" and ARDI conducted an inclusive event "Wider Circle" aimed at integrating and
adapting children with disabilities at an early age and opening of the inclusive development
center.
This event was moderated by Seinep Dyikanbaeva from ARDI. "She told about the
problems that exist in our country. It is important to solve these problems only through
joint efforts" - Tamara Balkibekova.
The event was attended by the deputies of the local Kenesh, the leading expert of the
plenipotentiary representative of the Government of the Kyrgyz Republic.
11
EXCHANGE VISITS (from 01.07.2014 to 31.12.2014)5.
01.07.2014. ARDI visited the RC of NGO "Hand in Hand", which is specialized in
the training and development of children with autism. The building is very large and
comfortable. About 20 children are trained at the center. Parents of children with
disabilities work at the center, the center attracts many volunteers from the United States
and Japan. Head - Sydykova Jyldyz . The center was opened 2 years ago.
14.02.2014. The purpose of the visit by a mobilizer S. Torobekova is to monitor
activities of the centers of NGO "Shoola-Kol" and "Ravenstvo" in Karakol.
NGO "Shoola-Kol" is a human rights organization. One of the areas is the assistance in the
creation of associations of parents of children with disabilities. The organization works on
early intervention.
The head of NGO "Shoola-Kol" Antonina Lee, Bokonbaev village, Ton district, Issyk-Kul
region.
15.02.14. Karakol, NGO "Ravenstvo", Union of the Disabled of the Issyk-Kul region,
the organization is working in various fields, the main aim is to improve the lives of people
with disabilities, promote and protect the rights and interests of people with disabilities,
head Kazakunova Gulmira.
STUDY TOUR TO RUSSIA
27-30.10.2014. There was organized a study tour "Study of the implementation of
standards of social semi-permanent institutions of the Russian Federation".
Venue: Moscow, Russian Federation.
Participants: MSD KR, deputy heads of district administrations, specialists of municipal
departments of education, members of the project team.
Purpose of the study tour: to study the experience of implementation of standards of
social services in semi-permanent institutions of the Russian Federation.
5
(The report is provided by an educator Torobekova Saltanat who worked in ARDI as an educator from 2009 to June
2015). Currently she headed the NGO "Special Child".
12
INFORMATION AND ADVOCACY EVENTS
03.12.2014. The representatives of the Network took part in the talk show "Oi
Ordo" on PTRC devoted to the 3rd of December - the International Day of Persons with
Disabilities jointly with UNDP Kyrgyzstan and the Network on the ratification of the
Convention on the Rights of Persons with Disabilities) adopted by General Assembly
resolution 61/106 dated 13 December 2006. (Link to view the talk show
https://www.youtube.com/watch?v=dp2YxCoDsTI). The talk show was attended by
state agencies and leaders of organizations on disability.
15.04.2014. There was held talk show "Oi Ordo" in the Kyrgyz language with the
participation of the Network. The event was held in conjunction with UNDP, with the
participation of state bodies and leaders of organizations on disability.
16.04.2014. Meeting with Niyazalieva N.A. on the ratification of the Convention,
ARDI represented by T.K. Jumabekova, Seinep Dyikanbaeva, NGO "Hand in Hand"
represented by Sadykova J.S. and Zheengul Zhaichinova, PF "Kelechek-HelthProm" on
establishing a working group on the ratification of the UN Convention on the Rights of
Persons with Disabilities, also there were sent letters to various government institutions
on this issue, together with UNDP Kyrgyzstan and the Network.
20.04.2014. There was held a press conference on the ratification of the
Convention.
11.12.2014. There was held a shooting at NBT in talk show "Theme" with Aleksandr
Shakhnazarov "On pay for the care of children with disabilities", representatives
of ARDI took part, and after the shooting ARDI had the idea to produce a TV program
on the successes of people with disabilities, it was important to reflect not only
problems but also achievements. They aimed to show that people with disabilities might
benefit and if supported by families they grew, formed personalities unhindered by
disability, even when faced with difficulties they made progress. If we create the
conditions to ratify the Convention there will be more successful individuals with
disabilities.
22.12.14. There was shown a TV program "About successful persons with
disabilities" on the television channel NBT in talk show "Theme" with Aleksandr
Shakhnazarov. http://nbt-tv.kg/ru/Programms/view/id/3
26.12.2014. Seinep Dyikanbaeva took part in the TV program on the channel NBT
on the theme "Early Childhood Education" (live program).
13
RATIFICATION ACTIVITIES "RATIFY THE UN CONVENTION ON THE
RIGHTS OF PERSONS WITH DISABILITY"
Even before the implementation of the first project of the Network there were held
activities to lobby the ratification of the Convention, members of the Network organized
and participated in various activities on the subject.
Below is a quote from a letter /61/18 dated 08.01.2013.
"To address the issue of ratification of the Convention on the Rights of Persons with
Disabilities, the Government of the Kyrgyz Republic adopted a Decree No. 324-p dated
29.07.2011 "On establishing an interagency working group on the comprehensive study
of the advisability of joining of the Kyrgyz Republic to the Convention on the Rights of
Persons with Disabilities adopted by the General Assembly of the United Nations on 13
December 2006 (UNGA)".
- Adopted a Decree of the Government of the Kyrgyz Republic No. 422-p dated
16.09.2011 "On approving the Convention on the Rights of Persons with Disabilities
adopted by the UN General Assembly on 13.12.2006”;
- Received a certified copy of the Convention on the Rights of Persons with Disabilities
signed by the President of the Kyrgyz Republic Otunbaeva R.I. dated 21.09.2011 in New
York City at the 66th session of the UNGA.
– Adopted a Decree of the Government of the Kyrgyz Republic No. 273-p dated
15.06.2012 "On the composition of the interagency committee and the interagency
working group to develop a draft set of measures to ensure the rights and improve the
quality of life of disabled in Kyrgyzstan for 2013-2018" – hereinafter the set of
measures.
- As a result of three meetings the interagency commission and the interagency working
group developed a draft set of measures;
- A draft set of measures (ref.No.6/7229 dated 20.12.2012) submitted to the interagency
commission".
The Network in conjunction with the PF "Legal assistance to the disabled" and the
network for the protection of the rights of persons with disabilities in KR organized a
social event - a festive flash mob "Give children a future" within the activity "Ratify
the UN Convention on the Rights of Persons with Disabilities", which was held
on 16 April from 12:00 to 14:00 in front of the Jogorku Kenesh in Chui Avenue.
Purpose of the event: Pay attention to the importance of ratifying the Convention.
The event was attended by 300 participants, including government representatives and
deputies. At the end of the flash mob the Jogorku Kenesh was handed over 5000
signatures of citizens for the ratification of the Convention. This event was organized
around the country.
Information is posted on Facebook
https://www.facebook.com/media/set/?set=a.766413776790859.1073741868.1024253
76523039&type=3
There were sent 8 letters to the Jogorku Kenesh and the Government of the Kyrgyz
Republic.
There were collected more than 5000 (five thousand) signatures for ratification of the
Convention.
14
On the basis of these events there was established a working group after the meeting
held on 28.04.2015 with Niyazalieva Damira Abaskanovna at that time served as Vice
Prime Minister of the Kyrgyz Republic, followed by a letter from ARDI No. 31 dated
06.05.2015. According to a letter No. /61/18 dated 08.01.2013 received from the MSD
KR.
FOOT MARCH "LIFE WITHOUT BARRIERS"
12.09.2015. There was held an event named "Life without barriers". The event was
organized by NGO "Ravenstvo", Issyk-Kul region, JICA and the Network in Bishkek. The
social event was aimed at raising public awareness about the problems of people with
disabilities. This event was held in the format of the foot march in the streets of the capital
city. This format was chosen for the event to show the unavailability of the existing
infrastructure of cities in the country, including transport and social facilities for people
with disabilities, which was often overlooked in the planning of infrastructure
development. This issue concerns not only 160 thousand citizens of the republic with
disabilities, but also a wider range of the population such as the elderly, pregnant women,
people with weight problems, mothers with children, etc.
One solution is the ratification of the Convention signed on 21 September 2011, but not yet
ratified by our country. Ratification of the Convention is one of the objectives of the
Network and this event is one of the steps necessary in the lobby of the initiative.
The march was attended by over 300 people, including from the regions of the Kyrgyz
Republic, in the framework of the campaign there were held flash mob, cultural events
organized by people with disabilities. After the end of the foot march there was held an
open lecture at the Kyrgyz State University named after I.Arabaev devoted to the
stereotypes and discrimination.
Link to the event in Facebook
https://www.facebook.com/rukavruke/posts/869984239721753
PAYMENT FOR PARENTS CARING FOR CHILDREN WITH DISABILITIES
ARDI for 20 years of its operation raised the issue of payment for parents
caring for children with disabilities, especially with severe disabilities. Over the past 5 years
there was a breakthrough: there were collected signatures of parents, held discussions and
in 2013 there was established a working group that developed the draft Regulation headed
by the Ministry of Labour and Social Development of the Kyrgyz Republic, and work in this
direction continues. Thus, in accordance with a letter /61/18 dated 08.01.2013 received
from the MSD KR there was adopted a decree of the MSD KR No. 4 dated 21.12.2012 on the
establishment of an interagency working group to develop a system of payment for persons
caring for children with disabilities with a mechanism provided to ensure the health and
pension insurance.
The decision of the interagency working group (ref. No.6/6086 dated 11.10.2012) was sent
to the leadership of the Government of the Kyrgyz Republic.
As a result there was received an order from the Government of the Kyrgyz Republic for the
development of the relevant draft resolution of the Government of the Kyrgyz Republic
with the approval of the decision of the interagency working group on payment.
ARDI and the Network continue to work in this direction in close cooperation with the
MLSD KR.
15
ISSUE OF E-NEWSLETTER
The Network issued an electronic newsletter. The purpose of the newsletter: To
inform the Network members, parents of children with disabilities, partners on the
activities of the project, to cover the situation in the field of working with children with
disabilities.
The format has been changed, it is issued not quarterly but monthly. In total issued f 18
newsletters, originally it was planned by the project to issue 9 newsletters.
The newsletter can be found at the following link
http://www.slideshare.net/ardikyrgyzstan/010614-
2?utm_source=slideshow&utm_medium=ssemail&utm_campaign=post_uplo
ad_view_cta

MEETINGS OF THE PROJECT TEAM
Training for specialists of RCs and DCCs for the northern regions of the
Kyrgyz Republic on the application and familiarization with the contents of
the Guidance manual and capacity building of center staff working with
children with disabilities
(report prepared by PF "Institute of Childhood" by the order and through the
sub-grant of ARDI for the project).
Training was held in Chui region on 12-13 December 2015.
Venue: Bishkek, NGO "Association of Parents of Children with Disabilities" (ARDI), base
of the center in Chapaev Street
Trainers: Dzhakubova Nurzhamal Ibraevna - President of PF "Institute of Childhood"
Alieva Ainura - psychologist of PF "Institute of Childhood"
Kydykbaeva Svetlana - PF LZPR
Arhipova S.V. – IUCA lecturer
Quantitative and qualitative composition of participants: 11 persons.
Among them: women – 16, men - 0;
leaders - ARDI, NOORZ PD, Dream of Child- 3.
center staff: ARDI – 4, Dream of Child- 1, NOORZ PD -1.
IUCA Students -2.
Goal: Familiarization with the content of the guidance manual and capacity building of
center staff working with children with disabilities in the provision of effective correctional
and developmental assistance to children.
Objectives:
- Familiarization with the guidelines to the state minimum social standards.
- Familiarization with the main directions of psychological and educational work with
children with disabilities.
- Training the center staff on methods and techniques of psychological and
pedagogical support of parents and children with disabilities.
The following methods of work were used during training:
16
 Discussion,
 Group work,
 Brainstorm,
 Practical sessions,
 Mini-lectures with presentations (РР),
 Questions-answers,
 Work with handouts,
The training consisted of two parts: theoretical and practical. The theoretical part
provided information about the guidelines to state minimum standards, requirements for
the services provided provision of psychological, speech therapy, educational, social and
legal services.
The practical part of the training included the study and solution of specific cases with the
use of the knowledge and skills obtained in the theoretical part. This part of the work was
carried out through group work, followed by presentation of developments.
The training consisted of the following sessions:
 Presentation of the goals and objectives of the training. Identification of
expectations. Trainer: Dzhakubova N.I.
 Who are the children with developmental problems?
 Key areas of speech therapy in day care centers for children with disabilities.
Trainer: Kydykbaeva S.B.
 Provision of social and educational services in DCC. Trainer: Arhipova T.V.
 Guidelines to the state minimum social standards. Requirements for the services
provided. Introduction to applications. Trainer: Dzhakubova N.I.
 Trainer: Alieva A.
 Features of psychological counseling of parents and children.
 Psychodiagnostics of parents.
 Methods of working with children:
 Psychodiagnostics of children.
 Methods of communication with children with disabilities.
 Psycho-correctional work with children.
 Features of working with parents in a day care centers. Trainer: Alieva A.

12 December. Registration of participants.
Greeting, explaining the training goals and objectives to participants.
Getting acquainted with the participants, identifying expectations.

17
Session: Who are the children with developmental problems?
The main directions of logopedic work in day care centers for children with
disabilities.
Session. Providing social and educational services in DCC
18
Session. Guidelines to the state minimum standards.
1. The participants talked about their centers. What services are available at this time
in their centers.
2. The participants were presented the guidelines to state minimum standards.
Participants reacted to the information about the requirements to the services
provided, the algorithm to provide services in day care centers, the content to the
requirements of the standards with great interest.
3. Practical work in groups, discussion of cases on the provision of services in the
centers.
4. Presentations of groups.
5. Discussions. Participants are given an explanation on the algorithm of each service
according to the requirements for standards.
6. Familiarization with applications to standards, practical part - filling applications.
13 December, session. Features of psychological counseling of parents and
children.
Greetings and a reflection of the first day.
1. There was provided a presentation and
information about the features of
psychological counseling of parents and
children.
2. The participants familiarized with the
stages of counseling, methods of
counseling, ethical principles, tactics of
behavior in counseling.
3. Familiarization with the psycho-diagnostic
tests used in counseling.
4. Practical part:
1. Carrying out training exercises with the
19
participants to form attitudes of understanding and acceptance of another's opinion,
empathic skills, establishing elementary contacts.
Session. Methods of working with children.
1. Familiarization with the methods of psychological studies of children: methods of
diagnosis of emotional and personal sphere of children, their attitude to their
parents and society.
2. Practical work: diagnosing emotional and personal sphere of children using the
methods of observation, conversation, method of images and testing material.
3. Psycho-correctional work with children. Mini-lectures, presentations on psycho-
correctional work of a psychologist in a day care center.
Session - Working with parents.
1. The participants got acquainted with psycho-correction techniques and methods of
interaction of parents with children with disabilities.
2. Self-regulation training. Breathing exercises.
3. Presentation: "Features of psychological training for parents".
4. Practical work: developing the program of work with parents.
Conclusions: 1. The goals and objectives of
the training were successfully achieved and
assessed by the participants as excellent.
Effective methods and techniques used by
trainers contributed to achieving the objectives
of the training.
2. Materials of guidelines to standards were
welcomed and appreciated.
3. Materials of the guidance manual were
evaluated as necessary and useful when
working with children and parents in DCC.
3. Participants asked to provide training in
practical skills of psychological, speech therapy work with children with disabilities.
4. The centers’ staff should be trained to work with completing the documentation,
introduction of reporting, developing educational and correctional programs.
FINAL ROUNDTABLE ON THE RESULTS OF THE PROJECT
16.12.2015. There was held a national roundtable of the first network project
"Empowering parents of children with disabilities" as part of the Network project in
partnership with the MLSD KR, ARDI Bishkek, PF "Family for every child" in Osh and
NGO "Nur Bala" in Talas, implemented with financial and technical support from ICCO
Cooperation/Kerk in Actie, held on 16 December 2015 in Dostuk Hotel, Bishkek, Kyrgyz
Republic from 9:30 to 14:00.
Turdubu Jumabekova from ARDI told about the purpose of the final roundtable and
thanked her colleagues for the fruitful work, in particular the Ministry of Labour and Social
Development of the Kyrgyz Republic, PF "Family for every child" in Osh, NGO "Nur Bala"
and ICCO Cooperation/Kerk in Actie and all those people who were involved in the project
activities. Without this, it would be impossible to achieve these results.
Deputy Minister of Labour and Social Development of the Kyrgyz Republic Polotova
J.A. noted the importance and efficiency of the work with the Network and the
effectiveness of the work done under the project, and invited all the participants of the final
20
roundtable for active discussion and provision of recommendations, which were made not
only by the members of the Network, but also by representatives of government agencies,
local governments from all regions of the country. Thus, during the discussion of results
achieved there were presented valuable recommendations for future work.
ARDI shared information on project activities as part of which there were conducted a
baseline survey and a mid-term evaluation of the project by independent experts Ibraeva
N.I. and Suyunalieva B.Sh. who were selected on a competitive basis, national roundtables,
discussions on the development of minimum social standards, training on the rights for
parents of children with disabilities in all regions of Kyrgyzstan, training on the use of
standards, their testing in day care centers and rehabilitation centers - members of the
Network, as well as exchange visits and work to mobilize and activate parents and non-
governmental organizations - members of the Network.
Tatyana Arhipova, ARDI expert presented the results of testing of the developed and
adopted social standards.
Alieva Ainura, psychologist of PF "Institute of Childhood" presented the results of the
development of guidelines to the state minimum social standards of social services
provided to persons with disabilities, including children, in semi-permanent organizations
and social service institutions, approved by the Government Decree No. 381 dated 8 July
2014, Bishkek.
Zeinep Eshmuratova from "Family for every child" informed about the successful
transfer of existing DCCs and RCs to the balance of the local budget, thanks to the
successful partnership with the representatives of state structures in the southern region, in
total 5 DCCs out of 6 DCCs were transferred to the balance of the local budget within the
framework of the project, covering 280 children. These are DCC Ariet, DCC Kurulchak,
DCC Nur, DCC Buchur and DCC Sezim, as well as there were carried out works on the
creation of NGOs and DCCs locally.
Nurkyz Sartalieva from NGO "Nur Bala" shared the experience of working with children
with disabilities in Talas region, in particular ensuring sustainability of day rehabilitation
centers for disabled children, achieving sustainability of DCC "Nur Bala" by transferring
into the education system through the successful working with local authorities.
Read more about the roundtable with pictures at the following link
https://www.facebook.com/permalink.php?story_fbid=1659105567673442&id=16128694
92297050
As a result of the final roundtable there were sent letters with recommendations of
the roundtable participants to the Prime Minister of the Kyrgyz Republic, Speaker of the
Jogorku Kenesh, Ministry of Labour and Social Development, Ministry of Health, Ministry
of Education and Science, Ministry of Finance and Department for Local Self-Government
(LSG) with ref. No. 103 dated 17.12.2015.
Trainer’s report on the training conducted on budgeting in the framework of
the project "Empowering parents of children with disabilities" (commissioned
by ARDI) with financial support from ICCO Cooperation
Training name: "Budgeting in NGOs", "Financial management in NGOs"
21

Date and time: 17 December 2015, from 09:00 to 18:00
Trainer: Toktomusheva Ainura, project mobilizer
Venue: Bishkek, hotel "Baikhan"
Training objective: To form a comprehensive understanding in the participants of the
formation of the budget of organizations and projects and to consider the basic methods for
the development of financial guidelines.
Participants: representatives of partner organizations of the Janyryk network in Chui
region (NGO "Dream of Child"), Naryn region (NOORZPD, NGO "Ak-Bayrak") and Bishkek
(NGO "Moving Forward").
Participants gained the following knowledge:
 The main approaches to the process of planning and developing different types of
budgets and their use.
 The concept of budget and budgeting process.
 The most common cost items and examples of measurement units.
 Features of the budgets of projects financed by several donors and allocation of
overhead costs to several projects.
 Basic concepts of financial policies and procedures.
 The content of the financial guidelines
During the training there were considered the main approaches to the process of
budgeting in NGOs and the process of budgeting in the preparation of projects. What is a
comprehensive system of budgeting and how it can be used to improve the efficiency of
management of the organization in order to achieve higher financial and economic results.
There were studied international budgeting practices, the main stages of the planning and
budgeting process. In the practical part of the workshop participants assessed (self-
diagnosis) current budgeting systems in order to understand what shall be corrected and
improved in it, as well as to decide on the restructuring plan of the current system of
budgeting in their organizations.
The workshop also provided additional information for those organizations that already
had experience in budgeting process. As part of the training there were considered the
methods of rational distribution of the administrative costs by donors or grantors and the
system of effective usage of items of administrative costs for the full use of funds.
Participants were informed about the necessity of accumulation and use of membership
contributions from founders, parents of children attending DCCs to directly support the
activities of DCCs, the participants were asked about the taxation of these contributions
and their correct use.
DOCUMENTS DEVELOPED UNDER THE PROJECT THROUGH ARDI
1. The draft state minimum social standards of social services provided to persons
with disabilities, including children, in the semi-permanent organizations and
social service institutions. Developers: SUYUNALIEVA B.Sh. ARHIPOVA T.V.,
ZHUMABEKOVA T.K.
2. Analysis of normative legal acts focusing on social services and standards.
Developer-lawyer of NGO "Association of Parents of Children with Disabilities"
(ARDI) Seinep Dyikanbaeva, published in the state and official languages.
3. Situational analysis of day care centers for children under the project of the
Janyryk network conducted by an expert Dzhakubova N.I.
4. Guidelines for the testing of minimum standards for social services for children
with disabilities, Arhipova Tatyana Viktorovna.
5. Didactic materials for working with children with disabilities in rehabilitation
centers. Developers: Jumabekova T.K., Eshenkulova K.M., Arhipova T.V.,
Dyikanbaeva S.R., published in the state and official languages.
6. Mid-term evaluation of the project conducted by an expert Dzhakubova N.I.
22
7. Monitoring of testing the state minimum social standards of social services
provided for children with disabilities by centers of the Janyryk network,
conducted by an expert Suyunalieva B.Sh. There were assessed the activities of
RCs in all regions of the Kyrgyz Republic - members of the Janyryk network, in
total 10 Centres.
8. Provision of social services in day care centers. As part of the sub-grant through
ARDI for PF “Institute of Childhood” - a national network "Janyryk". "Guidance
manual for social service institutions and day care centers providing services for
children with disabilities". Group of developers: Dzhakubova Nurzhamal -
expert, president of PF "Institute of Childhood", Alieva Ainura - psychologist in
KNU named after Zh.Balasagyn, Amerkhanova Sania - acting associate professor
of INDO at BHU named after K. Karasaev, expert on inclusive education of the
WB project "Global Partnership for Education" in MES KR, Arhipova Tatyana -
Ph.D., associate professor of IUCA, Dzhumabaeva Janyl - expert, head of the
Department for Family and Children, MSD KR, Kydykbaeva Svetlana – expert,
Ph.D.
9. MODEL REGULATION on semi-permanent services for children with
disabilities, Arhipova T.V., Dyikanbaeva S.R., Jumabekova T.K.
CONCLUSION
The project has been evaluated by independent local experts and an expert from the
Netherlands. Evaluation of the project has been positive, but the most important thing is
the achievement of the set goal and implementation of all planned objectives and expected
results, especially the timing of the standards adoption ahead of schedule and reduction of
activities to lobby the standards that allowed for additional activities described in this
report - this is an indicator of successful interaction of the Network with public authorities,
in particular with the Ministry of Labour and Social Development (MLSD) of the Kyrgyz
Republic.
Of course a single project cannot solve the problems in the provision of alternative
social services, but it's safe to say that the foundations are laid, and the initiative will be
continued by the Network and the MLSD KR.
ARDI, in turn, continues the initiated work in its activities.

итоговый отчет арди Eng

  • 1.
    1 FINAL REPORT OFNGO “ASSOCIATION OF PARENTS OF CHILDREN WITH DISABILITIES” (ARDI) Prepared by: Seinep Dyikanbaeva, Program Coordinator, lawyer of ARDI and mobilizer of the Network’s first project. This report reflects only project activities of ARDI, objectives and events implemented by the organization. ACKNOWLEDGEMENTS ARDI is grateful to ICCO Cooperation/Kerk in Actie, Gulzat Temirova (ICCO Cooperation), Shaten Toktogaziev, first National Project Manager, Gulnur Saparkulova, Ministry of Labour and Social Development of the Kyrgyz Republic, personally Minister Bazarbaev K.B., Suyunalieva B.Sh., Alybaeva Janyl, Head of Department for the Elderly and Disabled People, project partners of PF "Family to Every Child" in Osh, personally Zeinep Eshmuratova, NGO "Nur Bala" in Talas, personally Jyldyz Turdugulova, PF "Institute of Childhood", personally invited expert Dzhakubova N.I., expert group of Tatyana Arhipova, PhD, associate professor in IUCA, Alieva Ainura, Amerkhanova Sania, acting associate professor in INDO under Bishkek Humanitarian University named after K. Karasaev, inclusive education expert of the WB project "Global Partnership for Education" in MES KR, expert Dzhumabaeva Janyl, Head of Family and Children Office at MLSD KR, expert Kydykbaeva Svetlana, PhD, Eshenkulova Karakoz, social worker of ARDI, ARDI staff and PR-specialist Ainura Chotueva. Also to parents of children with disabilities and members of the network and to all the people who contributed to the project activities. It is thanks to your help and support, the project has achieved its objectives and we believe that the initiative launched will be continued. "The words "invalid" and "LOVZ" are still used in the report, since in national legislation these terms are used and applied in many normative legal acts (NLAs) in the Kyrgyz Republic. Abbreviations: KR - Kyrgyz Republic JK KR - Jogorku Kenesh of the Kyrgyz Republic (Parliament) MSD KR - Ministry of Social Development of the Kyrgyz Republic1 Project - "Empowering parents of children with disabilities" ARDI - NGO Association of Parents of Children with Disabilities (ARDI) 1 At the time of the project implementation, the Ministry of Labour and Social Development of the Kyrgyz Republic was named the Ministry of Social Development of the Kyrgyz Republic (MSD KR).
  • 2.
    2 IMC ARDI –Information and Methodical Center of NGO Association of Parents of Children with Disabilities (ARDI) LOVZ children – Disabled children2 DCC - Day Care Centers RC – Rehabilitation Centers NGO – Non-Governmental Organization PF - Public Foundation Abbreviations are not used throughout the report due to the impossibility of abbreviating, to preserve the semantic and logical connective. BRIEF OVERVIEW OF THE NETWORK The Janyryk National Network (hereinafter referred to as the "Network") was formed in 2010 on the initiative of ARDI, with financial and technical support from ICCO Cooperation/Kerk in Actie. Turdubu (Tamara) Kanaevna was elected the first chairperson of the network – chairperson of ARDI, who led the Network up to 1 July 2015, during this time the Network had developed a strategy, Regulations, there were established three committees: Committee for Network Capacity Development of Fundraising, Committee for Legal Affairs and External Relations, Committee for Monitoring and Evaluation. At the regular meeting of the Network held from 28 June to 1 July 2015, the Committees were renamed: Legal Committee for Advocacy and Lobby, Committee for Network Capacity Development and Fundraising, Committee for Information Policy. All network members took part in the development of documents and programs of the network. Currently, the network consists of 32 organizations. ICCO Cooperation/Kerk in Actie has played an important role in the creation and its development of the network as well as in the implementation of the first project by providing financial and technical assistance. On 28June - 1 July 2015 at the regular meeting of the network Sadykova Jyldyz Seyitbekovna, head of the NGO "Hand in Hand" was elected a chairperson. HISTORY OF THE CREATION OF THE NETWORK In 2006 ICCO Cooperation/Kerk in Actie decided to introduce a model of multilateral cooperation in all programs implemented in Central Asia. Thus, in 2008 the project HealthProm (United Kingdom) implemented with financial support from Big Lottery Fund became the basis for creating a program platform with the involvement of local NGOs and parent associations working with disabled children, HealthProm project was implemented in partnership with NGO "Association of Parents of Children with Disabilities", Bishkek and NGO "Shoola Kol", Bokonbaevo, Issyk-Kul region. 2 The terminology is used in national legislation and by the Network, ARDI adheres to the international term - persons with disabilities.
  • 3.
    3 As part ofthe project in 2011 there was held an international conference on the rights of children with disabilities and their parents, where NGO "Association of Parents of Children with Disabilities" made a presentation on the creation of the first joint informal network of organizations working for the protection of the rights of children with disabilities and their families, rehabilitation, education, socialization, employment, moral and psychological support, the main purpose of which was to work together to achieve the above goals. In 2011 and 2012 started an intensive process of creating a program platform and a strategic planning process for the platform, in 2012 there were identified, developed and approved Regulations and Strategy of the Janyryk network for 2013-2015 with the financial support from ICCO Cooperation/Kerk in Actie, thanks to which started the process of activation, training and consolidation of organizations, members of the Janyryk network. In 2013 there was launched the first network project implemented by three organizations - NGO "Association of Parents of Children with Disabilities" in Bishkek, NGO "Nur-Bala" in Talas and PF "Family for every child" in Osh and 10 Day Care Centers for children with disabilities in all 7 regions of Kyrgyzstan. The main objective of the project was to improve the provision of social services provided by Day Rehabilitation Centers for children with disabilities and their families. According to the results of the project the set objectives were achieved, namely in accordance with the Decree of the Government of the Kyrgyz Republic No.381 dated 8 July 2014 "On approving state minimum social standards of social services provided to persons with disabilities, including children, in semi stationary organizations and social service institutions" the state minimum social standards of social services provided to persons with disabilities, including children, in semi stationary organizations and social service institutions were taken to approval, which proves the strong collaboration of the Ministry of Labor and Social Protection of the Kyrgyz Republic with members of the Janyryk network. Also, there were developed methodical and didactic materials, provisions on the activities of DCC and provision on the approbation of the above standards. These results were achieved in the framework of the Memorandum of Cooperation signed between NGO "Association of Parents of Children with Disabilities" and the Ministry of Social Protection of the Kyrgyz Republic. FRUITFUL COOPERATION OF THE MINISTRY OF SOCIAL DEVELOPMENT OF THE KYRGYZ REPUBLIC WITH THE NETWORK 3 Jumabekova Turdubu Kanaevna, Chairperson of the Network received a letter No. /61/18 dated 08.01.2013 from the MSD KR saying that "in 2013 the MSD will continue to support the rights and legitimate interests of persons with disabilities and will rely on close cooperation with the Network led by you". The first issue of the newsletter of the Network, Bazarbaev Kudaibergen, Minister of Social Development of the Kyrgyz Republic. "Dear parents of children with disabilities, dear initiators and organizers of the Janyryk National Network, let me, first of all, congratulate everyone with the start of the good deed. It is important to realize that with joint efforts and constructive cooperation we can solve many problems, encourage society to look at the lives of children with disabilities and their families from a different, more human, point of view, see and appreciate the life of every child, especially those in difficult 3 Since November 2015, the Ministry of Social Development of the Kyrgyz Republic is named as the Ministry of Labour and Social Development of the Kyrgyz Republic (MLSD KR). For this reason, there are two names in the report: the Ministry of Social Development of the Kyrgyz Republic (MSD KR) and the Ministry of Labour and Social Development of the Kyrgyz Republic (MLSD KR).
  • 4.
    4 situation. On 6March this year we signed an Agreement on Mutual Cooperation between our organizations and plan to unite the experiences of parents who face daily challenges to improve the health and development of children with disabilities and experts of our Ministry for the development and improvement of the system of providing rehabilitation assistance in supporting our children to become full members of society, as well to help those parents who have not abandoned their children, who continue to love them and care for them. I think it is no coincidence that one of the leaders of Janyryl National Network is Tamara Jumabekova, who represents all parents-members of the network. Tamara Kanaevna has proven with her life, her work, love and care for children that our children can achieve good results in life, work for the good of society as a whole and just be happy with their families". As for the first project of the Network "Empowering parents of children with disabilities", in partnership with the MSD KR, ARDI Bishkek, PF "Family for every child" in Osh and NGO "Nur-Bala" in Talas, implemented with financial and technical support from ICCO Cooperation/Kerk in Actie, ARDI has committed itself to develop standards, carry out activities for their adopting, implementing and testing. Colleagues from PF "Family for every child" and NGO "Nur-Bala" performed the following project activities: transferring RCs and DCCs to the balance of local budgets, training and working with governments and parents, etc. in southern Kyrgyzstan and in Talas region. Change in societal attitudes towards children with disabilities is a long process and one project cannot achieve complete positive change, it needs years and continuous activities in this area. The work to create a positive image of disability and change existing stereotypes was carried out at all stages of the project. GOAL OF THE PROJECT Standards to guarantee the access of children with disabilities and their parents to quality habilitation and rehabilitation services on the basis of day care centers (hereinafter referred to as the "standards") funded from the state budget are developed and approved in Kyrgyzstan by 2015; OBJECTIVES OF THE PROJECT To develop together with the state agencies common standards for the provision of services for children with disabilities in day care centers; 1. Change the public attitude toward children with disabilities and increase the capacity of parents; 2. Ensure sustainability of day care centers through funding from the state budget. BENEFICIARIES OF THE PROJECT: - Children with disabilities; - Parents (families) of children with disabilities; - Staff of day care centers for children with disabilities. EXPECTED PROJECT RESULTS 1. Standards for the provision of habilitation and rehabilitation services at DCC and mechanisms of their implementation are developed;
  • 5.
    5 2. Stakeholder capacityin promotion of developed standards at all decision- making levels is increased; 3. Governments at the national and local levels provide financial support for the functioning of RCs and DCCs. 1. Conduct of a baseline study to review the situation before starting to implement the project and after its completion, in order to achieve a qualitative analysis of the results of the project. ARDI announced a tender among experts to conduct a baseline study and after receipt of offers there was chosen Dzhakubova N.I., who had experience in the field of disability and met the requirements of the tender. Outcome 1. Independent expert Dzhakubova N.I. held Situational analysis of Children's Day Care Centers under the project. As part of the project there was planned to analyze the existing NLAs related to the operation of centers providing habilitation and rehabilitation services. Seinep Dyikanbaeva, developer-lawyer of ARDI worked on the analysis. "Analysis of normative legal acts focusing on social services and standards". Outcome 2. The existing NLAs related to the operation of centers providing habilitation and rehabilitation services were analyzed. The project began in October 2013, at that time close working with the MSD KR started. In order to achieve effective implementation of the project and its effectiveness on 07.03.2014 there was signed an agreement of understanding between the MSD KR and NGO ARDI. On the basis of this agreement, there were started works on the development of standards, their adoption at the legislative level and testing. Outcome 3. On 07.03.2014 there was signed an agreement between the MSD KR and the Network represented by ARDI. According to the procedures, the agreement is signed with the legal entity rather than with an informal Network. Due to the fact that the standards were adopted at an earlier date, there was no need in the meetings with committees of the JK KR, deputies and other representatives of the state bodies, as well as in the conduct of public hearings. All the work was carried out with the MSD KR.
  • 6.
    6 2. NETWORK MEMBERSCAPACITY BUILDING ACTIVITIES, TRAININGS ON LEGAL ISSUES, LOBBYING AND ADVOCACY FOR PARENTS OF CHILDREN WITH DISABILITIES There were conducted trainings on the rights for parents of children with disabilities at the IMC ARDI. Training developer: Seinep Dyikanbaeva, lawyer of ARDI (trainer). The number of planned participants: 25 persons, participated 54 persons. Training goal: to train participants to protect the rights that will allow parents to defend the rights of children with disabilities and their own rights in practice. Outcome 1. Training participants gained practical skills to protect the rights of the child and their own rights, received legal advice on matters of interest, namely benefits, allowance, treatment, social services, education, etc. Subsequently, some of the participants of the workshop turned to ARDI for legal, consulting and other assistance. STANDARD-RELATED ACTIVITIES There were held working meetings to develop draft standards, with the conclusion of the involved experts and the MSD KR. Primary outcome. Standards were adopted by Decree No. 381 of the Government of the Kyrgyz Republic, Bishkek on 8 July 2014 "On approving state minimum social standards of social services provided to persons with disabilities, including children, in semi-permanent organizations and social service institutions". On the basis of the
  • 7.
    7 minimum standards therewas developed the draft guidance manual "Regulation on testing the minimum standards of social services". "Regulation on testing the minimum standards of social services" was developed on the adopted standards. The expert cards for the selection of social institutions to conduct testing, the form of a plan for testing, the expert assessment of compliance of material and technical resources as required by minimum standards and other materials are attached to the guidance manual. (page 15, Documents developed within the project). NATIONAL ROUNDTABLES 28.03.2014. Held a national roundtable to discuss "Standards of social services for children with disabilities" in hotel "Dostuk". Purpose: Improve the quality of services provided by non-governmental day care centers through the introduction of minimum quality standards. 12.02.2015. National roundtable on the implementation of state minimum social standards of social services provided for persons with disabilities, including children, in semi-permanent organizations and social service institutions, through testing. Purpose: Implement minimum standards of social services through the cooperation of state agencies and social service centers.
  • 8.
    8 Discussion of aworking group with the participation of parents of children with disabilities (testing) 09.06.-11.06.2014. Held training "Institutional and legislative framework for the operation of DCCs. The training was conducted for 40 persons. It was suggested to develop some additional provisions for non-diversified semi-permanent organizations, for example, semi-permanent organizations working with children with autism. FINAL STANDARD-RELATED EVENTS At the beginning of March 2014 ARDI with invited expert Tatyana Arhipova in conjunction with the MSD KR developed and proposed its draft minimum standards of social services. In accordance with the objectives of the project there was developed a model regulation on semi-permanent services for children with disabilities. The regulation was developed in two versions: an abridged and full version. The abridged version was based on the model designed by the MSD KR for hospitals. The full version is more detailed and covers all aspects of semi-permanent organizations. These two versions were proposed for consideration and making additions to members of the Network. All additions and changes were taken into account and introduced in the Regulation. Outcome 1. It was decided to focus on the full version of the Regulation. The Regulation was presented and discussed at the training on testing minimum standards.
  • 9.
    9 3. TESTING ANDPILOTING OF STANDARDS 29.12.2014. A representative of the MSD KR and ARDI held in Bishkek a review workshop on piloting state minimum social standards of social services. Outcome 1. ARDI organized testing in 4 organizations, including ARDI. Piloting was held in the Center of early intervention and rehabilitation of children with special needs, RC "Ornok" in Karakol, Issyk-Kul region (26-28.07.2015), RC "Kadam" in Naryn, Naryn non-governmental organization of parents to protect and support children (NOORZPD). (29-31.07.2015), DCC under NGO "Dream of Child" in Leninskoe village, Alamudun district, Chui region (06.08.2015) and IMC ARDI Bishkek (05.08.2015). 4. MOBILIZATION AND ORGANIZATION OF PARENTS Training experts of IMC ARDI4 01-02.04.2014 There were held workshops in Belovodsk Psychoneurologic Dispensary (BPNDI) on the theme "Social adaptation and rehabilitation of children with disabilities". The workshop was held by Torobekova Saltanat, educator of ARDI, and was attended by 20 persons, including specialists of BPNDI, parents and students. Challenges: Many experts and parents had no idea about the methods of training and development of children with disabilities. There was a presentation of the activities of IMC ARDI, talks about the methods of working with children, demonstration of educational toys, teaching aids and books made using the BoardMaker software. Outcome 1. The workshop was held successfully. Experts, parents and students were very interested in ARDI methodology. Member of the Republican Psycho-Medical and Pedagogical Consultation (PMPC), Tatiana Romanova noted that the teaching methodology of IMC ARDI - a curative education. Students and some parents received contact details of IMC ARDI in to visit it in the future. On 25 June 2014 in Naryn conducted training "Development and education of children with disabilities aged 3 to 10" under the project of the Network. Trainer: educators of IMC ARDI Torobekova S.D., Chylpakova S.U. There were 16 persons from among the parents of children with disabilities. On 26 June 2014 IMC ARDI held one-day training on legal issues, methods for training and development of children with disabilities aged 3 to 10 in Karakol in NGO Union of Disabled "Ravenstvo". Training objective: Increase the capacity of parents on rights; attract professionals and parents to correctional and educational process. Outcome: Training held by ARDI specialists facilitated the opening of the Center. Thus, on 03.12.1014 NGO "Ravenstvo" opened the RC to work with children with 4 (The report is provided by an educator Torobekova Saltanat who worked in ARDI as an educator from 2009 to June 2015). Currently she headed the NGO "Special Child".
  • 10.
    10 disabilities titled "Centerof early intervention and rehabilitation of children with special needs "Ornok" in Karakol, Issyk-Kul region. 21-22.10.2013. There was held training for parents of children with disabilities. Trainers: Tamara Balkibekova, Torobekova Saltanat and Chylpakova Svetlana. Participants: Parents of children with disabilities. Objectives:  Identify the problems and needs of children with disabilities;  Provide information about the medical and social model of disability and show the difference between them;  Demonstrate the work with children with disabilities and their parents based on experience of ARDI and other foreign countries. 04.07.2014. NGO "Dream of Child" held a roundtable in the framework of the partnership project "Sustainability of DCC for children with disabilities", implemented with financial support from ICCO Cooperation/Kerk in Actie and Kelechek HealthProm project "Support of children with disabilities" (currently PF "Kelechek plus") with the financial support from Big Lottery. Roundtable objective: Discussion of issues of sustainable development and institutionalization of the Day Care Center "Dream of Child". The roundtable participants were informed about the beginning of the activities of NGO "Dream of Child, the opening of a day care center in the framework of project of PF "Kelechek HealthProm" (now PF "Kelechek plus") with the financial support from Big Lottery. The next step should be strengthening of the center through the support of local authorities and government agencies, as maintaining a day care center is not a one-time work, but constant and consistent work. Also, the issue of space for the center was voiced, at this time the center is located in rented premises, which requires a constant search for funding. There was sent a letter to the deputies of the local government requesting to allocate premises for the Center and its partial financing. The network is looking for opportunities to maintain DCCs and RCs included in the Network for the development of alternative services in the field. 28.08. 2014. At 10:00 am in Leninskoe village, Chui region the NGO "Dream of Child" and ARDI conducted an inclusive event "Wider Circle" aimed at integrating and adapting children with disabilities at an early age and opening of the inclusive development center. This event was moderated by Seinep Dyikanbaeva from ARDI. "She told about the problems that exist in our country. It is important to solve these problems only through joint efforts" - Tamara Balkibekova. The event was attended by the deputies of the local Kenesh, the leading expert of the plenipotentiary representative of the Government of the Kyrgyz Republic.
  • 11.
    11 EXCHANGE VISITS (from01.07.2014 to 31.12.2014)5. 01.07.2014. ARDI visited the RC of NGO "Hand in Hand", which is specialized in the training and development of children with autism. The building is very large and comfortable. About 20 children are trained at the center. Parents of children with disabilities work at the center, the center attracts many volunteers from the United States and Japan. Head - Sydykova Jyldyz . The center was opened 2 years ago. 14.02.2014. The purpose of the visit by a mobilizer S. Torobekova is to monitor activities of the centers of NGO "Shoola-Kol" and "Ravenstvo" in Karakol. NGO "Shoola-Kol" is a human rights organization. One of the areas is the assistance in the creation of associations of parents of children with disabilities. The organization works on early intervention. The head of NGO "Shoola-Kol" Antonina Lee, Bokonbaev village, Ton district, Issyk-Kul region. 15.02.14. Karakol, NGO "Ravenstvo", Union of the Disabled of the Issyk-Kul region, the organization is working in various fields, the main aim is to improve the lives of people with disabilities, promote and protect the rights and interests of people with disabilities, head Kazakunova Gulmira. STUDY TOUR TO RUSSIA 27-30.10.2014. There was organized a study tour "Study of the implementation of standards of social semi-permanent institutions of the Russian Federation". Venue: Moscow, Russian Federation. Participants: MSD KR, deputy heads of district administrations, specialists of municipal departments of education, members of the project team. Purpose of the study tour: to study the experience of implementation of standards of social services in semi-permanent institutions of the Russian Federation. 5 (The report is provided by an educator Torobekova Saltanat who worked in ARDI as an educator from 2009 to June 2015). Currently she headed the NGO "Special Child".
  • 12.
    12 INFORMATION AND ADVOCACYEVENTS 03.12.2014. The representatives of the Network took part in the talk show "Oi Ordo" on PTRC devoted to the 3rd of December - the International Day of Persons with Disabilities jointly with UNDP Kyrgyzstan and the Network on the ratification of the Convention on the Rights of Persons with Disabilities) adopted by General Assembly resolution 61/106 dated 13 December 2006. (Link to view the talk show https://www.youtube.com/watch?v=dp2YxCoDsTI). The talk show was attended by state agencies and leaders of organizations on disability. 15.04.2014. There was held talk show "Oi Ordo" in the Kyrgyz language with the participation of the Network. The event was held in conjunction with UNDP, with the participation of state bodies and leaders of organizations on disability. 16.04.2014. Meeting with Niyazalieva N.A. on the ratification of the Convention, ARDI represented by T.K. Jumabekova, Seinep Dyikanbaeva, NGO "Hand in Hand" represented by Sadykova J.S. and Zheengul Zhaichinova, PF "Kelechek-HelthProm" on establishing a working group on the ratification of the UN Convention on the Rights of Persons with Disabilities, also there were sent letters to various government institutions on this issue, together with UNDP Kyrgyzstan and the Network. 20.04.2014. There was held a press conference on the ratification of the Convention. 11.12.2014. There was held a shooting at NBT in talk show "Theme" with Aleksandr Shakhnazarov "On pay for the care of children with disabilities", representatives of ARDI took part, and after the shooting ARDI had the idea to produce a TV program on the successes of people with disabilities, it was important to reflect not only problems but also achievements. They aimed to show that people with disabilities might benefit and if supported by families they grew, formed personalities unhindered by disability, even when faced with difficulties they made progress. If we create the conditions to ratify the Convention there will be more successful individuals with disabilities. 22.12.14. There was shown a TV program "About successful persons with disabilities" on the television channel NBT in talk show "Theme" with Aleksandr Shakhnazarov. http://nbt-tv.kg/ru/Programms/view/id/3 26.12.2014. Seinep Dyikanbaeva took part in the TV program on the channel NBT on the theme "Early Childhood Education" (live program).
  • 13.
    13 RATIFICATION ACTIVITIES "RATIFYTHE UN CONVENTION ON THE RIGHTS OF PERSONS WITH DISABILITY" Even before the implementation of the first project of the Network there were held activities to lobby the ratification of the Convention, members of the Network organized and participated in various activities on the subject. Below is a quote from a letter /61/18 dated 08.01.2013. "To address the issue of ratification of the Convention on the Rights of Persons with Disabilities, the Government of the Kyrgyz Republic adopted a Decree No. 324-p dated 29.07.2011 "On establishing an interagency working group on the comprehensive study of the advisability of joining of the Kyrgyz Republic to the Convention on the Rights of Persons with Disabilities adopted by the General Assembly of the United Nations on 13 December 2006 (UNGA)". - Adopted a Decree of the Government of the Kyrgyz Republic No. 422-p dated 16.09.2011 "On approving the Convention on the Rights of Persons with Disabilities adopted by the UN General Assembly on 13.12.2006”; - Received a certified copy of the Convention on the Rights of Persons with Disabilities signed by the President of the Kyrgyz Republic Otunbaeva R.I. dated 21.09.2011 in New York City at the 66th session of the UNGA. – Adopted a Decree of the Government of the Kyrgyz Republic No. 273-p dated 15.06.2012 "On the composition of the interagency committee and the interagency working group to develop a draft set of measures to ensure the rights and improve the quality of life of disabled in Kyrgyzstan for 2013-2018" – hereinafter the set of measures. - As a result of three meetings the interagency commission and the interagency working group developed a draft set of measures; - A draft set of measures (ref.No.6/7229 dated 20.12.2012) submitted to the interagency commission". The Network in conjunction with the PF "Legal assistance to the disabled" and the network for the protection of the rights of persons with disabilities in KR organized a social event - a festive flash mob "Give children a future" within the activity "Ratify the UN Convention on the Rights of Persons with Disabilities", which was held on 16 April from 12:00 to 14:00 in front of the Jogorku Kenesh in Chui Avenue. Purpose of the event: Pay attention to the importance of ratifying the Convention. The event was attended by 300 participants, including government representatives and deputies. At the end of the flash mob the Jogorku Kenesh was handed over 5000 signatures of citizens for the ratification of the Convention. This event was organized around the country. Information is posted on Facebook https://www.facebook.com/media/set/?set=a.766413776790859.1073741868.1024253 76523039&type=3 There were sent 8 letters to the Jogorku Kenesh and the Government of the Kyrgyz Republic. There were collected more than 5000 (five thousand) signatures for ratification of the Convention.
  • 14.
    14 On the basisof these events there was established a working group after the meeting held on 28.04.2015 with Niyazalieva Damira Abaskanovna at that time served as Vice Prime Minister of the Kyrgyz Republic, followed by a letter from ARDI No. 31 dated 06.05.2015. According to a letter No. /61/18 dated 08.01.2013 received from the MSD KR. FOOT MARCH "LIFE WITHOUT BARRIERS" 12.09.2015. There was held an event named "Life without barriers". The event was organized by NGO "Ravenstvo", Issyk-Kul region, JICA and the Network in Bishkek. The social event was aimed at raising public awareness about the problems of people with disabilities. This event was held in the format of the foot march in the streets of the capital city. This format was chosen for the event to show the unavailability of the existing infrastructure of cities in the country, including transport and social facilities for people with disabilities, which was often overlooked in the planning of infrastructure development. This issue concerns not only 160 thousand citizens of the republic with disabilities, but also a wider range of the population such as the elderly, pregnant women, people with weight problems, mothers with children, etc. One solution is the ratification of the Convention signed on 21 September 2011, but not yet ratified by our country. Ratification of the Convention is one of the objectives of the Network and this event is one of the steps necessary in the lobby of the initiative. The march was attended by over 300 people, including from the regions of the Kyrgyz Republic, in the framework of the campaign there were held flash mob, cultural events organized by people with disabilities. After the end of the foot march there was held an open lecture at the Kyrgyz State University named after I.Arabaev devoted to the stereotypes and discrimination. Link to the event in Facebook https://www.facebook.com/rukavruke/posts/869984239721753 PAYMENT FOR PARENTS CARING FOR CHILDREN WITH DISABILITIES ARDI for 20 years of its operation raised the issue of payment for parents caring for children with disabilities, especially with severe disabilities. Over the past 5 years there was a breakthrough: there were collected signatures of parents, held discussions and in 2013 there was established a working group that developed the draft Regulation headed by the Ministry of Labour and Social Development of the Kyrgyz Republic, and work in this direction continues. Thus, in accordance with a letter /61/18 dated 08.01.2013 received from the MSD KR there was adopted a decree of the MSD KR No. 4 dated 21.12.2012 on the establishment of an interagency working group to develop a system of payment for persons caring for children with disabilities with a mechanism provided to ensure the health and pension insurance. The decision of the interagency working group (ref. No.6/6086 dated 11.10.2012) was sent to the leadership of the Government of the Kyrgyz Republic. As a result there was received an order from the Government of the Kyrgyz Republic for the development of the relevant draft resolution of the Government of the Kyrgyz Republic with the approval of the decision of the interagency working group on payment. ARDI and the Network continue to work in this direction in close cooperation with the MLSD KR.
  • 15.
    15 ISSUE OF E-NEWSLETTER TheNetwork issued an electronic newsletter. The purpose of the newsletter: To inform the Network members, parents of children with disabilities, partners on the activities of the project, to cover the situation in the field of working with children with disabilities. The format has been changed, it is issued not quarterly but monthly. In total issued f 18 newsletters, originally it was planned by the project to issue 9 newsletters. The newsletter can be found at the following link http://www.slideshare.net/ardikyrgyzstan/010614- 2?utm_source=slideshow&utm_medium=ssemail&utm_campaign=post_uplo ad_view_cta MEETINGS OF THE PROJECT TEAM Training for specialists of RCs and DCCs for the northern regions of the Kyrgyz Republic on the application and familiarization with the contents of the Guidance manual and capacity building of center staff working with children with disabilities (report prepared by PF "Institute of Childhood" by the order and through the sub-grant of ARDI for the project). Training was held in Chui region on 12-13 December 2015. Venue: Bishkek, NGO "Association of Parents of Children with Disabilities" (ARDI), base of the center in Chapaev Street Trainers: Dzhakubova Nurzhamal Ibraevna - President of PF "Institute of Childhood" Alieva Ainura - psychologist of PF "Institute of Childhood" Kydykbaeva Svetlana - PF LZPR Arhipova S.V. – IUCA lecturer Quantitative and qualitative composition of participants: 11 persons. Among them: women – 16, men - 0; leaders - ARDI, NOORZ PD, Dream of Child- 3. center staff: ARDI – 4, Dream of Child- 1, NOORZ PD -1. IUCA Students -2. Goal: Familiarization with the content of the guidance manual and capacity building of center staff working with children with disabilities in the provision of effective correctional and developmental assistance to children. Objectives: - Familiarization with the guidelines to the state minimum social standards. - Familiarization with the main directions of psychological and educational work with children with disabilities. - Training the center staff on methods and techniques of psychological and pedagogical support of parents and children with disabilities. The following methods of work were used during training:
  • 16.
    16  Discussion,  Groupwork,  Brainstorm,  Practical sessions,  Mini-lectures with presentations (РР),  Questions-answers,  Work with handouts, The training consisted of two parts: theoretical and practical. The theoretical part provided information about the guidelines to state minimum standards, requirements for the services provided provision of psychological, speech therapy, educational, social and legal services. The practical part of the training included the study and solution of specific cases with the use of the knowledge and skills obtained in the theoretical part. This part of the work was carried out through group work, followed by presentation of developments. The training consisted of the following sessions:  Presentation of the goals and objectives of the training. Identification of expectations. Trainer: Dzhakubova N.I.  Who are the children with developmental problems?  Key areas of speech therapy in day care centers for children with disabilities. Trainer: Kydykbaeva S.B.  Provision of social and educational services in DCC. Trainer: Arhipova T.V.  Guidelines to the state minimum social standards. Requirements for the services provided. Introduction to applications. Trainer: Dzhakubova N.I.  Trainer: Alieva A.  Features of psychological counseling of parents and children.  Psychodiagnostics of parents.  Methods of working with children:  Psychodiagnostics of children.  Methods of communication with children with disabilities.  Psycho-correctional work with children.  Features of working with parents in a day care centers. Trainer: Alieva A. 12 December. Registration of participants. Greeting, explaining the training goals and objectives to participants. Getting acquainted with the participants, identifying expectations.
  • 17.
    17 Session: Who arethe children with developmental problems? The main directions of logopedic work in day care centers for children with disabilities. Session. Providing social and educational services in DCC
  • 18.
    18 Session. Guidelines tothe state minimum standards. 1. The participants talked about their centers. What services are available at this time in their centers. 2. The participants were presented the guidelines to state minimum standards. Participants reacted to the information about the requirements to the services provided, the algorithm to provide services in day care centers, the content to the requirements of the standards with great interest. 3. Practical work in groups, discussion of cases on the provision of services in the centers. 4. Presentations of groups. 5. Discussions. Participants are given an explanation on the algorithm of each service according to the requirements for standards. 6. Familiarization with applications to standards, practical part - filling applications. 13 December, session. Features of psychological counseling of parents and children. Greetings and a reflection of the first day. 1. There was provided a presentation and information about the features of psychological counseling of parents and children. 2. The participants familiarized with the stages of counseling, methods of counseling, ethical principles, tactics of behavior in counseling. 3. Familiarization with the psycho-diagnostic tests used in counseling. 4. Practical part: 1. Carrying out training exercises with the
  • 19.
    19 participants to formattitudes of understanding and acceptance of another's opinion, empathic skills, establishing elementary contacts. Session. Methods of working with children. 1. Familiarization with the methods of psychological studies of children: methods of diagnosis of emotional and personal sphere of children, their attitude to their parents and society. 2. Practical work: diagnosing emotional and personal sphere of children using the methods of observation, conversation, method of images and testing material. 3. Psycho-correctional work with children. Mini-lectures, presentations on psycho- correctional work of a psychologist in a day care center. Session - Working with parents. 1. The participants got acquainted with psycho-correction techniques and methods of interaction of parents with children with disabilities. 2. Self-regulation training. Breathing exercises. 3. Presentation: "Features of psychological training for parents". 4. Practical work: developing the program of work with parents. Conclusions: 1. The goals and objectives of the training were successfully achieved and assessed by the participants as excellent. Effective methods and techniques used by trainers contributed to achieving the objectives of the training. 2. Materials of guidelines to standards were welcomed and appreciated. 3. Materials of the guidance manual were evaluated as necessary and useful when working with children and parents in DCC. 3. Participants asked to provide training in practical skills of psychological, speech therapy work with children with disabilities. 4. The centers’ staff should be trained to work with completing the documentation, introduction of reporting, developing educational and correctional programs. FINAL ROUNDTABLE ON THE RESULTS OF THE PROJECT 16.12.2015. There was held a national roundtable of the first network project "Empowering parents of children with disabilities" as part of the Network project in partnership with the MLSD KR, ARDI Bishkek, PF "Family for every child" in Osh and NGO "Nur Bala" in Talas, implemented with financial and technical support from ICCO Cooperation/Kerk in Actie, held on 16 December 2015 in Dostuk Hotel, Bishkek, Kyrgyz Republic from 9:30 to 14:00. Turdubu Jumabekova from ARDI told about the purpose of the final roundtable and thanked her colleagues for the fruitful work, in particular the Ministry of Labour and Social Development of the Kyrgyz Republic, PF "Family for every child" in Osh, NGO "Nur Bala" and ICCO Cooperation/Kerk in Actie and all those people who were involved in the project activities. Without this, it would be impossible to achieve these results. Deputy Minister of Labour and Social Development of the Kyrgyz Republic Polotova J.A. noted the importance and efficiency of the work with the Network and the effectiveness of the work done under the project, and invited all the participants of the final
  • 20.
    20 roundtable for activediscussion and provision of recommendations, which were made not only by the members of the Network, but also by representatives of government agencies, local governments from all regions of the country. Thus, during the discussion of results achieved there were presented valuable recommendations for future work. ARDI shared information on project activities as part of which there were conducted a baseline survey and a mid-term evaluation of the project by independent experts Ibraeva N.I. and Suyunalieva B.Sh. who were selected on a competitive basis, national roundtables, discussions on the development of minimum social standards, training on the rights for parents of children with disabilities in all regions of Kyrgyzstan, training on the use of standards, their testing in day care centers and rehabilitation centers - members of the Network, as well as exchange visits and work to mobilize and activate parents and non- governmental organizations - members of the Network. Tatyana Arhipova, ARDI expert presented the results of testing of the developed and adopted social standards. Alieva Ainura, psychologist of PF "Institute of Childhood" presented the results of the development of guidelines to the state minimum social standards of social services provided to persons with disabilities, including children, in semi-permanent organizations and social service institutions, approved by the Government Decree No. 381 dated 8 July 2014, Bishkek. Zeinep Eshmuratova from "Family for every child" informed about the successful transfer of existing DCCs and RCs to the balance of the local budget, thanks to the successful partnership with the representatives of state structures in the southern region, in total 5 DCCs out of 6 DCCs were transferred to the balance of the local budget within the framework of the project, covering 280 children. These are DCC Ariet, DCC Kurulchak, DCC Nur, DCC Buchur and DCC Sezim, as well as there were carried out works on the creation of NGOs and DCCs locally. Nurkyz Sartalieva from NGO "Nur Bala" shared the experience of working with children with disabilities in Talas region, in particular ensuring sustainability of day rehabilitation centers for disabled children, achieving sustainability of DCC "Nur Bala" by transferring into the education system through the successful working with local authorities. Read more about the roundtable with pictures at the following link https://www.facebook.com/permalink.php?story_fbid=1659105567673442&id=16128694 92297050 As a result of the final roundtable there were sent letters with recommendations of the roundtable participants to the Prime Minister of the Kyrgyz Republic, Speaker of the Jogorku Kenesh, Ministry of Labour and Social Development, Ministry of Health, Ministry of Education and Science, Ministry of Finance and Department for Local Self-Government (LSG) with ref. No. 103 dated 17.12.2015. Trainer’s report on the training conducted on budgeting in the framework of the project "Empowering parents of children with disabilities" (commissioned by ARDI) with financial support from ICCO Cooperation Training name: "Budgeting in NGOs", "Financial management in NGOs"
  • 21.
    21 Date and time:17 December 2015, from 09:00 to 18:00 Trainer: Toktomusheva Ainura, project mobilizer Venue: Bishkek, hotel "Baikhan" Training objective: To form a comprehensive understanding in the participants of the formation of the budget of organizations and projects and to consider the basic methods for the development of financial guidelines. Participants: representatives of partner organizations of the Janyryk network in Chui region (NGO "Dream of Child"), Naryn region (NOORZPD, NGO "Ak-Bayrak") and Bishkek (NGO "Moving Forward"). Participants gained the following knowledge:  The main approaches to the process of planning and developing different types of budgets and their use.  The concept of budget and budgeting process.  The most common cost items and examples of measurement units.  Features of the budgets of projects financed by several donors and allocation of overhead costs to several projects.  Basic concepts of financial policies and procedures.  The content of the financial guidelines During the training there were considered the main approaches to the process of budgeting in NGOs and the process of budgeting in the preparation of projects. What is a comprehensive system of budgeting and how it can be used to improve the efficiency of management of the organization in order to achieve higher financial and economic results. There were studied international budgeting practices, the main stages of the planning and budgeting process. In the practical part of the workshop participants assessed (self- diagnosis) current budgeting systems in order to understand what shall be corrected and improved in it, as well as to decide on the restructuring plan of the current system of budgeting in their organizations. The workshop also provided additional information for those organizations that already had experience in budgeting process. As part of the training there were considered the methods of rational distribution of the administrative costs by donors or grantors and the system of effective usage of items of administrative costs for the full use of funds. Participants were informed about the necessity of accumulation and use of membership contributions from founders, parents of children attending DCCs to directly support the activities of DCCs, the participants were asked about the taxation of these contributions and their correct use. DOCUMENTS DEVELOPED UNDER THE PROJECT THROUGH ARDI 1. The draft state minimum social standards of social services provided to persons with disabilities, including children, in the semi-permanent organizations and social service institutions. Developers: SUYUNALIEVA B.Sh. ARHIPOVA T.V., ZHUMABEKOVA T.K. 2. Analysis of normative legal acts focusing on social services and standards. Developer-lawyer of NGO "Association of Parents of Children with Disabilities" (ARDI) Seinep Dyikanbaeva, published in the state and official languages. 3. Situational analysis of day care centers for children under the project of the Janyryk network conducted by an expert Dzhakubova N.I. 4. Guidelines for the testing of minimum standards for social services for children with disabilities, Arhipova Tatyana Viktorovna. 5. Didactic materials for working with children with disabilities in rehabilitation centers. Developers: Jumabekova T.K., Eshenkulova K.M., Arhipova T.V., Dyikanbaeva S.R., published in the state and official languages. 6. Mid-term evaluation of the project conducted by an expert Dzhakubova N.I.
  • 22.
    22 7. Monitoring oftesting the state minimum social standards of social services provided for children with disabilities by centers of the Janyryk network, conducted by an expert Suyunalieva B.Sh. There were assessed the activities of RCs in all regions of the Kyrgyz Republic - members of the Janyryk network, in total 10 Centres. 8. Provision of social services in day care centers. As part of the sub-grant through ARDI for PF “Institute of Childhood” - a national network "Janyryk". "Guidance manual for social service institutions and day care centers providing services for children with disabilities". Group of developers: Dzhakubova Nurzhamal - expert, president of PF "Institute of Childhood", Alieva Ainura - psychologist in KNU named after Zh.Balasagyn, Amerkhanova Sania - acting associate professor of INDO at BHU named after K. Karasaev, expert on inclusive education of the WB project "Global Partnership for Education" in MES KR, Arhipova Tatyana - Ph.D., associate professor of IUCA, Dzhumabaeva Janyl - expert, head of the Department for Family and Children, MSD KR, Kydykbaeva Svetlana – expert, Ph.D. 9. MODEL REGULATION on semi-permanent services for children with disabilities, Arhipova T.V., Dyikanbaeva S.R., Jumabekova T.K. CONCLUSION The project has been evaluated by independent local experts and an expert from the Netherlands. Evaluation of the project has been positive, but the most important thing is the achievement of the set goal and implementation of all planned objectives and expected results, especially the timing of the standards adoption ahead of schedule and reduction of activities to lobby the standards that allowed for additional activities described in this report - this is an indicator of successful interaction of the Network with public authorities, in particular with the Ministry of Labour and Social Development (MLSD) of the Kyrgyz Republic. Of course a single project cannot solve the problems in the provision of alternative social services, but it's safe to say that the foundations are laid, and the initiative will be continued by the Network and the MLSD KR. ARDI, in turn, continues the initiated work in its activities.
