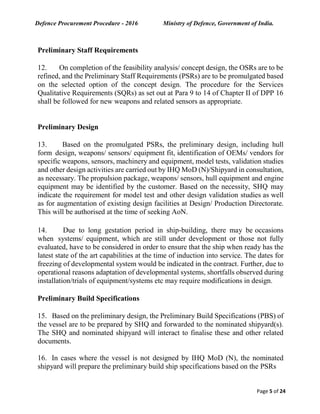

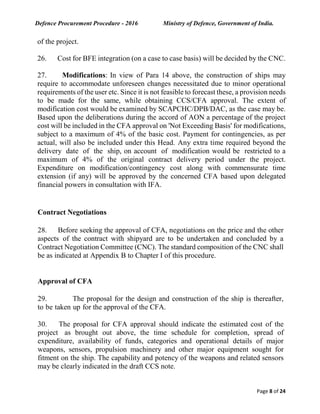

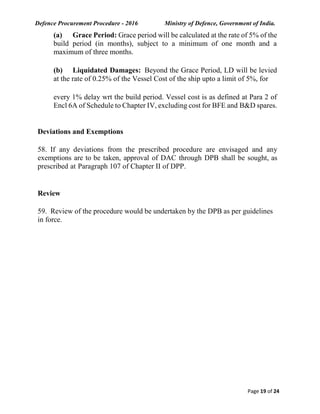

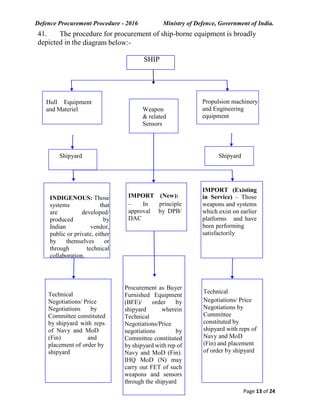

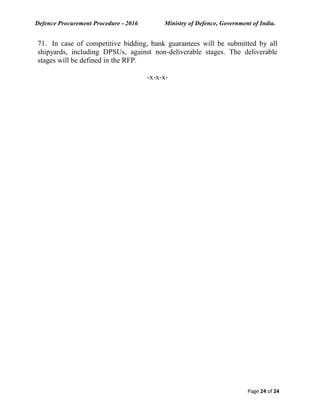

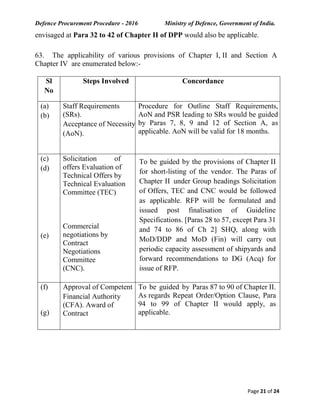

This document outlines the procedure for defence ship building in India according to the Defence Procurement Procedure of 2016. It discusses the process which includes feasibility studies, concept design, model tests, preliminary and detailed design, system integration and construction. It also involves selecting equipment from indigenous and foreign suppliers.

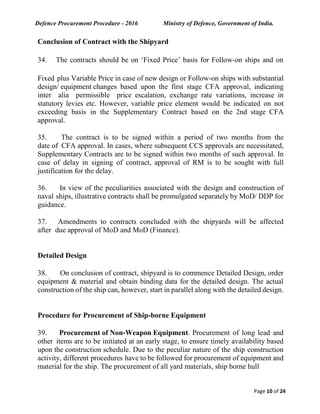

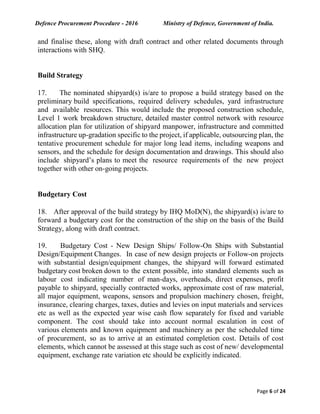

The procedure has two sections - acquisition of naval/coast guard ships through nomination of defence public sector undertakings, and acquisition through competitive bidding. For nomination projects, the outline and preliminary staff requirements are prepared, a shipyard is nominated, and budgetary/estimated costs along with timelines are developed. Approval is obtained from the competent financial authority in stages. The contract is then concluded with the shipyard.
