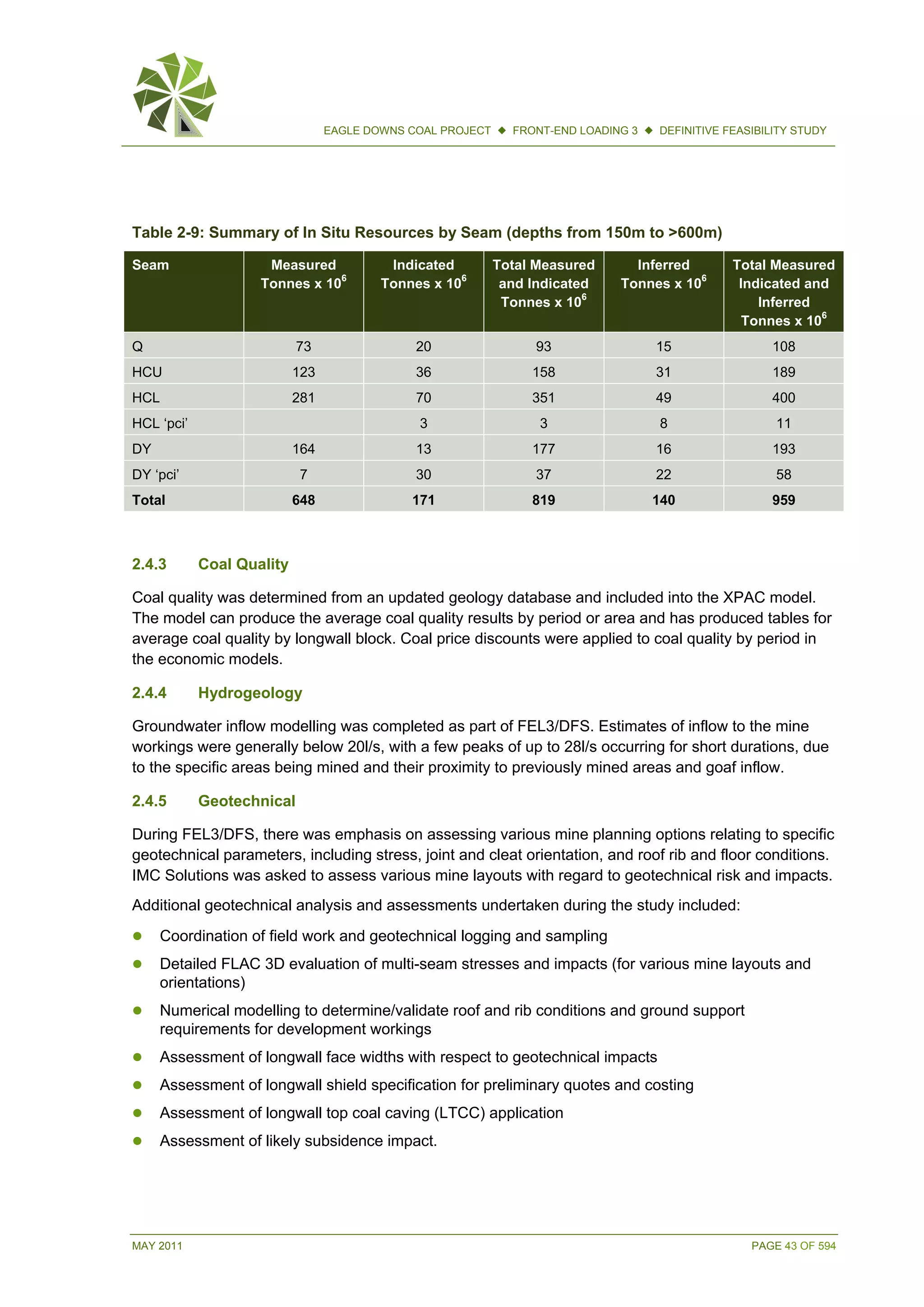

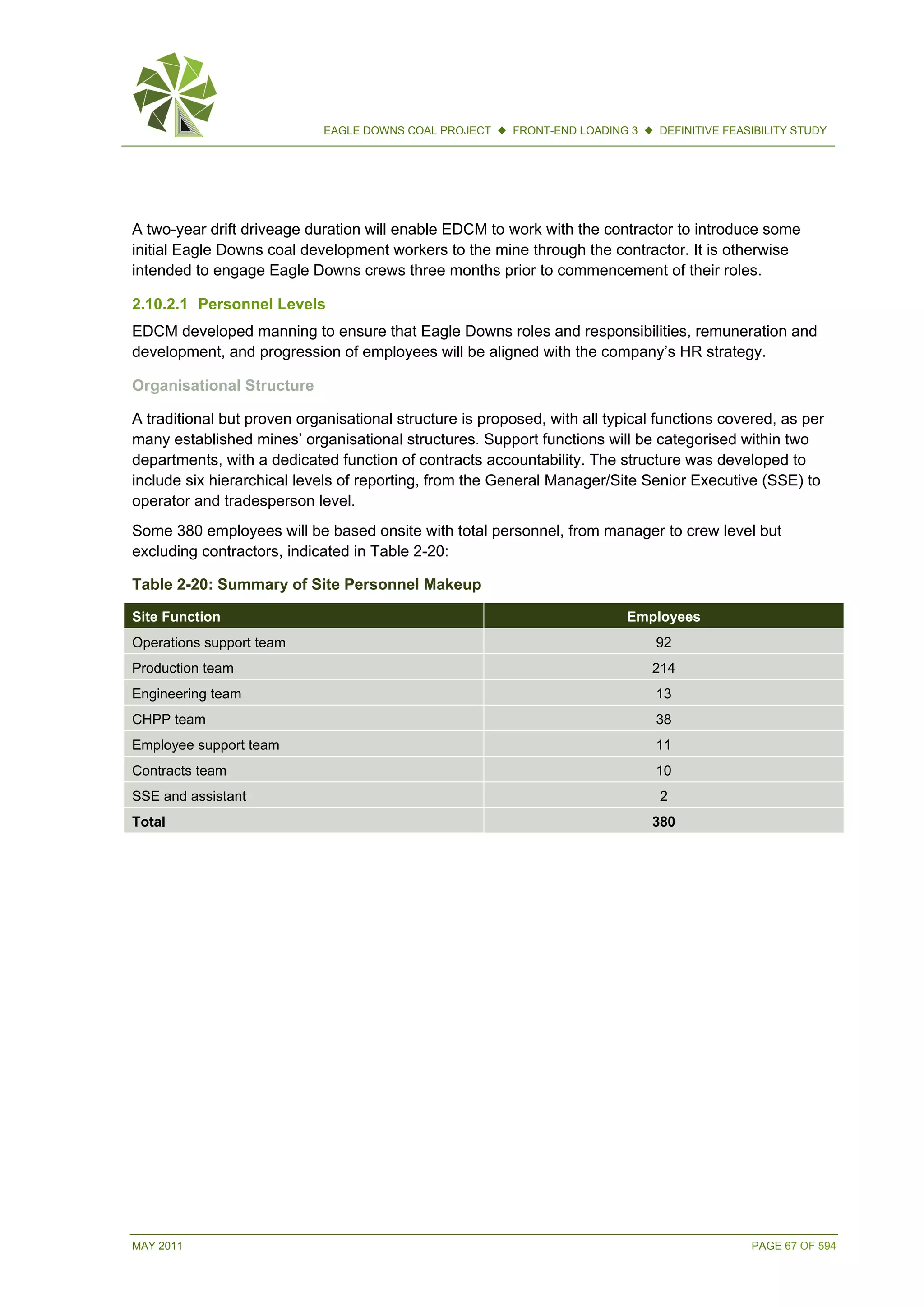

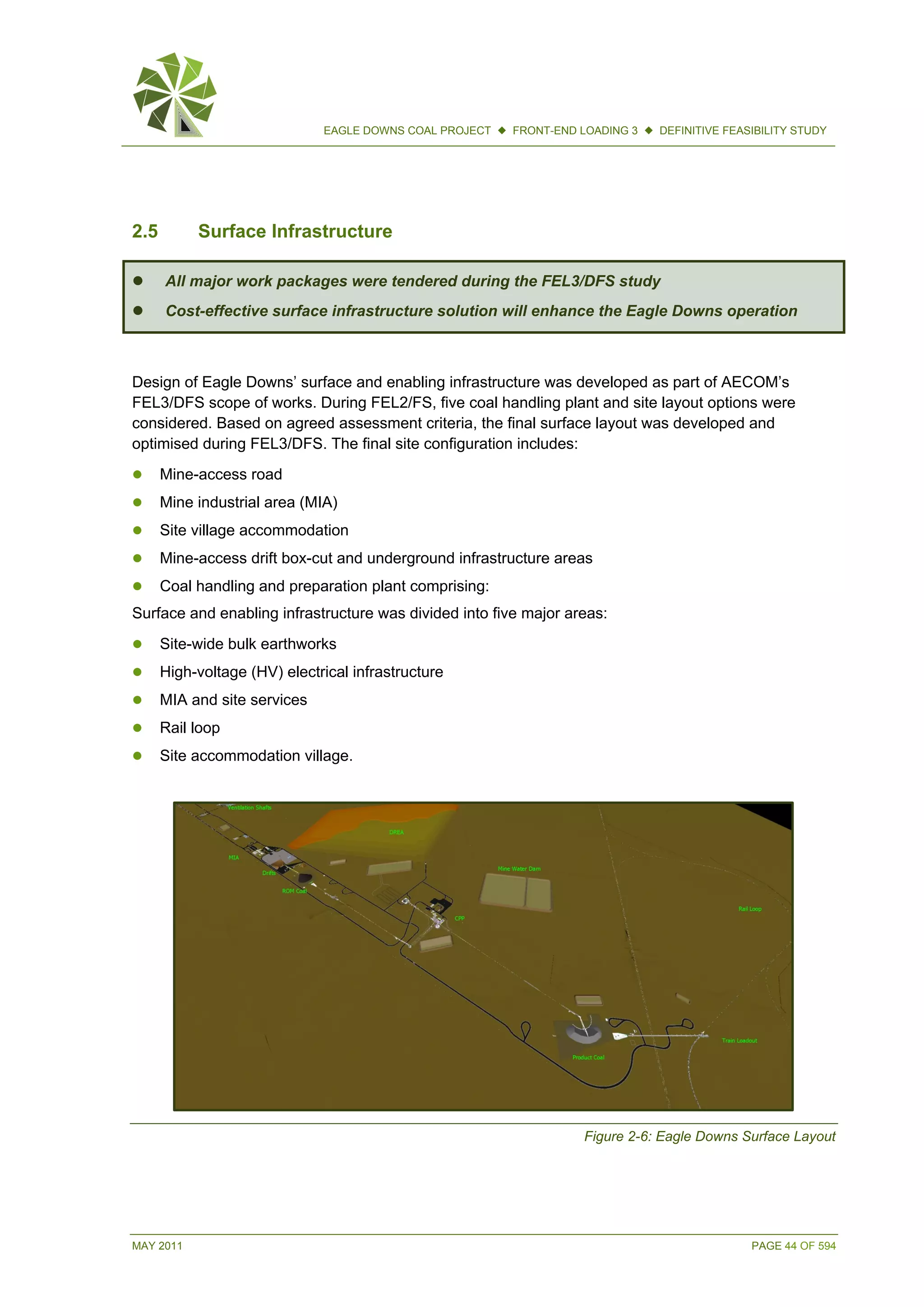

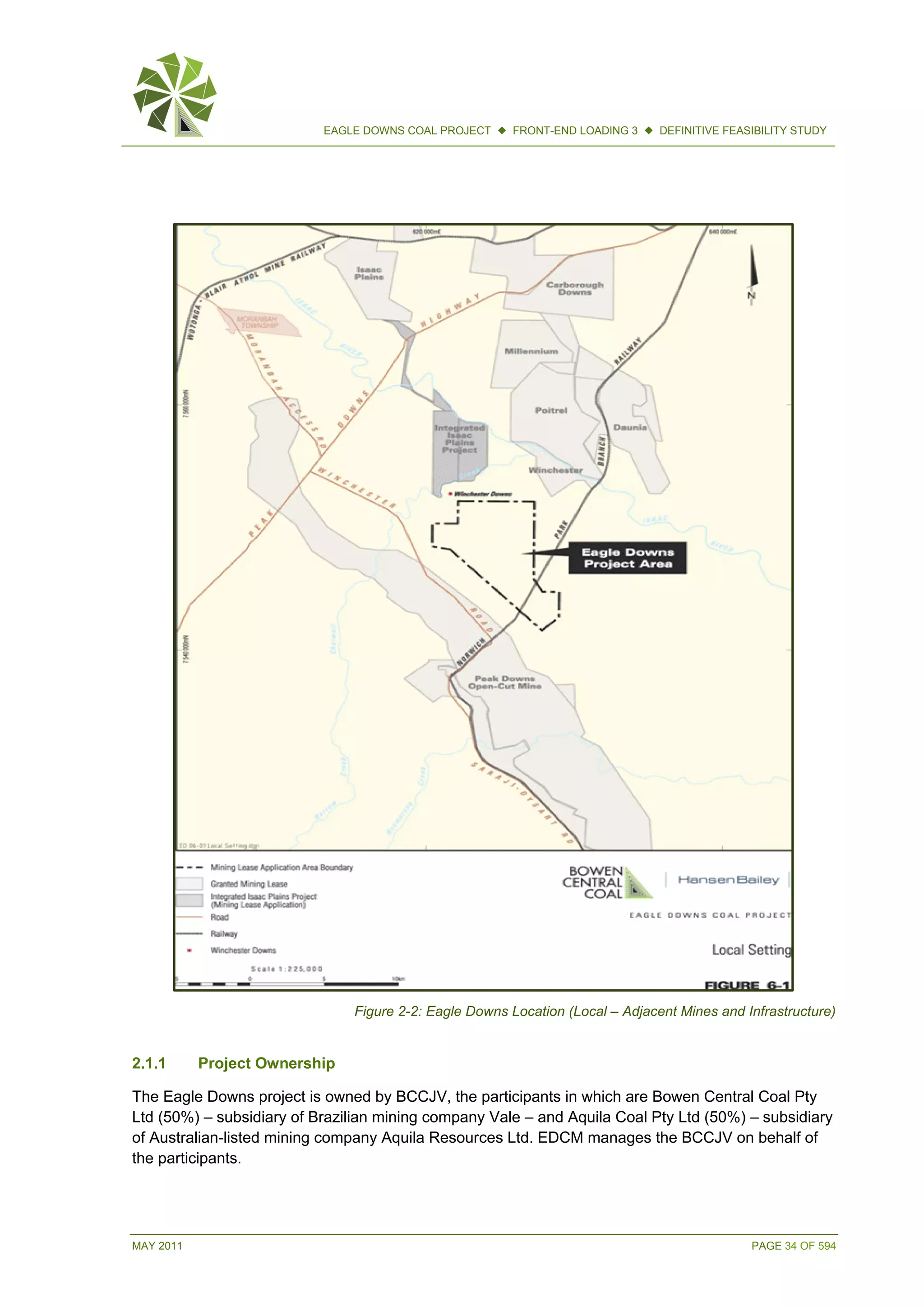

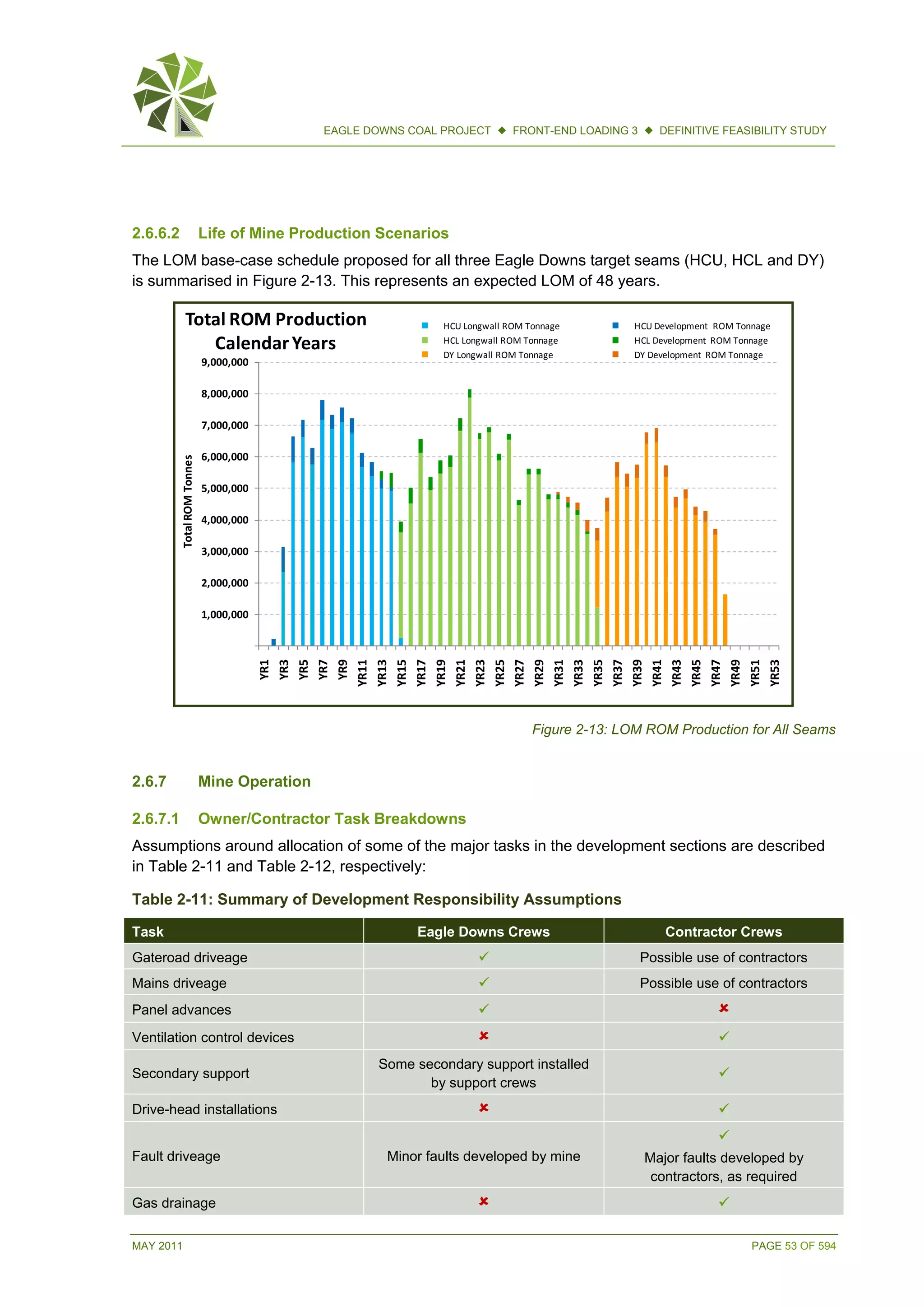

The document summarizes a feasibility study for the proposed Eagle Downs Coal Project in Queensland, Australia. Key points include:

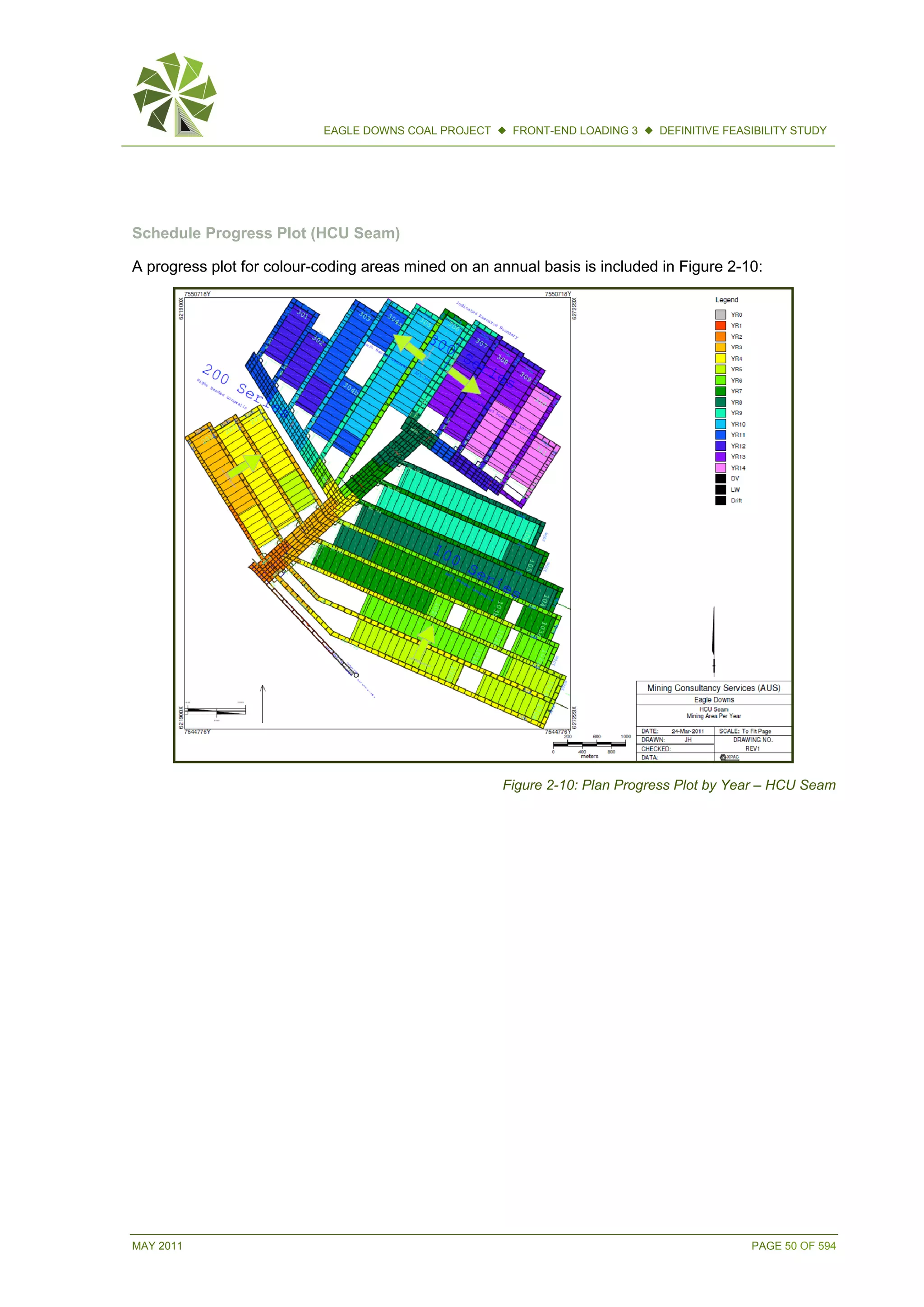

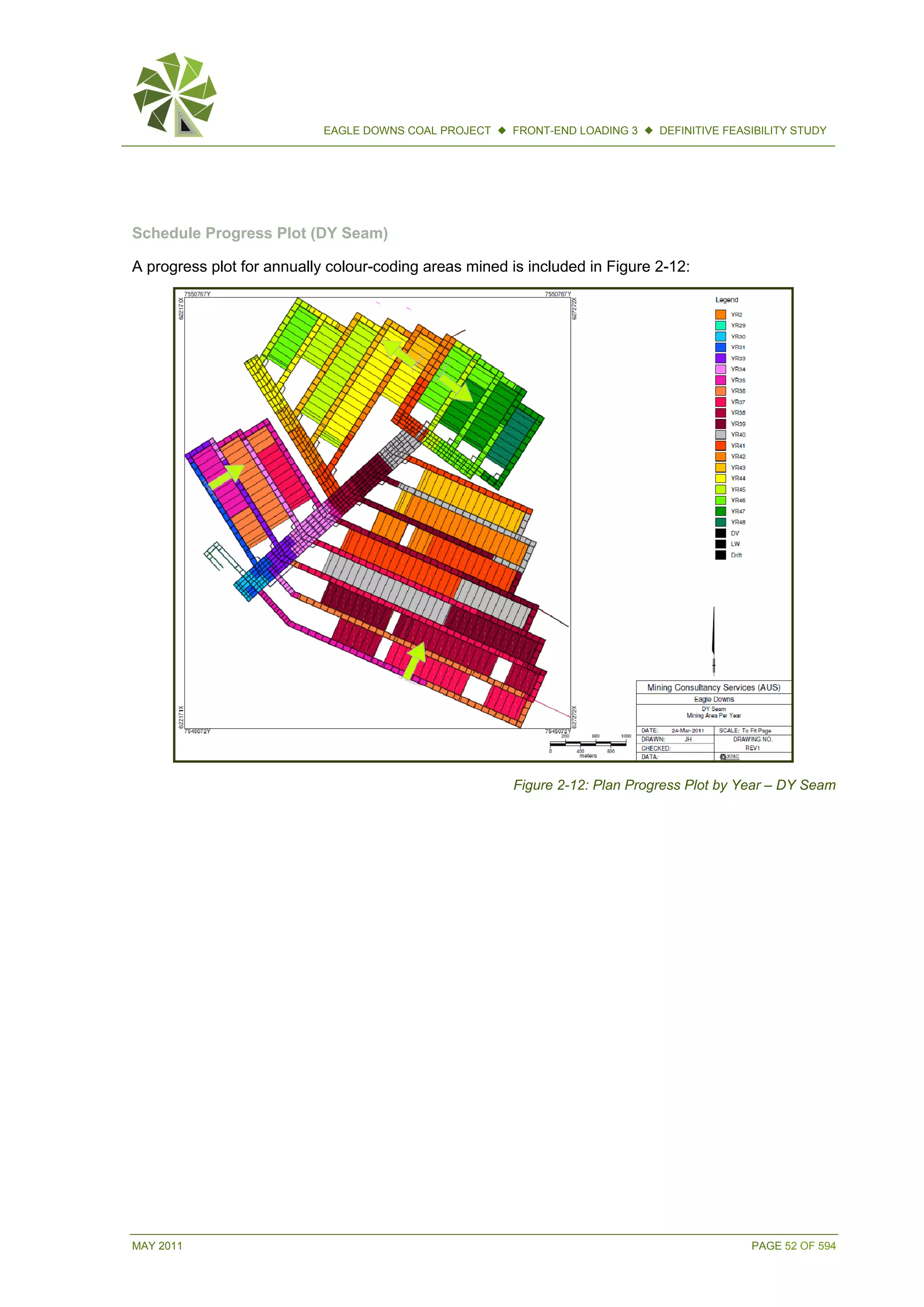

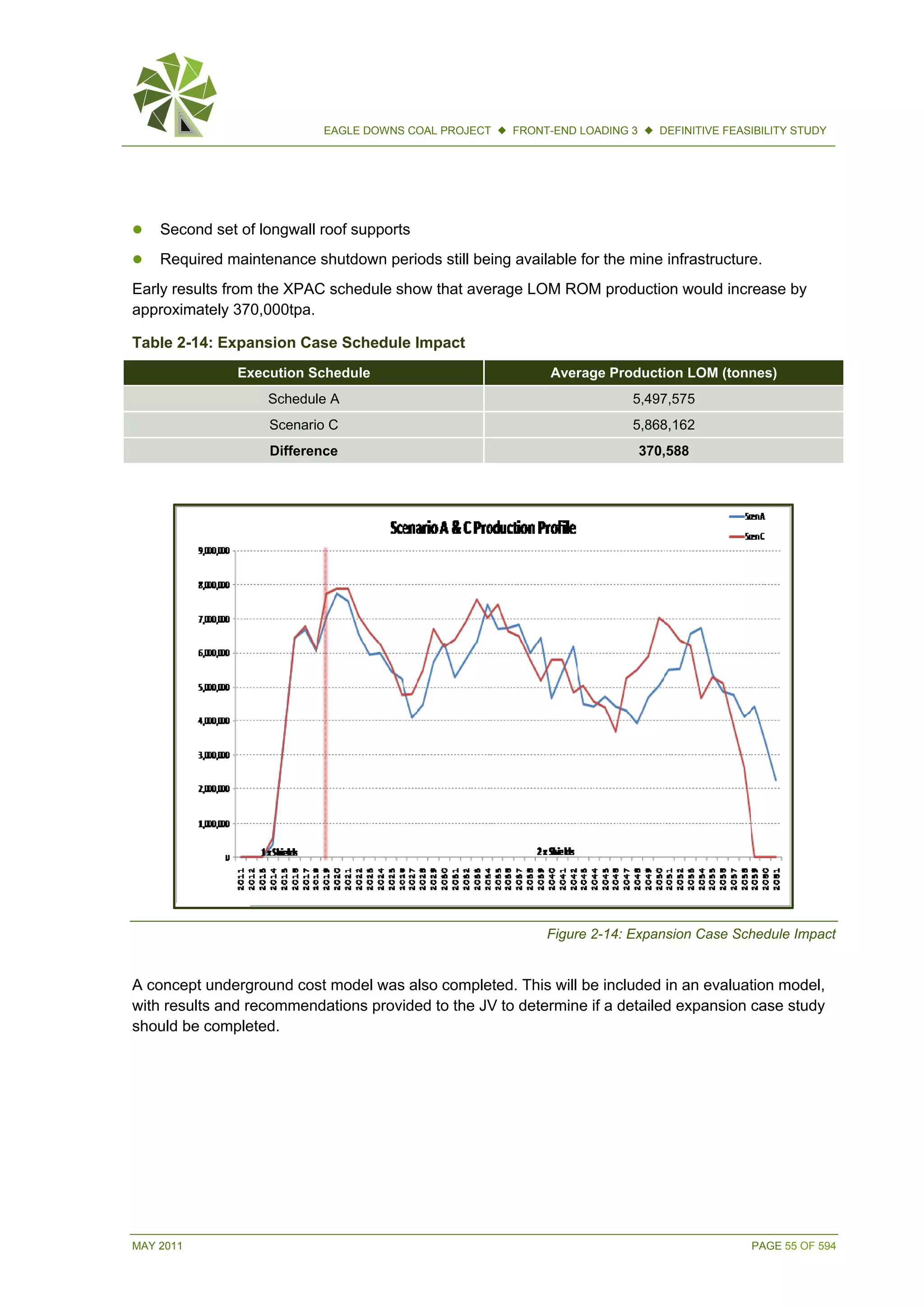

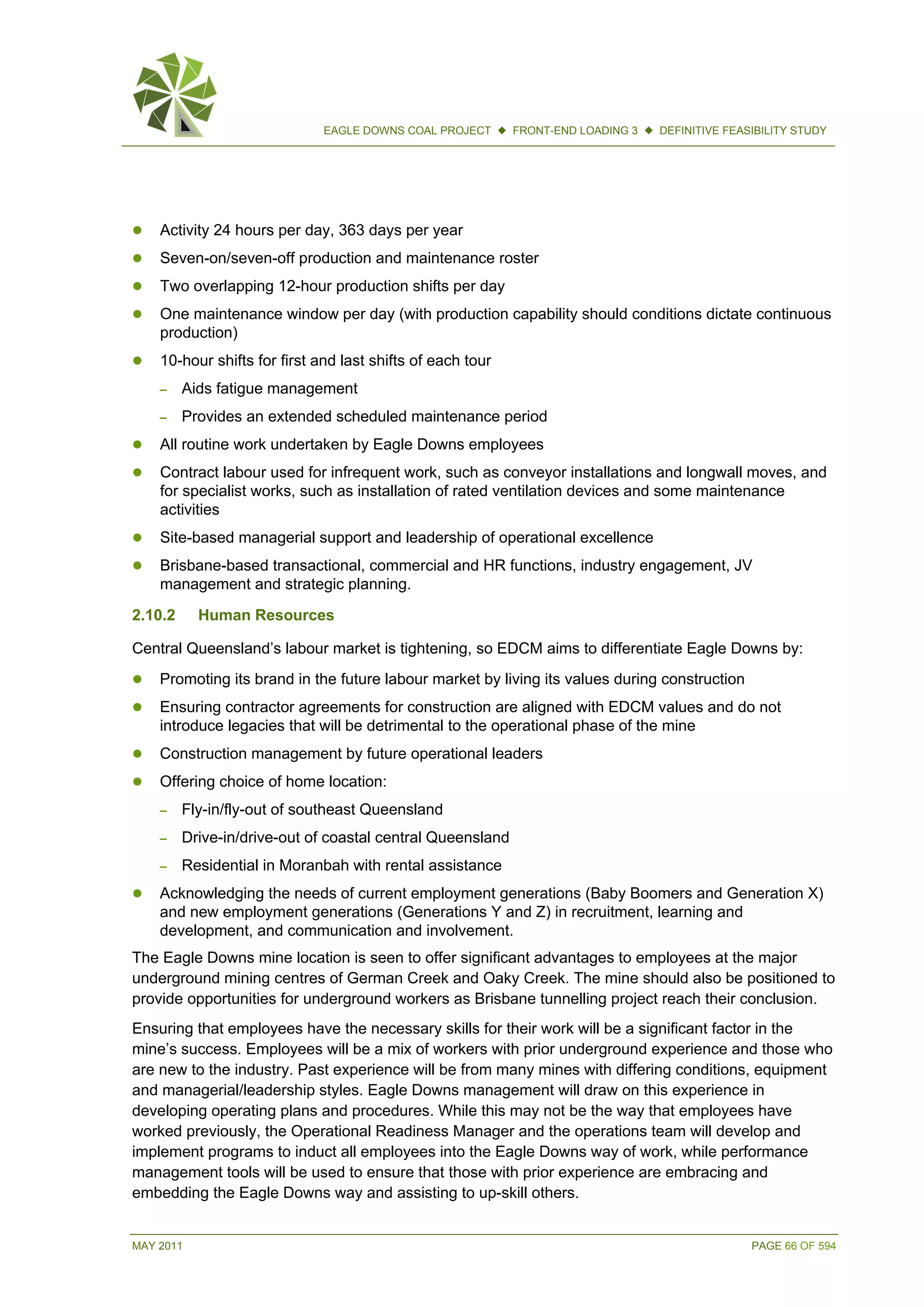

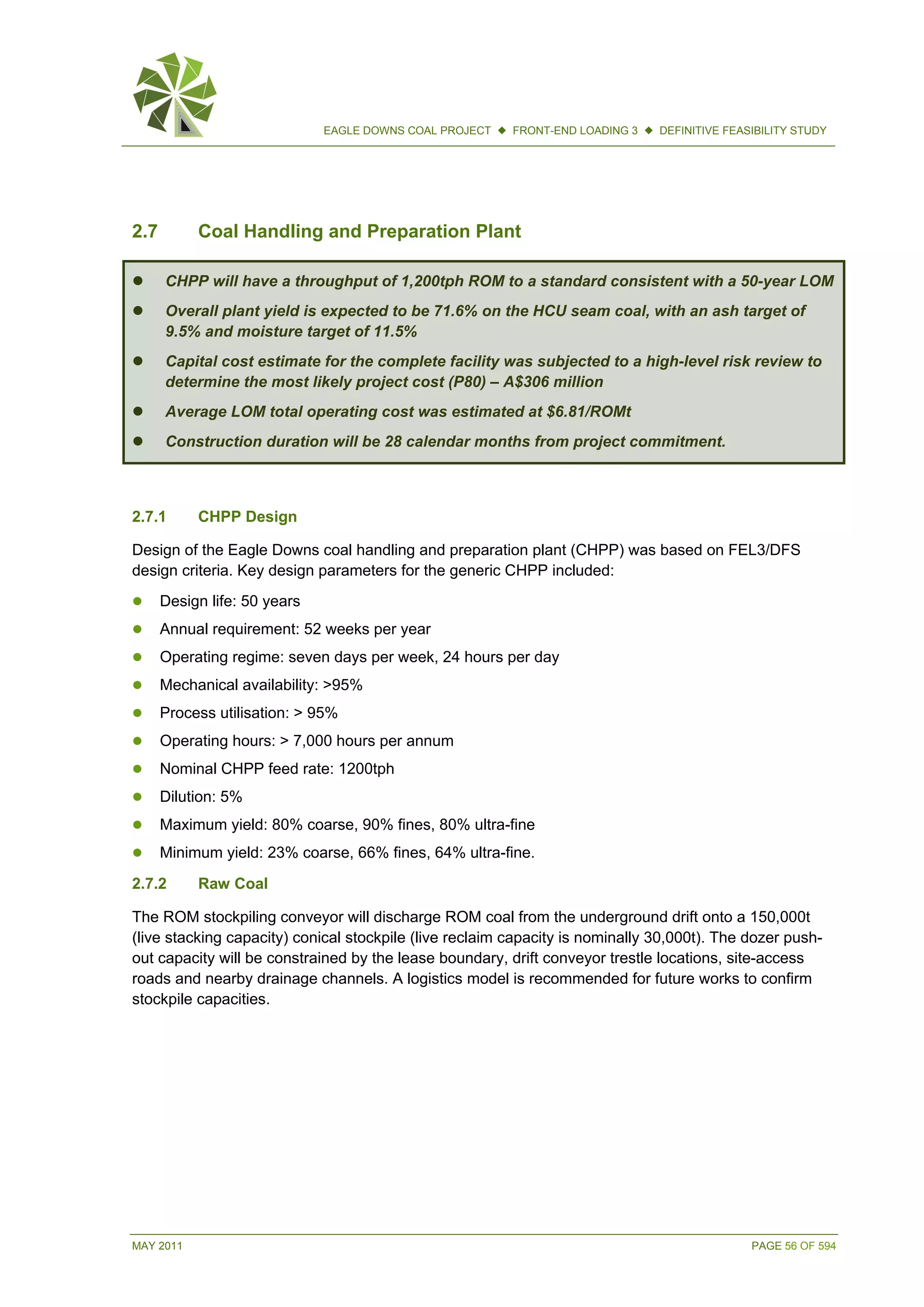

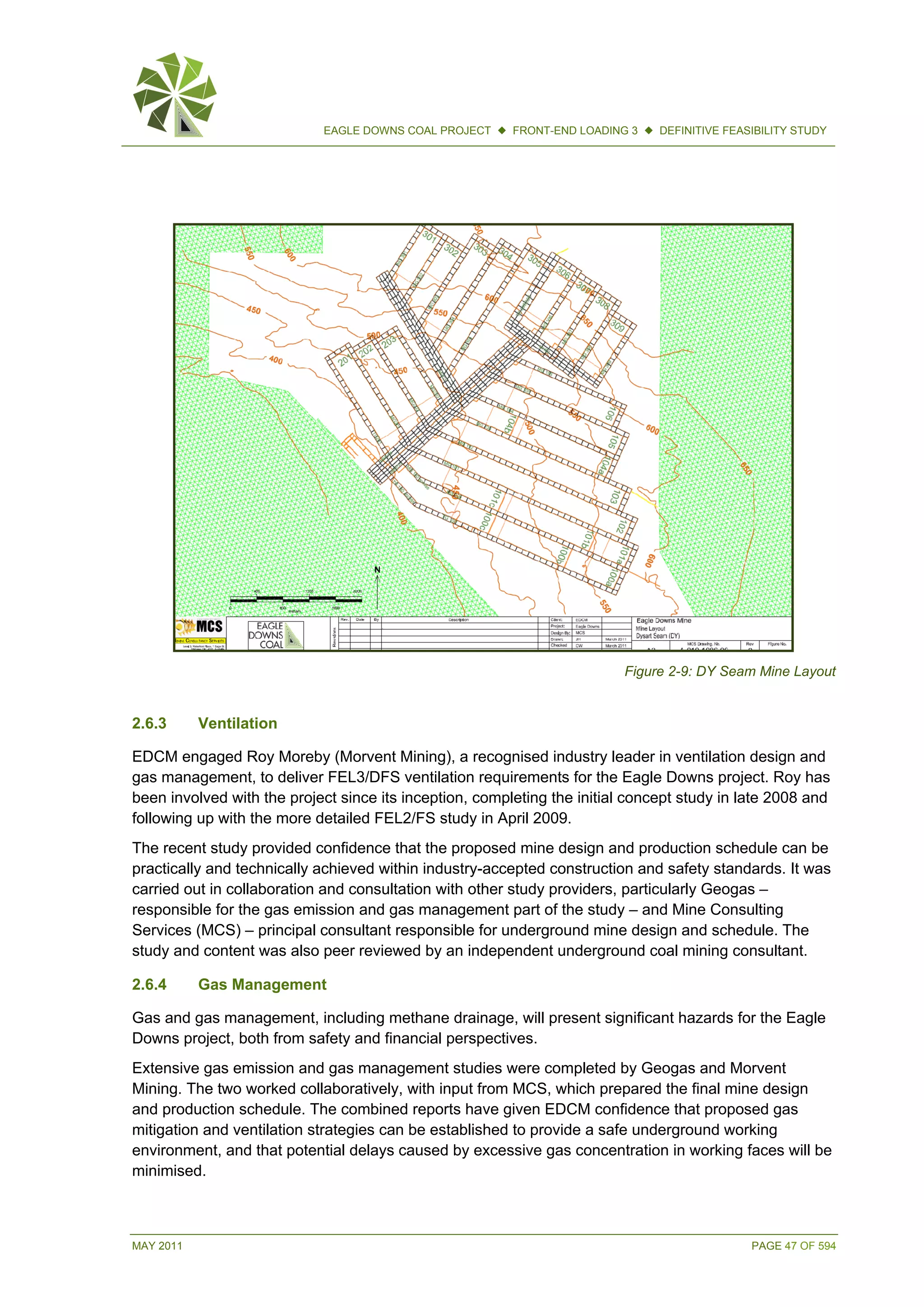

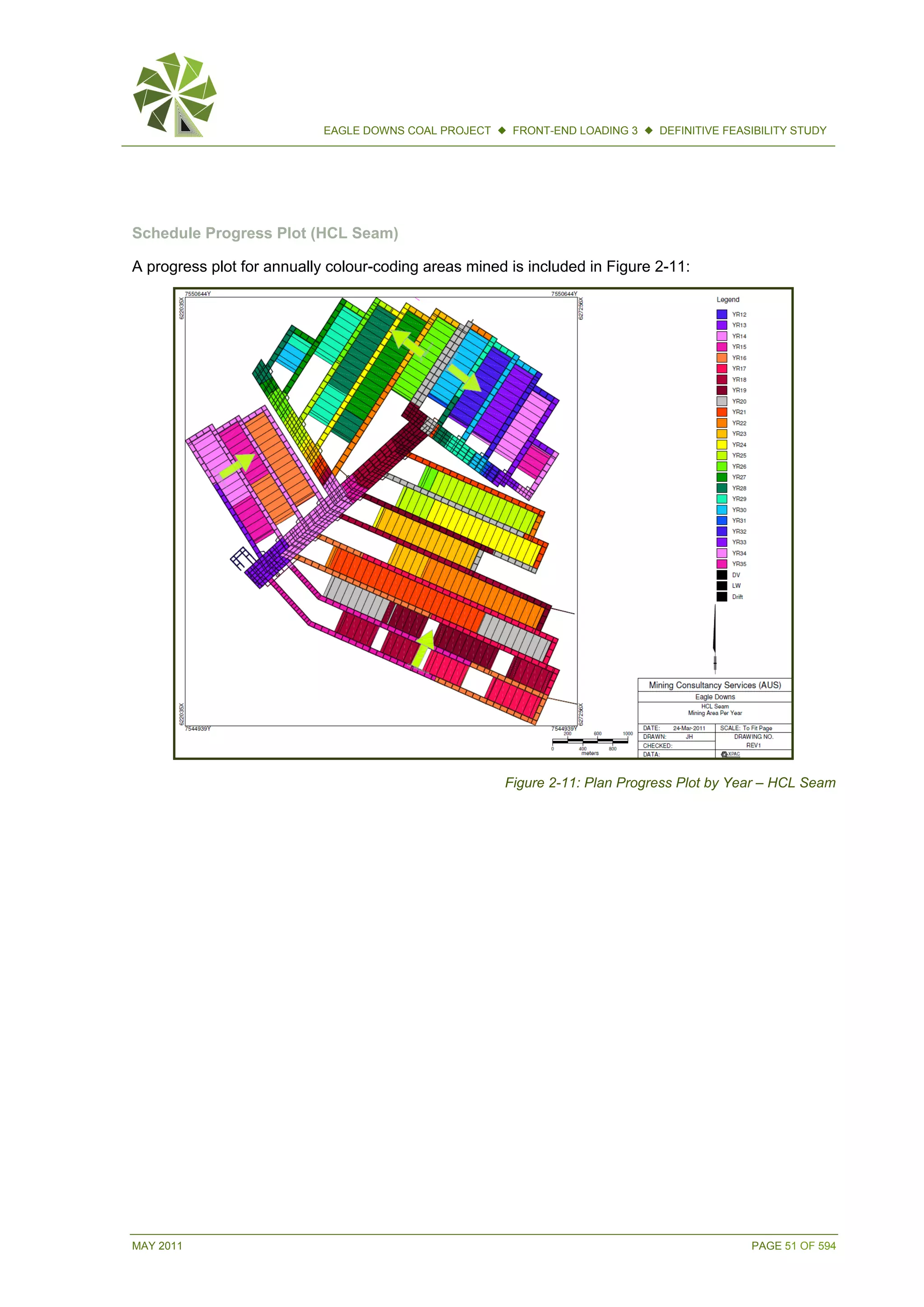

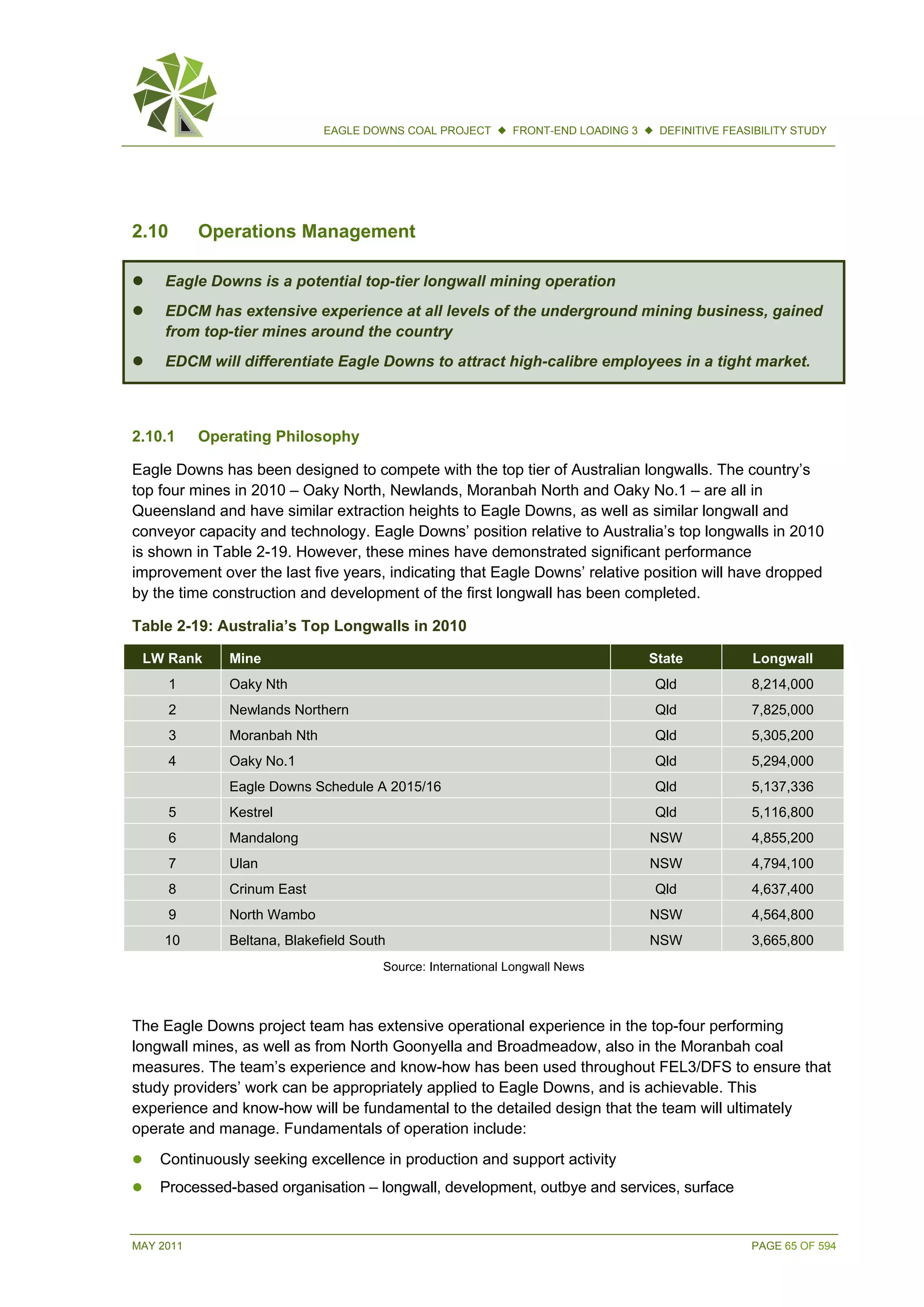

- The project involves developing an underground longwall hard coking coal mine with a planned production of over 5 million tonnes per year.

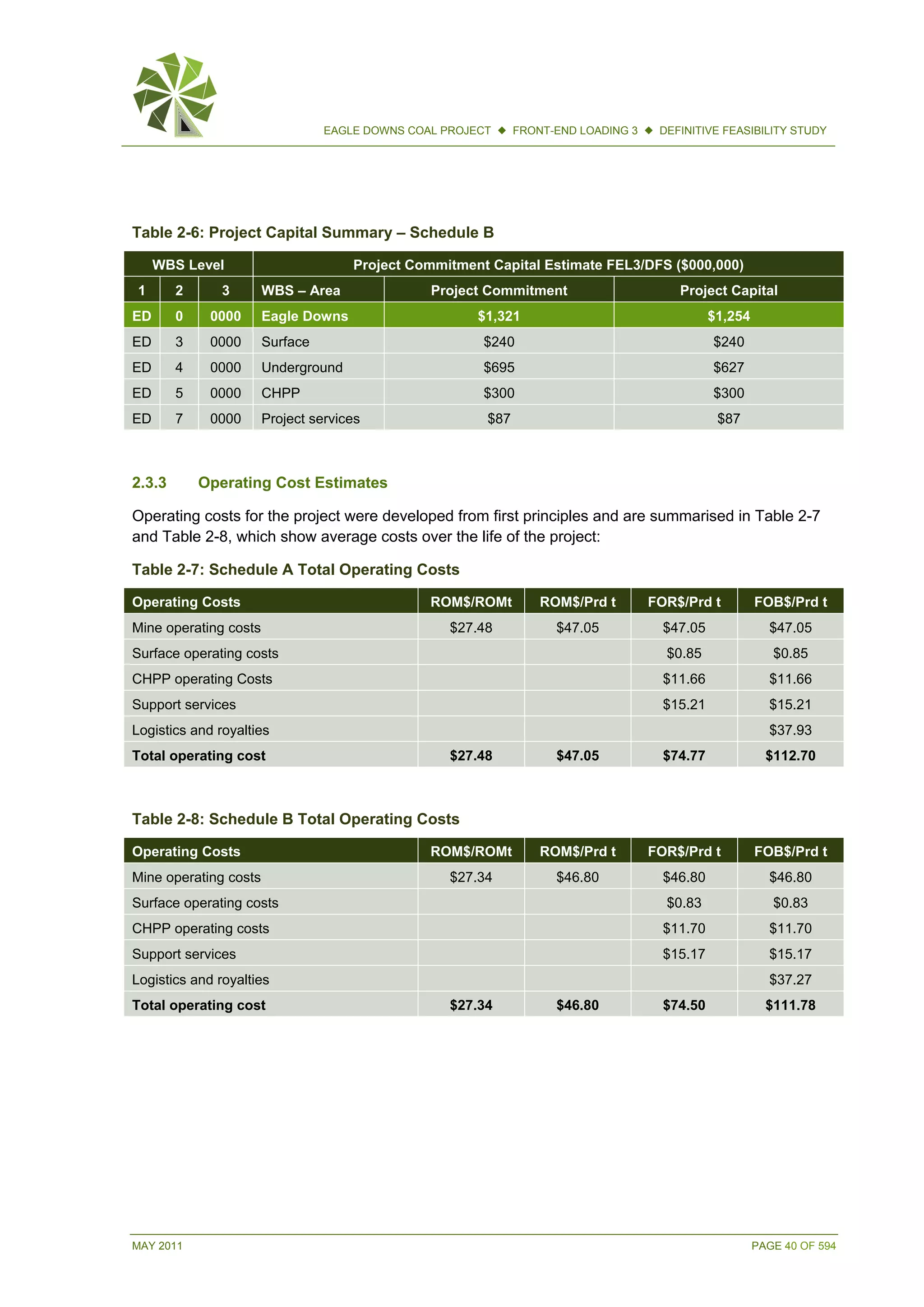

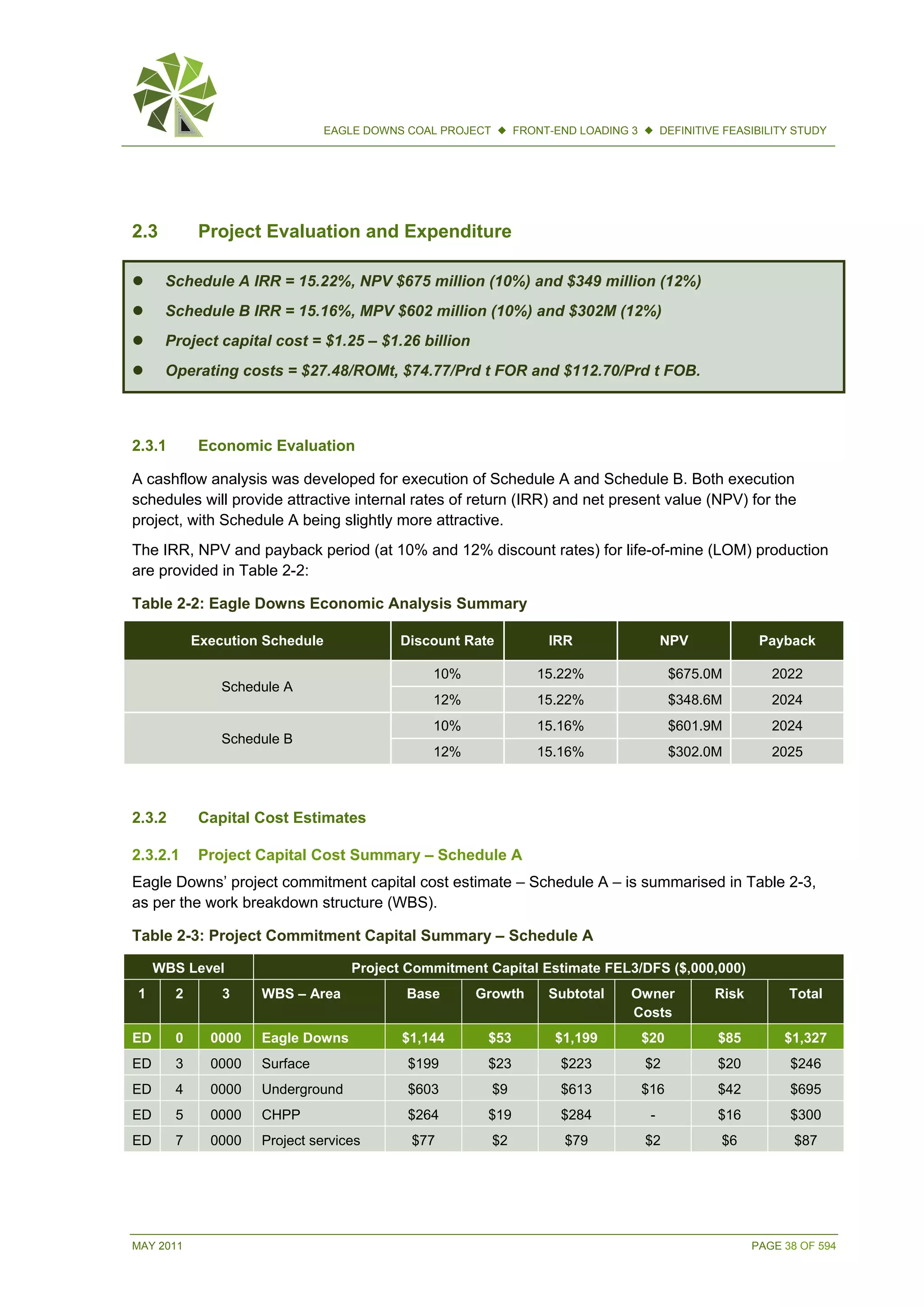

- A definitive feasibility study estimated the total capital cost at $1.25-1.26 billion and found the project would have an internal rate of return of 15.16-15.22% and payback period of 2022-2025, indicating it is economically viable.

- The target coal seams are the Harrow Creek Upper, Harrow Creek Lower and Dysart seams, which are estimated to contain a JOR
