WoodWorks

                  CaseStudy

                           CLT Milestone
                             in Montana
                                                                   Cross Laminated Timber
                                                                   Makes its Mark with
                                                                   The Long Hall

                                                                   It happened so quickly that most design
                                                                   and construction professionals probably
                                                                   missed it. But when the first commercial
                                                                   building project in the U.S. constructed
                                                                   with cross laminated timber (CLT) was
                                                                   completed in 2011, it opened the door
                                                                   to new opportunities for the entire
                                                                   building industry.

                                                                   The Long Hall in Whitefish, Montana
                                                                   epitomizes many of the benefits of
                                                                   CLT construction—speed of installation,
                                                                   environmental and aesthetic benefits
                                                                   of wood, and energy efficiency. The
                                                                   two-story wood structure took just five
                                                                   days to erect, and gave the owner a
                                                                   sustainable, energy-efficient building.




Earn one AIA/CES CEH (HSW) by reading this document and
taking a short online quiz. For details and learning objectives,
visit the Online Training Library at woodworks.org.
WoodWorks is an approved AIA provider.


                                                                   woodworks.org
Converting from CMU
   The Long Hall is a mixed-use, urban infill
project designed to replace an unsightly
60-year-old Quonset hut in downtown
Whitefish, Montana. The new 4,863-square-
foot structure provides business and retail
space on the first floor, and the second floor
is occupied by a martial arts studio.
   Originally designed with concrete masonry
units (CMU), the building designer, Datum
Design Drafting, worked with Innovative
Timber Systems (ITS) and Darryl Byle, PE, of
DSB Engineering & Consulting to convert the
structure to CLT. “Together, we convinced
the client that CLT would be a cost-effective
alternative to CMU while delivering a high-
performance building, more sustainably and
with a better design aesthetic,” said Byle. “The
client had no particular affinity for concrete and
also had time constraints. We were confident
that CLT would provide the perfect solution.”
   Byle said the top three benefits of using CLT
for The Long Hall were speed, aesthetics and
thermal performance. “With CLT, the entire
two-story structure took just five days to install.
We went from slab to occupancy in three
months. And the owner loves the interior              arts studio through the fall,” he explained. “By       and shipped directly from the manufacturer
feel and renewability of the resource. He             raising the building structure in just five days, he   to the job site, where they can be quickly
also wanted a high-performing structure; the          was able to open the studio for the fall season.”      and efficiently lifted into place. “By modeling
energy efficiency of the CLT system made this                                                                the entire structure in 3-D and meeting with
a good choice.”                                       Planning Ahead                                         vendors and subcontractors well in advance,
   The resulting Type VB structure was built                                                                 we defined the design challenges and resolved
to 2009 International Building Code (IBC)                 Because local code officials and
                                                                                                             issues dynamically,” said Byle.
requirements. The building consists of 38 glulam      subcontractors were not familiar with CLT,
beams along with 13,000 square feet of CLT            Byle said it was critical to plan ahead.
                                                          “I worked as a building official myself,
                                                                                                             Pre-assembled Walls
for the walls, second floor, roof, clerestory,
partitions and arches.                                so I understood their concerns about being                Because of shipping constraints from Europe,
                                                      first to use a new product,” he said. “That’s          CLT panel size was limited to 7 feet 4 inches
Cost Competitive                                      why I began talking with our local building            in width and 39 feet in length, said Byle. “This
                                                      department more than six months in advance;            meant the wall panels could not stack full-
   Overall cost of the entire project was             to make sure they were comfortable with it.            story height as is often the case with other
approximately $145 per square foot, $60 of            The project became a real team effort; we all          pre-manufactured CLT wall assemblies. After
which was attributable to the installed cost of       wanted to do this right so the building officials      reviewing the pros and cons of vertical versus
the CLT and glulam.                                   were there asking questions and educating              horizontal stacking, we determined that it
   Because CLT had not been used for a                themselves but also keeping an eye out for us.”        would be more effective to assemble the walls
commercial building in the U.S., one of the first         Preplanning was also critical because CLT          as vertical elements in a standard platform
things Byle and his team verified was its cost        for The Long Hall was sourced from Europe              framing configuration.”
competitiveness. Pete McCrone, a Quantity             (although there are now several North American            The Long Hall had less than 30 inches of
Surveyor with ITS, compared CMU and CLT               suppliers). CLT panels are manufactured for            spacing between it and adjacent buildings.
across approximately 30 project elements. The         specific applications, so are prefabricated            Because this left virtually no room for on-site
analysis favored CLT, in                                                                                     construction, contractors pre-assembled the
part because the exposed                                                                                     main vertical CLT walls in four- and five-panel
wood structural shell could                                                                                  elements at a nearby site. They glued and
serve both as interior wall                                                                                  screwed the splines and then transported the
and ceiling finish. The                                                                                      pre-assembled wall panels to the job site (the
CLT system also required                                                                                     largest were 30 x 11 feet) using an A-frame on a
less time on site for                                                                                        low-boy trailer.
erection, which reduced                                                                                         By pre-assembling the vertical panels
construction costs.                                                                                          and lifting them into place via crane, the
   Initial estimates put the                                                                                 contractor minimized on-site installation time.
cost difference between                                                                                      Panels arrived from the manufacturer with
CLT and CMU close to                                                                                         pre-slung lift webbing, which also helped
even, but Byle said time                                                                                     construction move quickly and efficiently. The
value of the finished                                                                                        CLT manufacturer used CNC equipment to
building tipped the scales                                                                                   precisely pre-cut beam pockets and openings
in favor of CLT. “Originally,                                                                                for windows and doors at the factory.
the owner was going to
have to close his martial
engineer designed a flexible glulam beam base
                                                                                                         plate using a tongue and groove connection at
                                                                                                         the base of the CLT wall. Anchor bolts connect
                                                                                                         the plate to the foundation at locations offset
                                                                                                         from panel attachment points, providing a
                                                                                                         flexible connection able to take the prescribed
                                                                                                         seismic loads.

                                                                                                         Thermal Performance
                                                                                                            CLT’s thermal performance was an attractive
                                                                                                         benefit for The Long Hall’s owner. Because CLT
                                                                                                         is a solid wood panel, it provides thermal mass.
                                                                                                         Wood is also a good natural insulator. And,
                                                                                                         since CLT panels can be manufactured using
                                                                                                         CNC equipment to precise tolerances, panel
                                                                                                         joints fit tight, which further improves energy
                                                                                                         efficiency.
                                                                                                            To help illustrate this benefit, Byle contacted
                                                                                                         a Montana Department of Environmental
                                                                                                         Quality (DEQ) official, who conducted a blower
                                                                                                         door test on the structure for educational
                                                                                                         purposes with an Energy Systems class. “They
                                                                                                         don’t normally do these tests for commercial
Approved as a One-hour                               CLT Met Other Design Challenges                     buildings,” he said, “but the results reflected a
Rated Assembly                                          The design and construction team used CLT
                                                                                                         very airtight system. Energy code maximum is
                                                                                                         four air changes per hour, and two is considered
   While The Long Hall was designed as a             to overcome a number of other challenges. For
                                                                                                         tight for an energy-efficient home. This CLT
Type VB structure, fire protection was still a       example, the site’s soils got softer as they went
                                                                                                         system measured just 1.5 air changes per hour,
consideration in terms of getting CLT accepted       deeper, so the foundation had to stay shallow.
                                                                                                         which is excellent.”
for use. Since the structure was sited within five   Since CLT weighs less than CMU, they were
                                                                                                            Byle said they taped panel joints and beam
feet of the property line, the north and south       able to use a smaller foundation. Heavier CMU
                                                                                                         ends before installing mineral wool insulation
exterior walls were required to be one-hour fire-    would have also increased footing size and slab
                                                                                                         boards on the exterior of the structure. “This
rated, and the entire building was sprinklered.      connection requirements, so additional cost
                                                                                                         fast, simple installation helps us maintain a
   Byle met with building officials to resolve       savings were realized by using CLT.
                                                                                                         vapor-open, breathable structure.”
concerns about fire safety. In order to meet the        In order to optimize available floor space and
design objective to feature exposed CLT on the       internal space configuration, the structure was
                                                     designed to free-span the 25-foot-wide lot.         Pre-planning Paid Off
interior, they needed approval of the CLT system
as a stand-alone, one-hour rated assembly. Byle      They incorporated CLT wall panels as out-of-            The significance of being involved with the
used data on fire design from sources such as        plane bending elements to provide sufficient        first commercial CLT installation in the U.S.
the National Design Specification® (NDS®) for        stiffness for the transverse lateral loads on the   was not lost on Byle. “I learned that I am going
Wood Construction and experimental CLT fire          structure. Each panel/column/beam assembly          to love using CLT,” he said. “The owner had
test data from manufacturers and independent         acts as a modified moment frame to absorb           never heard of CLT before this project, but he
sources1 to show CLT panels could be expected        lateral forces and distribute them to the           loves wood; CLT allows him to have a high-
to perform well in a fire event.                     foundation.                                         performance structure that looks good. He
   Additionally, Byle negotiated to reduce the          Because CLT has high stiffness, the design       had considered using CMU and metal, and was
required overall thickness of the wall assembly      had to accommodate vertical motion along            hesitant about being first to use something
by taking advantage of                               the longitudinal walls. In order to do that, the                  new, but he is thrilled with the
CLT’s unique structural                                                                                                end result.”
characteristics. Because                                                                                                  Byle knew that breaking ground
CLT is only exposed on one                                                                                             with CLT would be a challenge, but
side, it can easily withstand                                                                                          cites careful planning as key to their
the code-prescribed one-                                                                                               success. “Getting early buy-in from
hour burn. Further, the                                                                                                the code officials was a definite
undamaged portion will still                                                                                           advantage,” he said.
transfer loads bi-directionally                                                                                           He added that early design
around the compromised                                                                                                 completion was probably the
area. Working with the                                                                                                 most important thing he learned.
local code official, Byle                                                                                              “Having the design finalized well
established a reasonable                                                                                               in advance of construction helped
fire event dimension and                                                                                               us pre-emptively identify and
designed the structure to                                                                                              solve problems,” said Byle. “Pre-
deal with that localized                                                                                               planning with our CLT supplier and
structural compromise (an                                                                                              subcontractors also paid off. As a
approach that is conceptually                                                                                          result, we finished the project on
similar to disproportionate                                                                                            time and on budget. I look forward
collapse regulations used in                                                                                           to more success with CLT.”
the United Kingdom).

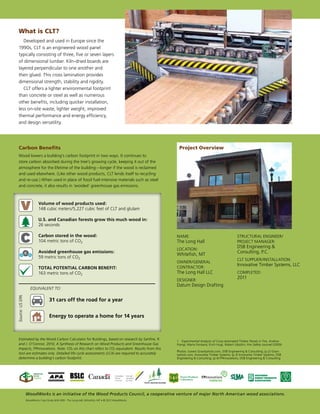

What is CLT?
    Developed and used in Europe since the
 1990s, CLT is an engineered wood panel
 typically consisting of three, five or seven layers
 of dimensional lumber. Kiln-dried boards are
 layered perpendicular to one another and
 then glued. This cross lamination provides
 dimensional strength, stability and rigidity.
    CLT offers a lighter environmental footprint
 than concrete or steel as well as numerous
 other benefits, including quicker installation,
 less on-site waste, lighter weight, improved
 thermal performance and energy efficiency,
 and design versatility.




 Carbon Benefits                                                                                  Project Overview
 Wood lowers a building’s carbon footprint in two ways. It continues to
 store carbon absorbed during the tree’s growing cycle, keeping it out of the
 atmosphere for the lifetime of the building—longer if the wood is reclaimed
 and used elsewhere. (Like other wood products, CLT lends itself to recycling
 and re-use.) When used in place of fossil fuel-intensive materials such as steel
 and concrete, it also results in ‘avoided’ greenhouse gas emissions.



                          Volume of wood products used:
                          148 cubic meters/5,227 cubic feet of CLT and glulam

                          U.S. and Canadian forests grow this much wood in:
                          26 seconds

                          Carbon stored in the wood:                                             Name:                                       Structural Engineer/
                          104 metric tons of CO2                                                 The Long Hall                               Project Manager:
                                                                                                                                             DSB Engineering &
                                                                                                 Location:
                          Avoided greenhouse gas emissions:                                                                                  Consulting, P.C.
                                                                                                 Whitefish, MT
                          59 metric tons of CO2
                                                                                                                                             CLT Supplier/Installation:
                                                                                                 Owner/General
                                                                                                                                             Innovative Timber Systems, LLC
                          Total POTENTIAL carbon benefit:                                        Contractor:
                          163 metric tons of CO2                                                 The Long Hall LLC                           Completed:
                                                                                                                                             2011
                                                                                                 Designer:
                                                                                                 Datum Design Drafting
                    Equivalent to:
Source: US EPA




                                  31 cars off the road for a year


                                  Energy to operate a home for 14 years



 Estimated by the Wood Carbon Calculator for Buildings, based on research by Sarthre, R.
                                                                                                 1	 Experimental Analysis of Cross-laminated Timber Panels in Fire, Andrea
 and J. O’Connor, 2010, A Synthesis of Research on Wood Products and Greenhouse Gas              Frangi, Mario Fontana, Erich Hugi, Robert Jübstlin, Fire Safety Journal (2009)
 Impacts, FPInnovations. Note: CO2 on this chart refers to CO2 equivalent. Results from this
                                                                                                 Photos: (cover) Gravityshots.com, DSB Engineering & Consulting; (p.2) Gravi-
 tool are estimates only. Detailed life cycle assessments (LCA) are required to accurately       tyshots.com, Innovative Timber Systems; (p.3) Innovative Timber Systems, DSB
 determine a building’s carbon footprint.                                                        Engineering & Consulting; (p.4) FPInnovations, DSB Engineering & Consulting




                                                  BSLC
                      AMERICAN
                      WOOD
                      COUNCIL




                 WoodWorks is an initiative of the Wood Products Council, a cooperative venture of major North American wood associations.
                 WoodWorks Case Study WW-009 - The Long Hall, Whitefish, MT • © 2012 WoodWorks

More Related Content

What's hot

My New Resume
My New ResumeMy New Resume
My New ResumeTRADESUSA

Development Magazine Tustin Commons A Tired Asset Comes of Age
Development Magazine Tustin Commons A Tired Asset Comes of AgeDevelopment Magazine Tustin Commons A Tired Asset Comes of Age
Development Magazine Tustin Commons A Tired Asset Comes of Agelarryarmstrong

American Builders Quarterly Spring 2009
American Builders Quarterly   Spring 2009American Builders Quarterly   Spring 2009
American Builders Quarterly Spring 2009J. Hall Homes, Inc.

Shipping Container Architecture
Shipping Container Architecture Shipping Container Architecture
Shipping Container Architecture Nicholas Socrates

SIMON DESIGN ENGINEERING
SIMON DESIGN ENGINEERINGSIMON DESIGN ENGINEERING
SIMON DESIGN ENGINEERINGWilliam Wieners

Don Talend Below-Grade Parking Boosts Low-Rise Housing Design
Don Talend Below-Grade Parking Boosts Low-Rise Housing DesignDon Talend Below-Grade Parking Boosts Low-Rise Housing Design
Don Talend Below-Grade Parking Boosts Low-Rise Housing DesignDon Talend

Office Design
Office DesignOffice Design
Office Designbmburns

Blanc De Bierges C&W
Blanc De Bierges C&WBlanc De Bierges C&W
Blanc De Bierges C&Wruperio

LCI -SA Minutes 7th March
LCI -SA Minutes 7th MarchLCI -SA Minutes 7th March
LCI -SA Minutes 7th Marchdanmrrt

SCPE Portfolio
SCPE PortfolioSCPE Portfolio
SCPE Portfoliodocapri

Resume And Detailed Project History
Resume And Detailed Project HistoryResume And Detailed Project History
Resume And Detailed Project Historysgarrison1960

PDA Mission Statement
PDA Mission StatementPDA Mission Statement
PDA Mission StatementEDeLaPaz_PDA


What's hot (15)

My New Resume
My New ResumeMy New Resume
My New Resume

Multiplex bustles with hockey and more
Multiplex bustles with hockey and moreMultiplex bustles with hockey and more
Multiplex bustles with hockey and more

Development Magazine Tustin Commons A Tired Asset Comes of Age
Development Magazine Tustin Commons A Tired Asset Comes of AgeDevelopment Magazine Tustin Commons A Tired Asset Comes of Age
Development Magazine Tustin Commons A Tired Asset Comes of Age

American Builders Quarterly Spring 2009
American Builders Quarterly   Spring 2009American Builders Quarterly   Spring 2009
American Builders Quarterly Spring 2009

Mill roll company sees the light
Mill roll company sees the lightMill roll company sees the light
Mill roll company sees the light

Shipping Container Architecture
Shipping Container Architecture Shipping Container Architecture
Shipping Container Architecture

SIMON DESIGN ENGINEERING
SIMON DESIGN ENGINEERINGSIMON DESIGN ENGINEERING
SIMON DESIGN ENGINEERING

Woodlawn project in Ascent magazine
Woodlawn project in Ascent magazineWoodlawn project in Ascent magazine
Woodlawn project in Ascent magazine

Don Talend Below-Grade Parking Boosts Low-Rise Housing Design
Don Talend Below-Grade Parking Boosts Low-Rise Housing DesignDon Talend Below-Grade Parking Boosts Low-Rise Housing Design
Don Talend Below-Grade Parking Boosts Low-Rise Housing Design

Office Design
Office DesignOffice Design
Office Design

Blanc De Bierges C&W
Blanc De Bierges C&WBlanc De Bierges C&W
Blanc De Bierges C&W

LCI -SA Minutes 7th March
LCI -SA Minutes 7th MarchLCI -SA Minutes 7th March
LCI -SA Minutes 7th March

SCPE Portfolio
SCPE PortfolioSCPE Portfolio
SCPE Portfolio

Resume And Detailed Project History
Resume And Detailed Project HistoryResume And Detailed Project History
Resume And Detailed Project History

PDA Mission Statement
PDA Mission StatementPDA Mission Statement
PDA Mission Statement


Similar to Clt Milestone Montana

Case Study: Philadelphia Mail Processing and Distribution
Case Study: Philadelphia Mail Processing and DistributionCase Study: Philadelphia Mail Processing and Distribution
Case Study: Philadelphia Mail Processing and DistributionDyplast Products

Case Study: Philadelphia Mail Processing and Distribution
Case Study: Philadelphia Mail Processing and DistributionCase Study: Philadelphia Mail Processing and Distribution
Case Study: Philadelphia Mail Processing and DistributionJoe Hughes

North America’s evolution toward taller wood buildings - Nov-2014
North America’s evolution toward taller wood buildings - Nov-2014North America’s evolution toward taller wood buildings - Nov-2014
North America’s evolution toward taller wood buildings - Nov-2014Alessandro Rinaldi

2023-04-28_IFIA Mini Seminar.pdf
2023-04-28_IFIA Mini Seminar.pdf2023-04-28_IFIA Mini Seminar.pdf
2023-04-28_IFIA Mini Seminar.pdfNorthwestBOCA

First Commercial CLT Project in the USA
First Commercial CLT Project in the USAFirst Commercial CLT Project in the USA
First Commercial CLT Project in the USADarryl Byle

Designing for Sustainability: Altair's Customer Story
Designing for Sustainability: Altair's Customer StoryDesigning for Sustainability: Altair's Customer Story
Designing for Sustainability: Altair's Customer StoryAltair

Modern Building Codes: Keeping Pace with the Wood Revolution
Modern Building Codes: Keeping Pace with the Wood RevolutionModern Building Codes: Keeping Pace with the Wood Revolution
Modern Building Codes: Keeping Pace with the Wood RevolutionThink Wood

TWIN WALL CONSTRUCTION.pptx
TWIN WALL CONSTRUCTION.pptxTWIN WALL CONSTRUCTION.pptx
TWIN WALL CONSTRUCTION.pptxSomeshMathad

prefabrication structure report
prefabrication structure report prefabrication structure report
prefabrication structure report AbhishekM45

Jack Cole TSP Industrial Placement Timeline Aug15
Jack Cole TSP Industrial Placement Timeline Aug15Jack Cole TSP Industrial Placement Timeline Aug15
Jack Cole TSP Industrial Placement Timeline Aug15Jack Cole

Bubble deck & hollow core slab
Bubble deck & hollow core slabBubble deck & hollow core slab
Bubble deck & hollow core slabErik Ong

Bubble deck&hollow core slab
Bubble deck&hollow core slabBubble deck&hollow core slab
Bubble deck&hollow core slabPenny3688

Civil Project structural engineering.pptx
Civil Project structural engineering.pptxCivil Project structural engineering.pptx
Civil Project structural engineering.pptxssuserbdc52c

One Museum Park West (Post-Tensioning case study)
One Museum Park West (Post-Tensioning case study)One Museum Park West (Post-Tensioning case study)
One Museum Park West (Post-Tensioning case study)AMSYSCO Inc.

Aluminium Formwork Vs Conventional Formwork
Aluminium Formwork Vs  Conventional  FormworkAluminium Formwork Vs  Conventional  Formwork
Aluminium Formwork Vs Conventional Formworkchaitanyakrsk

Post tensioning in building structures
Post tensioning in building structuresPost tensioning in building structures
Post tensioning in building structuresLuan Truong Van

Performance of ibs precast concrete beam column connections under earthquake ...
Performance of ibs precast concrete beam column connections under earthquake ...Performance of ibs precast concrete beam column connections under earthquake ...
Performance of ibs precast concrete beam column connections under earthquake ...Ramin Vaghei

Design Appraisal report
Design Appraisal reportDesign Appraisal report
Design Appraisal reportConor Meaney


Similar to Clt Milestone Montana (20)

Case Study: Philadelphia Mail Processing and Distribution
Case Study: Philadelphia Mail Processing and DistributionCase Study: Philadelphia Mail Processing and Distribution
Case Study: Philadelphia Mail Processing and Distribution

Case Study: Philadelphia Mail Processing and Distribution
Case Study: Philadelphia Mail Processing and DistributionCase Study: Philadelphia Mail Processing and Distribution
Case Study: Philadelphia Mail Processing and Distribution

North America’s evolution toward taller wood buildings - Nov-2014
North America’s evolution toward taller wood buildings - Nov-2014North America’s evolution toward taller wood buildings - Nov-2014
North America’s evolution toward taller wood buildings - Nov-2014

2023-04-28_IFIA Mini Seminar.pdf
2023-04-28_IFIA Mini Seminar.pdf2023-04-28_IFIA Mini Seminar.pdf
2023-04-28_IFIA Mini Seminar.pdf

First Commercial CLT Project in the USA
First Commercial CLT Project in the USAFirst Commercial CLT Project in the USA
First Commercial CLT Project in the USA

Designing for Sustainability: Altair's Customer Story
Designing for Sustainability: Altair's Customer StoryDesigning for Sustainability: Altair's Customer Story
Designing for Sustainability: Altair's Customer Story

Modern Building Codes: Keeping Pace with the Wood Revolution
Modern Building Codes: Keeping Pace with the Wood RevolutionModern Building Codes: Keeping Pace with the Wood Revolution
Modern Building Codes: Keeping Pace with the Wood Revolution

TWIN WALL CONSTRUCTION.pptx
TWIN WALL CONSTRUCTION.pptxTWIN WALL CONSTRUCTION.pptx
TWIN WALL CONSTRUCTION.pptx

prefabrication structure report
prefabrication structure report prefabrication structure report
prefabrication structure report

Session 12 ic2011 faller-unger
Session 12 ic2011 faller-ungerSession 12 ic2011 faller-unger
Session 12 ic2011 faller-unger

Jack Cole TSP Industrial Placement Timeline Aug15
Jack Cole TSP Industrial Placement Timeline Aug15Jack Cole TSP Industrial Placement Timeline Aug15
Jack Cole TSP Industrial Placement Timeline Aug15

Bubble deck & hollow core slab
Bubble deck & hollow core slabBubble deck & hollow core slab
Bubble deck & hollow core slab

Bubble deck&hollow core slab
Bubble deck&hollow core slabBubble deck&hollow core slab
Bubble deck&hollow core slab

Civil Project structural engineering.pptx
Civil Project structural engineering.pptxCivil Project structural engineering.pptx
Civil Project structural engineering.pptx

One Museum Park West (Post-Tensioning case study)
One Museum Park West (Post-Tensioning case study)One Museum Park West (Post-Tensioning case study)
One Museum Park West (Post-Tensioning case study)

Special-concretes
Special-concretesSpecial-concretes
Special-concretes

Aluminium Formwork Vs Conventional Formwork
Aluminium Formwork Vs  Conventional  FormworkAluminium Formwork Vs  Conventional  Formwork
Aluminium Formwork Vs Conventional Formwork

Post tensioning in building structures
Post tensioning in building structuresPost tensioning in building structures
Post tensioning in building structures

Performance of ibs precast concrete beam column connections under earthquake ...
Performance of ibs precast concrete beam column connections under earthquake ...Performance of ibs precast concrete beam column connections under earthquake ...
Performance of ibs precast concrete beam column connections under earthquake ...

Design Appraisal report
Design Appraisal reportDesign Appraisal report
Design Appraisal report


More from datumdraftingdesign (6)

Promo Tortomasi
Promo TortomasiPromo Tortomasi
Promo Tortomasi

Promo Shapero
Promo ShaperoPromo Shapero
Promo Shapero

Promo Ashley Schiess
Promo Ashley SchiessPromo Ashley Schiess
Promo Ashley Schiess

Promo Resume
Promo ResumePromo Resume
Promo Resume

Promo Tierney
Promo TierneyPromo Tierney
Promo Tierney

Promo Vanterpool
Promo VanterpoolPromo Vanterpool
Promo Vanterpool


Clt Milestone Montana

  • 1. WoodWorks CaseStudy CLT Milestone in Montana Cross Laminated Timber Makes its Mark with The Long Hall It happened so quickly that most design and construction professionals probably missed it. But when the first commercial building project in the U.S. constructed with cross laminated timber (CLT) was completed in 2011, it opened the door to new opportunities for the entire building industry. The Long Hall in Whitefish, Montana epitomizes many of the benefits of CLT construction—speed of installation, environmental and aesthetic benefits of wood, and energy efficiency. The two-story wood structure took just five days to erect, and gave the owner a sustainable, energy-efficient building. Earn one AIA/CES CEH (HSW) by reading this document and taking a short online quiz. For details and learning objectives, visit the Online Training Library at woodworks.org. WoodWorks is an approved AIA provider. woodworks.org

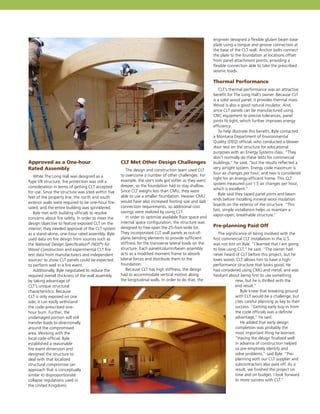

  • 2. Converting from CMU The Long Hall is a mixed-use, urban infill project designed to replace an unsightly 60-year-old Quonset hut in downtown Whitefish, Montana. The new 4,863-square- foot structure provides business and retail space on the first floor, and the second floor is occupied by a martial arts studio. Originally designed with concrete masonry units (CMU), the building designer, Datum Design Drafting, worked with Innovative Timber Systems (ITS) and Darryl Byle, PE, of DSB Engineering & Consulting to convert the structure to CLT. “Together, we convinced the client that CLT would be a cost-effective alternative to CMU while delivering a high- performance building, more sustainably and with a better design aesthetic,” said Byle. “The client had no particular affinity for concrete and also had time constraints. We were confident that CLT would provide the perfect solution.” Byle said the top three benefits of using CLT for The Long Hall were speed, aesthetics and thermal performance. “With CLT, the entire two-story structure took just five days to install. We went from slab to occupancy in three months. And the owner loves the interior arts studio through the fall,” he explained. “By and shipped directly from the manufacturer feel and renewability of the resource. He raising the building structure in just five days, he to the job site, where they can be quickly also wanted a high-performing structure; the was able to open the studio for the fall season.” and efficiently lifted into place. “By modeling energy efficiency of the CLT system made this the entire structure in 3-D and meeting with a good choice.” Planning Ahead vendors and subcontractors well in advance, The resulting Type VB structure was built we defined the design challenges and resolved to 2009 International Building Code (IBC) Because local code officials and issues dynamically,” said Byle. requirements. The building consists of 38 glulam subcontractors were not familiar with CLT, beams along with 13,000 square feet of CLT Byle said it was critical to plan ahead. “I worked as a building official myself, Pre-assembled Walls for the walls, second floor, roof, clerestory, partitions and arches. so I understood their concerns about being Because of shipping constraints from Europe, first to use a new product,” he said. “That’s CLT panel size was limited to 7 feet 4 inches Cost Competitive why I began talking with our local building in width and 39 feet in length, said Byle. “This department more than six months in advance; meant the wall panels could not stack full- Overall cost of the entire project was to make sure they were comfortable with it. story height as is often the case with other approximately $145 per square foot, $60 of The project became a real team effort; we all pre-manufactured CLT wall assemblies. After which was attributable to the installed cost of wanted to do this right so the building officials reviewing the pros and cons of vertical versus the CLT and glulam. were there asking questions and educating horizontal stacking, we determined that it Because CLT had not been used for a themselves but also keeping an eye out for us.” would be more effective to assemble the walls commercial building in the U.S., one of the first Preplanning was also critical because CLT as vertical elements in a standard platform things Byle and his team verified was its cost for The Long Hall was sourced from Europe framing configuration.” competitiveness. Pete McCrone, a Quantity (although there are now several North American The Long Hall had less than 30 inches of Surveyor with ITS, compared CMU and CLT suppliers). CLT panels are manufactured for spacing between it and adjacent buildings. across approximately 30 project elements. The specific applications, so are prefabricated Because this left virtually no room for on-site analysis favored CLT, in construction, contractors pre-assembled the part because the exposed main vertical CLT walls in four- and five-panel wood structural shell could elements at a nearby site. They glued and serve both as interior wall screwed the splines and then transported the and ceiling finish. The pre-assembled wall panels to the job site (the CLT system also required largest were 30 x 11 feet) using an A-frame on a less time on site for low-boy trailer. erection, which reduced By pre-assembling the vertical panels construction costs. and lifting them into place via crane, the Initial estimates put the contractor minimized on-site installation time. cost difference between Panels arrived from the manufacturer with CLT and CMU close to pre-slung lift webbing, which also helped even, but Byle said time construction move quickly and efficiently. The value of the finished CLT manufacturer used CNC equipment to building tipped the scales precisely pre-cut beam pockets and openings in favor of CLT. “Originally, for windows and doors at the factory. the owner was going to have to close his martial

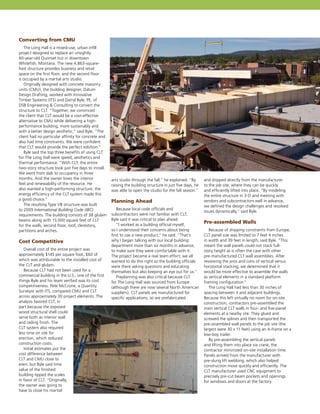

  • 3. engineer designed a flexible glulam beam base plate using a tongue and groove connection at the base of the CLT wall. Anchor bolts connect the plate to the foundation at locations offset from panel attachment points, providing a flexible connection able to take the prescribed seismic loads. Thermal Performance CLT’s thermal performance was an attractive benefit for The Long Hall’s owner. Because CLT is a solid wood panel, it provides thermal mass. Wood is also a good natural insulator. And, since CLT panels can be manufactured using CNC equipment to precise tolerances, panel joints fit tight, which further improves energy efficiency. To help illustrate this benefit, Byle contacted a Montana Department of Environmental Quality (DEQ) official, who conducted a blower door test on the structure for educational purposes with an Energy Systems class. “They don’t normally do these tests for commercial Approved as a One-hour CLT Met Other Design Challenges buildings,” he said, “but the results reflected a Rated Assembly The design and construction team used CLT very airtight system. Energy code maximum is four air changes per hour, and two is considered While The Long Hall was designed as a to overcome a number of other challenges. For tight for an energy-efficient home. This CLT Type VB structure, fire protection was still a example, the site’s soils got softer as they went system measured just 1.5 air changes per hour, consideration in terms of getting CLT accepted deeper, so the foundation had to stay shallow. which is excellent.” for use. Since the structure was sited within five Since CLT weighs less than CMU, they were Byle said they taped panel joints and beam feet of the property line, the north and south able to use a smaller foundation. Heavier CMU ends before installing mineral wool insulation exterior walls were required to be one-hour fire- would have also increased footing size and slab boards on the exterior of the structure. “This rated, and the entire building was sprinklered. connection requirements, so additional cost fast, simple installation helps us maintain a Byle met with building officials to resolve savings were realized by using CLT. vapor-open, breathable structure.” concerns about fire safety. In order to meet the In order to optimize available floor space and design objective to feature exposed CLT on the internal space configuration, the structure was designed to free-span the 25-foot-wide lot. Pre-planning Paid Off interior, they needed approval of the CLT system as a stand-alone, one-hour rated assembly. Byle They incorporated CLT wall panels as out-of- The significance of being involved with the used data on fire design from sources such as plane bending elements to provide sufficient first commercial CLT installation in the U.S. the National Design Specification® (NDS®) for stiffness for the transverse lateral loads on the was not lost on Byle. “I learned that I am going Wood Construction and experimental CLT fire structure. Each panel/column/beam assembly to love using CLT,” he said. “The owner had test data from manufacturers and independent acts as a modified moment frame to absorb never heard of CLT before this project, but he sources1 to show CLT panels could be expected lateral forces and distribute them to the loves wood; CLT allows him to have a high- to perform well in a fire event. foundation. performance structure that looks good. He Additionally, Byle negotiated to reduce the Because CLT has high stiffness, the design had considered using CMU and metal, and was required overall thickness of the wall assembly had to accommodate vertical motion along hesitant about being first to use something by taking advantage of the longitudinal walls. In order to do that, the new, but he is thrilled with the CLT’s unique structural end result.” characteristics. Because Byle knew that breaking ground CLT is only exposed on one with CLT would be a challenge, but side, it can easily withstand cites careful planning as key to their the code-prescribed one- success. “Getting early buy-in from hour burn. Further, the the code officials was a definite undamaged portion will still advantage,” he said. transfer loads bi-directionally He added that early design around the compromised completion was probably the area. Working with the most important thing he learned. local code official, Byle “Having the design finalized well established a reasonable in advance of construction helped fire event dimension and us pre-emptively identify and designed the structure to solve problems,” said Byle. “Pre- deal with that localized planning with our CLT supplier and structural compromise (an subcontractors also paid off. As a approach that is conceptually result, we finished the project on similar to disproportionate time and on budget. I look forward collapse regulations used in to more success with CLT.” the United Kingdom).
  • 4. What is CLT? Developed and used in Europe since the 1990s, CLT is an engineered wood panel typically consisting of three, five or seven layers of dimensional lumber. Kiln-dried boards are layered perpendicular to one another and then glued. This cross lamination provides dimensional strength, stability and rigidity. CLT offers a lighter environmental footprint than concrete or steel as well as numerous other benefits, including quicker installation, less on-site waste, lighter weight, improved thermal performance and energy efficiency, and design versatility. Carbon Benefits Project Overview Wood lowers a building’s carbon footprint in two ways. It continues to store carbon absorbed during the tree’s growing cycle, keeping it out of the atmosphere for the lifetime of the building—longer if the wood is reclaimed and used elsewhere. (Like other wood products, CLT lends itself to recycling and re-use.) When used in place of fossil fuel-intensive materials such as steel and concrete, it also results in ‘avoided’ greenhouse gas emissions. Volume of wood products used: 148 cubic meters/5,227 cubic feet of CLT and glulam U.S. and Canadian forests grow this much wood in: 26 seconds Carbon stored in the wood: Name: Structural Engineer/ 104 metric tons of CO2 The Long Hall Project Manager: DSB Engineering & Location: Avoided greenhouse gas emissions: Consulting, P.C. Whitefish, MT 59 metric tons of CO2 CLT Supplier/Installation: Owner/General Innovative Timber Systems, LLC Total POTENTIAL carbon benefit: Contractor: 163 metric tons of CO2 The Long Hall LLC Completed: 2011 Designer: Datum Design Drafting Equivalent to: Source: US EPA 31 cars off the road for a year Energy to operate a home for 14 years Estimated by the Wood Carbon Calculator for Buildings, based on research by Sarthre, R. 1 Experimental Analysis of Cross-laminated Timber Panels in Fire, Andrea and J. O’Connor, 2010, A Synthesis of Research on Wood Products and Greenhouse Gas Frangi, Mario Fontana, Erich Hugi, Robert Jübstlin, Fire Safety Journal (2009) Impacts, FPInnovations. Note: CO2 on this chart refers to CO2 equivalent. Results from this Photos: (cover) Gravityshots.com, DSB Engineering & Consulting; (p.2) Gravi- tool are estimates only. Detailed life cycle assessments (LCA) are required to accurately tyshots.com, Innovative Timber Systems; (p.3) Innovative Timber Systems, DSB determine a building’s carbon footprint. Engineering & Consulting; (p.4) FPInnovations, DSB Engineering & Consulting BSLC AMERICAN WOOD COUNCIL WoodWorks is an initiative of the Wood Products Council, a cooperative venture of major North American wood associations. WoodWorks Case Study WW-009 - The Long Hall, Whitefish, MT • © 2012 WoodWorks
