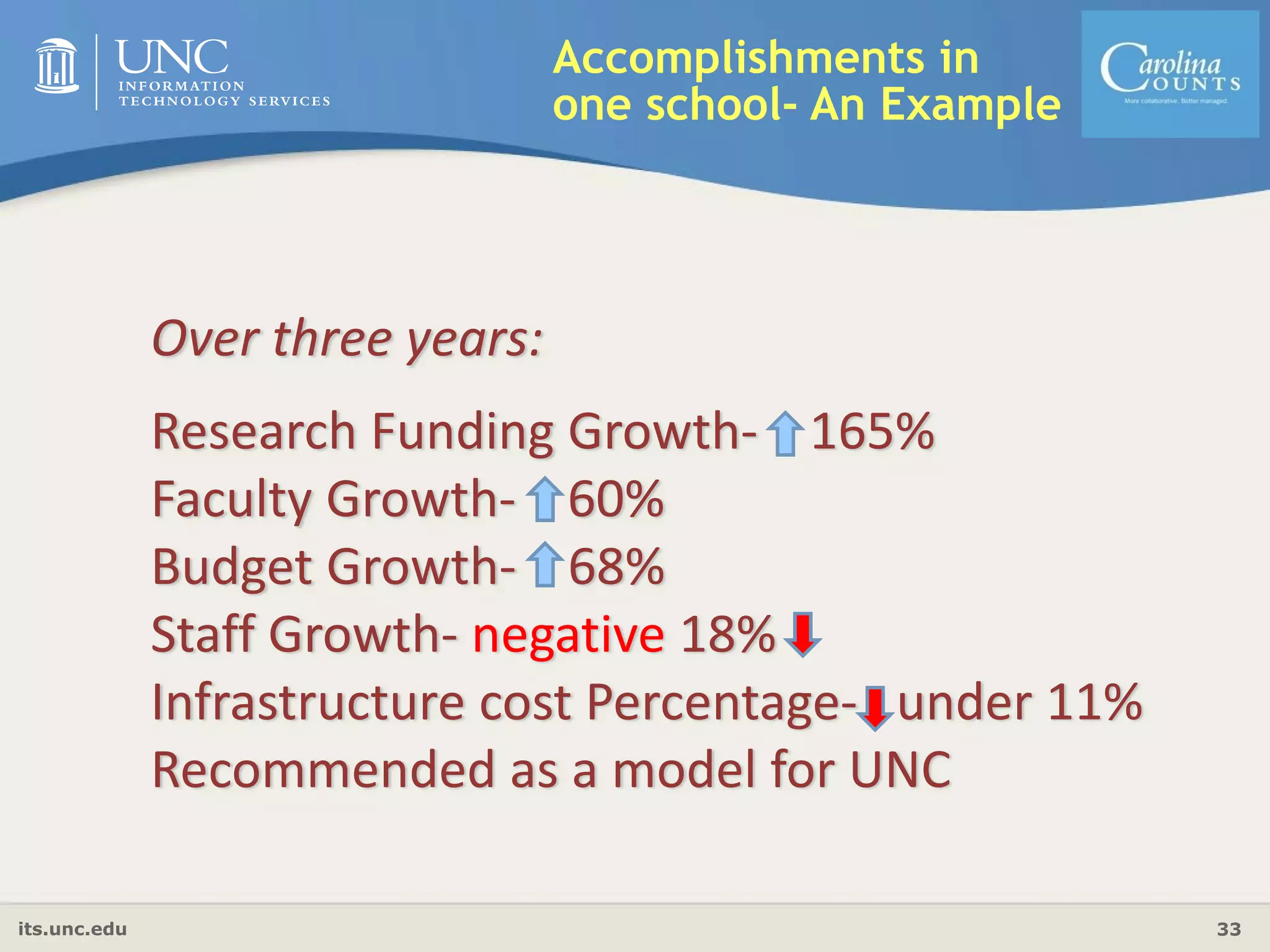

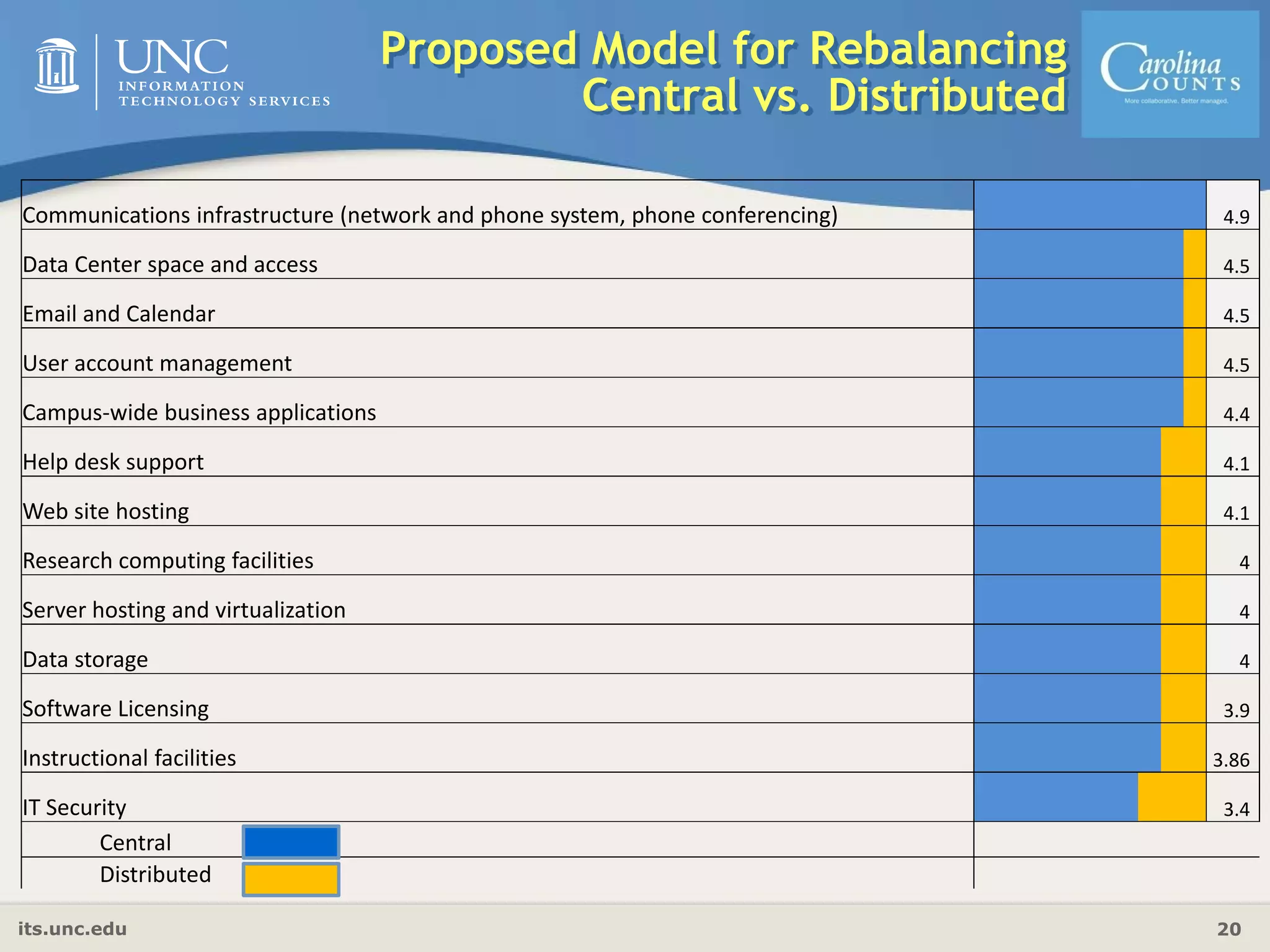

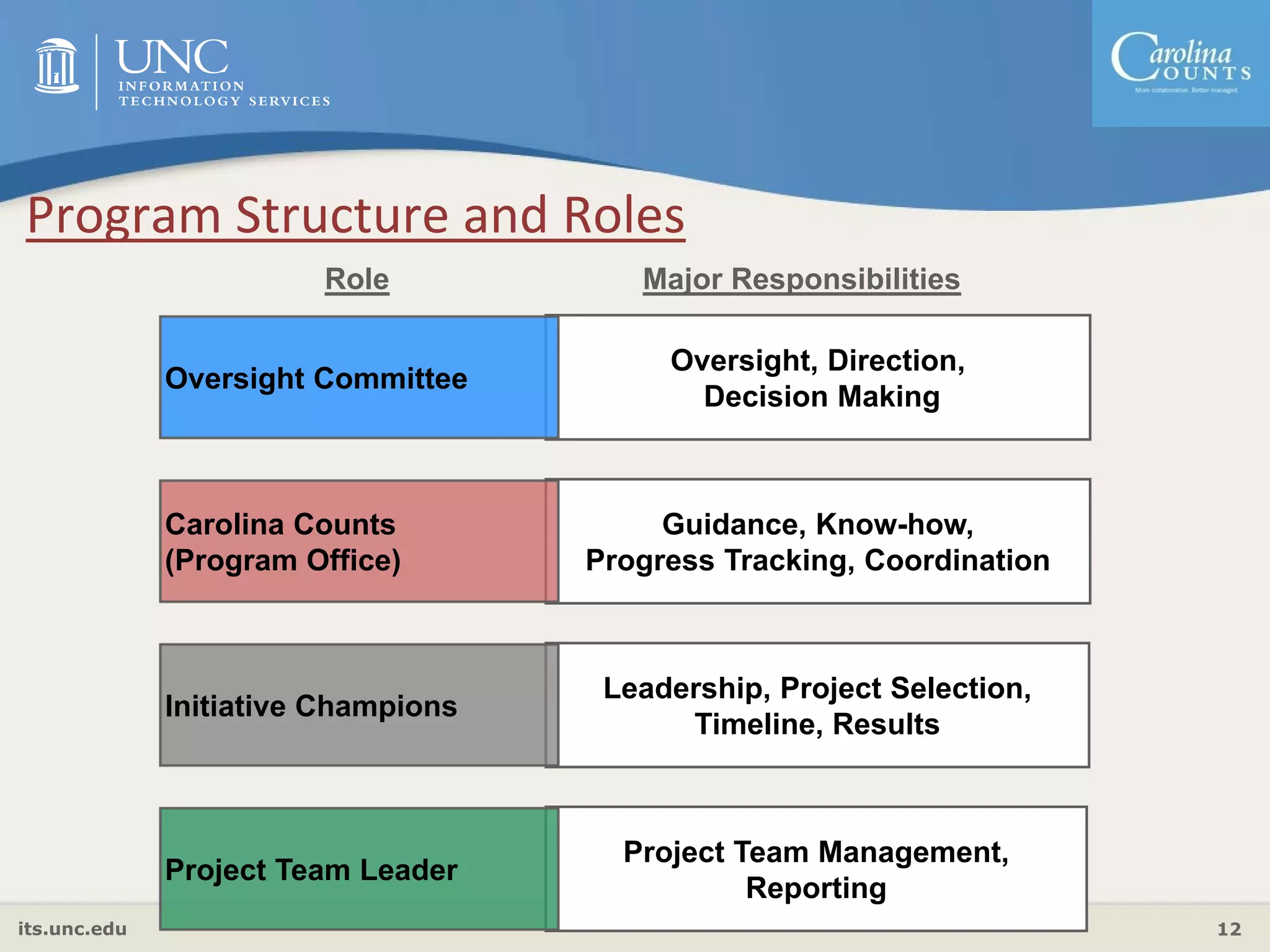

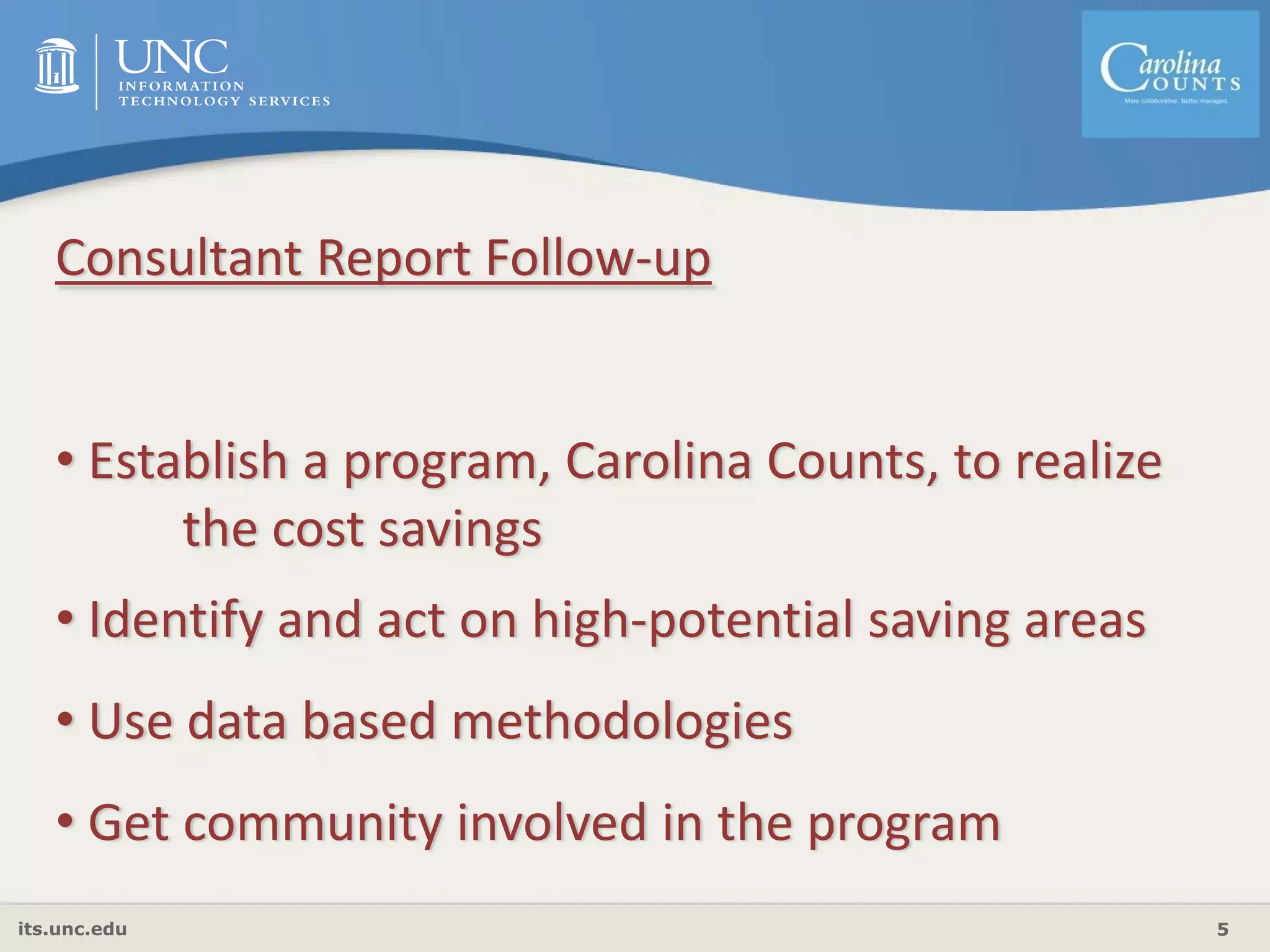

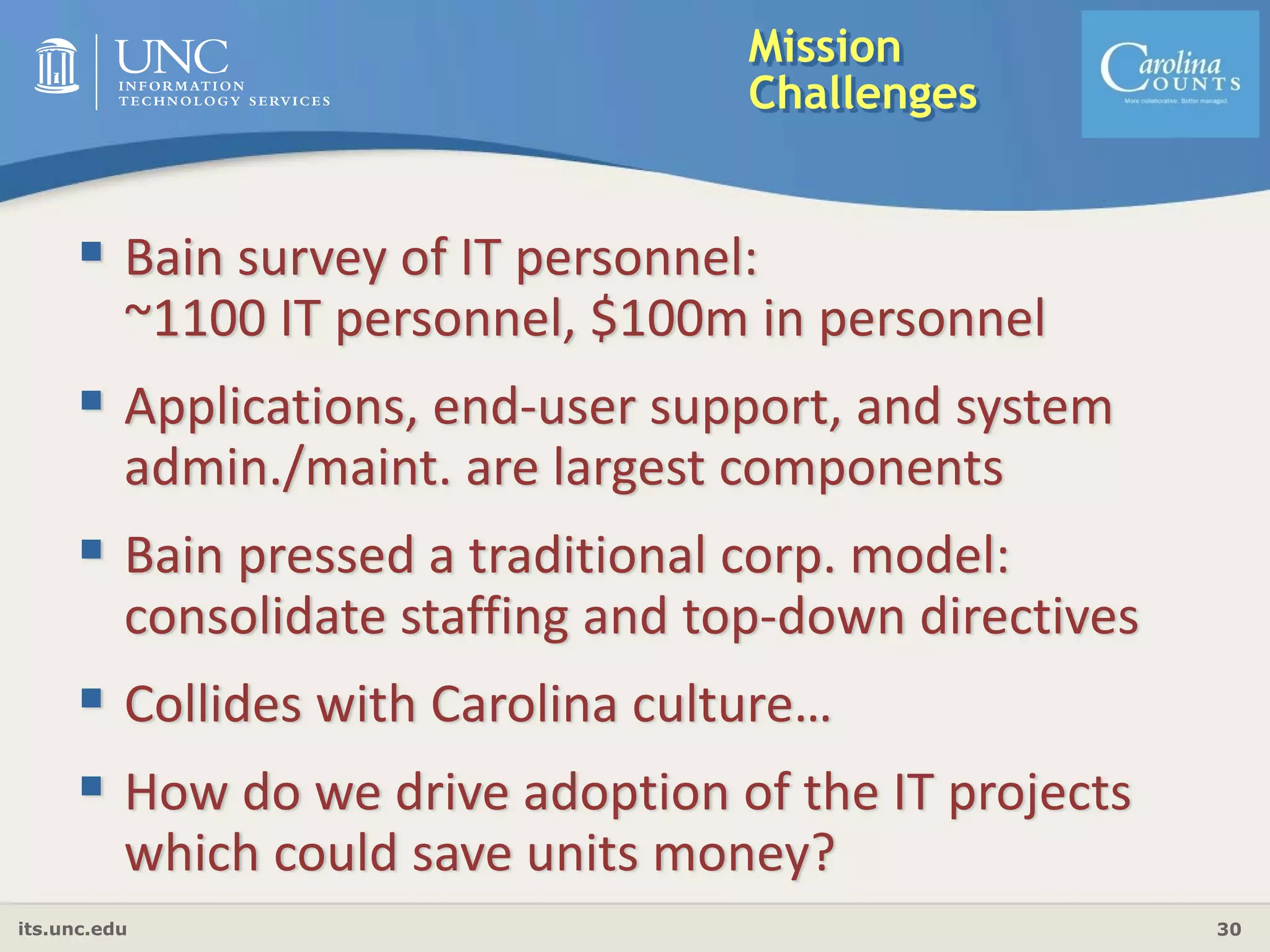

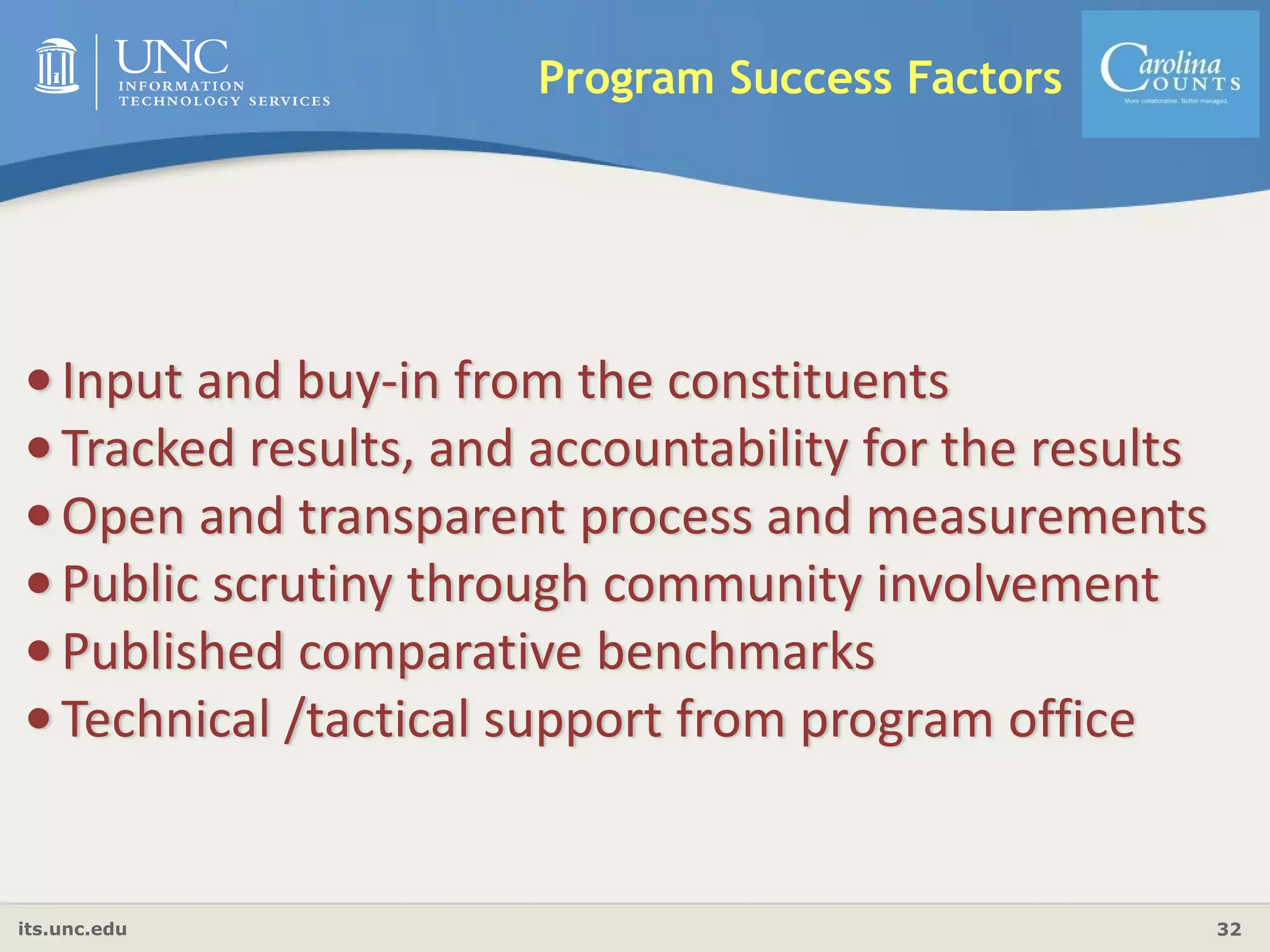

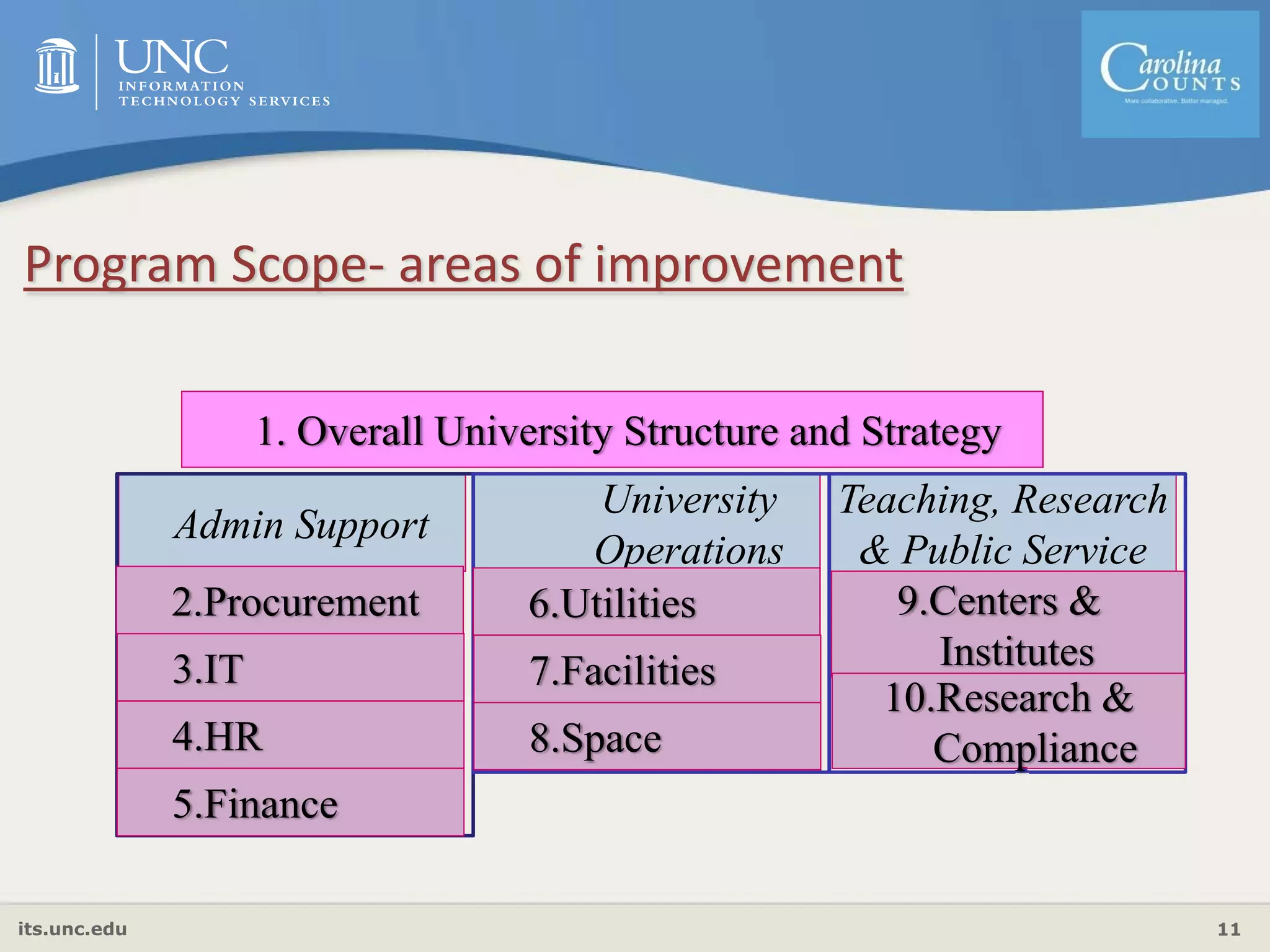

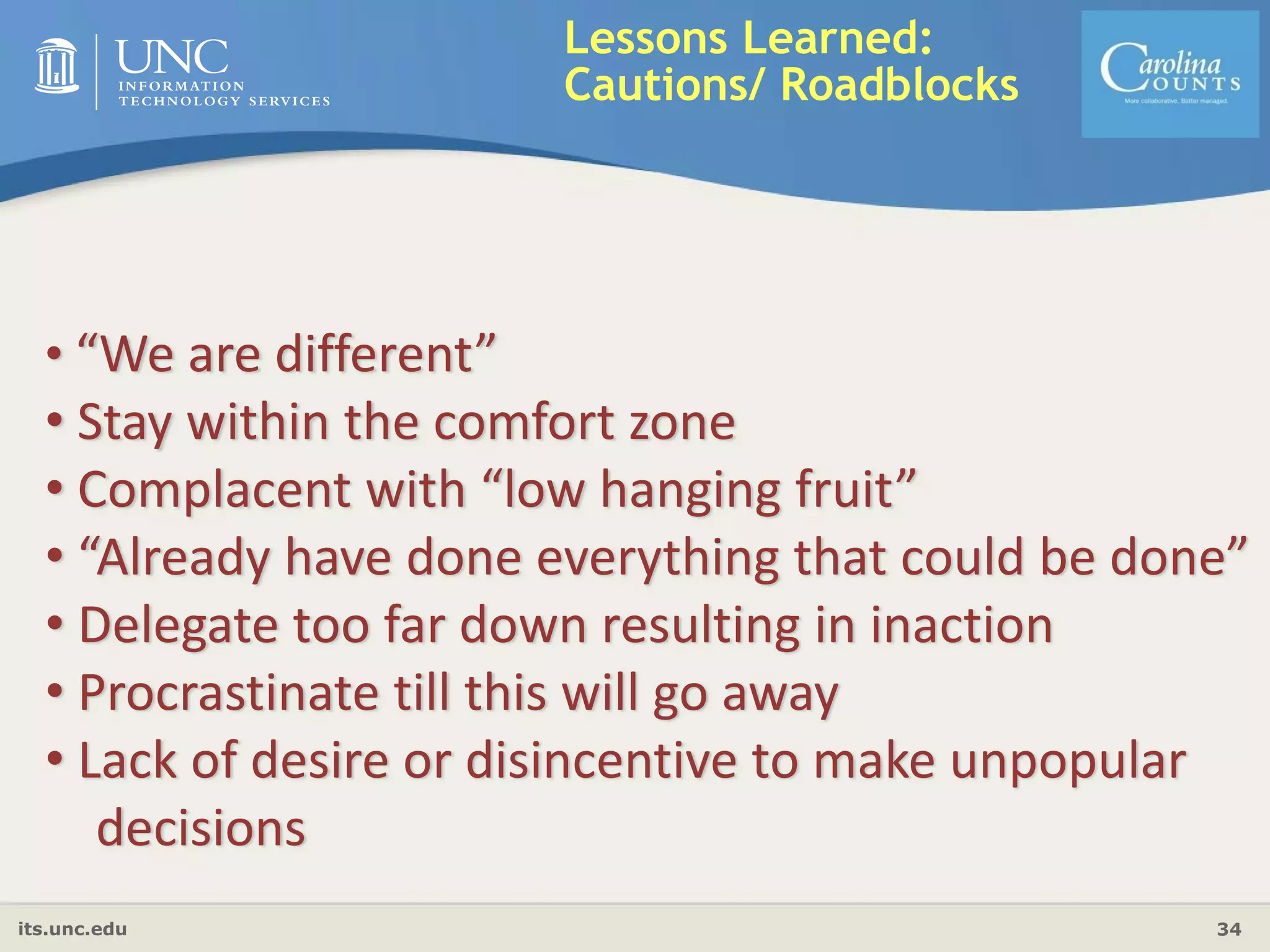

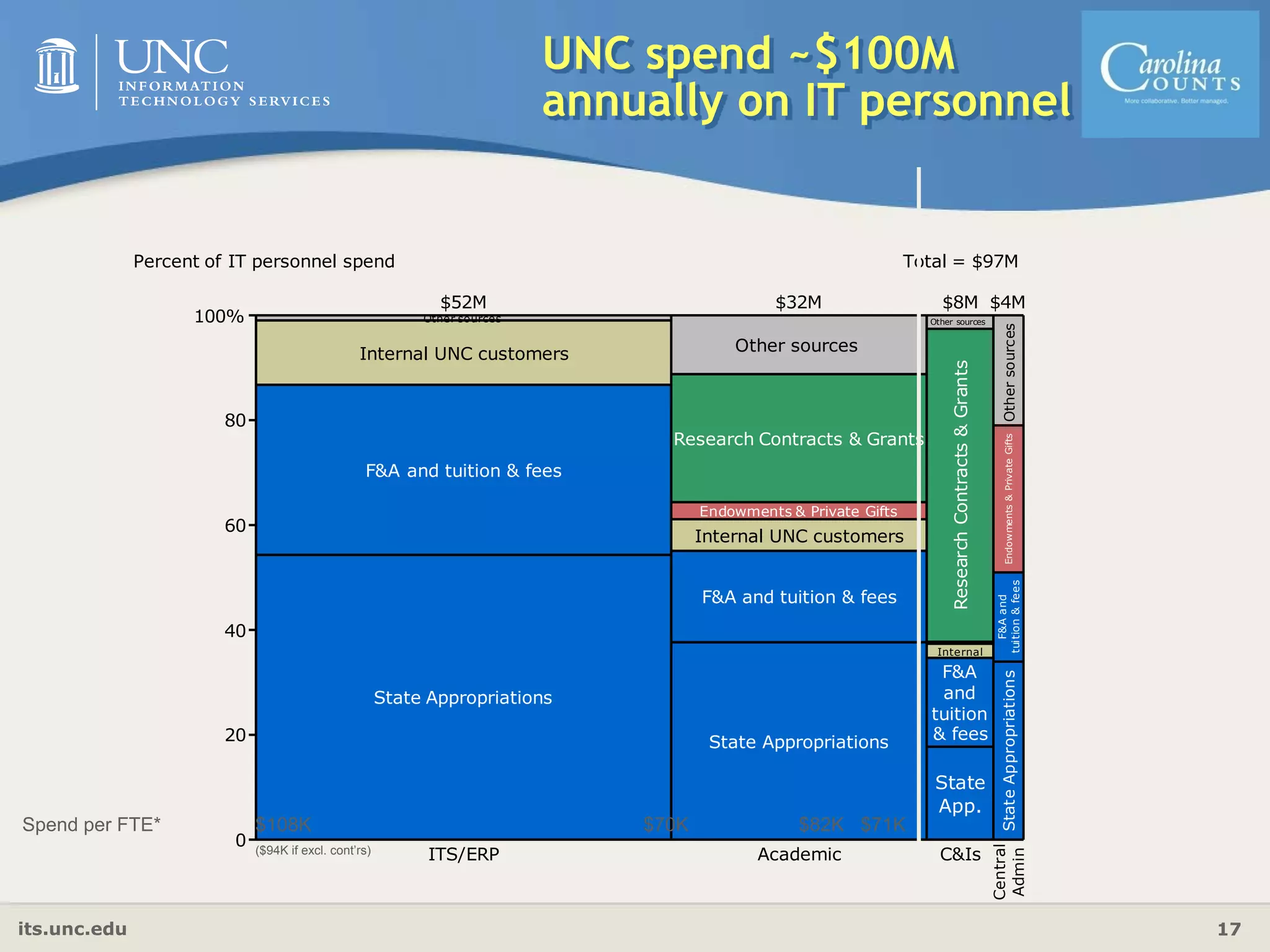

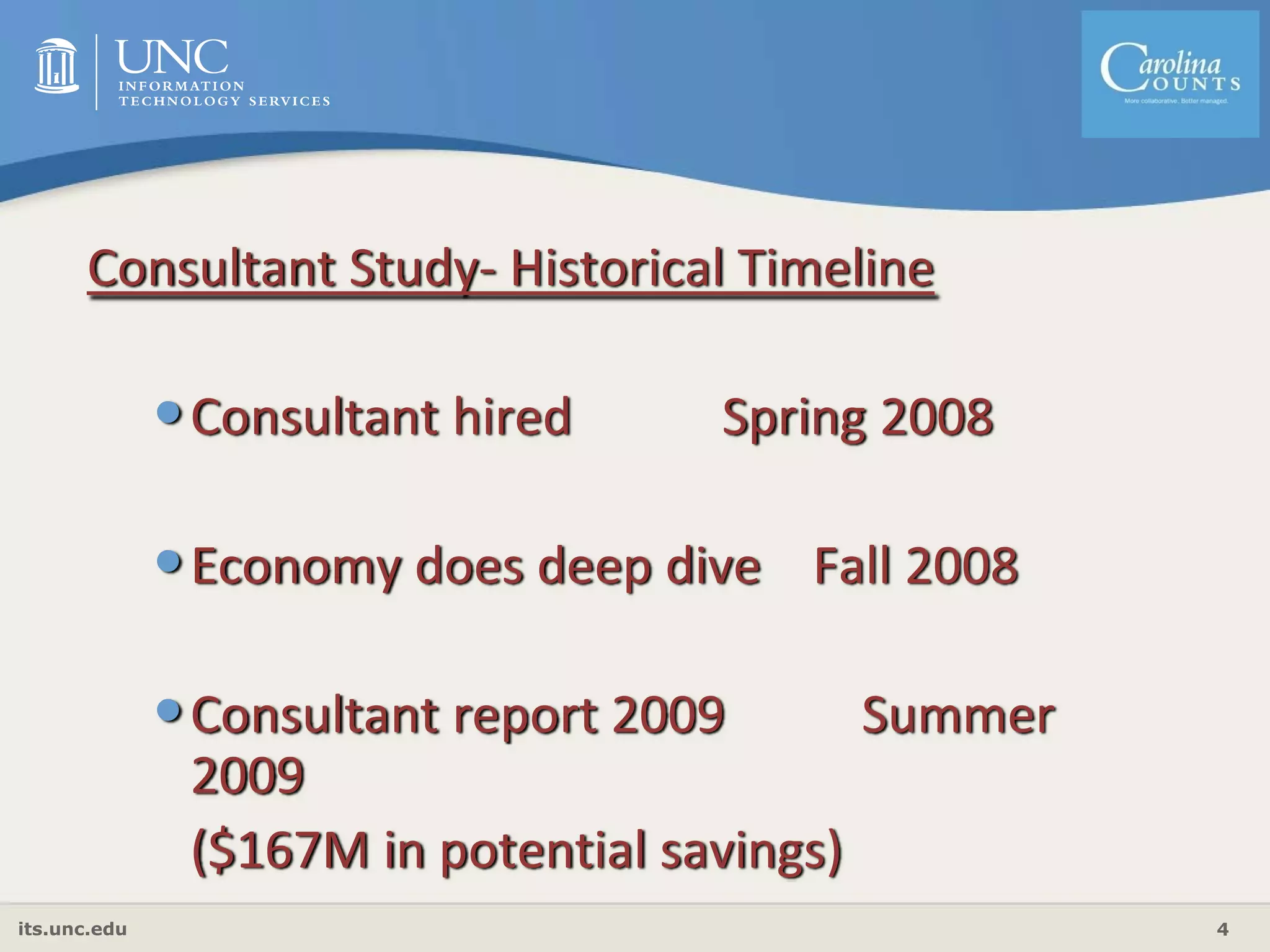

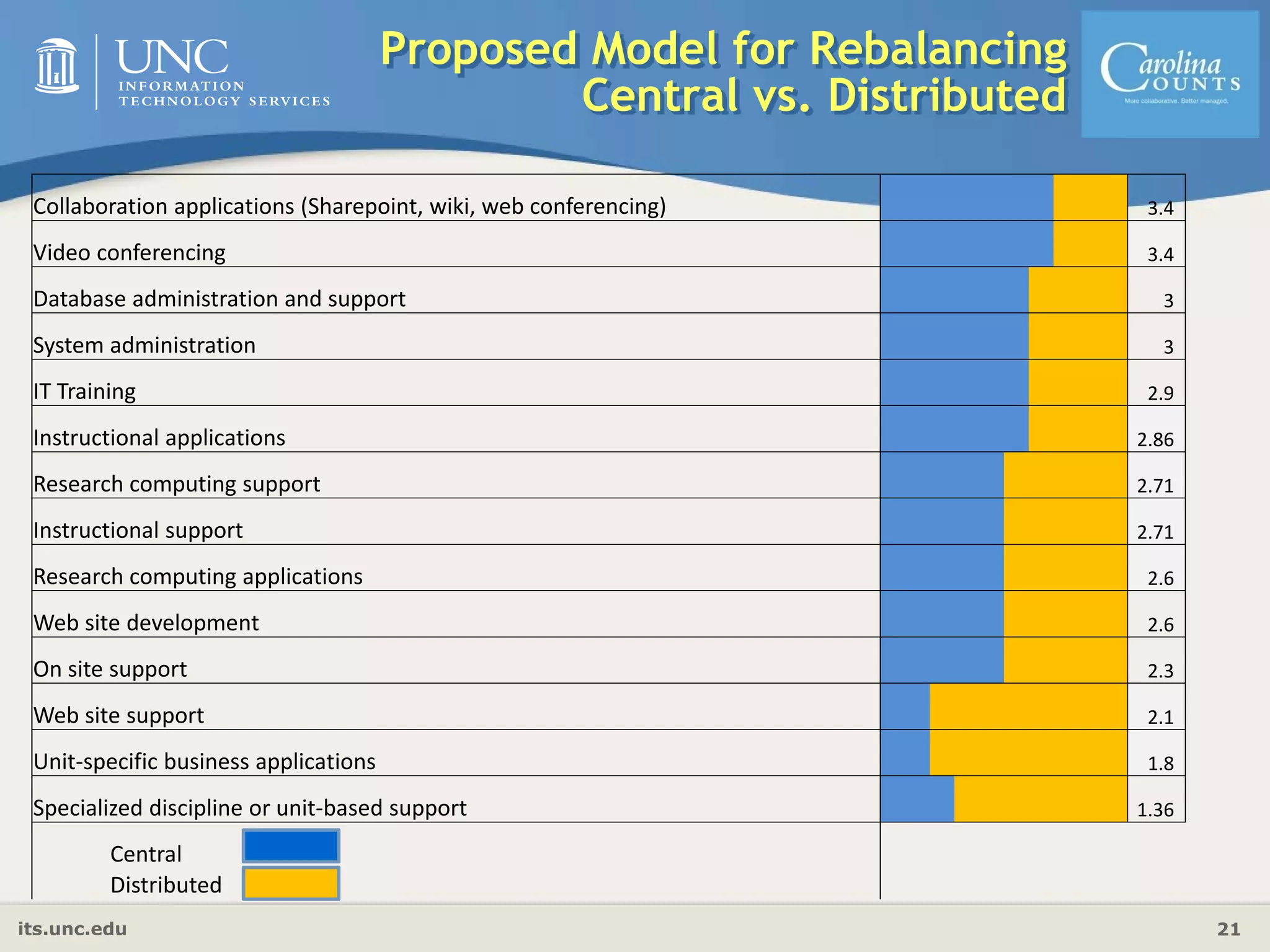

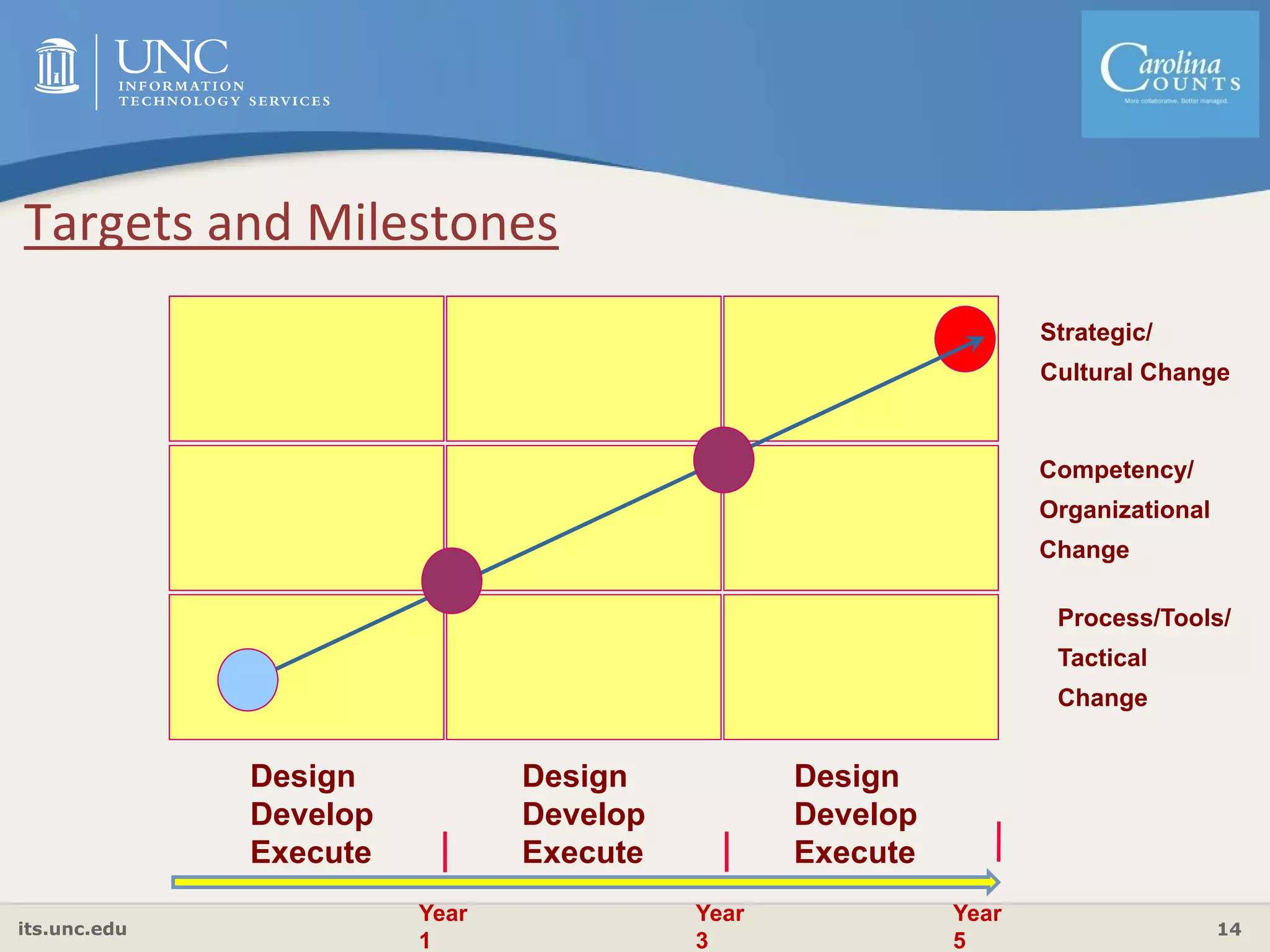

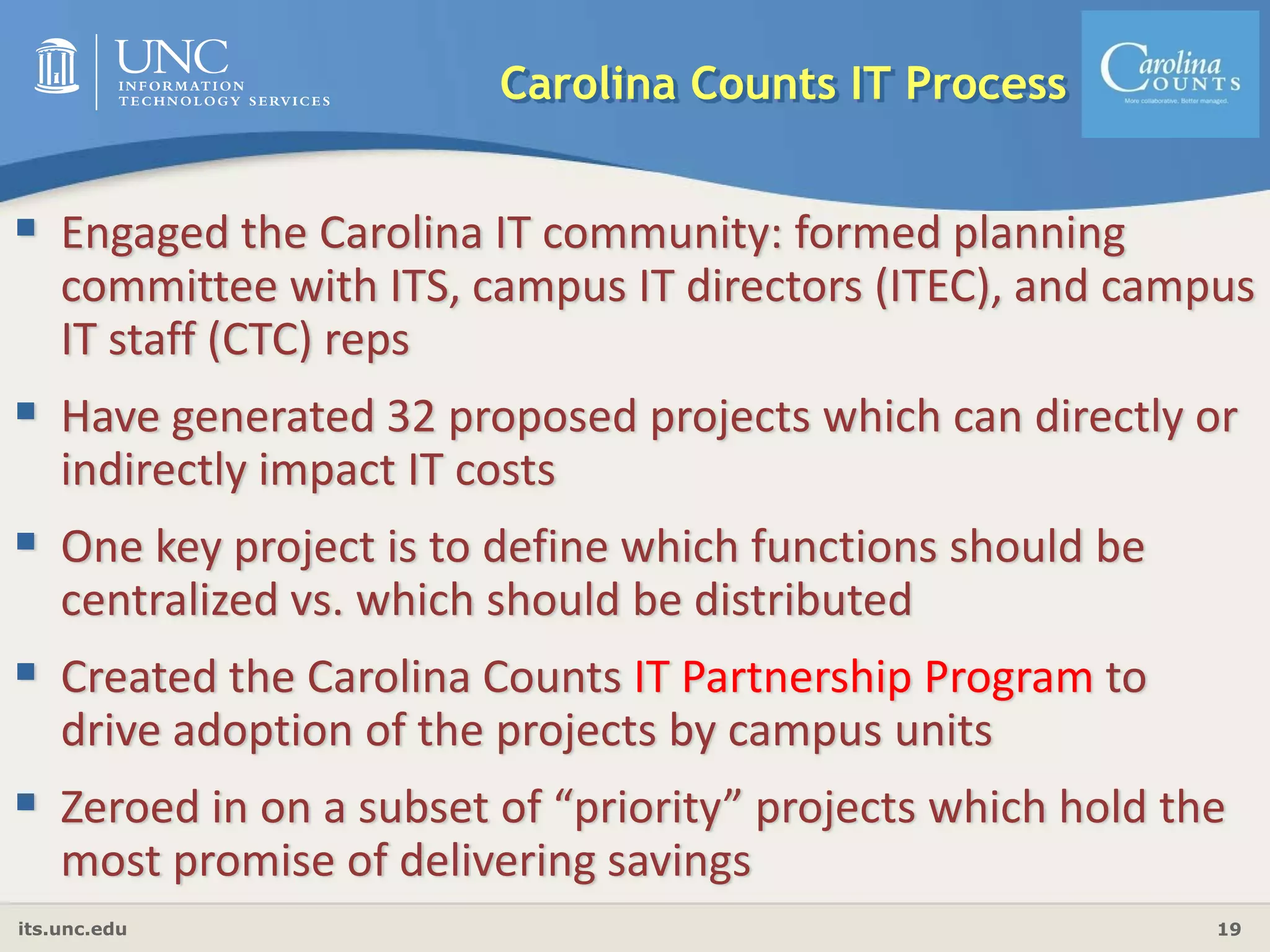

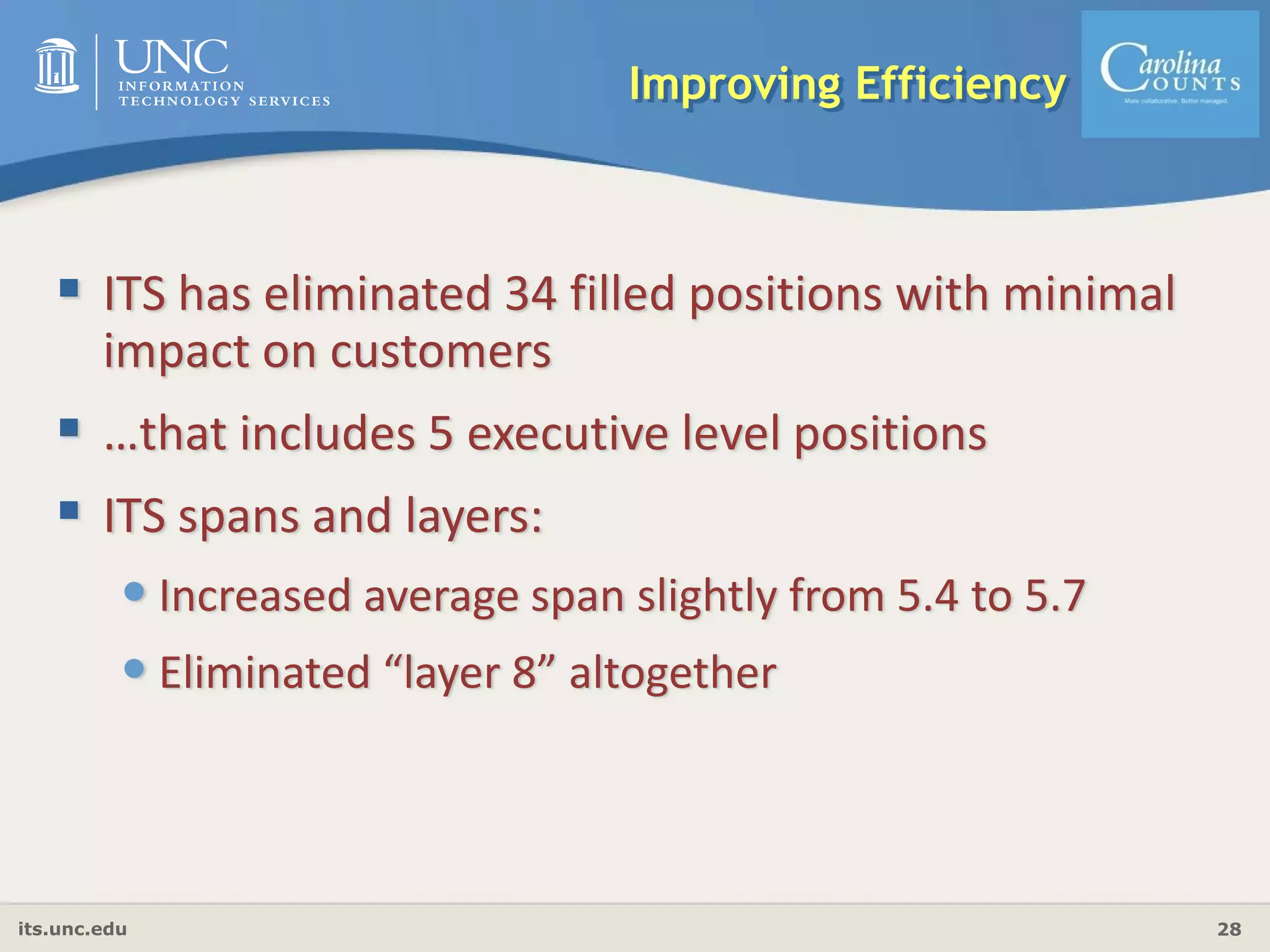

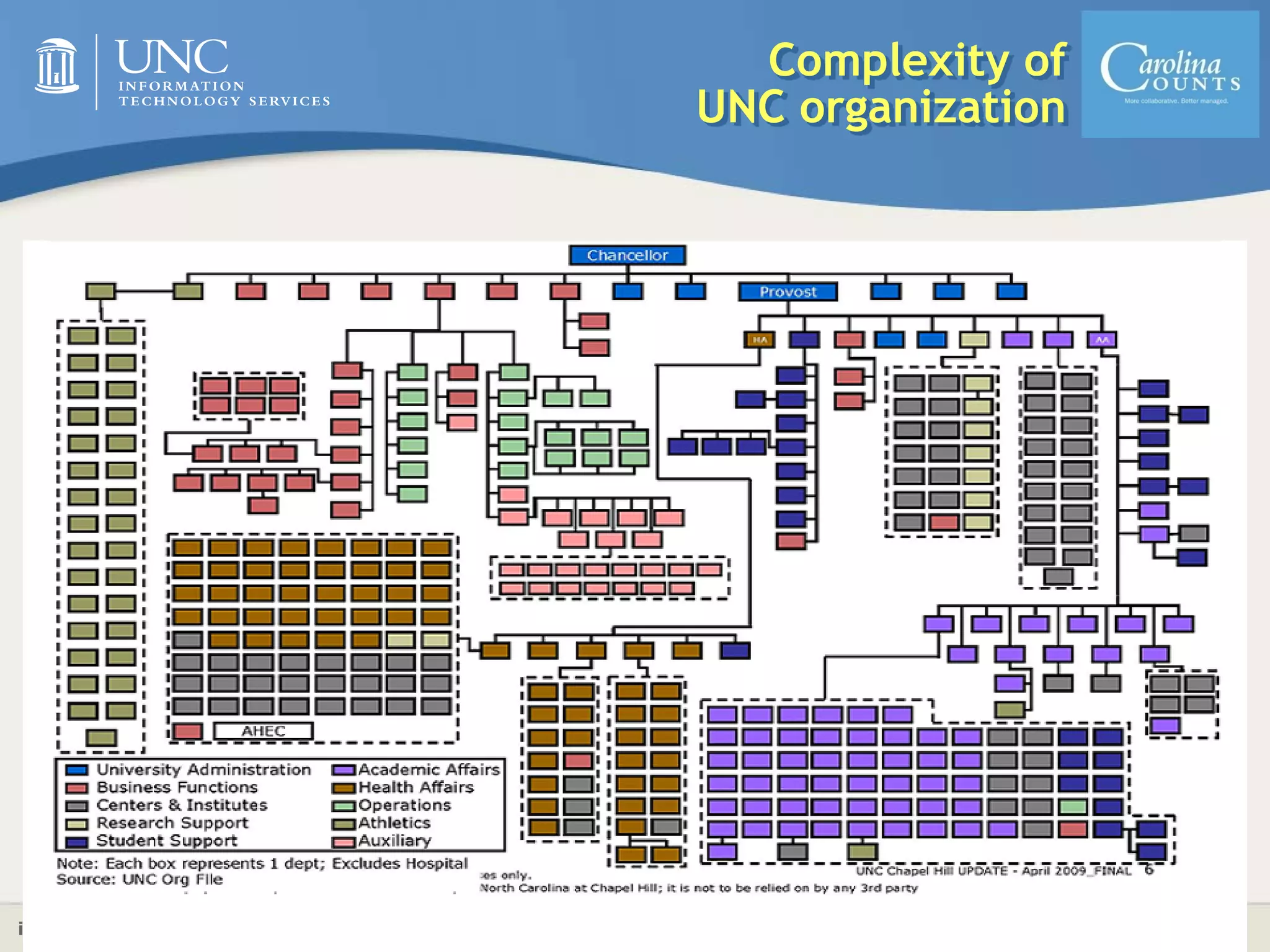

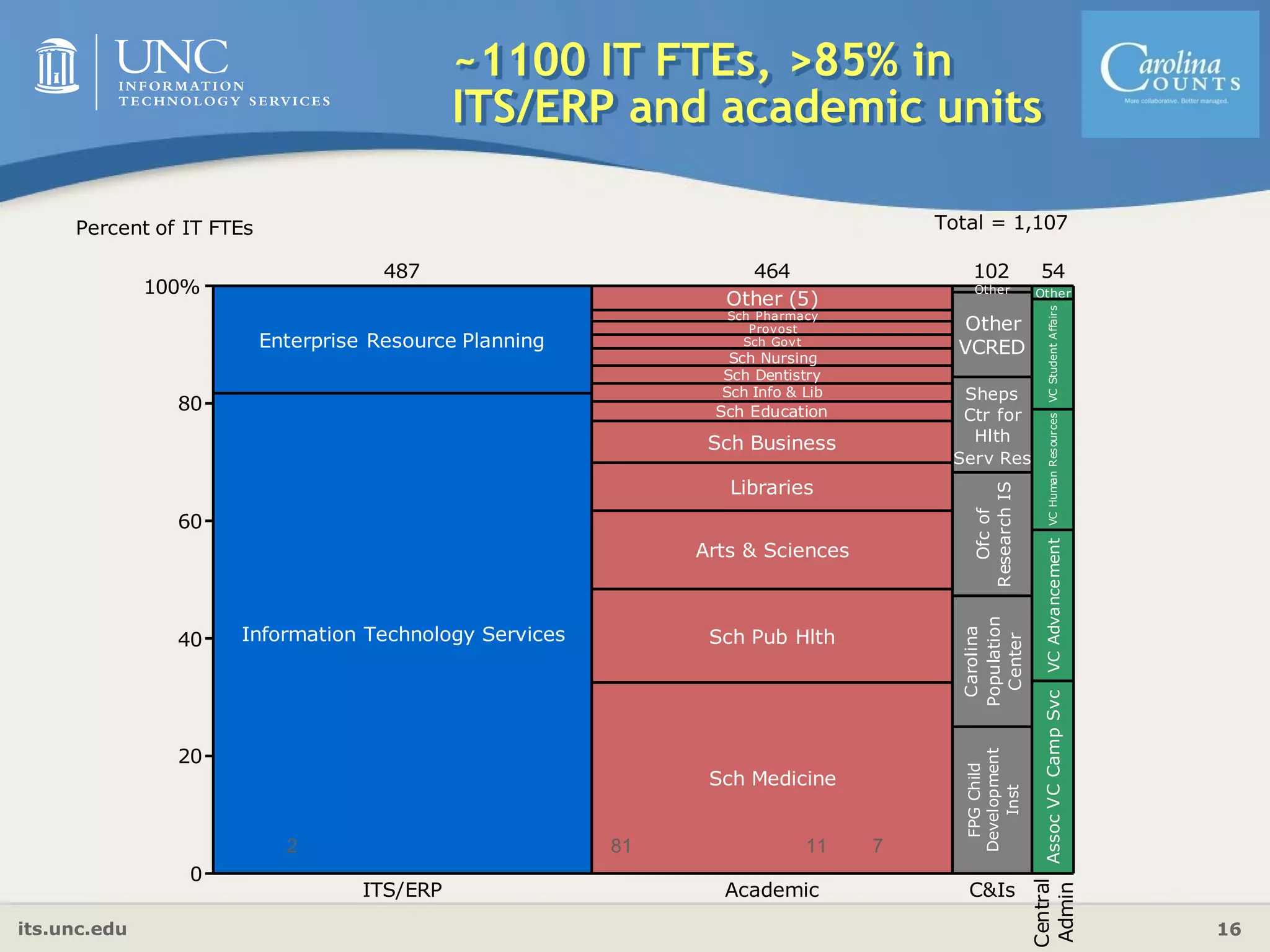

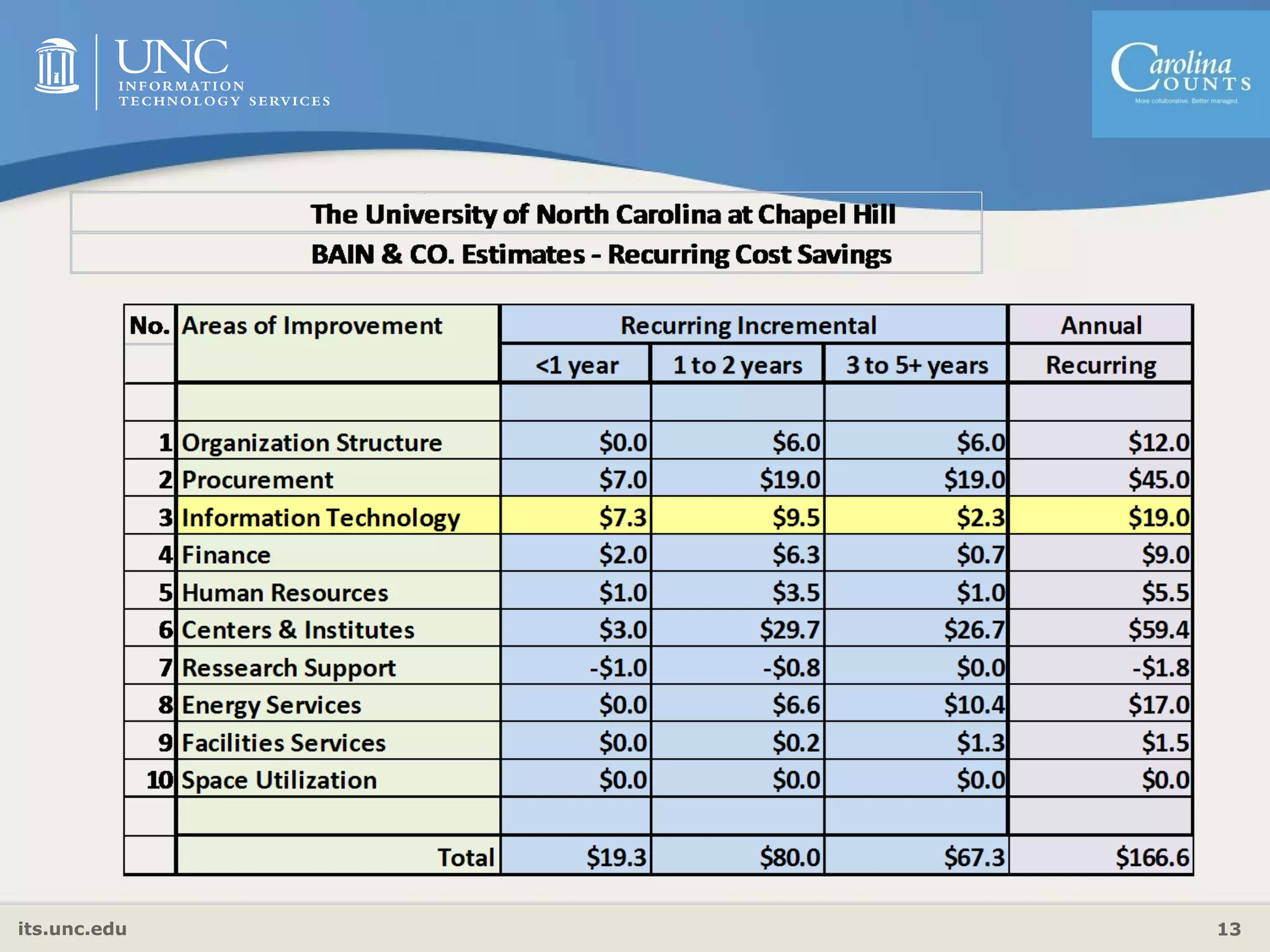

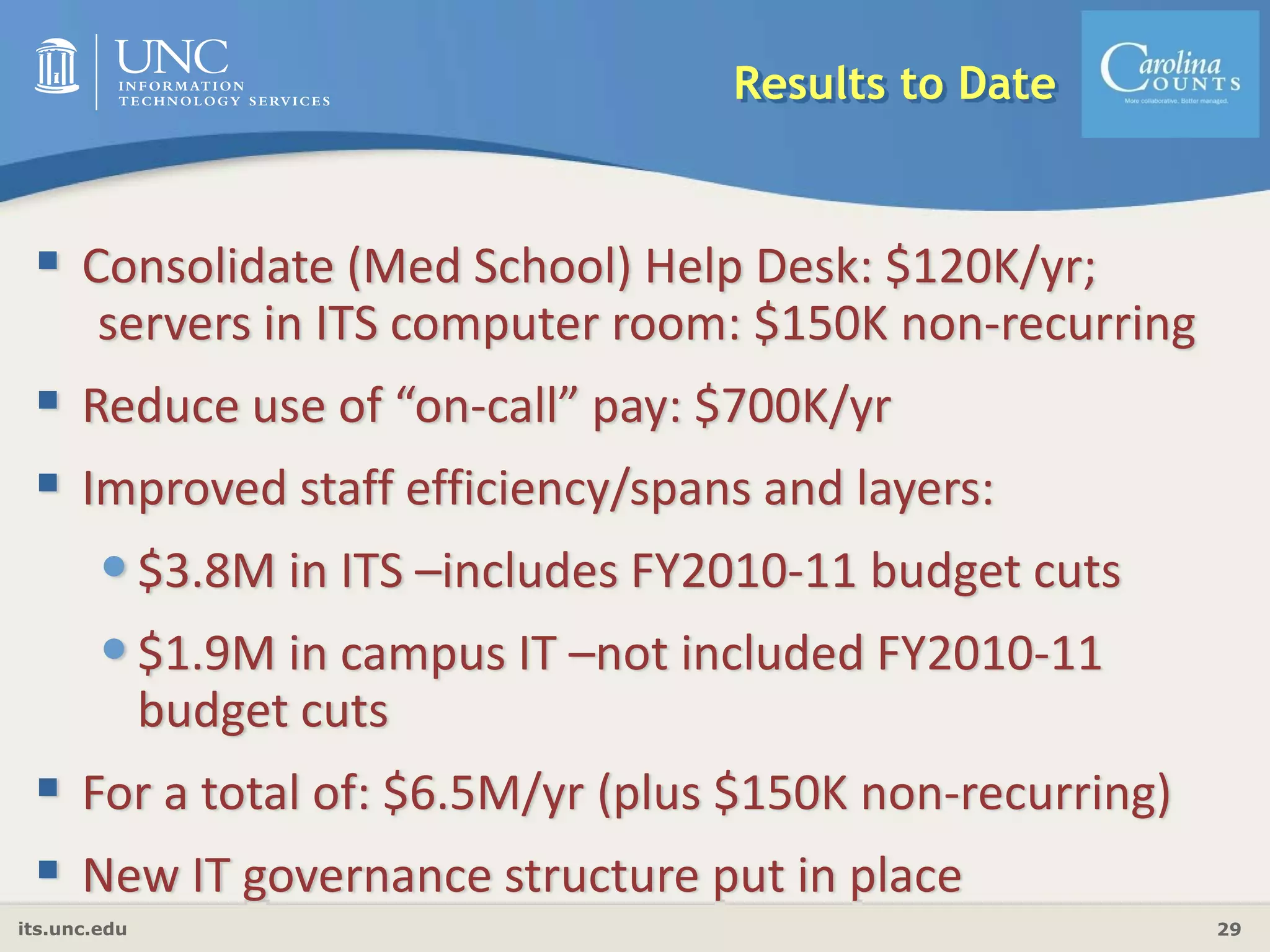

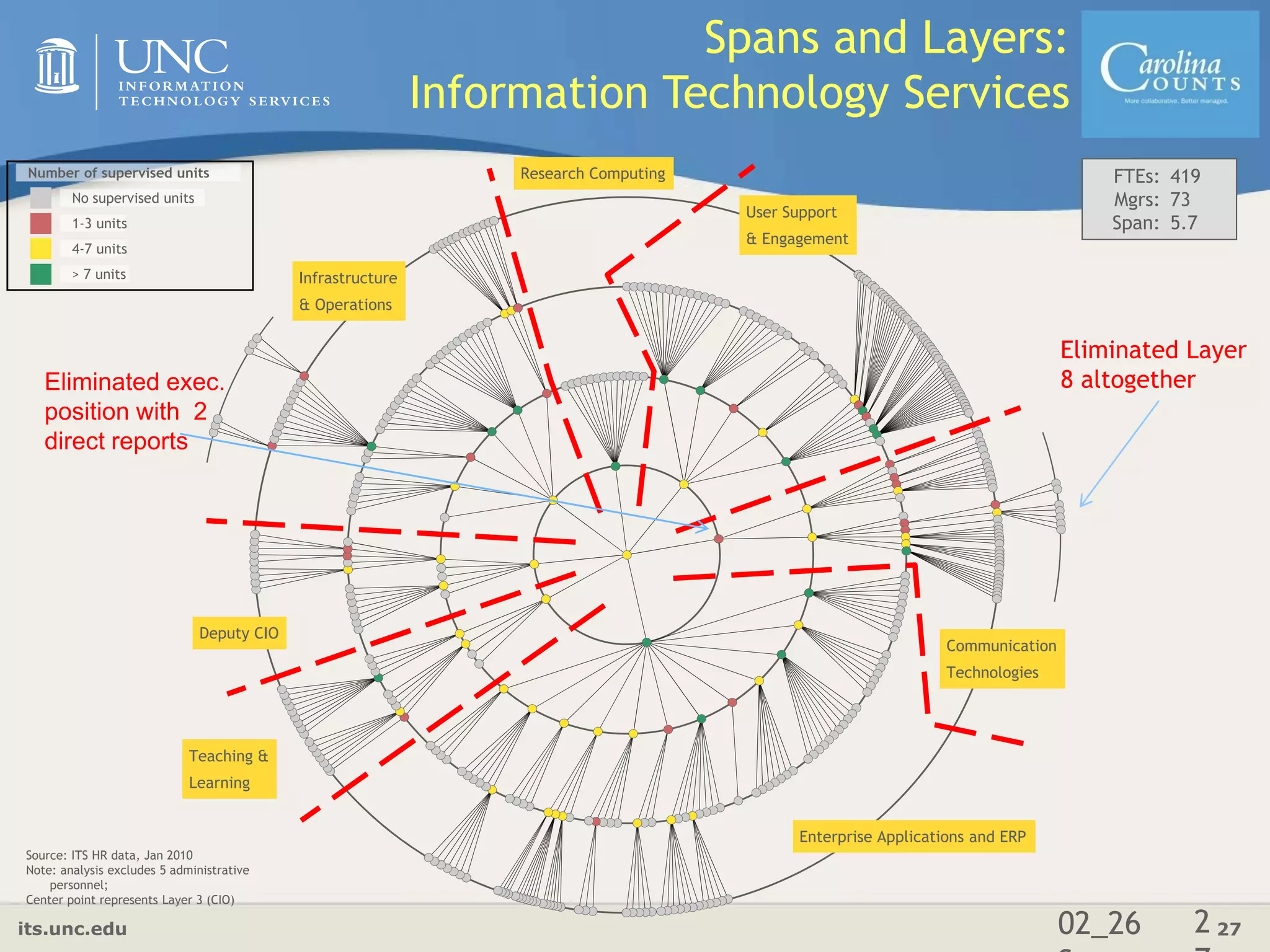

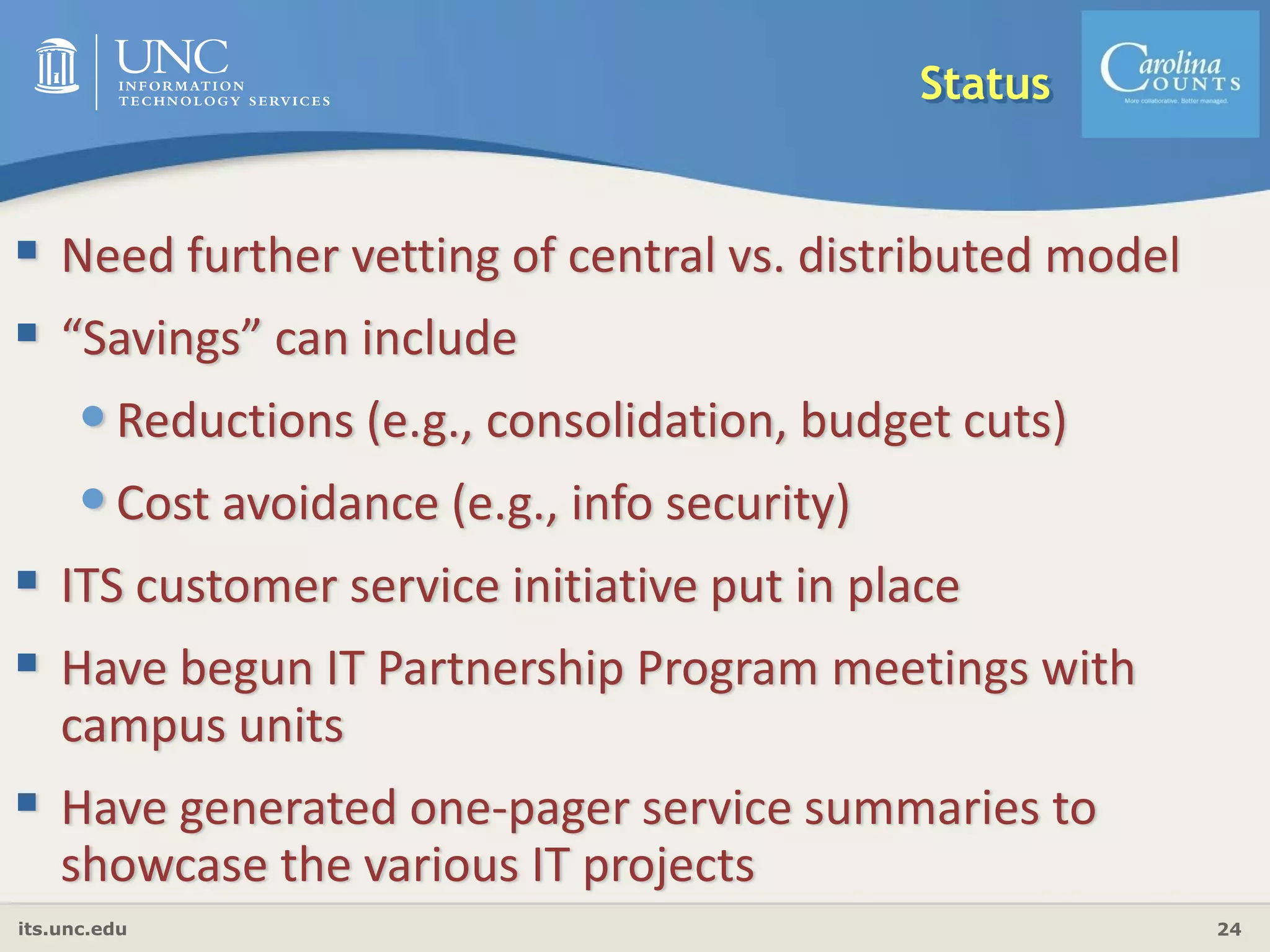

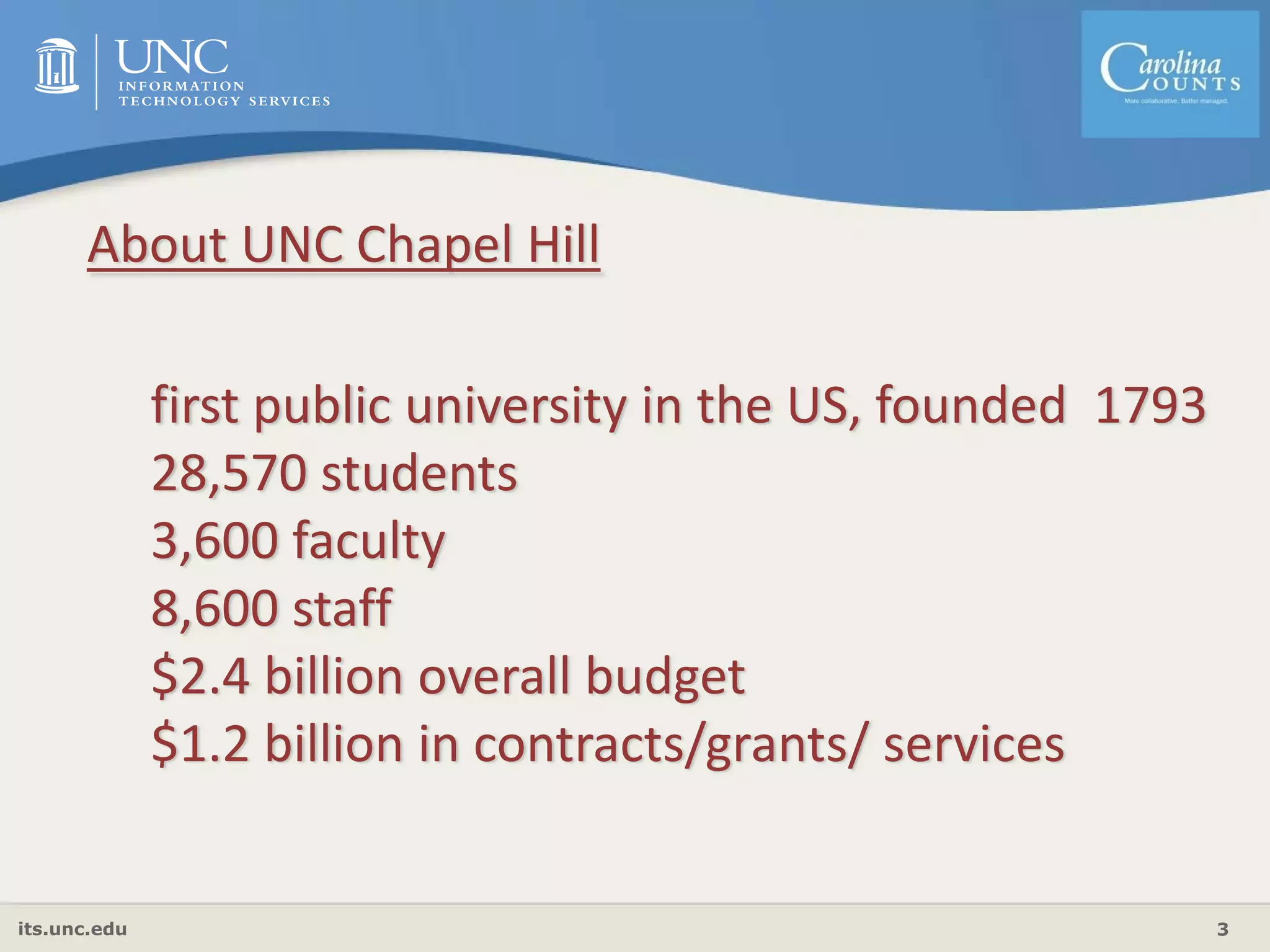

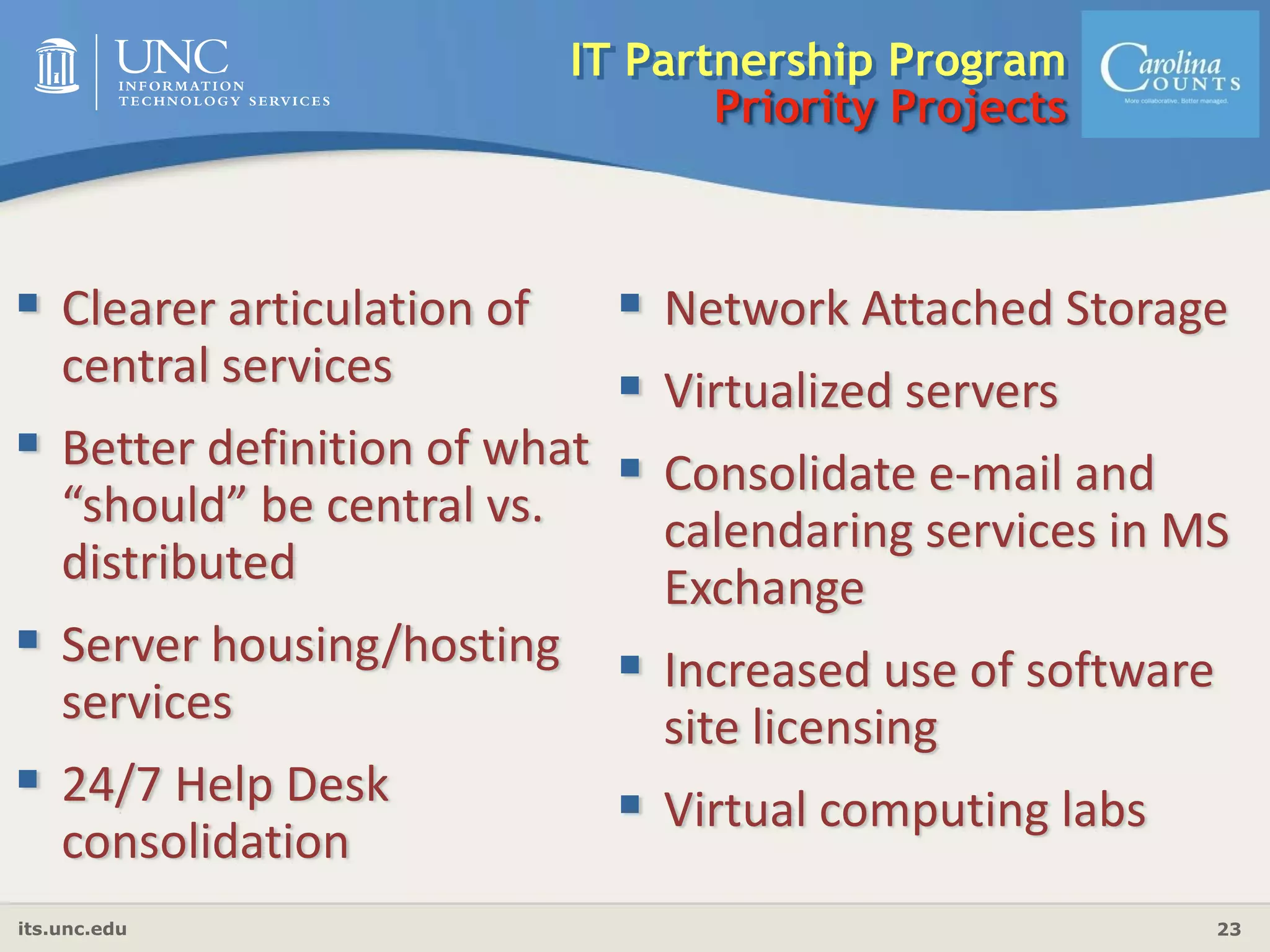

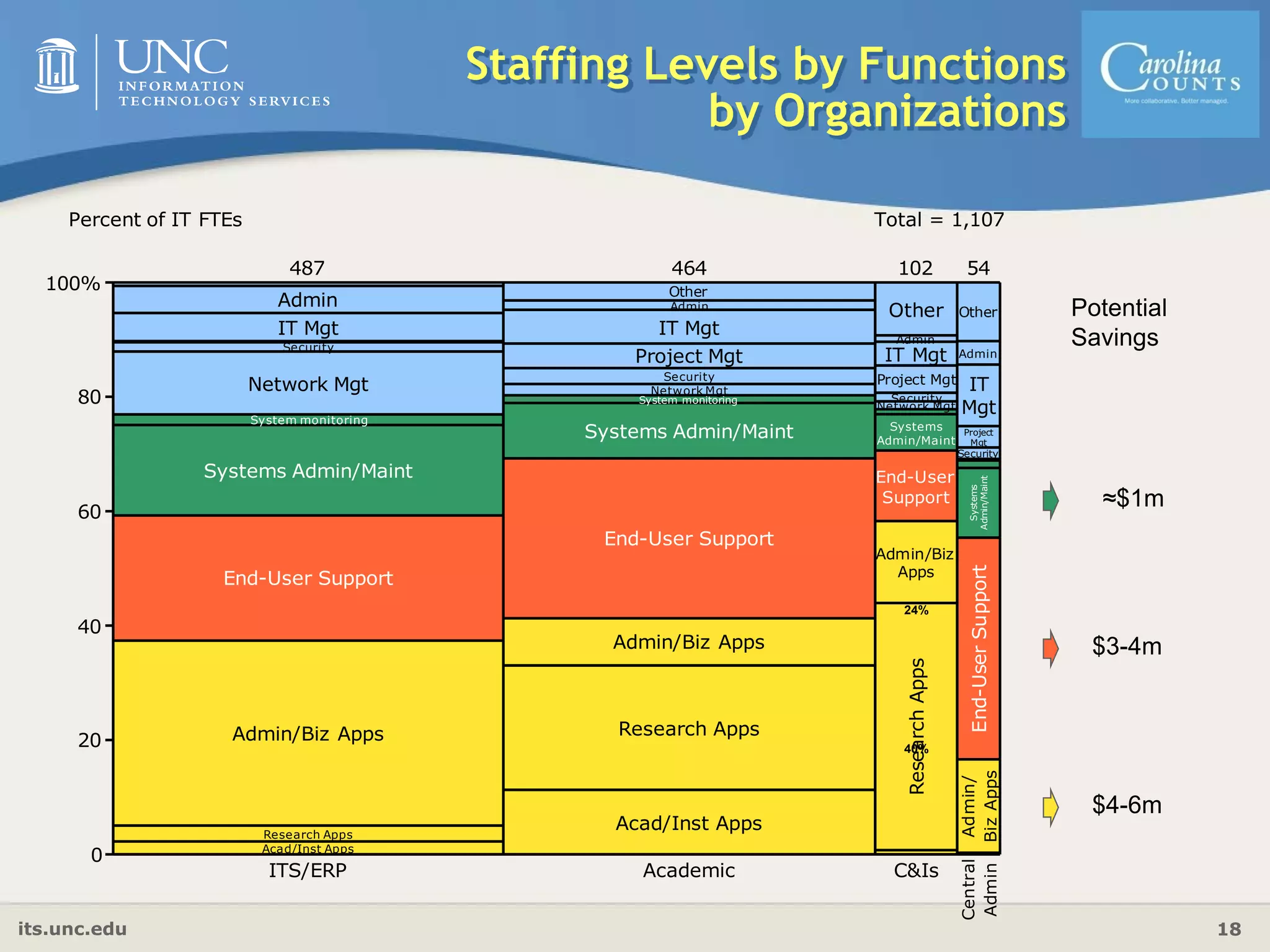

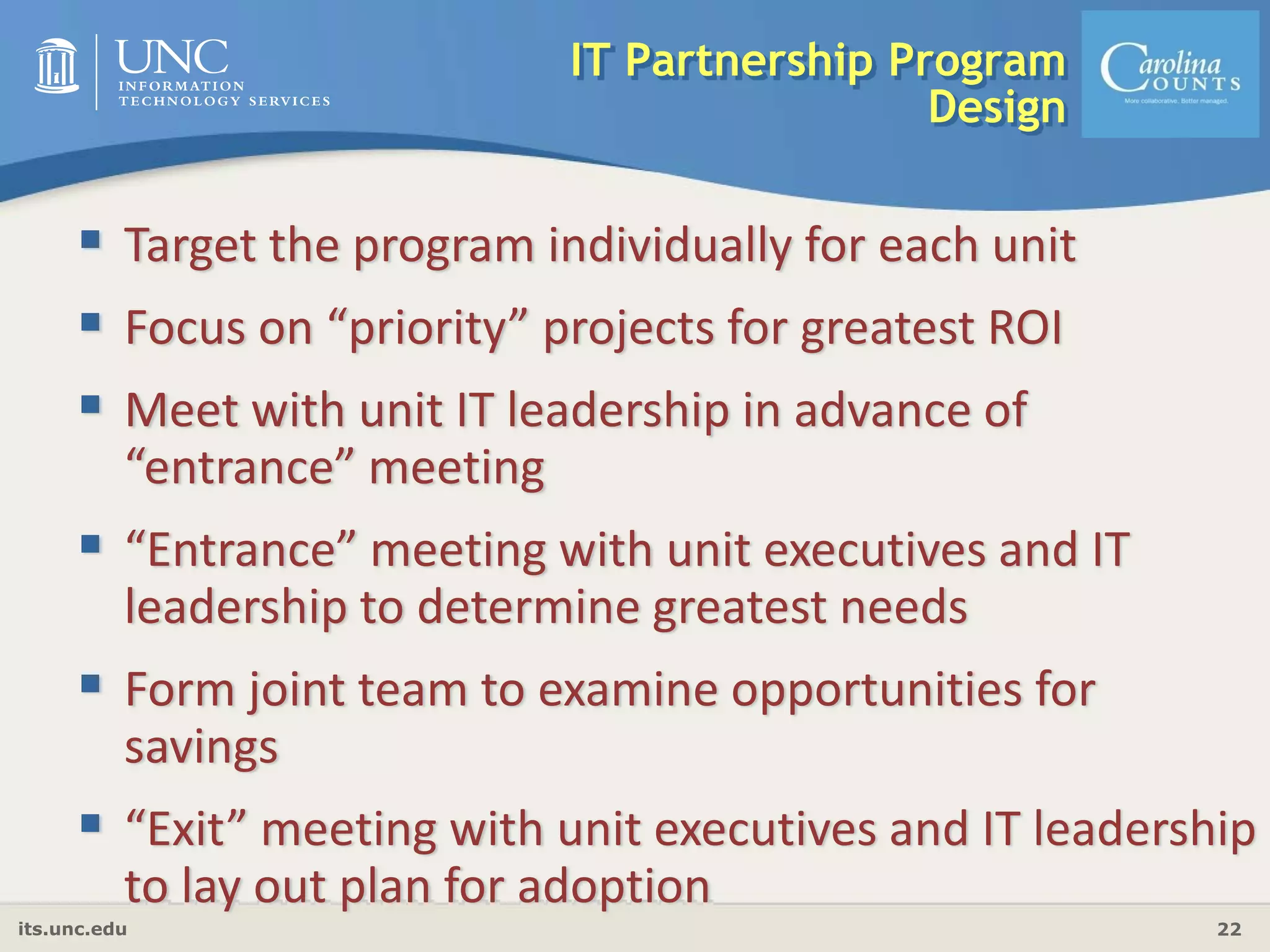

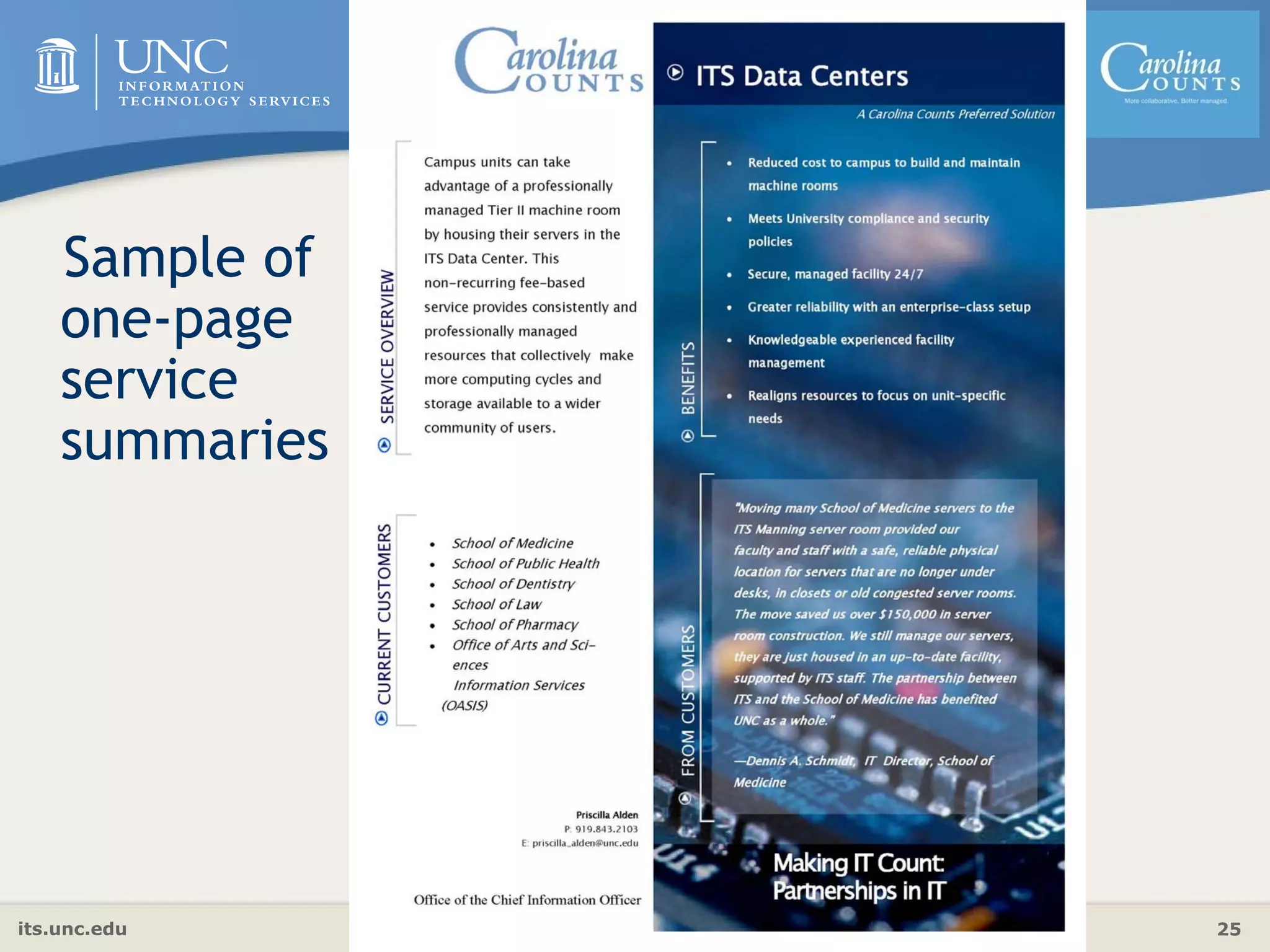

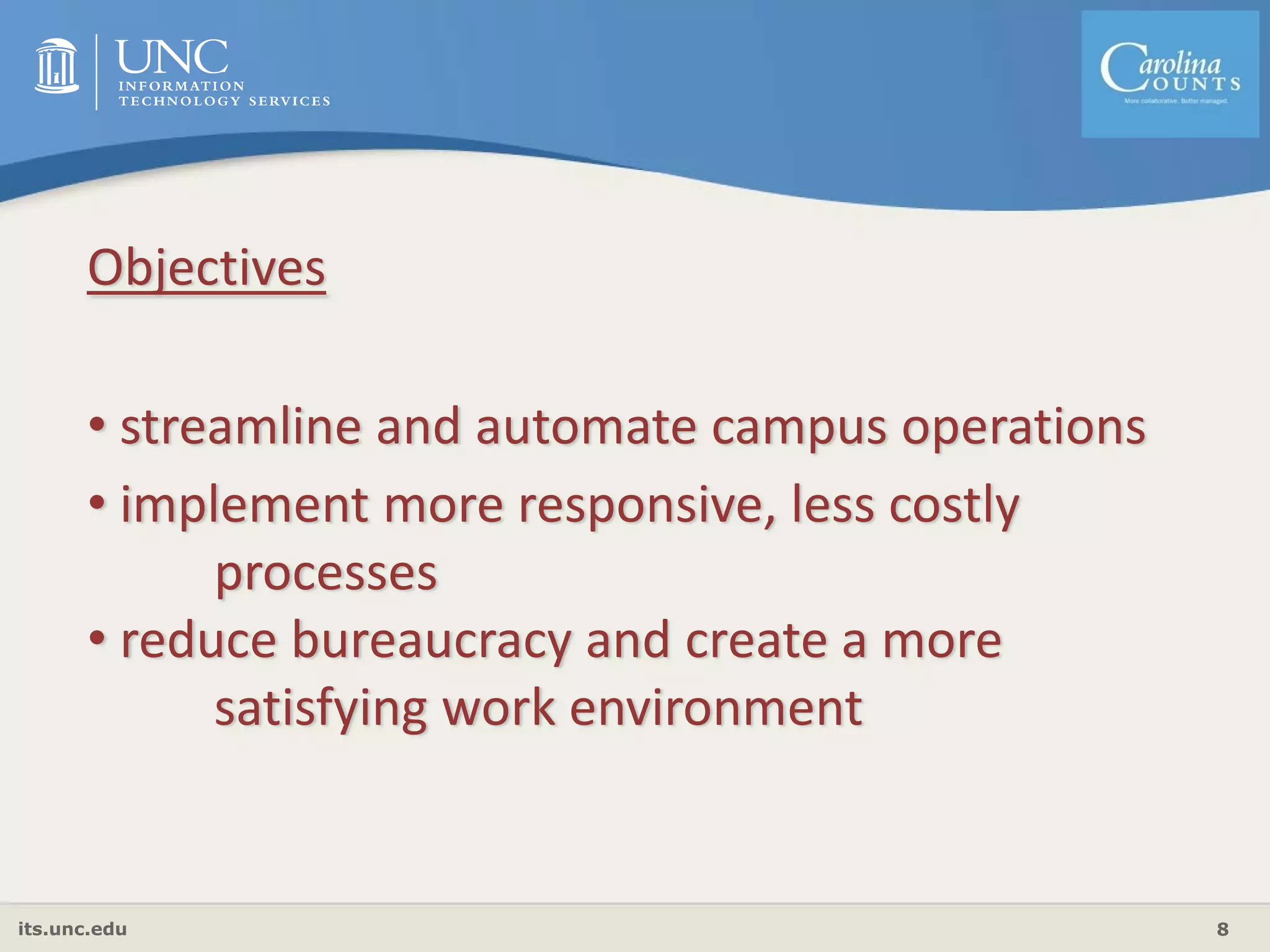

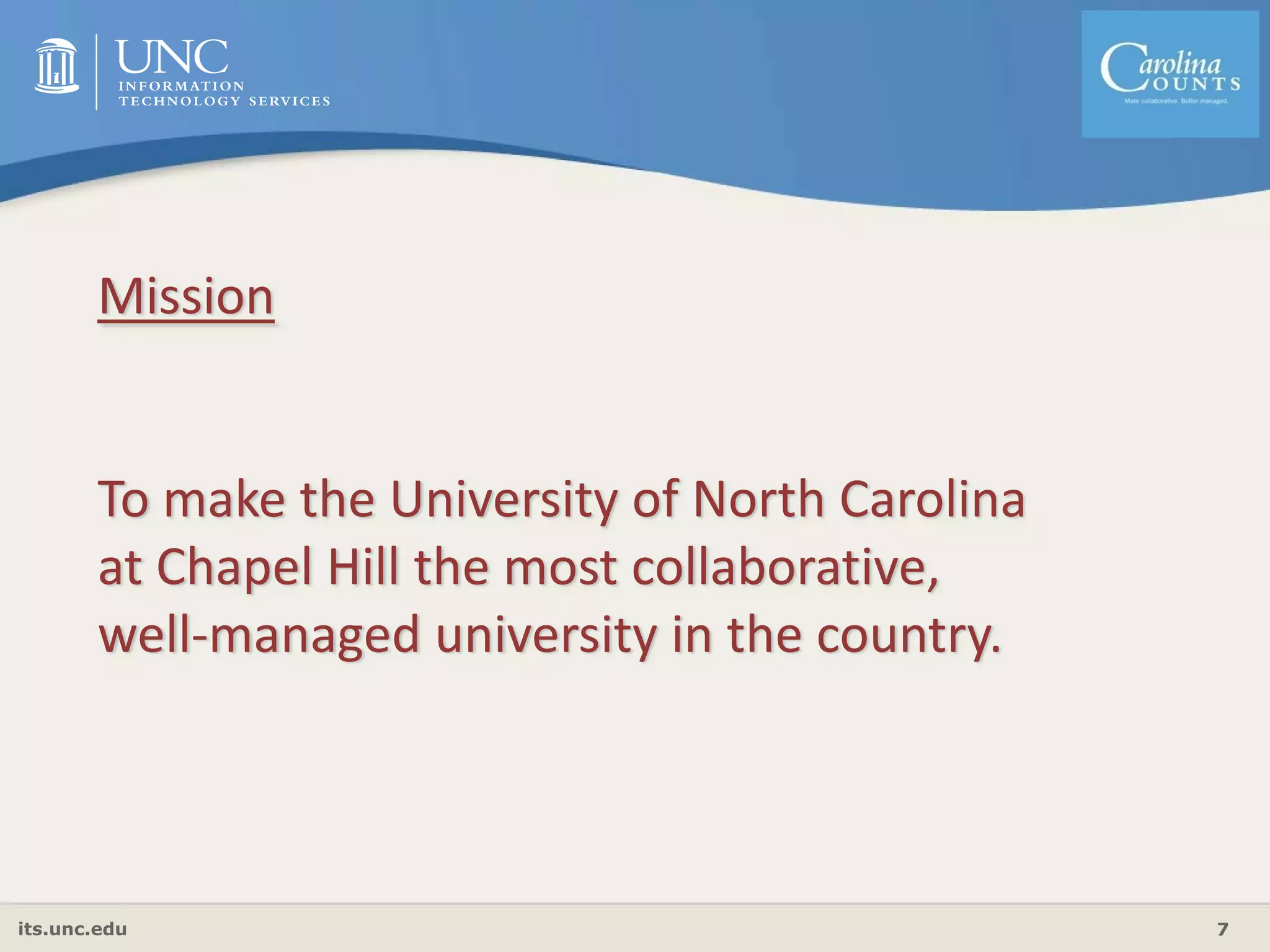

The document discusses the Carolina Counts program at UNC-Chapel Hill, which aims to make the university more cost effective. It was established based on recommendations from a consultant study to realize potential savings of $167 million. The program seeks to streamline campus operations, implement more efficient processes, and reduce bureaucracy. So far, the program has identified areas for improvement, established an IT partnership program, and achieved estimated annual savings of $6.5 million through initiatives like help desk consolidation and improved staff efficiency. However, driving adoption across the decentralized university remains a challenge.
