ENERGY & NUCLEAR




A NEW
PERSPECTIVE
ON GROWTH
Introduction to Assystem

                                 Product Design & Development
                                   Process & Plant Engineering
                            Technology Development & Implementation
                                Operation & Maintenance support




Assystem is a leading international group providing Engineering and Consultancy services across a broad
range of industry sectors. The UK branch of Assystem has 10 offices, a permanent workshop facility and
approximately 1500 engineers.

Energy & Nuclear is the oldest of the Assystem UK divisions, with a heritage spanning 40 years. Over that
time Assystem UK has achieved an impressive record of growth and diversification and provides value-
added services clients in Power Generation, Oil & Gas, Aerospace, Automotive, Defence, Marine and
Life Sciences industries.
                                                                                  Contract Models
Assystem UK provides a full life cycle of design services that
include concept design, detail design, mechanical and
electrical control & instrumentation engineering, analysis,
design substantiation, safety engineering, purchasing,
assembly & testing and recruitment.

Through its network of offices, Assystem provides a direct
local interface to our customers, enabling a clearer
understanding of client requirements and stronger working
relationships. Delivery of the consultative and technical
solutions is then delivered through the resources and
technical structure at the local offices and technical centres
of excellence throughout the country.




         ENERGY & NUCLEAR
         Assystem UK Ltd | Club Street | Bamber Bridge | PRESTON | PR5 6FN | UK
         Tel.: +44 (0)1772 645 000 | Fax: +44 (0)1772 645 001
         E&Ninfo@assystemuk.com More information at www.assystem.com                                FM 23790
Design Capability

                                       Design Engineering Services
Assystem is a leading international group providing Engineering and Consultancy services across a broad
range of product manufacturing and process sectors including the Aerospace, Automotive, Defence,
Energy, Life Sciences, Naval and Nuclear industries.

The Energy & Nuclear Division of Assystem UK Ltd. has a heritage spanning 40 years and over that time
the group has achieved an impressive record of growth and diversification. The strength of the group lies
in the ability to provide dedicated, multidiscipline project teams composed of specialist staff. There are
currently 10 UK offices and one permanent Test & Development Facility.


                                                          The company typically operates in four market areas:

                                                              ๏‚ท    Product Design & Development
                                                              ๏‚ท    Process & Plant Engineering
                                                              ๏‚ท    Technology Development & Implementation
                                                              ๏‚ท    Operation & Maintenance support



Within these market areas, we provide a comprehensive array of services and products that include
concept design, detail design, EC&I, engineering, analysis, substantiation, manufacturing, testing and
recruitment.

How we work
Through its network of offices, Assystem provides a direct local interface between customers and the
Assystem organisation. This enables us to establish a clear understanding of our clientโ€™s requirements.
Delivery of the technical solutions is then facilitated by the resources, facilities and technical capabilities
throughout the company at the local offices and technical centres.

Design and Substantiation
Product efficiency demands the linking of design and assessment to the required targets to be carried out
concurrently to achieve the best designs in the shortest possible time. Assystem achieves this by
embedding the analysis function within the design loop and ensuring that the lessons learnt from the
functional performance of one iteration is fed back to the next: the design and analysis engineers sit next
to each other and work on the designs concurrently.

Design Capabilities:
๏‚ท Conceptual Design                                           ๏‚ท    Detail Design & Analysis
๏‚ท Multi-Disciplinary Engineering Design                       ๏‚ท    Process Simulation & 3D Mock Ups
๏‚ท Design Studies                                              ๏‚ท    Detail design, manufacture & test



          ENERGY & NUCLEAR
          Assystem UK Ltd | Club Street | Bamber Bridge | PRESTON | PR5 6FN | UK
          Tel.: +44 (0)1772 645 000 | Fax: +44 (0)1772 645 001
          E&Ninfo@assystemuk.com More information at www.assystem.com                                  FM 23790
Design Capability

Case Studies
                      UKAE Harwell - design and build                                   Rolls-Royce Submarines -
                      of a retrieval machine.                                           fuelling/ defueling equipment.
                      ๏‚ท     Conceptual Design                                           ๏‚ท     Technology development
                      ๏‚ท     Detail design for manufacture.                              ๏‚ท     Concept design
                      ๏‚ท     Procurement, systems                                        ๏‚ท     System Integration
                            interrogation inactive                                      ๏‚ท     Mechanical seismic
                            commissioning.                                                    verification and
                                                                                              substantiation.
                      British Energy - design and                                       Nuclear industry - boiler lift rig
                      build of graphite sampling                                        ๏‚ท   Strength and limit load
                      machine.                                                              checks
                      ๏‚ท     Technology development                                      ๏‚ท   Seismic substantiation
                      ๏‚ท     Conceptual & detail design                                  ๏‚ท   BS2573
                      ๏‚ท     Procurement construction &
                            commissioning



                      Nuclear industry - impact                                         Nuclear Industry - cracked
                      analysis of storage flask                                         body analysis.
                      ๏‚ท    Concurrent design &                                          ๏‚ท     Cracked body analysis
                           substantiation                                                     BS7910/R6 code checks
                      ๏‚ท    Explicit dynamic



Analysis Capabilities:
๏‚ท Static, linear / non linear FEA (ANSYS,                    ๏‚ท   Seismic assessment (ASCE4-98 / Eurocode 8)
    NASTRAN, ABAQUS)                                              ๏ƒž Response spectrum and time history
๏‚ท   Dynamic / impact (Dyna, RADIOSS,
                                                                      analysis (linear or nonlinear)
    ABAQUS)                                                  ๏‚ท   Steelwork element design and detailing to
๏‚ท   Thermal transient analysis
                                                                 BS5950
                                                                  ๏ƒž Staircases / platforms
๏‚ท   Design optimisation (OPTISTRUCT, ANSYS,                       ๏ƒž Building frames
    ABAQUS)                                                       ๏ƒž Canopies
๏‚ท   Robustness Studies (HyperStudy, DoE)                     ๏‚ท   Modular construction
๏‚ท   Fatigue assessment                                       ๏‚ท   Concrete element design and detailing to BS8110
                                                                  ๏ƒž Pre-cast
๏‚ท   Pressure vessel assessment:
                                                                  ๏ƒž Flooring
     ๏ƒž ASME III, ASME VIII, TEMA, ASME/                           ๏ƒž Fire panels
         ANSI B31)
                                                             ๏‚ท    Civil design
๏‚ท   PD5500, EN13445, BS806
                                                                  ๏ƒž Foundations and retaining walls (BS8004)
๏‚ท   Fracture assessment (including Rcode and                      ๏ƒž Reinforced concrete (BS8110)
    BS7910)                                                  ๏‚ท   Envelope (BS5628)
                                                             ๏‚ท   Crane and lifting equipment design and
                                                                 assessment to BS2573 / BS EN 13001
         ENERGY & NUCLEAR
         Assystem UK Ltd | Club Street | Bamber Bridge | PRESTON | PR5 6FN | UK
         Tel.: +44 (0)1772 645 000 | Fax: +44 (0)1772 645 001
         E&Ninfo@assystemuk.com More information at www.assystem.com                                             FM 23790
Mechanical Engineering Capability

                                     Mechanical Engineering Services
Assystem UK Energy & Nuclear offers a world class mechanical engineering design service utilising a
broad base of in-house skills relevant to the world energy market. Specialist knowledge developed over 40
years across a multi disciplined team, allows Assystem UK Energy & Nuclear to be a โ€œone stop shopโ€ for
the delivery of cost effective technical solutions to clients for all phases of the project life cycle.

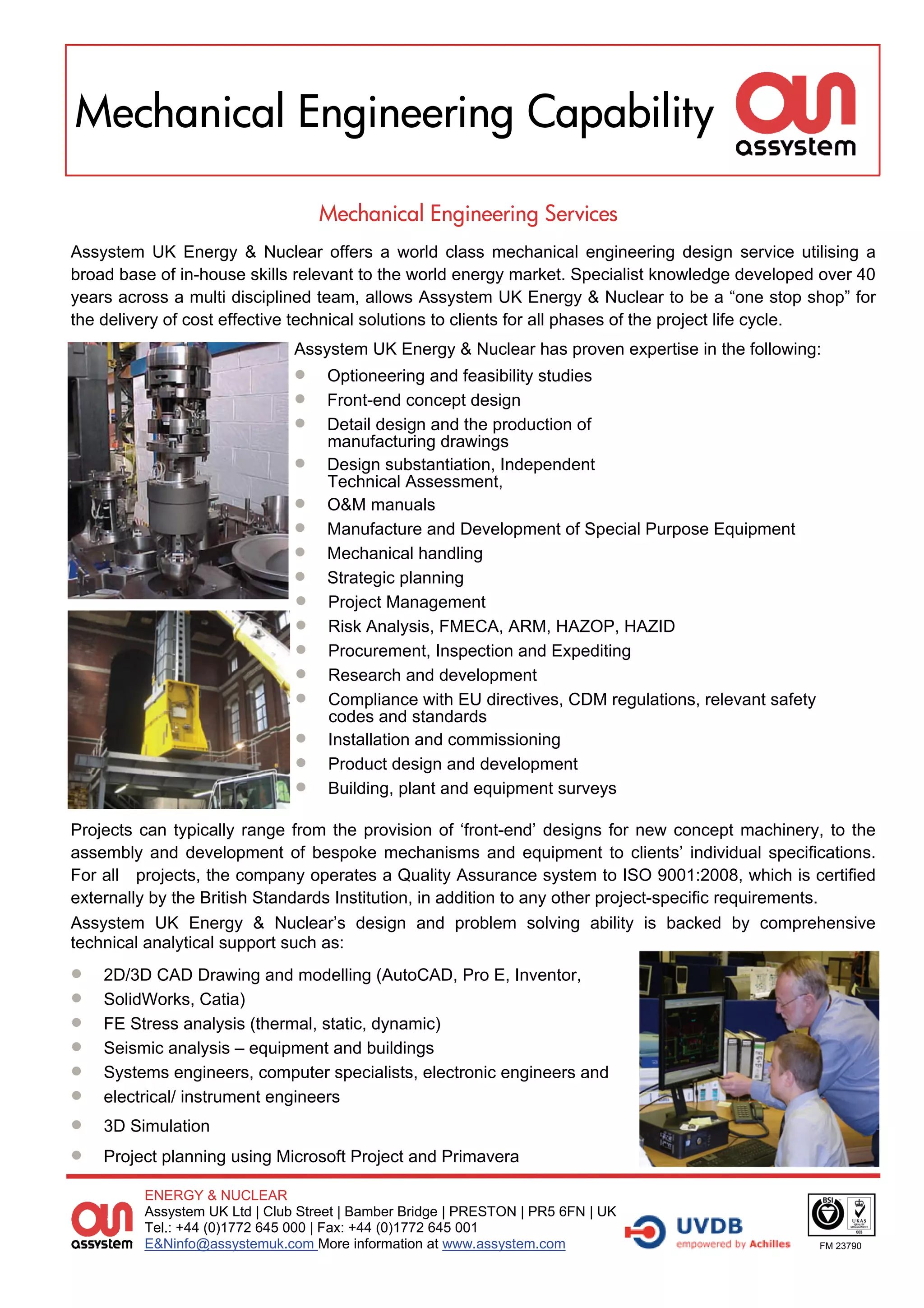

                                Assystem UK Energy & Nuclear has proven expertise in the following:
                                ๏‚ท๏€    Optioneering and feasibility studies
                                ๏‚ท๏€    Front-end concept design
                                ๏‚ท๏€    Detail design and the production of
                                     manufacturing drawings
                                ๏‚ท๏€    Design substantiation, Independent
                                     Technical Assessment,
                                ๏‚ท๏€    O&M manuals
                                ๏‚ท๏€    Manufacture and Development of Special Purpose Equipment
                                ๏‚ท๏€    Mechanical handling
                                ๏‚ท๏€    Strategic planning
                                ๏‚ท๏€    Project Management
                                ๏‚ท๏€    Risk Analysis, FMECA, ARM, HAZOP, HAZID
                                ๏‚ท๏€    Procurement, Inspection and Expediting
                                ๏‚ท๏€    Research and development
                                ๏‚ท๏€    Compliance with EU directives, CDM regulations, relevant safety
                                     codes and standards
                                ๏‚ท๏€    Installation and commissioning
                                ๏‚ท๏€    Product design and development
                                ๏‚ท๏€    Building, plant and equipment surveys

Projects can typically range from the provision of โ€˜front-endโ€™ designs for new concept machinery, to the
assembly and development of bespoke mechanisms and equipment to clientsโ€™ individual specifications.
For all projects, the company operates a Quality Assurance system to ISO 9001:2008, which is certified
externally by the British Standards Institution, in addition to any other project-specific requirements.
Assystem UK Energy & Nuclearโ€™s design and problem solving ability is backed by comprehensive
technical analytical support such as:
๏‚ท๏€    2D/3D CAD Drawing and modelling (AutoCAD, Pro E, Inventor,
๏‚ท๏€    SolidWorks, Catia)
๏‚ท๏€    FE Stress analysis (thermal, static, dynamic)
๏‚ท๏€    Seismic analysis โ€“ equipment and buildings
๏‚ท๏€    Systems engineers, computer specialists, electronic engineers and
๏‚ท๏€    electrical/ instrument engineers
๏‚ท๏€    3D Simulation
๏‚ท๏€    Project planning using Microsoft Project and Primavera

          ENERGY & NUCLEAR
          Assystem UK Ltd | Club Street | Bamber Bridge | PRESTON | PR5 6FN | UK
          Tel.: +44 (0)1772 645 000 | Fax: +44 (0)1772 645 001
          E&Ninfo@assystemuk.com More information at www.assystem.com                                  FM 23790
Mechanical Engineering Capability

Typical Equipment & Processes
๏‚ท๏€  Remote engineering; robotics, manipulators, remote viewing,
     shield doors, through-wall drives
๏‚ท๏€    Mechanical handling including bogies, conveyors, cranes
๏‚ท๏€    Mechanical equipment including compactors, powder processing,
     fuel fabrication & assembly
๏‚ท๏€    Wet process equipment engineering including vessels, piping,
     pumps, heat exchangers and other process plant and installation
๏‚ท๏€    Nuclear transport equipment including flasks, containers
๏‚ท๏€    Nuclear containment & ventilation including ventilation systems,
     fans, heating, ducting, filters
๏‚ท๏€    Services including steam, gases, water, electrical, fire protection,
     security etc.
๏‚ท๏€    Alpha plant engineering & equipment including gloveboxes
๏‚ท๏€    Engineering substantiation, technical assessment of equipment capability and justification of
     adequacy;
๏‚ท๏€    FMEA & ARM
๏‚ท๏€    Process plant including encapsulation
๏‚ท๏€    Safety case โ€“ support and supervision

Case Studies
                           AGR Graphite Sampling System โ€“ British Energy (Barnwood)
                           Assystem UK designed and supplied a graphite sampling system for deployment
                           inside the fuel channels of AGR reactors. The equipment incorporated a remote
                           trepanning tool, precision tool alignment mechanisms, sample conveying system
                           and a CCTV and operator control system.


                           Synchrotron โ€“ DLS
                           Assystem UK has been closely involved in the design of the Diamond Light
                           Source Synchrotron - the largest science facility to be funded in the UK for over
                           30 years and costing ยฃ350m. Assystem UKโ€™s team of up to 25 engineers have
                           been responsible for the design of many of the high precision mechanisms and
                           support systems associated with the accelerator.

                           Nuclear waste retrieval machine โ€“ UKAEA
                           Assystem UK designed and developed a waste retrieval facility for the removal
                           of intermediate level waste canisters from the B462.9 tube store at UKAEA
                           Harwell. The innovative design consists of a 3 cubic metre 220 ton shielded
                           containment enclosing a retrieval hoist, grabs and a waste export system.




          ENERGY & NUCLEAR
          Assystem UK Ltd | Club Street | Bamber Bridge | PRESTON | PR5 6FN | UK
          Tel.: +44 (0)1772 645 000 | Fax: +44 (0)1772 645 001
          E&Ninfo@assystemuk.com More information at www.assystem.com                                FM 23790
Control, Electrical and Instrumentation
Capability
                                 Control, Electrical & Instrumentation
Our substantial Electrical, Control and Instrumentation (C,E&I) capabilities range from initial concept
development through design, in-house assembly, installation, commissioning and through-life
maintenance support.

                                                               Assystem UK Energy and Nuclear has in-house
                                                               systems engineers, computer specialists,
                                                               electronic engineers and electrical/ instrument
                                                               engineers whose combined experience can be
                                                               used to complete the most demanding of
                                                               projects.

                                                               This includes complex safety critical control
                                                               systems or nuclear applications enabling us to
                                                               provide complete and fully integrated solutions.

                                                               Furthermore, our C,E&I engineers are highly
                                                               experienced in working alongside other
                                                               engineering disciplines to provide a total
                                                               system integration capability.


Capability Scope
Our capabilities cover a broad range of the C,E&I spectrum. These include:

Control                                   Electrical                              Instrumentation
๏‚ท   Embedded real-time systems            ๏‚ท   Site surveys                        ๏‚ท   In-line testing

๏‚ท   SCADA and data-logging                ๏‚ท   Cabling design                      ๏‚ท   Radiometrics

๏‚ท   Networks                              ๏‚ท   Site installation                   ๏‚ท   Process

๏‚ท   PLC systems                           ๏‚ท   Building services including
                                                                                      instrumentation

๏‚ท   Operator interfaces and HMIs
                                              lighting, earthing, and power
                                              distribution
๏‚ท   Safety system design and
    substantiation.

๏‚ท   Bespoke electronics




         ENERGY & NUCLEAR
         Assystem UK Ltd | Club Street | Bamber Bridge | PRESTON | PR5 6FN | UK
         Tel.: +44 (0)1772 645 000 | Fax: +44 (0)1772 645 001
         E&Ninfo@assystemuk.com More information at www.assystem.com                                    FM 23790
Control, Electrical and Instrumentation
Capability



Safety Engineering
Assystem have extensive experience in the design and substantiation of Safety Instrumented Systems
and are familiar with the requirements of IEC61508 and IEC61511. A number of our engineers have
undergone training in Sellafield Sites Ltd engineering guide for safety systems, EG90, and have also
successfully completed other customer specific but broadly applicable training in the realisation and
documentation of Safety Systems.

Toolsets
Our engineers are experienced in the use of a wide variety of tools and applications for the design and
development of software and hardware systems. We have a number of engineers with extensive
experience in the development of PLC systems, under IEC61131 and various customer specific
standards, for a variety of PLC platforms including Rockwell / Allen Bradley SLC series and Siemens S7.
We also have experience with older systems such as Allen Bradley PLC5 giving us the capability to
reverse engineer legacy systems in order to upgrade or replace them.

โ€˜Reliability Workbenchโ€™ with โ€˜Fault Tree Plusโ€™ are used for the design and validation of Safety Systems and
several of our engineers are trained and experienced in its use. Rapid development of test systems and
less critical control systems is undertaken using National Instruments LabView for which we have a full
development environment with many of the popular control and instrumentation sub-packages. We have
several engineers experienced with the use of real time operating environments such as VxWorks and
their application in the realisation of embedded real time systems.

Designs and drawings are produced using AutoCAD electrical which allows us to use a component based
approach to the creation of schematic diagrams and panel designs. Amtech is used for undertaking and
checking cable calculations.

All of our engineers are accustomed to being required to use a myriad of other proprietary and bespoke
packages as necessary to satisfy the requirements of specific projects. These include design tools,
software development systems and modelling packages.

Engineering Services Include:
Hardware Design: Overall Systems Integration - High Integrity Protection Control Systems - Safety
Instrumented Systems - Robotics & Remote Handling - Bespoke Electronics - MCC & Panel Design &
Wiring - HVDC - Cable Design - Building Management Systems - Industrial Networking - Process
Instrumentation - Power Distribution.

Software Design: PLC - Embedded Systems - SCADA & HMI Design and Testing.


         ENERGY & NUCLEAR
         Assystem UK Ltd | Club Street | Bamber Bridge | PRESTON | PR5 6FN | UK
         Tel.: +44 (0)1772 645 000 | Fax: +44 (0)1772 645 001
         E&Ninfo@assystemuk.com More information at www.assystem.com                               FM 23790
Finite Element Analysis Capability

                                           Finite Element Analysis
Finite element analysis is carried out as a bespoke service and also as part of larger projects. On larger
projects design and analysis engineers work within the same office and develop the designs concurrently.




FEA Capabilities
๏‚ท   Static, linear / non-linear analysis                  ๏‚ท   Fatigue assessment

๏‚ท   Dynamic / impact analysis                             ๏‚ท   Pressure vessel assessment

๏‚ท   Thermal transient analysis                            ๏‚ท   Fracture assessment

๏‚ท   Design optimisation                                   ๏‚ท   Seismic assessment and analysis

๏‚ท   Robustness studies                                    ๏‚ท   Hyperelastic material (e.g. rubber) simulation

๏‚ท   Computational Fluid Dynamics (CFD)                    ๏‚ท   Process simulation (e.g. pipe bending /

๏‚ท   DoE & response surface modelling
                                                               straightening)



         ENERGY & NUCLEAR
         Assystem UK Ltd | Club Street | Bamber Bridge | PRESTON | PR5 6FN | UK
         Tel.: +44 (0)1772 645 000 | Fax: +44 (0)1772 645 001
         E&Ninfo@assystemuk.com More information at www.assystem.com                                    FM 23790
Finite Element Analysis Capability

Case Study: Flask Impact Design Substantiation
To support and substantiate the design of a nuclear storage flask and internal assembly, dynamic impact
analysis was performed by Assystem UK to show that the ability of the container to safely hold its contents
would not be comprised through any impact that could occur through being dropped during transit.
The flask has been designed to provide a safe
method of containment for nuclear material. The
flasks are to be kept in a storage facility where
drop scenarios are possible. Two drop heights
were analysed, each with nine different drop
orientations (see example, bottom right).
The FEA mesh of the flask components was
generated using Altair Hypermesh and analysed
using RADIOSS v.4.4u, both of which are part of
the Altair Hyperworks suite.
The study identified five different possible failure
modes, each of which was investigated for both
drop heights and all drop orientations. The mode
of most concern was the failure of the dynamic
sealing of the flask. This involves the seals
being momentarily misaligned during impact and
allowing the escape of a limited, but dangerous,
amount of gas.

The substantiation showed that, with the design and drop heights specified, the ability of the flask to hold
its contents would not be compromised. This design was physically tested at the Assystem UK workshop
facility, and all tests were in agreement with the above analysis.




          ENERGY & NUCLEAR
          Assystem UK Ltd | Club Street | Bamber Bridge | PRESTON | PR5 6FN | UK
          Tel.: +44 (0)1772 645 000 | Fax: +44 (0)1772 645 001
          E&Ninfo@assystemuk.com More information at www.assystem.com                               FM 23790
Fracture Analysis Capability

                                                Fracture Analysis
Fracture analysis is carried out as a bespoke service and also as part of larger projects within the Energy
and Nuclear division of Assystem UK Limited. Our analysis capabilities can be accessed at National or
local levels via our network of 10 UK service centres.
Assystem can perform R6 Procedure structural integrity assessments on structural components containing
defects.



Defects: (NDE, postulated, maximum                                                           Defects assumed in
reasonably foreseeable Virgin                                                                attachment welds.




Using R-CODE Assystem can define and subsequently assess geometry specific solutions.
Un-cracked and cracked finite element analysis models are used to generate crack opening stresses and
SIFs. Modification of geometry codes undertaken to account for specific geometry (SIF solution modified
using FEA results). Geometry code sensitivity is undertaken for each assessment.

                                                                       Un-cracked geometry
  Defect     Maximum        Minimum K
  (mm)      K (MPa๏ƒ–m)        (MPa๏ƒ–m)
   0.5          8.0            -21.2
   1.0           9.1           -23.2
   1.5           9.4           -23.5
   4.0           7.8           -18.1          Cracked geometry

Critical flaw size calculations (calculates maximum defect size and proximity to brittle / plastic collapse).
Assystem can determine the limiting start of life defect size that would grow to the limiting critical flaw size
during the assumed operational life from which acceptance criteria (targets based on material toughness)
are specified.

           General Failure Assessment Diagram                        Start of Life Defect Vs. End of Life Defect




Fatigue Crack Growth made under known cyclic loading

           ENERGY & NUCLEAR
           Assystem UK Ltd | Club Street | Bamber Bridge | PRESTON | PR5 6FN | UK
           Tel.: +44 (0)1772 645 000 | Fax: +44 (0)1772 645 001
           E&Ninfo@assystemuk.com More information at www.assystem.com                                        FM 23790
Fracture Analysis Capability

Presentation of Margins of Safety
Fracture margins based on material fracture toughness with respect to operational temperatures (including
transition regions). These calculations account for crack tip plasticity and allow safe operating
temperatures to be identified

                                      Cracked body analysis can be carried out for assessments against the
                                      Failure Assessment Diagrams (FAD). Finite element analysis is used to
                                      determine the Kr (J-integral) and Limit Load Analysis to determine Lr.
                                      Pressure vessel design and assessment to all major codes
                                      (ASME III / VIII, PD5500, EN13445 etc.)

                                      Primary circuit and secondary side components (eg steam generators,
                                      regenerative heat exchangers).

Design and hydrotest conditions and Level A (fatigue) operation. Recent assessments moving towards
strain predictions and away from stress linearisation (or planarisation).

                                                                                   Fatigue life evaluation (or re-
                                                                                   evaluation based on measured
                                                                                   transient blackbox information)
                                                                                   carried out in accordance with
                                                                                   design codes (eg ASME III) or
                                                                                   using modern stress-life and
                                                                                   strain-life techniques.
                                                                                    A key aspect in plant operation
                                                                                   is life extension (aging plant
                                                                                   or extension of existing
                                                                                   Safety Justifications) therefore
                                                                                   knowledge of pessimisms in
                                                                                   fatigue calculation is vitally
                                                                                   important.


      Public domain RPV
Fatigue evaluation can be carried out elastically in accordance with design rule codes, or optionally,
elasto-plastically to check for shakedown as well as provide strain ranges for strain-based fatigue
calculation.

Non-linear material models
(e.g. nonlinear kinematic
plasticity) used in assessment
with life-cycle loading applied.




          ENERGY & NUCLEAR
          Assystem UK Ltd | Club Street | Bamber Bridge | PRESTON | PR5 6FN | UK
          Tel.: +44 (0)1772 645 000 | Fax: +44 (0)1772 645 001
          E&Ninfo@assystemuk.com More information at www.assystem.com                                      FM 23790
Civil Engineering Capability

                                        Civil Engineering Services

Assystem is a leading international group providing Engineering and Consultancy services across a broad
range of product manufacturing and process sectors including Aerospace, Automotive, Defence, Energy,
Life Sciences, Naval and Nuclear industries.
Within these industries, Assystem have delivered civil engineering services in conjunction with other
aspects of the projects. We have a dedicated civil engineering team; capable of interacting with the
customer at all levels.
Our civil engineering capabilities can be accessed at national or local levels via our network of 10 UK
service centres.

Building Structural Design                                Market Sectors
(Design/Analysis and Detail)
                                                          ๏‚ท    Defence
๏‚ท   Sub Structure
                                                          ๏‚ท    Civil Nuclear
     ๏ƒž     Piled/pad foundations (BS 8004)                ๏‚ท    Health / Education / Residential
     ๏ƒž     Basements
     ๏ƒž     Retaining Walls (BS 8002)                      ๏‚ท    Industrial / Commercial / Retail

                                                          Safety
๏‚ท   Super Structure
                                                          ๏‚ท    CDM 2007
     ๏ƒž     Steel frame (BS 5950)
     ๏ƒž     Reinforced concrete (BS 8110)                  ๏‚ท    Safety case
     ๏ƒž     Composite                                      ๏‚ท    Risk assessments

๏‚ท   Envelope
                                                          ๏‚ท    Method statements
                                                          ๏‚ท    Continued Operational Safety Reports
     ๏ƒž     Masonry (BS 5628)                                  (COSR)
     ๏ƒž     Cold rolled cladding
     ๏ƒž     Concrete panels
                                                          ๏‚ท    HAZOP/HAZCON




         ENERGY & NUCLEAR
         Assystem UK Ltd | Club Street | Bamber Bridge | PRESTON | PR5 6FN | UK
         Tel.: +44 (0)1772 645 000 | Fax: +44 (0)1772 645 001
         E&Ninfo@assystemuk.com More information at www.assystem.com                                  FM 23790
Civil Engineering Capability

Structural Elements                                        Survey / Structural Assessments
Design and Detailing                                       ๏‚ท    Topographical surveys/Desktop studies
๏‚ท   Steelwork (BS 5950 / BS EN 1993)                       ๏‚ท    Condition/Refurbishment/Modification
     ๏ƒž      Mezzanines                                     ๏‚ท    Civil / Nuclear Decommissioning
     ๏ƒž
     ๏ƒž
            Staircases/ platforms
            Pipe bridges/plant support
                                                           ๏‚ท    Impact Assessment
     ๏ƒž      Connections
     ๏ƒž      Modular Construction
                                                           Construction Documentation
๏‚ท   Concrete (BS 8110 / ACI 318M)
     ๏ƒž      Pre cast foundations, including
                                                           ๏‚ท    Building Control Submissions
            retaining walls                                ๏‚ท    Basis of Designs
     ๏ƒž      Fire panels
     ๏ƒž      Flooring systems                               ๏‚ท    Design Method Statements
     ๏ƒž      Industrial floor slabs
     ๏ƒž      Culverts/ bridges (BS 5400)
                                                           ๏‚ท    Design Justifications Reports




Software
By utilising Assystemโ€™s internal resource together with strategic partners, projects can delivered to clients
using a wide variety of design and analysis software seamlessly integrating with existing customer IT
infrastructure.




          ENERGY & NUCLEAR
          Assystem UK Ltd | Club Street | Bamber Bridge | PRESTON | PR5 6FN | UK
          Tel.: +44 (0)1772 645 000 | Fax: +44 (0)1772 645 001
          E&Ninfo@assystemuk.com More information at www.assystem.com                                   FM 23790
Nuclear Process Piping Capability

                                          Nuclear Process Piping

Assystem is a leading international group providing Engineering and Consultancy services across a broad
range of product manufacturing and process sectors.

Nuclear Process Piping is carried out as a bespoke service and also as part of larger projects. On larger
projects design and analysis engineers work within the same office and develop the designs concurrently.

Our engineering capabilities can be accessed at national or local levels via our network of 10 UK service
centres.
Piping Capabilities
๏‚ท   Front End Piping Design
๏‚ท   P&IDs
๏‚ท   EFDs
๏‚ท   Detailed piping design
๏‚ท   Pipe support design
๏‚ท   Piping isometrics
๏‚ท   Flow calculations
๏‚ท   Pipe flow analysis
๏‚ท   Pipe stress analysis
๏‚ท   Fatigue analysis
๏‚ท   Pressure vessel assessment
๏‚ท   Seismic assessment and analysis
๏‚ท   Process simulation (e.g. pipe bending / straightening)
๏‚ท   HAZOP Studies

In-House Software
Design                               Flow Calculations                            Pipe Stress
๏‚ท   AutoCAD P&ID                     ๏‚ท    Fluidflow                               ๏‚ท   Caesar II
๏‚ท   AutoCAD Plant 3d                 ๏‚ท    Flowmaster                              ๏‚ท   Bentley AutoPIP (ADLPipe)
                                                                                  ๏‚ท   Whessoe PSA5




                                                                                      PSA5




         ENERGY & NUCLEAR
         Assystem UK Ltd | Club Street | Bamber Bridge | PRESTON | PR5 6FN | UK
         Tel.: +44 (0)1772 645 000 | Fax: +44 (0)1772 645 001
         E&Ninfo@assystemuk.com More information at www.assystem.com                                     FM 23790
Nuclear Process Piping Capability

Case Studies
Assystem has a wide ranging background of process piping experience with many examples in the
Nuclear sector.


CRTF Rig โ€“ Raynesway Engineering Laboratory
Full design of a rig to provide hot and pressurised water to two test
vessels. Assystemโ€™s scope includes the front end initial design,
development of final design, detailed drawings, P&IDโ€™s, flow
calculations and analysis, stress analysis, equipment and piping
support, flexibility analysis, HAZOP Studies and piping isometrics.



Wylfa Power Station - AETP Discharge Pipeline
Complete design and analysis for a replacement AETP discharge
pipeline. Assystemโ€™s scope of supply included site surveys, design
of pipes and supports, detail drawings, fabrication drawings,
structural and stress analysis of pipes and supports, design of
secondary containment system and leak detection system.



Hunterston โ€˜Aโ€™ Decommissioning Site โ€“ Modifications to AETP
Design, manufacture, installation and commissioning of a
replacement delay tank and ancillary systems and pipework.
Assystemโ€™s scope of supply included design of pipes and supports,
relocation of existing equipment, detail drawings, fabrication
drawings, structural and stress analysis of pipes and supports, tank
design and substantiation, design of secondary containment system
and leak detection system.



Trawsfynydd Fire Pump System โ€“ Improvements to meet Regulations
Design and analysis of new fire pump system to improve existing system. Extensions of existing lines
couples with new higher spec pumps to allow fire system to meet regulations. Assystemโ€™s scope of supply
included flow calculations, pump selection, pump installation, flow analysis, pipework design, pipework
detailing, pipe supports and stress analysis.




         ENERGY & NUCLEAR
         Assystem UK Ltd | Club Street | Bamber Bridge | PRESTON | PR5 6FN | UK
         Tel.: +44 (0)1772 645 000 | Fax: +44 (0)1772 645 001
         E&Ninfo@assystemuk.com More information at www.assystem.com                           FM 23790
Safety Engineering Capability

                                       Safety Engineering Services

Assystem is a leading international group providing Engineering solutions across a broad range of product
design development life cycle stages including Aerospace, Automotive, Defence, Energy, Life Sciences,
Petro-chemical/Oil & Gas, Naval and Nuclear industries.
Assystem have a dedicated energy and nuclear safety engineering team capable of providing a full suite
of safety engineering services to all stages of a project life cycle.



Services
๏‚ท   The supply of safety services to Customer
    requirements, including the role of Independent
    Safety Assessor / Auditor
๏‚ท   Design,   development      &   implementation      of
    Project Safety Management Systems
๏‚ท   Production and delivery of Product Safety Case
    documentation

Safety Management Systems
Assystem Safety Management Systems capability
includes:

๏‚ท   Conventional and nuclear safety analysis

๏‚ท   Risk Management

๏‚ท   Human Factors Analysis

๏‚ท   Safety, HF and ARM training

๏‚ท   Operation / Safe Systems of Work

๏‚ท   Analysis and derivation of product availability,
    reliability, maintainability   and     supportability
    requirements
๏‚ท   Decommissioning and disposal




         ENERGY & NUCLEAR
         Assystem UK Ltd | Club Street | Bamber Bridge | PRESTON | PR5 6FN | UK
         Tel.: +44 (0)1772 645 000 | Fax: +44 (0)1772 645 001
         E&Ninfo@assystemuk.com More information at www.assystem.com                             FM 23790
Safety Engineering Capability

Safety Case
Production of Safety Case documentation provides a record of the
decision-making process.
Assystem will provide a full range of Safety Case documentation
including:

๏‚ท   Risk Assessment, risk reduction, cost benefit analysis and risk
    acceptance to ALARP criteria
๏‚ท   Safety Standards and Strategy Development
๏‚ท   Physical and Functional Safety Assessments using the following
    techniques:
๏ƒž   Hazard and Operability Studies (HAZOP)
๏ƒž   Hazard Identification (HAZID) and Hazard Analysis (HAZAN)
๏ƒž   Failure Modes and Effects Analysis (FMEA)
๏ƒž   Failure Modes Effects & Criticality Analysis (FMECA)
๏ƒž   Fault Tree Analysis (FTA)
๏ƒž   Event Tree Analysis (ETA)

๏‚ท   Safety Engineering Services:

๏ƒž   Hazardous Area Classification
๏ƒž   Consequence assessments/hazardous material releases
๏ƒž   Fire safety assessment
๏ƒž   Chemical safety/occupational health risk assessment
๏ƒž   Explosion analysis
๏ƒž   Confined spaces risk assessment
๏ƒž   General risk assessment
๏ƒž   CDM design risk assessment
๏ƒž   Safety Integrity Level determination (Functional Safety โ€“ 61508/61511)
๏ƒž   Safety inspections/surveys
๏ƒž   Gap analysis/auditing of safety management systems.
๏ƒž   Pressure systems โ€˜Written Schemes of Examinationโ€™
๏ƒž   Pressure systems safety advice
๏ƒž   Pressure Equipment Directive

Quality
Assystem have the software capability to carry out safety assessments. The software can perform
techniques such as HAZOP, HAZID, HAZAN, FTA and ETA. PHAST software can be used for material
release and consequence analysis

Software
All Assystem UK sites are certified to BS EN ISO 9001:2008.

                                                                                     Cert No.
                                                                                     FM23790


         ENERGY & NUCLEAR
         Assystem UK Ltd | Club Street | Bamber Bridge | PRESTON | PR5 6FN | UK
         Tel.: +44 (0)1772 645 000 | Fax: +44 (0)1772 645 001
         E&Ninfo@assystemuk.com More information at www.assystem.com                    FM 23790
Seismic Analysis Capability

                                        Seismic Analysis Services
Seismic analysis is carried out as a bespoke service and also as part of larger projects within the Energy
and Nuclear division of the company.

Our civil engineering capabilities can be accessed at national or local levels via our network of 10 UK
service centres.


Seismic Assessment Capabilities
๏‚ท   Seismic substantiation performed using the following methods:
     ๏ƒž     Static equivalent method
     ๏ƒž     Response spectra method
     ๏ƒž     Time history method
๏‚ท   Stress analysis performed using hand calculation methods
    (MATHCAD) and finite element analysis
    (ANSYS, ABAQUS & LS-DYNA)
๏‚ท   Code checks performed to BS 2573, BS 5950 and ASME III Level D

๏‚ท   Generation of artificial acceleration time histories (SIMQKE) for given response spectra

๏‚ท   Generation of secondary response spectra for given time earthquake time history data


Typical Structures Analysed

๏‚ท   Component parts

๏‚ท   Cranes/Lifting equipment, Mechanical structures

๏‚ท   Structural steelwork, Buildings

Quality
All sites are certified to BS EN ISO 9001:2008 for design and manufacture. The quality management
system is managed from head office and also by quality managers within each facility.




         ENERGY & NUCLEAR
         Assystem UK Ltd | Club Street | Bamber Bridge | PRESTON | PR5 6FN | UK
         Tel.: +44 (0)1772 645 000 | Fax: +44 (0)1772 645 001
         E&Ninfo@assystemuk.com More information at www.assystem.com                              FM 23790
Seismic Analysis Capability

Case Study: Waste Vitrification Process (WVP)
Including details of Residue Export Facility (REF), In-Cell Cranes and Seismic De-
sign Substantiation
In support of the Design Substantiation Report (DSR) produced by
Sellafield Ltd., Assystem provided the as-built seismic design
substantiation of the In-Cell Cranes and their rail systems for WVP
REF. At the time, the equipment was already installed and
undergoing final commissioning but a robust seismic substantiation
from the design stage was lacking.

The substantiation was based on a response spectrum analysis of
beam element F.E. models of structures. These gave forces and
moments within structures from which code assessment of structural
members were made using spreadsheets whilst local design details
were assessed by hand calculations using Mathcad.                                 Overhead Jib crane
The main body of the report reflected the DSR content whilst the supporting detail was placed in
appendices; this enabled Sellafield Ltd. to quickly transfer the required information into the DSR.

Substantiation required demonstration of the ability to meet a number of System Functional Requirements
against the Design Basis Earthquake (DBE) loading with a further demonstration of margins against cliff
edge effects, the Margins Earthquake (1.4 times DBE). This was achieved by demonstrating that the
design maintained an elastic and ductile response under the DBE, using a code based assessment, with a
performance based assessment to provide confidence against cliff edge effects.

The assessment was based on a demonstration of an understanding of the ultimate failure modes of the
structure, taking into account:

๏‚ท   Redundancy or alternate load paths
๏‚ท   Ultimate capacity of components
๏‚ท   Reduced loading due to increased damping

A significant part of this demonstration was achieved based on the reserves demonstrated against the
DBE loading; where this could not provide the required confidence then an assessment was made using
one of the following:

๏‚ท   Reasoned argument (simple or in depth) with no further analysis
๏‚ท   Additional simple analysis
๏‚ท   Additional in depth analysis

Although the assessment raised a number of technical challenges it was completed successfully; the
report was accepted with only a small number of minor comments.

         ENERGY & NUCLEAR
         Assystem UK Ltd | Club Street | Bamber Bridge | PRESTON | PR5 6FN | UK
         Tel.: +44 (0)1772 645 000 | Fax: +44 (0)1772 645 001
         E&Ninfo@assystemuk.com More information at www.assystem.com                                   FM 23790
Marine Hydrodynamics Capability

                                    Marine Hydrodynamic Services

Assystem is a leading international group providing Engineering and Consultancy services across a broad
range of product manufacturing and process sectors.
Marine hydrodynamics analysis is carried out as a bespoke service and also as part of larger projects.
Our engineering capabilities can be accessed at national or local levels via our network of 10 UK service
centres.

Capabilities
Marine hydrodynamic analysis performed using the following approaches:
     ๏ƒž       OrcaFlex
     ๏ƒž       Abaqus Aqua
     ๏ƒž       Simulink & SimMechanics
     ๏ƒž       Probability & Monte Carlo analyses
     ๏ƒž       Hand calculations

๏‚ท   Marine hydrodynamic and wave physics expertise
๏‚ท   Mathematical modelling and time-domain simulation
๏‚ท   Physical modelling, prototyping and testing methodology
๏‚ท   Wave analysis for specific marine locations to accurately
    describe extreme events, and normal conditions to support
    design specification
๏‚ท   Vessel motion analysis: RAOโ€™s are used to convert
    wave analysis into vessel motion analysis, for any position
    on a vessel.

Vessel and wave motion analyses replace pessimistic rules of thumb and unnecessary safety factors and
feed into engineering design specification eliminating over-engineering and the associated costs and
difficulties it brings.

The above capabilities can add value to projects in many areas of offshore engineering.

Assystem UK has in-house experience in consulting and working within; offshore oil & gas, submarine
telecoms, marine defence, offshore wind, wave power generation and tidal power generation projects.




         ENERGY & NUCLEAR
         Assystem UK Ltd | Club Street | Bamber Bridge | PRESTON | PR5 6FN | UK
         Tel.: +44 (0)1772 645 000 | Fax: +44 (0)1772 645 001
         E&Ninfo@assystemuk.com More information at www.assystem.com                               FM 23790
Marine Hydrodynamics Capability

Case Study: Vessel Motion Analysis
Offshore equipment must be designed to withstand, or exploit, the forces and motions that are
experienced as a result of the waves and associated vessel motions. Vessel motion analysis acts to
provide a more complete understanding of what these forces and motions will be under normal
circumstances, and what extreme occurrences could be expected, and how often.

This understanding supports Lloydโ€™s and DNV codes and can feed straight into design reviews giving
engineers the confidence to choose more optimised designs or highlight potential issues to them. Thus
cost is saved through the reduction of over-engineering and time is saved through the reduction of design
iterations. It is most effective to use this approach as close to the concept design phase as possible.

The sample graphs below show common output types from vessel motion analysis. The upper graph
shows the probability distribution for exceeding a maximum surge acceleration within a specified time
window for a given position on a vessel. The lower graph shows what proportion of time is spent in
excess of a given resultant acceleration for a given position on a vessel.

In the examples shown the analysis was performed for given significant wave height values. All sea-states
of that height which occur at the location of interest were analysed, and the individual probabilities
combined and weighted appropriately to give a complete analysis for the wave heights of interest at the
location of interest.

The analysis shown below is specific
to one example, but similar analysis
can be tailored to customer needs. It
is common to perform similar
analysis for resultant and component
velocities and positions, as well as
accelerations. In addition, analysis
can be performed for water motions
or wave forces acting on subsea
equipment.




         ENERGY & NUCLEAR
         Assystem UK Ltd | Club Street | Bamber Bridge | PRESTON | PR5 6FN | UK
         Tel.: +44 (0)1772 645 000 | Fax: +44 (0)1772 645 001
         E&Ninfo@assystemuk.com More information at www.assystem.com                             FM 23790

Assystem Capabilities

  • 1.
    ENERGY & NUCLEAR ANEW PERSPECTIVE ON GROWTH
  • 2.
    Introduction to Assystem Product Design & Development Process & Plant Engineering Technology Development & Implementation Operation & Maintenance support Assystem is a leading international group providing Engineering and Consultancy services across a broad range of industry sectors. The UK branch of Assystem has 10 offices, a permanent workshop facility and approximately 1500 engineers. Energy & Nuclear is the oldest of the Assystem UK divisions, with a heritage spanning 40 years. Over that time Assystem UK has achieved an impressive record of growth and diversification and provides value- added services clients in Power Generation, Oil & Gas, Aerospace, Automotive, Defence, Marine and Life Sciences industries. Contract Models Assystem UK provides a full life cycle of design services that include concept design, detail design, mechanical and electrical control & instrumentation engineering, analysis, design substantiation, safety engineering, purchasing, assembly & testing and recruitment. Through its network of offices, Assystem provides a direct local interface to our customers, enabling a clearer understanding of client requirements and stronger working relationships. Delivery of the consultative and technical solutions is then delivered through the resources and technical structure at the local offices and technical centres of excellence throughout the country. ENERGY & NUCLEAR Assystem UK Ltd | Club Street | Bamber Bridge | PRESTON | PR5 6FN | UK Tel.: +44 (0)1772 645 000 | Fax: +44 (0)1772 645 001 E&Ninfo@assystemuk.com More information at www.assystem.com FM 23790
  • 3.
    Design Capability Design Engineering Services Assystem is a leading international group providing Engineering and Consultancy services across a broad range of product manufacturing and process sectors including the Aerospace, Automotive, Defence, Energy, Life Sciences, Naval and Nuclear industries. The Energy & Nuclear Division of Assystem UK Ltd. has a heritage spanning 40 years and over that time the group has achieved an impressive record of growth and diversification. The strength of the group lies in the ability to provide dedicated, multidiscipline project teams composed of specialist staff. There are currently 10 UK offices and one permanent Test & Development Facility. The company typically operates in four market areas: ๏‚ท Product Design & Development ๏‚ท Process & Plant Engineering ๏‚ท Technology Development & Implementation ๏‚ท Operation & Maintenance support Within these market areas, we provide a comprehensive array of services and products that include concept design, detail design, EC&I, engineering, analysis, substantiation, manufacturing, testing and recruitment. How we work Through its network of offices, Assystem provides a direct local interface between customers and the Assystem organisation. This enables us to establish a clear understanding of our clientโ€™s requirements. Delivery of the technical solutions is then facilitated by the resources, facilities and technical capabilities throughout the company at the local offices and technical centres. Design and Substantiation Product efficiency demands the linking of design and assessment to the required targets to be carried out concurrently to achieve the best designs in the shortest possible time. Assystem achieves this by embedding the analysis function within the design loop and ensuring that the lessons learnt from the functional performance of one iteration is fed back to the next: the design and analysis engineers sit next to each other and work on the designs concurrently. Design Capabilities: ๏‚ท Conceptual Design ๏‚ท Detail Design & Analysis ๏‚ท Multi-Disciplinary Engineering Design ๏‚ท Process Simulation & 3D Mock Ups ๏‚ท Design Studies ๏‚ท Detail design, manufacture & test ENERGY & NUCLEAR Assystem UK Ltd | Club Street | Bamber Bridge | PRESTON | PR5 6FN | UK Tel.: +44 (0)1772 645 000 | Fax: +44 (0)1772 645 001 E&Ninfo@assystemuk.com More information at www.assystem.com FM 23790
  • 4.
    Design Capability Case Studies UKAE Harwell - design and build Rolls-Royce Submarines - of a retrieval machine. fuelling/ defueling equipment. ๏‚ท Conceptual Design ๏‚ท Technology development ๏‚ท Detail design for manufacture. ๏‚ท Concept design ๏‚ท Procurement, systems ๏‚ท System Integration interrogation inactive ๏‚ท Mechanical seismic commissioning. verification and substantiation. British Energy - design and Nuclear industry - boiler lift rig build of graphite sampling ๏‚ท Strength and limit load machine. checks ๏‚ท Technology development ๏‚ท Seismic substantiation ๏‚ท Conceptual & detail design ๏‚ท BS2573 ๏‚ท Procurement construction & commissioning Nuclear industry - impact Nuclear Industry - cracked analysis of storage flask body analysis. ๏‚ท Concurrent design & ๏‚ท Cracked body analysis substantiation BS7910/R6 code checks ๏‚ท Explicit dynamic Analysis Capabilities: ๏‚ท Static, linear / non linear FEA (ANSYS, ๏‚ท Seismic assessment (ASCE4-98 / Eurocode 8) NASTRAN, ABAQUS) ๏ƒž Response spectrum and time history ๏‚ท Dynamic / impact (Dyna, RADIOSS, analysis (linear or nonlinear) ABAQUS) ๏‚ท Steelwork element design and detailing to ๏‚ท Thermal transient analysis BS5950 ๏ƒž Staircases / platforms ๏‚ท Design optimisation (OPTISTRUCT, ANSYS, ๏ƒž Building frames ABAQUS) ๏ƒž Canopies ๏‚ท Robustness Studies (HyperStudy, DoE) ๏‚ท Modular construction ๏‚ท Fatigue assessment ๏‚ท Concrete element design and detailing to BS8110 ๏ƒž Pre-cast ๏‚ท Pressure vessel assessment: ๏ƒž Flooring ๏ƒž ASME III, ASME VIII, TEMA, ASME/ ๏ƒž Fire panels ANSI B31) ๏‚ท Civil design ๏‚ท PD5500, EN13445, BS806 ๏ƒž Foundations and retaining walls (BS8004) ๏‚ท Fracture assessment (including Rcode and ๏ƒž Reinforced concrete (BS8110) BS7910) ๏‚ท Envelope (BS5628) ๏‚ท Crane and lifting equipment design and assessment to BS2573 / BS EN 13001 ENERGY & NUCLEAR Assystem UK Ltd | Club Street | Bamber Bridge | PRESTON | PR5 6FN | UK Tel.: +44 (0)1772 645 000 | Fax: +44 (0)1772 645 001 E&Ninfo@assystemuk.com More information at www.assystem.com FM 23790
  • 5.
    Mechanical Engineering Capability Mechanical Engineering Services Assystem UK Energy & Nuclear offers a world class mechanical engineering design service utilising a broad base of in-house skills relevant to the world energy market. Specialist knowledge developed over 40 years across a multi disciplined team, allows Assystem UK Energy & Nuclear to be a โ€œone stop shopโ€ for the delivery of cost effective technical solutions to clients for all phases of the project life cycle. Assystem UK Energy & Nuclear has proven expertise in the following: ๏‚ท๏€  Optioneering and feasibility studies ๏‚ท๏€  Front-end concept design ๏‚ท๏€  Detail design and the production of manufacturing drawings ๏‚ท๏€  Design substantiation, Independent Technical Assessment, ๏‚ท๏€  O&M manuals ๏‚ท๏€  Manufacture and Development of Special Purpose Equipment ๏‚ท๏€  Mechanical handling ๏‚ท๏€  Strategic planning ๏‚ท๏€  Project Management ๏‚ท๏€  Risk Analysis, FMECA, ARM, HAZOP, HAZID ๏‚ท๏€  Procurement, Inspection and Expediting ๏‚ท๏€  Research and development ๏‚ท๏€  Compliance with EU directives, CDM regulations, relevant safety codes and standards ๏‚ท๏€  Installation and commissioning ๏‚ท๏€  Product design and development ๏‚ท๏€  Building, plant and equipment surveys Projects can typically range from the provision of โ€˜front-endโ€™ designs for new concept machinery, to the assembly and development of bespoke mechanisms and equipment to clientsโ€™ individual specifications. For all projects, the company operates a Quality Assurance system to ISO 9001:2008, which is certified externally by the British Standards Institution, in addition to any other project-specific requirements. Assystem UK Energy & Nuclearโ€™s design and problem solving ability is backed by comprehensive technical analytical support such as: ๏‚ท๏€  2D/3D CAD Drawing and modelling (AutoCAD, Pro E, Inventor, ๏‚ท๏€  SolidWorks, Catia) ๏‚ท๏€  FE Stress analysis (thermal, static, dynamic) ๏‚ท๏€  Seismic analysis โ€“ equipment and buildings ๏‚ท๏€  Systems engineers, computer specialists, electronic engineers and ๏‚ท๏€  electrical/ instrument engineers ๏‚ท๏€  3D Simulation ๏‚ท๏€  Project planning using Microsoft Project and Primavera ENERGY & NUCLEAR Assystem UK Ltd | Club Street | Bamber Bridge | PRESTON | PR5 6FN | UK Tel.: +44 (0)1772 645 000 | Fax: +44 (0)1772 645 001 E&Ninfo@assystemuk.com More information at www.assystem.com FM 23790
  • 6.
    Mechanical Engineering Capability TypicalEquipment & Processes ๏‚ท๏€  Remote engineering; robotics, manipulators, remote viewing, shield doors, through-wall drives ๏‚ท๏€  Mechanical handling including bogies, conveyors, cranes ๏‚ท๏€  Mechanical equipment including compactors, powder processing, fuel fabrication & assembly ๏‚ท๏€  Wet process equipment engineering including vessels, piping, pumps, heat exchangers and other process plant and installation ๏‚ท๏€  Nuclear transport equipment including flasks, containers ๏‚ท๏€  Nuclear containment & ventilation including ventilation systems, fans, heating, ducting, filters ๏‚ท๏€  Services including steam, gases, water, electrical, fire protection, security etc. ๏‚ท๏€  Alpha plant engineering & equipment including gloveboxes ๏‚ท๏€  Engineering substantiation, technical assessment of equipment capability and justification of adequacy; ๏‚ท๏€  FMEA & ARM ๏‚ท๏€  Process plant including encapsulation ๏‚ท๏€  Safety case โ€“ support and supervision Case Studies AGR Graphite Sampling System โ€“ British Energy (Barnwood) Assystem UK designed and supplied a graphite sampling system for deployment inside the fuel channels of AGR reactors. The equipment incorporated a remote trepanning tool, precision tool alignment mechanisms, sample conveying system and a CCTV and operator control system. Synchrotron โ€“ DLS Assystem UK has been closely involved in the design of the Diamond Light Source Synchrotron - the largest science facility to be funded in the UK for over 30 years and costing ยฃ350m. Assystem UKโ€™s team of up to 25 engineers have been responsible for the design of many of the high precision mechanisms and support systems associated with the accelerator. Nuclear waste retrieval machine โ€“ UKAEA Assystem UK designed and developed a waste retrieval facility for the removal of intermediate level waste canisters from the B462.9 tube store at UKAEA Harwell. The innovative design consists of a 3 cubic metre 220 ton shielded containment enclosing a retrieval hoist, grabs and a waste export system. ENERGY & NUCLEAR Assystem UK Ltd | Club Street | Bamber Bridge | PRESTON | PR5 6FN | UK Tel.: +44 (0)1772 645 000 | Fax: +44 (0)1772 645 001 E&Ninfo@assystemuk.com More information at www.assystem.com FM 23790
  • 7.
    Control, Electrical andInstrumentation Capability Control, Electrical & Instrumentation Our substantial Electrical, Control and Instrumentation (C,E&I) capabilities range from initial concept development through design, in-house assembly, installation, commissioning and through-life maintenance support. Assystem UK Energy and Nuclear has in-house systems engineers, computer specialists, electronic engineers and electrical/ instrument engineers whose combined experience can be used to complete the most demanding of projects. This includes complex safety critical control systems or nuclear applications enabling us to provide complete and fully integrated solutions. Furthermore, our C,E&I engineers are highly experienced in working alongside other engineering disciplines to provide a total system integration capability. Capability Scope Our capabilities cover a broad range of the C,E&I spectrum. These include: Control Electrical Instrumentation ๏‚ท Embedded real-time systems ๏‚ท Site surveys ๏‚ท In-line testing ๏‚ท SCADA and data-logging ๏‚ท Cabling design ๏‚ท Radiometrics ๏‚ท Networks ๏‚ท Site installation ๏‚ท Process ๏‚ท PLC systems ๏‚ท Building services including instrumentation ๏‚ท Operator interfaces and HMIs lighting, earthing, and power distribution ๏‚ท Safety system design and substantiation. ๏‚ท Bespoke electronics ENERGY & NUCLEAR Assystem UK Ltd | Club Street | Bamber Bridge | PRESTON | PR5 6FN | UK Tel.: +44 (0)1772 645 000 | Fax: +44 (0)1772 645 001 E&Ninfo@assystemuk.com More information at www.assystem.com FM 23790
  • 8.
    Control, Electrical andInstrumentation Capability Safety Engineering Assystem have extensive experience in the design and substantiation of Safety Instrumented Systems and are familiar with the requirements of IEC61508 and IEC61511. A number of our engineers have undergone training in Sellafield Sites Ltd engineering guide for safety systems, EG90, and have also successfully completed other customer specific but broadly applicable training in the realisation and documentation of Safety Systems. Toolsets Our engineers are experienced in the use of a wide variety of tools and applications for the design and development of software and hardware systems. We have a number of engineers with extensive experience in the development of PLC systems, under IEC61131 and various customer specific standards, for a variety of PLC platforms including Rockwell / Allen Bradley SLC series and Siemens S7. We also have experience with older systems such as Allen Bradley PLC5 giving us the capability to reverse engineer legacy systems in order to upgrade or replace them. โ€˜Reliability Workbenchโ€™ with โ€˜Fault Tree Plusโ€™ are used for the design and validation of Safety Systems and several of our engineers are trained and experienced in its use. Rapid development of test systems and less critical control systems is undertaken using National Instruments LabView for which we have a full development environment with many of the popular control and instrumentation sub-packages. We have several engineers experienced with the use of real time operating environments such as VxWorks and their application in the realisation of embedded real time systems. Designs and drawings are produced using AutoCAD electrical which allows us to use a component based approach to the creation of schematic diagrams and panel designs. Amtech is used for undertaking and checking cable calculations. All of our engineers are accustomed to being required to use a myriad of other proprietary and bespoke packages as necessary to satisfy the requirements of specific projects. These include design tools, software development systems and modelling packages. Engineering Services Include: Hardware Design: Overall Systems Integration - High Integrity Protection Control Systems - Safety Instrumented Systems - Robotics & Remote Handling - Bespoke Electronics - MCC & Panel Design & Wiring - HVDC - Cable Design - Building Management Systems - Industrial Networking - Process Instrumentation - Power Distribution. Software Design: PLC - Embedded Systems - SCADA & HMI Design and Testing. ENERGY & NUCLEAR Assystem UK Ltd | Club Street | Bamber Bridge | PRESTON | PR5 6FN | UK Tel.: +44 (0)1772 645 000 | Fax: +44 (0)1772 645 001 E&Ninfo@assystemuk.com More information at www.assystem.com FM 23790
  • 9.
    Finite Element AnalysisCapability Finite Element Analysis Finite element analysis is carried out as a bespoke service and also as part of larger projects. On larger projects design and analysis engineers work within the same office and develop the designs concurrently. FEA Capabilities ๏‚ท Static, linear / non-linear analysis ๏‚ท Fatigue assessment ๏‚ท Dynamic / impact analysis ๏‚ท Pressure vessel assessment ๏‚ท Thermal transient analysis ๏‚ท Fracture assessment ๏‚ท Design optimisation ๏‚ท Seismic assessment and analysis ๏‚ท Robustness studies ๏‚ท Hyperelastic material (e.g. rubber) simulation ๏‚ท Computational Fluid Dynamics (CFD) ๏‚ท Process simulation (e.g. pipe bending / ๏‚ท DoE & response surface modelling straightening) ENERGY & NUCLEAR Assystem UK Ltd | Club Street | Bamber Bridge | PRESTON | PR5 6FN | UK Tel.: +44 (0)1772 645 000 | Fax: +44 (0)1772 645 001 E&Ninfo@assystemuk.com More information at www.assystem.com FM 23790
  • 10.
    Finite Element AnalysisCapability Case Study: Flask Impact Design Substantiation To support and substantiate the design of a nuclear storage flask and internal assembly, dynamic impact analysis was performed by Assystem UK to show that the ability of the container to safely hold its contents would not be comprised through any impact that could occur through being dropped during transit. The flask has been designed to provide a safe method of containment for nuclear material. The flasks are to be kept in a storage facility where drop scenarios are possible. Two drop heights were analysed, each with nine different drop orientations (see example, bottom right). The FEA mesh of the flask components was generated using Altair Hypermesh and analysed using RADIOSS v.4.4u, both of which are part of the Altair Hyperworks suite. The study identified five different possible failure modes, each of which was investigated for both drop heights and all drop orientations. The mode of most concern was the failure of the dynamic sealing of the flask. This involves the seals being momentarily misaligned during impact and allowing the escape of a limited, but dangerous, amount of gas. The substantiation showed that, with the design and drop heights specified, the ability of the flask to hold its contents would not be compromised. This design was physically tested at the Assystem UK workshop facility, and all tests were in agreement with the above analysis. ENERGY & NUCLEAR Assystem UK Ltd | Club Street | Bamber Bridge | PRESTON | PR5 6FN | UK Tel.: +44 (0)1772 645 000 | Fax: +44 (0)1772 645 001 E&Ninfo@assystemuk.com More information at www.assystem.com FM 23790
  • 11.
    Fracture Analysis Capability Fracture Analysis Fracture analysis is carried out as a bespoke service and also as part of larger projects within the Energy and Nuclear division of Assystem UK Limited. Our analysis capabilities can be accessed at National or local levels via our network of 10 UK service centres. Assystem can perform R6 Procedure structural integrity assessments on structural components containing defects. Defects: (NDE, postulated, maximum Defects assumed in reasonably foreseeable Virgin attachment welds. Using R-CODE Assystem can define and subsequently assess geometry specific solutions. Un-cracked and cracked finite element analysis models are used to generate crack opening stresses and SIFs. Modification of geometry codes undertaken to account for specific geometry (SIF solution modified using FEA results). Geometry code sensitivity is undertaken for each assessment. Un-cracked geometry Defect Maximum Minimum K (mm) K (MPa๏ƒ–m) (MPa๏ƒ–m) 0.5 8.0 -21.2 1.0 9.1 -23.2 1.5 9.4 -23.5 4.0 7.8 -18.1 Cracked geometry Critical flaw size calculations (calculates maximum defect size and proximity to brittle / plastic collapse). Assystem can determine the limiting start of life defect size that would grow to the limiting critical flaw size during the assumed operational life from which acceptance criteria (targets based on material toughness) are specified. General Failure Assessment Diagram Start of Life Defect Vs. End of Life Defect Fatigue Crack Growth made under known cyclic loading ENERGY & NUCLEAR Assystem UK Ltd | Club Street | Bamber Bridge | PRESTON | PR5 6FN | UK Tel.: +44 (0)1772 645 000 | Fax: +44 (0)1772 645 001 E&Ninfo@assystemuk.com More information at www.assystem.com FM 23790
  • 12.
    Fracture Analysis Capability Presentationof Margins of Safety Fracture margins based on material fracture toughness with respect to operational temperatures (including transition regions). These calculations account for crack tip plasticity and allow safe operating temperatures to be identified Cracked body analysis can be carried out for assessments against the Failure Assessment Diagrams (FAD). Finite element analysis is used to determine the Kr (J-integral) and Limit Load Analysis to determine Lr. Pressure vessel design and assessment to all major codes (ASME III / VIII, PD5500, EN13445 etc.) Primary circuit and secondary side components (eg steam generators, regenerative heat exchangers). Design and hydrotest conditions and Level A (fatigue) operation. Recent assessments moving towards strain predictions and away from stress linearisation (or planarisation). Fatigue life evaluation (or re- evaluation based on measured transient blackbox information) carried out in accordance with design codes (eg ASME III) or using modern stress-life and strain-life techniques. A key aspect in plant operation is life extension (aging plant or extension of existing Safety Justifications) therefore knowledge of pessimisms in fatigue calculation is vitally important. Public domain RPV Fatigue evaluation can be carried out elastically in accordance with design rule codes, or optionally, elasto-plastically to check for shakedown as well as provide strain ranges for strain-based fatigue calculation. Non-linear material models (e.g. nonlinear kinematic plasticity) used in assessment with life-cycle loading applied. ENERGY & NUCLEAR Assystem UK Ltd | Club Street | Bamber Bridge | PRESTON | PR5 6FN | UK Tel.: +44 (0)1772 645 000 | Fax: +44 (0)1772 645 001 E&Ninfo@assystemuk.com More information at www.assystem.com FM 23790
  • 13.
    Civil Engineering Capability Civil Engineering Services Assystem is a leading international group providing Engineering and Consultancy services across a broad range of product manufacturing and process sectors including Aerospace, Automotive, Defence, Energy, Life Sciences, Naval and Nuclear industries. Within these industries, Assystem have delivered civil engineering services in conjunction with other aspects of the projects. We have a dedicated civil engineering team; capable of interacting with the customer at all levels. Our civil engineering capabilities can be accessed at national or local levels via our network of 10 UK service centres. Building Structural Design Market Sectors (Design/Analysis and Detail) ๏‚ท Defence ๏‚ท Sub Structure ๏‚ท Civil Nuclear ๏ƒž Piled/pad foundations (BS 8004) ๏‚ท Health / Education / Residential ๏ƒž Basements ๏ƒž Retaining Walls (BS 8002) ๏‚ท Industrial / Commercial / Retail Safety ๏‚ท Super Structure ๏‚ท CDM 2007 ๏ƒž Steel frame (BS 5950) ๏ƒž Reinforced concrete (BS 8110) ๏‚ท Safety case ๏ƒž Composite ๏‚ท Risk assessments ๏‚ท Envelope ๏‚ท Method statements ๏‚ท Continued Operational Safety Reports ๏ƒž Masonry (BS 5628) (COSR) ๏ƒž Cold rolled cladding ๏ƒž Concrete panels ๏‚ท HAZOP/HAZCON ENERGY & NUCLEAR Assystem UK Ltd | Club Street | Bamber Bridge | PRESTON | PR5 6FN | UK Tel.: +44 (0)1772 645 000 | Fax: +44 (0)1772 645 001 E&Ninfo@assystemuk.com More information at www.assystem.com FM 23790
  • 14.
    Civil Engineering Capability StructuralElements Survey / Structural Assessments Design and Detailing ๏‚ท Topographical surveys/Desktop studies ๏‚ท Steelwork (BS 5950 / BS EN 1993) ๏‚ท Condition/Refurbishment/Modification ๏ƒž Mezzanines ๏‚ท Civil / Nuclear Decommissioning ๏ƒž ๏ƒž Staircases/ platforms Pipe bridges/plant support ๏‚ท Impact Assessment ๏ƒž Connections ๏ƒž Modular Construction Construction Documentation ๏‚ท Concrete (BS 8110 / ACI 318M) ๏ƒž Pre cast foundations, including ๏‚ท Building Control Submissions retaining walls ๏‚ท Basis of Designs ๏ƒž Fire panels ๏ƒž Flooring systems ๏‚ท Design Method Statements ๏ƒž Industrial floor slabs ๏ƒž Culverts/ bridges (BS 5400) ๏‚ท Design Justifications Reports Software By utilising Assystemโ€™s internal resource together with strategic partners, projects can delivered to clients using a wide variety of design and analysis software seamlessly integrating with existing customer IT infrastructure. ENERGY & NUCLEAR Assystem UK Ltd | Club Street | Bamber Bridge | PRESTON | PR5 6FN | UK Tel.: +44 (0)1772 645 000 | Fax: +44 (0)1772 645 001 E&Ninfo@assystemuk.com More information at www.assystem.com FM 23790
  • 15.
    Nuclear Process PipingCapability Nuclear Process Piping Assystem is a leading international group providing Engineering and Consultancy services across a broad range of product manufacturing and process sectors. Nuclear Process Piping is carried out as a bespoke service and also as part of larger projects. On larger projects design and analysis engineers work within the same office and develop the designs concurrently. Our engineering capabilities can be accessed at national or local levels via our network of 10 UK service centres. Piping Capabilities ๏‚ท Front End Piping Design ๏‚ท P&IDs ๏‚ท EFDs ๏‚ท Detailed piping design ๏‚ท Pipe support design ๏‚ท Piping isometrics ๏‚ท Flow calculations ๏‚ท Pipe flow analysis ๏‚ท Pipe stress analysis ๏‚ท Fatigue analysis ๏‚ท Pressure vessel assessment ๏‚ท Seismic assessment and analysis ๏‚ท Process simulation (e.g. pipe bending / straightening) ๏‚ท HAZOP Studies In-House Software Design Flow Calculations Pipe Stress ๏‚ท AutoCAD P&ID ๏‚ท Fluidflow ๏‚ท Caesar II ๏‚ท AutoCAD Plant 3d ๏‚ท Flowmaster ๏‚ท Bentley AutoPIP (ADLPipe) ๏‚ท Whessoe PSA5 PSA5 ENERGY & NUCLEAR Assystem UK Ltd | Club Street | Bamber Bridge | PRESTON | PR5 6FN | UK Tel.: +44 (0)1772 645 000 | Fax: +44 (0)1772 645 001 E&Ninfo@assystemuk.com More information at www.assystem.com FM 23790
  • 16.
    Nuclear Process PipingCapability Case Studies Assystem has a wide ranging background of process piping experience with many examples in the Nuclear sector. CRTF Rig โ€“ Raynesway Engineering Laboratory Full design of a rig to provide hot and pressurised water to two test vessels. Assystemโ€™s scope includes the front end initial design, development of final design, detailed drawings, P&IDโ€™s, flow calculations and analysis, stress analysis, equipment and piping support, flexibility analysis, HAZOP Studies and piping isometrics. Wylfa Power Station - AETP Discharge Pipeline Complete design and analysis for a replacement AETP discharge pipeline. Assystemโ€™s scope of supply included site surveys, design of pipes and supports, detail drawings, fabrication drawings, structural and stress analysis of pipes and supports, design of secondary containment system and leak detection system. Hunterston โ€˜Aโ€™ Decommissioning Site โ€“ Modifications to AETP Design, manufacture, installation and commissioning of a replacement delay tank and ancillary systems and pipework. Assystemโ€™s scope of supply included design of pipes and supports, relocation of existing equipment, detail drawings, fabrication drawings, structural and stress analysis of pipes and supports, tank design and substantiation, design of secondary containment system and leak detection system. Trawsfynydd Fire Pump System โ€“ Improvements to meet Regulations Design and analysis of new fire pump system to improve existing system. Extensions of existing lines couples with new higher spec pumps to allow fire system to meet regulations. Assystemโ€™s scope of supply included flow calculations, pump selection, pump installation, flow analysis, pipework design, pipework detailing, pipe supports and stress analysis. ENERGY & NUCLEAR Assystem UK Ltd | Club Street | Bamber Bridge | PRESTON | PR5 6FN | UK Tel.: +44 (0)1772 645 000 | Fax: +44 (0)1772 645 001 E&Ninfo@assystemuk.com More information at www.assystem.com FM 23790
  • 17.
    Safety Engineering Capability Safety Engineering Services Assystem is a leading international group providing Engineering solutions across a broad range of product design development life cycle stages including Aerospace, Automotive, Defence, Energy, Life Sciences, Petro-chemical/Oil & Gas, Naval and Nuclear industries. Assystem have a dedicated energy and nuclear safety engineering team capable of providing a full suite of safety engineering services to all stages of a project life cycle. Services ๏‚ท The supply of safety services to Customer requirements, including the role of Independent Safety Assessor / Auditor ๏‚ท Design, development & implementation of Project Safety Management Systems ๏‚ท Production and delivery of Product Safety Case documentation Safety Management Systems Assystem Safety Management Systems capability includes: ๏‚ท Conventional and nuclear safety analysis ๏‚ท Risk Management ๏‚ท Human Factors Analysis ๏‚ท Safety, HF and ARM training ๏‚ท Operation / Safe Systems of Work ๏‚ท Analysis and derivation of product availability, reliability, maintainability and supportability requirements ๏‚ท Decommissioning and disposal ENERGY & NUCLEAR Assystem UK Ltd | Club Street | Bamber Bridge | PRESTON | PR5 6FN | UK Tel.: +44 (0)1772 645 000 | Fax: +44 (0)1772 645 001 E&Ninfo@assystemuk.com More information at www.assystem.com FM 23790
  • 18.
    Safety Engineering Capability SafetyCase Production of Safety Case documentation provides a record of the decision-making process. Assystem will provide a full range of Safety Case documentation including: ๏‚ท Risk Assessment, risk reduction, cost benefit analysis and risk acceptance to ALARP criteria ๏‚ท Safety Standards and Strategy Development ๏‚ท Physical and Functional Safety Assessments using the following techniques: ๏ƒž Hazard and Operability Studies (HAZOP) ๏ƒž Hazard Identification (HAZID) and Hazard Analysis (HAZAN) ๏ƒž Failure Modes and Effects Analysis (FMEA) ๏ƒž Failure Modes Effects & Criticality Analysis (FMECA) ๏ƒž Fault Tree Analysis (FTA) ๏ƒž Event Tree Analysis (ETA) ๏‚ท Safety Engineering Services: ๏ƒž Hazardous Area Classification ๏ƒž Consequence assessments/hazardous material releases ๏ƒž Fire safety assessment ๏ƒž Chemical safety/occupational health risk assessment ๏ƒž Explosion analysis ๏ƒž Confined spaces risk assessment ๏ƒž General risk assessment ๏ƒž CDM design risk assessment ๏ƒž Safety Integrity Level determination (Functional Safety โ€“ 61508/61511) ๏ƒž Safety inspections/surveys ๏ƒž Gap analysis/auditing of safety management systems. ๏ƒž Pressure systems โ€˜Written Schemes of Examinationโ€™ ๏ƒž Pressure systems safety advice ๏ƒž Pressure Equipment Directive Quality Assystem have the software capability to carry out safety assessments. The software can perform techniques such as HAZOP, HAZID, HAZAN, FTA and ETA. PHAST software can be used for material release and consequence analysis Software All Assystem UK sites are certified to BS EN ISO 9001:2008. Cert No. FM23790 ENERGY & NUCLEAR Assystem UK Ltd | Club Street | Bamber Bridge | PRESTON | PR5 6FN | UK Tel.: +44 (0)1772 645 000 | Fax: +44 (0)1772 645 001 E&Ninfo@assystemuk.com More information at www.assystem.com FM 23790
  • 19.
    Seismic Analysis Capability Seismic Analysis Services Seismic analysis is carried out as a bespoke service and also as part of larger projects within the Energy and Nuclear division of the company. Our civil engineering capabilities can be accessed at national or local levels via our network of 10 UK service centres. Seismic Assessment Capabilities ๏‚ท Seismic substantiation performed using the following methods: ๏ƒž Static equivalent method ๏ƒž Response spectra method ๏ƒž Time history method ๏‚ท Stress analysis performed using hand calculation methods (MATHCAD) and finite element analysis (ANSYS, ABAQUS & LS-DYNA) ๏‚ท Code checks performed to BS 2573, BS 5950 and ASME III Level D ๏‚ท Generation of artificial acceleration time histories (SIMQKE) for given response spectra ๏‚ท Generation of secondary response spectra for given time earthquake time history data Typical Structures Analysed ๏‚ท Component parts ๏‚ท Cranes/Lifting equipment, Mechanical structures ๏‚ท Structural steelwork, Buildings Quality All sites are certified to BS EN ISO 9001:2008 for design and manufacture. The quality management system is managed from head office and also by quality managers within each facility. ENERGY & NUCLEAR Assystem UK Ltd | Club Street | Bamber Bridge | PRESTON | PR5 6FN | UK Tel.: +44 (0)1772 645 000 | Fax: +44 (0)1772 645 001 E&Ninfo@assystemuk.com More information at www.assystem.com FM 23790
  • 20.
    Seismic Analysis Capability CaseStudy: Waste Vitrification Process (WVP) Including details of Residue Export Facility (REF), In-Cell Cranes and Seismic De- sign Substantiation In support of the Design Substantiation Report (DSR) produced by Sellafield Ltd., Assystem provided the as-built seismic design substantiation of the In-Cell Cranes and their rail systems for WVP REF. At the time, the equipment was already installed and undergoing final commissioning but a robust seismic substantiation from the design stage was lacking. The substantiation was based on a response spectrum analysis of beam element F.E. models of structures. These gave forces and moments within structures from which code assessment of structural members were made using spreadsheets whilst local design details were assessed by hand calculations using Mathcad. Overhead Jib crane The main body of the report reflected the DSR content whilst the supporting detail was placed in appendices; this enabled Sellafield Ltd. to quickly transfer the required information into the DSR. Substantiation required demonstration of the ability to meet a number of System Functional Requirements against the Design Basis Earthquake (DBE) loading with a further demonstration of margins against cliff edge effects, the Margins Earthquake (1.4 times DBE). This was achieved by demonstrating that the design maintained an elastic and ductile response under the DBE, using a code based assessment, with a performance based assessment to provide confidence against cliff edge effects. The assessment was based on a demonstration of an understanding of the ultimate failure modes of the structure, taking into account: ๏‚ท Redundancy or alternate load paths ๏‚ท Ultimate capacity of components ๏‚ท Reduced loading due to increased damping A significant part of this demonstration was achieved based on the reserves demonstrated against the DBE loading; where this could not provide the required confidence then an assessment was made using one of the following: ๏‚ท Reasoned argument (simple or in depth) with no further analysis ๏‚ท Additional simple analysis ๏‚ท Additional in depth analysis Although the assessment raised a number of technical challenges it was completed successfully; the report was accepted with only a small number of minor comments. ENERGY & NUCLEAR Assystem UK Ltd | Club Street | Bamber Bridge | PRESTON | PR5 6FN | UK Tel.: +44 (0)1772 645 000 | Fax: +44 (0)1772 645 001 E&Ninfo@assystemuk.com More information at www.assystem.com FM 23790
  • 21.
    Marine Hydrodynamics Capability Marine Hydrodynamic Services Assystem is a leading international group providing Engineering and Consultancy services across a broad range of product manufacturing and process sectors. Marine hydrodynamics analysis is carried out as a bespoke service and also as part of larger projects. Our engineering capabilities can be accessed at national or local levels via our network of 10 UK service centres. Capabilities Marine hydrodynamic analysis performed using the following approaches: ๏ƒž OrcaFlex ๏ƒž Abaqus Aqua ๏ƒž Simulink & SimMechanics ๏ƒž Probability & Monte Carlo analyses ๏ƒž Hand calculations ๏‚ท Marine hydrodynamic and wave physics expertise ๏‚ท Mathematical modelling and time-domain simulation ๏‚ท Physical modelling, prototyping and testing methodology ๏‚ท Wave analysis for specific marine locations to accurately describe extreme events, and normal conditions to support design specification ๏‚ท Vessel motion analysis: RAOโ€™s are used to convert wave analysis into vessel motion analysis, for any position on a vessel. Vessel and wave motion analyses replace pessimistic rules of thumb and unnecessary safety factors and feed into engineering design specification eliminating over-engineering and the associated costs and difficulties it brings. The above capabilities can add value to projects in many areas of offshore engineering. Assystem UK has in-house experience in consulting and working within; offshore oil & gas, submarine telecoms, marine defence, offshore wind, wave power generation and tidal power generation projects. ENERGY & NUCLEAR Assystem UK Ltd | Club Street | Bamber Bridge | PRESTON | PR5 6FN | UK Tel.: +44 (0)1772 645 000 | Fax: +44 (0)1772 645 001 E&Ninfo@assystemuk.com More information at www.assystem.com FM 23790
  • 22.
    Marine Hydrodynamics Capability CaseStudy: Vessel Motion Analysis Offshore equipment must be designed to withstand, or exploit, the forces and motions that are experienced as a result of the waves and associated vessel motions. Vessel motion analysis acts to provide a more complete understanding of what these forces and motions will be under normal circumstances, and what extreme occurrences could be expected, and how often. This understanding supports Lloydโ€™s and DNV codes and can feed straight into design reviews giving engineers the confidence to choose more optimised designs or highlight potential issues to them. Thus cost is saved through the reduction of over-engineering and time is saved through the reduction of design iterations. It is most effective to use this approach as close to the concept design phase as possible. The sample graphs below show common output types from vessel motion analysis. The upper graph shows the probability distribution for exceeding a maximum surge acceleration within a specified time window for a given position on a vessel. The lower graph shows what proportion of time is spent in excess of a given resultant acceleration for a given position on a vessel. In the examples shown the analysis was performed for given significant wave height values. All sea-states of that height which occur at the location of interest were analysed, and the individual probabilities combined and weighted appropriately to give a complete analysis for the wave heights of interest at the location of interest. The analysis shown below is specific to one example, but similar analysis can be tailored to customer needs. It is common to perform similar analysis for resultant and component velocities and positions, as well as accelerations. In addition, analysis can be performed for water motions or wave forces acting on subsea equipment. ENERGY & NUCLEAR Assystem UK Ltd | Club Street | Bamber Bridge | PRESTON | PR5 6FN | UK Tel.: +44 (0)1772 645 000 | Fax: +44 (0)1772 645 001 E&Ninfo@assystemuk.com More information at www.assystem.com FM 23790
