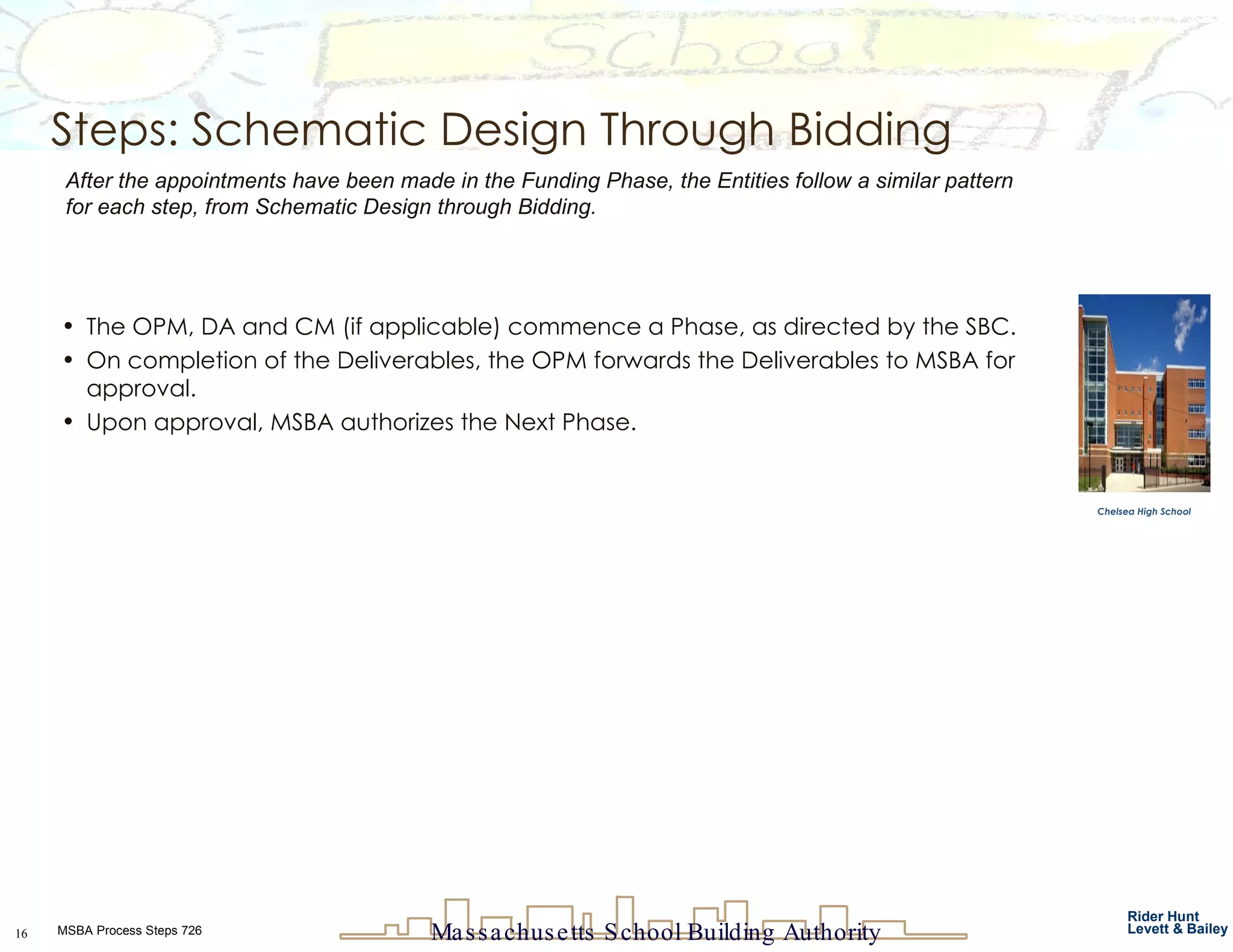

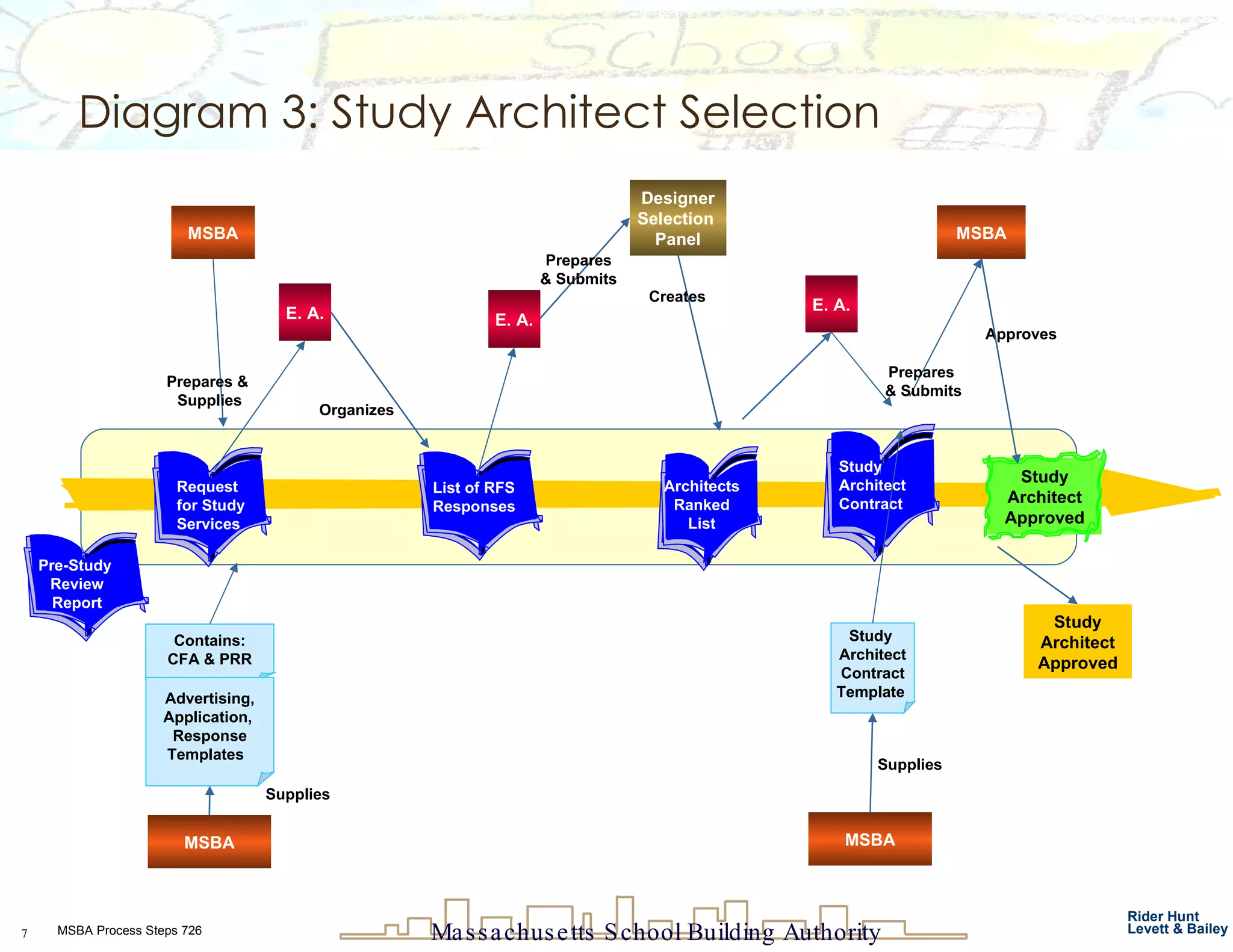

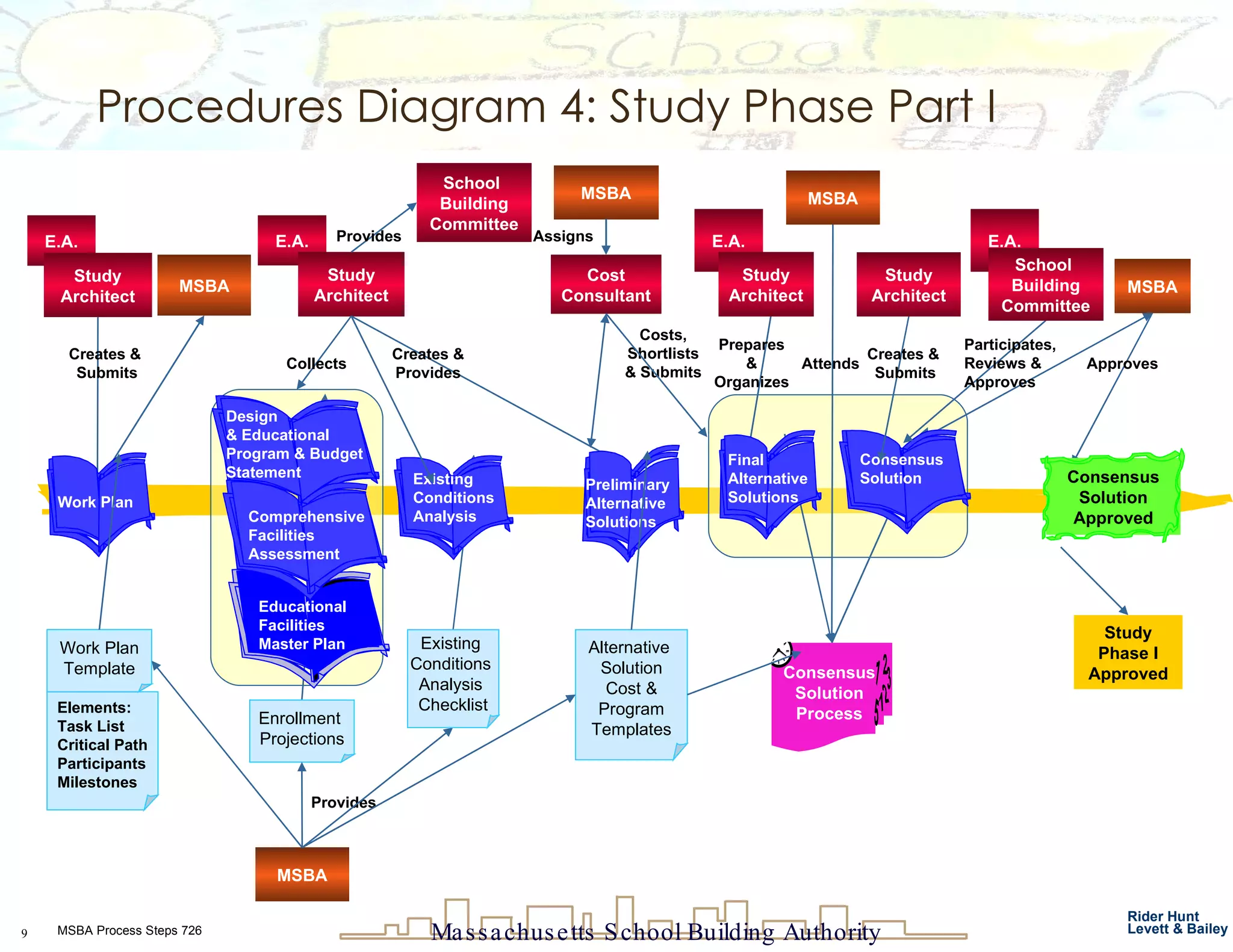

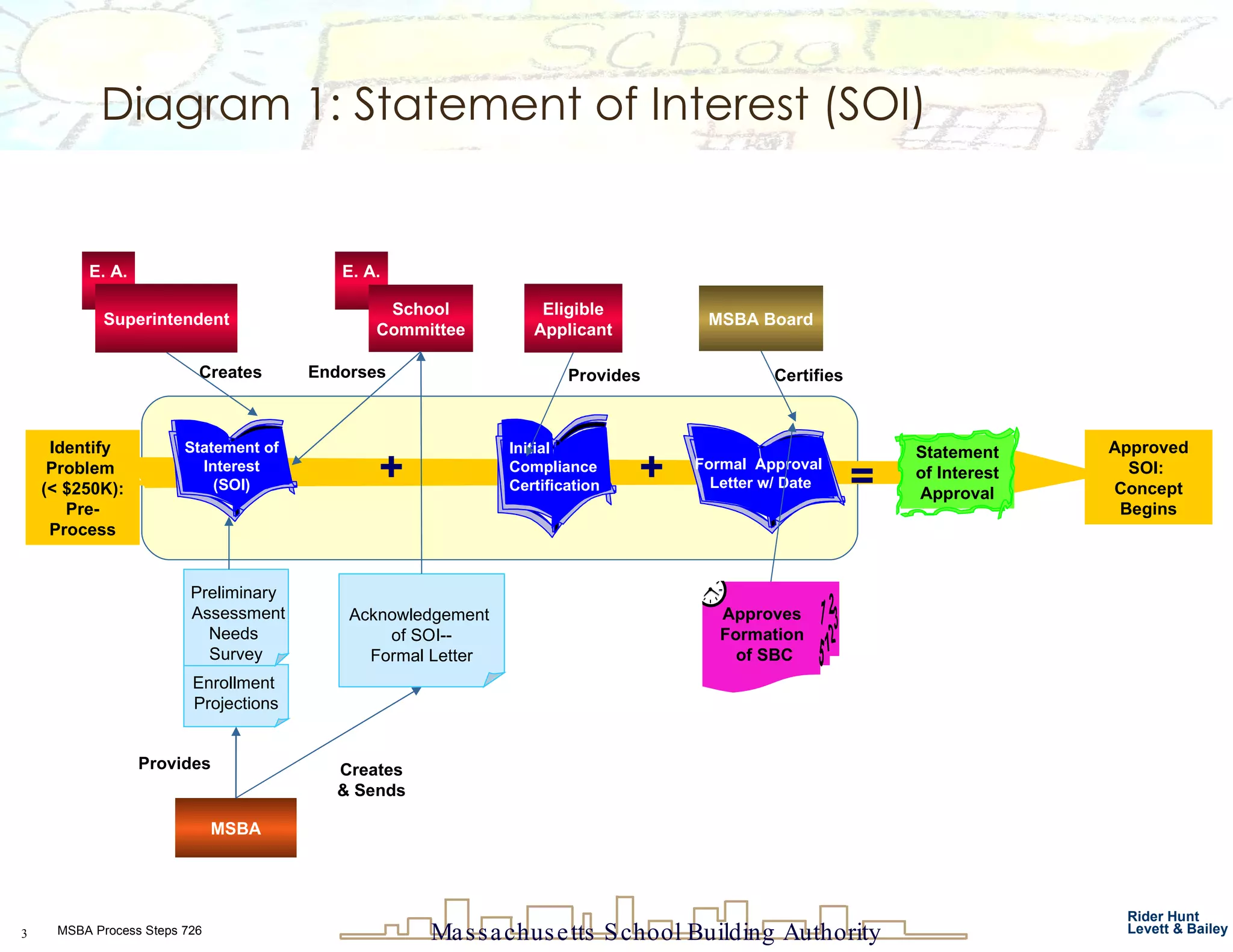

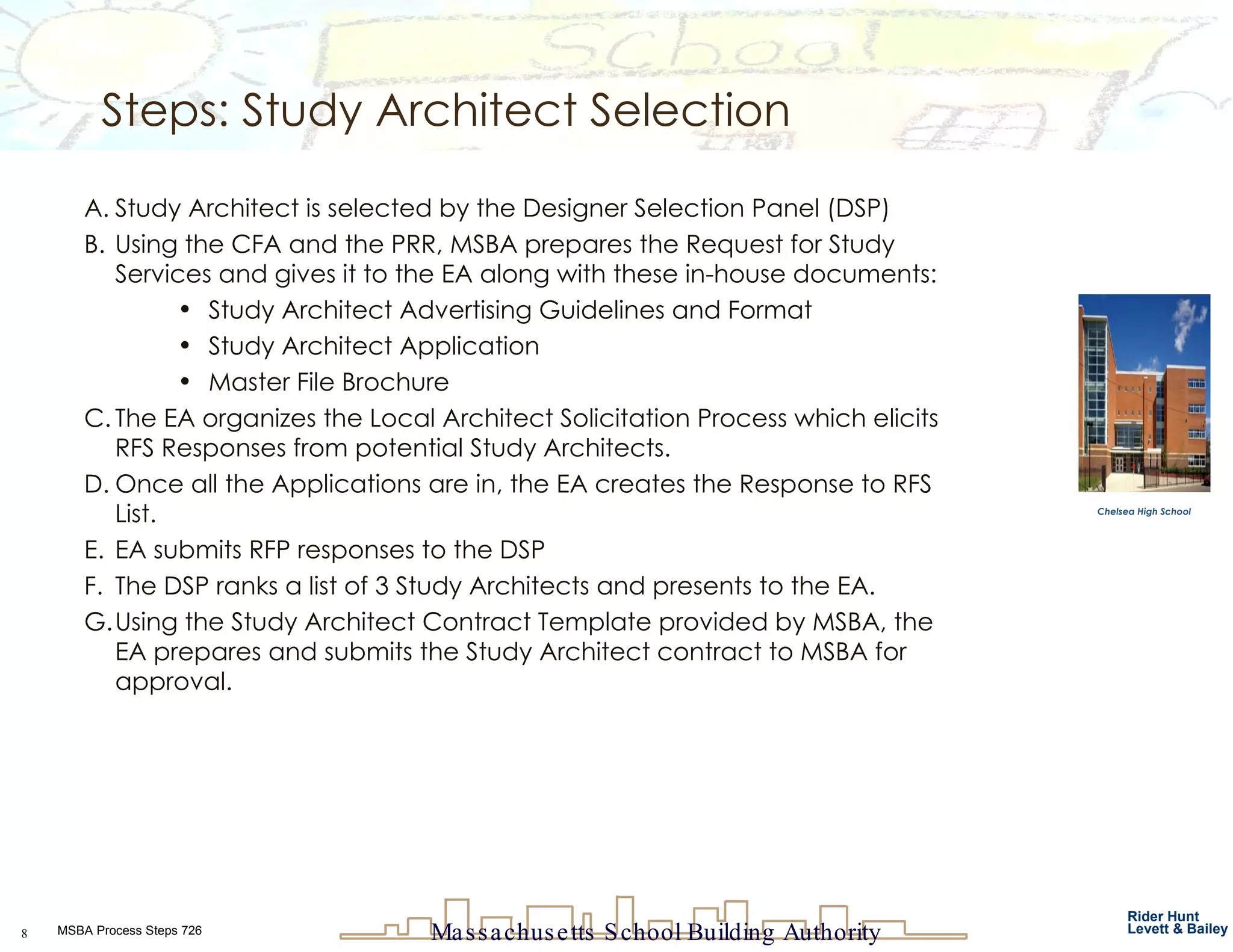

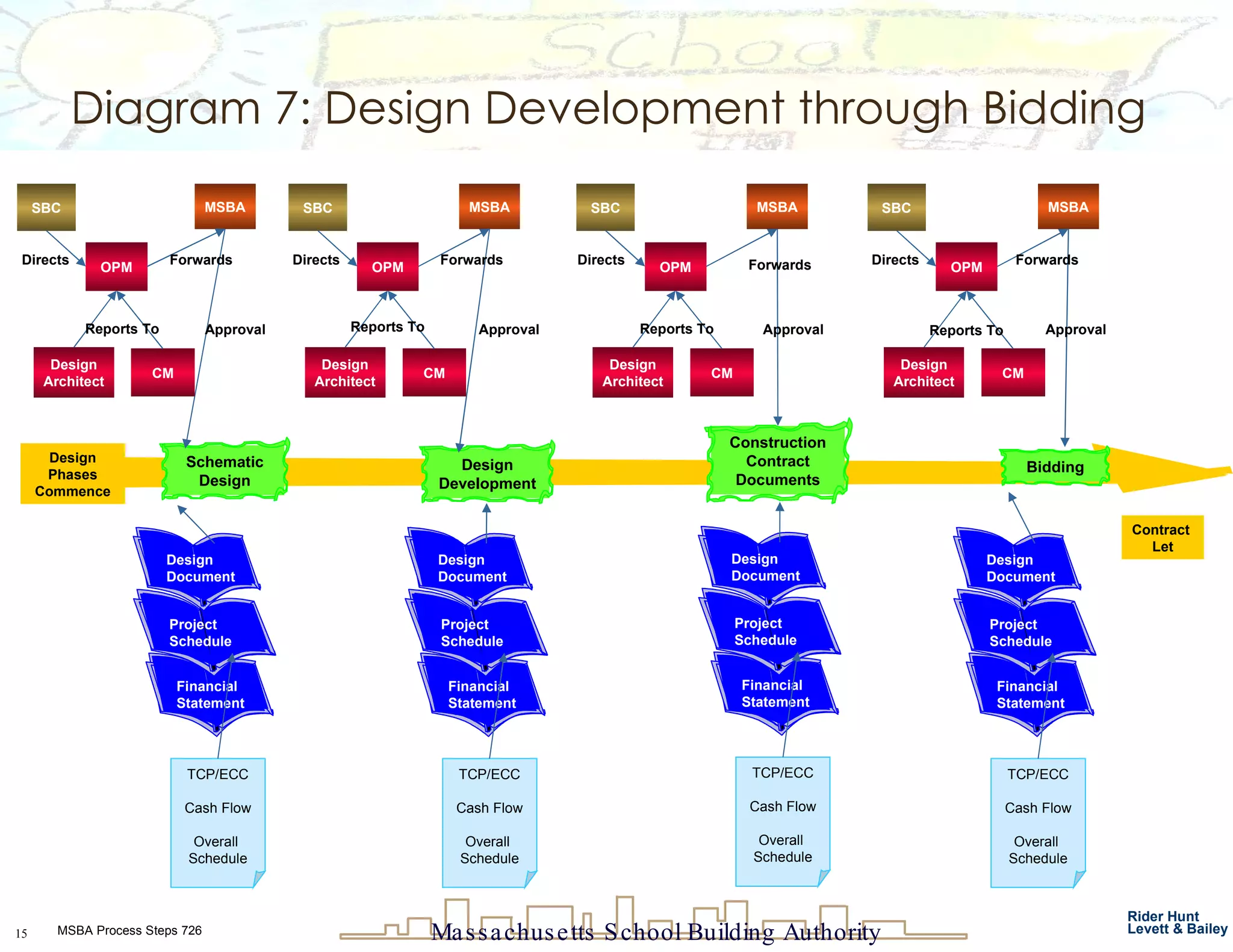

The document outlines the steps and flow of a school building project through the Massachusetts School Building Authority (MSBA) process. It begins with a school submitting a Statement of Interest to identify the problem and potential solution. It then progresses through concept planning, study phases, funding approval, design development, and bidding. Key entities involved at each step include the eligible applicant, school building committee, superintendent, study architect, and MSBA. Diagrams and descriptions provide details on documents, approvals, and responsibilities required to move a project from one phase to the next.
