Embed presentation

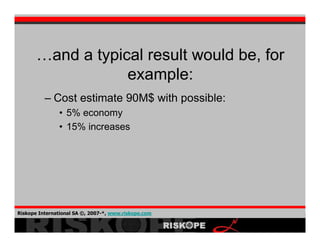

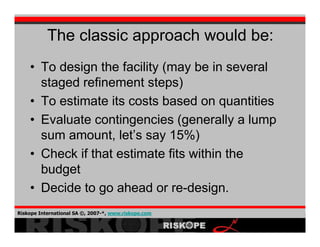

The document discusses a method for evaluating construction budgets while accounting for uncertainties that may lead to significant over-costs. It introduces a simple application that determines the probability of exceeding budgets by analyzing potential construction hazards and cost variations. This approach allows companies to make informed decisions about project affordability and risk management within their tolerability criteria.
