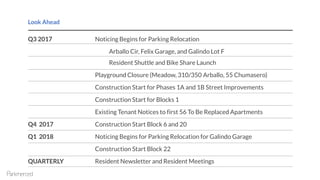

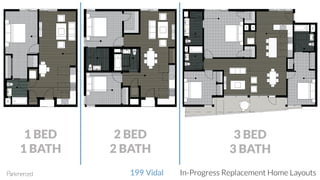

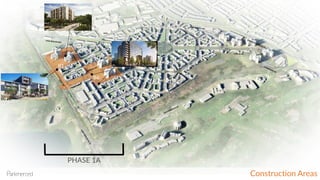

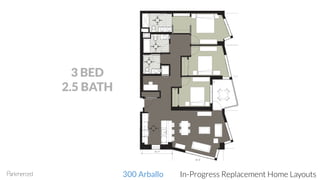

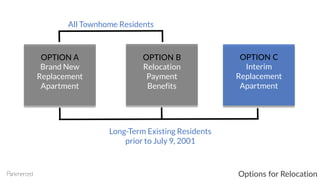

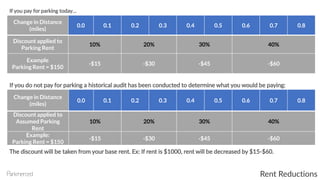

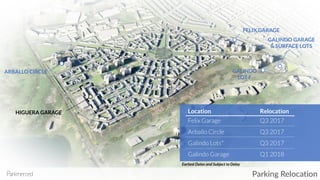

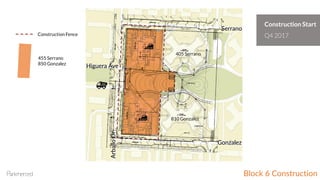

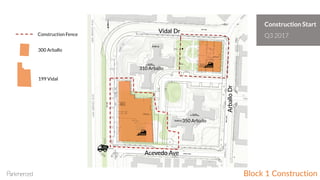

The vision plan meeting overview included phases 1A and 1B of construction as well as resident relocation and parking relocation. Phase 1A construction will include blocks 1, 6, 20, and 22 starting in Q3 2017 through 2019. It will involve the replacement of 56 existing homes in block 1 and 957 new homes across all blocks. Resident relocation options and the parking relocation plan from various lots to the Higuera garage were also discussed. A Q&A session followed the presentation.
