Contents
• Definition, Aims and Benefits
• Why accidents occur despite the use of current
design standards?
• Concepts of Road Safety Audit
• Road Safety Auditors & key personnel
• Organizing and conducting the Road Safety Audit
• Examples and commonly identified issues in RSA
• Road Safety Audit Check List
16 March 2021 1
ROAD SAFETY AUDIT
• A formal procedure for
o assessing accident potential
o assessing safety performance of
• existing road
• future road
• traffic related project or
• project, which interacts with road users
• Input to the design process
o separate from actual design
• Focus on physical elements of road
16 March 2021 2

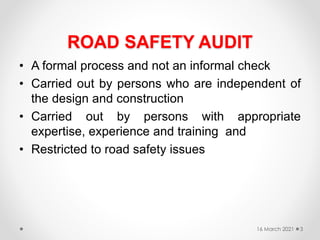

ROAD SAFETY AUDIT
• A formal process and not an informal check
• Carried out by persons who are independent of
the design and construction
• Carried out by persons with appropriate
expertise, experience and training and
• Restricted to road safety issues
16 March 2021 3

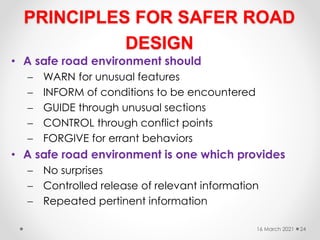

PRINCIPLE OF ROAD SAFETY
A Safe environment should
• Warn the driver of any substandard or unusual features.
• Inform the driver through unusual sections
• Control the driver’s passage through conflict points or
sections and
• Be forgiving of the driver’s errant or inappropriate
behaviour
Similar situations must be treated in similar way; it is
better to avoid
• Insufficient or deficient treatment
• Incorrect or misplaced treatment
• Exaggerated treatment
• Dissimilar treatment for similar situations 16 March 2021 4
PRINCIPLE OF ROAD SAFETY
Road Safety Audit is the systematic application of safety
principles. Specific aims are:
• To minimize the risk of accident occurring on the road project and to
minimize the severity of accident that does occur.
• To minimize the risk of accidents occurring on adjacent roads in the
network as a result of a scheme
• To recognize the importance of safety in highway design to meet the
needs and perceptions of all types of road users and to achieve a
balance between needs where they may be in conflict
• To reduce the long-term costs of a road project, bearing in mind that
unsafe design may be expensive or even impossible to correct at a
larger stage and
• To improve the awareness about safe design practices among those
involved in the planning, design, construction, operation and
maintenance of roads
16 March 2021 5
BENEFITS OF CONDUCTING
ROAD SAFETY AUDIT
• The likelihood of accidents on the road network can be
reduced
• The severity of accidents can be reduced,
• Road safety is given greater prominence in the minds of
road designers and traffic engineers,
• The need for costly remedial work is reduced and
• The total cost of a project to the community, including
accidents, disruption and trauma, is minimized.
16 March 2021 6
ROAD SAFETY AUDIT IS :
• Minimizing the likelihood of crashes occurring through safety-
conscious planning and design
• Ensuring that, if a crash occurs, then the likelihood of the injury
is minimized
• Ensuring that safety related design criteria have been met;
• Managing risks, such that the risk of major safety problems
occurring is less than the risk of minor problems occurring;
• Reducing the whole-life cycle costs of a design
• Minimizing the risk of crashes on the adjacent road network as
well as on the new road scheme;
• Enhancing the importance and relevance of road safety
engineering in highway design work and to enhance
consideration for the safety of all categories of road users in all
new and existing schemes.
16 March 2021 7
Road Safety Audit is NOT
• A way of assessing or rating project as good or poor;
• A means of ranking or justifying one project against
others in a work programme;
• A way of rating one option against another;
• An accident investigation
• A redesign of a project;
• Something to be applied only to high cost projects or
only to projects involving safety problems;
• The name you use to describe informal checks,
inspections and consultations;
• An opportunity to raise subjective concerns.
16 March 2021 8

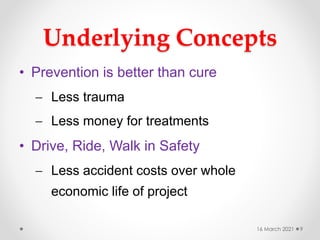

Underlying Concepts
• Prevention is better than cure
 Less trauma
 Less money for treatments
• Drive, Ride, Walk in Safety
 Less accident costs over whole
economic life of project
16 March 2021 9
MAIN FUNCTIONS OF THE KEY
PLAYERS IN ROAD SAFETY AUDIT
Key Players Main Functions
Project Owner (Govt.
and /or
Concessionaire)
• Expresses a commitment to road safety
• Provides funding and resources
• Considers safety audits and reviews as an essential quality
control requirement
• Selects road safety audit team
• Facilitates the response to the recommendations of audits and
reviews and arranges implementation of recommendations that
are accepted
• Attends commencement and completion meetings
Design Team • Attends commencement and completion meetings
• Provides relevant information to safety team
• Acts upon and documents response to recommendations of
audit
Safety Audit Team • Identifies safety issues in the proposed design
• Makes constructive recommendations to enhance safety
• Documents safety issues and recommendations
• Holds commencement and completion meetings with the client
and design team 16 March 2021 10

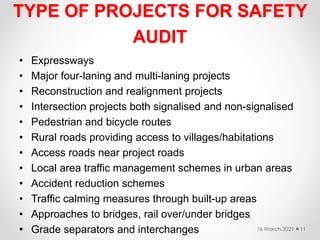

TYPE OF PROJECTS FOR SAFETY
AUDIT
• Expressways
• Major four-laning and multi-laning projects
• Reconstruction and realignment projects
• Intersection projects both signalised and non-signalised
• Pedestrian and bicycle routes
• Rural roads providing access to villages/habitations
• Access roads near project roads
• Local area traffic management schemes in urban areas
• Accident reduction schemes
• Traffic calming measures through built-up areas
• Approaches to bridges, rail over/under bridges
• Grade separators and interchanges 16 March 2021 11
STAGES OF ROAD SAFETY AUDIT
• During Feasibility Study
o Route options, layout options, standards, impact on network, number of
junctions , possible hazards

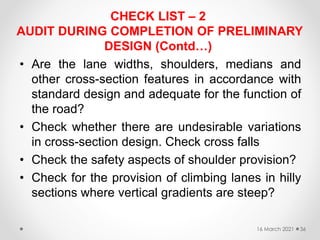

• Completion of preliminary Design
o Project changes since stage 1 audit, Alignment, Cross-section, Arrangement
of junctions , any interim measures
• Completion of Detailed Design
o Project changes since stage 2 audit, detail design of junctions, Geometrics,
cross-fall, side drains, signs, markings, embankment slopes, traffic signal,
lighting, interim measures
• During Construction Stage
o Terminal transition zone, work zone etc., Safety measure for women and
road workers, traffic control devices at construction zone
• Completion of Construction(Pre- opening)
o A final review
• Audit on Existing Roads and during operation and maintenance of
concession projects
o Safety hazards identification to prevent accidents
16 March 2021 12
The steps Responsibility of
Select the Audit Team
Provide the Background Information
Hold a Commencement Meeting
Assess the Documents
Inspect the
Site
Write the Audit Report
Hold a Completion Meeting
Write the Responses
Implement the Changes
Client or Designer
Client and Designer
Client/ Designer and
Audit Team
Audit Team
Audit Team
Audit Team and
Client/ Designer
Client and Designer
Designer
…………………………
……………………………
………………………
…………………
……………………………
…………………………
……………………………
……………………………
AUDIT PROCESS
16 March 2021 13

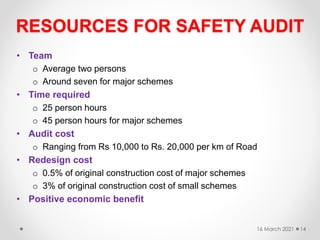

RESOURCES FOR SAFETY AUDIT
• Team
o Average two persons
o Around seven for major schemes
• Time required
o 25 person hours
o 45 person hours for major schemes
• Audit cost
o Ranging from Rs 10,000 to Rs. 20,000 per km of Road
• Redesign cost
o 0.5% of original construction cost of major schemes
o 3% of original construction cost of small schemes
• Positive economic benefit
16 March 2021 14
SELECTION OF AUDITOR
• Auditor is Independent
o team or individual
o application of ‘fresh eyes’ to the task
• Adequate experience
o trained or worked on previous audit
16 March 2021 15

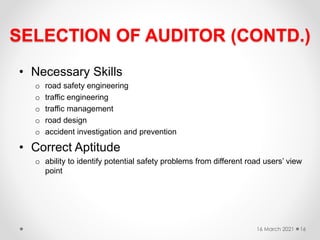

SELECTION OF AUDITOR (CONTD.)
• Necessary Skills
o road safety engineering
o traffic engineering
o traffic management
o road design
o accident investigation and prevention
• Correct Aptitude
o ability to identify potential safety problems from different road users’ view
point
16 March 2021 16

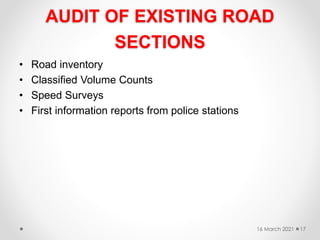

AUDIT OF EXISTING ROAD
SECTIONS
• Road inventory
• Classified Volume Counts
• Speed Surveys
• First information reports from police stations
16 March 2021 17

Safety in Different Stages of the Project
Stage of the
Project
Focus of the Audit
Feasibility
Safety issues associated with options such as route locations, design speed and
standards, impact on adjacent network, provision of intersections and
interchanges, access control, no. of lanes, traffic control, functionality, future
needs.
Preliminary
Project Report
(PPR)
Evaluation of general design standards, alignment, sight distance and lines of
sight, intersection layout, lanes and shoulder widths, cross-slopes, provision for
buses, cycles, pedestrians, emergency vehicles, rest areas, parking etc., safety
during construction.
Detailed Project
Report (DPR)
Examining safety issues of specific geometric design features, traffic control
devices, delineation, road side clear zones, intersection details, glare screens and
lightning, safety issues related to landscaping, provision for special road users
like elderly, school children, buses, equestrian, rail roads, heavy trucks etc.
• Construction
Sites
• During
construction
Examining the maintenance of existing lanes during construction, ensuring safe
and smooth flow of traffic, safety of all road users, construction workers required
road signs, markings and other traffic control devices, lighting at work zones.
Pre-opening
Final check prior to opening the facility to ensure that the safety concerns of all
road users have been addressed and that the hazardous conditions have been
eliminated. Should include day/night checks; evaluation considering dry/wet
weather; driving/riding and walking.

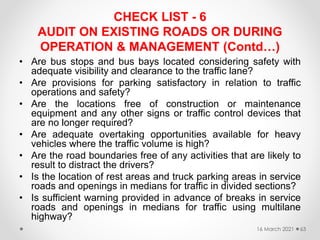

On existing
roads and
during O&M of
concessions
An audit of existing roadway to determine, if the safety needs of all road users
are currently being served. It recognizes that a roadway may change over time.
Changes may have resulted from changing road use, encroachments, design
inconsistency, aging infrastructure and inadequate maintenance. Points to be
emphasized are adequacy of roadway, road side and intersections, location of bus
stops, interaction of VRUs, access management.
16 March 2021 18

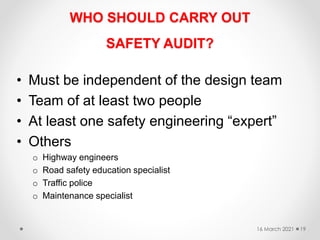

WHO SHOULD CARRY OUT
SAFETY AUDIT?
• Must be independent of the design team
• Team of at least two people
• At least one safety engineering “expert”
• Others
o Highway engineers
o Road safety education specialist
o Traffic police
o Maintenance specialist
16 March 2021 19

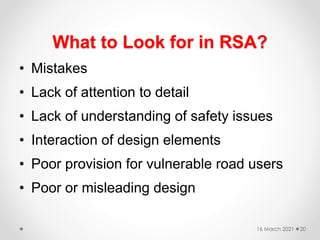

What to Look for in RSA?
• Mistakes
• Lack of attention to detail
• Lack of understanding of safety issues
• Interaction of design elements
• Poor provision for vulnerable road users
• Poor or misleading design
16 March 2021 20
PROJECT ASSESSMENT
• Statement of Expected Outcome
o Terms of Reference of the proposed audit
• Project Intent
o any deficiencies
o input from prior discussion, correspondence and
consultation
• Site Data
o accident history
o traffic of all users
o any known safety issues
o design standards used
o environmental effects
• Plans and Drawings
o horizontal and vertical alignment
o intersection layouts
16 March 2021 21
SITE INSPECTION
• Day, night and inclement weather
• From view point of all category of road users
• Also to include adjacent sections of roads
• Consider different types of movements
 merging and diverging
 road crossing
 traveling along the road
• Consider all age groups
 children, ladies, aged
 physically challenged
16 March 2021 22
ROAD SAFETY AUDIT REPORT
• Project Information
 Audit stage
• Background Information
 Support data/information
 Audit Team
 Details of Inspections
• Findings and Recommendations
• Formal Statement
16 March 2021 23
PRINCIPLES FOR SAFER ROAD
DESIGN
• A safe road environment should
 WARN for unusual features
 INFORM of conditions to be encountered
 GUIDE through unusual sections
 CONTROL through conflict points
 FORGIVE for errant behaviors
• A safe road environment is one which provides
 No surprises
 Controlled release of relevant information
 Repeated pertinent information
16 March 2021 24

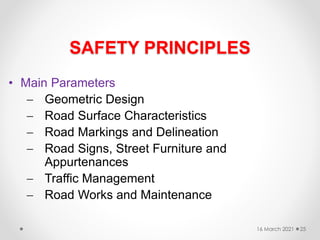

SAFETY PRINCIPLES
• Main Parameters
 Geometric Design
 Road Surface Characteristics
 Road Markings and Delineation
 Road Signs, Street Furniture and
Appurtenances
 Traffic Management
 Road Works and Maintenance
16 March 2021 25
SAFETY AUDIT CHECKLISTS
• Useful ‘Aide Memoir’
• Checking that important safety aspects are
not overlooked
• Understanding of safety in design
• Provide a systematic procedure
• Provide guidelines on principle safety issues
• To be used for Audit in
 Assessment of documents/drawings
 Site inspection
 Report writing
16 March 2021 26
COMMON IDENTIFIED PROBLEMS
• Pedestrians
 Walkways not continuous
 Improper locations for crossings
 Inadequate guard rails
 Lack of dropped kerb at crossings
• Cyclists
 Absence/ Discontinuity of cycle lanes
 Obstruction from street furniture
 Lack of proper signs
• Motor Cyclists
 Slippery road surface
 Protruding manholes
16 March 2021 27
COMMON IDENTIFIED PROBLEMS
• User of Public Transport
 Inadequate facilities
 Unsafe locations
• Vehicle Users
 High speed
 Inadequate, incorrect and obscured signs
 Uncontrolled accesses
 Poorly sited street furniture
 Signs/ Lamp posts in front of safety fences
 Conflict points at intersections not eliminated
 Poor visibility
 Poor skid resistance
16 March 2021 28
CODE OF GOOD PRACTICE
• Management of safety audits by highway authorities to
establish the procedures
• Selection of the audit team depending upon size and type
of scheme, audit stage and available resources
• Various amount of information is required from the design
engineer
• Audit recommendations must be responded to either
through redesign/implementation of changes or explained
in an exception report if recommendations not accepted
• Monitoring and evaluation of the schemes and procedures
of the audit are essential
16 March 2021 29
CHECKLISTS FOR CARRYING OUT ROAD SAFETY AUDIT FOR
DIFFERENT STAGES OF THE PROJECT
Check list 1 Stage 1 Audit (During Feasibility Study)
Check list 2 Stage 2 Audit (Completion of Preliminary Design)
Check list 3 Stage 3 Audit (Completion of Detailed Design)
Check list 4 Stage 4 Audit ( During Construction Stage)
Check list 5 Stage 5 Audit ( Pre-opening)
Check list 6 Stage 6 Audit ( On Existing Road)
Check list 7 Planning

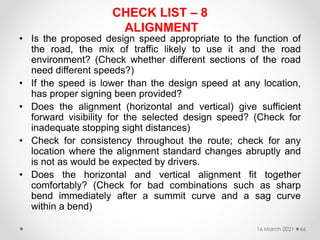

Check list 8 Alignment
Check list 9 Cross section

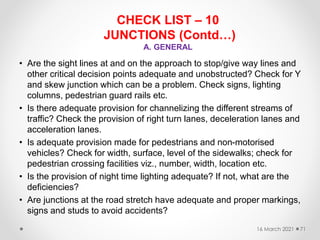

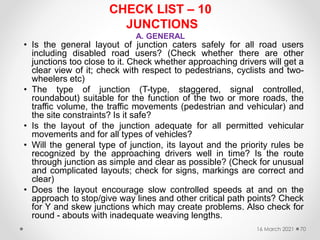

Check list 10 Intersections and interchanges

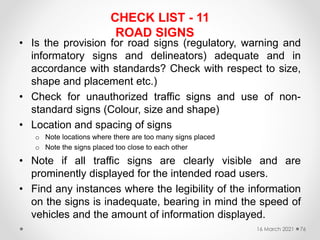

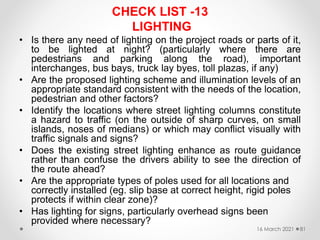

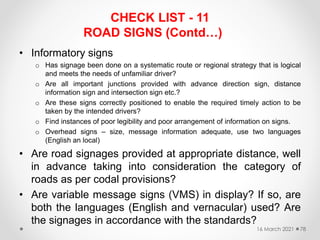

Check list 11 Road signs

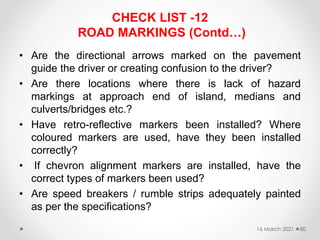

Check list 12 Road markings
Check list 13 Lighting
Check list 14 Roadside hazards

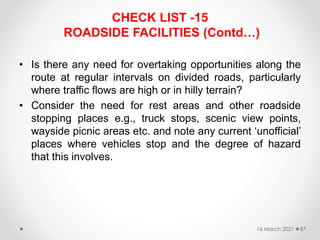

Check list 15 Roadside facilities

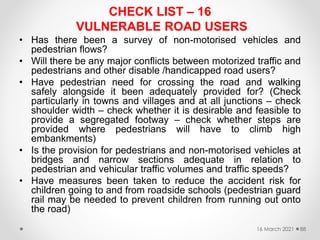

Check list 16 Vulnerable road users
Check list 17 Development proposals
Check list 18 Maintenance work 16 March 2021 30

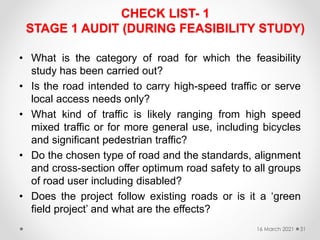

CHECK LIST- 1
STAGE 1 AUDIT (DURING FEASIBILITY STUDY)
• What is the category of road for which the feasibility
study has been carried out?
• Is the road intended to carry high-speed traffic or serve
local access needs only?
• What kind of traffic is likely ranging from high speed
mixed traffic or for more general use, including bicycles
and significant pedestrian traffic?
• Do the chosen type of road and the standards, alignment
and cross-section offer optimum road safety to all groups
of road user including disabled?
• Does the project follow existing roads or is it a ‘green
field project’ and what are the effects?
16 March 2021 31
CHECK LIST- 1

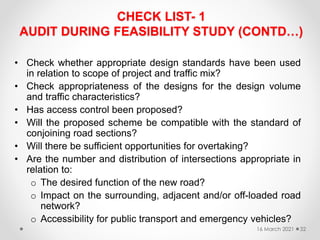

AUDIT DURING FEASIBILITY STUDY (CONTD…)
• Check whether appropriate design standards have been used
in relation to scope of project and traffic mix?
• Check appropriateness of the designs for the design volume
and traffic characteristics?
• Has access control been proposed?
• Will the proposed scheme be compatible with the standard of
conjoining road sections?
• Will there be sufficient opportunities for overtaking?
• Are the number and distribution of intersections appropriate in
relation to:
o The desired function of the new road?
o Impact on the surrounding, adjacent and/or off-loaded road
network?
o Accessibility for public transport and emergency vehicles?
16 March 2021 32
CHECK LIST -1
AUDIT DURING FEASIBILITY STUDY (CONTD…)
• Are junction types shown the safest available at each
location, in relation to the expected turning volumes?
• Are the proposed horizontal and vertical alignments
consistent with visibility requirements?
• Has lightning been planned? (safety at links and
junctions)
• Will the project have any effect on existing pedestrian
and cycle routes?
• Does the project include measures for vulnerable road
users?
• Do the available accident data for existing /adjacent road
network give reason to expect particular road safety
problems?
16 March 2021 33
CHECK LIST- 1
AUDIT DURING FEASIBILITY STUDY (CONTD…)
• Whether non-motorised traffic is expected to cause
problems?
• What is likelihood of future widening?
• Do the gradients, curves and general design approach fit
in with the class of terrain and likely weather or
environmental aspects?
• Check any special events creating unusual or hazardous
conditions?
• Other checks pertinent to the project at discretion of
auditor or client.
16 March 2021 34

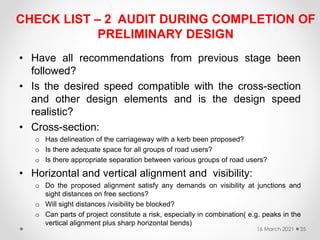

CHECK LIST – 2 AUDIT DURING COMPLETION OF
PRELIMINARY DESIGN
• Have all recommendations from previous stage been
followed?
• Is the desired speed compatible with the cross-section
and other design elements and is the design speed
realistic?
• Cross-section:
o Has delineation of the carriageway with a kerb been proposed?
o Is there adequate space for all groups of road users?
o Is there appropriate separation between various groups of road users?
• Horizontal and vertical alignment and visibility:
o Do the proposed alignment satisfy any demands on visibility at junctions and
sight distances on free sections?
o Will sight distances /visibility be blocked?
o Can parts of project constitute a risk, especially in combination( e.g. peaks in the
vertical alignment plus sharp horizontal bends)
16 March 2021 35
CHECK LIST – 2
AUDIT DURING COMPLETION OF PRELIMINARY
DESIGN (Contd…)
• Are the lane widths, shoulders, medians and
other cross-section features in accordance with
standard design and adequate for the function of
the road?
• Check whether there are undesirable variations
in cross-section design. Check cross falls
• Check the safety aspects of shoulder provision?
• Check for the provision of climbing lanes in hilly
sections where vertical gradients are steep?
16 March 2021 36
CHECK LIST- 2 AUDIT DURING COMPLETION OF
PRELIMINARY DESIGN (Contd…)
• Junctions, interchanges and their design:
o Will road users coming from all directions (including side roads) be able
to see that they are approaching a conflict area? Are give-way lines,
stop lines, turning lanes and ramps clearly visible?
o Are existing conjoining and intersecting roads appropriately adjusted
and matched to the new road (without sharp bends and gradients)?
o Do the routes of road users through the junction seem clear for all
directions and manoeuvres?
o Is there sufficient space for all types of vehicles to undertake all
manoeuvres?
o Are the crossing facilities for pedestrians and non-motorised traffic
adequate and safe?
o Can parking cause problems?
o Have roundabouts been considered? In urban areas, ghost markings
and left-turning lanes with islands are safest; they prevent overtaking
and assist pedestrians and cyclists who are crossing the road.
16 March 2021 37
CHECK LIST- 2 AUDIT DURING COMPLETION OF
PRELIMINARY DESIGN (Contd…)

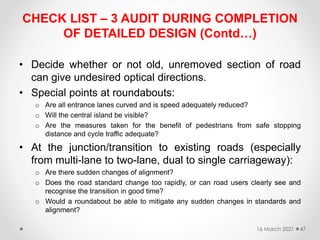

• Decide whether or not old, unremoved section of road
can give undesired optical directions.
• Special points at roundabouts:
o Are all entrance lanes curved and is speed adequately reduced?
o Will the central island be visible?
o Are the measures taken for the benefit of pedestrians from a safe stopping
distance and cycle traffic adequate?
• At the junction/transition to existing roads (especially
from multi-lane to two-lane, dual to single carriageway):
o Are there sudden changes of alignment?
o Does the road standard change too rapidly, or can road users clearly see and
recognize the transition in good time?
o Would a roundabout be able to mitigate any sudden changes in standards and
alignment?
16 March 2021 38

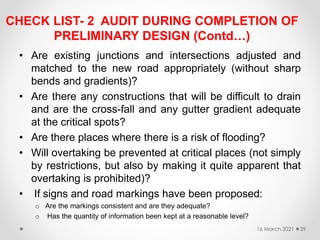

CHECK LIST- 2 AUDIT DURING COMPLETION OF
PRELIMINARY DESIGN (Contd…)
• Are existing junctions and intersections adjusted and
matched to the new road appropriately (without sharp
bends and gradients)?
• Are there any constructions that will be difficult to drain
and are the cross-fall and any gutter gradient adequate
at the critical spots?
• Are there places where there is a risk of flooding?
• Will overtaking be prevented at critical places (not simply
by restrictions, but also by making it quite apparent that
overtaking is prohibited)?
• If signs and road markings have been proposed:
o Are the markings consistent and are they adequate?
o Has the quantity of information been kept at a reasonable level?
16 March 2021 39
CHECK LIST- 2 AUDIT DURING COMPLETION OF
PRELIMINARY DESIGN (Contd…)
• If markings have not been proposed: will special markings be
necessary?
• Is there any risk that cannot be "marked out of existence"?
• Will there be any large sign constructions? Is so; will
guardrails or breakaway safety devices protect them?
• Has it been proposed that lighting be located on the outside
or inside of bends?
• Will it be possible to carry out maintenance work (on lighting,
gantries, plantations, etc.) safely and without using the
carriageway or cycle path?
• Is the landscaping design or plantation likely to lead to a
lowering of safety with mature or seasonal growth? Is
frangible vegetation appropriate?
16 March 2021 40
CHECK LIST- 2 AUDIT DURING COMPLETION OF

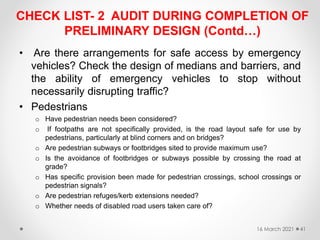

PRELIMINARY DESIGN (Contd…)
• Are there arrangements for safe access by emergency
vehicles? Check the design of medians and barriers, and
the ability of emergency vehicles to stop without
necessarily disrupting traffic?
• Pedestrians
o Have pedestrian needs been considered?
o If footpaths are not specifically provided, is the road layout safe for use by
pedestrians, particularly at blind corners and on bridges?
o Are pedestrian subways or footbridges sited to provide maximum use?
o Is the avoidance of footbridges or subways possible by crossing the road at
grade?
o Has specific provision been made for pedestrian crossings, school crossings or
pedestrian signals?
o Are pedestrian refuges/kerb extensions needed?
o Whether needs of disabled road users taken care of?
16 March 2021 41
CHECK LIST- 2 AUDIT DURING COMPLETION OF
PRELIMINARY DESIGN (Contd…)
• Have the needs of public transport users been considered?
Are bus stops positioned for safety?
• Is lighting envisaged in specified locations of the project? Are
the difficulties of illuminating sections of the road caused by
trees or over bridges, for example? Are there any aspects of
the provision of the lighting poles, which would require
consideration from the safety point of view in their being
struck by vehicles?
• Is adequate safe access to the work site available?
• Are there any factors requiring specific road safety provision,
including maintenance?
• Are there any traffic management features, which would
require special attention during construction or during the
transition from construction to full operation?
• Other checks made at discretion of auditor or client.
16 March 2021 42
CHECK LIST - 3 AUDIT DURING COMPLETION
OF DETAILED DESIGN
• Have all recommendations from the previous stage been
followed? If not, reasons thereof?
• Visibility, sight distance
o Are horizontal and vertical alignments consistent with the required visibility
requirements?
o Confirm whether the standard adopted for provision of visibility in the design is
appropriate for the ruling design speed and for any unusual traffic mix.
o Check whether sight lines are obstructed by:
• Safety fences
• Boundary fences
• Street furniture
• Parking facilities
• Signs
• Landscaping
• Bridge abutments
o Check whether railway crossings, bridges and other hazards are conspicuous.
o Will sight lines to be obstructed by temporary features such as parked vehicles in
lay-byes or parked or queued traffic has been taken care of?
16 March 2021 43
CHECK LIST - 3 AUDIT DURING COMPLETION
OF DETAILED DESIGN (Contd…)
• Check whether the design standards are appropriate for
all the new requirements of the proposed project and
check for consistency of general standards and
guidelines such as lane widths, camber and cross-fall.
• Cross-sections:
o Are cross-falls appropriate?
o Is there a suitable gutter gradient or is the carriageway laid at a suitable height
above the shoulder?
• Lighting columns, traffic signals, sign standards, etc.:
o Have requirements on safe distances to carriageway and cycle path been
observed?
o Have breakaway safety devices or such like been proposed?
16 March 2021 44
CHECK LIST - 3 AUDIT DURING COMPLETION
OF DETAILED DESIGN (Contd…)
• Signs and markings:
o Are markings consistent along the entire road section?
o Is the information clear?
o Are there enough signs?
o Are there too many signs?
o Will signs mask each other or traffic signals (be sure to include all plans for signs and
markings in your assessment)?
o Are the signs correctly positioned, without obstructing sight distances/visibility in any
way?
• Are the proposed types of kerb stone/edge marking
appropriate?
• Lighting:
o Is there any risk that the lighting can be optically misleading and will it have any
detrimental effects on traffic signals and signs?
o Are there any unlit areas that could conceal hazards?
o Will an illuminated side road mislead road users on the planned, unlit road?
o Are all pedestrian crossings illuminated (not merely the formally marked crossings, but
also unmarked places where pedestrians could be expected to cross)?
o Will powerful illumination of adjoining areas or strongly illuminated advertisements
cause problems?
16 March 2021 45
CHECK LIST - 3 AUDIT DURING COMPLETION
OF DETAILED DESIGN (Contd…)

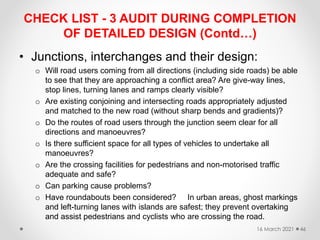

• Junctions, interchanges and their design:
o Will road users coming from all directions (including side roads) be able
to see that they are approaching a conflict area? Are give-way lines,
stop lines, turning lanes and ramps clearly visible?
o Are existing conjoining and intersecting roads appropriately adjusted
and matched to the new road (without sharp bends and gradients)?
o Do the routes of road users through the junction seem clear for all
directions and manoeuvres?
o Is there sufficient space for all types of vehicles to undertake all
manoeuvres?
o Are the crossing facilities for pedestrians and non-motorised traffic
adequate and safe?
o Can parking cause problems?
o Have roundabouts been considered? In urban areas, ghost markings
and left-turning lanes with islands are safest; they prevent overtaking
and assist pedestrians and cyclists who are crossing the road.
16 March 2021 46
CHECK LIST – 3 AUDIT DURING COMPLETION
OF DETAILED DESIGN (Contd…)
• Decide whether or not old, unremoved section of road
can give undesired optical directions.
• Special points at roundabouts:
o Are all entrance lanes curved and is speed adequately reduced?
o Will the central island be visible?
o Are the measures taken for the benefit of pedestrians from safe stopping
distance and cycle traffic adequate?
• At the junction/transition to existing roads (especially
from multi-lane to two-lane, dual to single carriageway):
o Are there sudden changes of alignment?
o Does the road standard change too rapidly, or can road users clearly see and
recognise the transition in good time?
o Would a roundabout be able to mitigate any sudden changes in standards and
alignment?
16 March 2021 47
CHECK LIST - 3 AUDIT DURING COMPLETION
OF DETAILED DESIGN (Contd…)
• Are existing junctions and intersections adjusted and
matched to the new road appropriately (without sharp
bends and gradients)?
• Guardrails, hedges and railings:
o Are all vulnerable areas protected?
o Are bridge pillars, steel posts, trees etc., protected by guardrails where
necessary?
o Are there places where hedges are necessary to prevent pedestrians from
crossing?
o Are the chosen hedges/guardrails "light" enough?
o Do guardrails/road side furniture have any hazardous sharp protruding edges?
• Road surface:
o Has a porous type of surface been chosen?
o Will an exceptionally high-friction surface be necessary in especially exposed
places?
o Would a change of surface as a purely visual signal to road users be of benefit?
Used in this way, could a change of surface be misunderstood by road users?
16 March 2021 48
CHECK LIST - 3 AUDIT DURING COMPLETION
OF DETAILED DESIGN (Contd…)
• At junction/transition to existing road network (especially
from multi-lane to two-lane, end of central reverse)
o Is there sufficient advance warning?
o Are reflector posts correctly positioned?
o Are ghost markings appropriate in connection with the merging of two lanes?
o Is there continuity of edge markings?
• For two-lane sections prepared for expansion to four
lanes with central reverse (e.g. expressways built as
“semi-motorways”)
o Will road users be clear everywhere that they are not on one-way, two-lane
carriageway?
o Should night illumination of signs be of extra high standards?
o Is overtaking prevented at all points where prevention is necessary?
o Should special measures are adopted at bridges built with a view to future
expansion?

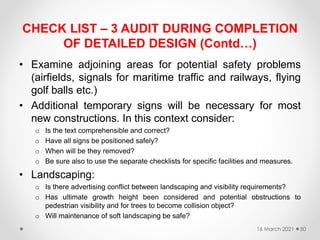

16 March 2021 49
CHECK LIST – 3 AUDIT DURING COMPLETION
OF DETAILED DESIGN (Contd…)
• Examine adjoining areas for potential safety problems
(airfields, signals for maritime traffic and railways, flying
golf balls etc.)
• Additional temporary signs will be necessary for most
new constructions. In this context consider:
o Is the text comprehensible and correct?
o Have all signs be positioned safely?
o When will be they removed?
o Be sure also to use the separate checklists for specific facilities and measures.
• Landscaping:
o Is there advertising conflict between landscaping and visibility requirements?
o Has ultimate growth height been considered and potential obstructions to
pedestrian visibility and for trees to become collision object?
o Will maintenance of soft landscaping be safe?
16 March 2021 50
CHECK LIST - 3 AUDIT DURING COMPLETION
OF DETAILED DESIGN (Contd…)
• Plantations:
o Will plantations obscure visibility and has a maximum height been specified?
o Are plantations likely to encroach on markings or lighting?
o Will fully-grown trees constitute a hazard?
o Can maintenance be carried out safely?
• Lay byes:
o Are there any lay-byes available in the section?
o Is the by bye properly located and it is not inconvenient to the drivers to stop the
vehicles?
o Is there any need to modify the lay-bye design (if yes, suggest the parameters
that need modification)? /
o Are advance warning signs and markings properly guiding the driver about the
lay-bye?
o Is there any need of any additional signs and markings?
16 March 2021 51
CHECK LIST - 3 AUDIT DURING COMPLETION
OF DETAILED DESIGN (Contd…)
• Check provision for pedestrians to cross safely at
intersections, signalised and pedestrian crossings, refuges,
kerb extensions and at other locations.
• Are median barriers necessary and have they been properly
detailed? Are there any design features such as end
conditions which require special attention?
• Are there any poles located adjacent to moving traffic which
could be sited elsewhere?
• Have frangible or breakaway poles been detailed?
• Is the unprotected median width adequate to accommodate
lighting poles?
• Are there any obstructions, which are likely to create a safety
hazard and can they be mitigated or relocated?
• Is a crash barrier provided wherever necessary and is it
properly detailed?
16 March 2021 52
CHECK LIST - 3 AUDIT DURING COMPLETION
OF DETAILED DESIGN (Contd…)
• Check whether access to structures and road furniture is safe.
Check that the road or utilities in the road reserve can be
maintained safely. Both road users and maintenance
personnel should be considered.
• Check that the requirements for the traffic management of the
construction site and safety measures needed for workers
and road users have been adequately spelled out from the
safety point of view including the transition from the existing
arrangements to the construction site and from the
construction site to the final layout can be effected safely.
• Check for the arrangement for temporary and permanent
traffic control devices, including possible signals, temporary
diversion etc.
• Check that the design duly considers the needs of persons
with disabilities.
• Other checks made at discretion of auditor or client.
16 March 2021 53

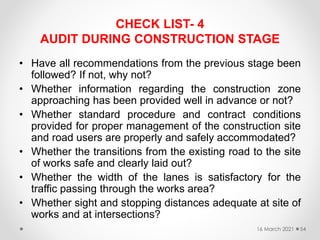

CHECK LIST- 4
AUDIT DURING CONSTRUCTION STAGE
• Have all recommendations from the previous stage been
followed? If not, why not?
• Whether information regarding the construction zone
approaching has been provided well in advance or not?
• Whether standard procedure and contract conditions
provided for proper management of the construction site
and road users are properly and safely accommodated?
• Whether the transitions from the existing road to the site
of works safe and clearly laid out?
• Whether the width of the lanes is satisfactory for the
traffic passing through the works area?
• Whether sight and stopping distances adequate at site of
works and at intersections?
16 March 2021 54
CHECKLIST - 4
AUDIT DURING CONSTRUCTION STAGE (Contd…)

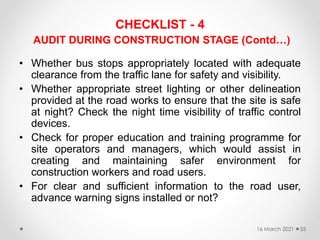

• Whether bus stops appropriately located with adequate
clearance from the traffic lane for safety and visibility.
• Whether appropriate street lighting or other delineation
provided at the road works to ensure that the site is safe
at night? Check the night time visibility of traffic control
devices.
• Check for proper education and training programme for
site operators and managers, which would assist in
creating and maintaining safer environment for
construction workers and road users.
• For clear and sufficient information to the road user,
advance warning signs installed or not?
16 March 2021 55
CHECKLIST - 4
AUDIT DURING CONSTRUCTION STAGE (Contd…)

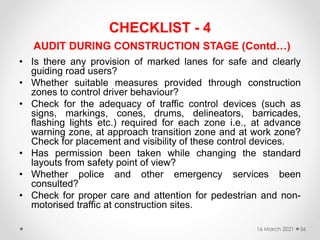

• Is there any provision of marked lanes for safe and clearly
guiding road users?
• Whether suitable measures provided through construction
zones to control driver behaviour?
• Check for the adequacy of traffic control devices (such as
signs, markings, cones, drums, delineators, barricades,
flashing lights etc.) required for each zone i.e., at advance
warning zone, at approach transition zone and at work zone?
Check for placement and visibility of these control devices.
• Has permission been taken while changing the standard
layouts from safety point of view?
• Whether police and other emergency services been
consulted?
• Check for proper care and attention for pedestrian and non-
motorised traffic at construction sites.
16 March 2021 56
CHECKLIST - 4
AUDIT DURING CONSTRUCTION STAGE (Contd…)
• Check for adequate safety provisions for the elderly and
persons with disabilities.
• Whether construction workers provided with protective
clothing etc. reflecting jackets, hard hats, gloves etc.?
• Whether flagmen are available on duty at the appropriate
places? Check for proper traffic management practice to
avoid inhibiting traffic to pass clear of work site and necessary
attention to roadside safety.
• Whether the temporary diversion is provided at work zones in
compliance with the contract and traffic management plan
approved by the Engineer.
• Whether the Traffic Management Plan at work site prepared
and submitted by the Contractor to the Engineer for approval.
• Is the Supervision Engineer ensuring the required quality of
traffic management plan?
16 March 2021 57
CHECKLIST - 4
AUDIT DURING CONSTRUCTION STAGE (Contd…)
• Whether arrangements of First Aid Box and other
emergency care exist for persons getting injured.
• Whether suitable speed reducing measures are provided
at work zones.
• Other checks made at discretion of auditor or client.
16 March 2021 58
CHECKLIST - 5
AUDIT DURING COMPLETION OF
CONSTRUCTION/PRE-OPENING
• Have all recommendations from the previous stages been
followed? If not, why not?
• Involve the site engineer
• Test the installations of traffic control devices as a road user:
by car, by truck, by bus, by cycle and on foot - from disabled
road user angle. Also in the dark/ night hours.
• Examine the carriageway for defects, especially at junctions
to existing roads.
• Has the opening of the road facility been adequately
publicized?
• How will the transition phase proceed?
• Check that provision for emergency vehicle access and
stopping is safe?
• Check that all delineators and pavement markings are
correctly in place.
16 March 2021 59

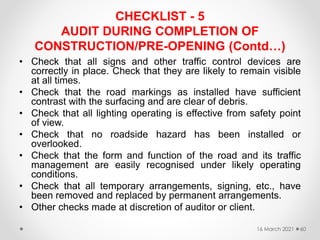

CHECKLIST - 5
AUDIT DURING COMPLETION OF
CONSTRUCTION/PRE-OPENING (Contd…)
• Check that all signs and other traffic control devices are
correctly in place. Check that they are likely to remain visible
at all times.
• Check that the road markings as installed have sufficient
contrast with the surfacing and are clear of debris.
• Check that all lighting operating is effective from safety point
of view.
• Check that no roadside hazard has been installed or
overlooked.
• Check that the form and function of the road and its traffic
management are easily recognised under likely operating
conditions.
• Check that all temporary arrangements, signing, etc., have
been removed and replaced by permanent arrangements.
• Other checks made at discretion of auditor or client.
16 March 2021 60
CHECK LIST - 6
AUDIT ON EXISTING ROADS OR DURING
OPERATION & MANAGEMENT
• Results of accident analysis.
• Does the actual function of the road correspond to its
intended function?
• Are the prevailing speed levels within the desirable limits?
• Do the equipment and standard of the road correspond to its
function, speed level and classification? (Use checklist 2 and
3, as well as any specific checklists, which are relevant.)
• Do the road users park on the carriageway that could cause
hazards?
• Do plantations obscure the visibility and mask the view of the
signs?
• Are the surface and carriageway markings in good visible
condition?
• Are there any signs that results in road users drive over
islands or kerbs or that the routes taken by the motorists
through junctions and bends that are unsafe?
16 March 2021 61
CHECK LIST - 6
AUDIT ON EXISTING ROADS OR DURING
OPERATION & MANAGEMENT (Contd…)
• Are there conflict situations that are likely to result in
accidents?
• Are the safe distances to rigid obstacles maintained at all
locations?
• Are medians and islands of adequate width for the road
users?
• Are there adequate safe pedestrian crossing facilities? Are the
existing facilities safe?
• Are there safe pedestrian sidewalks, as per standards?
• Does there appear to be a need for more or better crossing
facilities for pedestrians?
• Does there appear to be a need for more or better facilities for
cyclists?
• Has due consideration given for physically disabled, old, and
children in using the road space safely?
16 March 2021 62
CHECK LIST - 6
AUDIT ON EXISTING ROADS OR DURING
OPERATION & MANAGEMENT (Contd…)
• Are bus stops and bus bays located considering safety with
adequate visibility and clearance to the traffic lane?
• Are provisions for parking satisfactory in relation to traffic
operations and safety?
• Are the locations free of construction or maintenance
equipment and any other signs or traffic control devices that
are no longer required?
• Are adequate overtaking opportunities available for heavy
vehicles where the traffic volume is high?
• Are the road boundaries free of any activities that are likely to
result to distract the drivers?
• Is the location of rest areas and truck parking areas in service
roads and openings in medians for traffic in divided sections?
• Is sufficient warning provided in advance of breaks in service
roads and openings in medians for traffic using multilane
highway?
16 March 2021 63
CHECK LIST - 6
AUDIT ON EXISTING ROADS OR DURING
OPERATION & MANAGEMENT (Contd…)

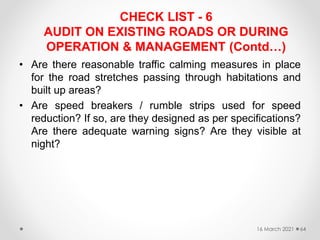

• Are there reasonable traffic calming measures in place
for the road stretches passing through habitations and
built up areas?
• Are speed breakers / rumble strips used for speed
reduction? If so, are they designed as per specifications?
Are there adequate warning signs? Are they visible at
night?
16 March 2021 64
CHECK LIST – 7
PLANNING
• Is there a development plan or development strategy for the
area and, if so, does the project conform to this?
• Is the proposed design appropriate in relation to the forecast
traffic volumes, traffic characteristics and the adjoining land
use?
• Does the alignment fit in with the physical constraints imposed
by the topography?
• Does the route serve major generators of traffic in a safe and
adequate manner?
• Is the frequency of junctions and their type appropriate for the
function of the road and the design speed?
• Does the project road fit well with the existing road network?
Check for likely future conflicts.
• Does the project road relieve routes or sites with bad accident
records?
• Do the project road sections have any harmful effects on
safety on the surrounding road network?
16 March 2021 65
CHECK LIST – 8
ALIGNMENT
• Is the proposed design speed appropriate to the function of
the road, the mix of traffic likely to use it and the road
environment? (Check whether different sections of the road
need different speeds?)
• If the speed is lower than the design speed at any location,
has proper signing been provided?
• Does the alignment (horizontal and vertical) give sufficient
forward visibility for the selected design speed? (Check for
inadequate stopping sight distances)
• Check for consistency throughout the route; check for any
location where the alignment standard changes abruptly and
is not as would be expected by drivers.
• Does the horizontal and vertical alignment fit together
comfortably? (Check for bad combinations such as sharp
bend immediately after a summit curve and a sag curve
within a bend)
16 March 2021 66
• Does the alignment provide safe overtaking
opportunities? Does it avoid creating situations where
the forward visibility is marginal for overtaking? (neither
clearly adequate not inadequate)
• Does the treatment at the curves proposed if any, make
appropriate, adequate and safe provision for transition
curves, super-elevation and carriageway widening?
• Does the vertical alignment pose excessive demands on
the power of heavy vehicles? Is the vertical alignment
been designed so that the maximum grades are
interspersed with recovery grades? Are there passing
places to enable faster vehicles to overtake slow moving
heavy vehicles?
• Is the transition between project road and the access
roads handled safely?
16 March 2021 67
CHECK LIST – 8
ALIGNMENT (Contd…)

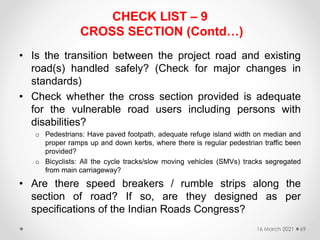

CHECK LIST – 9
CROSS SECTION
• Are the widths of the carriageway, shoulders, medians (if
any), service roads in accordance with the standards and
adequate for the function of the road and the mix of traffic
likely to use the highway?
• Check whether the bridges have footpaths and they have
proper gradient and crash barriers.
• Note any location where the cross section standard changes
abruptly along the route or is otherwise inconsistent with
driver expectations?
• Identify any locations where the capacity of the roadway is
restricted and note locations of regular congestion.
• Have the shoulders and side slopes been designed to a safe
standard and note any locations with inadequate shoulder
width.
• Have the side drains been designed to a safe standard? Are
the batter slopes and drains for surface run-off, safe for
vehicles to traverse?
16 March 2021 68
CHECK LIST – 9
CROSS SECTION (Contd…)
• Is the transition between the project road and existing
road(s) handled safely? (Check for major changes in
standards)
• Check whether the cross section provided is adequate
for the vulnerable road users including persons with
disabilities?
o Pedestrians: Have paved footpath, adequate refuge island width on median and
proper ramps up and down kerbs, where there is regular pedestrian traffic been
provided?
o Bicyclists: All the cycle tracks/slow moving vehicles (SMVs) tracks segregated
from main carriageway?
• Are there speed breakers / rumble strips along the
section of road? If so, are they designed as per
specifications of the Indian Roads Congress?
16 March 2021 69
CHECK LIST – 10
JUNCTIONS
A. GENERAL
• Is the general layout of junction caters safely for all road users
including disabled road users? (Check whether there are other
junctions too close to it. Check whether approaching drivers will get a
clear view of it; check with respect to pedestrians, cyclists and two-
wheelers etc)
• The type of junction (T-type, staggered, signal controlled,
roundabout) suitable for the function of the two or more roads, the
traffic volume, the traffic movements (pedestrian and vehicular) and
the site constraints? Is it safe?
• Is the layout of the junction adequate for all permitted vehicular
movements and for all types of vehicles?
• Will the general type of junction, its layout and the priority rules be
recognized by the approaching drivers well in time? Is the route
through junction as simple and clear as possible? (Check for unusual
and complicated layouts; check for signs, markings are correct and
clear)
• Does the layout encourage slow controlled speeds at and on the
approach to stop/give way lines and other critical path points? Check
for Y and skew junctions which may create problems. Also check for
round - abouts with inadequate weaving lengths.
16 March 2021 70
CHECK LIST – 10
JUNCTIONS (Contd…)
A. GENERAL
• Are the sight lines at and on the approach to stop/give way lines and
other critical decision points adequate and unobstructed? Check for Y
and skew junction which can be a problem. Check signs, lighting
columns, pedestrian guard rails etc.
• Is there adequate provision for channelizing the different streams of
traffic? Check the provision of right turn lanes, deceleration lanes and
acceleration lanes.
• Is adequate provision made for pedestrians and non-motorised
vehicles? Check for width, surface, level of the sidewalks; check for
pedestrian crossing facilities viz., number, width, location etc.
• Is the provision of night time lighting adequate? If not, what are the
deficiencies?
• Are junctions at the road stretch have adequate and proper markings,
signs and studs to avoid accidents?
16 March 2021 71
CHECK LIST- 10
JUNCTIONS (Contd…)
B. ROUNDABOUTS
• Is the geometry simple and easily understood?
• Are there too many entries for safe and efficient operation? Are they
sufficiently separated from each other to avoid confusion?
• Does the design deflect entering traffic sufficiently to ensure entry
speeds are greater than the standards? Check entry path of
curvature, centre island size, position etc.
• Is there visibility for circulating traffic adequate?
• Has the central island been designed to be forgiving errant
vehicles?
• Has adequate provision been made for pedestrians to cross the
arms of the junction?
• Have the needs of cyclists and other non-motorised vehicles been
considered?
• Does the signing make the priorities clear? Entering traffic must give
way to circulating traffic.
16 March 2021 72
CHECK LIST -10
JUNCTIONS (Contd…)

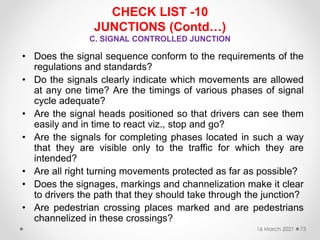

C. SIGNAL CONTROLLED JUNCTION
• Does the signal sequence conform to the requirements of the
regulations and standards?
• Do the signals clearly indicate which movements are allowed
at any one time? Are the timings of various phases of signal
cycle adequate?
• Are the signal heads positioned so that drivers can see them
easily and in time to react viz., stop and go?
• Are the signals for completing phases located in such a way
that they are visible only to the traffic for which they are
intended?
• Are all right turning movements protected as far as possible?
• Does the signages, markings and channelization make it clear
to drivers the path that they should take through the junction?
• Are pedestrian crossing places marked and are pedestrians
channelized in these crossings?
16 March 2021 73
CHECK LIST -10
JUNCTIONS (Contd…)
C. SIGNAL CONTROLLED JUNCTION
• Are pedestrian signals positioned such that, they are
clearly visible?
• Whether the pedestrian crossing signal controls are
provided where appropriate? If so, there is a need for the
crossing movements to be fully protected from conflicting
traffic movements, for example, where there will be
serious conflicts with turning traffic.
16 March 2021 74
CHECK LIST – 10
JUNCTIONS (Contd…)
D. VEGETATION AND PLANTATION
• Is the top of vegetation in the traffic island as well as
channelisers, dividers less than 600 mm above the road
top level for a length of 15 m from the end of the
dividers?
• Is the vegetation/plantation at the corners of the junction
retracted for enough back from the edge of the shoulders
to afford clear view of approaching traffic to the driver?
• Are there no branches of trees projecting over the road
berms/pavement at a height less than 7 m?
16 March 2021 75
CHECK LIST - 11
ROAD SIGNS
• Is the provision for road signs (regulatory, warning and
informatory signs and delineators) adequate and in
accordance with standards? Check with respect to size,
shape and placement etc.)
• Check for unauthorized traffic signs and use of non-
standard signs (Colour, size and shape)
• Location and spacing of signs
o Note locations where there are too many signs placed
o Note the signs placed too close to each other
• Note if all traffic signs are clearly visible and are
prominently displayed for the intended road users.
• Find any instances where the legibility of the information
on the signs is inadequate, bearing in mind the speed of
vehicles and the amount of information displayed.
16 March 2021 76
CHECK LIST - 11
ROAD SIGNS (Contd…)
• Determine the effectiveness of traffic signs by observing
them at night and identify any lack of reflectivity.
• Examine type of sign posts used and record situations
where sign posts constitute a fixed roadside hazard or
where the use of frangible sign posts should be
considered.
• Are there any situations where the traffic signs
themselves are obstructing essential ‘line of sight’ for
drivers and pedestrians.
• Regulatory and warning signs
o Are appropriate regulatory signs provided where necessary?
o Are warning signs provided only where they are warranted?
16 March 2021 77
CHECK LIST - 11
ROAD SIGNS (Contd…)
• Informatory signs
o Has signage been done on a systematic route or regional strategy that is logical
and meets the needs of unfamiliar driver?
o Are all important junctions provided with advance direction sign, distance
information sign and intersection sign etc.?
o Are these signs correctly positioned to enable the required timely action to be
taken by the intended drivers?
o Find instances of poor legibility and poor arrangement of information on signs.
o Overhead signs – size, message information adequate, use two languages
(English an local)
• Are road signages provided at appropriate distance, well
in advance taking into consideration the category of
roads as per codal provisions?
• Are variable message signs (VMS) in display? If so, are
both the languages (English and vernacular) used? Are
the signages in accordance with the standards?
16 March 2021 78
CHECK LIST -12
ROAD MARKINGS
• General adequacy and visibility of road markings during
day/night time and in wet/dry weather conditions
• Has correct type of markings been used in various
situations (eg., lane lines, edge marker lines etc)
• Are correct colours used for laying road markings?
• Is there any deficiency in the delineation of merge and
diverge areas, including situations where through traffic
may inadvertently lead into auxiliary and turn lanes?
• Are zebra crossing marking provided at junctions and
mid-blocks of the sections (depending upon movement
of pedestrians)
• Is positioning of stop lines adequate?
16 March 2021 79
CHECK LIST -12
ROAD MARKINGS (Contd…)
• Are the directional arrows marked on the pavement
guide the driver or creating confusion to the driver?
• Are there locations where there is lack of hazard
markings at approach end of island, medians and
culverts/bridges etc.?
• Have retro-reflective markers been installed? Where
coloured markers are used, have they been installed
correctly?
• If chevron alignment markers are installed, have the
correct types of markers been used?
• Are speed breakers / rumble strips adequately painted
as per the specifications?
16 March 2021 80
CHECK LIST -13
LIGHTING
• Is there any need of lighting on the project roads or parts of it,
to be lighted at night? (particularly where there are
pedestrians and parking along the road), important
interchanges, bus bays, truck lay byes, toll plazas, if any)
• Are the proposed lighting scheme and illumination levels of an
appropriate standard consistent with the needs of the location,
pedestrian and other factors?
• Identify the locations where street lighting columns constitute
a hazard to traffic (on the outside of sharp curves, on small
islands, noses of medians) or which may conflict visually with
traffic signals and signs?
• Does the existing street lighting enhance as route guidance
rather than confuse the drivers ability to see the direction of
the route ahead?
• Are the appropriate types of poles used for all locations and
correctly installed (eg. slip base at correct height, rigid poles
protects if within clear zone)?
• Has lighting for signs, particularly overhead signs been
provided where necessary?
16 March 2021 81
CHECK LIST -13
LIGHTING (Contd…)
• Are there any lighting or telephone poles close to the edge
of the berms so as to pose hazard to traffic?
• Are there any lighting poles in the median unprotected by
crash barriers?
16 March 2021 82
CHECK LIST – 14
ROADSIDE HAZARDS
• Is a clear zone provided in accordance with the guidelines? Is
the appropriate treatment or projection provided for any
objects within the clear zone?
• Are bridge and culvert parapets and other obstructions close
to moving traffic? If so, can they be relocated? If not, are they
adequately provided with signs and where necessary,
protected by safety barrier?
• Are bridge parapets designed to contain errant vehicles,
where the speed and volume of traffic warrant them?
• Are the ends of bridge parapets, bridge railing and pedestrian
guardrail/crash barriers of a safe design?
• Are there any poles or columns along the road and comment
on whether some or an of them can be removed, relocated to
less hazard positions etc.
• Is there a degree of hazard associated with large trees,
boulders etc. and whether these can be treated to improve the
roadside safety?
16 March 2021 83
CHECK LIST – 14
ROADSIDE HAZARDS (Contd…)
• Do the trees and other vegetations obstruct driver and pedestrian
sight lines, which are essential for safe traffic operation?
• Are there any ‘fixed’ roadside stalls which occur within the roadway?
Comment on the need to treat them in terms of road safety.
• Is there an existence of roadside stalls and other roadside business
activities within the right of way of the road?
• Are the provided crash barriers suitable for the purpose?
• Is the length of crash barrier at each installation adequate? Are the
crash barrier installed correctly?
• Is the provided barrier / fencing in the clear zone free of separate
horizontal rails?
• Is there adequate delineation / visibility of barriers and fences during
night time?
• Are there any thorny bushes by the roadside, whose branches are
likely to hurt the passengers occupying the window seat of a vehicle,
especially a non-AC bus?
16 March 2021 84

CHECK LIST – 14
ROADSIDE HAZARDS (Contd…)
• Is any thick growth of vegetation by the roadside enough
far back from the edge of the pavement to enable a
driver to take protective steps in time if any human or
animal should run across the road from behind or within
the vegetation?
• Are there any sharp edged or pointed fixtures or tops of
supporting verticals on the median crash barriers or on
dividers which can hurt a motor cyclist in case of a
collision or crash or loss of balance.?
• Are there any village name boards or direction boards by
the roadside with pointed ends to hurt a passenger in a
bus on window seat?
• Are entrances to abandoned roads properly fenced off?
16 March 2021 85
CHECK LIST – 15
ROADSIDE FACILITIES
• Do the cross section, alignment and signages encourage drivers to
adjust their speed on entering the town or village and maintain it at
an appropriate level? (Check that it will be quite clear to drivers that
the road environment is changing and that they should slow down)
• Is there adequate and safe provision for pedestrians and non-
motorised traffic to travel along the road and to cross it? (Check for
provision of footpaths, shoulders and safe crossing places and
whether pedestrian movements are controlled and channelled by
guard rails at busy places).
• Are the design and provision of roadside parking and access to
properties adequate, controlled and safe?
• Has the opportunity been taken to improve the traffic and parking
situation (in the town and villages through which the road passes?
(Check for junction improvements, access control, provision of
service lanes, parking areas and bus stops?
• Are bus stop locations safe and proper and whether the provision for
buses to stand clear of traffic lanes has been made? Also, is there
need for lighting at these locations for the security and safety of the
passengers?
16 March 2021 86
CHECK LIST -15
ROADSIDE FACILITIES (Contd…)
• Is there any need for overtaking opportunities along the
route at regular intervals on divided roads, particularly
where traffic flows are high or in hilly terrain?
• Consider the need for rest areas and other roadside
stopping places e.g., truck stops, scenic view points,
wayside picnic areas etc. and note any current ‘unofficial’
places where vehicles stop and the degree of hazard
that this involves.
16 March 2021 87
CHECK LIST – 16
VULNERABLE ROAD USERS
• Has there been a survey of non-motorised vehicles and
pedestrian flows?
• Will there be any major conflicts between motorized traffic and
pedestrians and other disable /handicapped road users?
• Have pedestrian need for crossing the road and walking
safely alongside it been adequately provided for? (Check
particularly in towns and villages and at all junctions – check
shoulder width – check whether it is desirable and feasible to
provide a segregated footway – check whether steps are
provided where pedestrians will have to climb high
embankments)
• Is the provision for pedestrians and non-motorised vehicles at
bridges and narrow sections adequate in relation to
pedestrian and vehicular traffic volumes and traffic speeds?
• Have measures been taken to reduce the accident risk for
children going to and from roadside schools (pedestrian guard
rail may be needed to prevent children from running out onto
the road)
16 March 2021 88

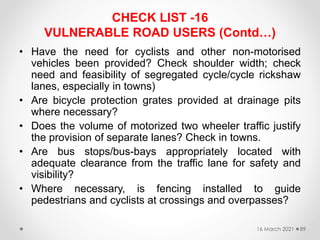

CHECK LIST -16
VULNERABLE ROAD USERS (Contd…)
• Have the need for cyclists and other non-motorised
vehicles been provided? Check shoulder width; check
need and feasibility of segregated cycle/cycle rickshaw
lanes, especially in towns)
• Are bicycle protection grates provided at drainage pits
where necessary?
• Does the volume of motorized two wheeler traffic justify
the provision of separate lanes? Check in towns.
• Are bus stops/bus-bays appropriately located with
adequate clearance from the traffic lane for safety and
visibility?
• Where necessary, is fencing installed to guide
pedestrians and cyclists at crossings and overpasses?
16 March 2021 89

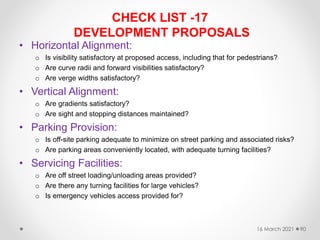

CHECK LIST -17
DEVELOPMENT PROPOSALS
• Horizontal Alignment:
o Is visibility satisfactory at proposed access, including that for pedestrians?
o Are curve radii and forward visibilities satisfactory?
o Are verge widths satisfactory?
• Vertical Alignment:
o Are gradients satisfactory?
o Are sight and stopping distances maintained?
• Parking Provision:
o Is off-site parking adequate to minimize on street parking and associated risks?
o Are parking areas conveniently located, with adequate turning facilities?
• Servicing Facilities:
o Are off street loading/unloading areas provided?
o Are there any turning facilities for large vehicles?
o Is emergency vehicles access provided for?
16 March 2021 90
CHECK LIST - 17
DEVELOPMENT PROPOSALS (Contd…)
• Landscaping:
o Does landscaping affect visibility at junctions, bends or access points?
o Is tree planting proposed where vehicles are most likely to run off road?
• Traffic Signs and Road Markings
o Have necessary traffic signs and road markings been provided as part of
development?
• Other Traffic Control Devices - Road Side furniture,
delineators, crash barriers, guard rails, etc.
• Others:
o Will there be area-wide effect on other roads?
o Will design keep speeds down where necessary?
o Are number of access points to busy roads minimized by layout?
o Are footpaths (sidewalks) necessary and provided adequately?
o Are cycle tracks required?
o Is street lighting required/ adequate?
o Are bus bays and stops safely located?
o Are dropped crossings provided at preferred pedestrian route or crossing points?
o Is pedestrian guardrail provided where walkways join the highway?
o Are truck lay byes required?
o Are toll plazas congestion free?
16 March 2021 91
CHECK LIST – 18
MAINTENANCE WORKS
• Is it publicized to the necessary extent about the road
works, including applicable speed limits and diversions?
• Are temporary traffic signals or road markings adequate
and does the message reach all road users?
• Has a temporary speed limit been suggested and is it
proper?
• Will it be possible for the unaffected road users to see
(and misunderstand) temporary traffic signals?
• Is the standard of proposed signs adequate?
16 March 2021 92

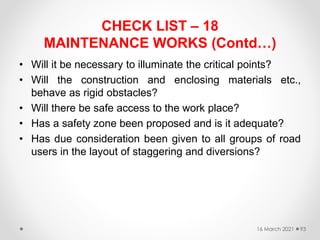

CHECK LIST – 18
MAINTENANCE WORKS (Contd…)
• Will it be necessary to illuminate the critical points?
• Will the construction and enclosing materials etc.,
behave as rigid obstacles?
• Will there be safe access to the work place?
• Has a safety zone been proposed and is it adequate?
• Has due consideration been given to all groups of road
users in the layout of staggering and diversions?
16 March 2021 93

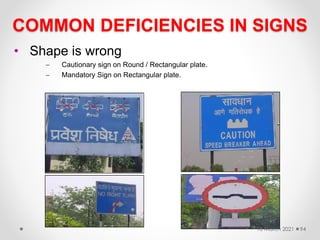

COMMON DEFICIENCIES IN SIGNS
• Shape is wrong
 Cautionary sign on Round / Rectangular plate.
 Mandatory Sign on Rectangular plate.
16 March 2021 94

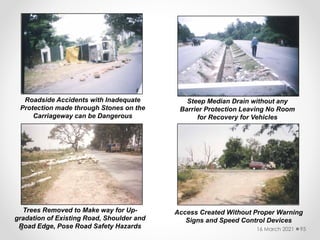

Roadside Accidents with Inadequate
Protection made through Stones on the
Carriageway can be Dangerous
Steep Median Drain without any
Barrier Protection Leaving No Room
for Recovery for Vehicles
Trees Removed to Make way for Up-
gradation of Existing Road, Shoulder and
Road Edge, Pose Road Safety Hazards
Access Created Without Proper Warning
Signs and Speed Control Devices
16 March 2021 95

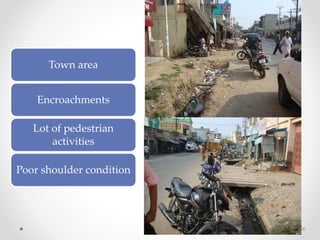

Town area
Encroachments
Lot of pedestrian
activities
Poor shoulder condition
96

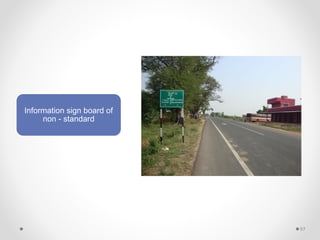

Information sign board of
non - standard
97
Accident prone area
Petrol bunk entry and exit
not as per IRC
Sharp Curve
98
Bypass starts
No information sign board
99

Non- standard speed
breaker provided on project
road
Not properly designed
100

T Junction
No sufficient sight
distance
101

Intersection
Town Area
Intense Pedestrian
activities
102

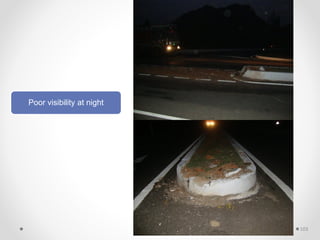

Poor visibility at night
103

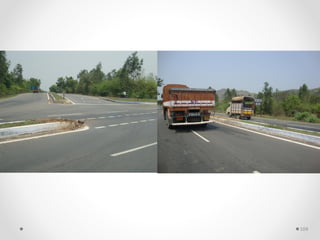

104

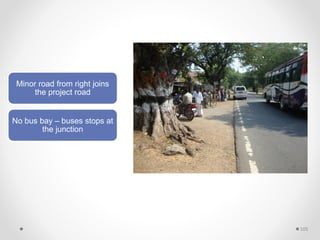

Minor road from right joins
the project road
No bus bay – buses stops at
the junction
105
Highway alignment along a
series of curve
106

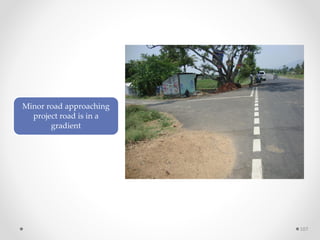

Minor road approaching
project road is in a
gradient
107

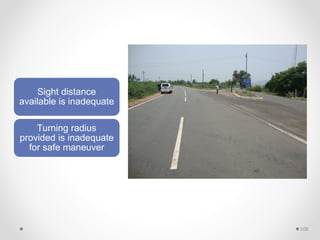

Sight distance
available is inadequate
Turning radius
provided is inadequate
for safe maneuver
108
Intersection
Sign boards are not
provided
109

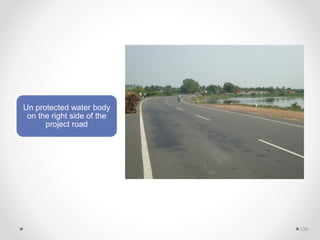

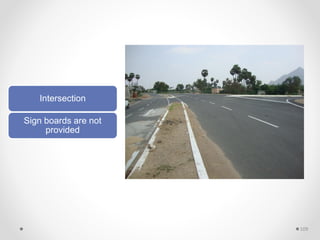

Un protected water body
on the right side of the
project road

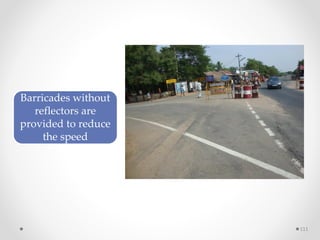

110
Barricades without
reflectors are
provided to reduce
the speed
111
Barricades without
reflectors are
provided to reduce
the speed
112

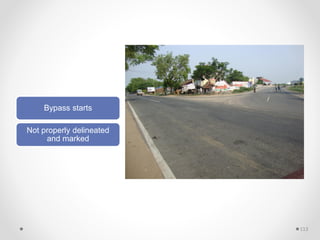

Bypass starts
Not properly delineated
and marked
113
Non-standard speed breakers
114

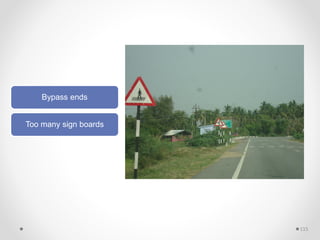

Bypass ends
Too many sign boards
115
Unprotected water body
116
Minor road ahead
warning sign board
missing

117
Barricades without
reflectors
118

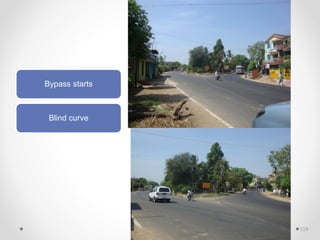

Bypass starts
Blind curve
119

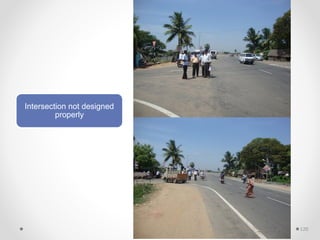

Intersection not designed
properly
120

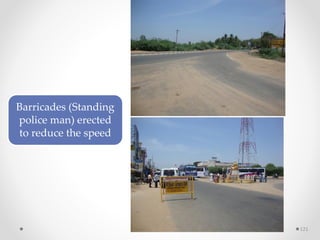

Barricades (Standing
police man) erected
to reduce the speed
121

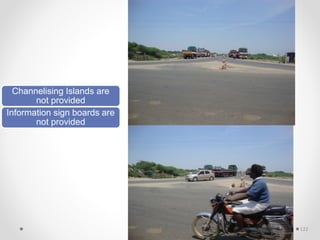

Channelising Islands are
not provided
Information sign boards are
not provided

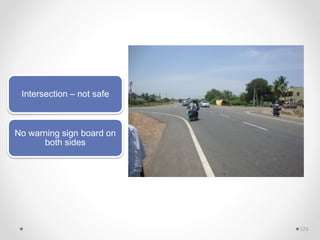

122
Intersection – not safe
No warning sign board on
both sides

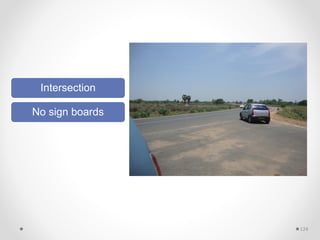

123
Intersection
No sign boards
124
Designed not considering
safety features
Accident prone area

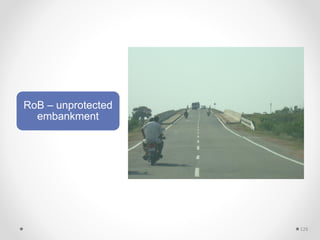

125
RoB – unprotected
embankment
126
Junction - unsafe
127
Unwanted chevron sign board provided
on median
128
129
Thank you
16 March 2021 130

The Road Safety and concomcerning audit .pdf

  • 1.
    Contents • Definition, Aimsand Benefits • Why accidents occur despite the use of current design standards? • Concepts of Road Safety Audit • Road Safety Auditors & key personnel • Organizing and conducting the Road Safety Audit • Examples and commonly identified issues in RSA • Road Safety Audit Check List 16 March 2021 1
  • 2.
    ROAD SAFETY AUDIT •A formal procedure for o assessing accident potential o assessing safety performance of • existing road • future road • traffic related project or • project, which interacts with road users • Input to the design process o separate from actual design • Focus on physical elements of road 16 March 2021 2
  • 3.
    ROAD SAFETY AUDIT •A formal process and not an informal check • Carried out by persons who are independent of the design and construction • Carried out by persons with appropriate expertise, experience and training and • Restricted to road safety issues 16 March 2021 3
  • 4.
    PRINCIPLE OF ROADSAFETY A Safe environment should • Warn the driver of any substandard or unusual features. • Inform the driver through unusual sections • Control the driver’s passage through conflict points or sections and • Be forgiving of the driver’s errant or inappropriate behaviour Similar situations must be treated in similar way; it is better to avoid • Insufficient or deficient treatment • Incorrect or misplaced treatment • Exaggerated treatment • Dissimilar treatment for similar situations 16 March 2021 4
  • 5.
    PRINCIPLE OF ROADSAFETY Road Safety Audit is the systematic application of safety principles. Specific aims are: • To minimize the risk of accident occurring on the road project and to minimize the severity of accident that does occur. • To minimize the risk of accidents occurring on adjacent roads in the network as a result of a scheme • To recognize the importance of safety in highway design to meet the needs and perceptions of all types of road users and to achieve a balance between needs where they may be in conflict • To reduce the long-term costs of a road project, bearing in mind that unsafe design may be expensive or even impossible to correct at a larger stage and • To improve the awareness about safe design practices among those involved in the planning, design, construction, operation and maintenance of roads 16 March 2021 5
  • 6.
    BENEFITS OF CONDUCTING ROADSAFETY AUDIT • The likelihood of accidents on the road network can be reduced • The severity of accidents can be reduced, • Road safety is given greater prominence in the minds of road designers and traffic engineers, • The need for costly remedial work is reduced and • The total cost of a project to the community, including accidents, disruption and trauma, is minimized. 16 March 2021 6
  • 7.
    ROAD SAFETY AUDITIS : • Minimizing the likelihood of crashes occurring through safety- conscious planning and design • Ensuring that, if a crash occurs, then the likelihood of the injury is minimized • Ensuring that safety related design criteria have been met; • Managing risks, such that the risk of major safety problems occurring is less than the risk of minor problems occurring; • Reducing the whole-life cycle costs of a design • Minimizing the risk of crashes on the adjacent road network as well as on the new road scheme; • Enhancing the importance and relevance of road safety engineering in highway design work and to enhance consideration for the safety of all categories of road users in all new and existing schemes. 16 March 2021 7
  • 8.
    Road Safety Auditis NOT • A way of assessing or rating project as good or poor; • A means of ranking or justifying one project against others in a work programme; • A way of rating one option against another; • An accident investigation • A redesign of a project; • Something to be applied only to high cost projects or only to projects involving safety problems; • The name you use to describe informal checks, inspections and consultations; • An opportunity to raise subjective concerns. 16 March 2021 8
  • 9.
    Underlying Concepts • Preventionis better than cure  Less trauma  Less money for treatments • Drive, Ride, Walk in Safety  Less accident costs over whole economic life of project 16 March 2021 9
  • 10.
    MAIN FUNCTIONS OFTHE KEY PLAYERS IN ROAD SAFETY AUDIT Key Players Main Functions Project Owner (Govt. and /or Concessionaire) • Expresses a commitment to road safety • Provides funding and resources • Considers safety audits and reviews as an essential quality control requirement • Selects road safety audit team • Facilitates the response to the recommendations of audits and reviews and arranges implementation of recommendations that are accepted • Attends commencement and completion meetings Design Team • Attends commencement and completion meetings • Provides relevant information to safety team • Acts upon and documents response to recommendations of audit Safety Audit Team • Identifies safety issues in the proposed design • Makes constructive recommendations to enhance safety • Documents safety issues and recommendations • Holds commencement and completion meetings with the client and design team 16 March 2021 10
  • 11.
    TYPE OF PROJECTSFOR SAFETY AUDIT • Expressways • Major four-laning and multi-laning projects • Reconstruction and realignment projects • Intersection projects both signalised and non-signalised • Pedestrian and bicycle routes • Rural roads providing access to villages/habitations • Access roads near project roads • Local area traffic management schemes in urban areas • Accident reduction schemes • Traffic calming measures through built-up areas • Approaches to bridges, rail over/under bridges • Grade separators and interchanges 16 March 2021 11
  • 12.
    STAGES OF ROADSAFETY AUDIT • During Feasibility Study o Route options, layout options, standards, impact on network, number of junctions , possible hazards • Completion of preliminary Design o Project changes since stage 1 audit, Alignment, Cross-section, Arrangement of junctions , any interim measures • Completion of Detailed Design o Project changes since stage 2 audit, detail design of junctions, Geometrics, cross-fall, side drains, signs, markings, embankment slopes, traffic signal, lighting, interim measures • During Construction Stage o Terminal transition zone, work zone etc., Safety measure for women and road workers, traffic control devices at construction zone • Completion of Construction(Pre- opening) o A final review • Audit on Existing Roads and during operation and maintenance of concession projects o Safety hazards identification to prevent accidents 16 March 2021 12
  • 13.
    The steps Responsibilityof Select the Audit Team Provide the Background Information Hold a Commencement Meeting Assess the Documents Inspect the Site Write the Audit Report Hold a Completion Meeting Write the Responses Implement the Changes Client or Designer Client and Designer Client/ Designer and Audit Team Audit Team Audit Team Audit Team and Client/ Designer Client and Designer Designer ………………………… …………………………… ……………………… ………………… …………………………… ………………………… …………………………… …………………………… AUDIT PROCESS 16 March 2021 13
  • 14.
    RESOURCES FOR SAFETYAUDIT • Team o Average two persons o Around seven for major schemes • Time required o 25 person hours o 45 person hours for major schemes • Audit cost o Ranging from Rs 10,000 to Rs. 20,000 per km of Road • Redesign cost o 0.5% of original construction cost of major schemes o 3% of original construction cost of small schemes • Positive economic benefit 16 March 2021 14
  • 15.
    SELECTION OF AUDITOR •Auditor is Independent o team or individual o application of ‘fresh eyes’ to the task • Adequate experience o trained or worked on previous audit 16 March 2021 15
  • 16.
    SELECTION OF AUDITOR(CONTD.) • Necessary Skills o road safety engineering o traffic engineering o traffic management o road design o accident investigation and prevention • Correct Aptitude o ability to identify potential safety problems from different road users’ view point 16 March 2021 16
  • 17.
    AUDIT OF EXISTINGROAD SECTIONS • Road inventory • Classified Volume Counts • Speed Surveys • First information reports from police stations 16 March 2021 17
  • 18.
    Safety in DifferentStages of the Project Stage of the Project Focus of the Audit Feasibility Safety issues associated with options such as route locations, design speed and standards, impact on adjacent network, provision of intersections and interchanges, access control, no. of lanes, traffic control, functionality, future needs. Preliminary Project Report (PPR) Evaluation of general design standards, alignment, sight distance and lines of sight, intersection layout, lanes and shoulder widths, cross-slopes, provision for buses, cycles, pedestrians, emergency vehicles, rest areas, parking etc., safety during construction. Detailed Project Report (DPR) Examining safety issues of specific geometric design features, traffic control devices, delineation, road side clear zones, intersection details, glare screens and lightning, safety issues related to landscaping, provision for special road users like elderly, school children, buses, equestrian, rail roads, heavy trucks etc. • Construction Sites • During construction Examining the maintenance of existing lanes during construction, ensuring safe and smooth flow of traffic, safety of all road users, construction workers required road signs, markings and other traffic control devices, lighting at work zones. Pre-opening Final check prior to opening the facility to ensure that the safety concerns of all road users have been addressed and that the hazardous conditions have been eliminated. Should include day/night checks; evaluation considering dry/wet weather; driving/riding and walking. On existing roads and during O&M of concessions An audit of existing roadway to determine, if the safety needs of all road users are currently being served. It recognizes that a roadway may change over time. Changes may have resulted from changing road use, encroachments, design inconsistency, aging infrastructure and inadequate maintenance. Points to be emphasized are adequacy of roadway, road side and intersections, location of bus stops, interaction of VRUs, access management. 16 March 2021 18
  • 19.
    WHO SHOULD CARRYOUT SAFETY AUDIT? • Must be independent of the design team • Team of at least two people • At least one safety engineering “expert” • Others o Highway engineers o Road safety education specialist o Traffic police o Maintenance specialist 16 March 2021 19
  • 20.
    What to Lookfor in RSA? • Mistakes • Lack of attention to detail • Lack of understanding of safety issues • Interaction of design elements • Poor provision for vulnerable road users • Poor or misleading design 16 March 2021 20
  • 21.
    PROJECT ASSESSMENT • Statementof Expected Outcome o Terms of Reference of the proposed audit • Project Intent o any deficiencies o input from prior discussion, correspondence and consultation • Site Data o accident history o traffic of all users o any known safety issues o design standards used o environmental effects • Plans and Drawings o horizontal and vertical alignment o intersection layouts 16 March 2021 21
  • 22.
    SITE INSPECTION • Day,night and inclement weather • From view point of all category of road users • Also to include adjacent sections of roads • Consider different types of movements  merging and diverging  road crossing  traveling along the road • Consider all age groups  children, ladies, aged  physically challenged 16 March 2021 22
  • 23.
    ROAD SAFETY AUDITREPORT • Project Information  Audit stage • Background Information  Support data/information  Audit Team  Details of Inspections • Findings and Recommendations • Formal Statement 16 March 2021 23
  • 24.
    PRINCIPLES FOR SAFERROAD DESIGN • A safe road environment should  WARN for unusual features  INFORM of conditions to be encountered  GUIDE through unusual sections  CONTROL through conflict points  FORGIVE for errant behaviors • A safe road environment is one which provides  No surprises  Controlled release of relevant information  Repeated pertinent information 16 March 2021 24
  • 25.
    SAFETY PRINCIPLES • MainParameters  Geometric Design  Road Surface Characteristics  Road Markings and Delineation  Road Signs, Street Furniture and Appurtenances  Traffic Management  Road Works and Maintenance 16 March 2021 25
  • 26.
    SAFETY AUDIT CHECKLISTS •Useful ‘Aide Memoir’ • Checking that important safety aspects are not overlooked • Understanding of safety in design • Provide a systematic procedure • Provide guidelines on principle safety issues • To be used for Audit in  Assessment of documents/drawings  Site inspection  Report writing 16 March 2021 26
  • 27.
    COMMON IDENTIFIED PROBLEMS •Pedestrians  Walkways not continuous  Improper locations for crossings  Inadequate guard rails  Lack of dropped kerb at crossings • Cyclists  Absence/ Discontinuity of cycle lanes  Obstruction from street furniture  Lack of proper signs • Motor Cyclists  Slippery road surface  Protruding manholes 16 March 2021 27
  • 28.
    COMMON IDENTIFIED PROBLEMS •User of Public Transport  Inadequate facilities  Unsafe locations • Vehicle Users  High speed  Inadequate, incorrect and obscured signs  Uncontrolled accesses  Poorly sited street furniture  Signs/ Lamp posts in front of safety fences  Conflict points at intersections not eliminated  Poor visibility  Poor skid resistance 16 March 2021 28
  • 29.
    CODE OF GOODPRACTICE • Management of safety audits by highway authorities to establish the procedures • Selection of the audit team depending upon size and type of scheme, audit stage and available resources • Various amount of information is required from the design engineer • Audit recommendations must be responded to either through redesign/implementation of changes or explained in an exception report if recommendations not accepted • Monitoring and evaluation of the schemes and procedures of the audit are essential 16 March 2021 29
  • 30.
    CHECKLISTS FOR CARRYINGOUT ROAD SAFETY AUDIT FOR DIFFERENT STAGES OF THE PROJECT Check list 1 Stage 1 Audit (During Feasibility Study) Check list 2 Stage 2 Audit (Completion of Preliminary Design) Check list 3 Stage 3 Audit (Completion of Detailed Design) Check list 4 Stage 4 Audit ( During Construction Stage) Check list 5 Stage 5 Audit ( Pre-opening) Check list 6 Stage 6 Audit ( On Existing Road) Check list 7 Planning Check list 8 Alignment Check list 9 Cross section Check list 10 Intersections and interchanges Check list 11 Road signs Check list 12 Road markings Check list 13 Lighting Check list 14 Roadside hazards Check list 15 Roadside facilities Check list 16 Vulnerable road users Check list 17 Development proposals Check list 18 Maintenance work 16 March 2021 30
  • 31.
    CHECK LIST- 1 STAGE1 AUDIT (DURING FEASIBILITY STUDY) • What is the category of road for which the feasibility study has been carried out? • Is the road intended to carry high-speed traffic or serve local access needs only? • What kind of traffic is likely ranging from high speed mixed traffic or for more general use, including bicycles and significant pedestrian traffic? • Do the chosen type of road and the standards, alignment and cross-section offer optimum road safety to all groups of road user including disabled? • Does the project follow existing roads or is it a ‘green field project’ and what are the effects? 16 March 2021 31
  • 32.
    CHECK LIST- 1 AUDITDURING FEASIBILITY STUDY (CONTD…) • Check whether appropriate design standards have been used in relation to scope of project and traffic mix? • Check appropriateness of the designs for the design volume and traffic characteristics? • Has access control been proposed? • Will the proposed scheme be compatible with the standard of conjoining road sections? • Will there be sufficient opportunities for overtaking? • Are the number and distribution of intersections appropriate in relation to: o The desired function of the new road? o Impact on the surrounding, adjacent and/or off-loaded road network? o Accessibility for public transport and emergency vehicles? 16 March 2021 32
  • 33.
    CHECK LIST -1 AUDITDURING FEASIBILITY STUDY (CONTD…) • Are junction types shown the safest available at each location, in relation to the expected turning volumes? • Are the proposed horizontal and vertical alignments consistent with visibility requirements? • Has lightning been planned? (safety at links and junctions) • Will the project have any effect on existing pedestrian and cycle routes? • Does the project include measures for vulnerable road users? • Do the available accident data for existing /adjacent road network give reason to expect particular road safety problems? 16 March 2021 33
  • 34.
    CHECK LIST- 1 AUDITDURING FEASIBILITY STUDY (CONTD…) • Whether non-motorised traffic is expected to cause problems? • What is likelihood of future widening? • Do the gradients, curves and general design approach fit in with the class of terrain and likely weather or environmental aspects? • Check any special events creating unusual or hazardous conditions? • Other checks pertinent to the project at discretion of auditor or client. 16 March 2021 34
  • 35.
    CHECK LIST –2 AUDIT DURING COMPLETION OF PRELIMINARY DESIGN • Have all recommendations from previous stage been followed? • Is the desired speed compatible with the cross-section and other design elements and is the design speed realistic? • Cross-section: o Has delineation of the carriageway with a kerb been proposed? o Is there adequate space for all groups of road users? o Is there appropriate separation between various groups of road users? • Horizontal and vertical alignment and visibility: o Do the proposed alignment satisfy any demands on visibility at junctions and sight distances on free sections? o Will sight distances /visibility be blocked? o Can parts of project constitute a risk, especially in combination( e.g. peaks in the vertical alignment plus sharp horizontal bends) 16 March 2021 35
  • 36.
    CHECK LIST –2 AUDIT DURING COMPLETION OF PRELIMINARY DESIGN (Contd…) • Are the lane widths, shoulders, medians and other cross-section features in accordance with standard design and adequate for the function of the road? • Check whether there are undesirable variations in cross-section design. Check cross falls • Check the safety aspects of shoulder provision? • Check for the provision of climbing lanes in hilly sections where vertical gradients are steep? 16 March 2021 36
  • 37.
    CHECK LIST- 2AUDIT DURING COMPLETION OF PRELIMINARY DESIGN (Contd…) • Junctions, interchanges and their design: o Will road users coming from all directions (including side roads) be able to see that they are approaching a conflict area? Are give-way lines, stop lines, turning lanes and ramps clearly visible? o Are existing conjoining and intersecting roads appropriately adjusted and matched to the new road (without sharp bends and gradients)? o Do the routes of road users through the junction seem clear for all directions and manoeuvres? o Is there sufficient space for all types of vehicles to undertake all manoeuvres? o Are the crossing facilities for pedestrians and non-motorised traffic adequate and safe? o Can parking cause problems? o Have roundabouts been considered? In urban areas, ghost markings and left-turning lanes with islands are safest; they prevent overtaking and assist pedestrians and cyclists who are crossing the road. 16 March 2021 37
  • 38.
    CHECK LIST- 2AUDIT DURING COMPLETION OF PRELIMINARY DESIGN (Contd…) • Decide whether or not old, unremoved section of road can give undesired optical directions. • Special points at roundabouts: o Are all entrance lanes curved and is speed adequately reduced? o Will the central island be visible? o Are the measures taken for the benefit of pedestrians from a safe stopping distance and cycle traffic adequate? • At the junction/transition to existing roads (especially from multi-lane to two-lane, dual to single carriageway): o Are there sudden changes of alignment? o Does the road standard change too rapidly, or can road users clearly see and recognize the transition in good time? o Would a roundabout be able to mitigate any sudden changes in standards and alignment? 16 March 2021 38
  • 39.
    CHECK LIST- 2AUDIT DURING COMPLETION OF PRELIMINARY DESIGN (Contd…) • Are existing junctions and intersections adjusted and matched to the new road appropriately (without sharp bends and gradients)? • Are there any constructions that will be difficult to drain and are the cross-fall and any gutter gradient adequate at the critical spots? • Are there places where there is a risk of flooding? • Will overtaking be prevented at critical places (not simply by restrictions, but also by making it quite apparent that overtaking is prohibited)? • If signs and road markings have been proposed: o Are the markings consistent and are they adequate? o Has the quantity of information been kept at a reasonable level? 16 March 2021 39
  • 40.
    CHECK LIST- 2AUDIT DURING COMPLETION OF PRELIMINARY DESIGN (Contd…) • If markings have not been proposed: will special markings be necessary? • Is there any risk that cannot be "marked out of existence"? • Will there be any large sign constructions? Is so; will guardrails or breakaway safety devices protect them? • Has it been proposed that lighting be located on the outside or inside of bends? • Will it be possible to carry out maintenance work (on lighting, gantries, plantations, etc.) safely and without using the carriageway or cycle path? • Is the landscaping design or plantation likely to lead to a lowering of safety with mature or seasonal growth? Is frangible vegetation appropriate? 16 March 2021 40
  • 41.
    CHECK LIST- 2AUDIT DURING COMPLETION OF PRELIMINARY DESIGN (Contd…) • Are there arrangements for safe access by emergency vehicles? Check the design of medians and barriers, and the ability of emergency vehicles to stop without necessarily disrupting traffic? • Pedestrians o Have pedestrian needs been considered? o If footpaths are not specifically provided, is the road layout safe for use by pedestrians, particularly at blind corners and on bridges? o Are pedestrian subways or footbridges sited to provide maximum use? o Is the avoidance of footbridges or subways possible by crossing the road at grade? o Has specific provision been made for pedestrian crossings, school crossings or pedestrian signals? o Are pedestrian refuges/kerb extensions needed? o Whether needs of disabled road users taken care of? 16 March 2021 41
  • 42.
    CHECK LIST- 2AUDIT DURING COMPLETION OF PRELIMINARY DESIGN (Contd…) • Have the needs of public transport users been considered? Are bus stops positioned for safety? • Is lighting envisaged in specified locations of the project? Are the difficulties of illuminating sections of the road caused by trees or over bridges, for example? Are there any aspects of the provision of the lighting poles, which would require consideration from the safety point of view in their being struck by vehicles? • Is adequate safe access to the work site available? • Are there any factors requiring specific road safety provision, including maintenance? • Are there any traffic management features, which would require special attention during construction or during the transition from construction to full operation? • Other checks made at discretion of auditor or client. 16 March 2021 42
  • 43.
    CHECK LIST -3 AUDIT DURING COMPLETION OF DETAILED DESIGN • Have all recommendations from the previous stage been followed? If not, reasons thereof? • Visibility, sight distance o Are horizontal and vertical alignments consistent with the required visibility requirements? o Confirm whether the standard adopted for provision of visibility in the design is appropriate for the ruling design speed and for any unusual traffic mix. o Check whether sight lines are obstructed by: • Safety fences • Boundary fences • Street furniture • Parking facilities • Signs • Landscaping • Bridge abutments o Check whether railway crossings, bridges and other hazards are conspicuous. o Will sight lines to be obstructed by temporary features such as parked vehicles in lay-byes or parked or queued traffic has been taken care of? 16 March 2021 43
  • 44.
    CHECK LIST -3 AUDIT DURING COMPLETION OF DETAILED DESIGN (Contd…) • Check whether the design standards are appropriate for all the new requirements of the proposed project and check for consistency of general standards and guidelines such as lane widths, camber and cross-fall. • Cross-sections: o Are cross-falls appropriate? o Is there a suitable gutter gradient or is the carriageway laid at a suitable height above the shoulder? • Lighting columns, traffic signals, sign standards, etc.: o Have requirements on safe distances to carriageway and cycle path been observed? o Have breakaway safety devices or such like been proposed? 16 March 2021 44
  • 45.
    CHECK LIST -3 AUDIT DURING COMPLETION OF DETAILED DESIGN (Contd…) • Signs and markings: o Are markings consistent along the entire road section? o Is the information clear? o Are there enough signs? o Are there too many signs? o Will signs mask each other or traffic signals (be sure to include all plans for signs and markings in your assessment)? o Are the signs correctly positioned, without obstructing sight distances/visibility in any way? • Are the proposed types of kerb stone/edge marking appropriate? • Lighting: o Is there any risk that the lighting can be optically misleading and will it have any detrimental effects on traffic signals and signs? o Are there any unlit areas that could conceal hazards? o Will an illuminated side road mislead road users on the planned, unlit road? o Are all pedestrian crossings illuminated (not merely the formally marked crossings, but also unmarked places where pedestrians could be expected to cross)? o Will powerful illumination of adjoining areas or strongly illuminated advertisements cause problems? 16 March 2021 45
  • 46.
    CHECK LIST -3 AUDIT DURING COMPLETION OF DETAILED DESIGN (Contd…) • Junctions, interchanges and their design: o Will road users coming from all directions (including side roads) be able to see that they are approaching a conflict area? Are give-way lines, stop lines, turning lanes and ramps clearly visible? o Are existing conjoining and intersecting roads appropriately adjusted and matched to the new road (without sharp bends and gradients)? o Do the routes of road users through the junction seem clear for all directions and manoeuvres? o Is there sufficient space for all types of vehicles to undertake all manoeuvres? o Are the crossing facilities for pedestrians and non-motorised traffic adequate and safe? o Can parking cause problems? o Have roundabouts been considered? In urban areas, ghost markings and left-turning lanes with islands are safest; they prevent overtaking and assist pedestrians and cyclists who are crossing the road. 16 March 2021 46
  • 47.
    CHECK LIST –3 AUDIT DURING COMPLETION OF DETAILED DESIGN (Contd…) • Decide whether or not old, unremoved section of road can give undesired optical directions. • Special points at roundabouts: o Are all entrance lanes curved and is speed adequately reduced? o Will the central island be visible? o Are the measures taken for the benefit of pedestrians from safe stopping distance and cycle traffic adequate? • At the junction/transition to existing roads (especially from multi-lane to two-lane, dual to single carriageway): o Are there sudden changes of alignment? o Does the road standard change too rapidly, or can road users clearly see and recognise the transition in good time? o Would a roundabout be able to mitigate any sudden changes in standards and alignment? 16 March 2021 47
  • 48.
    CHECK LIST -3 AUDIT DURING COMPLETION OF DETAILED DESIGN (Contd…) • Are existing junctions and intersections adjusted and matched to the new road appropriately (without sharp bends and gradients)? • Guardrails, hedges and railings: o Are all vulnerable areas protected? o Are bridge pillars, steel posts, trees etc., protected by guardrails where necessary? o Are there places where hedges are necessary to prevent pedestrians from crossing? o Are the chosen hedges/guardrails "light" enough? o Do guardrails/road side furniture have any hazardous sharp protruding edges? • Road surface: o Has a porous type of surface been chosen? o Will an exceptionally high-friction surface be necessary in especially exposed places? o Would a change of surface as a purely visual signal to road users be of benefit? Used in this way, could a change of surface be misunderstood by road users? 16 March 2021 48
  • 49.
    CHECK LIST -3 AUDIT DURING COMPLETION OF DETAILED DESIGN (Contd…) • At junction/transition to existing road network (especially from multi-lane to two-lane, end of central reverse) o Is there sufficient advance warning? o Are reflector posts correctly positioned? o Are ghost markings appropriate in connection with the merging of two lanes? o Is there continuity of edge markings? • For two-lane sections prepared for expansion to four lanes with central reverse (e.g. expressways built as “semi-motorways”) o Will road users be clear everywhere that they are not on one-way, two-lane carriageway? o Should night illumination of signs be of extra high standards? o Is overtaking prevented at all points where prevention is necessary? o Should special measures are adopted at bridges built with a view to future expansion? 16 March 2021 49
  • 50.
    CHECK LIST –3 AUDIT DURING COMPLETION OF DETAILED DESIGN (Contd…) • Examine adjoining areas for potential safety problems (airfields, signals for maritime traffic and railways, flying golf balls etc.) • Additional temporary signs will be necessary for most new constructions. In this context consider: o Is the text comprehensible and correct? o Have all signs be positioned safely? o When will be they removed? o Be sure also to use the separate checklists for specific facilities and measures. • Landscaping: o Is there advertising conflict between landscaping and visibility requirements? o Has ultimate growth height been considered and potential obstructions to pedestrian visibility and for trees to become collision object? o Will maintenance of soft landscaping be safe? 16 March 2021 50
  • 51.
    CHECK LIST -3 AUDIT DURING COMPLETION OF DETAILED DESIGN (Contd…) • Plantations: o Will plantations obscure visibility and has a maximum height been specified? o Are plantations likely to encroach on markings or lighting? o Will fully-grown trees constitute a hazard? o Can maintenance be carried out safely? • Lay byes: o Are there any lay-byes available in the section? o Is the by bye properly located and it is not inconvenient to the drivers to stop the vehicles? o Is there any need to modify the lay-bye design (if yes, suggest the parameters that need modification)? / o Are advance warning signs and markings properly guiding the driver about the lay-bye? o Is there any need of any additional signs and markings? 16 March 2021 51
  • 52.
    CHECK LIST -3 AUDIT DURING COMPLETION OF DETAILED DESIGN (Contd…) • Check provision for pedestrians to cross safely at intersections, signalised and pedestrian crossings, refuges, kerb extensions and at other locations. • Are median barriers necessary and have they been properly detailed? Are there any design features such as end conditions which require special attention? • Are there any poles located adjacent to moving traffic which could be sited elsewhere? • Have frangible or breakaway poles been detailed? • Is the unprotected median width adequate to accommodate lighting poles? • Are there any obstructions, which are likely to create a safety hazard and can they be mitigated or relocated? • Is a crash barrier provided wherever necessary and is it properly detailed? 16 March 2021 52
  • 53.
    CHECK LIST -3 AUDIT DURING COMPLETION OF DETAILED DESIGN (Contd…) • Check whether access to structures and road furniture is safe. Check that the road or utilities in the road reserve can be maintained safely. Both road users and maintenance personnel should be considered. • Check that the requirements for the traffic management of the construction site and safety measures needed for workers and road users have been adequately spelled out from the safety point of view including the transition from the existing arrangements to the construction site and from the construction site to the final layout can be effected safely. • Check for the arrangement for temporary and permanent traffic control devices, including possible signals, temporary diversion etc. • Check that the design duly considers the needs of persons with disabilities. • Other checks made at discretion of auditor or client. 16 March 2021 53
  • 54.
    CHECK LIST- 4 AUDITDURING CONSTRUCTION STAGE • Have all recommendations from the previous stage been followed? If not, why not? • Whether information regarding the construction zone approaching has been provided well in advance or not? • Whether standard procedure and contract conditions provided for proper management of the construction site and road users are properly and safely accommodated? • Whether the transitions from the existing road to the site of works safe and clearly laid out? • Whether the width of the lanes is satisfactory for the traffic passing through the works area? • Whether sight and stopping distances adequate at site of works and at intersections? 16 March 2021 54
  • 55.
    CHECKLIST - 4 AUDITDURING CONSTRUCTION STAGE (Contd…) • Whether bus stops appropriately located with adequate clearance from the traffic lane for safety and visibility. • Whether appropriate street lighting or other delineation provided at the road works to ensure that the site is safe at night? Check the night time visibility of traffic control devices. • Check for proper education and training programme for site operators and managers, which would assist in creating and maintaining safer environment for construction workers and road users. • For clear and sufficient information to the road user, advance warning signs installed or not? 16 March 2021 55
  • 56.
    CHECKLIST - 4 AUDITDURING CONSTRUCTION STAGE (Contd…) • Is there any provision of marked lanes for safe and clearly guiding road users? • Whether suitable measures provided through construction zones to control driver behaviour? • Check for the adequacy of traffic control devices (such as signs, markings, cones, drums, delineators, barricades, flashing lights etc.) required for each zone i.e., at advance warning zone, at approach transition zone and at work zone? Check for placement and visibility of these control devices. • Has permission been taken while changing the standard layouts from safety point of view? • Whether police and other emergency services been consulted? • Check for proper care and attention for pedestrian and non- motorised traffic at construction sites. 16 March 2021 56
  • 57.
    CHECKLIST - 4 AUDITDURING CONSTRUCTION STAGE (Contd…) • Check for adequate safety provisions for the elderly and persons with disabilities. • Whether construction workers provided with protective clothing etc. reflecting jackets, hard hats, gloves etc.? • Whether flagmen are available on duty at the appropriate places? Check for proper traffic management practice to avoid inhibiting traffic to pass clear of work site and necessary attention to roadside safety. • Whether the temporary diversion is provided at work zones in compliance with the contract and traffic management plan approved by the Engineer. • Whether the Traffic Management Plan at work site prepared and submitted by the Contractor to the Engineer for approval. • Is the Supervision Engineer ensuring the required quality of traffic management plan? 16 March 2021 57
  • 58.
    CHECKLIST - 4 AUDITDURING CONSTRUCTION STAGE (Contd…) • Whether arrangements of First Aid Box and other emergency care exist for persons getting injured. • Whether suitable speed reducing measures are provided at work zones. • Other checks made at discretion of auditor or client. 16 March 2021 58
  • 59.
    CHECKLIST - 5 AUDITDURING COMPLETION OF CONSTRUCTION/PRE-OPENING • Have all recommendations from the previous stages been followed? If not, why not? • Involve the site engineer • Test the installations of traffic control devices as a road user: by car, by truck, by bus, by cycle and on foot - from disabled road user angle. Also in the dark/ night hours. • Examine the carriageway for defects, especially at junctions to existing roads. • Has the opening of the road facility been adequately publicized? • How will the transition phase proceed? • Check that provision for emergency vehicle access and stopping is safe? • Check that all delineators and pavement markings are correctly in place. 16 March 2021 59
  • 60.
    CHECKLIST - 5 AUDITDURING COMPLETION OF CONSTRUCTION/PRE-OPENING (Contd…) • Check that all signs and other traffic control devices are correctly in place. Check that they are likely to remain visible at all times. • Check that the road markings as installed have sufficient contrast with the surfacing and are clear of debris. • Check that all lighting operating is effective from safety point of view. • Check that no roadside hazard has been installed or overlooked. • Check that the form and function of the road and its traffic management are easily recognised under likely operating conditions. • Check that all temporary arrangements, signing, etc., have been removed and replaced by permanent arrangements. • Other checks made at discretion of auditor or client. 16 March 2021 60
  • 61.
    CHECK LIST -6 AUDIT ON EXISTING ROADS OR DURING OPERATION & MANAGEMENT • Results of accident analysis. • Does the actual function of the road correspond to its intended function? • Are the prevailing speed levels within the desirable limits? • Do the equipment and standard of the road correspond to its function, speed level and classification? (Use checklist 2 and 3, as well as any specific checklists, which are relevant.) • Do the road users park on the carriageway that could cause hazards? • Do plantations obscure the visibility and mask the view of the signs? • Are the surface and carriageway markings in good visible condition? • Are there any signs that results in road users drive over islands or kerbs or that the routes taken by the motorists through junctions and bends that are unsafe? 16 March 2021 61
  • 62.
    CHECK LIST -6 AUDIT ON EXISTING ROADS OR DURING OPERATION & MANAGEMENT (Contd…) • Are there conflict situations that are likely to result in accidents? • Are the safe distances to rigid obstacles maintained at all locations? • Are medians and islands of adequate width for the road users? • Are there adequate safe pedestrian crossing facilities? Are the existing facilities safe? • Are there safe pedestrian sidewalks, as per standards? • Does there appear to be a need for more or better crossing facilities for pedestrians? • Does there appear to be a need for more or better facilities for cyclists? • Has due consideration given for physically disabled, old, and children in using the road space safely? 16 March 2021 62
  • 63.
    CHECK LIST -6 AUDIT ON EXISTING ROADS OR DURING OPERATION & MANAGEMENT (Contd…) • Are bus stops and bus bays located considering safety with adequate visibility and clearance to the traffic lane? • Are provisions for parking satisfactory in relation to traffic operations and safety? • Are the locations free of construction or maintenance equipment and any other signs or traffic control devices that are no longer required? • Are adequate overtaking opportunities available for heavy vehicles where the traffic volume is high? • Are the road boundaries free of any activities that are likely to result to distract the drivers? • Is the location of rest areas and truck parking areas in service roads and openings in medians for traffic in divided sections? • Is sufficient warning provided in advance of breaks in service roads and openings in medians for traffic using multilane highway? 16 March 2021 63
  • 64.
    CHECK LIST -6 AUDIT ON EXISTING ROADS OR DURING OPERATION & MANAGEMENT (Contd…) • Are there reasonable traffic calming measures in place for the road stretches passing through habitations and built up areas? • Are speed breakers / rumble strips used for speed reduction? If so, are they designed as per specifications? Are there adequate warning signs? Are they visible at night? 16 March 2021 64
  • 65.
    CHECK LIST –7 PLANNING • Is there a development plan or development strategy for the area and, if so, does the project conform to this? • Is the proposed design appropriate in relation to the forecast traffic volumes, traffic characteristics and the adjoining land use? • Does the alignment fit in with the physical constraints imposed by the topography? • Does the route serve major generators of traffic in a safe and adequate manner? • Is the frequency of junctions and their type appropriate for the function of the road and the design speed? • Does the project road fit well with the existing road network? Check for likely future conflicts. • Does the project road relieve routes or sites with bad accident records? • Do the project road sections have any harmful effects on safety on the surrounding road network? 16 March 2021 65
  • 66.
    CHECK LIST –8 ALIGNMENT • Is the proposed design speed appropriate to the function of the road, the mix of traffic likely to use it and the road environment? (Check whether different sections of the road need different speeds?) • If the speed is lower than the design speed at any location, has proper signing been provided? • Does the alignment (horizontal and vertical) give sufficient forward visibility for the selected design speed? (Check for inadequate stopping sight distances) • Check for consistency throughout the route; check for any location where the alignment standard changes abruptly and is not as would be expected by drivers. • Does the horizontal and vertical alignment fit together comfortably? (Check for bad combinations such as sharp bend immediately after a summit curve and a sag curve within a bend) 16 March 2021 66
  • 67.
    • Does thealignment provide safe overtaking opportunities? Does it avoid creating situations where the forward visibility is marginal for overtaking? (neither clearly adequate not inadequate) • Does the treatment at the curves proposed if any, make appropriate, adequate and safe provision for transition curves, super-elevation and carriageway widening? • Does the vertical alignment pose excessive demands on the power of heavy vehicles? Is the vertical alignment been designed so that the maximum grades are interspersed with recovery grades? Are there passing places to enable faster vehicles to overtake slow moving heavy vehicles? • Is the transition between project road and the access roads handled safely? 16 March 2021 67 CHECK LIST – 8 ALIGNMENT (Contd…)
  • 68.
    CHECK LIST –9 CROSS SECTION • Are the widths of the carriageway, shoulders, medians (if any), service roads in accordance with the standards and adequate for the function of the road and the mix of traffic likely to use the highway? • Check whether the bridges have footpaths and they have proper gradient and crash barriers. • Note any location where the cross section standard changes abruptly along the route or is otherwise inconsistent with driver expectations? • Identify any locations where the capacity of the roadway is restricted and note locations of regular congestion. • Have the shoulders and side slopes been designed to a safe standard and note any locations with inadequate shoulder width. • Have the side drains been designed to a safe standard? Are the batter slopes and drains for surface run-off, safe for vehicles to traverse? 16 March 2021 68
  • 69.
    CHECK LIST –9 CROSS SECTION (Contd…) • Is the transition between the project road and existing road(s) handled safely? (Check for major changes in standards) • Check whether the cross section provided is adequate for the vulnerable road users including persons with disabilities? o Pedestrians: Have paved footpath, adequate refuge island width on median and proper ramps up and down kerbs, where there is regular pedestrian traffic been provided? o Bicyclists: All the cycle tracks/slow moving vehicles (SMVs) tracks segregated from main carriageway? • Are there speed breakers / rumble strips along the section of road? If so, are they designed as per specifications of the Indian Roads Congress? 16 March 2021 69
  • 70.
    CHECK LIST –10 JUNCTIONS A. GENERAL • Is the general layout of junction caters safely for all road users including disabled road users? (Check whether there are other junctions too close to it. Check whether approaching drivers will get a clear view of it; check with respect to pedestrians, cyclists and two- wheelers etc) • The type of junction (T-type, staggered, signal controlled, roundabout) suitable for the function of the two or more roads, the traffic volume, the traffic movements (pedestrian and vehicular) and the site constraints? Is it safe? • Is the layout of the junction adequate for all permitted vehicular movements and for all types of vehicles? • Will the general type of junction, its layout and the priority rules be recognized by the approaching drivers well in time? Is the route through junction as simple and clear as possible? (Check for unusual and complicated layouts; check for signs, markings are correct and clear) • Does the layout encourage slow controlled speeds at and on the approach to stop/give way lines and other critical path points? Check for Y and skew junctions which may create problems. Also check for round - abouts with inadequate weaving lengths. 16 March 2021 70
  • 71.
    CHECK LIST –10 JUNCTIONS (Contd…) A. GENERAL • Are the sight lines at and on the approach to stop/give way lines and other critical decision points adequate and unobstructed? Check for Y and skew junction which can be a problem. Check signs, lighting columns, pedestrian guard rails etc. • Is there adequate provision for channelizing the different streams of traffic? Check the provision of right turn lanes, deceleration lanes and acceleration lanes. • Is adequate provision made for pedestrians and non-motorised vehicles? Check for width, surface, level of the sidewalks; check for pedestrian crossing facilities viz., number, width, location etc. • Is the provision of night time lighting adequate? If not, what are the deficiencies? • Are junctions at the road stretch have adequate and proper markings, signs and studs to avoid accidents? 16 March 2021 71
  • 72.
    CHECK LIST- 10 JUNCTIONS(Contd…) B. ROUNDABOUTS • Is the geometry simple and easily understood? • Are there too many entries for safe and efficient operation? Are they sufficiently separated from each other to avoid confusion? • Does the design deflect entering traffic sufficiently to ensure entry speeds are greater than the standards? Check entry path of curvature, centre island size, position etc. • Is there visibility for circulating traffic adequate? • Has the central island been designed to be forgiving errant vehicles? • Has adequate provision been made for pedestrians to cross the arms of the junction? • Have the needs of cyclists and other non-motorised vehicles been considered? • Does the signing make the priorities clear? Entering traffic must give way to circulating traffic. 16 March 2021 72
  • 73.
    CHECK LIST -10 JUNCTIONS(Contd…) C. SIGNAL CONTROLLED JUNCTION • Does the signal sequence conform to the requirements of the regulations and standards? • Do the signals clearly indicate which movements are allowed at any one time? Are the timings of various phases of signal cycle adequate? • Are the signal heads positioned so that drivers can see them easily and in time to react viz., stop and go? • Are the signals for completing phases located in such a way that they are visible only to the traffic for which they are intended? • Are all right turning movements protected as far as possible? • Does the signages, markings and channelization make it clear to drivers the path that they should take through the junction? • Are pedestrian crossing places marked and are pedestrians channelized in these crossings? 16 March 2021 73
  • 74.
    CHECK LIST -10 JUNCTIONS(Contd…) C. SIGNAL CONTROLLED JUNCTION • Are pedestrian signals positioned such that, they are clearly visible? • Whether the pedestrian crossing signal controls are provided where appropriate? If so, there is a need for the crossing movements to be fully protected from conflicting traffic movements, for example, where there will be serious conflicts with turning traffic. 16 March 2021 74
  • 75.
    CHECK LIST –10 JUNCTIONS (Contd…) D. VEGETATION AND PLANTATION • Is the top of vegetation in the traffic island as well as channelisers, dividers less than 600 mm above the road top level for a length of 15 m from the end of the dividers? • Is the vegetation/plantation at the corners of the junction retracted for enough back from the edge of the shoulders to afford clear view of approaching traffic to the driver? • Are there no branches of trees projecting over the road berms/pavement at a height less than 7 m? 16 March 2021 75
  • 76.
    CHECK LIST -11 ROAD SIGNS • Is the provision for road signs (regulatory, warning and informatory signs and delineators) adequate and in accordance with standards? Check with respect to size, shape and placement etc.) • Check for unauthorized traffic signs and use of non- standard signs (Colour, size and shape) • Location and spacing of signs o Note locations where there are too many signs placed o Note the signs placed too close to each other • Note if all traffic signs are clearly visible and are prominently displayed for the intended road users. • Find any instances where the legibility of the information on the signs is inadequate, bearing in mind the speed of vehicles and the amount of information displayed. 16 March 2021 76
  • 77.
    CHECK LIST -11 ROAD SIGNS (Contd…) • Determine the effectiveness of traffic signs by observing them at night and identify any lack of reflectivity. • Examine type of sign posts used and record situations where sign posts constitute a fixed roadside hazard or where the use of frangible sign posts should be considered. • Are there any situations where the traffic signs themselves are obstructing essential ‘line of sight’ for drivers and pedestrians. • Regulatory and warning signs o Are appropriate regulatory signs provided where necessary? o Are warning signs provided only where they are warranted? 16 March 2021 77
  • 78.
    CHECK LIST -11 ROAD SIGNS (Contd…) • Informatory signs o Has signage been done on a systematic route or regional strategy that is logical and meets the needs of unfamiliar driver? o Are all important junctions provided with advance direction sign, distance information sign and intersection sign etc.? o Are these signs correctly positioned to enable the required timely action to be taken by the intended drivers? o Find instances of poor legibility and poor arrangement of information on signs. o Overhead signs – size, message information adequate, use two languages (English an local) • Are road signages provided at appropriate distance, well in advance taking into consideration the category of roads as per codal provisions? • Are variable message signs (VMS) in display? If so, are both the languages (English and vernacular) used? Are the signages in accordance with the standards? 16 March 2021 78
  • 79.
    CHECK LIST -12 ROADMARKINGS • General adequacy and visibility of road markings during day/night time and in wet/dry weather conditions • Has correct type of markings been used in various situations (eg., lane lines, edge marker lines etc) • Are correct colours used for laying road markings? • Is there any deficiency in the delineation of merge and diverge areas, including situations where through traffic may inadvertently lead into auxiliary and turn lanes? • Are zebra crossing marking provided at junctions and mid-blocks of the sections (depending upon movement of pedestrians) • Is positioning of stop lines adequate? 16 March 2021 79
  • 80.
    CHECK LIST -12 ROADMARKINGS (Contd…) • Are the directional arrows marked on the pavement guide the driver or creating confusion to the driver? • Are there locations where there is lack of hazard markings at approach end of island, medians and culverts/bridges etc.? • Have retro-reflective markers been installed? Where coloured markers are used, have they been installed correctly? • If chevron alignment markers are installed, have the correct types of markers been used? • Are speed breakers / rumble strips adequately painted as per the specifications? 16 March 2021 80
  • 81.
    CHECK LIST -13 LIGHTING •Is there any need of lighting on the project roads or parts of it, to be lighted at night? (particularly where there are pedestrians and parking along the road), important interchanges, bus bays, truck lay byes, toll plazas, if any) • Are the proposed lighting scheme and illumination levels of an appropriate standard consistent with the needs of the location, pedestrian and other factors? • Identify the locations where street lighting columns constitute a hazard to traffic (on the outside of sharp curves, on small islands, noses of medians) or which may conflict visually with traffic signals and signs? • Does the existing street lighting enhance as route guidance rather than confuse the drivers ability to see the direction of the route ahead? • Are the appropriate types of poles used for all locations and correctly installed (eg. slip base at correct height, rigid poles protects if within clear zone)? • Has lighting for signs, particularly overhead signs been provided where necessary? 16 March 2021 81
  • 82.
    CHECK LIST -13 LIGHTING(Contd…) • Are there any lighting or telephone poles close to the edge of the berms so as to pose hazard to traffic? • Are there any lighting poles in the median unprotected by crash barriers? 16 March 2021 82
  • 83.
    CHECK LIST –14 ROADSIDE HAZARDS • Is a clear zone provided in accordance with the guidelines? Is the appropriate treatment or projection provided for any objects within the clear zone? • Are bridge and culvert parapets and other obstructions close to moving traffic? If so, can they be relocated? If not, are they adequately provided with signs and where necessary, protected by safety barrier? • Are bridge parapets designed to contain errant vehicles, where the speed and volume of traffic warrant them? • Are the ends of bridge parapets, bridge railing and pedestrian guardrail/crash barriers of a safe design? • Are there any poles or columns along the road and comment on whether some or an of them can be removed, relocated to less hazard positions etc. • Is there a degree of hazard associated with large trees, boulders etc. and whether these can be treated to improve the roadside safety? 16 March 2021 83
  • 84.
    CHECK LIST –14 ROADSIDE HAZARDS (Contd…) • Do the trees and other vegetations obstruct driver and pedestrian sight lines, which are essential for safe traffic operation? • Are there any ‘fixed’ roadside stalls which occur within the roadway? Comment on the need to treat them in terms of road safety. • Is there an existence of roadside stalls and other roadside business activities within the right of way of the road? • Are the provided crash barriers suitable for the purpose? • Is the length of crash barrier at each installation adequate? Are the crash barrier installed correctly? • Is the provided barrier / fencing in the clear zone free of separate horizontal rails? • Is there adequate delineation / visibility of barriers and fences during night time? • Are there any thorny bushes by the roadside, whose branches are likely to hurt the passengers occupying the window seat of a vehicle, especially a non-AC bus? 16 March 2021 84
  • 85.
    CHECK LIST –14 ROADSIDE HAZARDS (Contd…) • Is any thick growth of vegetation by the roadside enough far back from the edge of the pavement to enable a driver to take protective steps in time if any human or animal should run across the road from behind or within the vegetation? • Are there any sharp edged or pointed fixtures or tops of supporting verticals on the median crash barriers or on dividers which can hurt a motor cyclist in case of a collision or crash or loss of balance.? • Are there any village name boards or direction boards by the roadside with pointed ends to hurt a passenger in a bus on window seat? • Are entrances to abandoned roads properly fenced off? 16 March 2021 85
  • 86.
    CHECK LIST –15 ROADSIDE FACILITIES • Do the cross section, alignment and signages encourage drivers to adjust their speed on entering the town or village and maintain it at an appropriate level? (Check that it will be quite clear to drivers that the road environment is changing and that they should slow down) • Is there adequate and safe provision for pedestrians and non- motorised traffic to travel along the road and to cross it? (Check for provision of footpaths, shoulders and safe crossing places and whether pedestrian movements are controlled and channelled by guard rails at busy places). • Are the design and provision of roadside parking and access to properties adequate, controlled and safe? • Has the opportunity been taken to improve the traffic and parking situation (in the town and villages through which the road passes? (Check for junction improvements, access control, provision of service lanes, parking areas and bus stops? • Are bus stop locations safe and proper and whether the provision for buses to stand clear of traffic lanes has been made? Also, is there need for lighting at these locations for the security and safety of the passengers? 16 March 2021 86
  • 87.
    CHECK LIST -15 ROADSIDEFACILITIES (Contd…) • Is there any need for overtaking opportunities along the route at regular intervals on divided roads, particularly where traffic flows are high or in hilly terrain? • Consider the need for rest areas and other roadside stopping places e.g., truck stops, scenic view points, wayside picnic areas etc. and note any current ‘unofficial’ places where vehicles stop and the degree of hazard that this involves. 16 March 2021 87
  • 88.
    CHECK LIST –16 VULNERABLE ROAD USERS • Has there been a survey of non-motorised vehicles and pedestrian flows? • Will there be any major conflicts between motorized traffic and pedestrians and other disable /handicapped road users? • Have pedestrian need for crossing the road and walking safely alongside it been adequately provided for? (Check particularly in towns and villages and at all junctions – check shoulder width – check whether it is desirable and feasible to provide a segregated footway – check whether steps are provided where pedestrians will have to climb high embankments) • Is the provision for pedestrians and non-motorised vehicles at bridges and narrow sections adequate in relation to pedestrian and vehicular traffic volumes and traffic speeds? • Have measures been taken to reduce the accident risk for children going to and from roadside schools (pedestrian guard rail may be needed to prevent children from running out onto the road) 16 March 2021 88
  • 89.
    CHECK LIST -16 VULNERABLEROAD USERS (Contd…) • Have the need for cyclists and other non-motorised vehicles been provided? Check shoulder width; check need and feasibility of segregated cycle/cycle rickshaw lanes, especially in towns) • Are bicycle protection grates provided at drainage pits where necessary? • Does the volume of motorized two wheeler traffic justify the provision of separate lanes? Check in towns. • Are bus stops/bus-bays appropriately located with adequate clearance from the traffic lane for safety and visibility? • Where necessary, is fencing installed to guide pedestrians and cyclists at crossings and overpasses? 16 March 2021 89
  • 90.
    CHECK LIST -17 DEVELOPMENTPROPOSALS • Horizontal Alignment: o Is visibility satisfactory at proposed access, including that for pedestrians? o Are curve radii and forward visibilities satisfactory? o Are verge widths satisfactory? • Vertical Alignment: o Are gradients satisfactory? o Are sight and stopping distances maintained? • Parking Provision: o Is off-site parking adequate to minimize on street parking and associated risks? o Are parking areas conveniently located, with adequate turning facilities? • Servicing Facilities: o Are off street loading/unloading areas provided? o Are there any turning facilities for large vehicles? o Is emergency vehicles access provided for? 16 March 2021 90
  • 91.
    CHECK LIST -17 DEVELOPMENT PROPOSALS (Contd…) • Landscaping: o Does landscaping affect visibility at junctions, bends or access points? o Is tree planting proposed where vehicles are most likely to run off road? • Traffic Signs and Road Markings o Have necessary traffic signs and road markings been provided as part of development? • Other Traffic Control Devices - Road Side furniture, delineators, crash barriers, guard rails, etc. • Others: o Will there be area-wide effect on other roads? o Will design keep speeds down where necessary? o Are number of access points to busy roads minimized by layout? o Are footpaths (sidewalks) necessary and provided adequately? o Are cycle tracks required? o Is street lighting required/ adequate? o Are bus bays and stops safely located? o Are dropped crossings provided at preferred pedestrian route or crossing points? o Is pedestrian guardrail provided where walkways join the highway? o Are truck lay byes required? o Are toll plazas congestion free? 16 March 2021 91
  • 92.
    CHECK LIST –18 MAINTENANCE WORKS • Is it publicized to the necessary extent about the road works, including applicable speed limits and diversions? • Are temporary traffic signals or road markings adequate and does the message reach all road users? • Has a temporary speed limit been suggested and is it proper? • Will it be possible for the unaffected road users to see (and misunderstand) temporary traffic signals? • Is the standard of proposed signs adequate? 16 March 2021 92
  • 93.
    CHECK LIST –18 MAINTENANCE WORKS (Contd…) • Will it be necessary to illuminate the critical points? • Will the construction and enclosing materials etc., behave as rigid obstacles? • Will there be safe access to the work place? • Has a safety zone been proposed and is it adequate? • Has due consideration been given to all groups of road users in the layout of staggering and diversions? 16 March 2021 93
  • 94.
    COMMON DEFICIENCIES INSIGNS • Shape is wrong  Cautionary sign on Round / Rectangular plate.  Mandatory Sign on Rectangular plate. 16 March 2021 94
  • 95.
    Roadside Accidents withInadequate Protection made through Stones on the Carriageway can be Dangerous Steep Median Drain without any Barrier Protection Leaving No Room for Recovery for Vehicles Trees Removed to Make way for Up- gradation of Existing Road, Shoulder and Road Edge, Pose Road Safety Hazards Access Created Without Proper Warning Signs and Speed Control Devices 16 March 2021 95
  • 96.
    Town area Encroachments Lot ofpedestrian activities Poor shoulder condition 96
  • 97.
    Information sign boardof non - standard 97
  • 98.
    Accident prone area Petrolbunk entry and exit not as per IRC Sharp Curve 98
  • 99.
  • 100.
    Non- standard speed breakerprovided on project road Not properly designed 100
  • 101.
    T Junction No sufficientsight distance 101
  • 102.
  • 103.
  • 104.
  • 105.
    Minor road fromright joins the project road No bus bay – buses stops at the junction 105
  • 106.
    Highway alignment alonga series of curve 106
  • 107.
    Minor road approaching projectroad is in a gradient 107
  • 108.
    Sight distance available isinadequate Turning radius provided is inadequate for safe maneuver 108
  • 109.
  • 110.
    Un protected waterbody on the right side of the project road 110
  • 111.
  • 112.
  • 113.
    Bypass starts Not properlydelineated and marked 113
  • 114.
  • 115.
    Bypass ends Too manysign boards 115
  • 116.
  • 117.
    Minor road ahead warningsign board missing 117
  • 118.
  • 119.
  • 120.
  • 121.
    Barricades (Standing police man)erected to reduce the speed 121
  • 122.
    Channelising Islands are notprovided Information sign boards are not provided 122
  • 123.
    Intersection – notsafe No warning sign board on both sides 123
  • 124.
  • 125.
    Designed not considering safetyfeatures Accident prone area 125
  • 126.
  • 127.
  • 128.
    Unwanted chevron signboard provided on median 128
  • 129.
  • 130.
