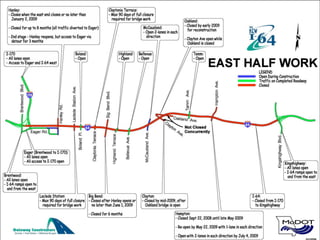

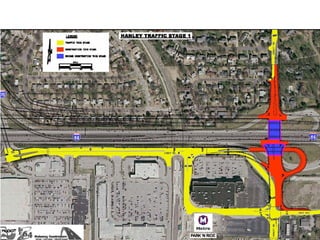

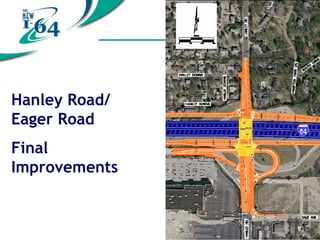

Embed presentation

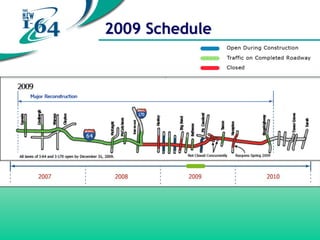

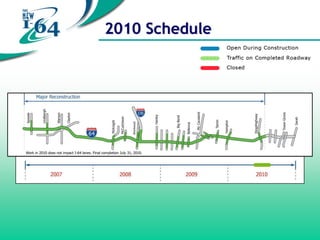

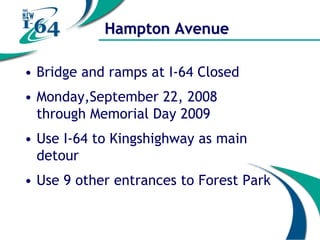

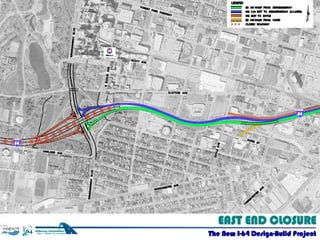

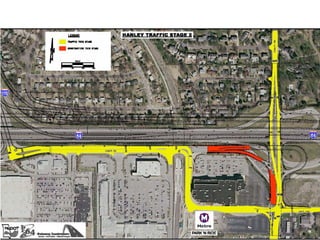

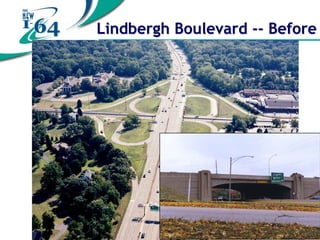

The document outlines the schedule and key details for the I-64 reconstruction project, including the closure of the bridge and ramps at I-64 from September 22, 2008, through Memorial Day 2009. It provides alternate route options and commuter strategies, such as using public transportation, carpooling, or working remotely. The project aims to monitor traffic closely during closures and includes improvements to several affected roadways.
