INTERNAL – SAP and Customers Only
Sabrina Autier, SAP
Expert Guided Implementation – Day 1
Plan Your System Conversion – SAP S/4HANA
Expert Guided Implementation powered by SAP Enterprise Support Academy*
e-mail: sabrina.autier@sap.com
2
INTERNAL – SAP and Customers Only
Disclaimer
▪ The information in this presentation is confidential and proprietary to SAP and may not be disclosed without the permission of SAP. Except
for your obligation to protect confidential information, this presentation is not subject to your license agreement or any other service or
subscription agreement with SAP. SAP has no obligation to pursue any course of business outlined in this presentation or any related
document, or to develop or release any functionality mentioned therein.
▪ This presentation, or any related document and SAP's strategy and possible future developments, products and or platforms directions and
functionality are all subject to change and may be changed by SAP at any time for any reason without notice. The information in this
presentation is not a commitment, promise or legal obligation to deliver any material, code or functionality. This presentation is provided
without a warranty of any kind, either express or implied, including but not limited to, the implied warranties of merchantability, fitness for a
particular purpose, or non-infringement. This presentation is for informational purposes and may not be incorporated into a contract. SAP
assumes no responsibility for errors or omissions in this presentation, except if such damages were caused by SAP’s intentional or gross
negligence.
▪ All forward-looking statements are subject to various risks and uncertainties that could cause actual results to differ materially from
expectations. Readers are cautioned not to place undue reliance on these forward-looking statements, which speak only as of their dates,
and they should not be relied upon in making purchasing decisions.
3
INTERNAL – SAP and Customers Only
Your organization is at the beginning of the digital
transformation and is planning to adopt SAP S/4HANA or
SAP S/4HANA Cloud, Private Edition through a conversion
scenario.
This Expert-Guided Implementation session will help you
prepare for your project. The delivery demonstrates how to
leverage key accelerators and best practices to plan an SAP
S/4HANA conversion project. It will provide references and
tools that are stored in various places.
Expert Guided Implementation
Plan Your Conversion To SAP S/4HANA
4
INTERNAL – SAP and Customers Only

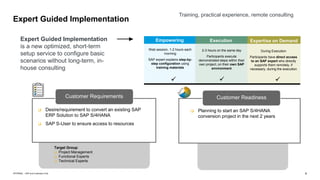

Expert Guided Implementation
Expert Guided Implementation
is a new optimized, short-term
setup service to configure basic
scenarios without long-term, in-
house consulting
Customer Readiness
❑ Desire/requirement to convert an existing SAP
ERP Solution to SAP S/4HANA
❑ SAP S-User to ensure access to resources
❑ Planning to start an SAP S/4HANA
conversion project in the next 2 years
Target Group:
❑ Project Management
❑ Functional Experts
❑ Technical Experts
Customer Requirements
Execution
Execution
Empowering Execution Expertise on
Demand
Demand
Web session, 1-2 hours each
morning
SAP expert explains step-by-
step configuration using
training materials
2-3 hours on the same day
Participants execute
demonstrated steps within their
own project, on their own SAP
environment
✓ ✓ ✓
During Execution
Participants have direct access
to an SAP expert who directly
supports them remotely, if
necessary, during the execution
Execution Expertise on Demand
Empowering
Training, practical experience, remote consulting
5
INTERNAL – SAP and Customers Only
Expert Guided Implementation Schedule
Schedule: SAP S/4HANA Plan Your System Conversion
Day 1 Day 2 Day 3 Day 4
Empowering lesson
Introduction to SAP S/4HANA
• Why is SAP S/4HANA different?
• How is it different?
SAP S/4HANA Release Strategy
SAP S/4HANA Transition Scenarios
Key activities of an SAP S/4HANA
conversion project
Planning elements of an SAP S/4HANA
conversion project
(Web session, 1-2 h. in the morning)
Empowering lesson
SAP Readiness Check overview
Simplification Item Check Overview
Functional preparation: Finance
Functional preparation: Customer and
vendors
(Web session, 1-2 h. in the morning)
Empowering lesson
Maintenance planner
Custom code activities
Introduction to SAP Fiori
Introduction to SAP S/4HANA embedded
analytics
(Web session, 1-2 h. in the morning)
Empowering lesson
SUM and DMO of SUM
Downtime minimization approaches
SAP HANA 2.0
Sizing
(Web session, 1-2 h. in the morning)
Execution by customer
Customers will understand the transition
scenarios and have a high level
understanding of the end to end system
conversion pathway
(Remote support in the afternoon)
Execution by customer
Customers will understand the different
checks that can be run on the source SAP
ECC system and can start implementing
the prerequisites
(Remote support in the afternoon)
Execution by customer
Customers will understand the
different checks that can be run on the
source SAP ECC system for custom
code, and can start discussing
internally to check that SAP Fiori and
SAP S/4HANA embedded analytics
are in the scope of the project
(Remote support in the afternoon)
Execution by customer
Customers will understand how to run the
Sizing tool, and can start to implement it on
the system
(Remote support in the afternoon)
Goal of the day
◼ Understand how the differences
between SAP ECC and SAP S/4HANA
will influence the conversion project.
Goal of the day
◼ Understand how the simplification
aspects will influence the conversion
project, and which check can be run
before or early in the project, in order to
avoid unplanned issues within the
project
Goal of the day
◼ Understand how the simplification
aspects will influence impact custom
code during the conversion project, and
why SAP Fiori and SAP S/4HANA
embedded analytics should be included
(at least an initial scope) in the project
Goal of the day
◼ Understand how to use SUM and DMO
of SUM and the toolset for system
conversion
6
INTERNAL – SAP and Customers Only
Agenda – DAY 1
▪ Learning Objectives
▪ SAP S/4HANA Introduction
o Why is SAP S/4HANA different from SAP ECC
o How is it different from SAP ECC
▪ Three transition scenarios
▪ Conversion
▪ Selective Data Transition
▪ New implementation
▪ Key activities of an SAP S/4HANA conversion project
▪ How do SAP S/4HANA differences impact the project
▪ Overview of some key activities
▪ Conversion project planning elements
▪ Key accelerators to help with project planning
▪ Planning elements
▪ Key Takeaways
▪ Additional documentation
SAP S/4HANA – Why is it different?
8
INTERNAL – SAP and Customers Only
Embedded analytics for
simulation, prediction &
insight-to-action
Machine learning for
automated processing &
decision support
On any device, use
role based cockpits
with digital assistant
Sales Order fulfillment Issues
Capacity Plan Simulation
Monitor GR/IR Account Reconciliation
Overdue Materials - Stock in Transit
Slow or Non-Moving Materials

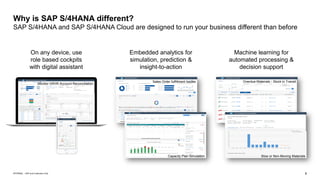

Why is SAP S/4HANA different?
SAP S/4HANA and SAP S/4HANA Cloud are designed to run your business different than before

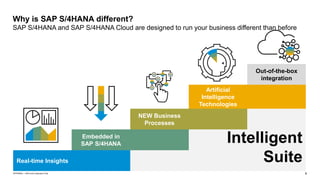

9
INTERNAL – SAP and Customers Only
Out-of-the-box
integration
Artificial
Intelligence
Technologies
NEW Business
Processes
Embedded in
SAP S/4HANA
Real-time Insights
Why is SAP S/4HANA different?
SAP S/4HANA and SAP S/4HANA Cloud are designed to run your business different than before
Intelligent
Suite
SAP S/4HANA – How is it different from
SAP ECC?
12
INTERNAL – SAP and Customers Only

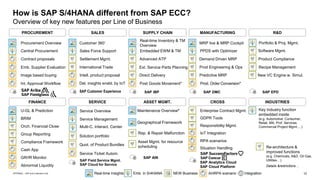

How is SAP S/4HANA different from SAP ECC?
Overview of key new features per Line of Business
Central Procurement
MRP live & MRP Cockpit
U-GL & Prediction
Product Compliance
Customer 360˚
Service Management
Enterprise Contract Mgmt.
Rep. & Repair Malfunction
AI/iRPA scenario
NEW Business
Emb. in S/4HANA
Real-time Insights Integration
Key Industry function
embedded inside
(e.g. Automotive, Consumer,
Retail, Mill, Prof. Services:
Commercial Project Mgmt.…)
SAP Cloud Platform
SAP Analytics Cloud
SAP AIN
Procurement Overview
Image based buying Intell. product proposal
International Trade
Del. insights enabl. by IoT
Direct Delivery
Embedded EWM & TM
Ext. Service Parts Planning
Predictive MRP
Prod Engineering & Ops
PPDS with Optimizer
Portfolio & Proj. Mgmt.
Recipe Management
Cash App
Orch. Financial Close
Compliance Framework
Group Reporting
Multi-C. Interact. Center
Maintenance Overview*
Asset Mgmt. for resource
scheduling
IoT Integration
GDPR Tools
Re-architecture &
improved functions
(e.g. Chemicals, A&D, Oil Gas,
Utilities…)
Details &restrictions…
Real-time Inventory & TM
Overview
Contract proposals
SAP Field Service Mgmt.
SAP Cloud for Service
Sales Force Support
Demand Driven MRP
Quot. of Product Bundles
Emb. Supplier Evaluation
Geographical Framework
GR/IR Monitor
Responsibility Mgmt.
PROCUREMENT MANUFACTURING
SUPPLY CHAIN R&D
FINANCE
SALES
SERVICE CROSS
ASSET MGMT. INDUSTRIES
Prod. Order Conversion*
SAP DMC
SAP IBP SAP EPD
SAP Customer Experience
BRIM
RPA scenarios
Service Ticket Autom.
Software Mgmt.
New VC Engine w. Simul.
Settlement Mgmt.
Post Goods Movement*
Int. Approval Workflow
Abnormal Liquidity
Situation Handling
Advanced ATP
Solution portfolio
Service Overview
13
INTERNAL – SAP and Customers Only
How is SAP S/4HANA different from SAP ECC?
Some functionalities spread on different SAP Business Suite products are available in SAP S/4HANA
SAP Business Suite and non-SAP solutions
Complex landscape with integration and
lifecycle management challenges
SAP Business Suite
Functionality
now in SAP S/4HANA
Commercial Project Management
Project & Portfolio Management
Central Purchasing (SRM)
Supplier Lifecycle Management (SRM)
Ext. Warehouse Management (SCM)
Transportation Management (SCM)
Production Planning & Detailed
Scheduling (SCM)
Sales Force Support (CRM)
Multi-Channel Interaction Center (CRM)
Production Planning Optimizer (SCM)
SAP Event Management (SCM)
New Functionality
replacing SAP Business Suite
functionality in SAP S/4HANA
Advanced ATP
SAP S/4HANA Service
International Trade
Extended Service Parts
Management
SAP Direct Delivery - Last Mile
Distribution
New Functionality
with no predecessor in Suite
Legal Content Management
Demand-Driven and Predictive MRP
Intelligent Apps
Responsibility Management
Situation Handling
SAP HANA DB
CDS Views ML Foundation
Predictive Analytics Integrator (PAI)
SAP S/4HANA 2021
(SAP Business Suite is a group of several on-premise products :SAP ECC,
SAP CRM, SAP SRM, SAP SCM, SAP EWM)
14
INTERNAL – SAP and Customers Only
How is SAP S/4HANA different from SAP ECC?
SAP S/4HANA is available in different deployment options
functional scope
business engagement
SAP Product
Release Cycles
Minimum Upgrade Frequency
UX
Deployment Types
SAP Best Practices
Configuration Options
Custom Code
Modification of SAP code
3rd
Party Add-ons
Infrastructure
Upgrades
Compatibility Scope
Licensing
SAP S/4HANA Cloud
Twice per year (e.g. 2208)
SAP Fiori
new implementation
yes
Self-Service and Expert Configuration
no
no
certified Public Cloud add-ons allowed
SAP, Alibaba, AWS,. ect. (SAP decision)
included and mandatory
n/a
SAP S/4HANA
annually, plus quarterly Feature/Support Packs (e.g. 2022)*
5 years* (to stay in mainstream maintenance)
SAP Fiori and SAP GUI
new Implementation, System Conversion, Selective Data Transition
optional (for New Implementation)
Implementation Guide (IMG)
optional
optional
allowed unless operating system access required
SAP, AWS, Azure, GCP, (customer preference)
customer owned, installation on request
mostly allowed – see note 2269324
allowed
customer preferred infrastructure
not included
allowed
SAP S/4HANA Cloud, public edition SAP S/4HANA Cloud, private edition SAP S/4HANA
subscription perpetual
* with 2023 Release and Maintenance Announcement changed to by yearly release + 4 years standard maintenance
15
INTERNAL – SAP and Customers Only

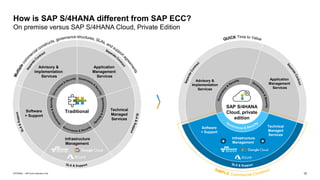

How is SAP S/4HANA different from SAP ECC?
On premise versus SAP S/4HANA Cloud, Private Edition
Traditional
Advisory &
Implementation
Services
Application
Management
Services
Software
+ Support
Technical
Managed
Services
Infrastructure
Management
SAP S/4HANA
Cloud, private
edition
+
Advisory &
Implementation
Services
Application
Management
Services
Software
+ Support
Technical
Managed
Services
Infrastructure
Management
+
16
INTERNAL – SAP and Customers Only
How is SAP S/4HANA different from SAP ECC?
SAP S/4HANA runs on ABAP Platform and not anymore on SAP NetWeaver
• The first SAP S/4HANA versions (1511, 1610, 1709) were developed on top of AS ABAP, but had some important
changes:
• SAP S/4HANA 1709 runs on top of AS ABAP 7.52 and contains the SW component SAP ABAP 7.5C
• Starting from SAP S/4HANA 1809, SAP S/4HANA is built on top of ABAP Platform, which is the evolution of the
SAP NetWeaver platform and replaces it in SAP S/4HANA. The ABAP platform:
• Contains the SAP ABAP software component (not the classic SAP ABAP 7.50, but the new SAP ABAP 7.5D,
E, F, etc. as needed for SAP S/4HANA), SAP S/4HANA 2021 is on SAP ABAP 7.5G
• Is based on a new Kernel line (7.7x or higher instead of 7.53 used for old SAP NetWeaver)
• Will not be released as a standalone product (like the old SAP NetWeaver), but only as foundation of the
corresponding SAP S/4HANA system
17
INTERNAL – SAP and Customers Only

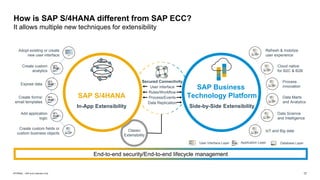

How is SAP S/4HANA different from SAP ECC?
It allows multiple new techniques for extensibility
End-to-end security/End-to-end lifecycle management
Secured Connectivity
User Interface
Rules/Workflow
Process/Events
Data Replication
SAP S/4HANA
In-App Extensibility
Adopt existing or create
new user interface
Create custom
analytics
Expose data
Create forms/
email templates
Add application
logic
Create custom fields or
custom business objects
Classic
Extensibility
SAP Business
Technology Platform
Side-by-Side Extensibility
Refresh & mobilize
user experience
Cloud native
for B2C & B2B
Process
innovation
Data Marts
and Analytics
Data Science
and Intelligence
IoT and Big data
User Interface Layer Application Layer Database Layer
18
INTERNAL – SAP and Customers Only
FPS01*
Feature Package Stack
(technically SPS01)
FPS02*
Feature Package Stack
(technically SPS02)
SPS03*
Support Package Stack
(technically SPS03)
SAP S/4HANA 2021
Support Package Stack for SAP S/4HANA 2021*
After general availability of SAP S/4HANA 2021, Feature Package Stacks (FPS)
and Support Package Stacks (SPS) contains stabilizations bundled with
corrections and legal changes. Customers benefit from this functionality as part of
their maintenance fee. First SPS of a new release can contain selected features
and are labelled Feature Package Stack (FPS) accordingly.
Support Package Stacks are compiled periodically and made available in the
SAP Support Portal
Q4 Q1 Q2 Q4
Q3
SAP S/4HANA 2022*
New release incl. new
technology stack
Maintenance Line
2023
Important Links
Restrictions and recommendations
regarding specific revisions of the SAP
HANA database for use in SAP S/4HANA
Release and maintenance strategy for
SAP S/4HANA
New release incl. new Technology Stack
(ABAP Platform 2021 and SAP HANA 2.0 SPS05
will be defined as minimal version for customers)
SAP S/4HANA 2021 - Restriction Note
2021 2022
Q4 Q1 Q2 Q3 Q4
OCT 13, 2021
2040
SAP S/4HANA release strategy
Release strategy for 2021 / 2022 and definition of deliveries
SAP S/4HANA Maintenance Commitment 2040:
SAP Business Suite 7 Maintenance Commitment 2027/2030:
Announcement on news.sap.com
19

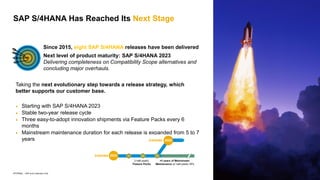

INTERNAL – SAP and Customers Only
• Starting with SAP S/4HANA 2023
• Stable two-year release cycle
• Three easy-to-adopt innovation shipments via Feature Packs every 6
months
• Mainstream maintenance duration for each release is expanded from 5 to 7
years
Taking the next evolutionary step towards a release strategy, which
better supports our customer base.
Since 2015, eight SAP S/4HANA releases have been delivered
Next level of product maturity: SAP S/4HANA 2023
Delivering completeness on Compatibility Scope alternatives and
concluding major overhauls.
SAP S/4HANA Has Reached Its Next Stage
SAP S/4HANA – Three transition scenarios
21
INTERNAL – SAP and Customers Only
Type Approach Available for Purpose
System
conversion
(Tool: Software Update Manager)
New
implementation
(Tool: SAP S/4HANA migration
cockpit)
Selective Data
Transition
(Customer-tailored
(service/consulting offering)
Reusing
by
in-place
conversion
Bringing your business processes to the new
platform
 A complete technical in-place conversion of an existing ERP
software system in SAP Business Suite to SAP S/4HANA
 Adoption of new innovations at your speed
New implementation/reimplementation
 Reengineering and process simplification based on latest innovations
 Implementing innovative business processes with preconfigured
content on a new platform
 Performing initial data load
 Retiring old landscape
Value-driven data migration to the new platform
 You need more than master data and open items, i.e. transactional
data, complete or selected,
 migrate a selection of data (i.e. by organizational units),
 migrate data from more than one system, or
 migrate application related data into a S/4HANAbased solution
landscape
Standardized
Customer
tailored
Reengineering
with
data
migration
SAP ERP
SAP ERP or
third-party
system(s)
SAP S/4HANA
SAP ERP or
third-party
system(s)
Recap of the three transition scenarios
Overview of the different approaches to move to SAP S/4HANA
SAP S/4HANA
SAP S/4HANA
SAP S/4HANA
Cloud, private
SAP S/4HANA
Cloud, private
SAP S/4HANA
Cloud, private
22
INTERNAL – SAP and Customers Only
Recap of the three transition scenarios
Scenario 1 – System Conversion
Scenario description
• A complete technical in-place conversion
of an existing SAP ERP system to
SAP S/4HANA (Database, SAP
NetWeaver and Application transition in
one step).
Why would you choose this Option?
• Bring your existing business processes to
the new platform.
• Keep your investments in custom specific
processes and developments
• Keep your complete data
• Mitigate the risk and investment of a big
bang conversion project by reducing the
scope of the transition project to a pure
technical conversion project, and adopt
new innovations at your speed at a later
point of time and in a phased approach.
(SAP GUI) / SAP Fiori
SAP HANA 2.0
SAP S/4HANA Core
SAP GUI
AnyDB / SAP HANA
SAP ERP Core
Software Update
Manager (SUM)
with Database
Migration Option
(DMO)
What How
In-place technical
conversion
tool-based technical conversion process of a SAP Business
Suite ERP system to SAP S/4 HANA using SAP Software
Update manager (SUM);
Downtime minimizing options available
*
*
SCN Blog: SAP S/4HANA System Conversion – At a glance
SAP ERP 6.0 (any EHP level)
23
INTERNAL – SAP and Customers Only
Recap of the three transition scenarios
Scenario 2 – New Implementation
Scenario description
New implementation of SAP S/4HANA, e.g. for
customers migrating a legacy system, also known
as “greenfield” approach.
Why would you choose this Option?
Customers planning to
• re-design their SAP ERP solution based
processes on SAP pre-configured best practices
• migrate a non-SAP / 3rd-part legacy system,
• migrate an SAP ERP System on releases lower
than SAP ERP 6.0 not meeting the technical
prerequisites for a system conversion
Benefits for the customer are
• Reengineering and process simplification
based on pre-configured business processes
• Rapid adoption of new innovations in a
standardized manner
Steps How
Install SAP S/4HANA Software Provisioning Manager
Initial data load from
source system
• SAP S/4HANA Migration Cockpit
• SAP Data Services (SAP DS)
both with best practice migration content
24
INTERNAL – SAP and Customers Only
A Selective Data Transition to SAP S/4HANA goes beyond a standard
new implementation or conversion. It includes a host of options, related
to the handling of software & data provisioning, requiring additional
expert services and tools to accomplish.
SAP strongly advises you to engage SAP Digital Business
Services or specialized SAP Partners equipped with the necessary
tools and experience with such an approach.
Reasons for selecting a Selective Data Transition approach:
• Large, multi-national corporation
• Multi-SAP ERP instance environment
• Business requirement to harmonize or to do just a partial redesign / leverage
partly today’s ECC installation
• Necessity to retain historic data in productive system
• Often effort intense & complex to load historical data
• Increased risk vs. other options

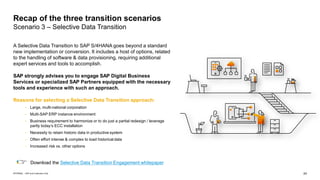

Recap of the three transition scenarios
Scenario 3 – Selective Data Transition
Download the Selective Data Transition Engagement whitepaper
25
INTERNAL – SAP and Customers Only
Transition to SAP S/4HANA
Considerations when determining your transition path
Do current business processes support your long-term strategy?
Strategic redesign of business processes suggests a new implementation.
Can you adopt SAP Best Practices or will you retain past customizations?
A move to standardization brings agility, suggesting a new implementation.
Is your move to SAP S/4HANA driven by the business or IT?
IT sponsored projects are typically conversions to SAP S/4HANA, which lay the foundation for incremental
innovation projects driven by the business.
Can you convert from SAP ERP to SAP S/4HANA in a single step?
Single-step conversion is possible for SAP ERP 6.x (any enhancement pack) single stack, Unicode systems.
According to SAP statistics, a majority of our customers fulfill this criterion.
Do you require previous transactional data in the new system?
The requirement to retain all data in the system is a very strong indication for conversion. Alternatively, consider a new implementation if re-platforming your current ECC
data on commodity hardware or leveraging data retention solutions.
Is landscape consolidation and process harmonization a key value driver?
Consider a new implementation and consolidate the required configuration and data into that new system.
High or low number of interfaces to other systems (SAP and third-party)?
The higher the number of interfaces, the stronger is the case for conversion
Can your company sustain a multi-year innovation plan with incremental innovations?
If an incremental innovation is part of the company’s philosophy, a system conversion followed by innovative projects will lead to the desired outcome. If you are
uncertain whether a multi-year innovation plan can be sustained, a new installation is the only chance to harvest the full value.
SAP S/4HANA – Conversion project
Overview on some key activities
27
INTERNAL – SAP and Customers Only
• Data model is simplified, some tables are not existing anymore
• Industries are “back to core”
• Some formerly included products are out of the core
• Some “old” features/transactions/reports have been
decommissioned or rebuilt
• Some features are now mandatory (Material ledger, Business
Partner..)
• Some formerly separated products are embedded in the core
• New architecture based on ABAP Platform
• New User Interface (SAP Fiori)
• New capabilities (Machine Learning, embedded analytics..)
• New processes
SAP S/4HANA – Conversion project – Overview on some key activities
How will the SAP S/4HANA differences impact the project?
Innovation =
Optional workload to bring
differentiating value
Simplification items =
Mandatory Workload
required to be live, which can
be, or not at same time
innovation
28
INTERNAL – SAP and Customers Only
SAP S/4HANA – Conversion project – Overview on some key activities
Example of a simplification item
Example: The change of the MM-IM data
model - Attachment of SAP Note 2206980
29
INTERNAL – SAP and Customers Only
The following activities are some key specific activities of a conversion project. For each of these activities,
there can be one or several tools, mandatory or optional.
Management of simplification item
impacts on components or applications
Downtime management
Customer/Vendor and finance data
consistency
Software and database change
Adaptation of custom code due to
simplification item impacts and move
to SAP HANA database
Management of the Business Partner
simplification Item
Reduction of custom code
Keep source and project landscape in
sync where needed
SAP S/4HANA – Conversion project – Overview on some key activities
Overview of the activities
30
INTERNAL – SAP and Customers Only
time
Start Release: SAP ERP 6.0x
Manage simplification Item impacts and configure system
Identify and resolve inconsistencies (in each environment)
Run detailed (manual) Simplification Item (SI) Check
Retire unused custom code
Adapt custom code due to simplification item and SAP HANA
Clarify add-on status
Manage Business Partner
2nd SUM SI Check Analyze Transactional data
Customizing Checks
1st SUM SI Check
SUM Uptime SUM Downtime
Post conversion activities
on SAP S/4HANA
Preparation
and Migration
of Customizing
Data
Migration
Activities After
Migration
Conversion of Accounting
Target Release: SAP S/4HANA
SAP S/4HANA – Conversion project – Overview on some key activities
How is SAP S/4HANA different and how does this impact the project?
Preparation phase on SAP ECC
31
INTERNAL – SAP and Customers Only
The SAP Roadmap Viewer gives you access to the
implementation, conversion or upgrade methodology for
multiple SAP products including SAP S/4HANA. It contains
many accelerators, organized by phases and streams,
including the pre-project phase
SAP S/4HANA Conversion project - planning elements

The SAP Roadmap Viewer Accelerator example: SAP S/4HANA sample
project plan
32
INTERNAL – SAP and Customers Only
Project Mgmt.
Solution
Adoption
Application
Design and
Configuration
Data Management
Extensibility
Integration
Analytics
Testing
Technical
Architecture and
Infrastructure
Operations &
Support
Run
Realize Deploy
Explore
Prepare
SAP S/4HANA – Conversion project – Overview of recommended activities
Discover
Sizing & Scalability Verification
IT Infrastructure Setup
Trial
System
Provisioning
Execution / Monitoring / Controlling
Organizational Change Management (OCM)
Project
Initiation
Analytics Configuration
Integration Implementation
QAS Setup/Conversion
Data Migration & Verification
CC. Quality
Closing
Go
Live
Stop
Start
Strategic
Planning
Production
Cutover
Dress
Rehearsal
Hyper
Care
Transition
Planning
Transition
Preparation
Prototype
Handover
to
Support
Organization
Operate
Solution
Cutover
Preparation
Test Preparation & Execution
Configuration
Fit-to-Standard
Analysis / Design
Activate Solution
Application
Value
and
Scoping
Product Enhancements
Gap Validation
Security Design
Improve
&
Innovate
Solution
Learning Design Learning Realization
Security Implementation
UX Activation and Design
Team Enablement
DVM Design DVM Configuration & Execution
Integration Validation
Design Review
Sizing
Technical Design
Tech. Architecture and
Infrastructure Definition
Operations Impact Evaluation Operations Implementation
Custom Code Impact
Analytics Design
Test Planning
DEV Setup/Conversion
Integration Design
Data Migration Design
Operations
Readiness
Sandbox Setup/Conversion
Quality Gates Task / Activity
QG2 QG4
QG3 QG5
QG1
SAP S/4HANA Conversion project -
planning elements
34
INTERNAL – SAP and Customers Only
SAP S/4HANA Conversion project - planning elements
The “Mapping Your Journey to SAP S/4HANA - A Practical Guide for senior IT Leadership” guide
This guide is a practical,
condensed, down-to-earth
handbook for executives,
project managers, decision-
makers, and senior IT
leaders. It summarizes our
combined experience from
over 5,000 SAP S/4HANA
migration projects we’ve
seen so far.
Download it from this link.
35
INTERNAL – SAP and Customers Only
SAP S/4HANA Conversion project - planning elements

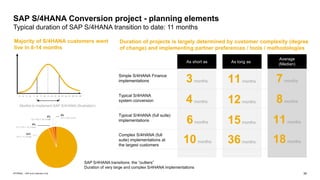

Typical duration of SAP S/4HANA transition to date: 11 months
Majority of S/4HANA customers went
live in 8-14 months
Duration of projects is largely determined by customer complexity (degree
of change) and implementing partner preferences / tools / methodologies
SAP S/4HANA transitions: the “outliers”
Duration of very large and complex S/4HANA implementations
Simple S/4HANA Finance
implementations
Typical S/4HANA
system conversion
Typical S/4HANA (full suite)
implementations
As short as As long as
Average
(Median)
3months 11months 7months
4months 12months 8months
6months 15months 11months
Complex S/4HANA (full
suite) implementations at
the largest customers
10months 36months 18months
Months to implement SAP S/4HANA (Illustration)
36
INTERNAL – SAP and Customers Only
SAP S/4HANA Conversion project - planning elements
Actual findings from customer projects & recommendations
• For SAP ERP on any DB customers a two step approach via SAP ERP on SAP HANA has in general no significant benefits.
Individual exceptions may make sense in case of for non-Unicode systems & for SAP ERP Systems releases < SAP ERP 6.0)
• System conversion projects are in average shorter and cost less than new implementation projects
→ Many customers choose system conversion for doing a ‚technical uplift‘ to SAP S/4HANA. intensive adoption of new SAP
S/4HANA applications and Fiori UI Technology is often addressed in follow-up projects.
• SAP S/4HANA Finance and SAP S/4HANA projects have pretty much the same project duration
→ In general a two steps approach by moving to SAP S/4HANA via SAP S/4HANA Finance does not make sense
• Two steps approach with Central Finance
→ For those companies in which a central financial department is a key component of the current or future business architecture,
SAP recommends starting with SAP S/4HANA for central finance and planning for the system conversions of each of the source
SAP ERP instances later on.
→ However, the perception of SAP S/4HANA for central finance as a “first stepping-stone” in a transition to SAP S/4HANA in just any
landscape is misleading. In particular, companies with a single SAP ERP instance should retain their landscape design and focus
on the standard options.
37
INTERNAL – SAP and Customers Only
Transition Project
Further Business
Process
Transformation
Technical Migration
Initial Business
Process
Transformation
SAP S/4HANA Conversion project - planning elements
Deciding when Business Process Transformation should occur
System Conversion + Selective Innovation
System Conversion with additional / full scope of Business Process Transformation (aka‘Big Bang‘)
Separate, single implementation projects
(i.e. Business Process redesign, new
Applications, Fiori UX, Analytics etc.)
Mandatory Simplifications (i.e. in FI,
SD, MM, .. area) plus some focused,
selected innovations
Go-Live
✓ In the transition project, not only Mandatory Simplification but Business Process Transformation should be included to
some extent.
✓ Further Business Process Transformations should be conducted gradually after Go-Live to enjoy new innovations.
Project
preparation
37
System Conversion
38
INTERNAL – SAP and Customers Only
SAP S/4HANA Conversion project – planning elements
Suggested pre-project activities (if not done before, start as soon as possible within)
Sandbox / Trial
Project
start
Custom code worklist
Workload assessment
Budgeting
Partner
selection
Internal
team and
Partner
available
Simplification items impacts evaluation
Landscape impacts
SAP
Readiness
Check
CVI / SIC
Maint. Planner
Add-ons
Source system pre-req.
Target system preparation
Inconsistencies fixing
SUM & Fin
Conversion
ATC installation &
config
Custom code impact workload
assessment
39
INTERNAL – SAP and Customers Only
Conversion 2
SAP S/4HANA Conversion project - planning elements
The conversion process will occur multiple times during the project
QA Conversion
Purposes
• Convert the QA
environment to SAP
S/4HANA
• Enhance cookbook
• Test Integration
• Functional regression
• Operational readiness
• User acceptance
DEV Conversion
Purposes
 Convert the DEV
environment to SAP
S/4HANA
 Refine cookbook
 Perform mandatory
code adaptations and
simple code
optimizations
 Perform post-
conversion steps to
adapt business
processes
 Configure new
processes and
features
Copy of production
Purposes
• Test conversion steps
with copy from
production
• Familiarize with
process before
working on DEV/QA
and production
• Estimate downtime
• Identify finance issues
which are not
appearing in the
consistency checks,
but detected during
finance conversion
(post SUM)
• Initiate conversion
cookbook
Test Conversion
(1 to n times)
Conversion 1
PRD Conversion
Purposes
 Convert the PRD
environment to SAP
S/4HANA
Note
 Execute end-to-end
conversion precisely
as defined within
cutover plan and
cookbook
Conversion 3
Copy of production
Purposes
 Finalize & validate
cutover plan
 Finalize & validate
cookbook
 Validate the total
downtime duration
and optimize if
needed
 Test environment:
− Infrastructure testing
− Post-cutover
operational
performance testing
Dress Rehearsal
(1 to n times)
Data consistency issues identified, for correction in production
Corrections implemented before system copy, task is reduced in next runs based on copy of production
SAP S/4HANA Conversion Project – RISE
with SAP
41
INTERNAL – SAP and Customers Only
Building YOUR Intelligent Enterprise
 Take your next step towards an intelligent enterprise:
Resilience and low TCO with infrastructure of choice
• SAP Data Center
• IaaS Provider Infrastructure
• Customer Data Center
• Scalability option based on the growth of your
business
• Technical operations excellence by SAP
◼ Single point of contact
◼ One set of SLAs
Business
process
intelligence
(BPI) &
Signavio
SAP
Business
Technology
Platform
SAP Business
Network
Starter Pack
SAP S/4HANA Cloud
(Public or Private)
Flexibility to
choose
infrastructure
provider
Premier Value
Simplified
Engagement
Guided Journey
SAP Launchpad Service & Mobile Start App,
Custom Code Migration,
SAP Readiness Check,
SAP Cloud ALM,
SAP Enable Now,
SAP Learning Hub
Driving business
innovation together
RISE with SAP
42
INTERNAL – SAP and Customers Only
SAP S/4HANA - Deployment Options
High level picture of SAP S/4HANA consumption
Customers who desire:
• A complete, modern, native SaaS ERP
solution with the full benefits of
public cloud
• The fastest path to innovation and
the lowest TCO
• A clean Cloud ERP solution without
converting old/legacy ERP processes
and configurations.
• To reimagine business processes and
take advantage of standardized best
practices
Customers who desire:
• A rapid conversion of their existing
ERP/ECC environments to a Cloud-based
architecture
• The flexibility of a traditional on-premise
application as well as subscription-based,
cloud economics
• Gradual transformation to a pure SaaS
landscape at their own pace
• Full, extensive, ERP functionality including
partner add-ons with the ability to extend
and enhance
Customers who require:
• Complete control and ownership of
their application and data landscape
• The ability to manage unique, customer-
specific needs which cannot be
addressed by public cloud or private
cloud offerings
• The utilization of their existing IT
departments, infrastructure, budget,
and IaaS vendor agreements
• Specific compliance with industry- and
country-specific regulatory requirements
SAP S/4HANA Public Cloud SAP S/4HANA Private Cloud SAP S/4HANA On-Premise
RISE with SAP
To learn more about cloud deployment, listen to the session:
The Path to SAP S/4HANA, Choosing the Right Cloud
Deployment for Your Business
43
INTERNAL – SAP and Customers Only
• SAP S/4HANA is a new product, which is very different from SAP ECC/ERP, and this will influence
your conversion project in many aspects
• Starting a given list of activities prior to the project, or at the beginning of the project, will save
significant time and can avoid some showstoppers.
• It is very important to decide if the project will include innovation in some aspects (technical and/or
functional) since this will change the workload of your project.
• Conversion will occur multiple times during the project. It is recommended with a trial conversion
based on a copy of production, or even several trials.
• The “Mapping Your Journey to SAP S/4HANA - A Practical Guide for senior IT Leadership” guide is a
key document to better understand key elements of a transition to SAP S/4HANA, while the SAP
Roadmap Viewer helps you to understand the most common tasks for each workstream
• SAP S/4HANA conversion transition path is available for both SAP S/4HANA On-Premise or SAP
S/4HANA Cloud, Private Edition.
Key takeaways
Thank you.
Contact information:
© 2023 SAP SE or an SAP affiliate company. All rights reserved. See Legal Notice on www.sap.com/legal-notice for use terms, disclaimers, disclosures, or restrictions related to SAP Materials for general audiences.
Sabrina Autier
mailto:sabrina.autier@sap.com
Additional resources
47
INTERNAL – SAP and Customers Only
SAP S/4HANA reality – Comparison of SAP ECC on HANA and SAP S/4HANA
Project durations are very similar indicating high
importance of customer specific factors for project
management, not product features.
Top reasons why you should skip SAP ECC on
SAP on HANA and go directly to SAP S/4HANA:
• SAP ECC on SAP HANA project almost
doubles your effort
• SAP S/4HANA makes operational reporting
easier than SAP ECC on SAP HANA
• SAP S/4HANA has been re-architected for
SAP HANA while SAP ECC on SAP HANA is
not
➔ SAP ECC on SAP HANA is not a head start for SAP S/4HANA
49
INTERNAL – SAP and Customers Only
SAP S/4HANA 2021 Fully Activated Appliance
The Software Appliance Concept
Software
Configuration
Walk-
throughs
Create your own pre-configured system
in a fraction of the usual setup time
SAP S/4HANA 2021 &
additional components
SAP Best Practices &
technical settings
Sample data &
demo scenarios
More information:
• Overview blog
• Demo scenarios
• Try out as S/4HANA 30-day trial
• Detailed How-To videos
*SAP S/4HANA 2021 SP00 version is planned for end of Q4 2021.
Until then the most recent appliance release (SAP S/4HANA 2020 FPS02) can be used.
In 1-2 hours via SAP Cloud Appliance Library
(SAP CAL), hosted in AWS / MS Azure / GCP
In 2-3 days when deploying on own physical
hardware
Use cases:
Trial / Sandbox / PoC / Scoping
Open to customers, partners, public users, and
SAP employees
SAP S/4HANA 2021*,
Fully-Activated Appliance

SUP_EDE_0140_1712_DAY1_Q123.pdf

  • 1.
    INTERNAL – SAPand Customers Only Sabrina Autier, SAP Expert Guided Implementation – Day 1 Plan Your System Conversion – SAP S/4HANA Expert Guided Implementation powered by SAP Enterprise Support Academy* e-mail: sabrina.autier@sap.com
  • 2.
    2 INTERNAL – SAPand Customers Only Disclaimer ▪ The information in this presentation is confidential and proprietary to SAP and may not be disclosed without the permission of SAP. Except for your obligation to protect confidential information, this presentation is not subject to your license agreement or any other service or subscription agreement with SAP. SAP has no obligation to pursue any course of business outlined in this presentation or any related document, or to develop or release any functionality mentioned therein. ▪ This presentation, or any related document and SAP's strategy and possible future developments, products and or platforms directions and functionality are all subject to change and may be changed by SAP at any time for any reason without notice. The information in this presentation is not a commitment, promise or legal obligation to deliver any material, code or functionality. This presentation is provided without a warranty of any kind, either express or implied, including but not limited to, the implied warranties of merchantability, fitness for a particular purpose, or non-infringement. This presentation is for informational purposes and may not be incorporated into a contract. SAP assumes no responsibility for errors or omissions in this presentation, except if such damages were caused by SAP’s intentional or gross negligence. ▪ All forward-looking statements are subject to various risks and uncertainties that could cause actual results to differ materially from expectations. Readers are cautioned not to place undue reliance on these forward-looking statements, which speak only as of their dates, and they should not be relied upon in making purchasing decisions.
  • 3.
    3 INTERNAL – SAPand Customers Only Your organization is at the beginning of the digital transformation and is planning to adopt SAP S/4HANA or SAP S/4HANA Cloud, Private Edition through a conversion scenario. This Expert-Guided Implementation session will help you prepare for your project. The delivery demonstrates how to leverage key accelerators and best practices to plan an SAP S/4HANA conversion project. It will provide references and tools that are stored in various places. Expert Guided Implementation Plan Your Conversion To SAP S/4HANA
  • 4.
    4 INTERNAL – SAPand Customers Only Expert Guided Implementation Expert Guided Implementation is a new optimized, short-term setup service to configure basic scenarios without long-term, in- house consulting Customer Readiness ❑ Desire/requirement to convert an existing SAP ERP Solution to SAP S/4HANA ❑ SAP S-User to ensure access to resources ❑ Planning to start an SAP S/4HANA conversion project in the next 2 years Target Group: ❑ Project Management ❑ Functional Experts ❑ Technical Experts Customer Requirements Execution Execution Empowering Execution Expertise on Demand Demand Web session, 1-2 hours each morning SAP expert explains step-by- step configuration using training materials 2-3 hours on the same day Participants execute demonstrated steps within their own project, on their own SAP environment ✓ ✓ ✓ During Execution Participants have direct access to an SAP expert who directly supports them remotely, if necessary, during the execution Execution Expertise on Demand Empowering Training, practical experience, remote consulting
  • 5.
    5 INTERNAL – SAPand Customers Only Expert Guided Implementation Schedule Schedule: SAP S/4HANA Plan Your System Conversion Day 1 Day 2 Day 3 Day 4 Empowering lesson Introduction to SAP S/4HANA • Why is SAP S/4HANA different? • How is it different? SAP S/4HANA Release Strategy SAP S/4HANA Transition Scenarios Key activities of an SAP S/4HANA conversion project Planning elements of an SAP S/4HANA conversion project (Web session, 1-2 h. in the morning) Empowering lesson SAP Readiness Check overview Simplification Item Check Overview Functional preparation: Finance Functional preparation: Customer and vendors (Web session, 1-2 h. in the morning) Empowering lesson Maintenance planner Custom code activities Introduction to SAP Fiori Introduction to SAP S/4HANA embedded analytics (Web session, 1-2 h. in the morning) Empowering lesson SUM and DMO of SUM Downtime minimization approaches SAP HANA 2.0 Sizing (Web session, 1-2 h. in the morning) Execution by customer Customers will understand the transition scenarios and have a high level understanding of the end to end system conversion pathway (Remote support in the afternoon) Execution by customer Customers will understand the different checks that can be run on the source SAP ECC system and can start implementing the prerequisites (Remote support in the afternoon) Execution by customer Customers will understand the different checks that can be run on the source SAP ECC system for custom code, and can start discussing internally to check that SAP Fiori and SAP S/4HANA embedded analytics are in the scope of the project (Remote support in the afternoon) Execution by customer Customers will understand how to run the Sizing tool, and can start to implement it on the system (Remote support in the afternoon) Goal of the day ◼ Understand how the differences between SAP ECC and SAP S/4HANA will influence the conversion project. Goal of the day ◼ Understand how the simplification aspects will influence the conversion project, and which check can be run before or early in the project, in order to avoid unplanned issues within the project Goal of the day ◼ Understand how the simplification aspects will influence impact custom code during the conversion project, and why SAP Fiori and SAP S/4HANA embedded analytics should be included (at least an initial scope) in the project Goal of the day ◼ Understand how to use SUM and DMO of SUM and the toolset for system conversion
  • 6.
    6 INTERNAL – SAPand Customers Only Agenda – DAY 1 ▪ Learning Objectives ▪ SAP S/4HANA Introduction o Why is SAP S/4HANA different from SAP ECC o How is it different from SAP ECC ▪ Three transition scenarios ▪ Conversion ▪ Selective Data Transition ▪ New implementation ▪ Key activities of an SAP S/4HANA conversion project ▪ How do SAP S/4HANA differences impact the project ▪ Overview of some key activities ▪ Conversion project planning elements ▪ Key accelerators to help with project planning ▪ Planning elements ▪ Key Takeaways ▪ Additional documentation
  • 7.
    SAP S/4HANA –Why is it different?
  • 8.
    8 INTERNAL – SAPand Customers Only Embedded analytics for simulation, prediction & insight-to-action Machine learning for automated processing & decision support On any device, use role based cockpits with digital assistant Sales Order fulfillment Issues Capacity Plan Simulation Monitor GR/IR Account Reconciliation Overdue Materials - Stock in Transit Slow or Non-Moving Materials Why is SAP S/4HANA different? SAP S/4HANA and SAP S/4HANA Cloud are designed to run your business different than before
  • 9.
    9 INTERNAL – SAPand Customers Only Out-of-the-box integration Artificial Intelligence Technologies NEW Business Processes Embedded in SAP S/4HANA Real-time Insights Why is SAP S/4HANA different? SAP S/4HANA and SAP S/4HANA Cloud are designed to run your business different than before Intelligent Suite
  • 10.
    SAP S/4HANA –How is it different from SAP ECC?
  • 11.
    12 INTERNAL – SAPand Customers Only How is SAP S/4HANA different from SAP ECC? Overview of key new features per Line of Business Central Procurement MRP live & MRP Cockpit U-GL & Prediction Product Compliance Customer 360˚ Service Management Enterprise Contract Mgmt. Rep. & Repair Malfunction AI/iRPA scenario NEW Business Emb. in S/4HANA Real-time Insights Integration Key Industry function embedded inside (e.g. Automotive, Consumer, Retail, Mill, Prof. Services: Commercial Project Mgmt.…) SAP Cloud Platform SAP Analytics Cloud SAP AIN Procurement Overview Image based buying Intell. product proposal International Trade Del. insights enabl. by IoT Direct Delivery Embedded EWM & TM Ext. Service Parts Planning Predictive MRP Prod Engineering & Ops PPDS with Optimizer Portfolio & Proj. Mgmt. Recipe Management Cash App Orch. Financial Close Compliance Framework Group Reporting Multi-C. Interact. Center Maintenance Overview* Asset Mgmt. for resource scheduling IoT Integration GDPR Tools Re-architecture & improved functions (e.g. Chemicals, A&D, Oil Gas, Utilities…) Details &restrictions… Real-time Inventory & TM Overview Contract proposals SAP Field Service Mgmt. SAP Cloud for Service Sales Force Support Demand Driven MRP Quot. of Product Bundles Emb. Supplier Evaluation Geographical Framework GR/IR Monitor Responsibility Mgmt. PROCUREMENT MANUFACTURING SUPPLY CHAIN R&D FINANCE SALES SERVICE CROSS ASSET MGMT. INDUSTRIES Prod. Order Conversion* SAP DMC SAP IBP SAP EPD SAP Customer Experience BRIM RPA scenarios Service Ticket Autom. Software Mgmt. New VC Engine w. Simul. Settlement Mgmt. Post Goods Movement* Int. Approval Workflow Abnormal Liquidity Situation Handling Advanced ATP Solution portfolio Service Overview
  • 12.
    13 INTERNAL – SAPand Customers Only How is SAP S/4HANA different from SAP ECC? Some functionalities spread on different SAP Business Suite products are available in SAP S/4HANA SAP Business Suite and non-SAP solutions Complex landscape with integration and lifecycle management challenges SAP Business Suite Functionality now in SAP S/4HANA Commercial Project Management Project & Portfolio Management Central Purchasing (SRM) Supplier Lifecycle Management (SRM) Ext. Warehouse Management (SCM) Transportation Management (SCM) Production Planning & Detailed Scheduling (SCM) Sales Force Support (CRM) Multi-Channel Interaction Center (CRM) Production Planning Optimizer (SCM) SAP Event Management (SCM) New Functionality replacing SAP Business Suite functionality in SAP S/4HANA Advanced ATP SAP S/4HANA Service International Trade Extended Service Parts Management SAP Direct Delivery - Last Mile Distribution New Functionality with no predecessor in Suite Legal Content Management Demand-Driven and Predictive MRP Intelligent Apps Responsibility Management Situation Handling SAP HANA DB CDS Views ML Foundation Predictive Analytics Integrator (PAI) SAP S/4HANA 2021 (SAP Business Suite is a group of several on-premise products :SAP ECC, SAP CRM, SAP SRM, SAP SCM, SAP EWM)
  • 13.
    14 INTERNAL – SAPand Customers Only How is SAP S/4HANA different from SAP ECC? SAP S/4HANA is available in different deployment options functional scope business engagement SAP Product Release Cycles Minimum Upgrade Frequency UX Deployment Types SAP Best Practices Configuration Options Custom Code Modification of SAP code 3rd Party Add-ons Infrastructure Upgrades Compatibility Scope Licensing SAP S/4HANA Cloud Twice per year (e.g. 2208) SAP Fiori new implementation yes Self-Service and Expert Configuration no no certified Public Cloud add-ons allowed SAP, Alibaba, AWS,. ect. (SAP decision) included and mandatory n/a SAP S/4HANA annually, plus quarterly Feature/Support Packs (e.g. 2022)* 5 years* (to stay in mainstream maintenance) SAP Fiori and SAP GUI new Implementation, System Conversion, Selective Data Transition optional (for New Implementation) Implementation Guide (IMG) optional optional allowed unless operating system access required SAP, AWS, Azure, GCP, (customer preference) customer owned, installation on request mostly allowed – see note 2269324 allowed customer preferred infrastructure not included allowed SAP S/4HANA Cloud, public edition SAP S/4HANA Cloud, private edition SAP S/4HANA subscription perpetual * with 2023 Release and Maintenance Announcement changed to by yearly release + 4 years standard maintenance
  • 14.
    15 INTERNAL – SAPand Customers Only How is SAP S/4HANA different from SAP ECC? On premise versus SAP S/4HANA Cloud, Private Edition Traditional Advisory & Implementation Services Application Management Services Software + Support Technical Managed Services Infrastructure Management SAP S/4HANA Cloud, private edition + Advisory & Implementation Services Application Management Services Software + Support Technical Managed Services Infrastructure Management +
  • 15.
    16 INTERNAL – SAPand Customers Only How is SAP S/4HANA different from SAP ECC? SAP S/4HANA runs on ABAP Platform and not anymore on SAP NetWeaver • The first SAP S/4HANA versions (1511, 1610, 1709) were developed on top of AS ABAP, but had some important changes: • SAP S/4HANA 1709 runs on top of AS ABAP 7.52 and contains the SW component SAP ABAP 7.5C • Starting from SAP S/4HANA 1809, SAP S/4HANA is built on top of ABAP Platform, which is the evolution of the SAP NetWeaver platform and replaces it in SAP S/4HANA. The ABAP platform: • Contains the SAP ABAP software component (not the classic SAP ABAP 7.50, but the new SAP ABAP 7.5D, E, F, etc. as needed for SAP S/4HANA), SAP S/4HANA 2021 is on SAP ABAP 7.5G • Is based on a new Kernel line (7.7x or higher instead of 7.53 used for old SAP NetWeaver) • Will not be released as a standalone product (like the old SAP NetWeaver), but only as foundation of the corresponding SAP S/4HANA system
  • 16.
    17 INTERNAL – SAPand Customers Only How is SAP S/4HANA different from SAP ECC? It allows multiple new techniques for extensibility End-to-end security/End-to-end lifecycle management Secured Connectivity User Interface Rules/Workflow Process/Events Data Replication SAP S/4HANA In-App Extensibility Adopt existing or create new user interface Create custom analytics Expose data Create forms/ email templates Add application logic Create custom fields or custom business objects Classic Extensibility SAP Business Technology Platform Side-by-Side Extensibility Refresh & mobilize user experience Cloud native for B2C & B2B Process innovation Data Marts and Analytics Data Science and Intelligence IoT and Big data User Interface Layer Application Layer Database Layer
  • 17.
    18 INTERNAL – SAPand Customers Only FPS01* Feature Package Stack (technically SPS01) FPS02* Feature Package Stack (technically SPS02) SPS03* Support Package Stack (technically SPS03) SAP S/4HANA 2021 Support Package Stack for SAP S/4HANA 2021* After general availability of SAP S/4HANA 2021, Feature Package Stacks (FPS) and Support Package Stacks (SPS) contains stabilizations bundled with corrections and legal changes. Customers benefit from this functionality as part of their maintenance fee. First SPS of a new release can contain selected features and are labelled Feature Package Stack (FPS) accordingly. Support Package Stacks are compiled periodically and made available in the SAP Support Portal Q4 Q1 Q2 Q4 Q3 SAP S/4HANA 2022* New release incl. new technology stack Maintenance Line 2023 Important Links Restrictions and recommendations regarding specific revisions of the SAP HANA database for use in SAP S/4HANA Release and maintenance strategy for SAP S/4HANA New release incl. new Technology Stack (ABAP Platform 2021 and SAP HANA 2.0 SPS05 will be defined as minimal version for customers) SAP S/4HANA 2021 - Restriction Note 2021 2022 Q4 Q1 Q2 Q3 Q4 OCT 13, 2021 2040 SAP S/4HANA release strategy Release strategy for 2021 / 2022 and definition of deliveries SAP S/4HANA Maintenance Commitment 2040: SAP Business Suite 7 Maintenance Commitment 2027/2030: Announcement on news.sap.com
  • 18.
    19 INTERNAL – SAPand Customers Only • Starting with SAP S/4HANA 2023 • Stable two-year release cycle • Three easy-to-adopt innovation shipments via Feature Packs every 6 months • Mainstream maintenance duration for each release is expanded from 5 to 7 years Taking the next evolutionary step towards a release strategy, which better supports our customer base. Since 2015, eight SAP S/4HANA releases have been delivered Next level of product maturity: SAP S/4HANA 2023 Delivering completeness on Compatibility Scope alternatives and concluding major overhauls. SAP S/4HANA Has Reached Its Next Stage
  • 19.
    SAP S/4HANA –Three transition scenarios
  • 20.
    21 INTERNAL – SAPand Customers Only Type Approach Available for Purpose System conversion (Tool: Software Update Manager) New implementation (Tool: SAP S/4HANA migration cockpit) Selective Data Transition (Customer-tailored (service/consulting offering) Reusing by in-place conversion Bringing your business processes to the new platform  A complete technical in-place conversion of an existing ERP software system in SAP Business Suite to SAP S/4HANA  Adoption of new innovations at your speed New implementation/reimplementation  Reengineering and process simplification based on latest innovations  Implementing innovative business processes with preconfigured content on a new platform  Performing initial data load  Retiring old landscape Value-driven data migration to the new platform  You need more than master data and open items, i.e. transactional data, complete or selected,  migrate a selection of data (i.e. by organizational units),  migrate data from more than one system, or  migrate application related data into a S/4HANAbased solution landscape Standardized Customer tailored Reengineering with data migration SAP ERP SAP ERP or third-party system(s) SAP S/4HANA SAP ERP or third-party system(s) Recap of the three transition scenarios Overview of the different approaches to move to SAP S/4HANA SAP S/4HANA SAP S/4HANA SAP S/4HANA Cloud, private SAP S/4HANA Cloud, private SAP S/4HANA Cloud, private
  • 21.
    22 INTERNAL – SAPand Customers Only Recap of the three transition scenarios Scenario 1 – System Conversion Scenario description • A complete technical in-place conversion of an existing SAP ERP system to SAP S/4HANA (Database, SAP NetWeaver and Application transition in one step). Why would you choose this Option? • Bring your existing business processes to the new platform. • Keep your investments in custom specific processes and developments • Keep your complete data • Mitigate the risk and investment of a big bang conversion project by reducing the scope of the transition project to a pure technical conversion project, and adopt new innovations at your speed at a later point of time and in a phased approach. (SAP GUI) / SAP Fiori SAP HANA 2.0 SAP S/4HANA Core SAP GUI AnyDB / SAP HANA SAP ERP Core Software Update Manager (SUM) with Database Migration Option (DMO) What How In-place technical conversion tool-based technical conversion process of a SAP Business Suite ERP system to SAP S/4 HANA using SAP Software Update manager (SUM); Downtime minimizing options available * * SCN Blog: SAP S/4HANA System Conversion – At a glance SAP ERP 6.0 (any EHP level)
  • 22.
    23 INTERNAL – SAPand Customers Only Recap of the three transition scenarios Scenario 2 – New Implementation Scenario description New implementation of SAP S/4HANA, e.g. for customers migrating a legacy system, also known as “greenfield” approach. Why would you choose this Option? Customers planning to • re-design their SAP ERP solution based processes on SAP pre-configured best practices • migrate a non-SAP / 3rd-part legacy system, • migrate an SAP ERP System on releases lower than SAP ERP 6.0 not meeting the technical prerequisites for a system conversion Benefits for the customer are • Reengineering and process simplification based on pre-configured business processes • Rapid adoption of new innovations in a standardized manner Steps How Install SAP S/4HANA Software Provisioning Manager Initial data load from source system • SAP S/4HANA Migration Cockpit • SAP Data Services (SAP DS) both with best practice migration content
  • 23.
    24 INTERNAL – SAPand Customers Only A Selective Data Transition to SAP S/4HANA goes beyond a standard new implementation or conversion. It includes a host of options, related to the handling of software & data provisioning, requiring additional expert services and tools to accomplish. SAP strongly advises you to engage SAP Digital Business Services or specialized SAP Partners equipped with the necessary tools and experience with such an approach. Reasons for selecting a Selective Data Transition approach: • Large, multi-national corporation • Multi-SAP ERP instance environment • Business requirement to harmonize or to do just a partial redesign / leverage partly today’s ECC installation • Necessity to retain historic data in productive system • Often effort intense & complex to load historical data • Increased risk vs. other options Recap of the three transition scenarios Scenario 3 – Selective Data Transition Download the Selective Data Transition Engagement whitepaper
  • 24.
    25 INTERNAL – SAPand Customers Only Transition to SAP S/4HANA Considerations when determining your transition path Do current business processes support your long-term strategy? Strategic redesign of business processes suggests a new implementation. Can you adopt SAP Best Practices or will you retain past customizations? A move to standardization brings agility, suggesting a new implementation. Is your move to SAP S/4HANA driven by the business or IT? IT sponsored projects are typically conversions to SAP S/4HANA, which lay the foundation for incremental innovation projects driven by the business. Can you convert from SAP ERP to SAP S/4HANA in a single step? Single-step conversion is possible for SAP ERP 6.x (any enhancement pack) single stack, Unicode systems. According to SAP statistics, a majority of our customers fulfill this criterion. Do you require previous transactional data in the new system? The requirement to retain all data in the system is a very strong indication for conversion. Alternatively, consider a new implementation if re-platforming your current ECC data on commodity hardware or leveraging data retention solutions. Is landscape consolidation and process harmonization a key value driver? Consider a new implementation and consolidate the required configuration and data into that new system. High or low number of interfaces to other systems (SAP and third-party)? The higher the number of interfaces, the stronger is the case for conversion Can your company sustain a multi-year innovation plan with incremental innovations? If an incremental innovation is part of the company’s philosophy, a system conversion followed by innovative projects will lead to the desired outcome. If you are uncertain whether a multi-year innovation plan can be sustained, a new installation is the only chance to harvest the full value.
  • 25.
    SAP S/4HANA –Conversion project Overview on some key activities
  • 26.
    27 INTERNAL – SAPand Customers Only • Data model is simplified, some tables are not existing anymore • Industries are “back to core” • Some formerly included products are out of the core • Some “old” features/transactions/reports have been decommissioned or rebuilt • Some features are now mandatory (Material ledger, Business Partner..) • Some formerly separated products are embedded in the core • New architecture based on ABAP Platform • New User Interface (SAP Fiori) • New capabilities (Machine Learning, embedded analytics..) • New processes SAP S/4HANA – Conversion project – Overview on some key activities How will the SAP S/4HANA differences impact the project? Innovation = Optional workload to bring differentiating value Simplification items = Mandatory Workload required to be live, which can be, or not at same time innovation
  • 27.
    28 INTERNAL – SAPand Customers Only SAP S/4HANA – Conversion project – Overview on some key activities Example of a simplification item Example: The change of the MM-IM data model - Attachment of SAP Note 2206980
  • 28.
    29 INTERNAL – SAPand Customers Only The following activities are some key specific activities of a conversion project. For each of these activities, there can be one or several tools, mandatory or optional. Management of simplification item impacts on components or applications Downtime management Customer/Vendor and finance data consistency Software and database change Adaptation of custom code due to simplification item impacts and move to SAP HANA database Management of the Business Partner simplification Item Reduction of custom code Keep source and project landscape in sync where needed SAP S/4HANA – Conversion project – Overview on some key activities Overview of the activities
  • 29.
    30 INTERNAL – SAPand Customers Only time Start Release: SAP ERP 6.0x Manage simplification Item impacts and configure system Identify and resolve inconsistencies (in each environment) Run detailed (manual) Simplification Item (SI) Check Retire unused custom code Adapt custom code due to simplification item and SAP HANA Clarify add-on status Manage Business Partner 2nd SUM SI Check Analyze Transactional data Customizing Checks 1st SUM SI Check SUM Uptime SUM Downtime Post conversion activities on SAP S/4HANA Preparation and Migration of Customizing Data Migration Activities After Migration Conversion of Accounting Target Release: SAP S/4HANA SAP S/4HANA – Conversion project – Overview on some key activities How is SAP S/4HANA different and how does this impact the project? Preparation phase on SAP ECC
  • 30.
    31 INTERNAL – SAPand Customers Only The SAP Roadmap Viewer gives you access to the implementation, conversion or upgrade methodology for multiple SAP products including SAP S/4HANA. It contains many accelerators, organized by phases and streams, including the pre-project phase SAP S/4HANA Conversion project - planning elements The SAP Roadmap Viewer Accelerator example: SAP S/4HANA sample project plan
  • 31.
    32 INTERNAL – SAPand Customers Only Project Mgmt. Solution Adoption Application Design and Configuration Data Management Extensibility Integration Analytics Testing Technical Architecture and Infrastructure Operations & Support Run Realize Deploy Explore Prepare SAP S/4HANA – Conversion project – Overview of recommended activities Discover Sizing & Scalability Verification IT Infrastructure Setup Trial System Provisioning Execution / Monitoring / Controlling Organizational Change Management (OCM) Project Initiation Analytics Configuration Integration Implementation QAS Setup/Conversion Data Migration & Verification CC. Quality Closing Go Live Stop Start Strategic Planning Production Cutover Dress Rehearsal Hyper Care Transition Planning Transition Preparation Prototype Handover to Support Organization Operate Solution Cutover Preparation Test Preparation & Execution Configuration Fit-to-Standard Analysis / Design Activate Solution Application Value and Scoping Product Enhancements Gap Validation Security Design Improve & Innovate Solution Learning Design Learning Realization Security Implementation UX Activation and Design Team Enablement DVM Design DVM Configuration & Execution Integration Validation Design Review Sizing Technical Design Tech. Architecture and Infrastructure Definition Operations Impact Evaluation Operations Implementation Custom Code Impact Analytics Design Test Planning DEV Setup/Conversion Integration Design Data Migration Design Operations Readiness Sandbox Setup/Conversion Quality Gates Task / Activity QG2 QG4 QG3 QG5 QG1
  • 32.
    SAP S/4HANA Conversionproject - planning elements
  • 33.
    34 INTERNAL – SAPand Customers Only SAP S/4HANA Conversion project - planning elements The “Mapping Your Journey to SAP S/4HANA - A Practical Guide for senior IT Leadership” guide This guide is a practical, condensed, down-to-earth handbook for executives, project managers, decision- makers, and senior IT leaders. It summarizes our combined experience from over 5,000 SAP S/4HANA migration projects we’ve seen so far. Download it from this link.
  • 34.
    35 INTERNAL – SAPand Customers Only SAP S/4HANA Conversion project - planning elements Typical duration of SAP S/4HANA transition to date: 11 months Majority of S/4HANA customers went live in 8-14 months Duration of projects is largely determined by customer complexity (degree of change) and implementing partner preferences / tools / methodologies SAP S/4HANA transitions: the “outliers” Duration of very large and complex S/4HANA implementations Simple S/4HANA Finance implementations Typical S/4HANA system conversion Typical S/4HANA (full suite) implementations As short as As long as Average (Median) 3months 11months 7months 4months 12months 8months 6months 15months 11months Complex S/4HANA (full suite) implementations at the largest customers 10months 36months 18months Months to implement SAP S/4HANA (Illustration)
  • 35.
    36 INTERNAL – SAPand Customers Only SAP S/4HANA Conversion project - planning elements Actual findings from customer projects & recommendations • For SAP ERP on any DB customers a two step approach via SAP ERP on SAP HANA has in general no significant benefits. Individual exceptions may make sense in case of for non-Unicode systems & for SAP ERP Systems releases < SAP ERP 6.0) • System conversion projects are in average shorter and cost less than new implementation projects → Many customers choose system conversion for doing a ‚technical uplift‘ to SAP S/4HANA. intensive adoption of new SAP S/4HANA applications and Fiori UI Technology is often addressed in follow-up projects. • SAP S/4HANA Finance and SAP S/4HANA projects have pretty much the same project duration → In general a two steps approach by moving to SAP S/4HANA via SAP S/4HANA Finance does not make sense • Two steps approach with Central Finance → For those companies in which a central financial department is a key component of the current or future business architecture, SAP recommends starting with SAP S/4HANA for central finance and planning for the system conversions of each of the source SAP ERP instances later on. → However, the perception of SAP S/4HANA for central finance as a “first stepping-stone” in a transition to SAP S/4HANA in just any landscape is misleading. In particular, companies with a single SAP ERP instance should retain their landscape design and focus on the standard options.
  • 36.
    37 INTERNAL – SAPand Customers Only Transition Project Further Business Process Transformation Technical Migration Initial Business Process Transformation SAP S/4HANA Conversion project - planning elements Deciding when Business Process Transformation should occur System Conversion + Selective Innovation System Conversion with additional / full scope of Business Process Transformation (aka‘Big Bang‘) Separate, single implementation projects (i.e. Business Process redesign, new Applications, Fiori UX, Analytics etc.) Mandatory Simplifications (i.e. in FI, SD, MM, .. area) plus some focused, selected innovations Go-Live ✓ In the transition project, not only Mandatory Simplification but Business Process Transformation should be included to some extent. ✓ Further Business Process Transformations should be conducted gradually after Go-Live to enjoy new innovations. Project preparation 37 System Conversion
  • 37.
    38 INTERNAL – SAPand Customers Only SAP S/4HANA Conversion project – planning elements Suggested pre-project activities (if not done before, start as soon as possible within) Sandbox / Trial Project start Custom code worklist Workload assessment Budgeting Partner selection Internal team and Partner available Simplification items impacts evaluation Landscape impacts SAP Readiness Check CVI / SIC Maint. Planner Add-ons Source system pre-req. Target system preparation Inconsistencies fixing SUM & Fin Conversion ATC installation & config Custom code impact workload assessment
  • 38.
    39 INTERNAL – SAPand Customers Only Conversion 2 SAP S/4HANA Conversion project - planning elements The conversion process will occur multiple times during the project QA Conversion Purposes • Convert the QA environment to SAP S/4HANA • Enhance cookbook • Test Integration • Functional regression • Operational readiness • User acceptance DEV Conversion Purposes  Convert the DEV environment to SAP S/4HANA  Refine cookbook  Perform mandatory code adaptations and simple code optimizations  Perform post- conversion steps to adapt business processes  Configure new processes and features Copy of production Purposes • Test conversion steps with copy from production • Familiarize with process before working on DEV/QA and production • Estimate downtime • Identify finance issues which are not appearing in the consistency checks, but detected during finance conversion (post SUM) • Initiate conversion cookbook Test Conversion (1 to n times) Conversion 1 PRD Conversion Purposes  Convert the PRD environment to SAP S/4HANA Note  Execute end-to-end conversion precisely as defined within cutover plan and cookbook Conversion 3 Copy of production Purposes  Finalize & validate cutover plan  Finalize & validate cookbook  Validate the total downtime duration and optimize if needed  Test environment: − Infrastructure testing − Post-cutover operational performance testing Dress Rehearsal (1 to n times) Data consistency issues identified, for correction in production Corrections implemented before system copy, task is reduced in next runs based on copy of production
  • 39.
    SAP S/4HANA ConversionProject – RISE with SAP
  • 40.
    41 INTERNAL – SAPand Customers Only Building YOUR Intelligent Enterprise  Take your next step towards an intelligent enterprise: Resilience and low TCO with infrastructure of choice • SAP Data Center • IaaS Provider Infrastructure • Customer Data Center • Scalability option based on the growth of your business • Technical operations excellence by SAP ◼ Single point of contact ◼ One set of SLAs Business process intelligence (BPI) & Signavio SAP Business Technology Platform SAP Business Network Starter Pack SAP S/4HANA Cloud (Public or Private) Flexibility to choose infrastructure provider Premier Value Simplified Engagement Guided Journey SAP Launchpad Service & Mobile Start App, Custom Code Migration, SAP Readiness Check, SAP Cloud ALM, SAP Enable Now, SAP Learning Hub Driving business innovation together RISE with SAP
  • 41.
    42 INTERNAL – SAPand Customers Only SAP S/4HANA - Deployment Options High level picture of SAP S/4HANA consumption Customers who desire: • A complete, modern, native SaaS ERP solution with the full benefits of public cloud • The fastest path to innovation and the lowest TCO • A clean Cloud ERP solution without converting old/legacy ERP processes and configurations. • To reimagine business processes and take advantage of standardized best practices Customers who desire: • A rapid conversion of their existing ERP/ECC environments to a Cloud-based architecture • The flexibility of a traditional on-premise application as well as subscription-based, cloud economics • Gradual transformation to a pure SaaS landscape at their own pace • Full, extensive, ERP functionality including partner add-ons with the ability to extend and enhance Customers who require: • Complete control and ownership of their application and data landscape • The ability to manage unique, customer- specific needs which cannot be addressed by public cloud or private cloud offerings • The utilization of their existing IT departments, infrastructure, budget, and IaaS vendor agreements • Specific compliance with industry- and country-specific regulatory requirements SAP S/4HANA Public Cloud SAP S/4HANA Private Cloud SAP S/4HANA On-Premise RISE with SAP To learn more about cloud deployment, listen to the session: The Path to SAP S/4HANA, Choosing the Right Cloud Deployment for Your Business
  • 42.
    43 INTERNAL – SAPand Customers Only • SAP S/4HANA is a new product, which is very different from SAP ECC/ERP, and this will influence your conversion project in many aspects • Starting a given list of activities prior to the project, or at the beginning of the project, will save significant time and can avoid some showstoppers. • It is very important to decide if the project will include innovation in some aspects (technical and/or functional) since this will change the workload of your project. • Conversion will occur multiple times during the project. It is recommended with a trial conversion based on a copy of production, or even several trials. • The “Mapping Your Journey to SAP S/4HANA - A Practical Guide for senior IT Leadership” guide is a key document to better understand key elements of a transition to SAP S/4HANA, while the SAP Roadmap Viewer helps you to understand the most common tasks for each workstream • SAP S/4HANA conversion transition path is available for both SAP S/4HANA On-Premise or SAP S/4HANA Cloud, Private Edition. Key takeaways
  • 43.
    Thank you. Contact information: ©2023 SAP SE or an SAP affiliate company. All rights reserved. See Legal Notice on www.sap.com/legal-notice for use terms, disclaimers, disclosures, or restrictions related to SAP Materials for general audiences. Sabrina Autier mailto:sabrina.autier@sap.com
  • 44.
  • 45.
    47 INTERNAL – SAPand Customers Only SAP S/4HANA reality – Comparison of SAP ECC on HANA and SAP S/4HANA Project durations are very similar indicating high importance of customer specific factors for project management, not product features. Top reasons why you should skip SAP ECC on SAP on HANA and go directly to SAP S/4HANA: • SAP ECC on SAP HANA project almost doubles your effort • SAP S/4HANA makes operational reporting easier than SAP ECC on SAP HANA • SAP S/4HANA has been re-architected for SAP HANA while SAP ECC on SAP HANA is not ➔ SAP ECC on SAP HANA is not a head start for SAP S/4HANA
  • 46.
    49 INTERNAL – SAPand Customers Only SAP S/4HANA 2021 Fully Activated Appliance The Software Appliance Concept Software Configuration Walk- throughs Create your own pre-configured system in a fraction of the usual setup time SAP S/4HANA 2021 & additional components SAP Best Practices & technical settings Sample data & demo scenarios More information: • Overview blog • Demo scenarios • Try out as S/4HANA 30-day trial • Detailed How-To videos *SAP S/4HANA 2021 SP00 version is planned for end of Q4 2021. Until then the most recent appliance release (SAP S/4HANA 2020 FPS02) can be used. In 1-2 hours via SAP Cloud Appliance Library (SAP CAL), hosted in AWS / MS Azure / GCP In 2-3 days when deploying on own physical hardware Use cases: Trial / Sandbox / PoC / Scoping Open to customers, partners, public users, and SAP employees SAP S/4HANA 2021*, Fully-Activated Appliance
