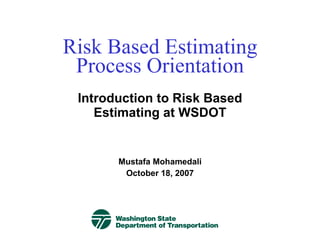

Risk Based Estimating
 Process Orientation
 Introduction to Risk Based
    Estimating at WSDOT

       Mustafa Mohamedali
        October 18, 2007

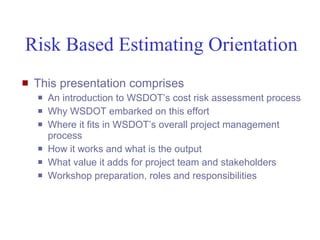

Risk Based Estimating Orientation
   This presentation comprises
         An introduction to WSDOT’s cost risk assessment process
         Why WSDOT embarked on this effort
         Where it fits in WSDOT’s overall project management
          process
         How it works and what is the output
         What value it adds for project team and stakeholders
         Workshop preparation, roles and responsibilities

Mustafa Mohamedali - WSDOT/SAEO                                2/38

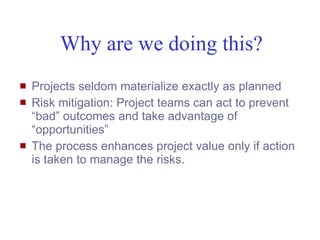

Why are we doing this?
   Projects seldom materialize exactly as planned
   Risk mitigation: Project teams can act to prevent
    “bad” outcomes and take advantage of
    “opportunities”
   The process enhances project value only if action
    is taken to manage the risks.

Mustafa Mohamedali - WSDOT/SAEO                     3/38

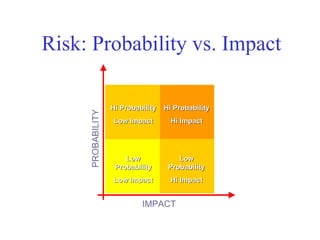

Risk: Probability vs. Impact

                                          Hi Probability   Hi Probability
                            PROBABILITY

                                           Low Impact        Hi Impact

                                              Low              Low
                                           Probability      Probability
                                           Low Impact        Hi Impact

                                                   IMPACT

Mustafa Mohamedali - WSDOT/SAEO                                             4/38

When a project is conceived… what
        do people want to know?

                                  N?                 1. What are we getting?

                                                CO
                                                          2. How long will it take?
                         T IO

                                                   ST
                       RA

                                                             3. How much will it

                                                      ?
                     DU

                                                                cost?

                                       WHAT ?

Mustafa Mohamedali - WSDOT/SAEO                                                5/38

PM Fundamentals: Triple Constraints
              Theory

                             LE
                                                     Risk

                                          BU
                                                    Event!
                           DU

                                            DG
                        HE

                                               ET
                      SC

                                  SCOPE

Mustafa Mohamedali - WSDOT/SAEO                              6/38

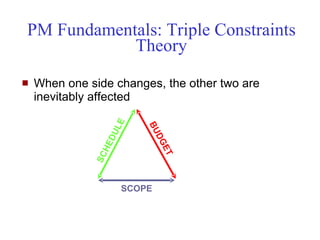

PM Fundamentals: Triple Constraints
              Theory
   When one side changes, the other two are
    inevitably affected
                                    E

                                           BU
                                  UL

                                               DG
                                  ED

                                                ET
                                H
                             SC

                                       SCOPE

Mustafa Mohamedali - WSDOT/SAEO                      7/38

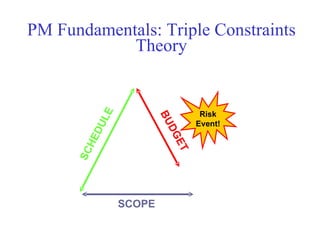

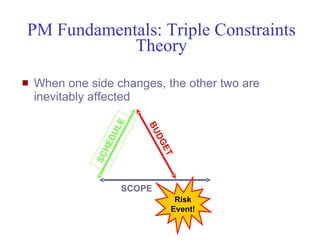

PM Fundamentals: Triple Constraints
              Theory
   When one side changes, the other two are
    inevitably affected
                                    E

                                           BU
                                  UL

                                               DG
                                  ED

                                                ET
                                H
                             SC

                                       SCOPE
                                                     Risk
                                                    Event!

Mustafa Mohamedali - WSDOT/SAEO                              8/38
PM Fundamentals: Triple Constraints
              Theory

                             LE

                                          BU
                           DU

                                            DG
                        HE

                                               ET
                      SC

                                  SCOPE

Mustafa Mohamedali - WSDOT/SAEO                     9/38

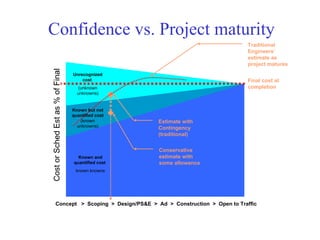

Confidence vs. Project maturity
                                                                                           Traditional
                                                                                           Engineers’
                                                                                           estimate as
                                                                                           project matures
            Cost or Sched Est as % of Final

                                              Unrecognized
                                                  cost                                     Final cost at
                                                (unknown                                   completion
                                                unknowns)

                                              Known but not
                                              quantified cost
                                                 (known                   Estimate with
                                                unknowns)                 Contingency
                                                                          (traditional)

                                                                          Conservative
                                                Known and                 estimate with
                                              quantified cost             some allowance
                                               known knowns

                       Concept > Scoping > Design/PS&E > Ad > Construction > Open to Traffic
                                                                Project Maturity

Mustafa Mohamedali - WSDOT/SAEO                                                                              10/38

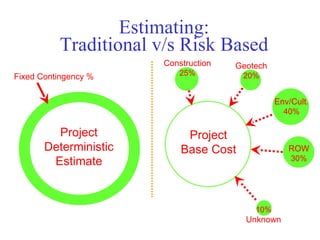

Estimating:
                Traditional v/s Risk Based
                                   Construction   Geotech
Fixed Contingency %                   25%          20%

                                                            Env/Cult.
                                                              40%

            Project                     Project
          Deterministic                Base Cost               ROW
                                                                30%
           Estimate

                                                      10%
                                                    Unknown
 Mustafa Mohamedali - WSDOT/SAEO                                11/38

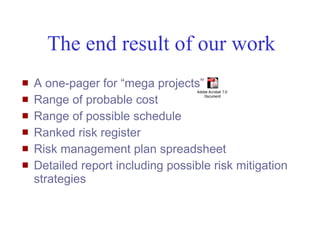

The end result of our work
   A one-pager for “mega projects”
                                    Adobe Acrobat 7.0

    Range of probable cost             Document

   Range of possible schedule
   Ranked risk register
   Risk management plan spreadsheet
   Detailed report including possible risk mitigation
    strategies

Mustafa Mohamedali - WSDOT/SAEO                          12/38

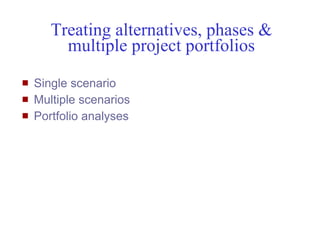

Treating alternatives, phases &
             multiple project portfolios
   Single scenario
   Multiple scenarios
   Portfolio analyses

Mustafa Mohamedali - WSDOT/SAEO              13/38

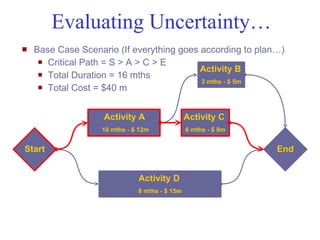

Evaluating Uncertainty…
   Base Case Scenario (If everything goes according to plan…)
      Critical Path = S > A > C > E
                                           Activity B
      Total Duration = 16 mths
                                           3 mths - $ 5m
      Total Cost = $40 m

                                  Activity A                  Activity C
                                  10 mths - $ 12m             6 mths - $ 8m

 Start                                                                        End

                                             Activity D
                                             8 mths - $ 15m

Mustafa Mohamedali - WSDOT/SAEO                                                 14/38
Evaluating Uncertainty…
   Risk Realization #1:                                              20
                                                                      %
      New Critical Path = S > A > B > E
                                                                     Activity B
      Duration = 18 mths
                                                                      8 mths - $ 6m
      Cost = $46 m

                                  Activity A                   Activity C
                                  10 mths - $ 12m              6 mths - $ 8m

 Start                                                                                End
                                      30
                                      %
                                             Activity D
                                             12 mths - $ 20m

Mustafa Mohamedali - WSDOT/SAEO                                                         15/38

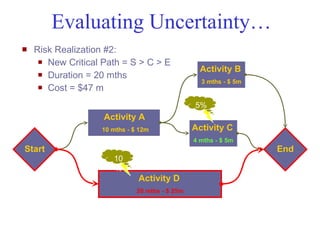

Evaluating Uncertainty…
   Risk Realization #2:
      New Critical Path = S > C > E
                                                                 Activity B
      Duration = 20 mths
                                                                 3 mths - $ 5m
      Cost = $47 m

                                                               5%
                                  Activity A
                                  10 mths - $ 12m              Activity C
                                                               4 mths - $ 5m
 Start                                                                           End
                                     10
                                     %
                                             Activity D
                                             20 mths - $ 25m

Mustafa Mohamedali - WSDOT/SAEO                                                    16/38

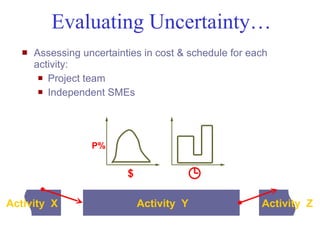

Evaluating Uncertainty…
      Assessing uncertainties in cost & schedule for each
       activity:
         Project team

         Independent SMEs

                               P%

                                     $

Activity X                               Activity Y     Activity Z

   Mustafa Mohamedali - WSDOT/SAEO                           17/38

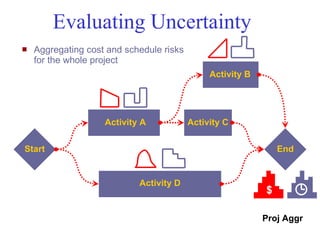

Evaluating Uncertainty
   Aggregating cost and schedule risks
    for the whole project
                                                            Activity B

                                  Activity A           Activity C

 Start                                                                       End

                                          Activity D
                                                                         $

                                                                         }
                                                                         Proj Aggr
Mustafa Mohamedali - WSDOT/SAEO                                                18/38

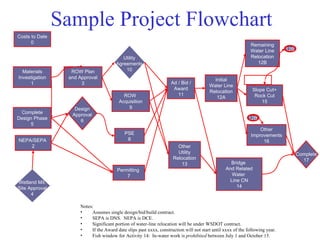

Sample Project Flowchart
Costs to Date
      0
                                                                                                                 Remaining
                                                                                                                 Water Line         12B
                                                  Utility                                                        Relocation
                                               Agreements                                                           12B
  Materials             ROW Plan                   10
Investigation          and Approval                                                            Initial          F – 2 mo.
     1                      3                                             Ad / Bid /
                                                                                             Water Line
                                                                           Award                                  Slope Cut+
                                                                                             Relocation
                                                  ROW                        11                                    Rock Cut
                                                                                                12A
 F – 4 mo.                                      Acquisition                                                           15
                          Design                    9
 Complete                Approval
Design Phase                                                                                                    12B
                            6                                                                                           F – 2 mo.
      5
                                                                                                                     Other
                                                   PSE                                                           Improvements
NEPA/SEPA                                           8                                                                 16
    2                                                                        Other
                                                                             Utility                                                      Complete
                                                                           Relocation                                                       17
       F – 5 mo.                                                                                       Bridge
                                                                               13
                                               Permitting                                            And Related
                                                   7                                                    Water
Wetland Mit.                                                                                           Line CN
Site Approval                                                                                             14
      4

                          Notes:
                          •    Assumes single design/bid/build contract.
                          •    SEPA is DNS. NEPA is DCE.
                          •    Significant portion of water-line relocation will be under WSDOT contract.
                          •
 Mustafa Mohamedali - WSDOT/SAEO the Award date slips past xxxx, construction will not start until xxxx of the following year.
                               If                                                                                                    19/38
                          •    Fish window for Activity 14: In-water work is prohibited between July 1 and October 15.

Risk Elicitation
   Sample of table developed during risk elicitation

Mustafa Mohamedali - WSDOT/SAEO                         20/38

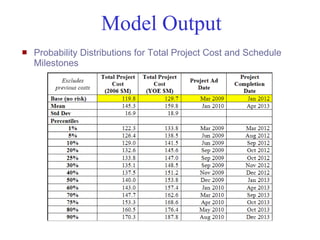

Model Output
   Probability Distributions for Total Project Cost and Schedule
    Milestones

Mustafa Mohamedali - WSDOT/SAEO                                     21/38

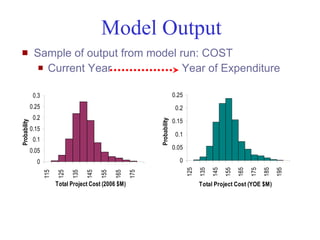

Model Output
              Sample of output from model run: COST
                 Current Year              Year of Expenditure

               0.3                                                            0.25
              0.25                                                             0.2
               0.2
                                                                              0.15

                                                                Probability
Probability

              0.15
                                                                               0.1
               0.1
                                                                              0.05
              0.05
                0                                                               0

                                                                                                                         185
                                                                                     125

                                                                                           135

                                                                                                 145

                                                                                                       155

                                                                                                             165

                                                                                                                   175

                                                                                                                               195
                                                          175
                     115

                           125

                                 135

                                       145

                                             155

                                                   165

                           Total Project Cost (2006 $M)                                    Total Project Cost (YOE $M)

Mustafa Mohamedali - WSDOT/SAEO                                                                                                      22/38

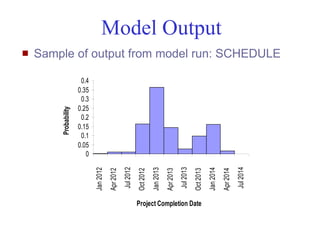

Model Output
   Sample of output from model run: SCHEDULE

                               0.4
                              0.35
                               0.3
                              0.25
                Probability

                               0.2
                              0.15
                               0.1
                              0.05
                                 0

                                                                                                                                                   Jul 2014
                                                           Jul 2012

                                                                                                       Jul 2013
                                     Jan 2012

                                                                                 Jan 2013

                                                                                                                             Jan 2014
                                                Apr 2012

                                                                                            Apr 2013

                                                                                                                                        Apr 2014
                                                                      Oct 2012

                                                                                                                  Oct 2013
                                                                      Project Completion Date

Mustafa Mohamedali - WSDOT/SAEO                                                                                                                               23/38

Model Output
   Ranked risk register

Mustafa Mohamedali - WSDOT/SAEO                  24/38

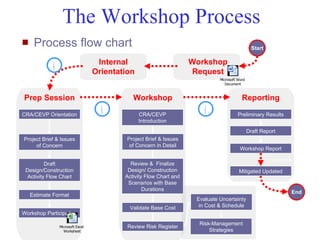

The Workshop Process
    Process flow chart                                                                        Start

                                Internal                          Workshop
               i               Orientation                         Request
                                                                            Microsoft Word
                                                                               Document

 Prep Session                              Workshop                                     Reporting

CRA/CEVP Orientation
                                    i        CRA/CEVP
                                                                      i               Preliminary Results
                                             Introduction
                                                                                             Draft Report
Project Brief & Issues                  Project Brief & Issues
     of Concern                          of Concern in Detail
                                                                                       Workshop Report

                                                                                                       3 > 6 months
          Draft                           Review & Finalize
 Design/Construction                     Design/ Construction                         Mitigated Updated
  Activity Flow Chart                   Activity Flow Chart and
                                         Scenarios with Base
                                                Durations
                                                                                                                      End
    Estimate Format
                                                                   Evaluate Uncertainty
                                          Validate Base Cost        in Cost & Schedule
Workshop Participation
                                                                    Risk-Management
                 Microsoft Excel        Review Risk Register
Mustafa   Mohamedali Worksheet
                     - WSDOT/SAEO                                       Strategies                                25/38

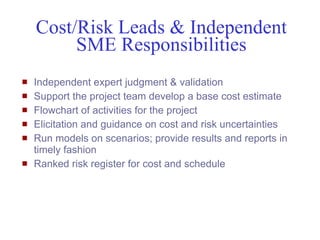

Cost/Risk Leads & Independent
          SME Responsibilities
   Independent expert judgment & validation
   Support the project team develop a base cost estimate
   Flowchart of activities for the project
   Elicitation and guidance on cost and risk uncertainties
   Run models on scenarios; provide results and reports in
    timely fashion
   Ranked risk register for cost and schedule

Mustafa Mohamedali - WSDOT/SAEO                               26/38

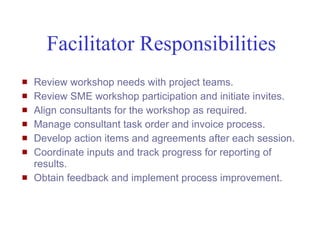

Facilitator Responsibilities
   Review workshop needs with project teams.
   Review SME workshop participation and initiate invites.
   Align consultants for the workshop as required.
   Manage consultant task order and invoice process.
   Develop action items and agreements after each session.
   Coordinate inputs and track progress for reporting of
    results.
   Obtain feedback and implement process improvement.

Mustafa Mohamedali - WSDOT/SAEO                          27/38

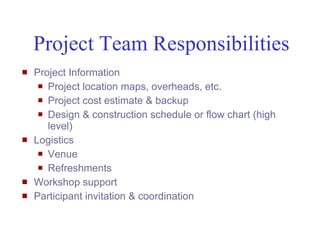

Project Team Responsibilities
   Project Information
      Project location maps, overheads, etc.

      Project cost estimate & backup

      Design & construction schedule or flow chart (high
       level)
   Logistics
      Venue

      Refreshments

   Workshop support
   Participant invitation & coordination

Mustafa Mohamedali - WSDOT/SAEO                             28/38
How does your team estimate cost
         and schedule…

                                  ?
Mustafa Mohamedali - WSDOT/SAEO       29/38

Risk Est 200907 Linked In

  • 1.
    Risk Based Estimating Process Orientation Introduction to Risk Based Estimating at WSDOT Mustafa Mohamedali October 18, 2007
  • 2.
    Risk Based EstimatingOrientation  This presentation comprises  An introduction to WSDOT’s cost risk assessment process  Why WSDOT embarked on this effort  Where it fits in WSDOT’s overall project management process  How it works and what is the output  What value it adds for project team and stakeholders  Workshop preparation, roles and responsibilities Mustafa Mohamedali - WSDOT/SAEO 2/38
  • 3.
    Why are wedoing this?  Projects seldom materialize exactly as planned  Risk mitigation: Project teams can act to prevent “bad” outcomes and take advantage of “opportunities”  The process enhances project value only if action is taken to manage the risks. Mustafa Mohamedali - WSDOT/SAEO 3/38
  • 4.
    Risk: Probability vs.Impact Hi Probability Hi Probability PROBABILITY Low Impact Hi Impact Low Low Probability Probability Low Impact Hi Impact IMPACT Mustafa Mohamedali - WSDOT/SAEO 4/38
  • 5.
    When a projectis conceived… what do people want to know? N? 1. What are we getting? CO 2. How long will it take? T IO ST RA 3. How much will it ? DU cost? WHAT ? Mustafa Mohamedali - WSDOT/SAEO 5/38
  • 6.
    PM Fundamentals: TripleConstraints Theory LE Risk BU Event! DU DG HE ET SC SCOPE Mustafa Mohamedali - WSDOT/SAEO 6/38
  • 7.
    PM Fundamentals: TripleConstraints Theory  When one side changes, the other two are inevitably affected E BU UL DG ED ET H SC SCOPE Mustafa Mohamedali - WSDOT/SAEO 7/38
  • 8.
    PM Fundamentals: TripleConstraints Theory  When one side changes, the other two are inevitably affected E BU UL DG ED ET H SC SCOPE Risk Event! Mustafa Mohamedali - WSDOT/SAEO 8/38
  • 9.
    PM Fundamentals: TripleConstraints Theory LE BU DU DG HE ET SC SCOPE Mustafa Mohamedali - WSDOT/SAEO 9/38
  • 10.
    Confidence vs. Projectmaturity Traditional Engineers’ estimate as project matures Cost or Sched Est as % of Final Unrecognized cost Final cost at (unknown completion unknowns) Known but not quantified cost (known Estimate with unknowns) Contingency (traditional) Conservative Known and estimate with quantified cost some allowance known knowns Concept > Scoping > Design/PS&E > Ad > Construction > Open to Traffic Project Maturity Mustafa Mohamedali - WSDOT/SAEO 10/38
  • 11.
    Estimating: Traditional v/s Risk Based Construction Geotech Fixed Contingency % 25% 20% Env/Cult. 40% Project Project Deterministic Base Cost ROW 30% Estimate 10% Unknown Mustafa Mohamedali - WSDOT/SAEO 11/38
  • 12.
    The end resultof our work  A one-pager for “mega projects” Adobe Acrobat 7.0 Range of probable cost Document   Range of possible schedule  Ranked risk register  Risk management plan spreadsheet  Detailed report including possible risk mitigation strategies Mustafa Mohamedali - WSDOT/SAEO 12/38
  • 13.
    Treating alternatives, phases& multiple project portfolios  Single scenario  Multiple scenarios  Portfolio analyses Mustafa Mohamedali - WSDOT/SAEO 13/38
  • 14.
    Evaluating Uncertainty…  Base Case Scenario (If everything goes according to plan…)  Critical Path = S > A > C > E Activity B  Total Duration = 16 mths 3 mths - $ 5m  Total Cost = $40 m Activity A Activity C 10 mths - $ 12m 6 mths - $ 8m Start End Activity D 8 mths - $ 15m Mustafa Mohamedali - WSDOT/SAEO 14/38
  • 15.
    Evaluating Uncertainty…  Risk Realization #1: 20 %  New Critical Path = S > A > B > E Activity B  Duration = 18 mths 8 mths - $ 6m  Cost = $46 m Activity A Activity C 10 mths - $ 12m 6 mths - $ 8m Start End 30 % Activity D 12 mths - $ 20m Mustafa Mohamedali - WSDOT/SAEO 15/38
  • 16.
    Evaluating Uncertainty…  Risk Realization #2:  New Critical Path = S > C > E Activity B  Duration = 20 mths 3 mths - $ 5m  Cost = $47 m 5% Activity A 10 mths - $ 12m Activity C 4 mths - $ 5m Start End 10 % Activity D 20 mths - $ 25m Mustafa Mohamedali - WSDOT/SAEO 16/38
  • 17.
    Evaluating Uncertainty…  Assessing uncertainties in cost & schedule for each activity:  Project team  Independent SMEs P% $ Activity X Activity Y Activity Z Mustafa Mohamedali - WSDOT/SAEO 17/38
  • 18.
    Evaluating Uncertainty  Aggregating cost and schedule risks for the whole project Activity B Activity A Activity C Start End Activity D $ } Proj Aggr Mustafa Mohamedali - WSDOT/SAEO 18/38
  • 19.
    Sample Project Flowchart Coststo Date 0 Remaining Water Line 12B Utility Relocation Agreements 12B Materials ROW Plan 10 Investigation and Approval Initial F – 2 mo. 1 3 Ad / Bid / Water Line Award Slope Cut+ Relocation ROW 11 Rock Cut 12A F – 4 mo. Acquisition 15 Design 9 Complete Approval Design Phase 12B 6 F – 2 mo. 5 Other PSE Improvements NEPA/SEPA 8 16 2 Other Utility Complete Relocation 17 F – 5 mo. Bridge 13 Permitting And Related 7 Water Wetland Mit. Line CN Site Approval 14 4 Notes: • Assumes single design/bid/build contract. • SEPA is DNS. NEPA is DCE. • Significant portion of water-line relocation will be under WSDOT contract. • Mustafa Mohamedali - WSDOT/SAEO the Award date slips past xxxx, construction will not start until xxxx of the following year. If 19/38 • Fish window for Activity 14: In-water work is prohibited between July 1 and October 15.
  • 20.
    Risk Elicitation  Sample of table developed during risk elicitation Mustafa Mohamedali - WSDOT/SAEO 20/38
  • 21.
    Model Output  Probability Distributions for Total Project Cost and Schedule Milestones Mustafa Mohamedali - WSDOT/SAEO 21/38
  • 22.
    Model Output  Sample of output from model run: COST  Current Year Year of Expenditure 0.3 0.25 0.25 0.2 0.2 0.15 Probability Probability 0.15 0.1 0.1 0.05 0.05 0 0 185 125 135 145 155 165 175 195 175 115 125 135 145 155 165 Total Project Cost (2006 $M) Total Project Cost (YOE $M) Mustafa Mohamedali - WSDOT/SAEO 22/38
  • 23.
    Model Output  Sample of output from model run: SCHEDULE 0.4 0.35 0.3 0.25 Probability 0.2 0.15 0.1 0.05 0 Jul 2014 Jul 2012 Jul 2013 Jan 2012 Jan 2013 Jan 2014 Apr 2012 Apr 2013 Apr 2014 Oct 2012 Oct 2013 Project Completion Date Mustafa Mohamedali - WSDOT/SAEO 23/38
  • 24.
    Model Output  Ranked risk register Mustafa Mohamedali - WSDOT/SAEO 24/38
  • 25.
    The Workshop Process  Process flow chart Start Internal Workshop i Orientation Request Microsoft Word Document Prep Session Workshop Reporting CRA/CEVP Orientation i CRA/CEVP i Preliminary Results Introduction Draft Report Project Brief & Issues Project Brief & Issues of Concern of Concern in Detail Workshop Report 3 > 6 months Draft Review & Finalize Design/Construction Design/ Construction Mitigated Updated Activity Flow Chart Activity Flow Chart and Scenarios with Base Durations End Estimate Format Evaluate Uncertainty Validate Base Cost in Cost & Schedule Workshop Participation Risk-Management Microsoft Excel Review Risk Register Mustafa Mohamedali Worksheet - WSDOT/SAEO Strategies 25/38
  • 26.
    Cost/Risk Leads &Independent SME Responsibilities  Independent expert judgment & validation  Support the project team develop a base cost estimate  Flowchart of activities for the project  Elicitation and guidance on cost and risk uncertainties  Run models on scenarios; provide results and reports in timely fashion  Ranked risk register for cost and schedule Mustafa Mohamedali - WSDOT/SAEO 26/38
  • 27.
    Facilitator Responsibilities  Review workshop needs with project teams.  Review SME workshop participation and initiate invites.  Align consultants for the workshop as required.  Manage consultant task order and invoice process.  Develop action items and agreements after each session.  Coordinate inputs and track progress for reporting of results.  Obtain feedback and implement process improvement. Mustafa Mohamedali - WSDOT/SAEO 27/38
  • 28.
    Project Team Responsibilities  Project Information  Project location maps, overheads, etc.  Project cost estimate & backup  Design & construction schedule or flow chart (high level)  Logistics  Venue  Refreshments  Workshop support  Participant invitation & coordination Mustafa Mohamedali - WSDOT/SAEO 28/38
  • 29.
    How does yourteam estimate cost and schedule… ? Mustafa Mohamedali - WSDOT/SAEO 29/38
