Quality contamination
in Agile Scrum Teams
and the Remedies
www.srijan.net | sumeet.gupta@srijan.in
The QA Strategy
1
Learning Outcome
2
• How to perform QA on an Agile Scrum Projects
• Defining efficient QA strategies for Agile Projects
• Agile/QA best practices

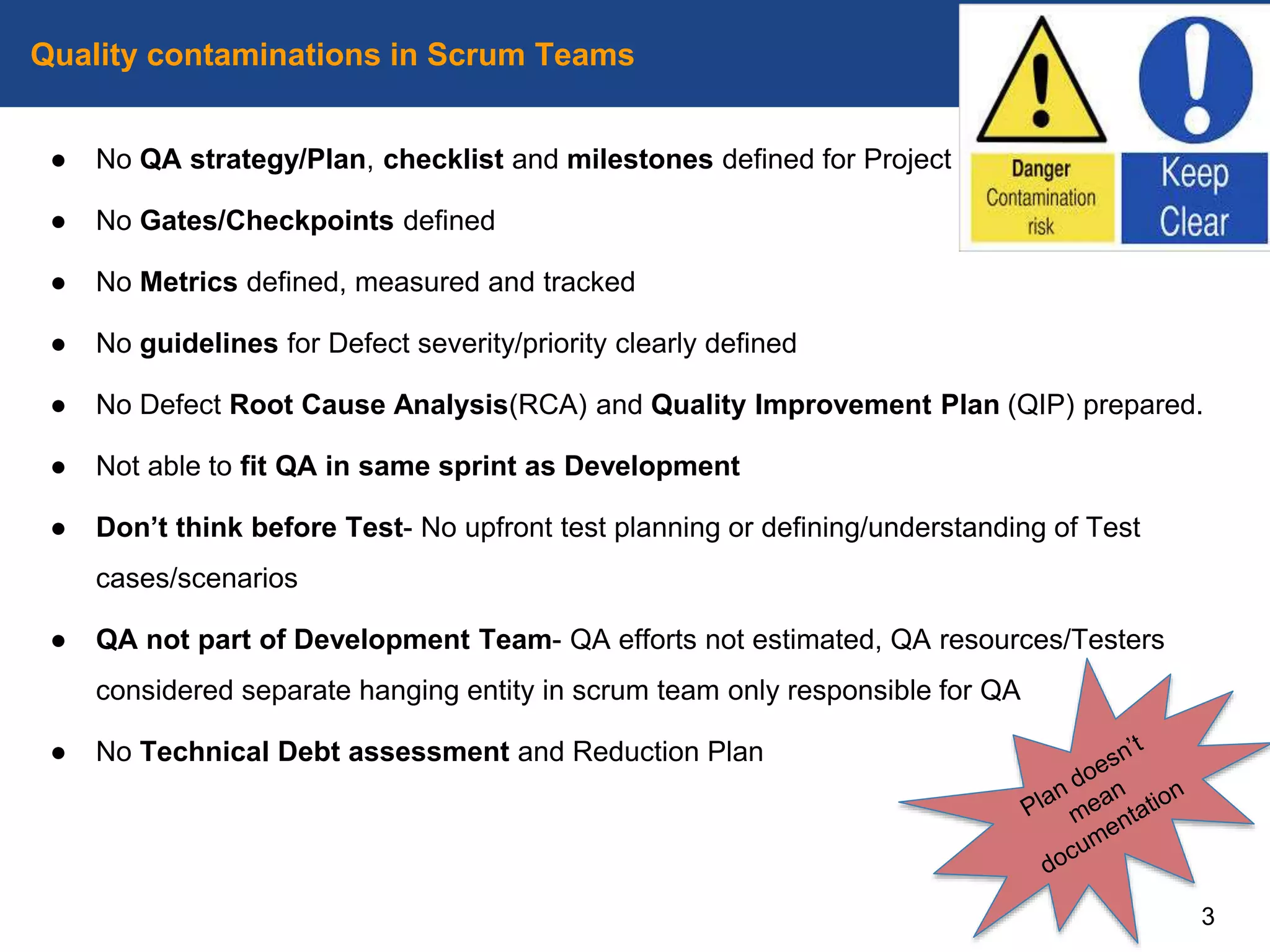

● No QA strategy/Plan, checklist and milestones defined for Project
● No Gates/Checkpoints defined
● No Metrics defined, measured and tracked
● No guidelines for Defect severity/priority clearly defined
● No Defect Root Cause Analysis(RCA) and Quality Improvement Plan (QIP) prepared.
● Not able to fit QA in same sprint as Development
● Don’t think before Test- No upfront test planning or defining/understanding of Test
cases/scenarios
● QA not part of Development Team- QA efforts not estimated, QA resources/Testers
considered separate hanging entity in scrum team only responsible for QA
● No Technical Debt assessment and Reduction Plan
Quality contaminations in Scrum Teams
3

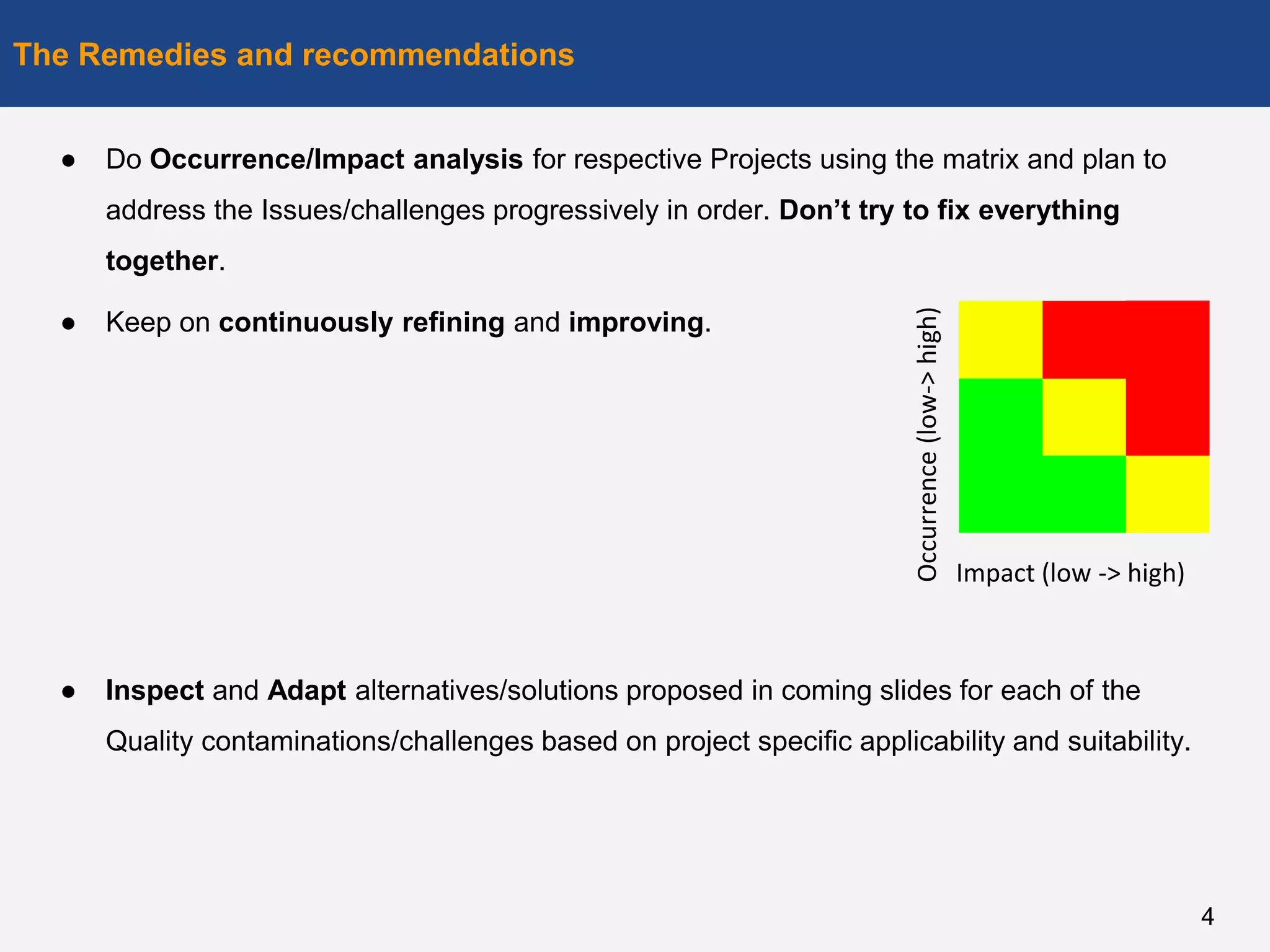

● Do Occurrence/Impact analysis for respective Projects using the matrix and plan to
address the Issues/challenges progressively in order. Don’t try to fix everything
together.
● Keep on continuously refining and improving.
● Inspect and Adapt alternatives/solutions proposed in coming slides for each of the
Quality contaminations/challenges based on project specific applicability and suitability.
The Remedies and recommendations
4
Impact (low -> high)
Occurrence(low->high)

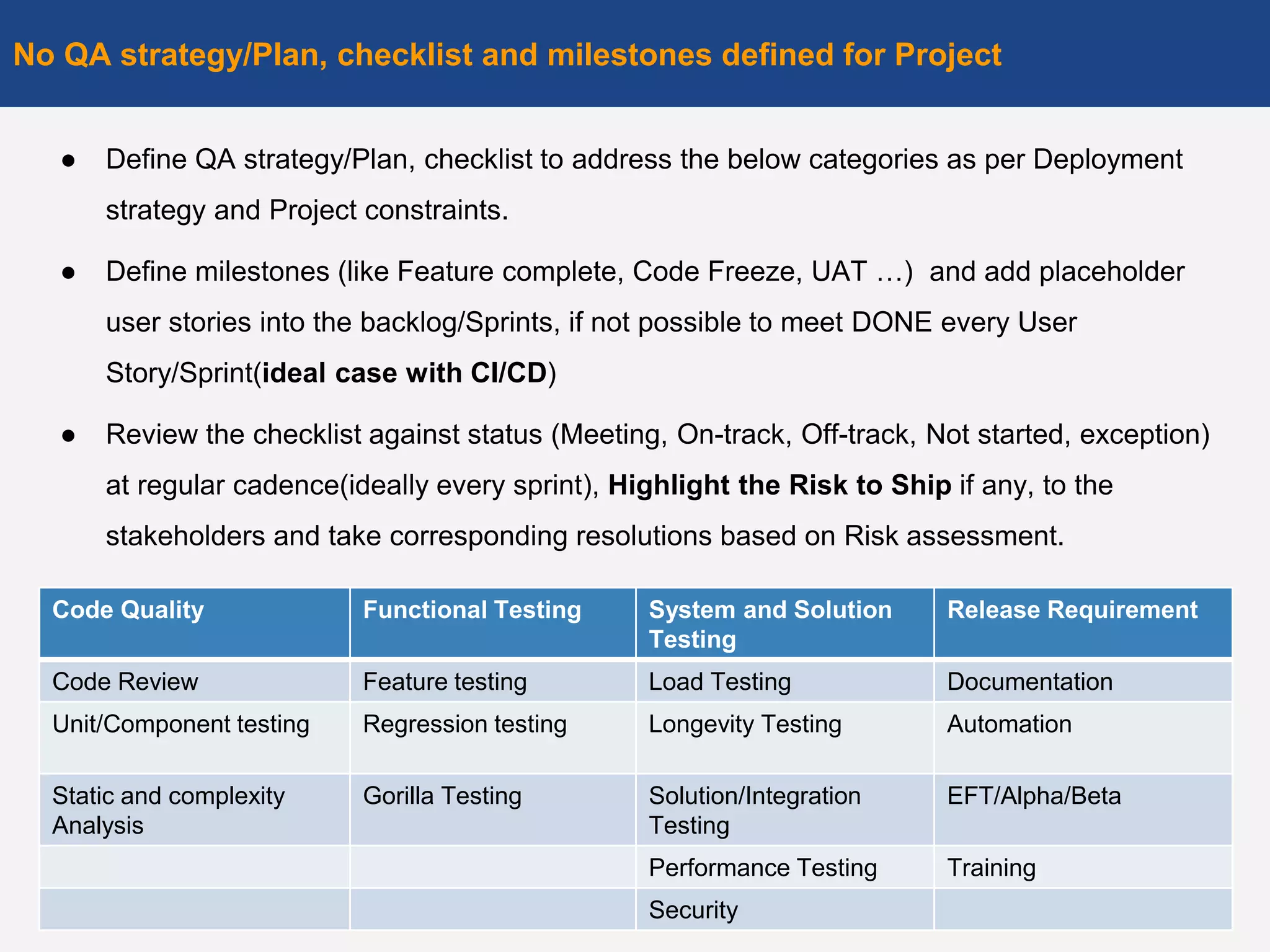

● Define QA strategy/Plan, checklist to address the below categories as per Deployment
strategy and Project constraints.
● Define milestones (like Feature complete, Code Freeze, UAT …) and add placeholder
user stories into the backlog/Sprints, if not possible to meet DONE every User
Story/Sprint(ideal case with CI/CD)
● Review the checklist against status (Meeting, On-track, Off-track, Not started, exception)
at regular cadence(ideally every sprint), Highlight the Risk to Ship if any, to the
stakeholders and take corresponding resolutions based on Risk assessment.
No QA strategy/Plan, checklist and milestones defined for Project
5
Code Quality Functional Testing System and Solution
Testing
Release Requirement
Code Review Feature testing Load Testing Documentation
Unit/Component testing Regression testing Longevity Testing Automation
Static and complexity
Analysis
Gorilla Testing Solution/Integration
Testing
EFT/Alpha/Beta
Performance Testing Training
Security

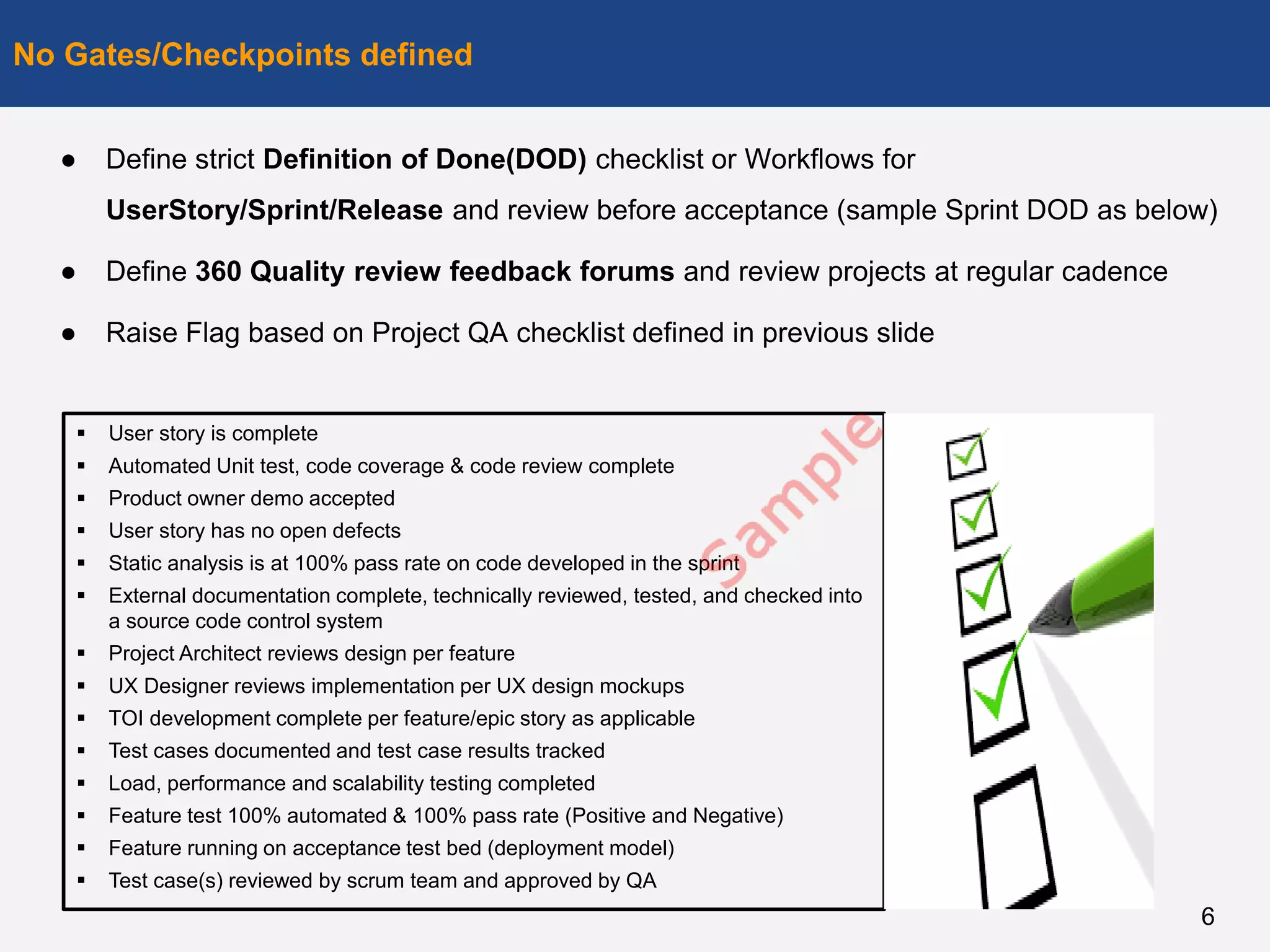

● Define strict Definition of Done(DOD) checklist or Workflows for
UserStory/Sprint/Release and review before acceptance (sample Sprint DOD as below)
● Define 360 Quality review feedback forums and review projects at regular cadence
● Raise Flag based on Project QA checklist defined in previous slide
No Gates/Checkpoints defined
6
 User story is complete
 Automated Unit test, code coverage & code review complete
 Product owner demo accepted
 User story has no open defects
 Static analysis is at 100% pass rate on code developed in the sprint
 External documentation complete, technically reviewed, tested, and checked into
a source code control system
 Project Architect reviews design per feature
 UX Designer reviews implementation per UX design mockups
 TOI development complete per feature/epic story as applicable
 Test cases documented and test case results tracked
 Load, performance and scalability testing completed
 Feature test 100% automated & 100% pass rate (Positive and Negative)
 Feature running on acceptance test bed (deployment model)
 Test case(s) reviewed by scrum team and approved by QA
● Mix in Release Done along the way so you don't build up a huge debt to complete in the
final Release Done

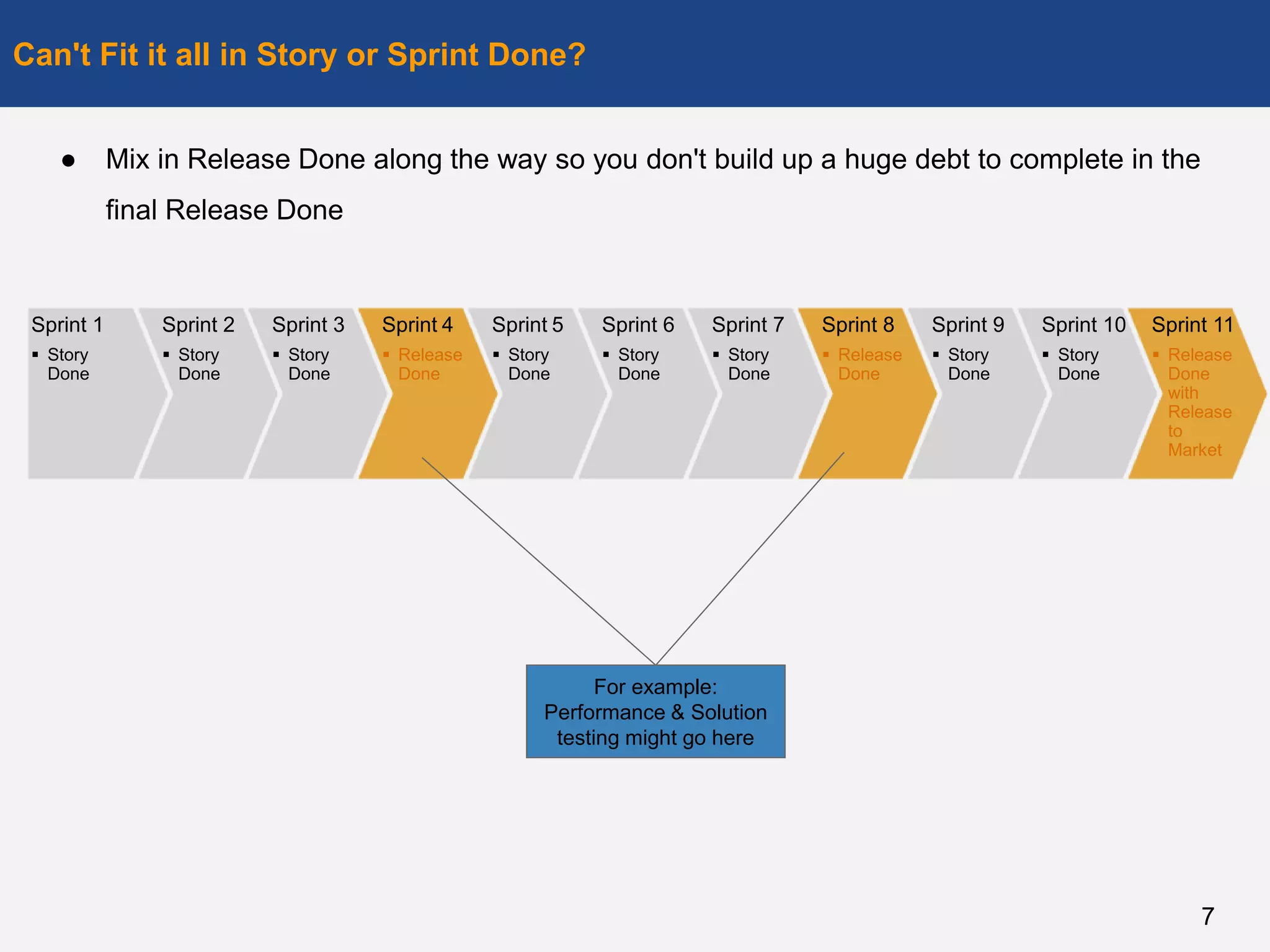

Can't Fit it all in Story or Sprint Done?
7
Sprint 1
 Story
Done
Sprint 2
 Story
Done
Sprint 3
 Story
Done
Sprint 4
 Release
Done
Sprint 5
 Story
Done
Sprint 6
 Story
Done
Sprint 7
 Story
Done
Sprint 8
 Release
Done
Sprint 9
 Story
Done
Sprint 10
 Story
Done
Sprint 11
 Release
Done
with
Release
to
Market
For example:
Performance & Solution
testing might go here

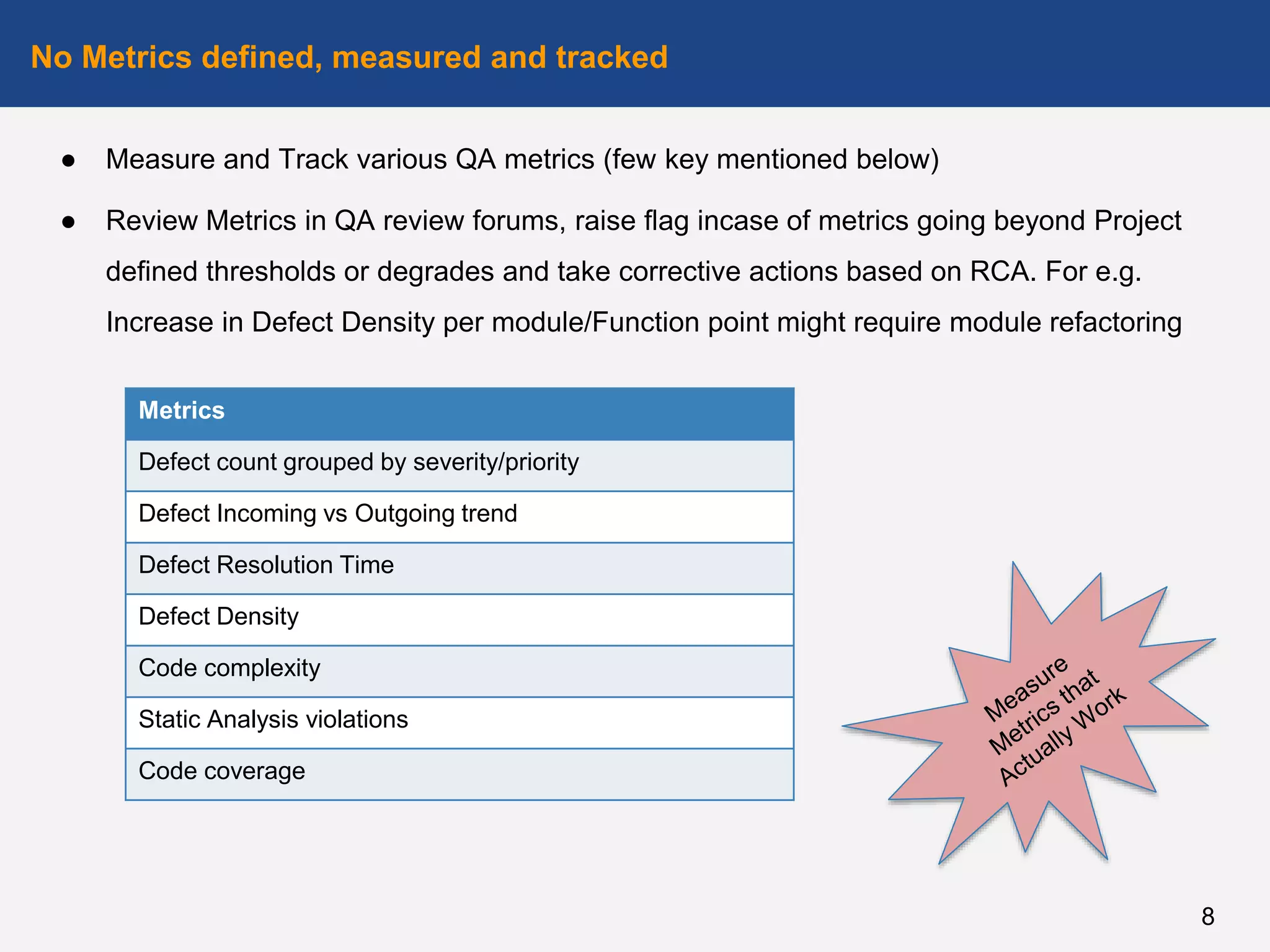

● Measure and Track various QA metrics (few key mentioned below)
● Review Metrics in QA review forums, raise flag incase of metrics going beyond Project
defined thresholds or degrades and take corrective actions based on RCA. For e.g.
Increase in Defect Density per module/Function point might require module refactoring
No Metrics defined, measured and tracked
8
Metrics
Defect count grouped by severity/priority
Defect Incoming vs Outgoing trend
Defect Resolution Time
Defect Density
Code complexity
Static Analysis violations
Code coverage

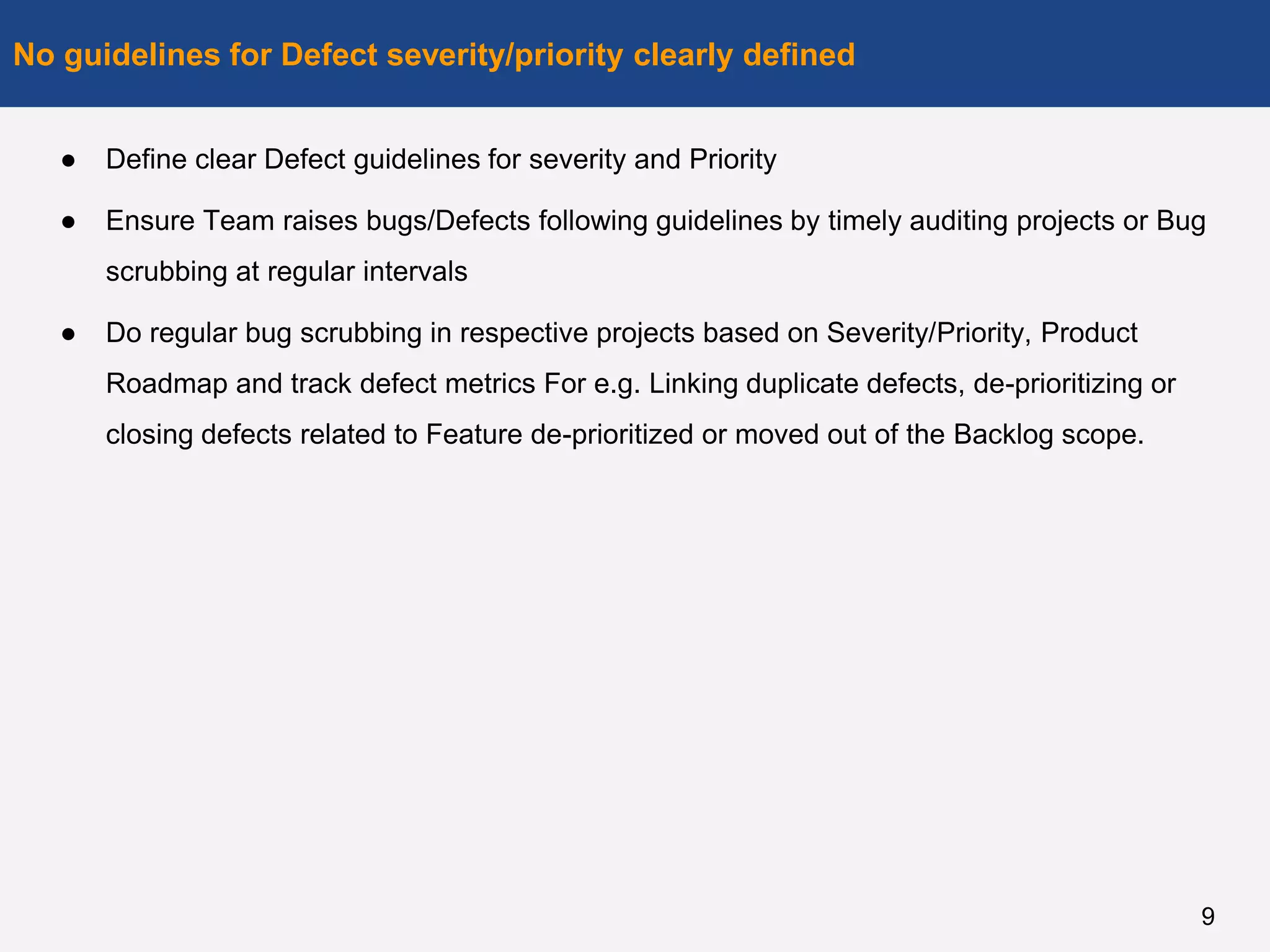

● Define clear Defect guidelines for severity and Priority
● Ensure Team raises bugs/Defects following guidelines by timely auditing projects or Bug
scrubbing at regular intervals
● Do regular bug scrubbing in respective projects based on Severity/Priority, Product
Roadmap and track defect metrics For e.g. Linking duplicate defects, de-prioritizing or
closing defects related to Feature de-prioritized or moved out of the Backlog scope.
No guidelines for Defect severity/priority clearly defined
9

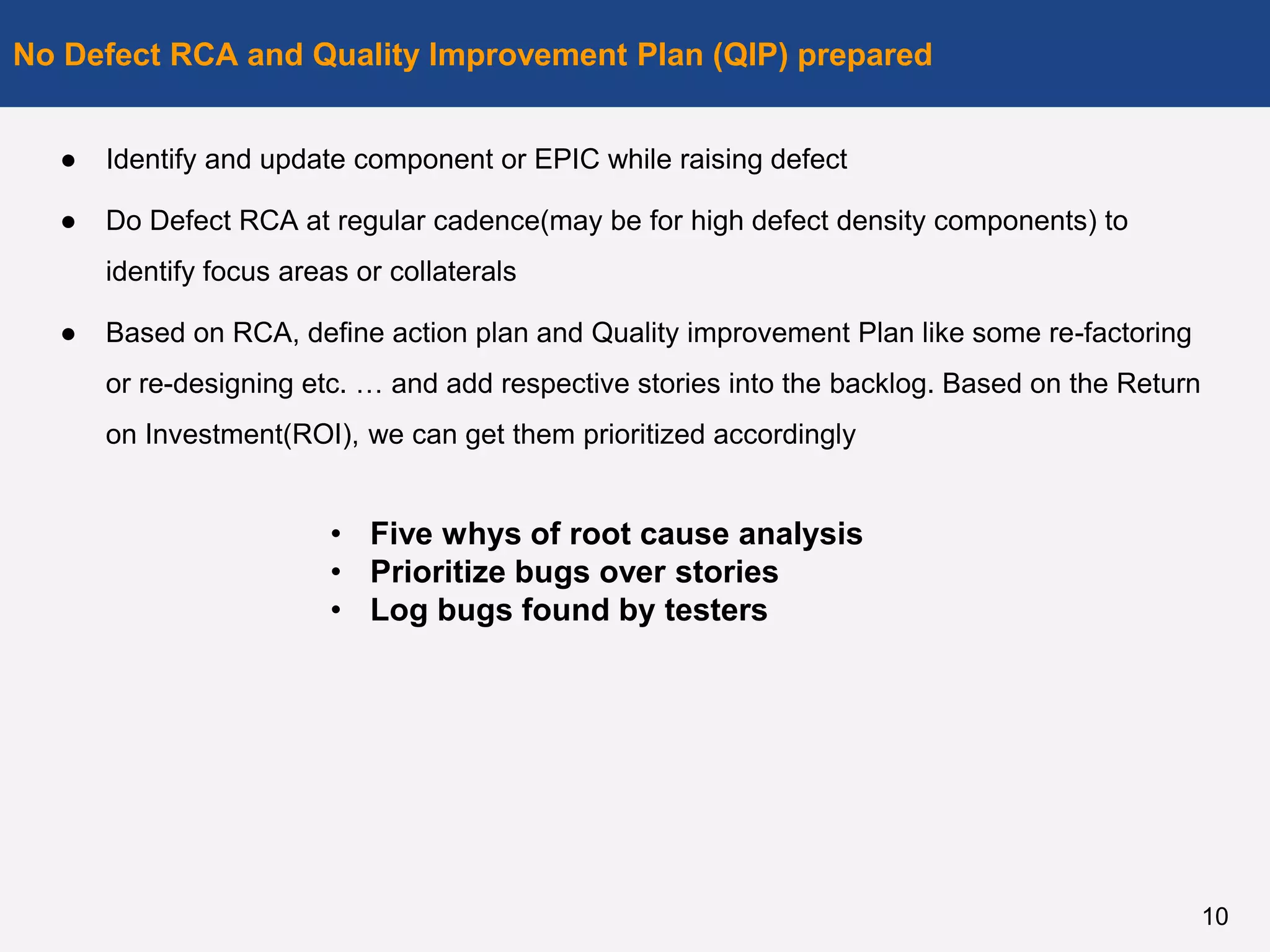

● Identify and update component or EPIC while raising defect
● Do Defect RCA at regular cadence(may be for high defect density components) to
identify focus areas or collaterals
● Based on RCA, define action plan and Quality improvement Plan like some re-factoring
or re-designing etc. … and add respective stories into the backlog. Based on the Return
on Investment(ROI), we can get them prioritized accordingly
No Defect RCA and Quality Improvement Plan (QIP) prepared
10
• Five whys of root cause analysis
• Prioritize bugs over stories
• Log bugs found by testers

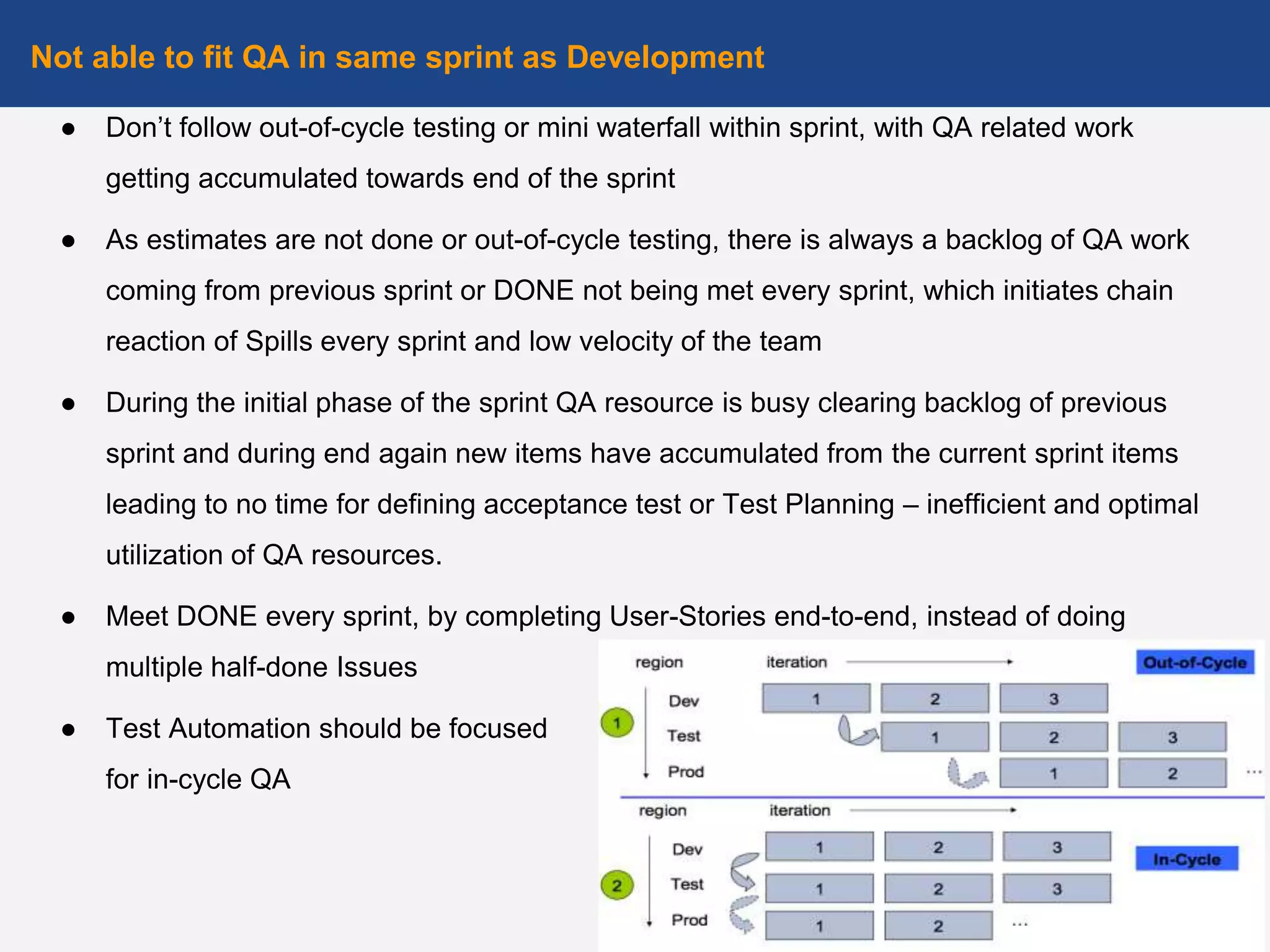

● Don’t follow out-of-cycle testing or mini waterfall within sprint, with QA related work
getting accumulated towards end of the sprint
● As estimates are not done or out-of-cycle testing, there is always a backlog of QA work
coming from previous sprint or DONE not being met every sprint, which initiates chain
reaction of Spills every sprint and low velocity of the team
● During the initial phase of the sprint QA resource is busy clearing backlog of previous
sprint and during end again new items have accumulated from the current sprint items
leading to no time for defining acceptance test or Test Planning – inefficient and optimal
utilization of QA resources.
● Meet DONE every sprint, by completing User-Stories end-to-end, instead of doing
multiple half-done Issues
● Test Automation should be focused
for in-cycle QA
Not able to fit QA in same sprint as Development
11

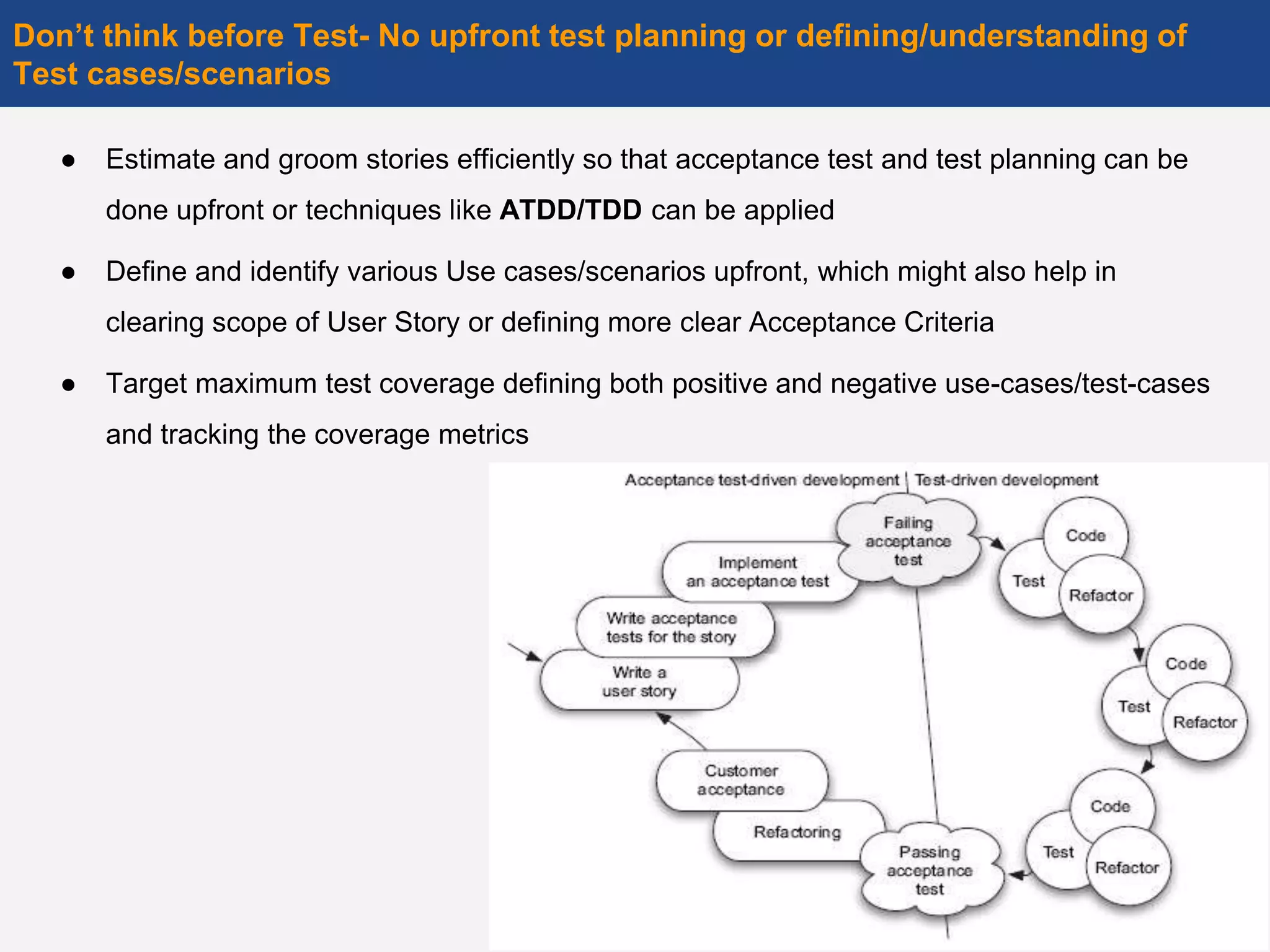

● Estimate and groom stories efficiently so that acceptance test and test planning can be
done upfront or techniques like ATDD/TDD can be applied
● Define and identify various Use cases/scenarios upfront, which might also help in
clearing scope of User Story or defining more clear Acceptance Criteria
● Target maximum test coverage defining both positive and negative use-cases/test-cases
and tracking the coverage metrics
Don’t think before Test- No upfront test planning or defining/understanding of
Test cases/scenarios
12

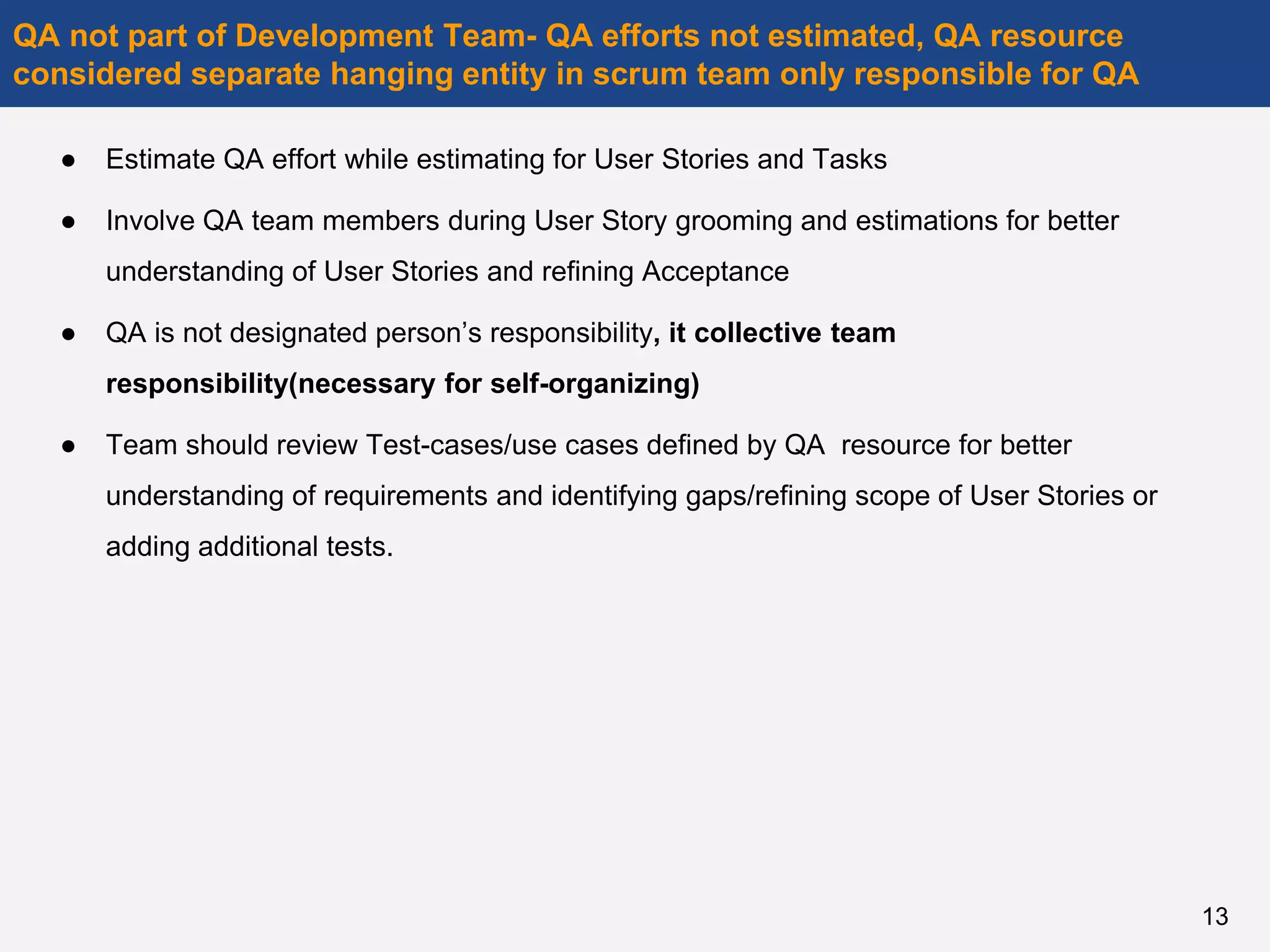

● Estimate QA effort while estimating for User Stories and Tasks
● Involve QA team members during User Story grooming and estimations for better
understanding of User Stories and refining Acceptance
● QA is not designated person’s responsibility, it collective team
responsibility(necessary for self-organizing)
● Team should review Test-cases/use cases defined by QA resource for better
understanding of requirements and identifying gaps/refining scope of User Stories or
adding additional tests.
QA not part of Development Team- QA efforts not estimated, QA resource
considered separate hanging entity in scrum team only responsible for QA
13

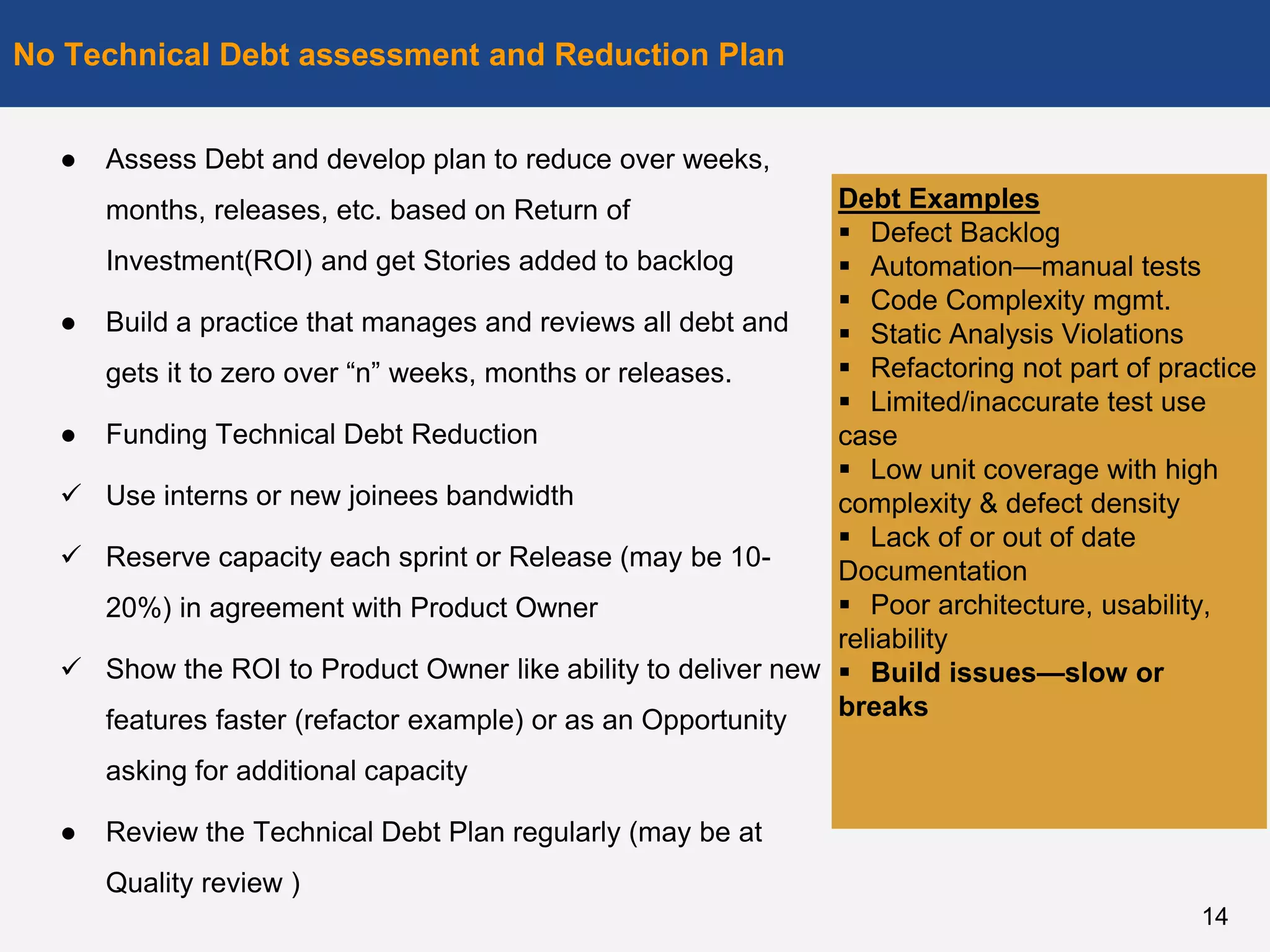

● Assess Debt and develop plan to reduce over weeks,
months, releases, etc. based on Return of
Investment(ROI) and get Stories added to backlog
● Build a practice that manages and reviews all debt and
gets it to zero over “n” weeks, months or releases.
● Funding Technical Debt Reduction
 Use interns or new joinees bandwidth
 Reserve capacity each sprint or Release (may be 10-
20%) in agreement with Product Owner
 Show the ROI to Product Owner like ability to deliver new
features faster (refactor example) or as an Opportunity
asking for additional capacity
● Review the Technical Debt Plan regularly (may be at
Quality review )
No Technical Debt assessment and Reduction Plan
14
Debt Examples
 Defect Backlog
 Automation—manual tests
 Code Complexity mgmt.
 Static Analysis Violations
 Refactoring not part of practice
 Limited/inaccurate test use
case
 Low unit coverage with high
complexity & defect density
 Lack of or out of date
Documentation
 Poor architecture, usability,
reliability
 Build issues—slow or
breaks
No Technical Debt assessment and Reduction Plan
15

Reducing build time. Increasing number of builds per day. Added continuous
integration builds
0.00
1.00
2.00
3.00
4.00
5.00
6.00
7.00
8.00
9.00
0
2
4
6
8
10
12
7.5 8.0 8.5 9.0 10.0 10.5
Hours
Builds
Number of Builds/Day # of CI Builds/Day Build Duration (Hrs)
“Software testing proves the
existing of bugs not their
absence.” – Edsger W. Dijkstra
“Quality is not an act, it is a
habit” – Aristotle
16
THANK YOU
Sumeet Gupta
Agile Coach | CSP, CSM | SAFe Agilist | Certified Disciplined Agilist- Yellow Belt
17
@sumeetgupta1982 sumgupta
