Q4 2013
Financial Results
Conference Call and Webcast
March 4, 2014
TSX: AUQ / NYSE: AUQ
www.auricogold.com
FORWARD LOOKING STATEMENTS
This presentation contains forward-looking statements and forward-looking information as defined under Canadian and U.S. securities laws. All statements,
other than statements of historical fact, are forward-looking statements. The words "expect", "believe", "anticipate", "will", "intend", "estimate", "forecast",
"budget" and similar expressions identify forward-looking statements. Forward-looking statements include information as to strategy, plans or future financial or
operating performance, such as the Company’s expansion plans, project timelines, production plans, projected cash flows or capital expenditures, cost
estimates, projected exploration results, reserve and resource estimates and other statements that express management’s expectations or estimates of future
performance.
Forward-looking statements are necessarily based upon a number of factors and assumptions that, while considered reasonable by management, are inherently
subject to significant uncertainties and contingencies. Known and unknown factors could cause actual results to differ materially from those projected in the
forward-looking statements, including: uncertainty of production and cost estimates; fluctuations in the price of gold and foreign exchange rates; the uncertainty
of replacing depleted reserves; the risk that the Young-Davidson shaft will not perform as planned; the risk that mining operations do not meet expectations; the
risk that projects will not be developed accordingly to budgets or timelines, changes in laws in Canada, Mexico and other jurisdictions in which the Company
may carry on business; risks of obtaining necessary licenses, permits or approvals for operations or projects such as Kemess; disputes over title to properties;
the speculative nature of mineral exploration and development; risks related to aboriginal title claims; compliance risks with respect to current and future
environmental regulations; disruptions affecting operations; opportunities that may be pursued by the Company; employee relations; availability and costs of
mining inputs and labor; the ability to secure capital to execute business plans; volatility of the Company’s share price; continuation of the dividend and dividend
reinvestment plan; the effect of future financings; litigation; risk of loss due to sabotage and civil disturbances; the values of assets and liabilities based on
projected future cash flows; risks arising from derivative instruments or the absence of hedging; adequacy of internal control over financial reporting; changes in
credit rating; and the impact of inflation.
Actual results and developments are likely to differ, and may differ materially, from those expressed or implied by the forward-looking statements contained
herein. Such statements are based on a number of assumptions which may prove to be incorrect, including assumptions about: business and economic
conditions; commodity prices and the price of key inputs such as labour, fuel and electricity; credit market conditions and conditions in financial markets
generally; revenue and cash flow estimates, production levels, development schedules and the associated costs; ability to procure equipment and supplies and
on a timely basis; the timing of the receipt of permits and other approvals for projects and operations; the ability to attract and retain skilled employees and
contractors for the operations; the accuracy of reserve and resource estimates; the impact of changes in currency exchange rates on costs and results; interest
rates; taxation; and ongoing relations with employees and business partners. The Company disclaims any intention or obligation to update or revise any
forward-looking statements whether as a result of new information, future events or otherwise, except as required by applicable law.
Cautionary Note to U.S. Investors Concerning Measured, Indicated and Inferred Resources
This presentation uses the terms "measured," "indicated" and "inferred” resources. We advise investors that while those terms are recognized and required by
Canadian regulations, the United States Securities and Exchange Commission does not recognize them. “Inferred” resources” have a great amount of
uncertainty as to their existence and as to their economic and legal feasibility. It cannot be assumed that all or any part of an inferred resource will ever be
upgraded to a higher category. Under Canadian rules, estimates of inferred mineral resources may not form the basis of feasibility or other economic studies.
United States investors are cautioned not to assume that all or any part of measured or indicated mineral resources will ever be converted into mineral reserves.
United States investors are also cautioned not to assume that all or any part of an inferred mineral resource exists, or is economically or legally mineable.

2
Scott Perry
President & CEO
Corporate Update

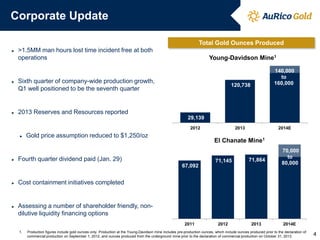

Total Gold Ounces Produced
►

>1.5MM man hours lost time incident free at both
operations

►

120,738

140,000
to
160,000

2013

Sixth quarter of company-wide production growth,
Q1 well positioned to be the seventh quarter

►

Young-Davidson Mine1

2014E

2013 Reserves and Resources reported
29,139
2012
►

►

Gold price assumption reduced to $1,250/oz

El Chanate Mine1

Fourth quarter dividend paid (Jan. 29)

71,145

71,864

2012

2013

67,092
►

Cost containment initiatives completed

►

70,000
to
80,000

Assessing a number of shareholder friendly, nondilutive liquidity financing options
2011
1.

2014E

Production figures include gold ounces only. Production at the Young-Davidson mine includes pre-production ounces, which include ounces produced prior to the declaration of
commercial production on September 1, 2012, and ounces produced from the underground mine prior to the declaration of commercial production on October 31, 2013.

4
Sixth Quarter of Record Gold Production
Young-Davidson

Sixth Consecutive Quarter of Record Gold Production

El Chanate

46,170

50,000

48,003

48,903

49,526

Q2 13

Q3 13

Q4 13

Gold Ounces Produced

41,145
40,000

37,213

30,000

20,000

10,000

0

Q3 12

Q4 12

Q1 13

Q1 14E

2013 Operational Results
First Quarter
March 31/13

Gold Ounces Produced3
Total Cash Costs per oz.1,2
All-in Sustaining Costs per oz.2
1.

2.
3.

Second Quarter
June 30/13

Third Quarter
Sept. 30/13

Fourth Quarter
Dec. 31/13

Year-End
Dec. 31/13

46,170

48,003

48,903

49,526

192,602

$635

$655

$628

$771

$676

$1,090

$1,189

$1,210

$1,232

$1,181

Prior to commissioning the underground mine at Young-Davidson, cash costs were calculated on ounces produced from the open pit only. All underground costs were capitalized, and any revenue related to underground ounces sold
was credited against capital. Subsequent to the declaration of commercial production in the underground mine, cash costs are calculated on ounces produced from both the open pit and underground mines, and revenue related to the
sale of underground ounces is recognized in the Company's Statement of Operations as revenue.
Cash costs, prior to inventory net realizable value adjustments. See the Non-GAAP Measures section on page 23 of the Management’s Discussion and Analysis for the year ended December 31, 2013.
Includes pre-production gold ounces from the Young-Davidson underground mine prior to the declaration of commercial production on October 31, 2013.

5
Young-Davidson Update
Mid-shaft loading project commissioned
►

Q4 underground productivity of approx. 2,600tpd

►

Productivity ramp-up from 2,500tpd to 4,000tpd at year-end
(target of 8,000tpd at end of 2016)

Paste Backfill Plant Commissioned
►

First paste pour in January 2014

In-line underground unit mining costs
►

$39/t in November and December, 2013

►

$45/t in Q1/14 with inclusion of paste fill, decreasing throughout
the year with increased productivity

Underground Mine Development Advance
►

75% of 2014 mine plan is laterally accessed

Lower mine vertical development underway
►

Will provide access to 20 years of strategic mine life

Mill facility permit increased to 10,000tpd
6

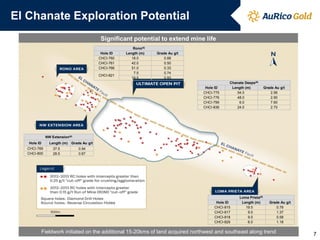

El Chanate Exploration Potential
Significant potential to extend mine life
Hole ID
CHCI-760
CHCI-761
CHCI-766
CHCI-821

Rono(6)
Length (m)
18.0
42.0
51.0
7.5
19.5

Grade Au g/t
0.88
0.50
0.33
0.74
0.93
Hole ID
CHCI-775
CHCI-776
CHCI-799
CHCI-836

Chanate Deeps(6)
Length (m)
54.0
48.0
6.0
24.0

Grade Au g/t
2.56
2.90
7.60
2.70

NW Extension(6)
Hole ID
CHCI-769
CHCI-800

Length (m)
37.5
28.5

Grade Au g/t
0.94
0.67

Hole ID
CHCI-815
CHCI-817
CHCI-818
CHCI-829

Loma Prieta(6)
Length (m)
19.5
9.0
9.0
6.0

Grade Au g/t
0.78
1.37
0.58
1.18

Fieldwork initiated on the additional 15-20kms of land acquired northwest and southeast along trend

7

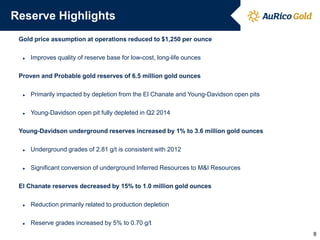

Reserve Highlights
Gold price assumption at operations reduced to $1,250 per ounce
►

Improves quality of reserve base for low-cost, long-life ounces

Proven and Probable gold reserves of 6.5 million gold ounces
►

Primarily impacted by depletion from the El Chanate and Young-Davidson open pits

►

Young-Davidson open pit fully depleted in Q2 2014

Young-Davidson underground reserves increased by 1% to 3.6 million gold ounces
►

Underground grades of 2.81 g/t is consistent with 2012

►

Significant conversion of underground Inferred Resources to M&I Resources

El Chanate reserves decreased by 15% to 1.0 million gold ounces
►

Reduction primarily related to production depletion

►

Reserve grades increased by 5% to 0.70 g/t
8
Rob Chausse
Chief Financial Officer
Conference Call and Webcast
March 4, 2014
Continuing Operations Highlights(1)
Quarter Ended
(in thousands, except ounces , per share amounts and average realized price)

Revenue from mining operations

Quarter Ended

Dec. 31, 2013

Dec. 31, 2012

$50,782

$63,119

Total gold ounces sold (excluding pre-production ounces)

39,855

36,137

Total gold ounces produced (excluding pre-production ounces)

46,017

34,018

$17,508

$30,426

$0.07

$0.11

$(106,412)

$(135,142)

$(0.43)

$(0.48)

$(5,484)

$13,052

Adjusted net (loss) / earnings per share, basic(3)

$(0.02)

$0.05

Average realized price per ounce

$1,257

$1,720

Adjusted operating cash flow(2)
Adjusted operating cash flow per share, basic(2)
Net loss
Net loss per share, basic
Adjusted net (loss) / earnings(3)

1.
2.
3.

Continuing operations include the Young-Davidson and El Chanate mine operations.
See the table on slide 18 for a reconciliation of adjusted operating cash flow and refer to the discussion of Non-GAAP measures in the Company’s 2013 Financial Results Press
Release.
See the table on slide 15 and 17 for a reconciliation of adjusted net earnings and refer to the discussion of Non-GAAP measures in the Company’s 2013 Financial Results Press
Release.

10

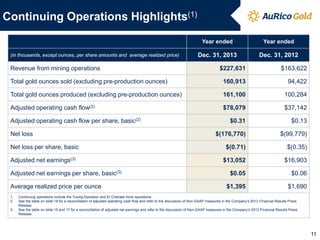

Continuing Operations Highlights(1)
Year ended
(in thousands, except ounces, per share amounts and average realized price)

Revenue from mining operations

Year ended

Dec. 31, 2013

Dec. 31, 2012

$227,631

$163,622

Total gold ounces sold (excluding pre-production ounces)

160,913

94,422

Total gold ounces produced (excluding pre-production ounces)

161,100

100,284

Adjusted operating cash flow(2)

$78,079

$37,142

$0.31

$0.13

$(176,770)

$(99,779)

Net loss per share, basic

$(0.71)

$(0.35)

Adjusted net earnings(3)

$13,052

$16,903

$0.05

$0.06

$1,395

$1,690

Adjusted operating cash flow per share, basic(2)
Net loss

Adjusted net earnings per share, basic(3)
Average realized price per ounce
1.
2.
3.

Continuing operations include the Young-Davidson and El Chanate mine operations.
See the table on slide 18 for a reconciliation of adjusted operating cash flow and refer to the discussion of Non-GAAP measures in the Company’s 2013 Financial Results Press
Release.
See the table on slide 15 and 17 for a reconciliation of adjusted net earnings and refer to the discussion of Non-GAAP measures in the Company’s 2013 Financial Results Press
Release.

11

Continuing Operations Highlights(1)
YoungDavidson

El Chanate

Q4 2013

Q4 2012(2)

Gold ounces produced

29,597

16,420

46,017

34,018

Pre-production gold ounces produced

3,509

-

3,509

7,127

Total gold ounces produced

33,106

16,420

49,526

41,145

Gold ounces sold

24,831

15,024

39,855

36,137

Pre-production gold ounces sold

3,416

-

3,416

3,595

Total gold ounces sold

28,247

15,024

43,271

39,732

$850

$615

$771

$650

$31,420

$19,362

$50,782

$63,119

(in thousands, except ounces and total cash costs)

Cash costs per ounce, before NRV(3),(4),(5)
Revenue from mining operations
1.
2.

3.
4.
5.

Continuing operations include the Young-Davidson and El Chanate mine operations.
Certain comparative information has been restated as a result of the adoption of IFRIC 20, Stripping Costs in the Production Phase of a Surface Mine, which was applied prospectively
to production stripping costs incurred on or after January 1, 2012. For further details, refer to the Critical Accounting Estimates, Policies and Changes section on page 30 in the
Company’s Management’s Discussion & Analysis or note 3(a) to the Company's consolidated financial statements for the year ended December 31, 2013.
Cash costs for the El Chanate mine and Young-Davidson mine are calculated on a per gold ounce basis, using by-product revenues as a cost credit.
Gold ounces used to calculate cash costs include ounces sold at the El Chanate mine and ounces produced at the Young-Davidson mine.
The Young-Davidson open pit mine declared commercial production on September 1, 2012 and the Young-Davidson underground mine declared commercial production on October
31, 2013. Pre-production ounces produced and sold are excluded from the calculation of cash costs as they are credited against capitalized project costs.

12
Continuing Operations Highlights(1)
YoungDavidson

El Chanate

Year ended
Dec. 31/13

Year ended
Dec. 31/12(2)

Gold ounces produced

89,236

71,864

161,100

100,284

Pre-production gold ounces produced

31,502

-

31,502

26,999

Total gold ounces produced

120,738

71,864

192,602

127,283

Gold ounces sold

88,878

72,035

160,913

94,422

Pre-production gold ounces sold

31,839

-

31,839

17,505

Total gold ounces sold

120,717

72,035

192,752

111,927

$744

$592

$676

$536

$124,439

$103,192

$227,631

$163,222

(in thousands, except ounces and total cash costs)

Cash costs per ounce, before NRV(3),(4),(5)
Revenue from mining operations
1.
2.

3.
4.
5.

Continuing operations include the Young-Davidson and El Chanate mine operations.
Certain comparative information has been restated as a result of the adoption of IFRIC 20, Stripping Costs in the Production Phase of a Surface Mine, which was applied prospectively to
production stripping costs incurred on or after January 1, 2012. For further details, refer to the Critical Accounting Estimates, Policies and Changes section on page 30 in the Company’s
Management’s Discussion & Analysis or note 3(a) to the Company's consolidated financial statements for the year ended December 31, 2013.
Cash costs for the El Chanate mine and Young-Davidson mine are calculated on a per gold ounce basis, using by-product revenues as a cost credit.
Gold ounces used to calculate cash costs include ounces sold at the El Chanate mine and ounces produced at the Young-Davidson mine.
The Young-Davidson open pit mine declared commercial production on September 1, 2012 and the Young-Davidson underground mine declared commercial production on October 31,
2013. Pre-production ounces produced and sold are excluded from the calculation of cash costs as they are credited against capitalized project costs.

13

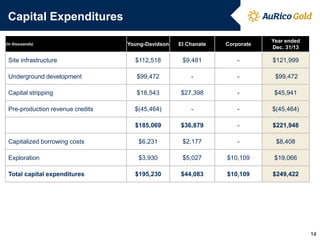

Capital Expenditures
Young-Davidson

El Chanate

Corporate

Year ended
Dec. 31/13

Site infrastructure

$112,518

$9,481

-

$121,999

Underground development

$99,472

-

-

$99,472

Capital stripping

$18,543

$27,398

-

$45,941

$(45,464)

-

-

$(45,464)

$185,069

$36,879

-

$221,948

Capitalized borrowing costs

$6,231

$2,177

-

$8,408

Exploration

$3,930

$5,027

$10,109

$19,066

$195,230

$44,083

$10,109

$249,422

(in thousands)

Pre-production revenue credits

Total capital expenditures

14

Adjusted Net Earnings Reconciliation
Quarter Ended
 (in thousands, except per share metrics)

Net loss from continuing operations
Adjustments:
Deferred income tax expense related to foreign exchange
Foreign exchange gain
Net realizable value adjustments on inventory
Impairment charges
(Gain) / loss on option component of convertible notes
Unrealized losses on investments
Unrealized loss on derivatives
Equity in loss / (earnings) of jointly-controlled entity
Unrealized loss on contingent consideration
Gain on disposition of 50% interest in Orion
Impact of new Mexican mining tax
Other (including tax effect of adjustments)
Adjusted net (loss) / earnings from continuing operations
Adjusted net (loss) / earnings from continuing operations, per share
Net loss from discontinued operations
Adjustments:
Unrealized foreign exchange gain
Loss on disposition of Australian operations
Net realizable value adjustment on Ocampo HL inventory
Impairment of Australian Operations
Disposition-related costs
Loss on disposition of El Cubo and GyC
Ocampo outside tax basis adjustment
Gain on disposition of Ocampo
Tax impact
Adjusted net earnings from discontinued operations
Adjusted net earnings from discontinued operations, per share
Adjusted net loss
Adjusted net loss, per share

Quarter Ended

Decem ber 31, 2013

Decem ber 31, 2012

($106,412)
$

$

($135,142)

19,781
(3,732)
37,196
59,886
(772)
2,533
483
4,917
(19,364)
($5,484)
(0.02)

629
(2,298)
127,000
6,186
17,778
210
(83)
3,569
(6,620)
2,276
$13,505
0.05

-

$108,977

-

(391)
7,778
6,796
2,277
(39,168)
(150,793)
80,101
$15,577
$0.06

($5,484)
($0.02)

$29,082
$0.10

15
Scott Perry
President & CEO

2014 Operational Guidance
►

Gold production increase of up to 25%, with continued annual growth over next 3 years

►

Operating costs are anticipated to decrease significantly as annual production increases

►

Up to 40% decrease in capital investment, with additional decreases going forward

2014 Operational Guidance Highlights
250

Growing Production

$250

Declining Capital Investments

$1,300

225

All-in Sustaining Costs

$1,200

200

175

US$ per ounce

$1,100
US$ (000’s)

Production Oz. (000’s)

$200

$150

$100

150

$1,000

$900

$50
125

$800

100

$700

$0
2013

2014E

2013

2014E

2013

2014E

17
Positioned For Value Creation
Politically-friendly jurisdiction
High quality asset base
Organic year over year production growth
Lower end of industry cost curve
Long mine life
Strong balance sheet
Pure gold leverage
Capital return to shareholders
18
Q&A

Adjusted Net Earnings Reconciliation
Year Ended

Net loss from continuing operations
Adjustments:
Deferred income tax expense / (recovery) related to foreign exchange
Foreign exchange (gain) / loss
Net realizable value adjustments on inventory
Impairment charges
Gain on option component of convertible notes
Unrealized loss on investments
Unrealized gain on derivatives
Equity in loss / (earnings) of jointly-controlled entity
Unrealized loss / (gain) on contingent consideration
Gain on disposition of 50% interest in Orion
Impact of new Mexican mining tax
Other (including tax effect of adjustments)
Adjusted net earnings from continuing operations
Adjusted net earnings from continuing operations, per share
Net earnings from discontinued operations
Adjustments:
Unrealized foreign exchange loss
Loss on disposition of Australian operations
Net realizable value adjustment on Ocampo HL inventory
Impairment of Australian Operations
Disposition-related costs
Gain on disposition of El Cubo and GyC
Ocampo outside tax basis adjustment
Gain on disposition of Ocampo
Tax impact
Adjusted net earnings from discontinued operations
Adjusted net earnings from discontinued operations, per share
Adjusted net earnings
Adjusted net earnings, per share

Year Ended

Decem ber 31, 2013

Decem ber 31, 2012

($176,770)

($99,779)

24,999
(10,927)
42,069
158,574
(15,622)
(2,183)
2,533
7,395
4,917
(21,933)
$13,052
$0.05

(15,785)
10,663
127,000
(4,046)
146
(1,713)
(83)
(1,568)
(6,620)
8,688
$16,903
0.06

-

$131,052

-

9,080
1,736
16,070
22,857
12,123
(21,785)
(150,793)
83,005
$103,345
$0.37

$13,052
$0.05

$120,248
$0.43

20

Adj. Operating Cash Flow Reconciliation

Quarter Ended
 (in thousands, except per share metrics)

Operating cash flow from continuing operations
Add back: Non-cash change in operating working capital
Operating cash flow (before changes in working
capital) from continuing operations
Operating cash flow (before changes in working
capital) from continuing operations, per share

Quarter Ended

Decem ber 31, 2013

Decem ber 31, 2012

$11,954
5,554
$17,508
$

($7,813)
38,239
$30,426

0.07

$

0.11

Year Ended
 (in thousands, except per share metrics)

Operating cash flow from continuing operations
Add back: Non-cash change in operating working capital
Operating cash flow (before changes in working
capital) from continuing operations
Operating cash flow (before changes in working
capital) from continuing operations, per share

Year Ended

Decem ber 31, 2013

Decem ber 31, 2012

$63,266
14,813
$78,079
$

0.31 $

($7,231)
$44,373
$37,142
0.13

21

Q4 2013 financial results webcast presentation final

  • 1.
    Q4 2013 Financial Results ConferenceCall and Webcast March 4, 2014 TSX: AUQ / NYSE: AUQ www.auricogold.com
  • 2.
    FORWARD LOOKING STATEMENTS Thispresentation contains forward-looking statements and forward-looking information as defined under Canadian and U.S. securities laws. All statements, other than statements of historical fact, are forward-looking statements. The words "expect", "believe", "anticipate", "will", "intend", "estimate", "forecast", "budget" and similar expressions identify forward-looking statements. Forward-looking statements include information as to strategy, plans or future financial or operating performance, such as the Company’s expansion plans, project timelines, production plans, projected cash flows or capital expenditures, cost estimates, projected exploration results, reserve and resource estimates and other statements that express management’s expectations or estimates of future performance. Forward-looking statements are necessarily based upon a number of factors and assumptions that, while considered reasonable by management, are inherently subject to significant uncertainties and contingencies. Known and unknown factors could cause actual results to differ materially from those projected in the forward-looking statements, including: uncertainty of production and cost estimates; fluctuations in the price of gold and foreign exchange rates; the uncertainty of replacing depleted reserves; the risk that the Young-Davidson shaft will not perform as planned; the risk that mining operations do not meet expectations; the risk that projects will not be developed accordingly to budgets or timelines, changes in laws in Canada, Mexico and other jurisdictions in which the Company may carry on business; risks of obtaining necessary licenses, permits or approvals for operations or projects such as Kemess; disputes over title to properties; the speculative nature of mineral exploration and development; risks related to aboriginal title claims; compliance risks with respect to current and future environmental regulations; disruptions affecting operations; opportunities that may be pursued by the Company; employee relations; availability and costs of mining inputs and labor; the ability to secure capital to execute business plans; volatility of the Company’s share price; continuation of the dividend and dividend reinvestment plan; the effect of future financings; litigation; risk of loss due to sabotage and civil disturbances; the values of assets and liabilities based on projected future cash flows; risks arising from derivative instruments or the absence of hedging; adequacy of internal control over financial reporting; changes in credit rating; and the impact of inflation. Actual results and developments are likely to differ, and may differ materially, from those expressed or implied by the forward-looking statements contained herein. Such statements are based on a number of assumptions which may prove to be incorrect, including assumptions about: business and economic conditions; commodity prices and the price of key inputs such as labour, fuel and electricity; credit market conditions and conditions in financial markets generally; revenue and cash flow estimates, production levels, development schedules and the associated costs; ability to procure equipment and supplies and on a timely basis; the timing of the receipt of permits and other approvals for projects and operations; the ability to attract and retain skilled employees and contractors for the operations; the accuracy of reserve and resource estimates; the impact of changes in currency exchange rates on costs and results; interest rates; taxation; and ongoing relations with employees and business partners. The Company disclaims any intention or obligation to update or revise any forward-looking statements whether as a result of new information, future events or otherwise, except as required by applicable law. Cautionary Note to U.S. Investors Concerning Measured, Indicated and Inferred Resources This presentation uses the terms "measured," "indicated" and "inferred” resources. We advise investors that while those terms are recognized and required by Canadian regulations, the United States Securities and Exchange Commission does not recognize them. “Inferred” resources” have a great amount of uncertainty as to their existence and as to their economic and legal feasibility. It cannot be assumed that all or any part of an inferred resource will ever be upgraded to a higher category. Under Canadian rules, estimates of inferred mineral resources may not form the basis of feasibility or other economic studies. United States investors are cautioned not to assume that all or any part of measured or indicated mineral resources will ever be converted into mineral reserves. United States investors are also cautioned not to assume that all or any part of an inferred mineral resource exists, or is economically or legally mineable. 2
  • 3.
  • 4.
    Corporate Update Total GoldOunces Produced ► >1.5MM man hours lost time incident free at both operations ► 120,738 140,000 to 160,000 2013 Sixth quarter of company-wide production growth, Q1 well positioned to be the seventh quarter ► Young-Davidson Mine1 2014E 2013 Reserves and Resources reported 29,139 2012 ► ► Gold price assumption reduced to $1,250/oz El Chanate Mine1 Fourth quarter dividend paid (Jan. 29) 71,145 71,864 2012 2013 67,092 ► Cost containment initiatives completed ► 70,000 to 80,000 Assessing a number of shareholder friendly, nondilutive liquidity financing options 2011 1. 2014E Production figures include gold ounces only. Production at the Young-Davidson mine includes pre-production ounces, which include ounces produced prior to the declaration of commercial production on September 1, 2012, and ounces produced from the underground mine prior to the declaration of commercial production on October 31, 2013. 4
  • 5.
    Sixth Quarter ofRecord Gold Production Young-Davidson Sixth Consecutive Quarter of Record Gold Production El Chanate 46,170 50,000 48,003 48,903 49,526 Q2 13 Q3 13 Q4 13 Gold Ounces Produced 41,145 40,000 37,213 30,000 20,000 10,000 0 Q3 12 Q4 12 Q1 13 Q1 14E 2013 Operational Results First Quarter March 31/13 Gold Ounces Produced3 Total Cash Costs per oz.1,2 All-in Sustaining Costs per oz.2 1. 2. 3. Second Quarter June 30/13 Third Quarter Sept. 30/13 Fourth Quarter Dec. 31/13 Year-End Dec. 31/13 46,170 48,003 48,903 49,526 192,602 $635 $655 $628 $771 $676 $1,090 $1,189 $1,210 $1,232 $1,181 Prior to commissioning the underground mine at Young-Davidson, cash costs were calculated on ounces produced from the open pit only. All underground costs were capitalized, and any revenue related to underground ounces sold was credited against capital. Subsequent to the declaration of commercial production in the underground mine, cash costs are calculated on ounces produced from both the open pit and underground mines, and revenue related to the sale of underground ounces is recognized in the Company's Statement of Operations as revenue. Cash costs, prior to inventory net realizable value adjustments. See the Non-GAAP Measures section on page 23 of the Management’s Discussion and Analysis for the year ended December 31, 2013. Includes pre-production gold ounces from the Young-Davidson underground mine prior to the declaration of commercial production on October 31, 2013. 5
  • 6.
    Young-Davidson Update Mid-shaft loadingproject commissioned ► Q4 underground productivity of approx. 2,600tpd ► Productivity ramp-up from 2,500tpd to 4,000tpd at year-end (target of 8,000tpd at end of 2016) Paste Backfill Plant Commissioned ► First paste pour in January 2014 In-line underground unit mining costs ► $39/t in November and December, 2013 ► $45/t in Q1/14 with inclusion of paste fill, decreasing throughout the year with increased productivity Underground Mine Development Advance ► 75% of 2014 mine plan is laterally accessed Lower mine vertical development underway ► Will provide access to 20 years of strategic mine life Mill facility permit increased to 10,000tpd 6
  • 7.
    El Chanate ExplorationPotential Significant potential to extend mine life Hole ID CHCI-760 CHCI-761 CHCI-766 CHCI-821 Rono(6) Length (m) 18.0 42.0 51.0 7.5 19.5 Grade Au g/t 0.88 0.50 0.33 0.74 0.93 Hole ID CHCI-775 CHCI-776 CHCI-799 CHCI-836 Chanate Deeps(6) Length (m) 54.0 48.0 6.0 24.0 Grade Au g/t 2.56 2.90 7.60 2.70 NW Extension(6) Hole ID CHCI-769 CHCI-800 Length (m) 37.5 28.5 Grade Au g/t 0.94 0.67 Hole ID CHCI-815 CHCI-817 CHCI-818 CHCI-829 Loma Prieta(6) Length (m) 19.5 9.0 9.0 6.0 Grade Au g/t 0.78 1.37 0.58 1.18 Fieldwork initiated on the additional 15-20kms of land acquired northwest and southeast along trend 7
  • 8.
    Reserve Highlights Gold priceassumption at operations reduced to $1,250 per ounce ► Improves quality of reserve base for low-cost, long-life ounces Proven and Probable gold reserves of 6.5 million gold ounces ► Primarily impacted by depletion from the El Chanate and Young-Davidson open pits ► Young-Davidson open pit fully depleted in Q2 2014 Young-Davidson underground reserves increased by 1% to 3.6 million gold ounces ► Underground grades of 2.81 g/t is consistent with 2012 ► Significant conversion of underground Inferred Resources to M&I Resources El Chanate reserves decreased by 15% to 1.0 million gold ounces ► Reduction primarily related to production depletion ► Reserve grades increased by 5% to 0.70 g/t 8
  • 9.
    Rob Chausse Chief FinancialOfficer Conference Call and Webcast March 4, 2014
  • 10.
    Continuing Operations Highlights(1) QuarterEnded (in thousands, except ounces , per share amounts and average realized price) Revenue from mining operations Quarter Ended Dec. 31, 2013 Dec. 31, 2012 $50,782 $63,119 Total gold ounces sold (excluding pre-production ounces) 39,855 36,137 Total gold ounces produced (excluding pre-production ounces) 46,017 34,018 $17,508 $30,426 $0.07 $0.11 $(106,412) $(135,142) $(0.43) $(0.48) $(5,484) $13,052 Adjusted net (loss) / earnings per share, basic(3) $(0.02) $0.05 Average realized price per ounce $1,257 $1,720 Adjusted operating cash flow(2) Adjusted operating cash flow per share, basic(2) Net loss Net loss per share, basic Adjusted net (loss) / earnings(3) 1. 2. 3. Continuing operations include the Young-Davidson and El Chanate mine operations. See the table on slide 18 for a reconciliation of adjusted operating cash flow and refer to the discussion of Non-GAAP measures in the Company’s 2013 Financial Results Press Release. See the table on slide 15 and 17 for a reconciliation of adjusted net earnings and refer to the discussion of Non-GAAP measures in the Company’s 2013 Financial Results Press Release. 10
  • 11.
    Continuing Operations Highlights(1) Yearended (in thousands, except ounces, per share amounts and average realized price) Revenue from mining operations Year ended Dec. 31, 2013 Dec. 31, 2012 $227,631 $163,622 Total gold ounces sold (excluding pre-production ounces) 160,913 94,422 Total gold ounces produced (excluding pre-production ounces) 161,100 100,284 Adjusted operating cash flow(2) $78,079 $37,142 $0.31 $0.13 $(176,770) $(99,779) Net loss per share, basic $(0.71) $(0.35) Adjusted net earnings(3) $13,052 $16,903 $0.05 $0.06 $1,395 $1,690 Adjusted operating cash flow per share, basic(2) Net loss Adjusted net earnings per share, basic(3) Average realized price per ounce 1. 2. 3. Continuing operations include the Young-Davidson and El Chanate mine operations. See the table on slide 18 for a reconciliation of adjusted operating cash flow and refer to the discussion of Non-GAAP measures in the Company’s 2013 Financial Results Press Release. See the table on slide 15 and 17 for a reconciliation of adjusted net earnings and refer to the discussion of Non-GAAP measures in the Company’s 2013 Financial Results Press Release. 11
  • 12.
    Continuing Operations Highlights(1) YoungDavidson ElChanate Q4 2013 Q4 2012(2) Gold ounces produced 29,597 16,420 46,017 34,018 Pre-production gold ounces produced 3,509 - 3,509 7,127 Total gold ounces produced 33,106 16,420 49,526 41,145 Gold ounces sold 24,831 15,024 39,855 36,137 Pre-production gold ounces sold 3,416 - 3,416 3,595 Total gold ounces sold 28,247 15,024 43,271 39,732 $850 $615 $771 $650 $31,420 $19,362 $50,782 $63,119 (in thousands, except ounces and total cash costs) Cash costs per ounce, before NRV(3),(4),(5) Revenue from mining operations 1. 2. 3. 4. 5. Continuing operations include the Young-Davidson and El Chanate mine operations. Certain comparative information has been restated as a result of the adoption of IFRIC 20, Stripping Costs in the Production Phase of a Surface Mine, which was applied prospectively to production stripping costs incurred on or after January 1, 2012. For further details, refer to the Critical Accounting Estimates, Policies and Changes section on page 30 in the Company’s Management’s Discussion & Analysis or note 3(a) to the Company's consolidated financial statements for the year ended December 31, 2013. Cash costs for the El Chanate mine and Young-Davidson mine are calculated on a per gold ounce basis, using by-product revenues as a cost credit. Gold ounces used to calculate cash costs include ounces sold at the El Chanate mine and ounces produced at the Young-Davidson mine. The Young-Davidson open pit mine declared commercial production on September 1, 2012 and the Young-Davidson underground mine declared commercial production on October 31, 2013. Pre-production ounces produced and sold are excluded from the calculation of cash costs as they are credited against capitalized project costs. 12
  • 13.
    Continuing Operations Highlights(1) YoungDavidson ElChanate Year ended Dec. 31/13 Year ended Dec. 31/12(2) Gold ounces produced 89,236 71,864 161,100 100,284 Pre-production gold ounces produced 31,502 - 31,502 26,999 Total gold ounces produced 120,738 71,864 192,602 127,283 Gold ounces sold 88,878 72,035 160,913 94,422 Pre-production gold ounces sold 31,839 - 31,839 17,505 Total gold ounces sold 120,717 72,035 192,752 111,927 $744 $592 $676 $536 $124,439 $103,192 $227,631 $163,222 (in thousands, except ounces and total cash costs) Cash costs per ounce, before NRV(3),(4),(5) Revenue from mining operations 1. 2. 3. 4. 5. Continuing operations include the Young-Davidson and El Chanate mine operations. Certain comparative information has been restated as a result of the adoption of IFRIC 20, Stripping Costs in the Production Phase of a Surface Mine, which was applied prospectively to production stripping costs incurred on or after January 1, 2012. For further details, refer to the Critical Accounting Estimates, Policies and Changes section on page 30 in the Company’s Management’s Discussion & Analysis or note 3(a) to the Company's consolidated financial statements for the year ended December 31, 2013. Cash costs for the El Chanate mine and Young-Davidson mine are calculated on a per gold ounce basis, using by-product revenues as a cost credit. Gold ounces used to calculate cash costs include ounces sold at the El Chanate mine and ounces produced at the Young-Davidson mine. The Young-Davidson open pit mine declared commercial production on September 1, 2012 and the Young-Davidson underground mine declared commercial production on October 31, 2013. Pre-production ounces produced and sold are excluded from the calculation of cash costs as they are credited against capitalized project costs. 13
  • 14.
    Capital Expenditures Young-Davidson El Chanate Corporate Yearended Dec. 31/13 Site infrastructure $112,518 $9,481 - $121,999 Underground development $99,472 - - $99,472 Capital stripping $18,543 $27,398 - $45,941 $(45,464) - - $(45,464) $185,069 $36,879 - $221,948 Capitalized borrowing costs $6,231 $2,177 - $8,408 Exploration $3,930 $5,027 $10,109 $19,066 $195,230 $44,083 $10,109 $249,422 (in thousands) Pre-production revenue credits Total capital expenditures 14
  • 15.
    Adjusted Net EarningsReconciliation Quarter Ended  (in thousands, except per share metrics) Net loss from continuing operations Adjustments: Deferred income tax expense related to foreign exchange Foreign exchange gain Net realizable value adjustments on inventory Impairment charges (Gain) / loss on option component of convertible notes Unrealized losses on investments Unrealized loss on derivatives Equity in loss / (earnings) of jointly-controlled entity Unrealized loss on contingent consideration Gain on disposition of 50% interest in Orion Impact of new Mexican mining tax Other (including tax effect of adjustments) Adjusted net (loss) / earnings from continuing operations Adjusted net (loss) / earnings from continuing operations, per share Net loss from discontinued operations Adjustments: Unrealized foreign exchange gain Loss on disposition of Australian operations Net realizable value adjustment on Ocampo HL inventory Impairment of Australian Operations Disposition-related costs Loss on disposition of El Cubo and GyC Ocampo outside tax basis adjustment Gain on disposition of Ocampo Tax impact Adjusted net earnings from discontinued operations Adjusted net earnings from discontinued operations, per share Adjusted net loss Adjusted net loss, per share Quarter Ended Decem ber 31, 2013 Decem ber 31, 2012 ($106,412) $ $ ($135,142) 19,781 (3,732) 37,196 59,886 (772) 2,533 483 4,917 (19,364) ($5,484) (0.02) 629 (2,298) 127,000 6,186 17,778 210 (83) 3,569 (6,620) 2,276 $13,505 0.05 - $108,977 - (391) 7,778 6,796 2,277 (39,168) (150,793) 80,101 $15,577 $0.06 ($5,484) ($0.02) $29,082 $0.10 15
  • 16.
  • 17.
    2014 Operational Guidance ► Goldproduction increase of up to 25%, with continued annual growth over next 3 years ► Operating costs are anticipated to decrease significantly as annual production increases ► Up to 40% decrease in capital investment, with additional decreases going forward 2014 Operational Guidance Highlights 250 Growing Production $250 Declining Capital Investments $1,300 225 All-in Sustaining Costs $1,200 200 175 US$ per ounce $1,100 US$ (000’s) Production Oz. (000’s) $200 $150 $100 150 $1,000 $900 $50 125 $800 100 $700 $0 2013 2014E 2013 2014E 2013 2014E 17
  • 18.
    Positioned For ValueCreation Politically-friendly jurisdiction High quality asset base Organic year over year production growth Lower end of industry cost curve Long mine life Strong balance sheet Pure gold leverage Capital return to shareholders 18
  • 19.
  • 20.
    Adjusted Net EarningsReconciliation Year Ended Net loss from continuing operations Adjustments: Deferred income tax expense / (recovery) related to foreign exchange Foreign exchange (gain) / loss Net realizable value adjustments on inventory Impairment charges Gain on option component of convertible notes Unrealized loss on investments Unrealized gain on derivatives Equity in loss / (earnings) of jointly-controlled entity Unrealized loss / (gain) on contingent consideration Gain on disposition of 50% interest in Orion Impact of new Mexican mining tax Other (including tax effect of adjustments) Adjusted net earnings from continuing operations Adjusted net earnings from continuing operations, per share Net earnings from discontinued operations Adjustments: Unrealized foreign exchange loss Loss on disposition of Australian operations Net realizable value adjustment on Ocampo HL inventory Impairment of Australian Operations Disposition-related costs Gain on disposition of El Cubo and GyC Ocampo outside tax basis adjustment Gain on disposition of Ocampo Tax impact Adjusted net earnings from discontinued operations Adjusted net earnings from discontinued operations, per share Adjusted net earnings Adjusted net earnings, per share Year Ended Decem ber 31, 2013 Decem ber 31, 2012 ($176,770) ($99,779) 24,999 (10,927) 42,069 158,574 (15,622) (2,183) 2,533 7,395 4,917 (21,933) $13,052 $0.05 (15,785) 10,663 127,000 (4,046) 146 (1,713) (83) (1,568) (6,620) 8,688 $16,903 0.06 - $131,052 - 9,080 1,736 16,070 22,857 12,123 (21,785) (150,793) 83,005 $103,345 $0.37 $13,052 $0.05 $120,248 $0.43 20
  • 21.
    Adj. Operating CashFlow Reconciliation Quarter Ended  (in thousands, except per share metrics) Operating cash flow from continuing operations Add back: Non-cash change in operating working capital Operating cash flow (before changes in working capital) from continuing operations Operating cash flow (before changes in working capital) from continuing operations, per share Quarter Ended Decem ber 31, 2013 Decem ber 31, 2012 $11,954 5,554 $17,508 $ ($7,813) 38,239 $30,426 0.07 $ 0.11 Year Ended  (in thousands, except per share metrics) Operating cash flow from continuing operations Add back: Non-cash change in operating working capital Operating cash flow (before changes in working capital) from continuing operations Operating cash flow (before changes in working capital) from continuing operations, per share Year Ended Decem ber 31, 2013 Decem ber 31, 2012 $63,266 14,813 $78,079 $ 0.31 $ ($7,231) $44,373 $37,142 0.13 21
