The document discusses several project evaluation techniques:

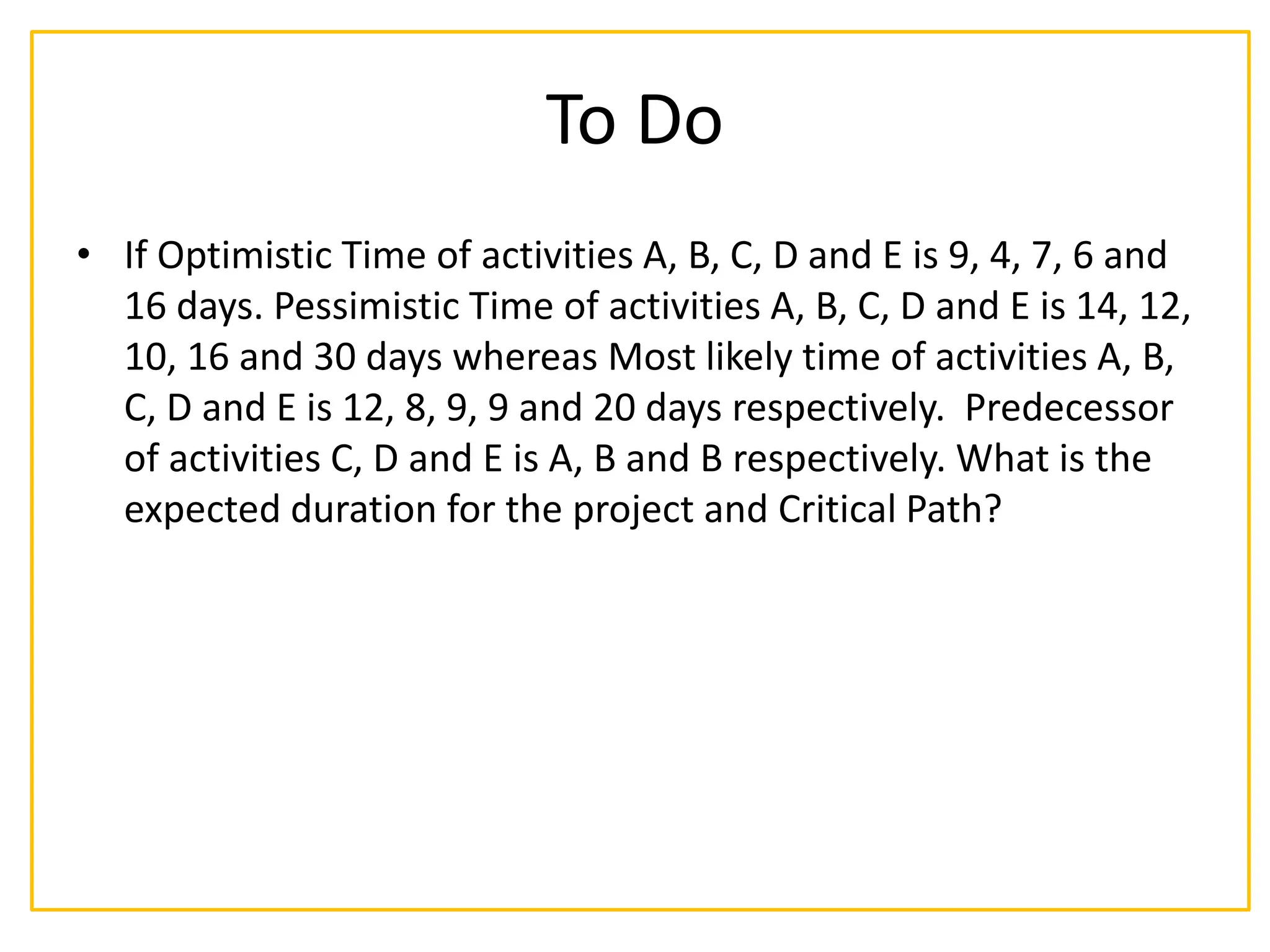

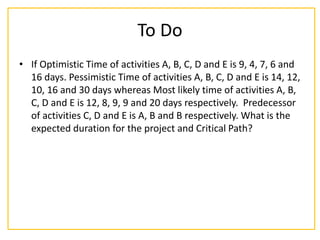

1) It provides an example project with activities A through E and asks to calculate the expected project duration and identify the critical path using optimistic, pessimistic, and most likely times.

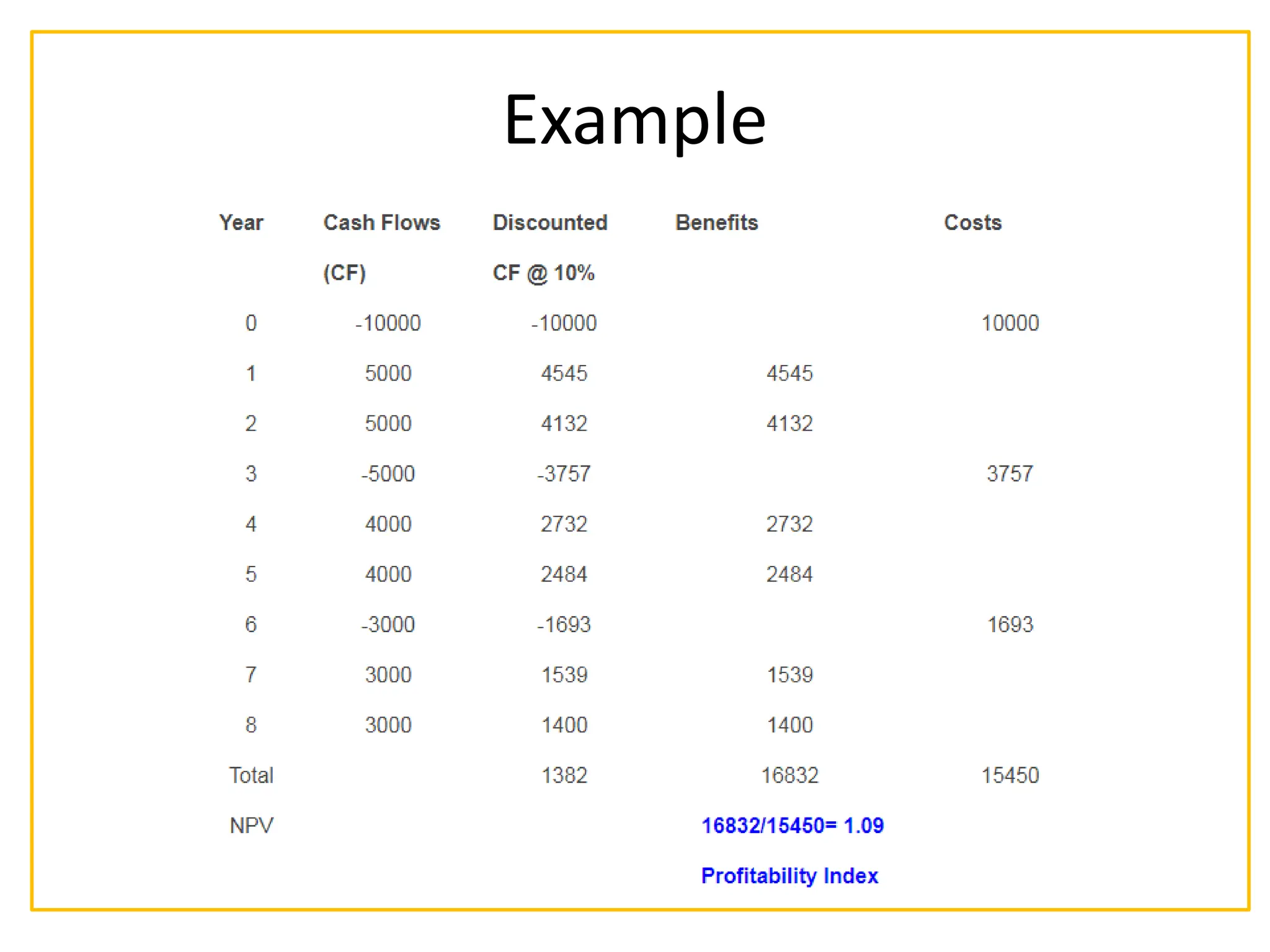

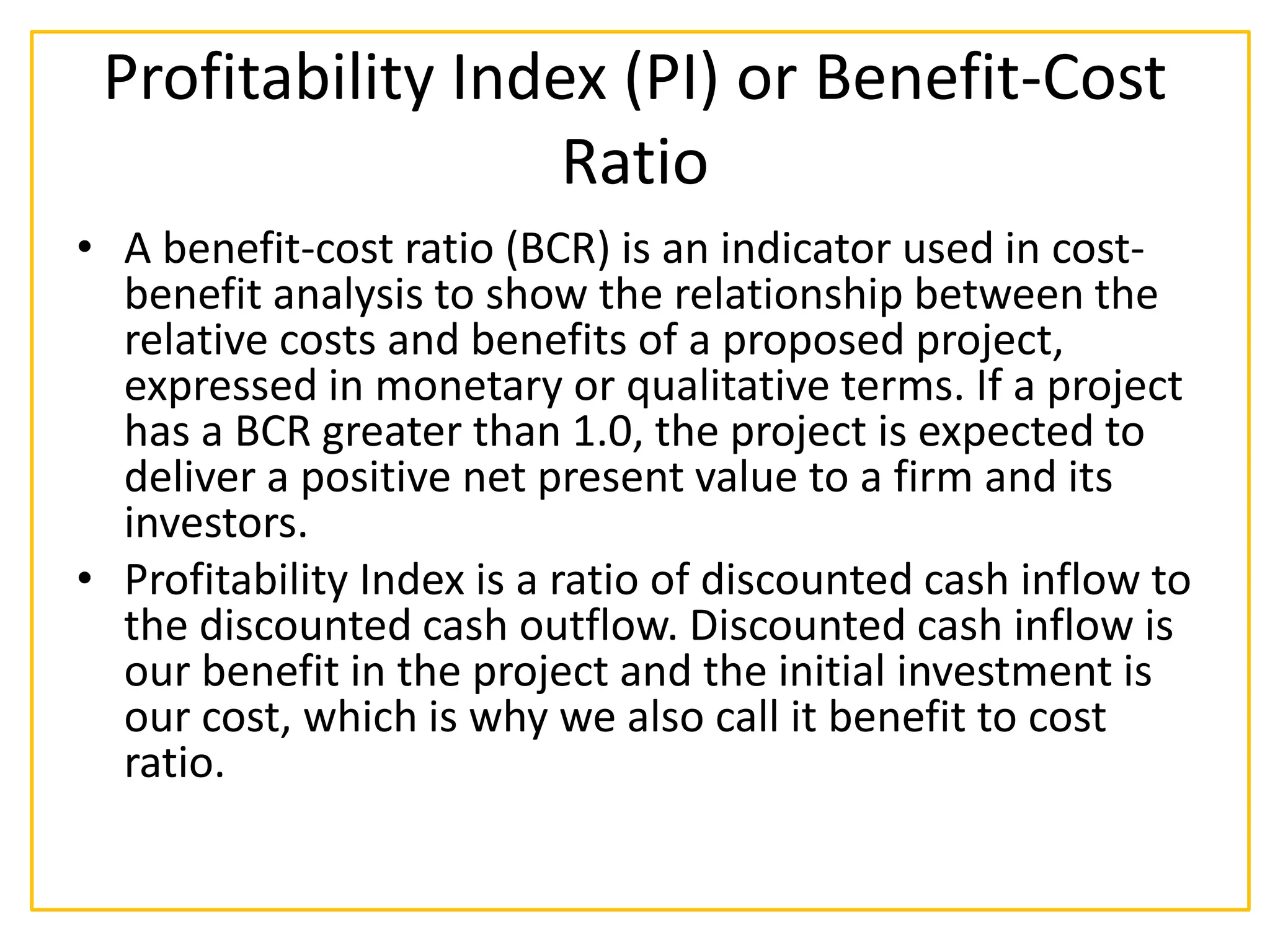

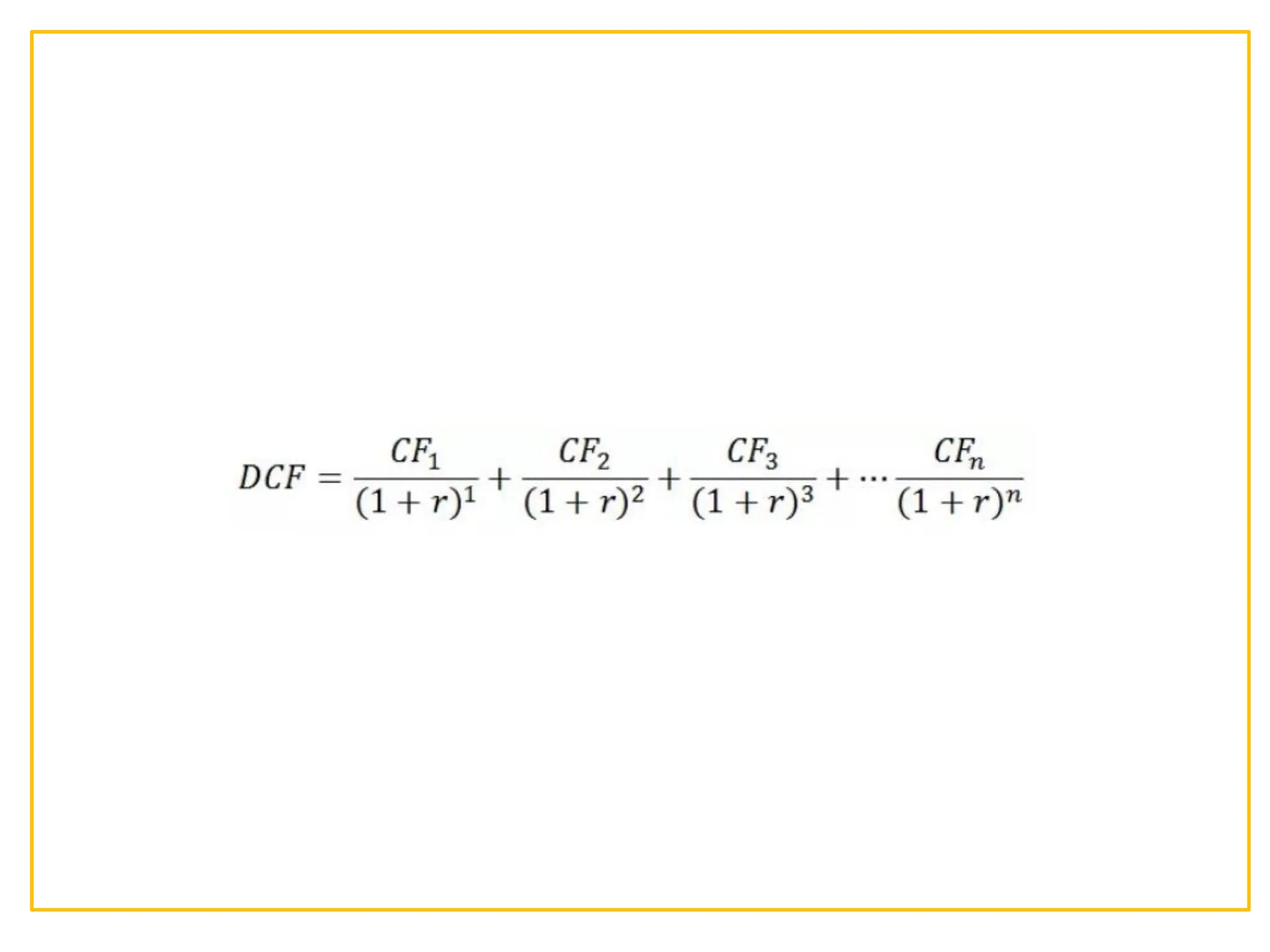

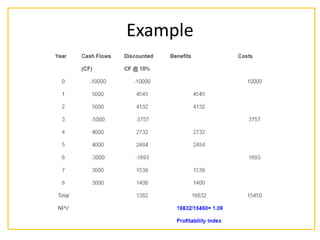

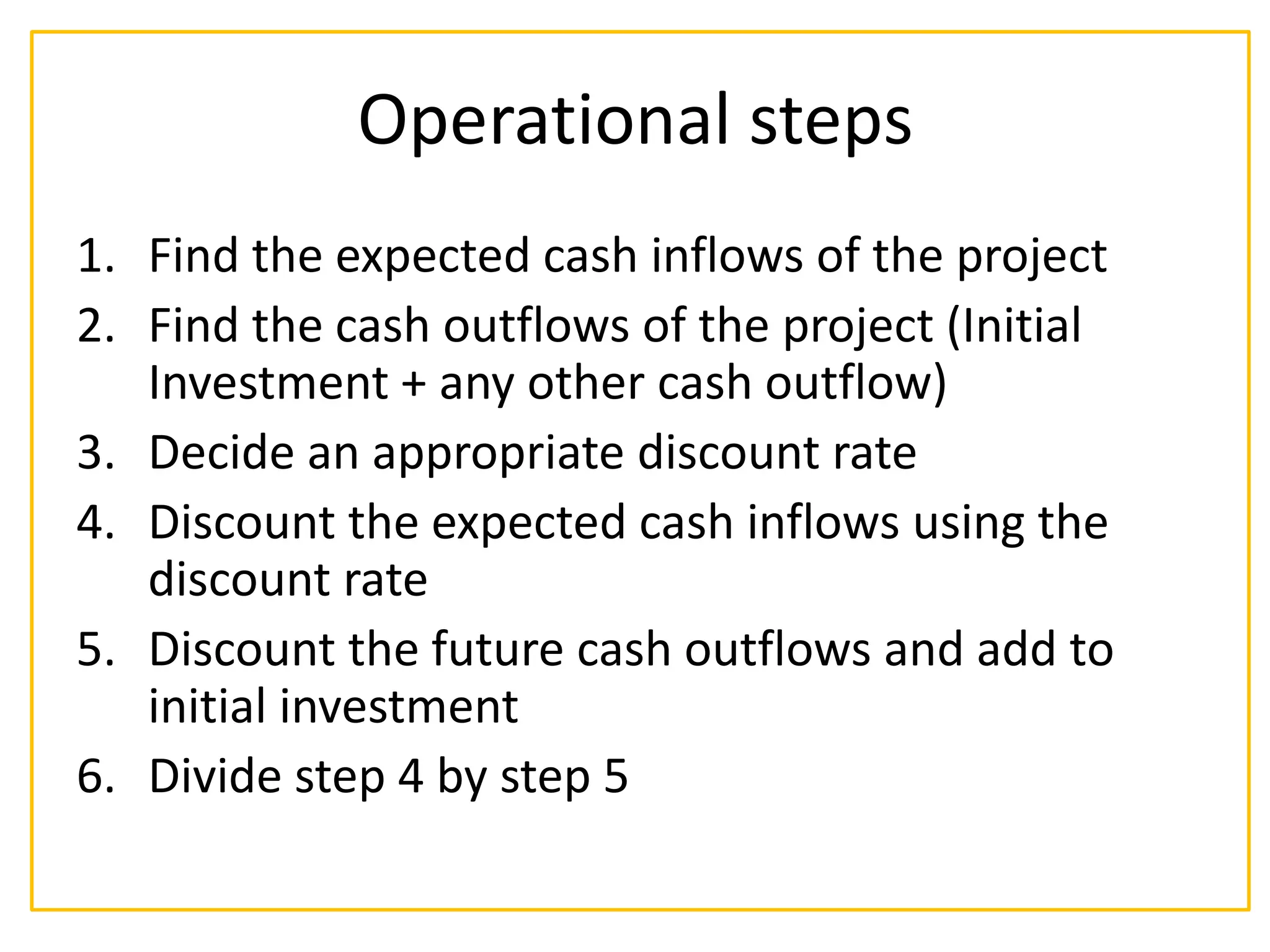

2) It defines profitability index (PI) or benefit-cost ratio as a metric used in cost-benefit analysis where a ratio above 1 indicates positive net present value. It provides steps to calculate PI by discounting cash inflows and outflows.

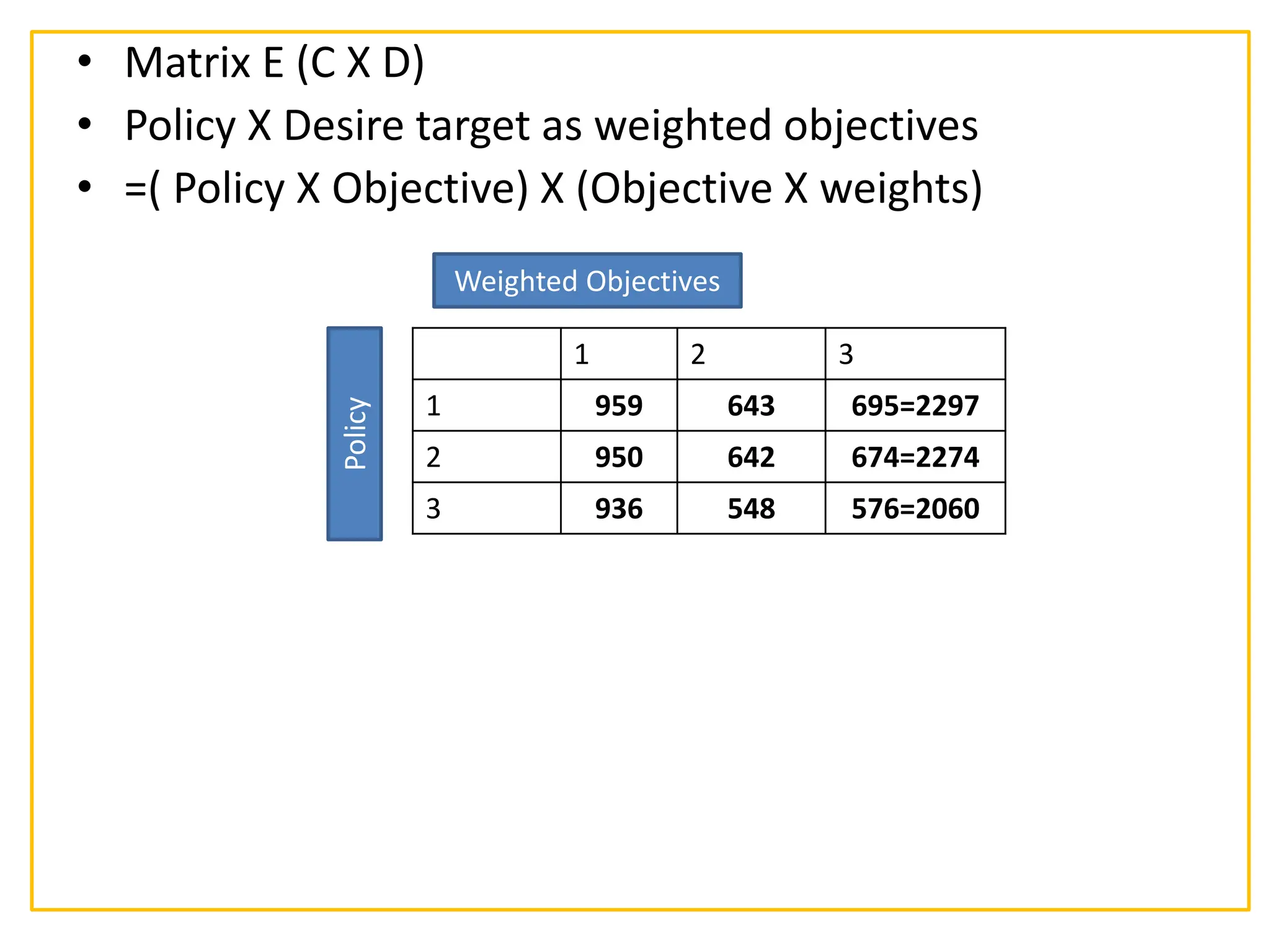

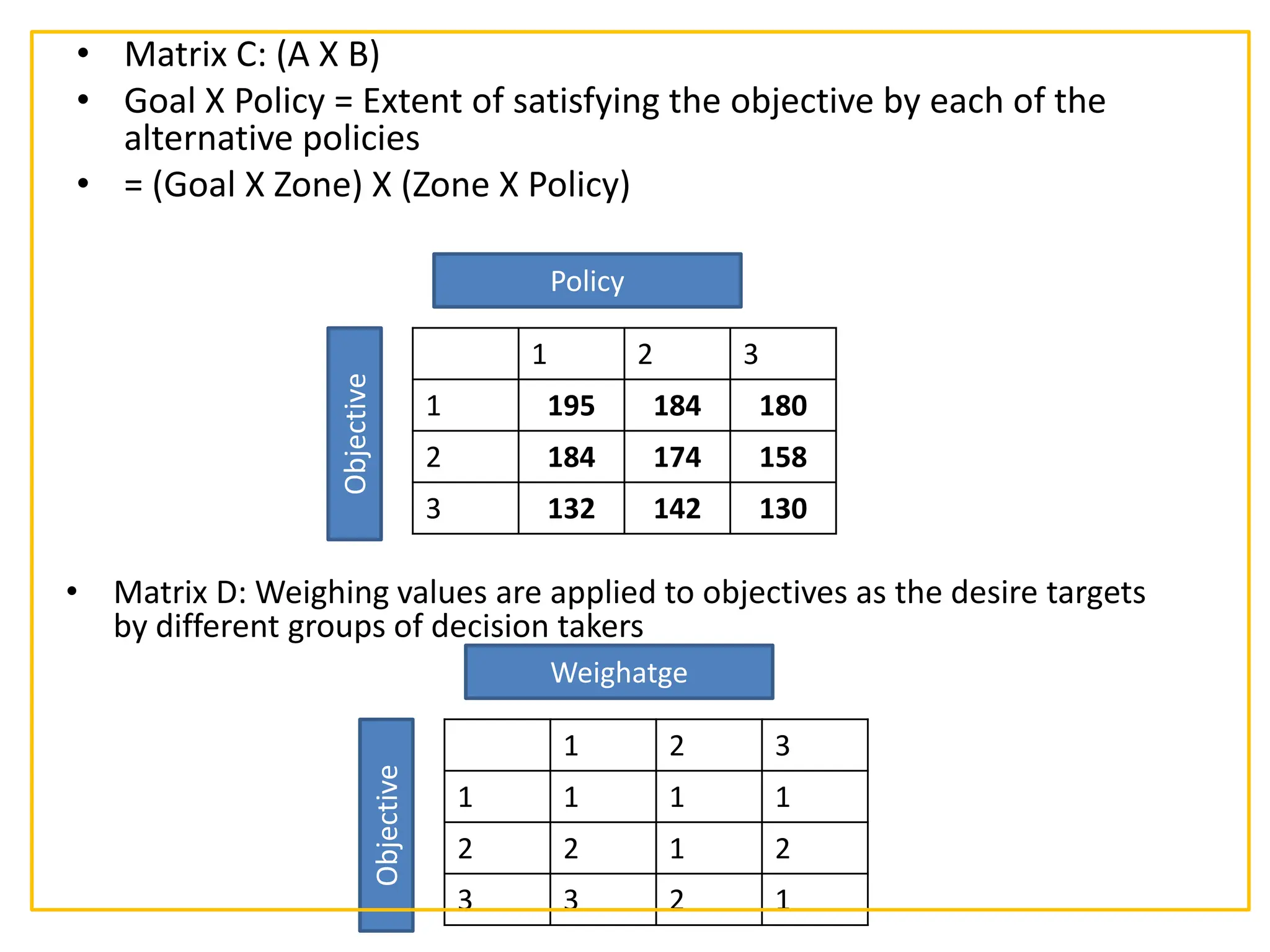

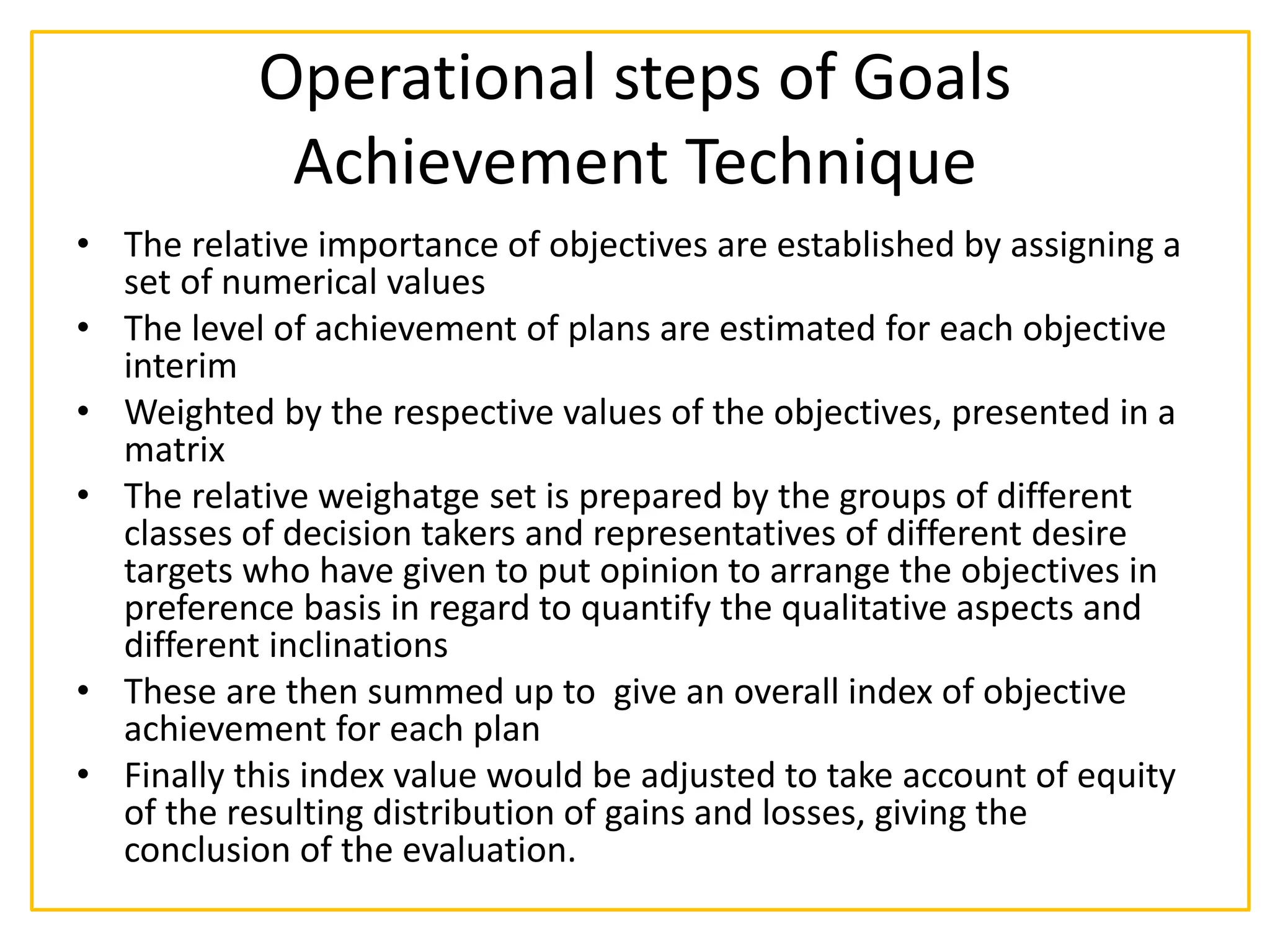

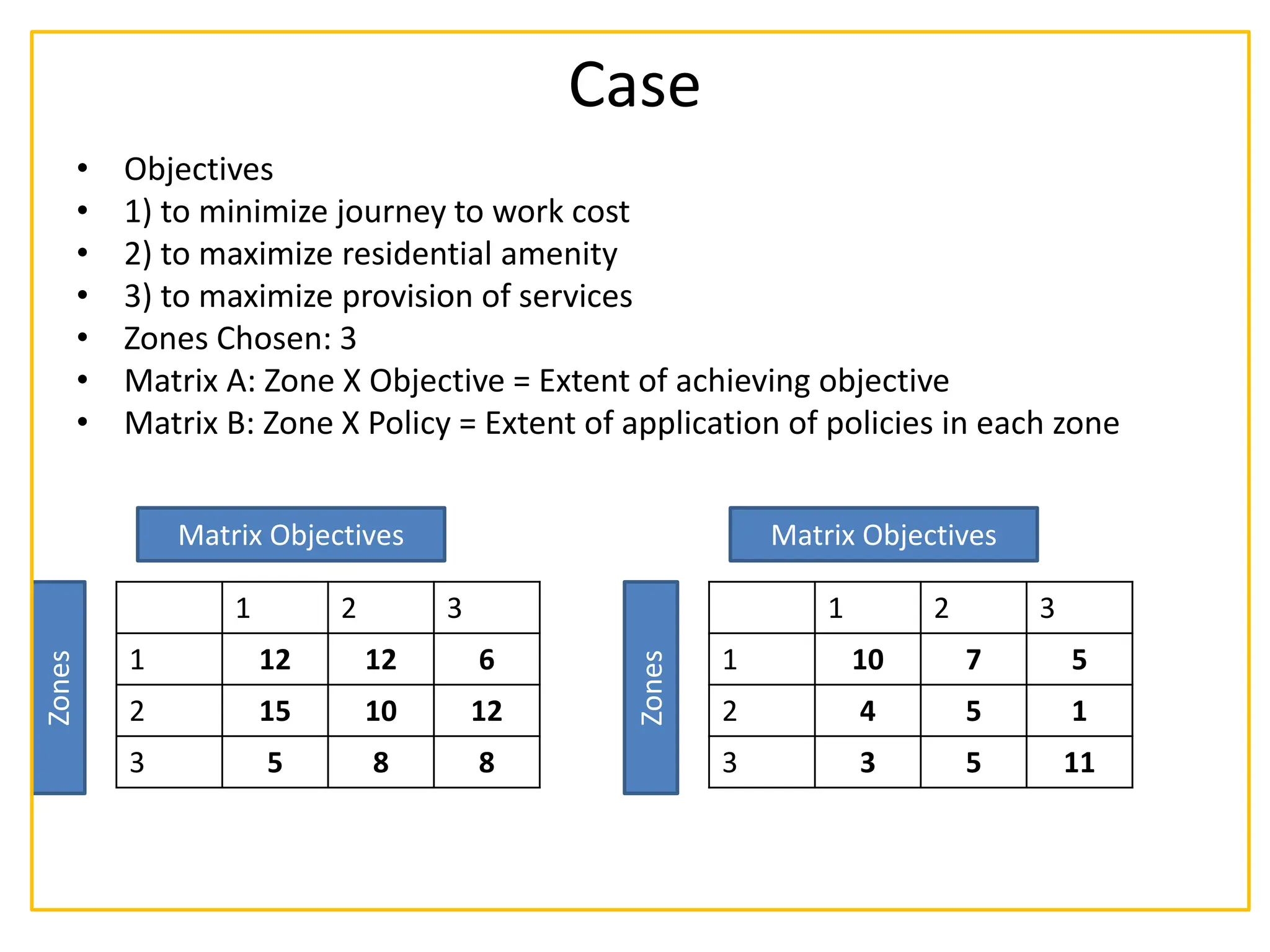

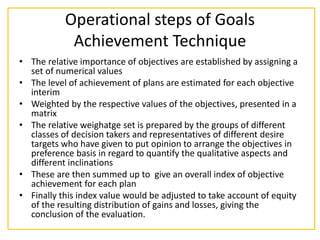

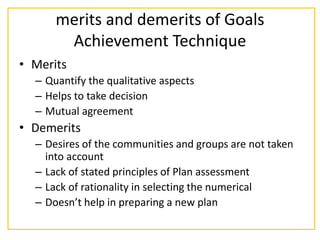

3) It outlines the goals achievement technique for evaluating alternative plans based on scoring how well each plan achieves predetermined objectives and applying weighting to objectives. An example case is provided to illustrate this method.
