1

OPENERP VERSION 6 TRAINING
USING HUMAN RESOURCE
MANAGEMENT MODULE
Dr. M Masoom Alam              Dr. Amir Hayat
Associate Professor           Assistant Professor
     IMSciences                      SEECS
                 Mohsin Yasin
                System Analyst
                  IMSciences
Outline
2

   Why Enterprise Resource Planning Systems – Part I
   Introduction to Open Source technologies – Part II
   OpenERP Introduction – Part III
   OpenERP VS Other Open Source ERPs – Part IV
   OpenERP evaluation with SAP as a reference – Part V
   Conclusion
Outline
3

   Why Enterprise Resource Planning Systems – Part I
   Introduction to Open Source technologies – Part II
   OpenERP Introduction – Part III
   OpenERP VS Other Open Source ERPs – Part IV
   OpenERP Evaluation with SAP as a reference – Part V
   Conclusion
Enterprise Resource Planning Systems
4

   Enterprise resource planning (ERP) systems automate and
    integrate various with an integrated software application.
     activities
               = Finance/Accounting, Sales&Service, Customer
      Relationship Management, etc.
   The concept was born in Early 1960s
   In 1972 “Systems Applications Products in data
    processing”
   In 1976 Company name changed to “SAP GmBH”
     SAP R/1 in 1973
     SAP R/2 in 1979
     SAP R/3 in 1992
                                   Source: http://en.wikipedia.org/wiki/Enterprise_resource_planning
An Enterprise Landscape (without ERP)
5

                  Sales   Human resources          Engineering
                                                   Design

    Inventory                                                         Production
                                                                      Planning

    Finance                                                                Controlling
                          Quality             Maintenance
                legal          Source: http://gyansangam.iiita.ac.in/content/cluster_2_1/ERP.ppt
Categories Of Information Systems
 6

• Operational - level systems:
   Support operational managers
   keep track of the elementary
   activities and transactions.

• Management-level systems:
   Serve the monitoring, controlling,
   decision-making, and administrative
   activities

• Strategic-level systems:
   Help senior management tackle and
   address strategic issues.

                                Figure Source: http://gyansangam.iiita.ac.in/content/cluster_2_1/ERP.ppt
Four Major Types of Information
    Systems
7

• Transaction Processing Systems
  (TPS):
    Business level systems that serves the
    Operational level.
• Management Information Systems
  (MIS):
    Provides feedback on daily
    operations.
• Decision-Support Systems (DSS):
    Provides managers with information
    and support for effective decision
    making
• Executive Support Systems (ESS):
    Designed for the CEO of the
    company

                                       Figure Source: http://gyansangam.iiita.ac.in/content/cluster_2_1/ERP.ppt

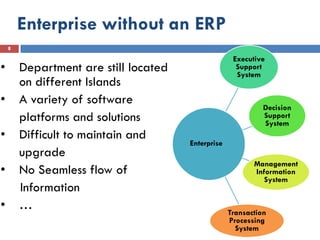

Enterprise without an ERP
    8

                                                     Executive
•       Department are still located                  Support
                                                      System
        on different Islands
•       A variety of software
                                                              Decision
        platforms and solutions                               Support
                                                              System
•       Difficult to maintain and
                                       Enterprise
        upgrade
                                                           Management
•       No Seamless flow of                                Information
                                                              System
        Information
•       …                                           Transaction
                                                    Processing
                                                      System
What is a Business Process
9

    • According to Wikipedia:

     “A business process or business method is a
     collection of related, structured activities in
     different functional areas of an organization
     that produce a specific service or product
     (serve a particular goal) for a particular
     customer or customers.”

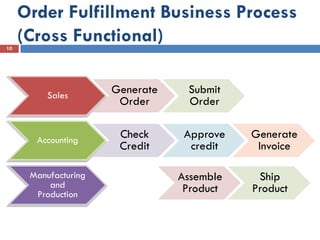

Order Fulfillment Business Process
10
     (Cross Functional)

          Sales
                      Generate    Submit
                       Order      Order

       Accounting
                       Check      Approve   Generate
                       Credit      credit    Invoice

      Manufacturing              Assemble    Ship
          and                     Product   Product
       Production
Enterprise Systems
11

• Enterprise Systems, are
  software solutions that
  focuses the Enterprise
  needs by taking a process
  view of the overall
  Enterprise to meet the
  goals by tightly
  integrating all functional
  areas and under a
  common platform.
• SAP, Oracle Applications,
  PeopleSoft, JD Edwards,
  NetSuite etc., are the
  world leading ERP
  Packages.
     Figure Source: http://gyansangam.iiita.ac.in/content/cluster_2_1/ERP.ppt
Advantages of an ERP System
12

     • Seamless flow of information among all functions of
     an enterprise in a real time.
     • One integrated system replaces many different
     software .
     • Reliable information access through a common
     DBMS
     • Improves the Business Processes: Eliminates data
     and operational redundancies (no duplication of work
     or data entries etc.)
Outline
13

    Why Enterprise Resource Planning Systems – Part I
    Introduction to Open Source technologies – Part II
    OpenERP Introduction – Part III
    OpenERP VS Other Open Source ERPs – Part IV
    OpenERP Evaluation with SAP as a reference – Part V
    Conclusion
Introduction
14

        In 1983 Richard Stallman started GNU project to launch a
         complete Operation System free from constraints.
        In 1989, first version of GNU public license was published.
        The Linux kernel, started by Linus Torvalds, was released as
         freely modifiable source code in 1991
        Recently, viable open source ERP alternatives have begun to
         appear
        OpenERP is one of these new kind of ERP systems
Open Source Products at a Glance…
15

        Programming Languages: LISP, C, C++,Perl, Python,Java, PHP,Ruby, ...

        Computer Operating systems: Linux, freeBSD, …

        Database Management System: PostgreSQL, MySQL, SQLite, …

        Web Servers/Services infrastructure: Apache, Bind, Postfix, …

        Content Management System: JOOMLA, Drupal, Wordpress, Alfresco, …

        Application Server Infrastructure (Middleware): JBoss, Spring, Rails,
         OpenObject, …

        Mobile Operating Systems: Android, Memo

        All Credit Goes to World Wide Web!
Open source powers the web
16

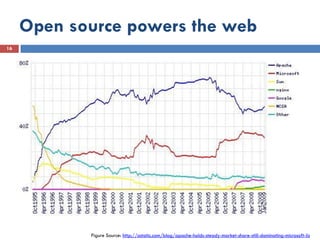

            Figure Source: http://ostatic.com/blog/apache-holds-steady-market-share-still-dominating-microsoft-iis
Software Development Process for
Open Source
17

        Across the globe community of developers working together to
         improve the software
        Distributed Versioning System (SVN, CVS, Bazar)
        Not only from different countries but also from companies
        “Many eyes make all bugs shallow”
             That’s Why viruses does not create problems for Linux or Ubuntu
         Is only suitable for top talent
         More visibility & Freedom
         More efficient process, avoid duplication of efforts
        “Disadvantage”
         New business models are needed to support developers
         GTA01 – also called OpenMOKO, open source Mobile software
          and hardware – no future

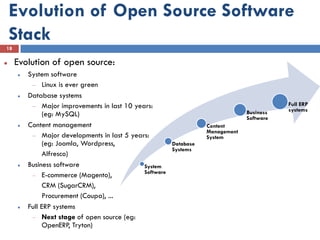

Evolution of Open Source Software
    Stack
18

    Evolution of open source:
        System software
               Linux is ever green
        Database systems
               Major improvements in last 10 years:                                           Full ERP
                                                                                   Business   systems
               (eg: MySQL)                                                         Software
        Content management                                           Content
                                                                      Management
               Major developments in last 5 years:                    System
               (eg: Joomla, Wordpress,                     Database
                                                           Systems
               Alfresco)
        Business software                      System
                                                Software
               E-commerce (Magento),
               CRM (SugarCRM),
               Procurement (Coupa), ...
        Full ERP systems
               Next stage of open source (eg:
               OpenERP, Tryton)
Some Criticism on Open Source
19

        Open Source Business: Model or Tactic?
         •   An article by Kristin Shoemaker
              http://ostatic.com/blog/open-source-business-model-or-tactic

         •   Now a days there are 114 open source vendors,
             including Red Hat,Alfresco, IBM and Oracle, MySQL DB
             (Owned by Oracle).
         •   Conclusion: In a perfect world, it would be wonderful to see
             "proprietary add-ons" disappear, and be offered openly
        Another Article:
              http://blogs.the451group.com/opensource/2008/10/13/open-
               source-is-not-a-business-model/
Outline
20

    Why Enterprise Resource Planning Systems – Part I
    Introduction to Open Source technologies – Part II
    OpenERP Introduction – Part III
    OpenERP VS Other Open Source ERPs – Part IV
    OpenERP Evaluation with SAP as a reference – Part V
    Conclusion
What is OpenERP?
21

    A leading ERP system
    Started in 2002 in Europe, Belgium
    Indian development branch opened in 2007
    Now more than 1000 modules
    Global network of partners in more than 70 countries
    Modern software architecture
        Dynamic web interface, Desktop Client (called GTK client), python based
         application server, and uses XML for changing visual screens.
    Completely open development process
        One of most active projects on Launchpad
    20 new modules per month, 1000 installations per day, 110 new
     customer requests per day
OpenERP License
22

        Alferro GNU Public License (AGPL) License V3 for
         the server plus modules, GTK client.
          Covers the “Application Service Provider (ASP)
           loophole” present in GPL License
        OPL License for the web client
          Itis Mozilla Public License (MPL) with some restrictions
           on the logos
OpenERP Project at a Glance…
23

 2002: 1.0 version. Fabien Pinckaers launches a
  specific solution for an auction house
 2004: first versions called TinyERP. Company
  name Tiny Sprl
 2005: Company name changed to OpenERP.
 2006: 3.0 version. First success story in Spain
  successfully 2007, SVN repository opened. 35
  official modules and 120 extras.
 2008: code in launchpad/bazaar. Community
  participation is opened.
2002 V 1.0 for auction   2004 Called   2005 Company     2006 First       2008 Code in   2009 Version   2010 Version     2011 version
       house               TinyERP     name changed   Success Story in    Launchpad       5.0 114      6.0 Early View   6.1 More user
                                        to OpenERP        Spain                           modules                          friendly

24

    2009: OpenERP 5.0 is published. 114 official modules and
     250 extras.
    2010: in July, OpenERP Early-Adopter Preview - 6.0-dev
     (alpha). Great community around the globe. It becomes the
     most reliable Open Source ERP. 500 published modules, 30
     languages and presence in 80 countries.
    2011: OpenERP has released its new version 6.0. More
     user-friendly, accessible, intuitive and ready to boost up a
     business. Response to the needs of customers, community
     and industries and the answer to today’s market
25

26

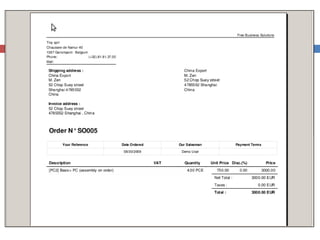

27

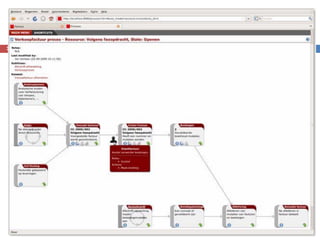

28
29
30
31

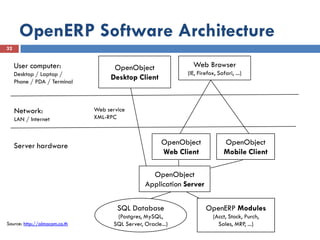

OpenERP Software Architecture
32

     User computer:                   OpenObject                 Web Browser
     Desktop / Laptop /                                        (IE, Firefox, Safari, ...)
     Phone / PDA / Terminal
                                     Desktop Client

     Network:                  Web service
     LAN / Internet            XML-RPC

     Server hardware                                     OpenObject             OpenObject
                                                         Web Client             Mobile Client

                                                    OpenObject
                                                  Application Server

                                       SQL Database                    OpenERP Modules
                                       (Postgres, MySQL,                   (Acct, Stock, Purch,
Source: http://almacom.co.th          SQL Server, Oracle...)                 Sales, MRP, ...)
OpenERP modules Diversity
33

                          Source: http://apenobject.com

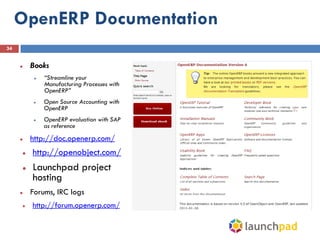

OpenERP Documentation
34

        Books
             “Streamline your
              Manufacturing Processes with
              OpenERP”
             Open Source Accounting with
              OpenERP
             OpenERP evaluation with SAP
              as reference
        http://doc.openerp.com/
        http://openobject.com/
        Launchpad project
         hosting
        Forums, IRC logs
        http://forum.openerp.com/
Outline
35

    Why Enterprise Resource Planning Systems – Part I
    Introduction to Open Source technologies – Part II
    OpenERP Introduction – Part III
    OpenERP VS Other Open Source ERPs – Part IV
    OpenERP Evaluation with SAP as a reference – Part V
    Conclusion
Open source ERP Business Model
36

         License costs are zero
         Great for customers, what about developers? (the community)
         What is the business model ($)?
            Services

                       Implementation, customization, training, maintenance, ...
                On-demand
                       Hosting ERP in the “cloud”
                       Similar to Salesforce.com, Netsuite
         ERP software requires lots of service
                SAP, Oracle: 80% of revenue = services

Source: http://almacom.co.th
Open Source Marketing Power
37

          Sales and marketing budget:
                Netsuite: 80MEUR, OpenERP: 200kEUR (x400!)

Source: http://almacom.co.th
Genealogy of Open Source ERPs

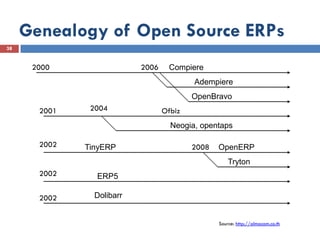

38

      2000                 2006    Compiere
                                          Adempiere
                                          OpenBravo
       2001    2004               Ofbiz
                                    Neogia, opentaps

       2002   TinyERP                     2008   OpenERP
                                                     Tryton
       2002     ERP5

       2002     Dolibarr

                                                 Source: http://almacom.co.th
Open source ERP Trends
39

                              Source: Google Insight
Case study: ERP in Europe
40

        Smile.fr
             Biggest open-source system
              integrator in France
             400 people, 25MEur revenue
             Started selling ERP services at end
              of 2007
             Compared all open source ERP
              systems
                    6-month study, 110-page
                    white-paper
                    Result: #1: OpenERP, #2:
                    OpenBravo
             Feedback two years later:
                    OpenBravo dropped, success
                    with OpenERP
               http://rvalyi.blogspot.com/

                                                    Source: http://almacom.co.th
Open Source ERP Comparison
41
Outline
42

    Why Enterprise Resource Planning Systems – Part I
    Introduction to Open Source technologies – Part II
    OpenERP Introduction – Part III
    OpenERP VS Other Open Source ERPs – Part IV
    OpenERP Evaluation with SAP as a reference – Part V
(Source: OpenERP evaluation with SAP as a reference Book by Yves Delsart and Christelle Van)

    Conclusion
Comparison Factors
43

        Market Position
          Strength   of the Channel, offline and online available
           material
        Features and Business Coverage
          Do   you have the features, I need?
        Technical Quality
          How  does the solution supports the development of
           specific requirements
Comparison Factors Cont’d..
44

        Customization and Flexibility
          Abilityof software to easily adapt to different users and
           system requirements
        Productivity and Ease of Use
          Latest
                Client requirement, i.e., user-centric approach
          How much easy to use

        Total Cost of Ownership
          Client   cannot risk unwise investments especially in SMEs
Market Position
45

        Visibility: hits number on the Google
           Relevant          SAP          OpenERP   OpenERP VS
           Feature                                  SAP
           Hits on Google    233Million   1,49M     0.6%

           Books on          8800         13        0.15%
           Amazon.com
           Followers on      13516        2793      20%
           Twitter
           Official Events   70           39        55%
Google Trend for the Keyword “SAP”
46
Google Trend for the Keyword
“OpenERP” – shows Fast Growth
47
Google Trend for the Keyword
 “OpenERP”+”TinyERP”
48
Google Trend for the Keyword
“OpenERP”+”TinyERP”+”SAP”
49

        SAP has 268 times more searches than OpenERP
Red Hat Partners with OpenERP
50
Service Offer
51

        OpenERP software vendor:
          Medium   sized company with around 200 Employees
          Offices located in Belgium, United States and India
           (Ahmadabad)
        Around 500 Partners in 78 Countries
        OpenERP strategy is to invest minimum on marketing
          Leverage  the communities
          Educate through events
SAP VS OpenERP
52

                         SAP                             OpenERP
     Promote the Company (SAP vs SAP R3)    Promote the Product: OpenERP

     Buyer and Sponsor: CFO and COO         Buyer and Sponsor: IT Guys

     We can do every thing!                 We can do what you want

     Publish Studies, Comparisons, awards   Leverage Communication through users

     Good, Strong Success Stories           Thousands of References

     Remain the Leader                      Be the most widely used

     Mature Software                        Agile Software

     Brand Growth mainly supported by the   Brand growth only supported by the
     marketing department                   communities

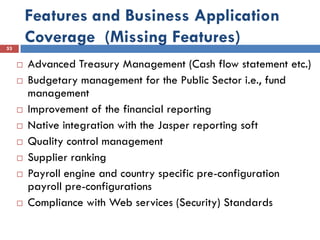

Features and Business Application
53
         Coverage (Missing Features)
        Advanced Treasury Management (Cash flow statement etc.)
        Budgetary management for the Public Sector i.e., fund
         management
        Improvement of the financial reporting
        Native integration with the Jasper reporting soft
        Quality control management
        Supplier ranking
        Payroll engine and country specific pre-configuration
         payroll pre-configurations
        Compliance with Web services (Security) Standards
Features and Business Application
54
         Coverage (Advanced Features)
        High Capability of Integration with Other tools
          Asterisk (keeping track of voice ip calls)
          OS Commerce, Magento

          Even Integration with SAP:

         Danone surprises the market deploying an open source ERP –
         OpenERP
         "Extraordinary project in the industry world, Danone deploys a very fast,
         integrated managing tool in the merging countries. Surprise: it's an open source
         software package and the integration deadlines are astonishing! Although
         Danone is a significant SAP client, the industry giant decided to use an open
         source integrated ERP solution for the emerging countries where it operates. The
         OpenERP integration was done in collaboration with Octo Technology”
Features and Business Application
     Coverage (Advanced Features)
55

        Fully Integrated Geo Engine
OpeERP development Accelerators
56
                               Year       # of Modules
    Open source               Jan 2005   40
     Application               Jan 2006   50

      Gathers some 2500 Jan 2007         112

       developers in addition Jan 2008    195
                              Jan 2009    350
       to 200 employed
                              Jan 2010    750
       developers             Jan 2011    1250
    Agile Architecture        Jan 2012   1950

     A   change in SAP will   Jan 2013   2683
                                                         Expected no
                               Jan 2014   3583
       take three times more                             of modules
                               Jan 2015   4606
       time
                               Jan 2016   5751
OpenERP and SAP way of handling
 Client Needs
57

       140

       120

 Client 100
 Need
         80

        60                    Features Coverage

        40

        20

         0
              SAP   OpenERP
Total Cost of Ownership (TCO)
58
Implementation Cost
59

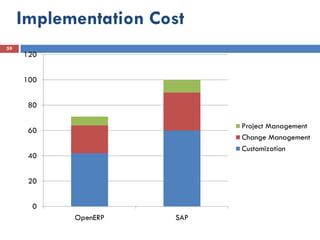

     120

     100

      80

                             Project Management
      60
                             Change Management
                             Customization
      40

      20

      0
           OpenERP     SAP
Installation Cost
60   35

     30

     25

     20
                          License
     15                   Hardware

     10

     5

     0
          OpenERP   SAP
Maintenance Cost
61
     70

     60

     50

     40
                               Support
                               Maintenance (5 years)
     30
                               Upgrade
     20

     10

     0
              OpenERP    SAP
Technical Quality
62

        Efficiency
          Programming     language efficiency
            Python   VS. ABAP
          Architecture   efficiency
            MVC,  ORM, Workflow engine, Module System, Integrated
             Tested system, Several reports engines
          Database    efficiency
            Object   Relational Mapping on top of Postgresql
Object Relational Mapping Example
63
           class cms_city(osv.osv):
              """(NULL)"""
              _name = 'cms.city'
              _columns = {
                  'name':
               fields.char('City', size=100, required=True),
              }
           cms_city()
                                    Object
                                    level

                                       Relational
                                       level
            CREATE TABLE CMS_CITY(
              id INT PRIMARY KEY,
              name VARCHAR(64) NOT NULL,
            )

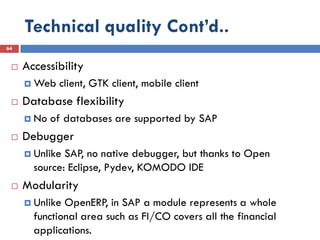

Technical quality Cont’d..
64

    Accessibility
      Web   client, GTK client, mobile client
    Database flexibility
      No   of databases are supported by SAP
    Debugger
      Unlike SAP, no native debugger, but thanks to Open
       source: Eclipse, Pydev, KOMODO IDE
    Modularity
      Unlike OpenERP, in SAP a module represents a whole
       functional area such as FI/CO covers all the financial
       applications.
Conclusion – I
65

    OpenERP product life cycle maturity
      Product   is launched some 8 years ago and now its stable
    OpenERP market maturity
      Transition
                phase: “Early Majority Adopters” wait until an
       emerging product has been fully tried and tested
    Open source VS close source
      Close   source is known and recognized by the guarantees it
       offers
      But Open source has made remarkable progress in:
        Web  Servers/Services – Apache
        Database – Postgresql
        Browsers – Chrome, Firefox
        BackOffice – FTP, SQUID, DHCP, …
Conclusion – II
66

        OpenERP must extends its functional landscape
        European and local public Institutions are
         constrained by the law to consider the open source
         solutions before trying proprietary ones.
        What if, proprietary ERP providers go Open source
         way, like Oracle Virtual Box etc.,….

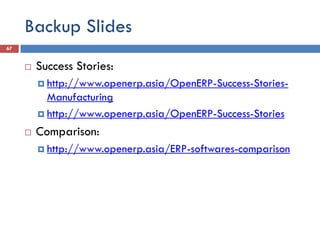

Backup Slides
67

        Success Stories:
          http://www.openerp.asia/OpenERP-Success-Stories-
           Manufacturing
          http://www.openerp.asia/OpenERP-Success-Stories

        Comparison:
          http://www.openerp.asia/ERP-softwares-comparison

NUST SEECS OpenERP Presentation

  • 1.
    1 OPENERP VERSION 6TRAINING USING HUMAN RESOURCE MANAGEMENT MODULE Dr. M Masoom Alam Dr. Amir Hayat Associate Professor Assistant Professor IMSciences SEECS Mohsin Yasin System Analyst IMSciences
  • 2.
    Outline 2  Why Enterprise Resource Planning Systems – Part I  Introduction to Open Source technologies – Part II  OpenERP Introduction – Part III  OpenERP VS Other Open Source ERPs – Part IV  OpenERP evaluation with SAP as a reference – Part V  Conclusion
  • 3.
    Outline 3  Why Enterprise Resource Planning Systems – Part I  Introduction to Open Source technologies – Part II  OpenERP Introduction – Part III  OpenERP VS Other Open Source ERPs – Part IV  OpenERP Evaluation with SAP as a reference – Part V  Conclusion
  • 4.
    Enterprise Resource PlanningSystems 4  Enterprise resource planning (ERP) systems automate and integrate various with an integrated software application.  activities = Finance/Accounting, Sales&Service, Customer Relationship Management, etc.  The concept was born in Early 1960s  In 1972 “Systems Applications Products in data processing”  In 1976 Company name changed to “SAP GmBH”  SAP R/1 in 1973  SAP R/2 in 1979  SAP R/3 in 1992 Source: http://en.wikipedia.org/wiki/Enterprise_resource_planning
  • 5.
    An Enterprise Landscape(without ERP) 5 Sales Human resources Engineering Design Inventory Production Planning Finance Controlling Quality Maintenance legal Source: http://gyansangam.iiita.ac.in/content/cluster_2_1/ERP.ppt
  • 6.
    Categories Of InformationSystems 6 • Operational - level systems: Support operational managers keep track of the elementary activities and transactions. • Management-level systems: Serve the monitoring, controlling, decision-making, and administrative activities • Strategic-level systems: Help senior management tackle and address strategic issues. Figure Source: http://gyansangam.iiita.ac.in/content/cluster_2_1/ERP.ppt
  • 7.
    Four Major Typesof Information Systems 7 • Transaction Processing Systems (TPS): Business level systems that serves the Operational level. • Management Information Systems (MIS): Provides feedback on daily operations. • Decision-Support Systems (DSS): Provides managers with information and support for effective decision making • Executive Support Systems (ESS): Designed for the CEO of the company Figure Source: http://gyansangam.iiita.ac.in/content/cluster_2_1/ERP.ppt
  • 8.
    Enterprise without anERP 8 Executive • Department are still located Support System on different Islands • A variety of software Decision platforms and solutions Support System • Difficult to maintain and Enterprise upgrade Management • No Seamless flow of Information System Information • … Transaction Processing System
  • 9.
    What is aBusiness Process 9 • According to Wikipedia: “A business process or business method is a collection of related, structured activities in different functional areas of an organization that produce a specific service or product (serve a particular goal) for a particular customer or customers.”
  • 10.
    Order Fulfillment BusinessProcess 10 (Cross Functional) Sales Generate Submit Order Order Accounting Check Approve Generate Credit credit Invoice Manufacturing Assemble Ship and Product Product Production
  • 11.
    Enterprise Systems 11 • EnterpriseSystems, are software solutions that focuses the Enterprise needs by taking a process view of the overall Enterprise to meet the goals by tightly integrating all functional areas and under a common platform. • SAP, Oracle Applications, PeopleSoft, JD Edwards, NetSuite etc., are the world leading ERP Packages. Figure Source: http://gyansangam.iiita.ac.in/content/cluster_2_1/ERP.ppt
  • 12.
    Advantages of anERP System 12 • Seamless flow of information among all functions of an enterprise in a real time. • One integrated system replaces many different software . • Reliable information access through a common DBMS • Improves the Business Processes: Eliminates data and operational redundancies (no duplication of work or data entries etc.)
  • 13.
    Outline 13  Why Enterprise Resource Planning Systems – Part I  Introduction to Open Source technologies – Part II  OpenERP Introduction – Part III  OpenERP VS Other Open Source ERPs – Part IV  OpenERP Evaluation with SAP as a reference – Part V  Conclusion
  • 14.
    Introduction 14  In 1983 Richard Stallman started GNU project to launch a complete Operation System free from constraints.  In 1989, first version of GNU public license was published.  The Linux kernel, started by Linus Torvalds, was released as freely modifiable source code in 1991  Recently, viable open source ERP alternatives have begun to appear  OpenERP is one of these new kind of ERP systems
  • 15.
    Open Source Productsat a Glance… 15  Programming Languages: LISP, C, C++,Perl, Python,Java, PHP,Ruby, ...  Computer Operating systems: Linux, freeBSD, …  Database Management System: PostgreSQL, MySQL, SQLite, …  Web Servers/Services infrastructure: Apache, Bind, Postfix, …  Content Management System: JOOMLA, Drupal, Wordpress, Alfresco, …  Application Server Infrastructure (Middleware): JBoss, Spring, Rails, OpenObject, …  Mobile Operating Systems: Android, Memo  All Credit Goes to World Wide Web!
  • 16.
    Open source powersthe web 16 Figure Source: http://ostatic.com/blog/apache-holds-steady-market-share-still-dominating-microsoft-iis
  • 17.
    Software Development Processfor Open Source 17  Across the globe community of developers working together to improve the software  Distributed Versioning System (SVN, CVS, Bazar)  Not only from different countries but also from companies  “Many eyes make all bugs shallow”  That’s Why viruses does not create problems for Linux or Ubuntu  Is only suitable for top talent  More visibility & Freedom  More efficient process, avoid duplication of efforts  “Disadvantage”  New business models are needed to support developers  GTA01 – also called OpenMOKO, open source Mobile software and hardware – no future
  • 18.
    Evolution of OpenSource Software Stack 18  Evolution of open source:  System software Linux is ever green  Database systems Major improvements in last 10 years: Full ERP Business systems (eg: MySQL) Software  Content management Content Management Major developments in last 5 years: System (eg: Joomla, Wordpress, Database Systems Alfresco)  Business software System Software E-commerce (Magento), CRM (SugarCRM), Procurement (Coupa), ...  Full ERP systems Next stage of open source (eg: OpenERP, Tryton)
  • 19.
    Some Criticism onOpen Source 19  Open Source Business: Model or Tactic? • An article by Kristin Shoemaker  http://ostatic.com/blog/open-source-business-model-or-tactic • Now a days there are 114 open source vendors, including Red Hat,Alfresco, IBM and Oracle, MySQL DB (Owned by Oracle). • Conclusion: In a perfect world, it would be wonderful to see "proprietary add-ons" disappear, and be offered openly  Another Article:  http://blogs.the451group.com/opensource/2008/10/13/open- source-is-not-a-business-model/
  • 20.
    Outline 20  Why Enterprise Resource Planning Systems – Part I  Introduction to Open Source technologies – Part II  OpenERP Introduction – Part III  OpenERP VS Other Open Source ERPs – Part IV  OpenERP Evaluation with SAP as a reference – Part V  Conclusion
  • 21.
    What is OpenERP? 21  A leading ERP system  Started in 2002 in Europe, Belgium  Indian development branch opened in 2007  Now more than 1000 modules  Global network of partners in more than 70 countries  Modern software architecture  Dynamic web interface, Desktop Client (called GTK client), python based application server, and uses XML for changing visual screens.  Completely open development process  One of most active projects on Launchpad  20 new modules per month, 1000 installations per day, 110 new customer requests per day
  • 22.
    OpenERP License 22  Alferro GNU Public License (AGPL) License V3 for the server plus modules, GTK client.  Covers the “Application Service Provider (ASP) loophole” present in GPL License  OPL License for the web client  Itis Mozilla Public License (MPL) with some restrictions on the logos
  • 23.
    OpenERP Project ata Glance… 23  2002: 1.0 version. Fabien Pinckaers launches a specific solution for an auction house  2004: first versions called TinyERP. Company name Tiny Sprl  2005: Company name changed to OpenERP.  2006: 3.0 version. First success story in Spain successfully 2007, SVN repository opened. 35 official modules and 120 extras.  2008: code in launchpad/bazaar. Community participation is opened.
  • 24.
    2002 V 1.0for auction 2004 Called 2005 Company 2006 First 2008 Code in 2009 Version 2010 Version 2011 version house TinyERP name changed Success Story in Launchpad 5.0 114 6.0 Early View 6.1 More user to OpenERP Spain modules friendly 24  2009: OpenERP 5.0 is published. 114 official modules and 250 extras.  2010: in July, OpenERP Early-Adopter Preview - 6.0-dev (alpha). Great community around the globe. It becomes the most reliable Open Source ERP. 500 published modules, 30 languages and presence in 80 countries.  2011: OpenERP has released its new version 6.0. More user-friendly, accessible, intuitive and ready to boost up a business. Response to the needs of customers, community and industries and the answer to today’s market
  • 25.
  • 26.
  • 27.
  • 28.
  • 29.
  • 30.
  • 31.
  • 32.
    OpenERP Software Architecture 32 User computer: OpenObject Web Browser Desktop / Laptop / (IE, Firefox, Safari, ...) Phone / PDA / Terminal Desktop Client Network: Web service LAN / Internet XML-RPC Server hardware OpenObject OpenObject Web Client Mobile Client OpenObject Application Server SQL Database OpenERP Modules (Postgres, MySQL, (Acct, Stock, Purch, Source: http://almacom.co.th SQL Server, Oracle...) Sales, MRP, ...)
  • 33.
    OpenERP modules Diversity 33 Source: http://apenobject.com
  • 34.
    OpenERP Documentation 34  Books  “Streamline your Manufacturing Processes with OpenERP”  Open Source Accounting with OpenERP  OpenERP evaluation with SAP as reference  http://doc.openerp.com/  http://openobject.com/  Launchpad project hosting  Forums, IRC logs  http://forum.openerp.com/
  • 35.
    Outline 35  Why Enterprise Resource Planning Systems – Part I  Introduction to Open Source technologies – Part II  OpenERP Introduction – Part III  OpenERP VS Other Open Source ERPs – Part IV  OpenERP Evaluation with SAP as a reference – Part V  Conclusion
  • 36.
    Open source ERPBusiness Model 36  License costs are zero  Great for customers, what about developers? (the community)  What is the business model ($)?  Services Implementation, customization, training, maintenance, ...  On-demand Hosting ERP in the “cloud” Similar to Salesforce.com, Netsuite  ERP software requires lots of service  SAP, Oracle: 80% of revenue = services Source: http://almacom.co.th
  • 37.
    Open Source MarketingPower 37  Sales and marketing budget:  Netsuite: 80MEUR, OpenERP: 200kEUR (x400!) Source: http://almacom.co.th
  • 38.
    Genealogy of OpenSource ERPs 38 2000 2006 Compiere Adempiere OpenBravo 2001 2004 Ofbiz Neogia, opentaps 2002 TinyERP 2008 OpenERP Tryton 2002 ERP5 2002 Dolibarr Source: http://almacom.co.th
  • 39.
    Open source ERPTrends 39 Source: Google Insight
  • 40.
    Case study: ERPin Europe 40  Smile.fr  Biggest open-source system integrator in France  400 people, 25MEur revenue  Started selling ERP services at end of 2007  Compared all open source ERP systems 6-month study, 110-page white-paper Result: #1: OpenERP, #2: OpenBravo  Feedback two years later: OpenBravo dropped, success with OpenERP http://rvalyi.blogspot.com/ Source: http://almacom.co.th
  • 41.
    Open Source ERPComparison 41
  • 42.
    Outline 42  Why Enterprise Resource Planning Systems – Part I  Introduction to Open Source technologies – Part II  OpenERP Introduction – Part III  OpenERP VS Other Open Source ERPs – Part IV  OpenERP Evaluation with SAP as a reference – Part V (Source: OpenERP evaluation with SAP as a reference Book by Yves Delsart and Christelle Van)  Conclusion
  • 43.
    Comparison Factors 43  Market Position  Strength of the Channel, offline and online available material  Features and Business Coverage  Do you have the features, I need?  Technical Quality  How does the solution supports the development of specific requirements
  • 44.
    Comparison Factors Cont’d.. 44  Customization and Flexibility  Abilityof software to easily adapt to different users and system requirements  Productivity and Ease of Use  Latest Client requirement, i.e., user-centric approach  How much easy to use  Total Cost of Ownership  Client cannot risk unwise investments especially in SMEs
  • 45.
    Market Position 45  Visibility: hits number on the Google Relevant SAP OpenERP OpenERP VS Feature SAP Hits on Google 233Million 1,49M 0.6% Books on 8800 13 0.15% Amazon.com Followers on 13516 2793 20% Twitter Official Events 70 39 55%
  • 46.
    Google Trend forthe Keyword “SAP” 46
  • 47.
    Google Trend forthe Keyword “OpenERP” – shows Fast Growth 47
  • 48.
    Google Trend forthe Keyword “OpenERP”+”TinyERP” 48
  • 49.
    Google Trend forthe Keyword “OpenERP”+”TinyERP”+”SAP” 49  SAP has 268 times more searches than OpenERP
  • 50.
    Red Hat Partnerswith OpenERP 50
  • 51.
    Service Offer 51  OpenERP software vendor:  Medium sized company with around 200 Employees  Offices located in Belgium, United States and India (Ahmadabad)  Around 500 Partners in 78 Countries  OpenERP strategy is to invest minimum on marketing  Leverage the communities  Educate through events
  • 52.
    SAP VS OpenERP 52 SAP OpenERP Promote the Company (SAP vs SAP R3) Promote the Product: OpenERP Buyer and Sponsor: CFO and COO Buyer and Sponsor: IT Guys We can do every thing! We can do what you want Publish Studies, Comparisons, awards Leverage Communication through users Good, Strong Success Stories Thousands of References Remain the Leader Be the most widely used Mature Software Agile Software Brand Growth mainly supported by the Brand growth only supported by the marketing department communities
  • 53.
    Features and BusinessApplication 53 Coverage (Missing Features)  Advanced Treasury Management (Cash flow statement etc.)  Budgetary management for the Public Sector i.e., fund management  Improvement of the financial reporting  Native integration with the Jasper reporting soft  Quality control management  Supplier ranking  Payroll engine and country specific pre-configuration payroll pre-configurations  Compliance with Web services (Security) Standards
  • 54.
    Features and BusinessApplication 54 Coverage (Advanced Features)  High Capability of Integration with Other tools  Asterisk (keeping track of voice ip calls)  OS Commerce, Magento  Even Integration with SAP: Danone surprises the market deploying an open source ERP – OpenERP "Extraordinary project in the industry world, Danone deploys a very fast, integrated managing tool in the merging countries. Surprise: it's an open source software package and the integration deadlines are astonishing! Although Danone is a significant SAP client, the industry giant decided to use an open source integrated ERP solution for the emerging countries where it operates. The OpenERP integration was done in collaboration with Octo Technology”
  • 55.
    Features and BusinessApplication Coverage (Advanced Features) 55  Fully Integrated Geo Engine
  • 56.
    OpeERP development Accelerators 56 Year # of Modules  Open source Jan 2005 40 Application Jan 2006 50  Gathers some 2500 Jan 2007 112 developers in addition Jan 2008 195 Jan 2009 350 to 200 employed Jan 2010 750 developers Jan 2011 1250  Agile Architecture Jan 2012 1950 A change in SAP will Jan 2013 2683 Expected no Jan 2014 3583 take three times more of modules Jan 2015 4606 time Jan 2016 5751
  • 57.
    OpenERP and SAPway of handling Client Needs 57 140 120 Client 100 Need 80 60 Features Coverage 40 20 0 SAP OpenERP
  • 58.
    Total Cost ofOwnership (TCO) 58
  • 59.
    Implementation Cost 59 120 100 80 Project Management 60 Change Management Customization 40 20 0 OpenERP SAP
  • 60.
    Installation Cost 60 35 30 25 20 License 15 Hardware 10 5 0 OpenERP SAP
  • 61.
    Maintenance Cost 61 70 60 50 40 Support Maintenance (5 years) 30 Upgrade 20 10 0 OpenERP SAP
  • 62.
    Technical Quality 62  Efficiency  Programming language efficiency  Python VS. ABAP  Architecture efficiency  MVC, ORM, Workflow engine, Module System, Integrated Tested system, Several reports engines  Database efficiency  Object Relational Mapping on top of Postgresql
  • 63.
    Object Relational MappingExample 63 class cms_city(osv.osv): """(NULL)""" _name = 'cms.city' _columns = { 'name': fields.char('City', size=100, required=True), } cms_city() Object level Relational level CREATE TABLE CMS_CITY( id INT PRIMARY KEY, name VARCHAR(64) NOT NULL, )
  • 64.
    Technical quality Cont’d.. 64  Accessibility  Web client, GTK client, mobile client  Database flexibility  No of databases are supported by SAP  Debugger  Unlike SAP, no native debugger, but thanks to Open source: Eclipse, Pydev, KOMODO IDE  Modularity  Unlike OpenERP, in SAP a module represents a whole functional area such as FI/CO covers all the financial applications.
  • 65.
    Conclusion – I 65  OpenERP product life cycle maturity  Product is launched some 8 years ago and now its stable  OpenERP market maturity  Transition phase: “Early Majority Adopters” wait until an emerging product has been fully tried and tested  Open source VS close source  Close source is known and recognized by the guarantees it offers  But Open source has made remarkable progress in:  Web Servers/Services – Apache  Database – Postgresql  Browsers – Chrome, Firefox  BackOffice – FTP, SQUID, DHCP, …
  • 66.
    Conclusion – II 66  OpenERP must extends its functional landscape  European and local public Institutions are constrained by the law to consider the open source solutions before trying proprietary ones.  What if, proprietary ERP providers go Open source way, like Oracle Virtual Box etc.,….
  • 67.
    Backup Slides 67  Success Stories:  http://www.openerp.asia/OpenERP-Success-Stories- Manufacturing  http://www.openerp.asia/OpenERP-Success-Stories  Comparison:  http://www.openerp.asia/ERP-softwares-comparison
