| ICU JPM |

Introduction of ICU

          Assessing Where We Are

            Managing and Administering Development

           Monitoring and Evaluation(M&E) Mechanisms

         Outcome Based Approach (OBA) – the new dimension of M&E

   Summary

                                                               2

Corporate Video of
  ICUJPM

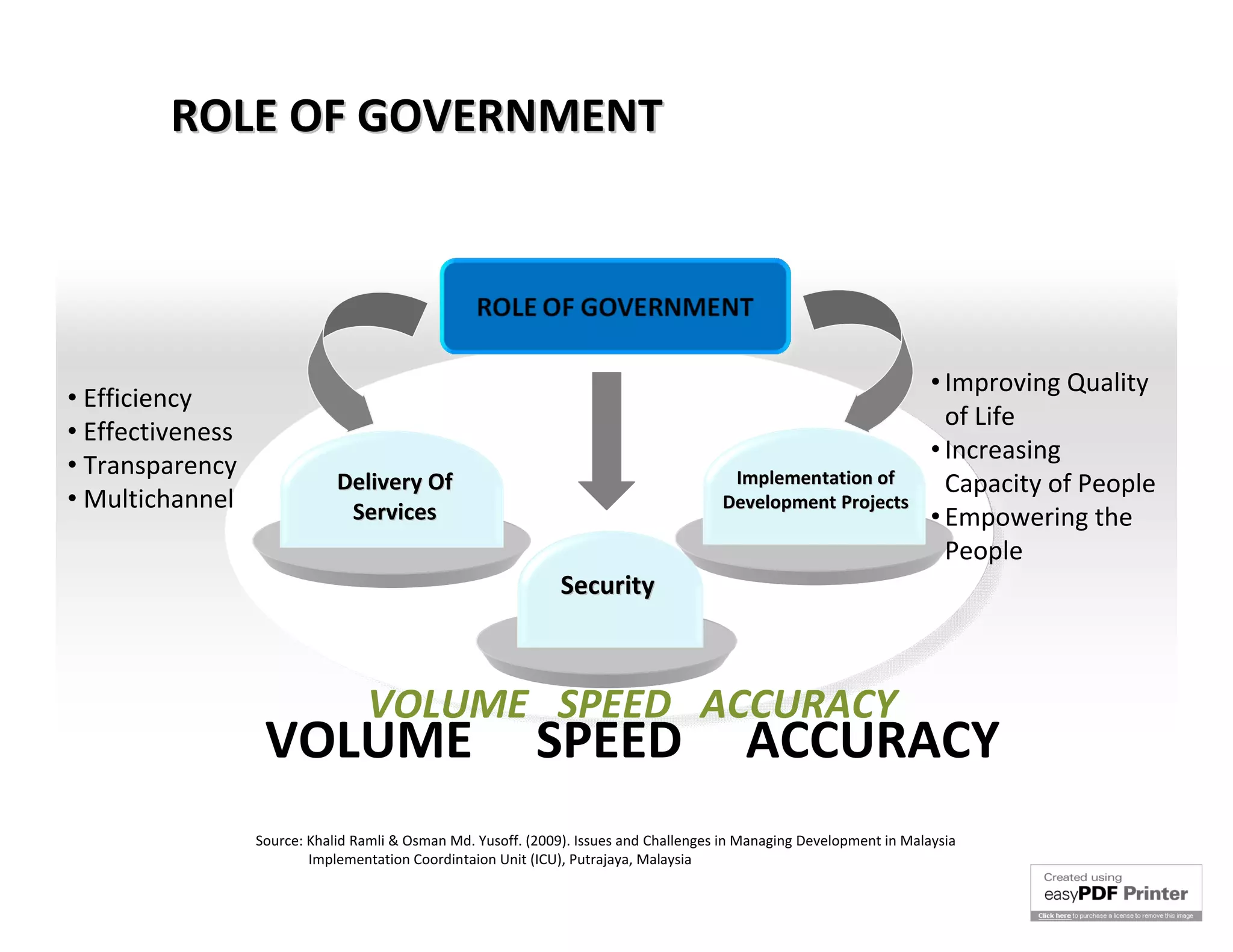

ROLE OF GOVERNMENT

                                                                                                                        • Improving Quality
• Efficiency
                                                                                                                          of Life
• Effectiveness
                                                                                                                        • Increasing
• Transparency                                                                           Implementation of
                              Delivery Of                                                                                 Capacity of People
• Multichannel                 Services                                                 Development Projects
                                                                                                                        • Empowering the
                                                                                                                          People
                                                                Security

                                  VOLUME SPEED ACCURACY
                   VOLUME                                   SPEED                           ACCURACY
                  Source: Khalid Ramli & Osman Md. Yusoff. (2009). Issues and Challenges in Managing Development in Malaysia
                          Implementation Coordintaion Unit (ICU), Putrajaya, Malaysia

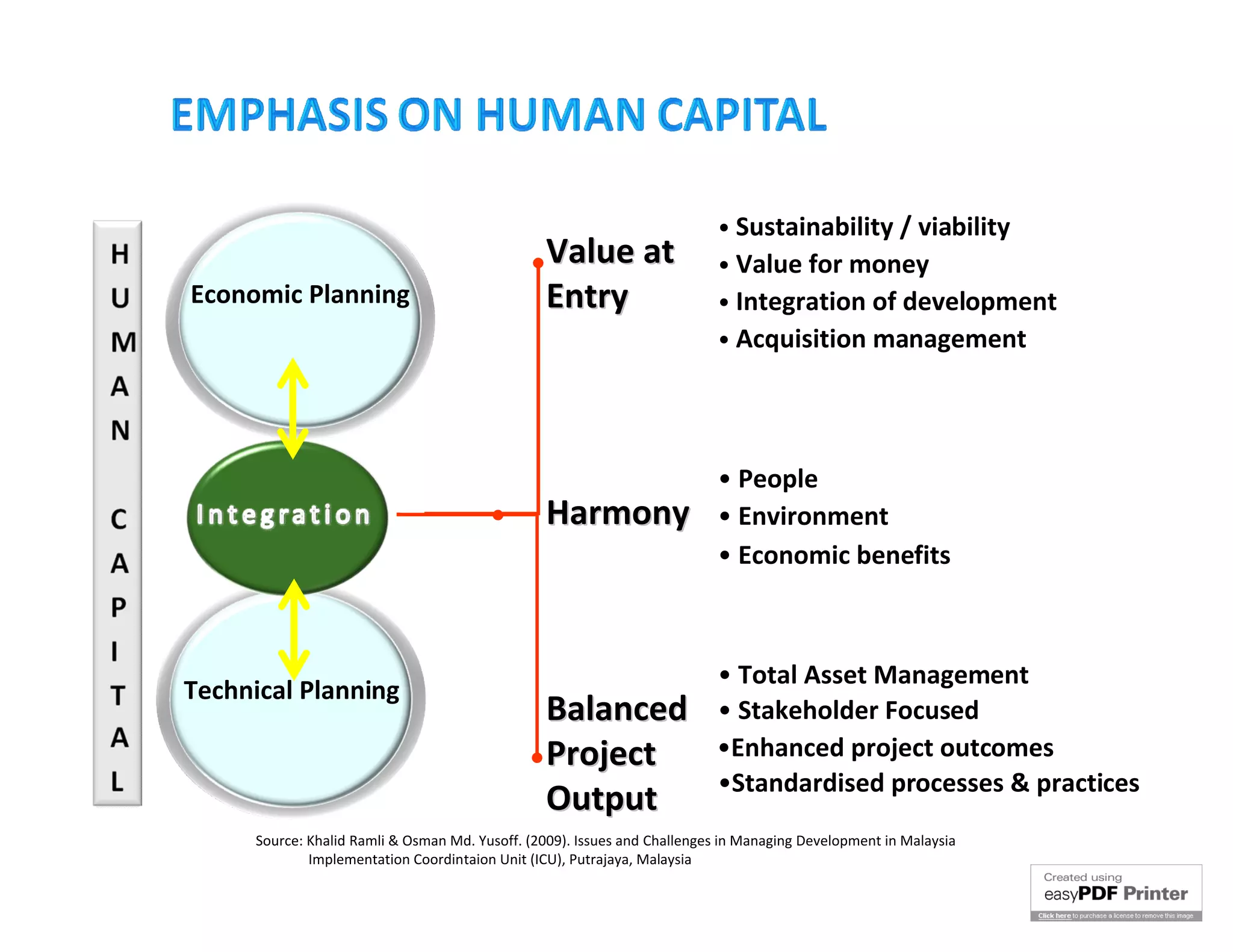

• Sustainability / viability
                                                 Value at                  • Value for money
Economic Planning                                Entry                     • Integration of development
                                                                           • Acquisition management

                                                                           • People
                                                 Harmony                   • Environment
                                                                           • Economic benefits

                                                                           • Total Asset Management
Technical Planning
                                                 Balanced                  • Stakeholder Focused
                                                 Project                   •Enhanced project outcomes
                                                                           •Standardised processes & practices
                                                 Output
      Source: Khalid Ramli & Osman Md. Yusoff. (2009). Issues and Challenges in Managing Development in Malaysia
              Implementation Coordintaion Unit (ICU), Putrajaya, Malaysia

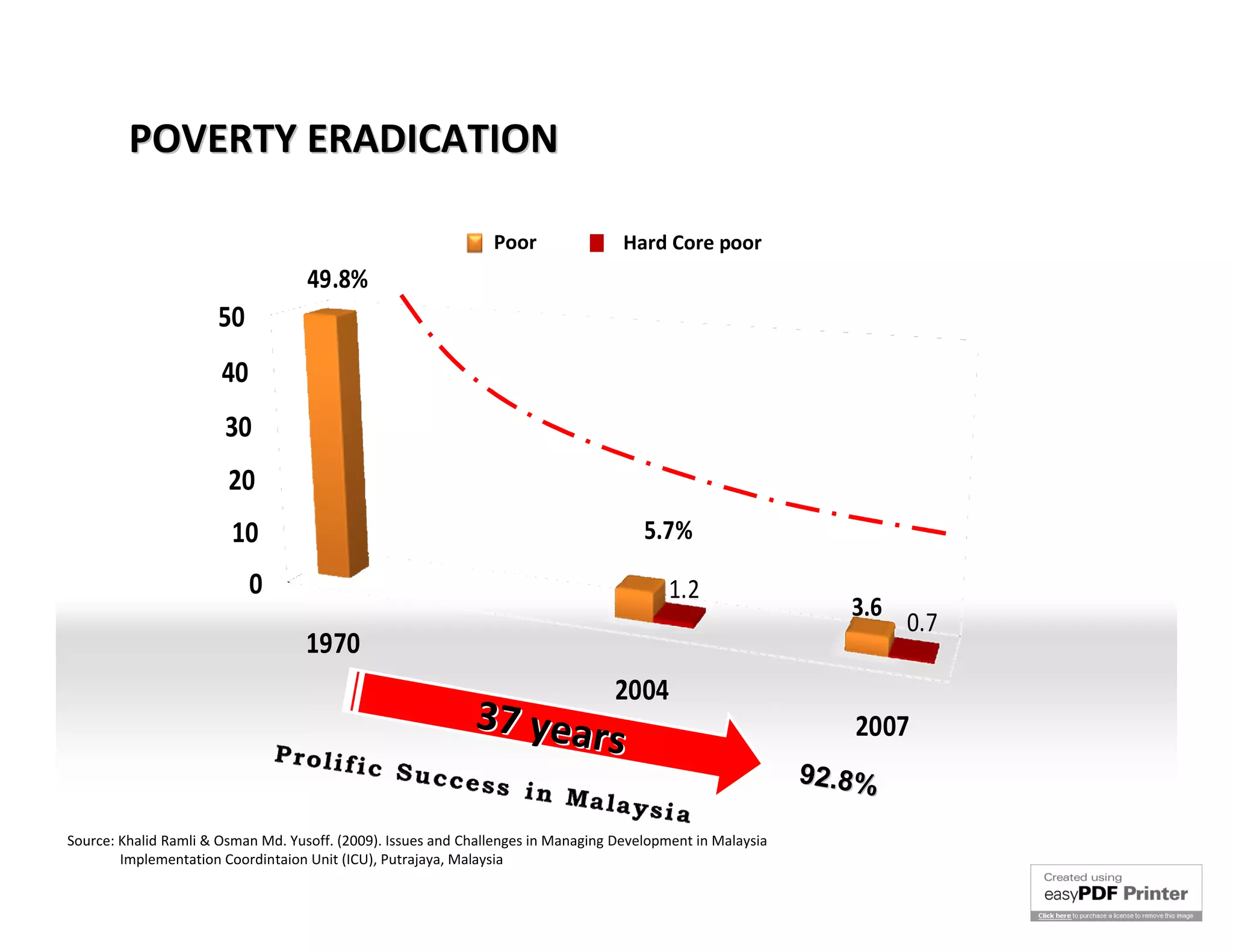

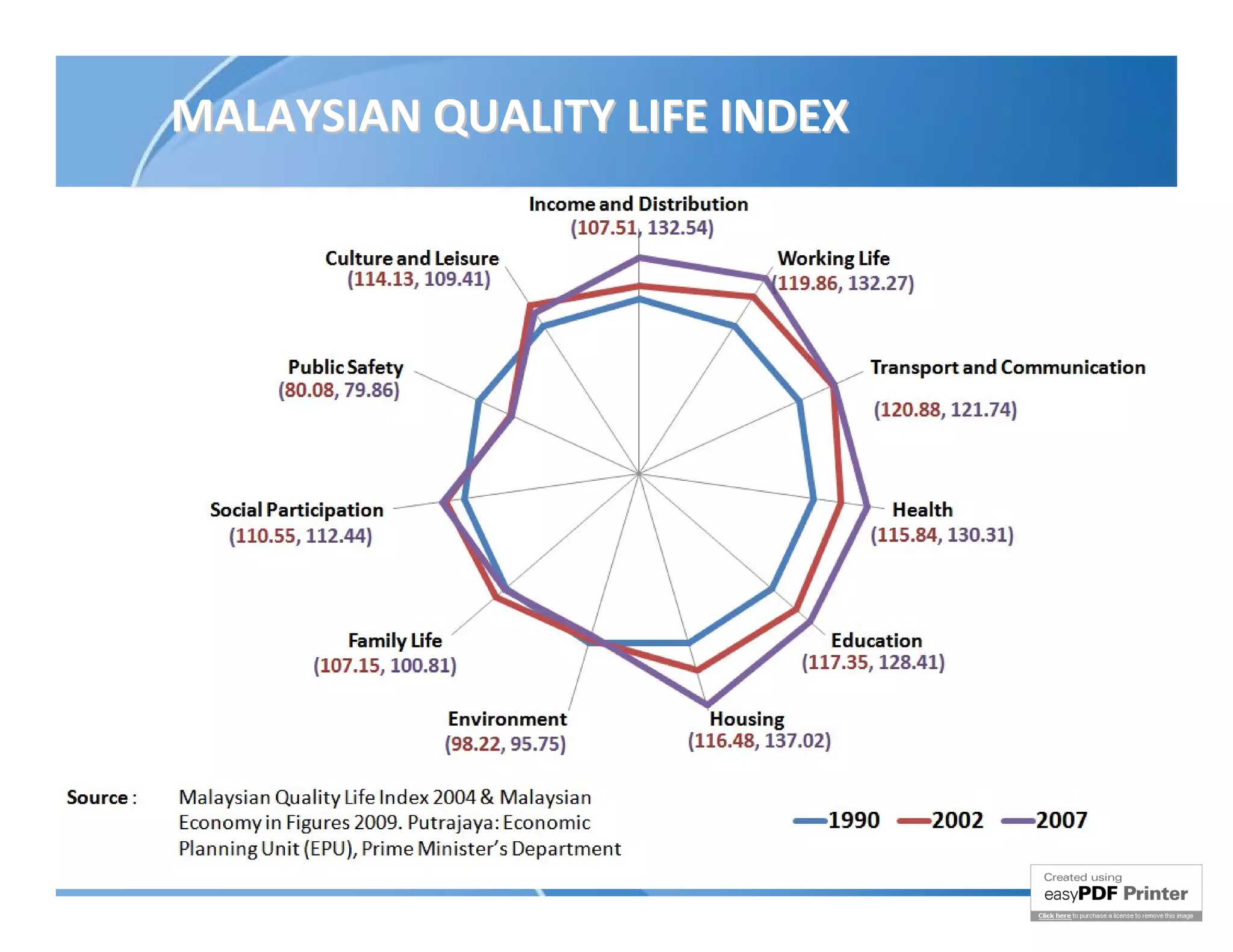

MALAYSIAN QUALITY LIFE INDEX
POVERTY ERADICATION

                                                                Miskin
                                                                Poor              Miskin Tegar
                                                                                  Hard Core poor
                                    49.8%
                      50
                       40
                       30
                        20
                        10                                                             5.7%
                            0                                                              1.2
                                                                                                                3.6
                                                                                                                      0.7
                                    1970
                                                                                  2004
                                                             37 year                                            2007
                                                                     s
                                                                                                             92.8%

Source: Khalid Ramli & Osman Md. Yusoff. (2009). Issues and Challenges in Managing Development in Malaysia
        Implementation Coordintaion Unit (ICU), Putrajaya, Malaysia

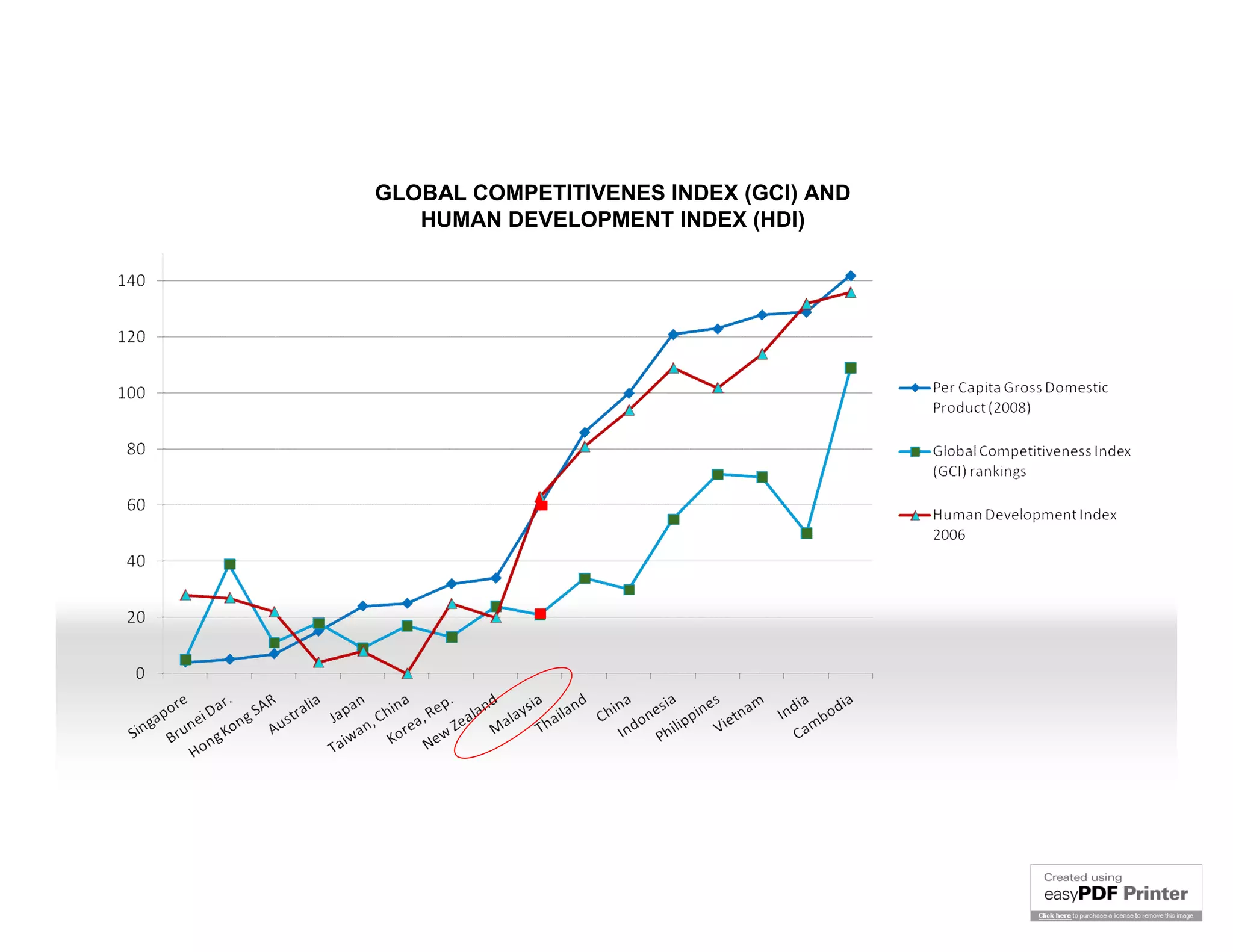

GLOBAL COMPETITIVENES INDEX (GCI) AND
    HUMAN DEVELOPMENT INDEX (HDI)

Per Capita Gross Domestic Product (2008)
GLOBAL COMPETITIVENES INDEX (GCI) AND
   HUMAN DEVELOPMENT INDEX (HDI)

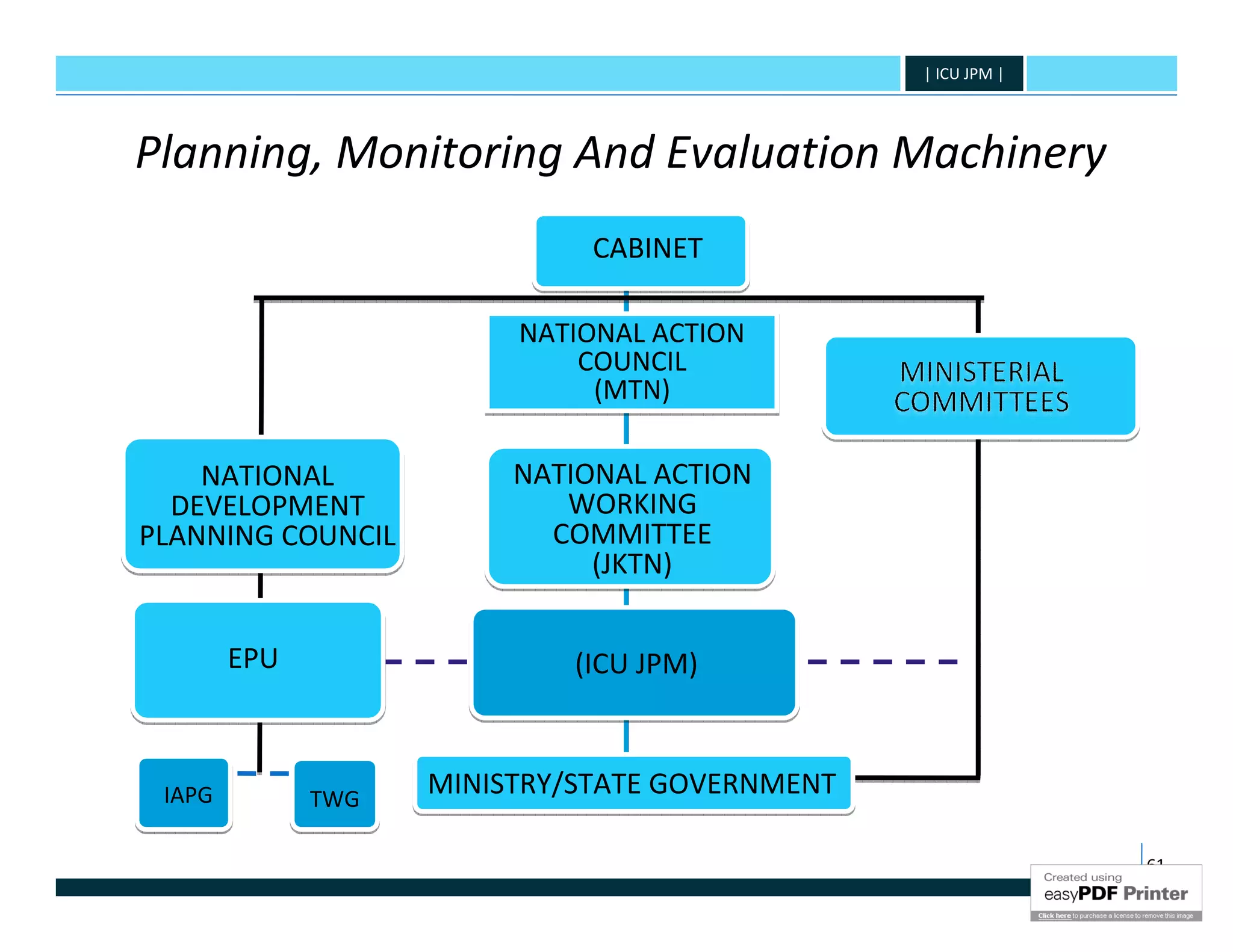

Monitoring Machinery

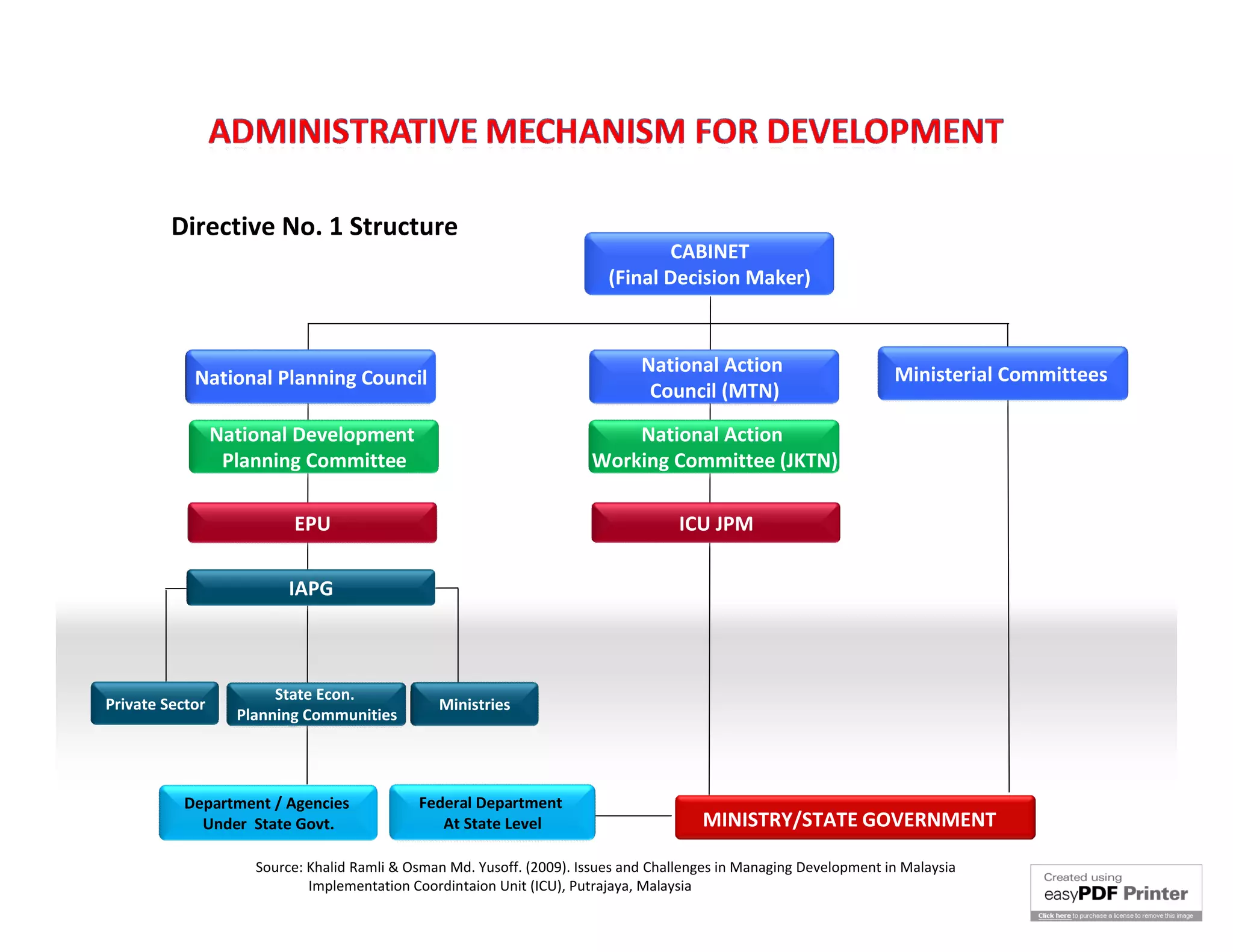

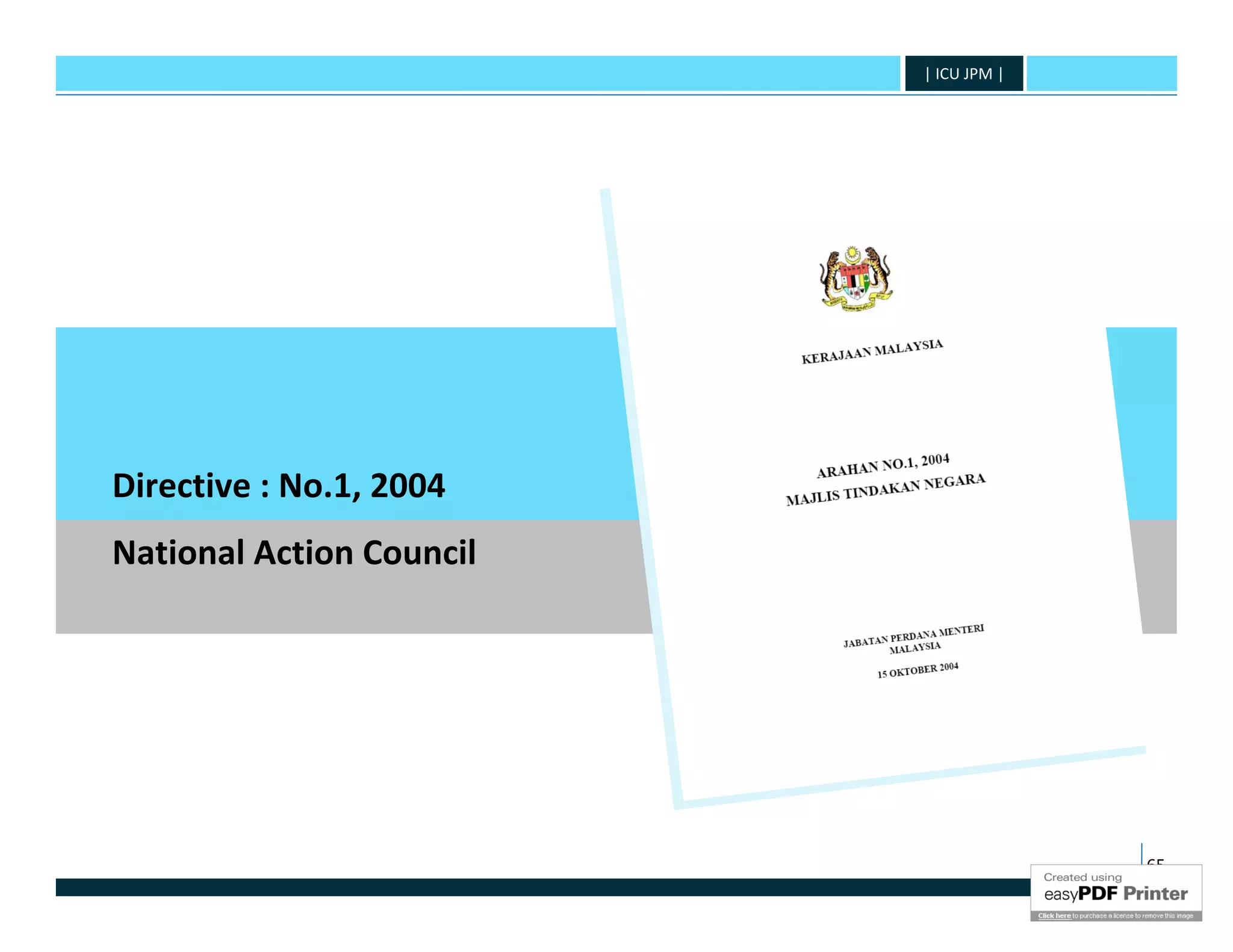

Directive No. 1 Structure
                                                                                  CABINET
                                                                          (Final Decision Maker)

                                                                               National Action                       Ministerial Committees
            National Planning Council
                                                                                Council (MTN)

                 National Development                                      National Action
                  Planning Committee                                   Working Committee (JKTN)

                          EPU                                                        ICU JPM

                          IAPG

                        State Econ.
Private Sector                                  Ministries
                   Planning Communities

           Department / Agencies             Federal Department
             Under State Govt.                  At State Level                          MINISTRY/STATE GOVERNMENT

                     Source: Khalid Ramli & Osman Md. Yusoff. (2009). Issues and Challenges in Managing Development in Malaysia
                             Implementation Coordintaion Unit (ICU), Putrajaya, Malaysia
| ICU JPM |

Source: Khalid Ramli & Osman Md. Yusoff. (2009). Issues and Challenges in Managing Development in Malaysia
        Implementation Coordintaion Unit (ICU), Putrajaya, Malaysia                                                14
| ICU JPM |

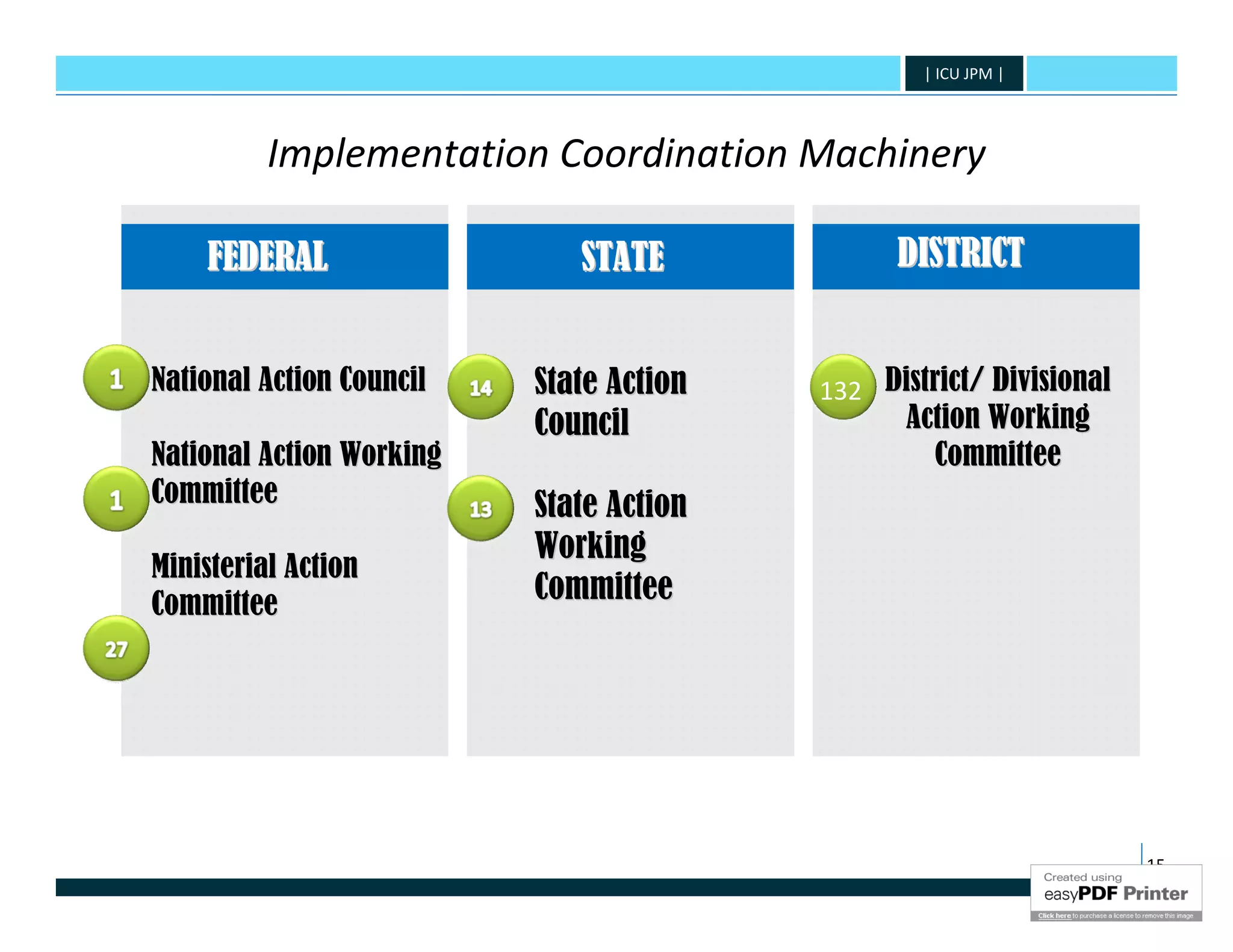

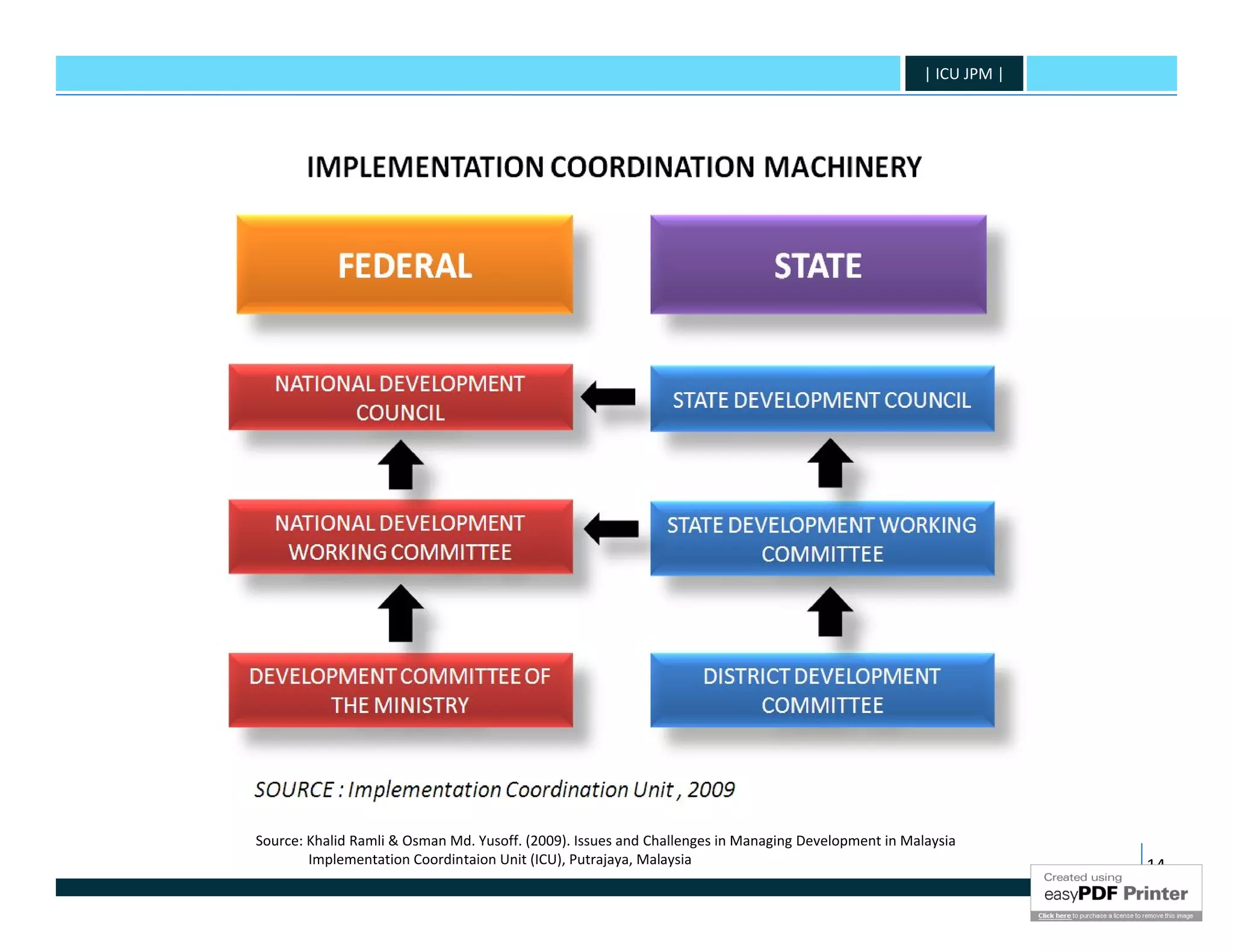

          Implementation Coordination Machinery

    FEDERAL                  STATE             DISTRICT

National Action Council   State Action   132 District/ Divisional
                          Council               Action Working
National Action Working                           Committee
Committee                 State Action
                          Working
Ministerial Action
Committee
                          Committee

                                                                    15
| ICU JPM |

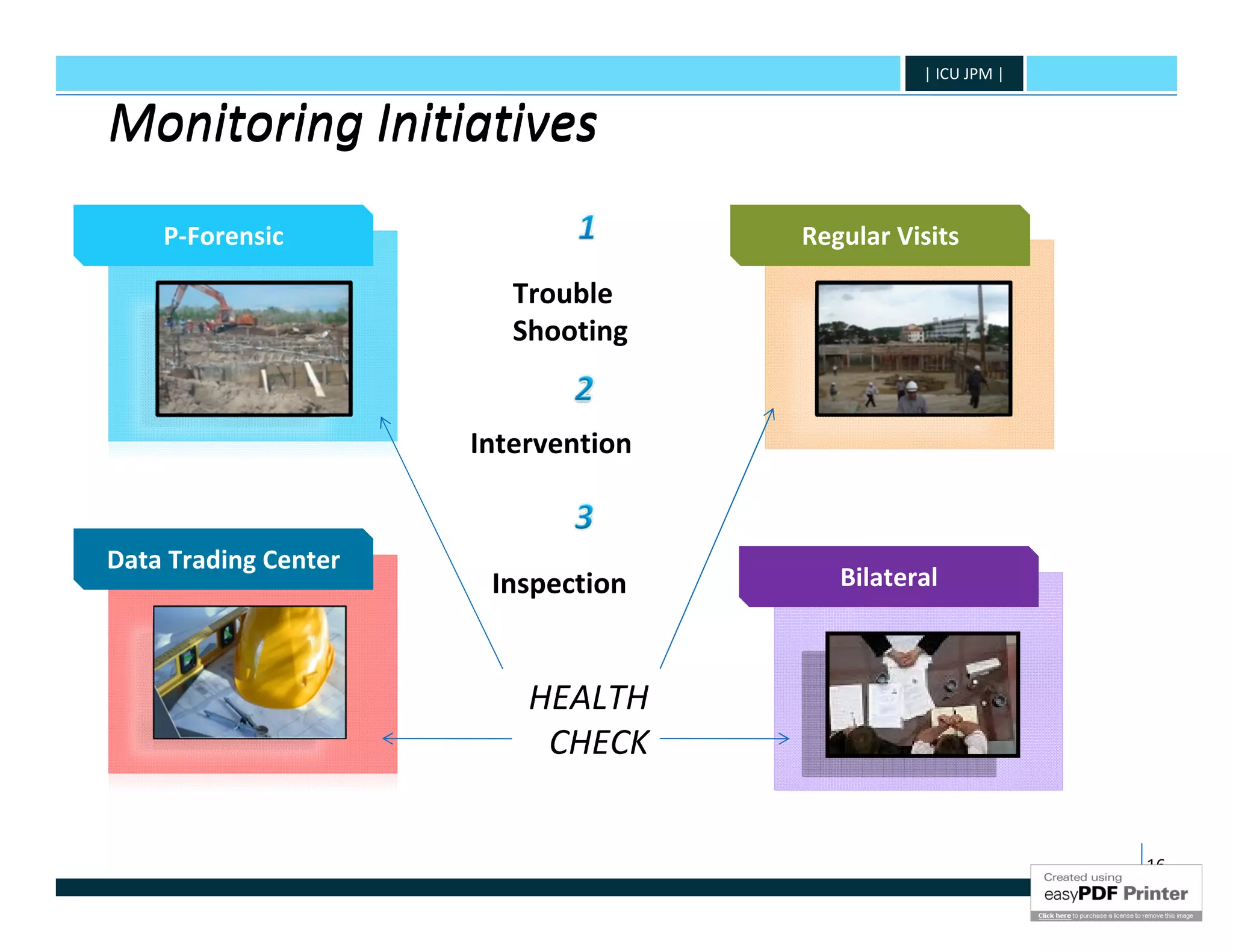

Monitoring Initiatives
    P-Forensic                       Regular Visits

                         Trouble
                         Shooting

                      Intervention

Data Trading Center
                       Inspection       Bilateral

                          HEALTH
                           CHECK

                                                             16
| ICU JPM |

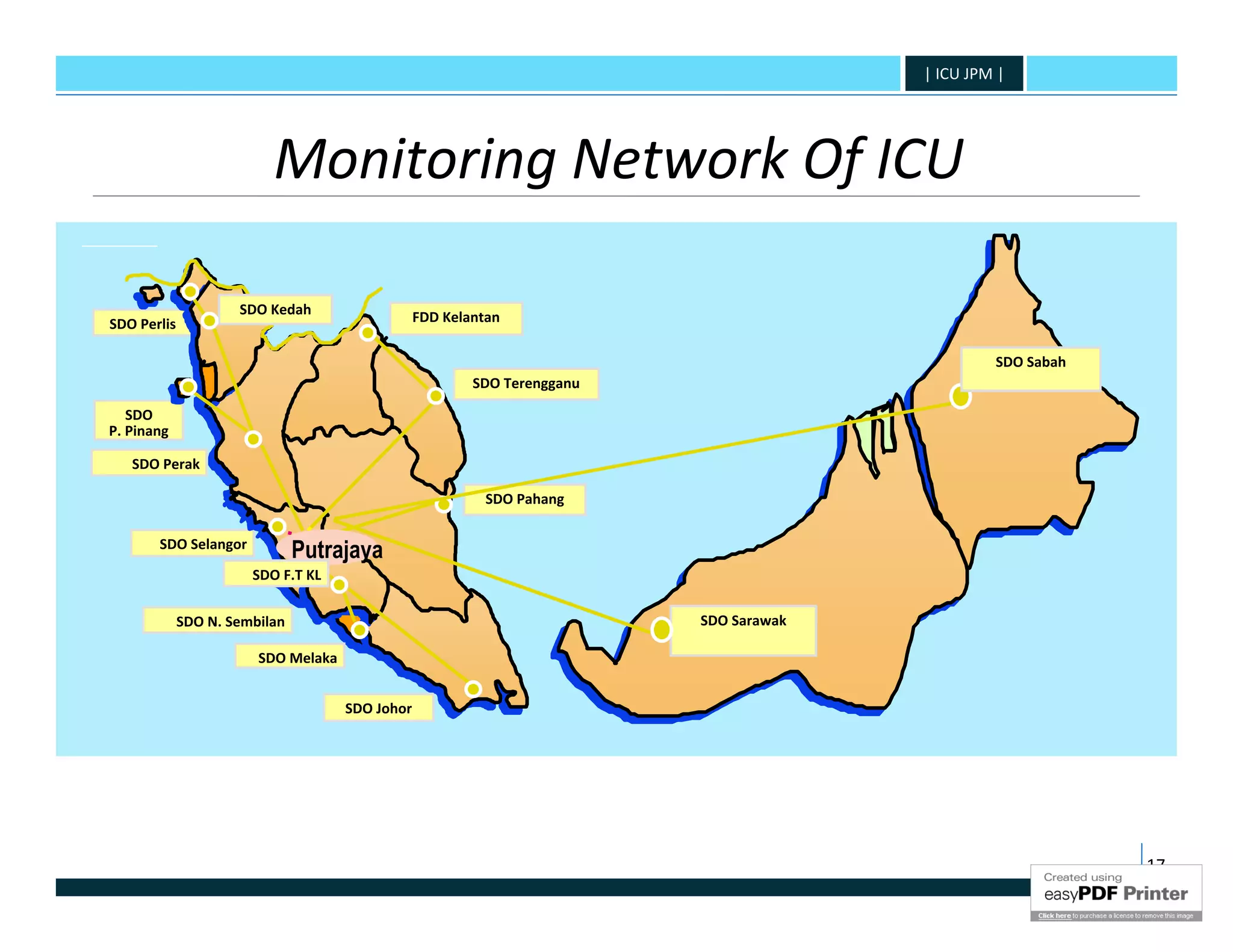

                          Monitoring Network Of ICU

                     SDO Kedah                   FDD Kelantan
SDO Perlis

                                                                                                 SDO Sabah
                                                         SDO Terengganu

   SDO
P. Pinang

   SDO Perak

                                                           SDO Pahang

       SDO Selangor
                               Putrajaya
                       SDO F.T KL

             SDO N. Sembilan                                              SDO Sarawak

                        SDO Melaka

                                     SDO Johor

                                                                                                             17
| ICU JPM |

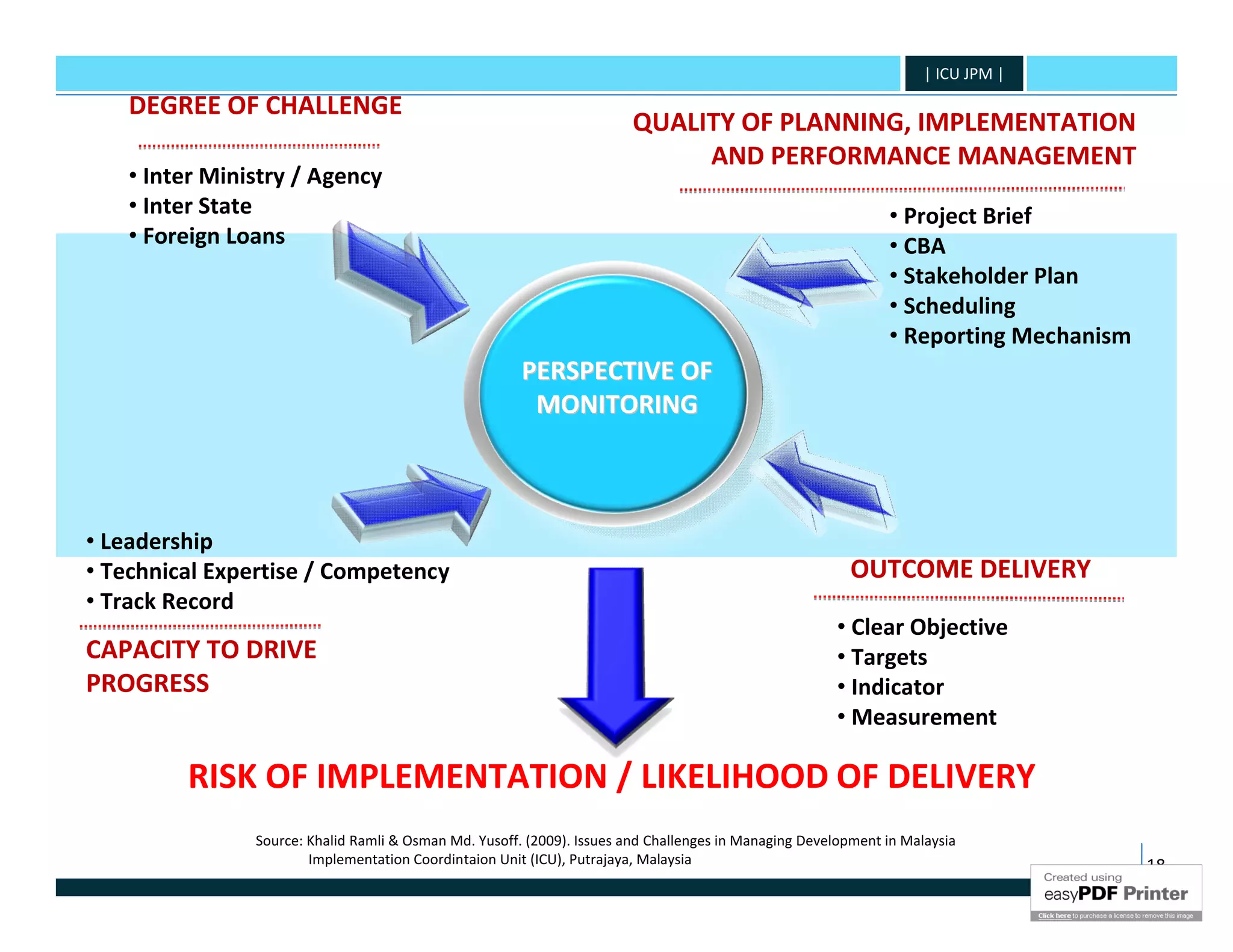

   DEGREE OF CHALLENGE
                                                                        QUALITY OF PLANNING, IMPLEMENTATION
                                                                             AND PERFORMANCE MANAGEMENT
   • Inter Ministry / Agency
   • Inter State                                                                                              • Project Brief
   • Foreign Loans                                                                                            • CBA
                                                                                                              • Stakeholder Plan
                                                                                                              • Scheduling
                                                                                                              • Reporting Mechanism
                                                       PERSPECTIVEOF
                                                        PERSPECTIVE OF
                                                         MONITORING
                                                        MONITORING

• Leadership
• Technical Expertise / Competency                                                                       OUTCOME DELIVERY
• Track Record
                                                                                                       • Clear Objective
CAPACITY TO DRIVE                                                                                      • Targets
PROGRESS                                                                                               • Indicator
                                                                                                       • Measurement

         RISK OF IMPLEMENTATION / LIKELIHOOD OF DELIVERY
               Source: Khalid Ramli & Osman Md. Yusoff. (2009). Issues and Challenges in Managing Development in Malaysia
                       Implementation Coordintaion Unit (ICU), Putrajaya, Malaysia                                                    18

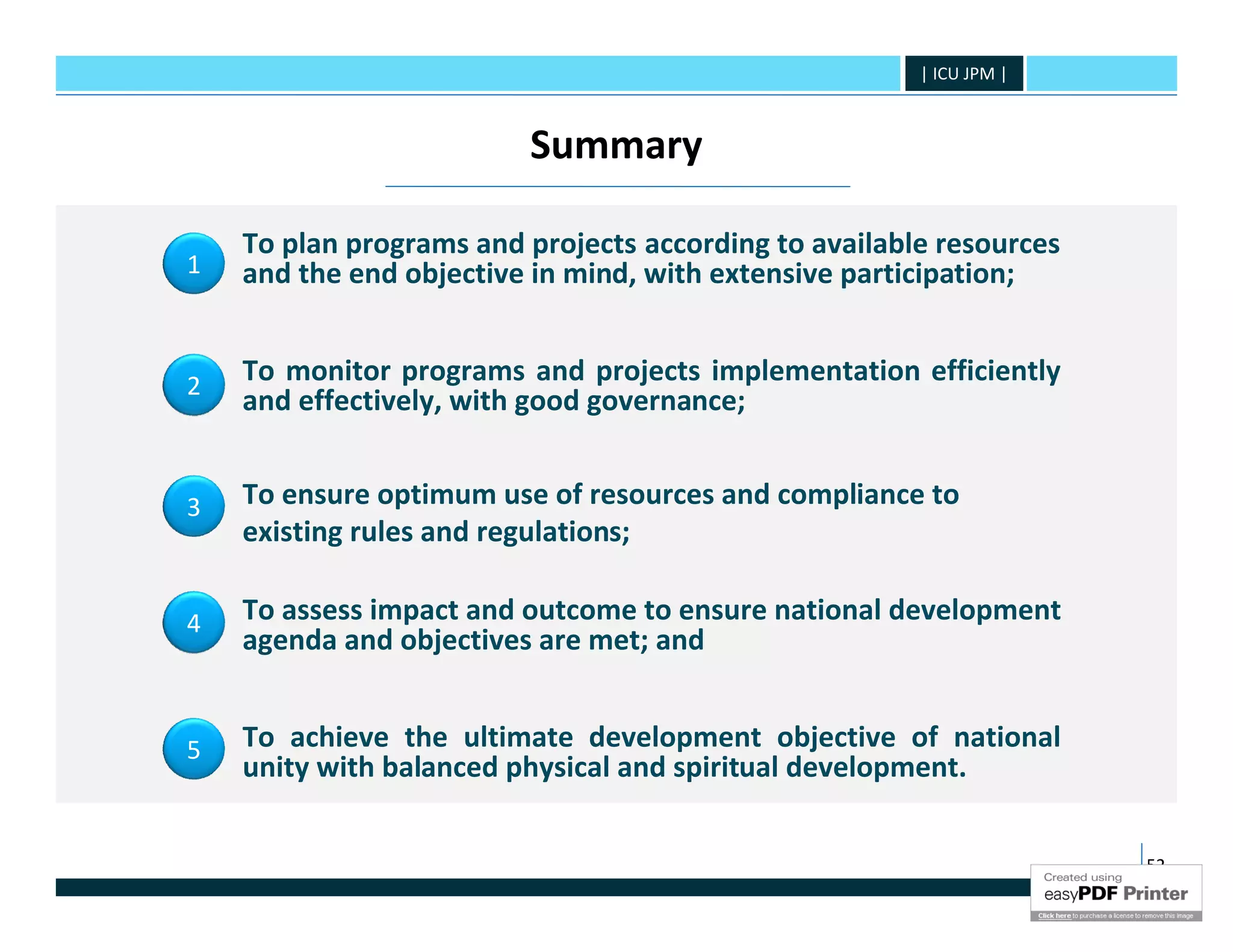

1 Malaysia, People First, Performance Now

         Delivering programs and projects in the context of
         current environment

        Meeting the Desired Outcome

        Projects must be delivered FAST

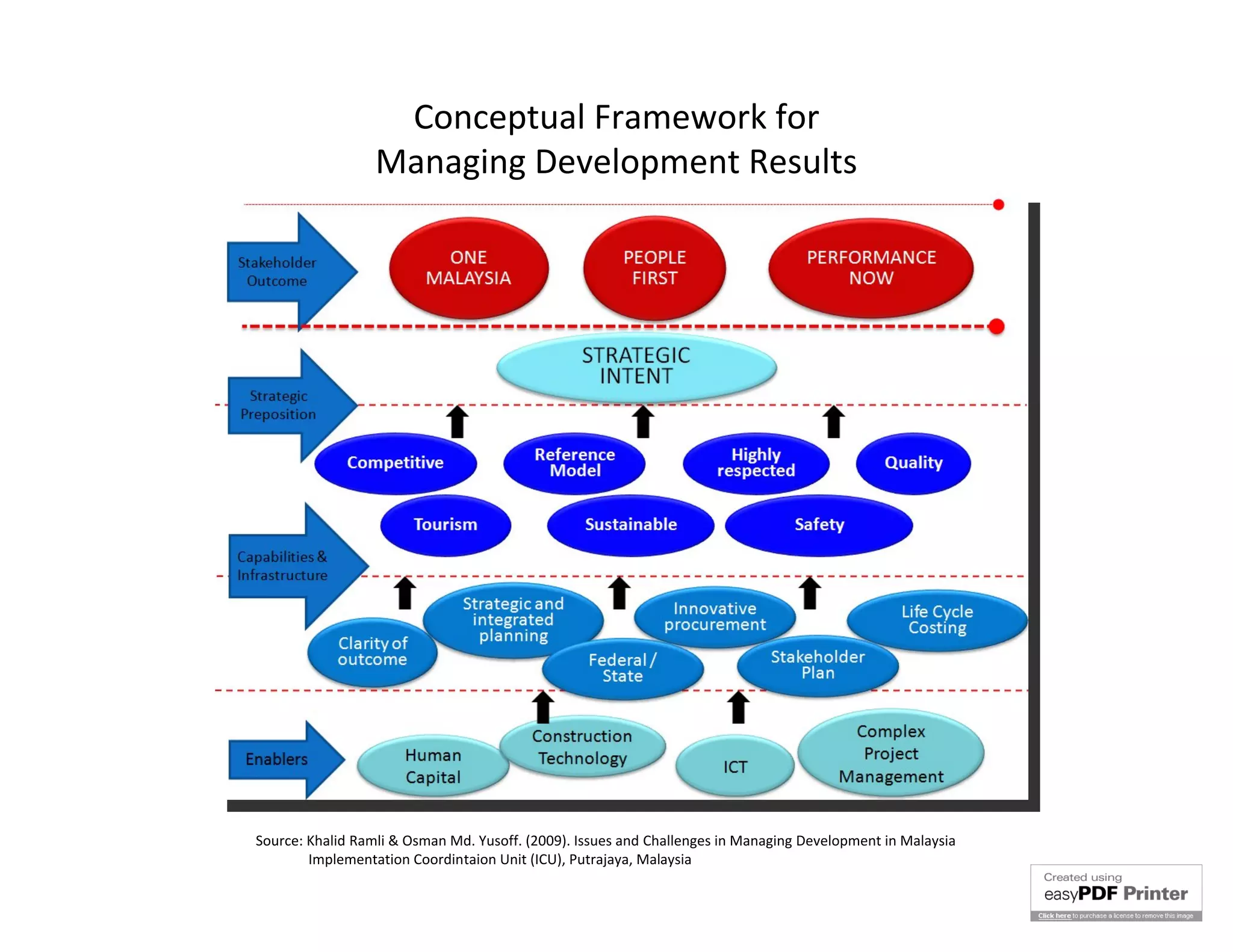

Conceptual Framework for
                  Managing Development Results

Source: Khalid Ramli & Osman Md. Yusoff. (2009). Issues and Challenges in Managing Development in Malaysia
        Implementation Coordintaion Unit (ICU), Putrajaya, Malaysia
Bu
                                      id
                                         i   ng
   Pro                                      M                                                                                                     me
 ex ject
                                               at
                                                 er                                                                                            tco ation

                                                                                                    er
   cee C                                Ex           ia                                                                                     O u lu

                                                                                                 th
        din ost                           -G           ls                                                                                       a
                                                                                                                                              Ev

                                                                                              ea
                                             ra

                                                                                            W
           gc                                   ti a
              eil                                                                                                                   ate
                  i ng                                                                                in
                                                                                                          g                     pri
Ph                                         Sit
                                               e                                                    nn                      p ro                    ost
   ysi
       cal
                                                              La
                                                                 nd                            Pl
                                                                                                  a           d          ap
                                                                                                                       In e                   ject C g
                                                                                                            re
           Ob
             sta                      Co                    Co                                         f er              Sit               Pro eedin
                                        ntr                                                         De                                      Exc ling

                                                                               T
                  cle                                          ns                                               ut

                                                                            EO
 De                    s                          ac              ul                                     go                         of
of
    la  y
     Tec s in P
                                                    to
                                                      r              ta              nt               din rder
                                                                                                                                 nt
                                                                                                                               me wn e
                                                                                                                                       r      Cei
        h n re p
                                                                       nt         rra                n
                                                                                                   ha O
                                                                                                                             e
                                                                                                                        ors by O
           ic a                                                               a                  in ent              End ign
               l Sp aratio            Tr e                                   W                 s                         s                   Ex-Gratia
                   ec i n                 spa                                               lay pm                    De ncy
                       fica                  sse            Utility                       De velo                       Ag
                                                                                                                           e                 Payment
                           t io
                               n                 rs                         Ceiling        De               e
                                                                                                          cop
                                      Allo                                                            ct S                      NOC
     Proje                                 cati
                                                on                                           Pr   oj e
          ct        Brief                                                                                                                      VOP

                                                                            Aw
                                                                                                                         Del
                                                                  ign

                                                                                                                            a
                                                                                                                       Neg ys in

                                                                             ar
                                                                 s

                                                                                                         VO
                                                              De

                                                                                d
                                       VOP                                                                                 o ti a
                                                                                                                                 tion
       Outcome
       Evaluation                                                                                                       Co                  Des
                                                  s                                                                   Cre ntrac                 ig   n
                                               er                                                                        dib tor

                                                                                              Co
                              n              rk                                                                              ilit ’s
                          tio

                                                                                                 m
                                       o
                       ala            W                                                                                          y

                                                                                                   pe
                                                      n
                                                  tio

                    sc

                                                                                                     te
               eE
                                               isi

                                                                                                                      Pr

                                                                                                       nc
           c
       Pri                                                                                                           M oje
                                             qu

                                                                                                          y
                                      Ac

                                                                                                                      an ct
                                                                                                                        ag
                                                                                                                           em
               ra o
                   or
             nt t t

                                                                                                                             en
                 ct
           Co n
         b- m e

                                                                                                                                t
       Su Pay
Apparent weaknesses
in project planning and management
               due to :-
        • Increase in number of
          projects
        • Nature & complexity of
          projects
        • Mega projects

                A drastic increase in the multitude and magnitude of
                projects being managed
                Need to strengthen Project Management within
                Ministries and Agencies
PROJECT MONITORING SYSTEM II
          (SPP II)
| ICU JPM |

                          HISTORY OF PROJECT MONITORING SYSTEMS IN MALAYSIA

                   2001                        SPP II                   8th & 9th MP
                 Scope covers complete lifecycle from Project Application to
                 Payment, with data capture at source

                1996                     SMBSS                                   7th MP
              Project Information : Financial & Physical Progress. Focus on Monitoring

            1991                    SIAP                                    6th MP
           Stand alone System. Focus on Physical Progress                5th MP
                                                                        4th MP
         1981                   SETIA
      Distributed Processing System. Focus on Financial Progress       3rd MP

     1971                PMS I                                   2nd MP
    Ministries and agencies sent Project Physical Progress in
    hard copy to ICU for central processing                   1st MP

                 RED BOOK                             2nd Malaya Plan
  1957                                           1st Malaya Plan
Project information were kept and updated in the RED Book
                                                                                            24
                                                                                          24
| ICU JPM |

               Panduan Rancangan Buku
               Hijau

The Red Book
                                        25
| ICU JPM |

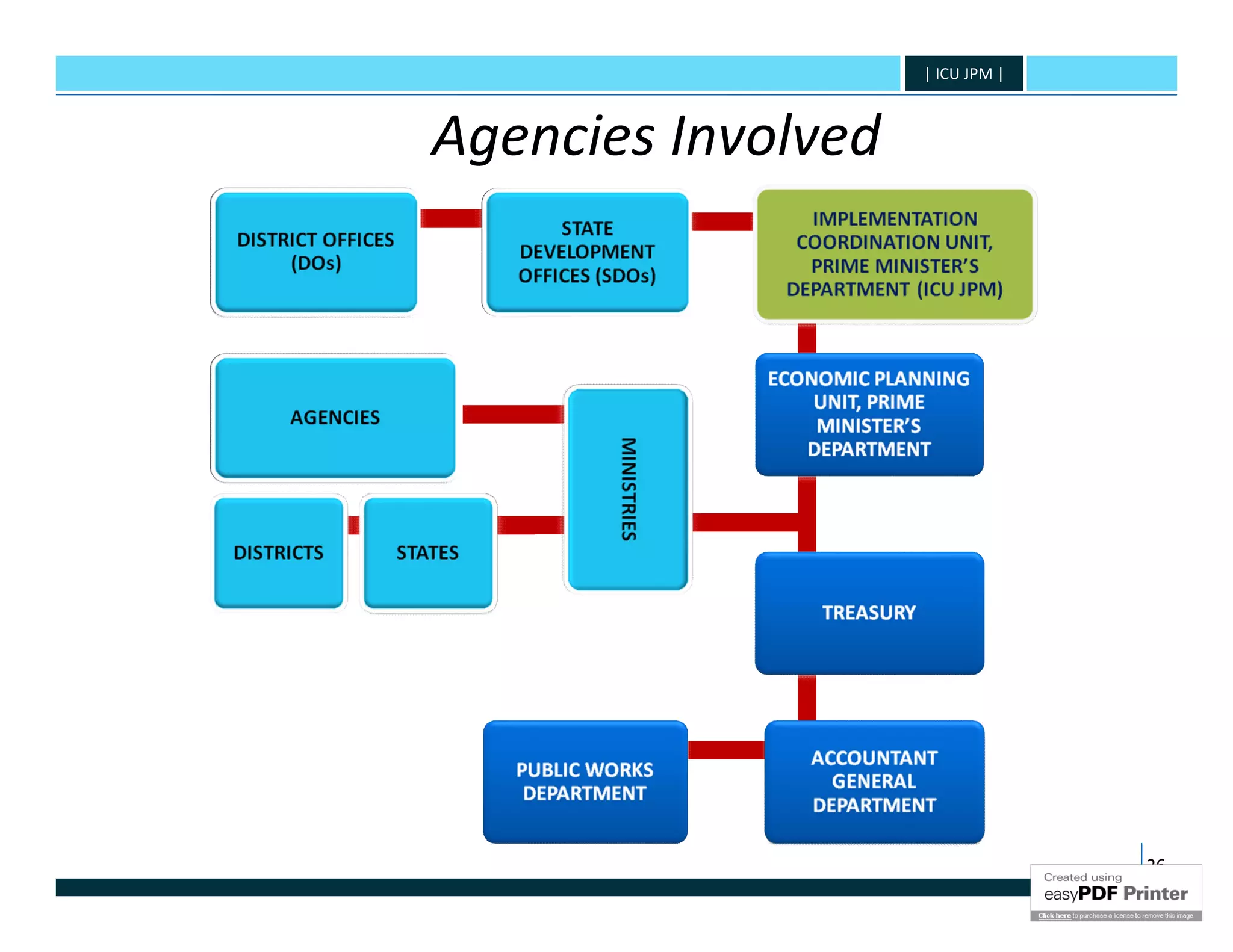

Agencies Involved

                                  26
| ICU JPM |

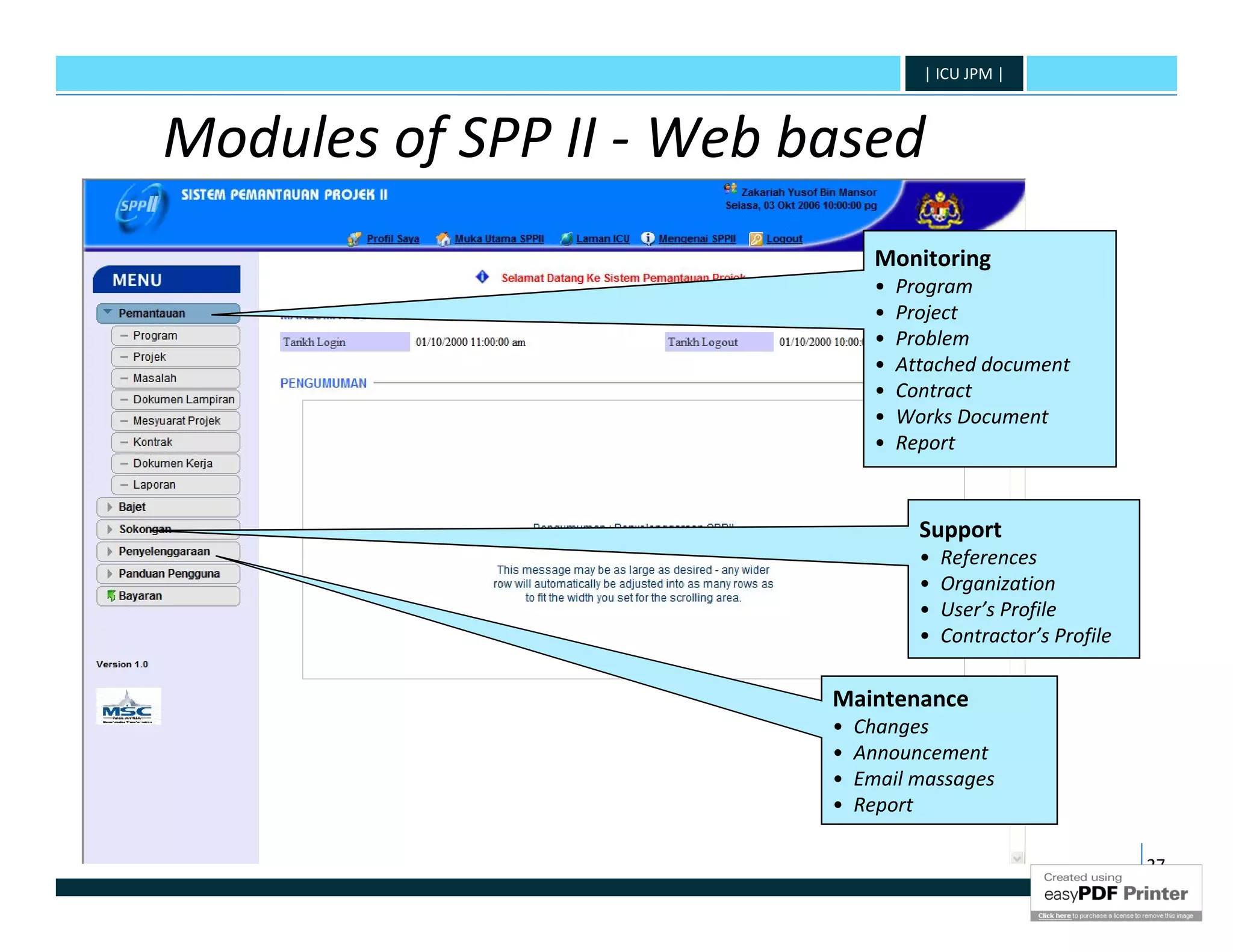

Modules of SPP II - Web based
                               Monitoring
                               •   Program
                               •   Project
                               •   Problem
                               •   Attached document
                               •   Contract
                               •   Works Document
                               •   Report

                                     Support
                                     •   References
                                     •   Organization
                                     •   User’s Profile
                                     •   Contractor’s Profile

                         Maintenance
                         •   Changes
                         •   Announcement
                         •   Email massages
                         •   Report

                                                                27
| ICU JPM |

              28
| ICU JPM |

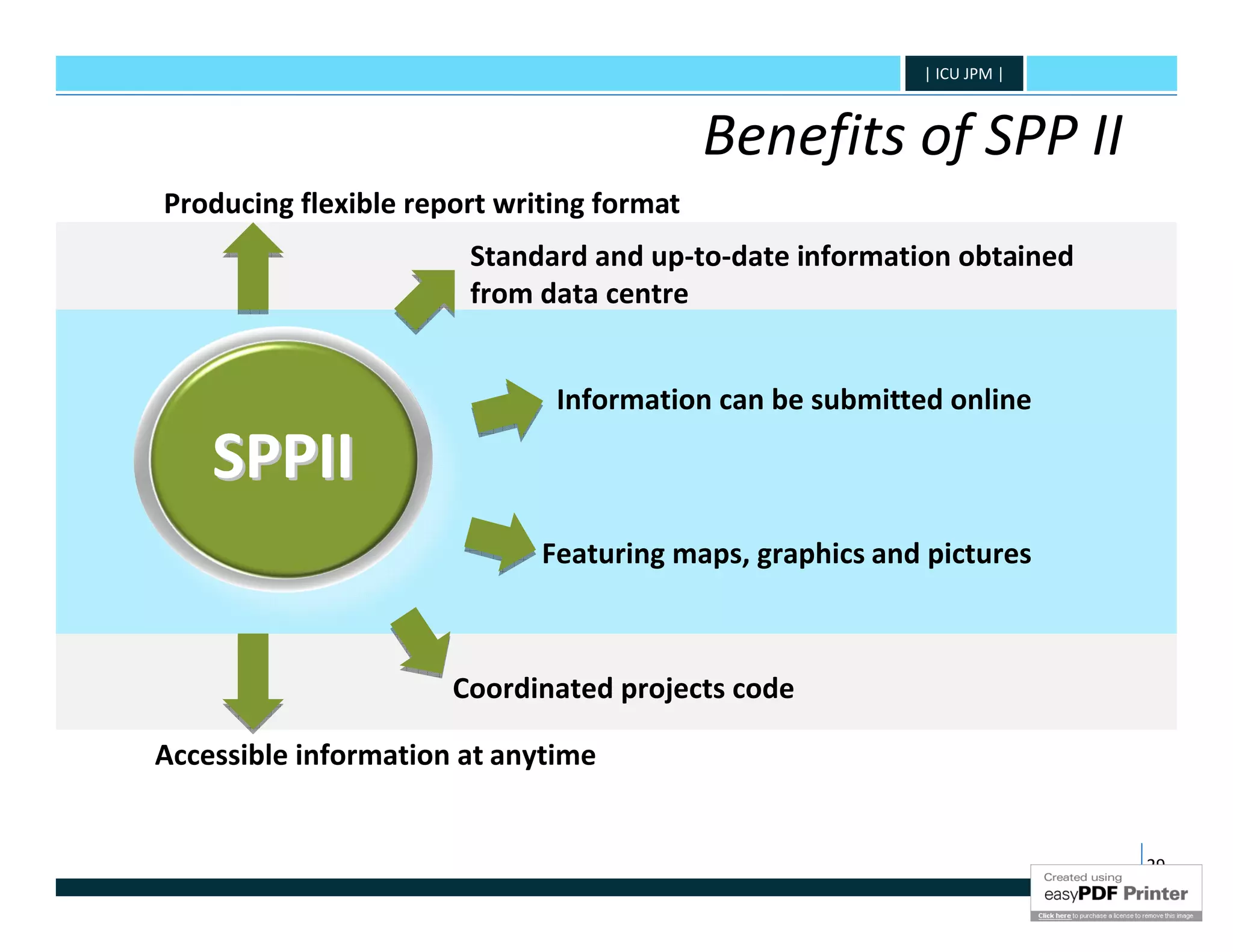

                                           Benefits of SPP II
Producing flexible report writing format
                       Standard and up-to-date information obtained
                       from data centre

                              Information can be submitted online

    SPPII
                             Featuring maps, graphics and pictures

                      Coordinated projects code

Accessible information at anytime

                                                                       29
OUTCOME MONITORING
| ICU JPM |

OUTCOME & RESULT BASED MONITORING

       “No Use Of Projects Without
       Delivering Desired Outcome”
                            Tun Abdullah Badawi

       “Emphasis – Outcome Not Output”
                              Dato’ Seri Najib Tun Razak

                                                           31

OBJECTIVES OF OUTCOME BASED
                MONITORING

To evaluate the effectiveness of
programs/projects to the target group

To assist management in
making balanced decisions                       To develop corrective actions in
                                                overcoming issues relating to
                                                unachievable desired outcomes

                                    Central agencies will distribute resources to
                                    ministries based on the real outcomes achieved by
                                    programs/projects
| ICU JPM |

Evaluation’s Chain

                         33
| ICU JPM |

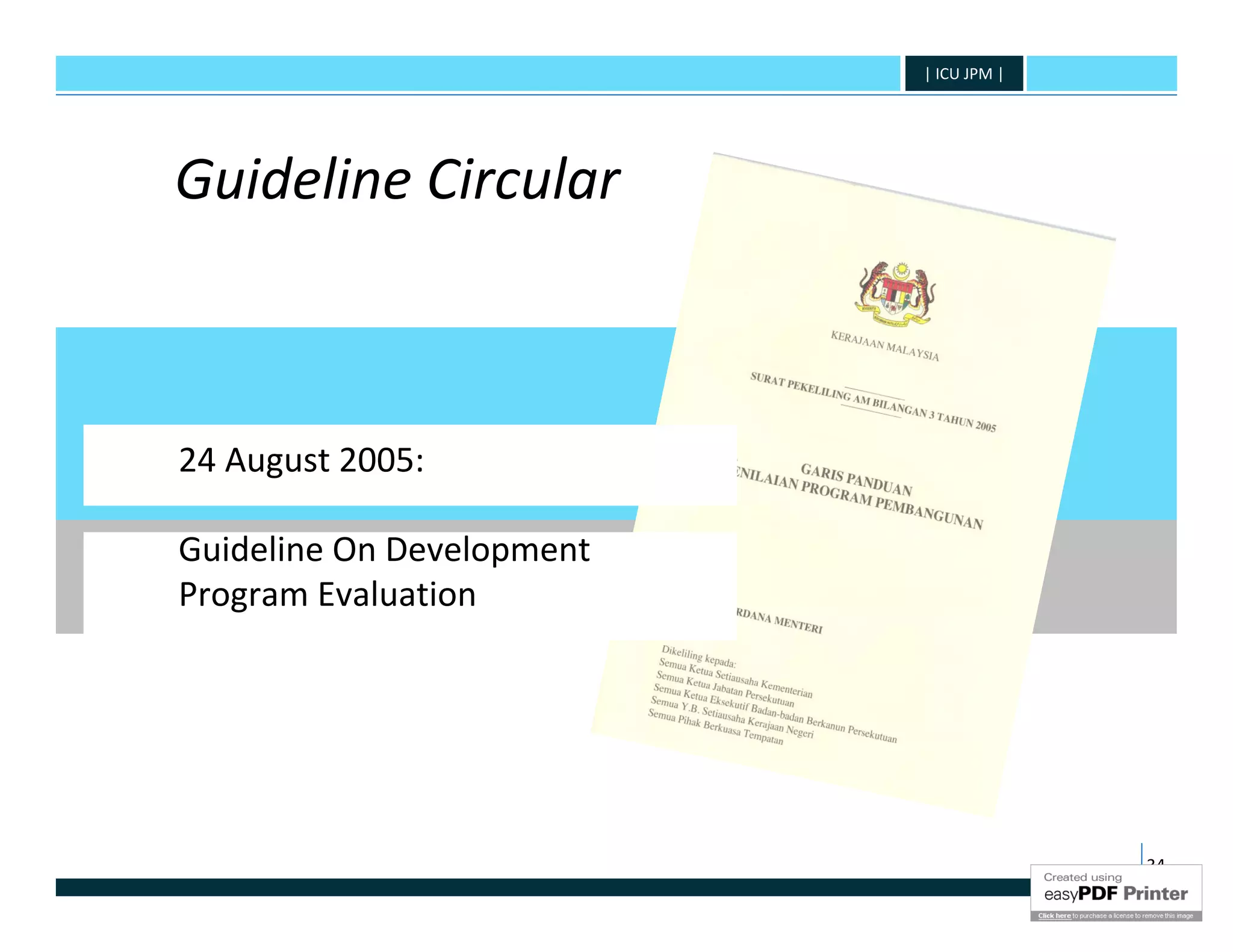

Guideline Circular

24 August 2005:

Guideline On Development
Program Evaluation

                                         34
| ICU JPM |

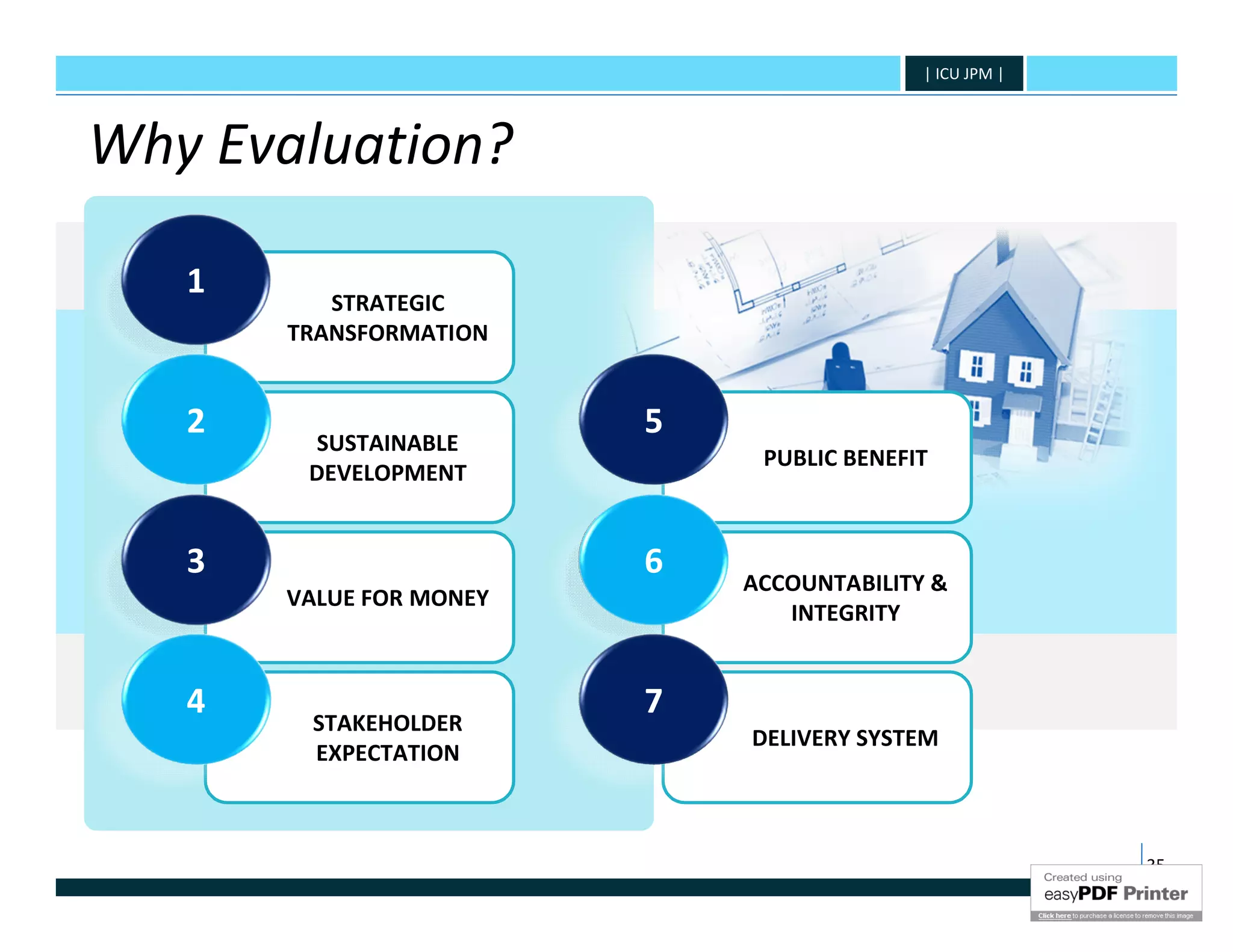

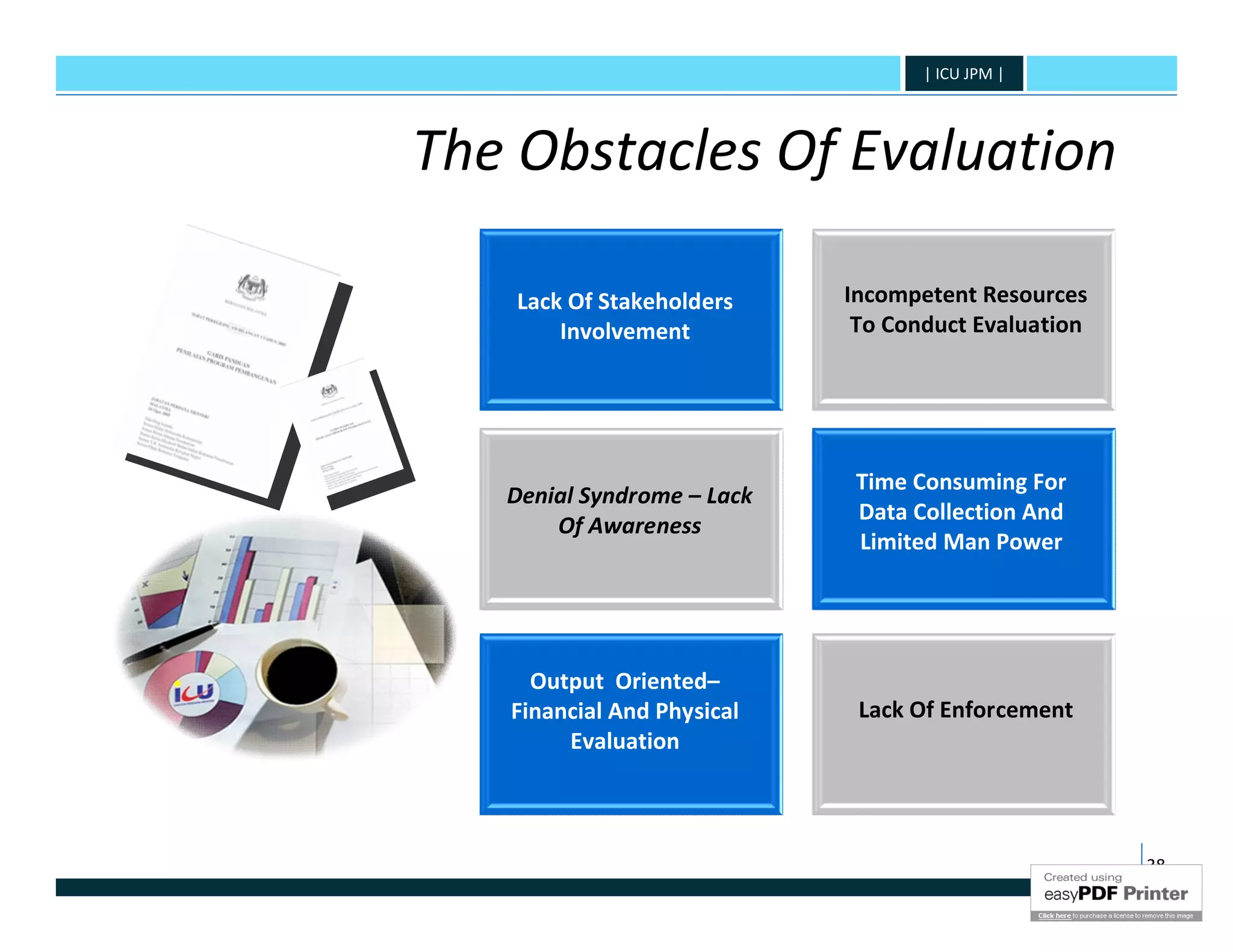

Why Evaluation?

   1      STRATEGIC
       TRANSFORMATION

   2     SUSTAINABLE
                         5
                              PUBLIC BENEFIT
        DEVELOPMENT

   3                     6   ACCOUNTABILITY &
       VALUE FOR MONEY
                                INTEGRITY

   4    STAKEHOLDER
                         7
                             DELIVERY SYSTEM
        EXPECTATION

                                                         35
| ICU JPM |

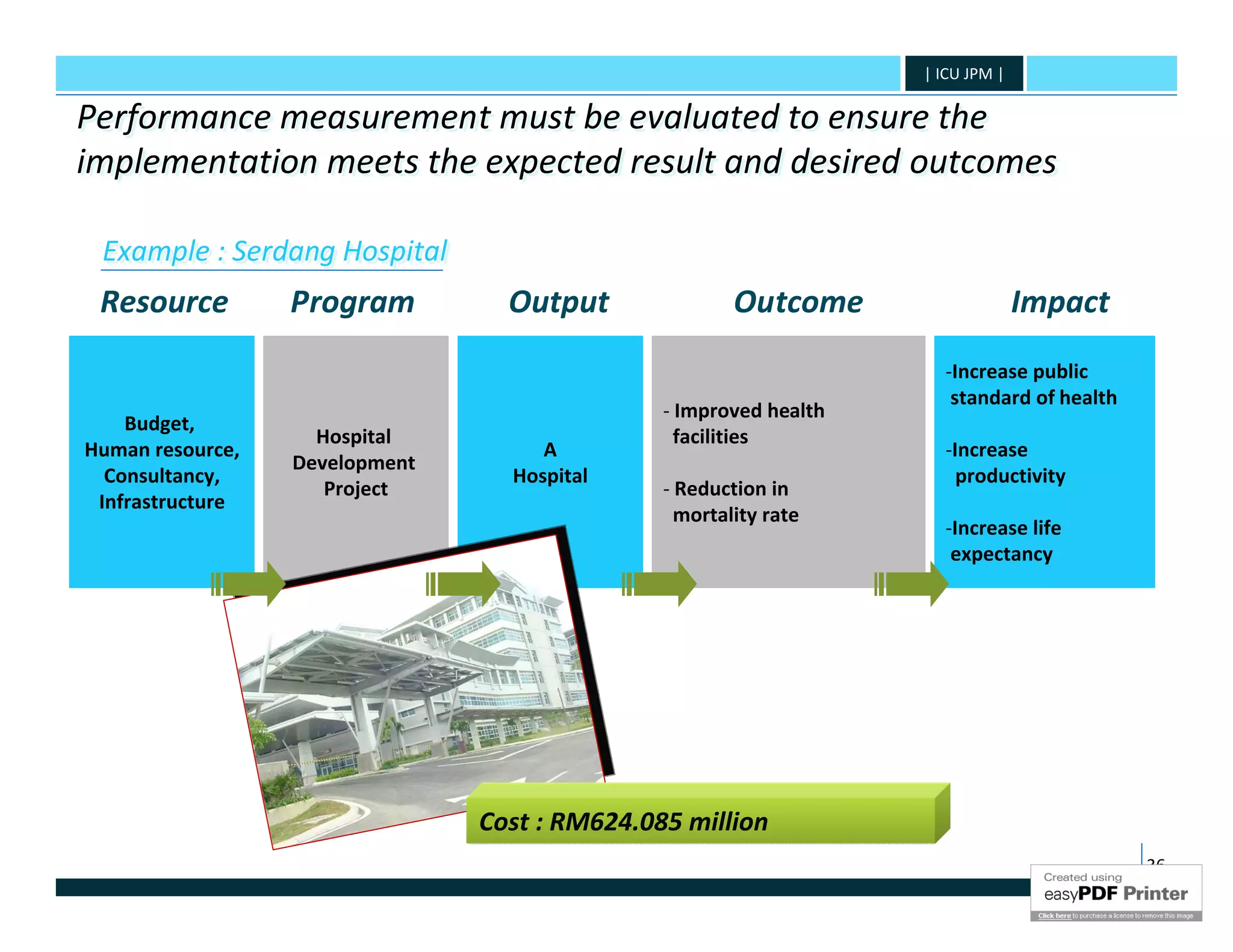

Performance measurement must be evaluated to ensure the
implementation meets the expected result and desired outcomes

 Example :: Serdang Hospital
 Example Serdang Hospital
 Resource         Program         Output               Outcome                   Impact
                                                                     -Increase public
                                                                      standard of health
                                               - Improved health
    Budget,
                    Hospital                     facilities
Human resource,                      A                               -Increase
                  Development
  Consultancy,                    Hospital                             productivity
                     Project                   - Reduction in
 Infrastructure
                                                 mortality rate
                                                                     -Increase life
                                                                      expectancy

                                Cost : RM624.085 million
                                                                                           36
| ICU JPM |

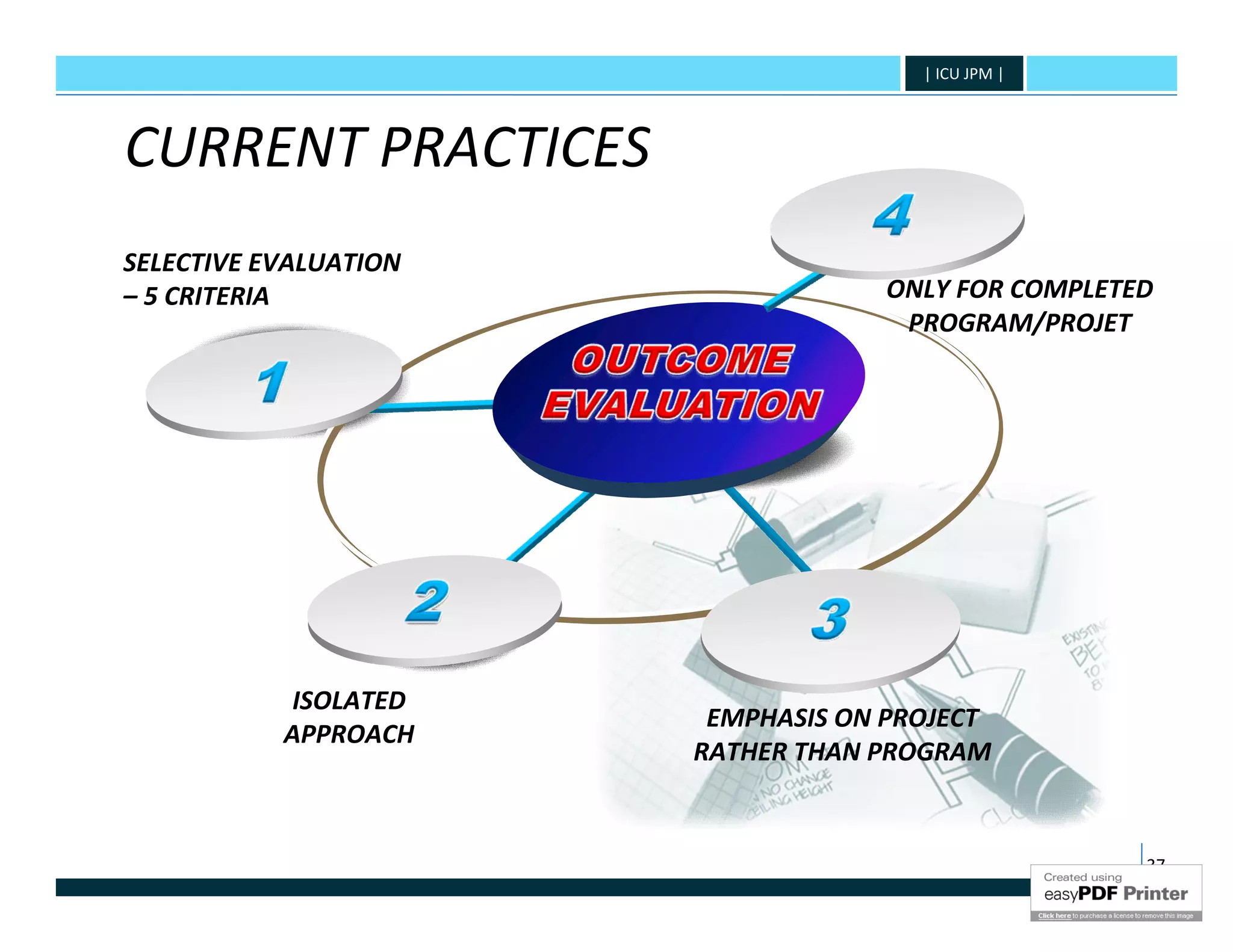

CURRENT PRACTICES
SELECTIVE EVALUATION
– 5 CRITERIA                       ONLY FOR COMPLETED
                                    PROGRAM/PROJET

            ISOLATED
                        EMPHASIS ON PROJECT
           APPROACH
                       RATHER THAN PROGRAM

                                                    37
| ICU JPM |

The Obstacles Of Evaluation

    Lack Of Stakeholders    Incompetent Resources
        Involvement          To Conduct Evaluation

                             Time Consuming For
   Denial Syndrome – Lack
                             Data Collection And
       Of Awareness
                             Limited Man Power

     Output Oriented–
   Financial And Physical    Lack Of Enforcement
        Evaluation

                                                     38
| ICU JPM |

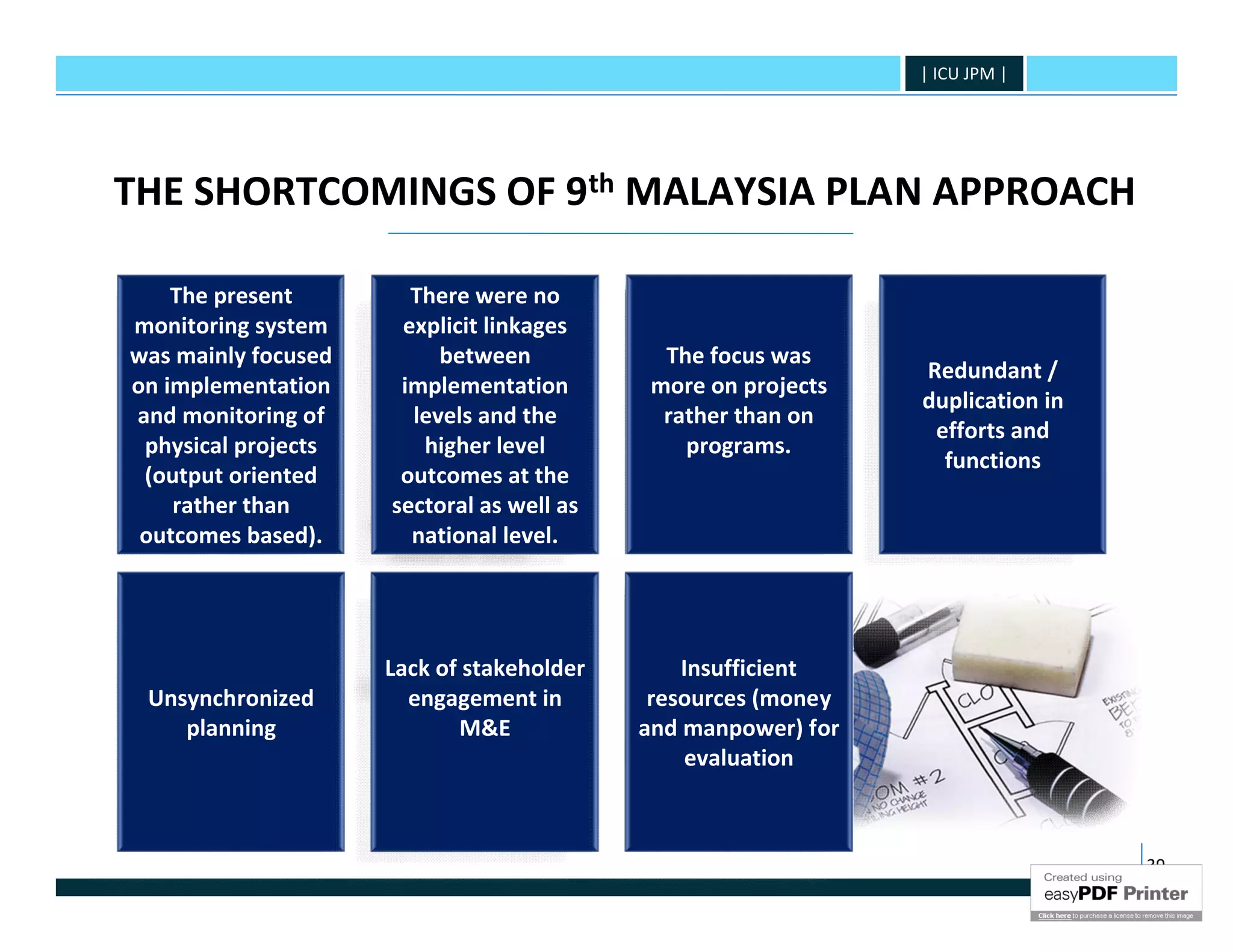

THE SHORTCOMINGS OF 9th MALAYSIA PLAN APPROACH

    The present        There were no
monitoring system     explicit linkages
was mainly focused        between            The focus was
                                                               Redundant /
on implementation     implementation        more on projects
                                                               duplication in
and monitoring of      levels and the        rather than on
                                                                efforts and
 physical projects      higher level           programs.
                                                                 functions
 (output oriented     outcomes at the
    rather than      sectoral as well as
 outcomes based).      national level.

                     Lack of stakeholder       Insufficient
 Unsynchronized        engagement in        resources (money
    planning                M&E            and manpower) for
                                                evaluation

                                                                                39
| ICU JPM |

TRANSFORMATION OF 10th Malaysia Plan

                     N
                IO
         U   AT                  Setting the vision
       AL
     EV

                                                                         PLA
                                        A

                                                                            NN
                                                                              ING
                                                               Defining the
   Managing and
                                                             results map and
  using evaluation
                         E                                 B       RBM
                                                               Framework
                                  Stakeholder
                                  participation

      Implementing                                       Planning for
        and using                                     C monitoring and
                             D
       monitoring                                         evaluation

                             MONI
                                 TO   RING
                                                                           * Source : UNDP 2009   40
| ICU JPM |

                             The RBM Results Chain
        How?                            What do we want?                                  Why?
    INPUTS            ACTIVITIES             OUTPUTS              OUTCOMES                  IMPACT

                                                                                      Actual or intended
                                                                 The short-term
  The financial,       Action taken                                                   changes in human
                                            The products,       and medium-term
   human and          through which                                                     development as
                                          capital goods and        effects of an
material resources      inputs are                                                       measured by
                                         services that result     intervention's
    used for           mobilized to                                                      people’s well-
                                         from development       outputs; change in
  development        produce specific                                                       being;
                                            interventions          development
  intervention           outputs                                                       improvements in
                                                                    conditions
                                                                                         people’s lives

              Resources                                              Result

                                            PLANNING
                                         IMPLEMENTATION

                                                                                                           41
| ICU JPM |

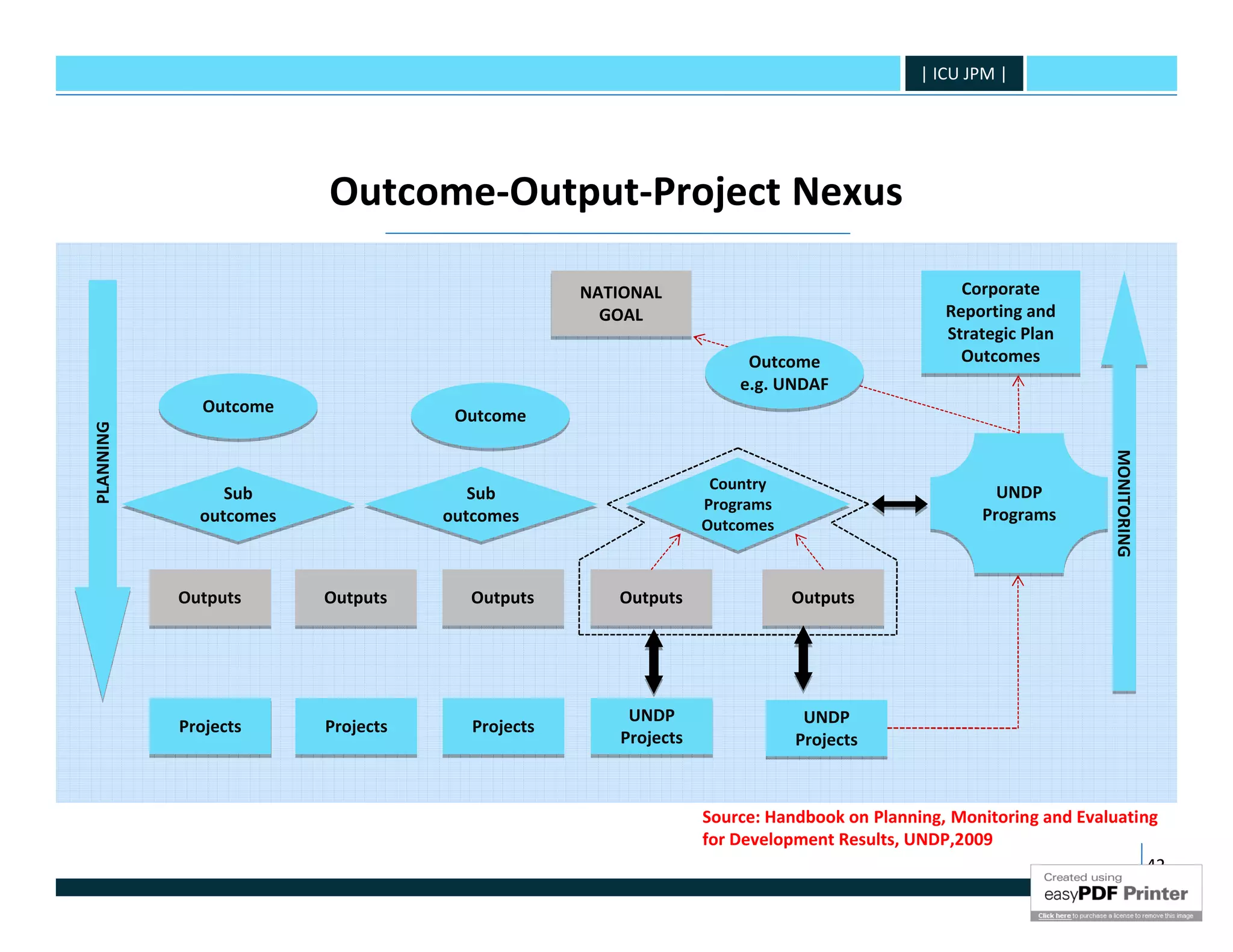

                        Outcome-Output-Project Nexus

                                                 NATIONAL                                     Corporate
                                                   GOAL                                     Reporting and
                                                                                            Strategic Plan
                                                                    Outcome                   Outcomes
                                                                   e.g. UNDAF
              Outcome               Outcome
PLANNING
PLANNING

                                                                                                                MONITORING
                                                                                                                MONITORING
                                                                Country
                Sub                   Sub                                                         UNDP
                                                               Programs
             outcomes              outcomes                                                     Programs
                                                               Outcomes

           Outputs      Outputs      Outputs        Outputs               Outputs

                                                     UNDP                  UNDP
           Projects     Projects      Projects
                                                    Projects              Projects

                                                               Source: Handbook on Planning, Monitoring and Evaluating
                                                               for Development Results, UNDP,2009
                                                                                                                     42
| ICU JPM |

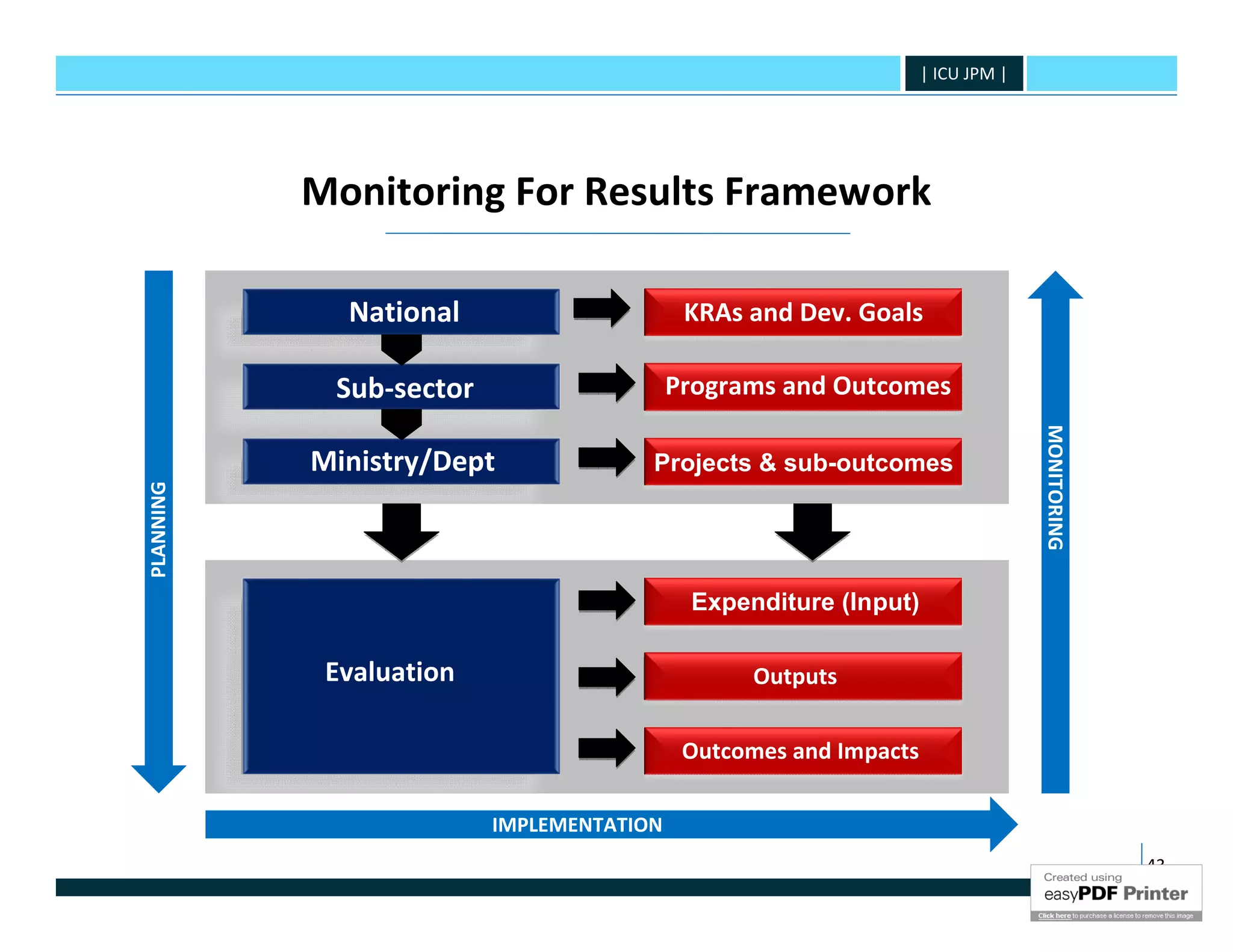

           Monitoring For Results Framework

             National                      KRAs and Dev. Goals

            Sub-sector                    Programs and Outcomes

                                                                                MONITORING
           Ministry/Dept              Projects & sub-outcomes
PLANNING

                                           Expenditure (Input)

            Evaluation                           Outputs

                                           Outcomes and Impacts

                         IMPLEMENTATION
                                                                                             43
| ICU JPM |

            Outcome Based Monitoring
                      Outcome Not Output

1   Clear Objective

      2       Specific Target Group

               3        Desired Outcome

                         4      KRA

                                      5   KPI

                                            6   Measurement

                                                7       Enforcement

                                                                      44
| ICU JPM |

                       Desired Outcome

                            Measurable
                              KPIs
             KPIs Clearly                 Reporting
              Defined                    Framework

   Set                 Measurement                    Realistic
Objectives                                            Targets
                          Tools

                  KPI FRAMEWORK                                                 45
| ICU JPM |

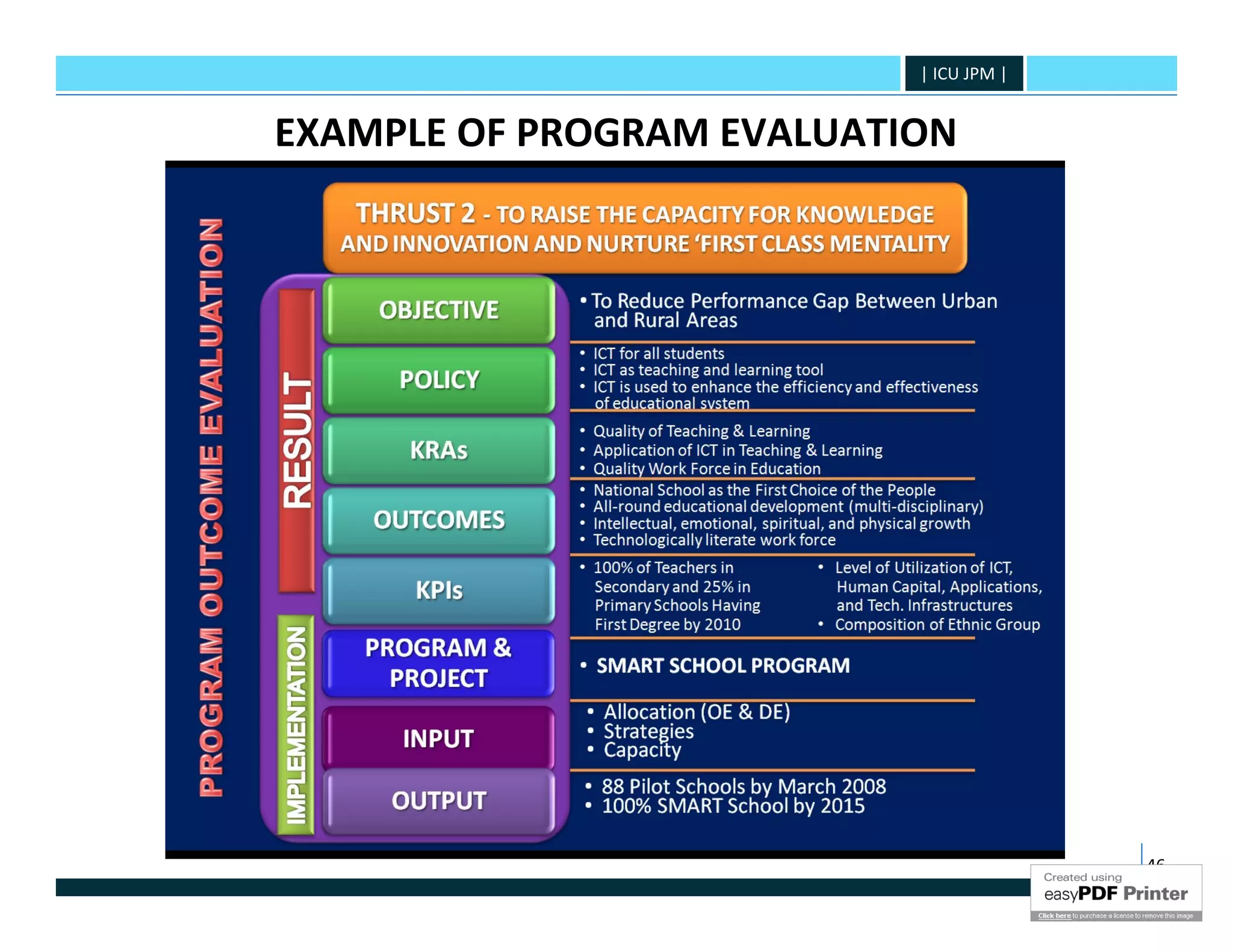

EXAMPLE OF PROGRAM EVALUATION

                                         46
| ICU JPM |

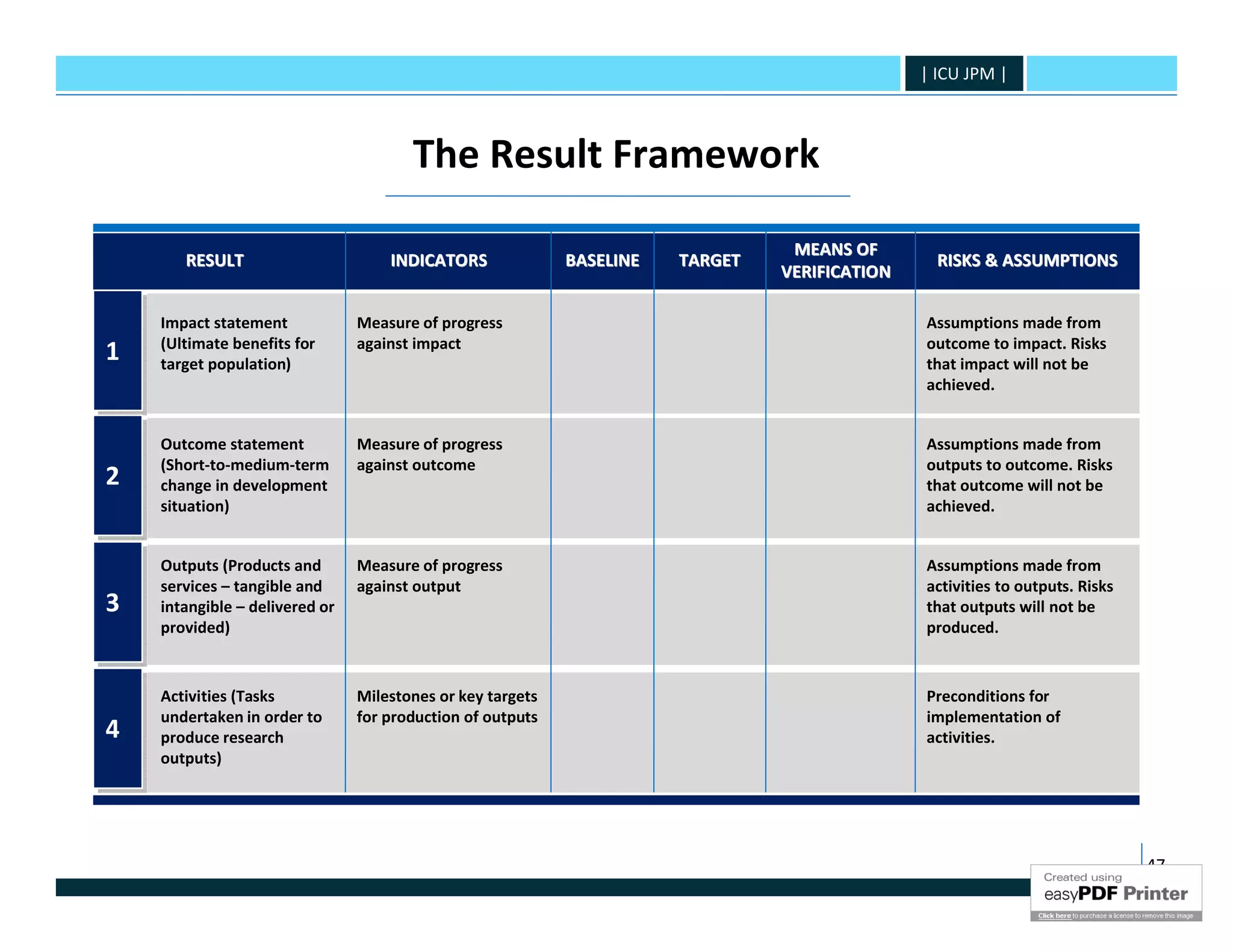

                                       The Result Framework

                                                                                 MEANS OF
       RESULT                       INDICATORS              BASELINE   TARGET                    RISKS & ASSUMPTIONS
                                                                                VERIFICATION

    Impact statement            Measure of progress                                            Assumptions made from
    (Ultimate benefits for      against impact                                                 outcome to impact. Risks
1
1   target population)                                                                         that impact will not be
                                                                                               achieved.

    Outcome statement           Measure of progress                                            Assumptions made from
    (Short-to-medium-term       against outcome                                                outputs to outcome. Risks
2
2   change in development                                                                      that outcome will not be
    situation)                                                                                 achieved.

    Outputs (Products and       Measure of progress                                            Assumptions made from
    services – tangible and     against output                                                 activities to outputs. Risks
3
3   intangible – delivered or                                                                  that outputs will not be
    provided)                                                                                  produced.

    Activities (Tasks           Milestones or key targets                                      Preconditions for
    undertaken in order to      for production of outputs                                      implementation of
4
4   produce research                                                                           activities.
    outputs)

                                                                                                                              47
| ICU JPM |

Example of an Annual Work Plan format with monitoring component

                                                               48
| ICU JPM |

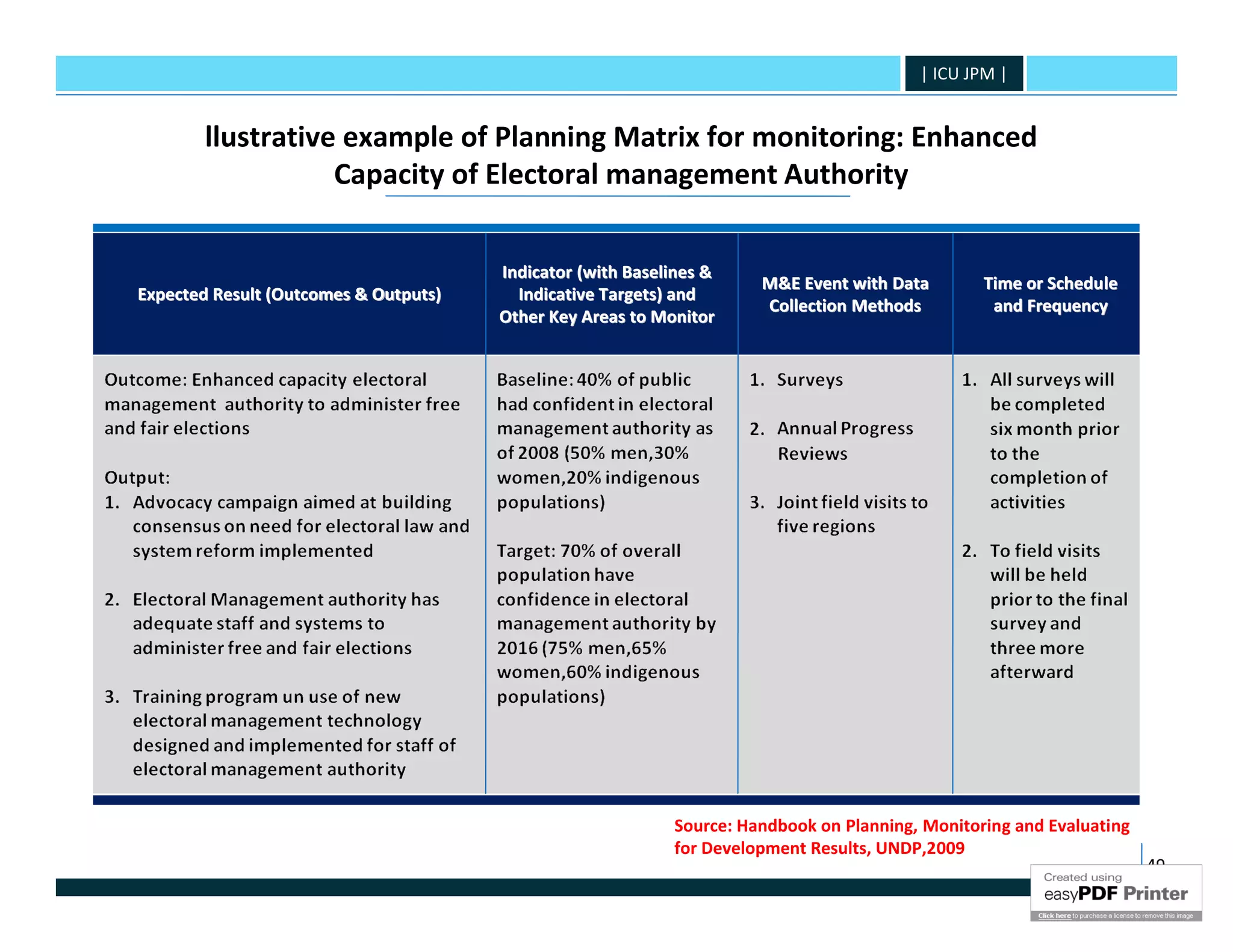

       llustrative example of Planning Matrix for monitoring: Enhanced
                  Capacity of Electoral management Authority

                                       Indicator (with Baselines &
                                                                      M&E Event with Data        Time or Schedule
Expected Result (Outcomes & Outputs)     Indicative Targets) and
                                                                      Collection Methods          and Frequency
                                       Other Key Areas to Monitor

                                                            Source: Handbook on Planning, Monitoring and Evaluating
                                                            for Development Results, UNDP,2009
                                                                                                                      49
| ICU JPM |

     Illustrative example of Planning Matrix for monitoring:

                       Mean of Verification:
Responsibilities                                       Resources                   Risks
                       Data Source and Type

                                        Source: Handbook on Planning, Monitoring and Evaluating
                                        for Development Results, UNDP,2009
                                                                                                  50
| ICU JPM |

                         Summary

    To plan programs and projects according to available resources
1   and the end objective in mind, with extensive participation;

2
    To monitor programs and projects implementation efficiently
    and effectively, with good governance;

3   To ensure optimum use of resources and compliance to
    existing rules and regulations;

4   To assess impact and outcome to ensure national development
    agenda and objectives are met; and

5   To achieve the ultimate development objective of national
    unity with balanced physical and spiritual development.

                                                                     52
Implementation Coordination Unit
  Prime Minister’s Department
      Putrajaya, Malaysia
| ICU JPM |

To be the premier central agency in
   coordinating and monitoring for
              ensuring an effective
        implementation of national
           development programs.

                                     54
| ICU JPM |

Synergizing the nation’s developments
    through coordination, monitoring,
  evaluation of policies, programs and
     projects implementation through
   excellent working culture and good
                           governance.

                                      55
| ICU JPM |

      Malaysia’s Development Efforrts
                         The New Economic Policy                    1971 - 1990
3 National Policies      The National Development Policy            1991 - 2000
                         The National Vision Policy                 2001 - 2010

                        OPP 1                                       1971 - 1990
3 Outline Perspective   OPP 2                                       1991 - 2000
    Plans (OPP)         OPP 3                                       2001 - 2010

                        1957 - 2006
      10 Five-year
   Development Plans

                                                                                  57
| ICU JPM |

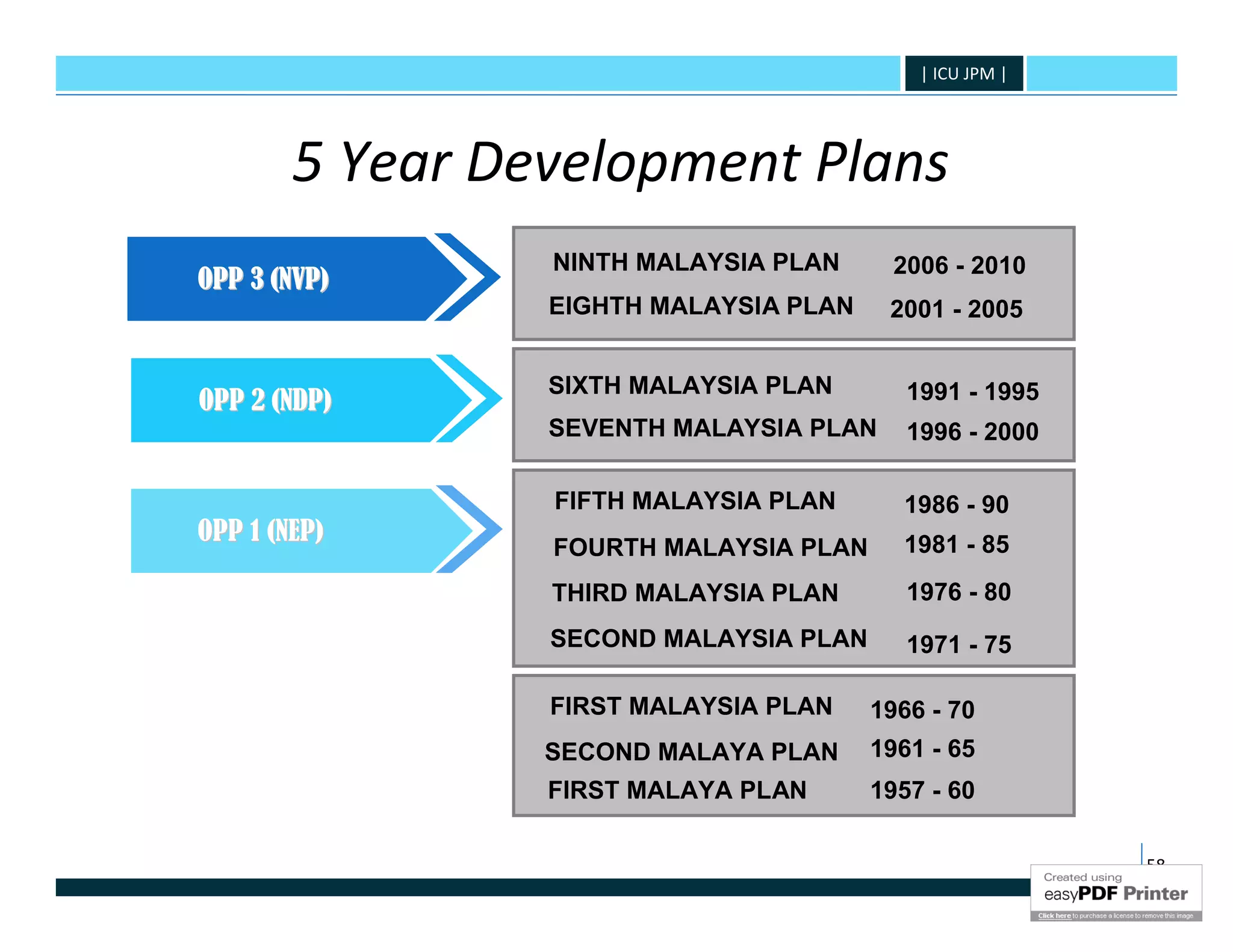

        5 Year Development Plans
                 NINTH MALAYSIA PLAN     2006 - 2010
OPP 3 (NVP)
                 EIGHTH MALAYSIA PLAN    2001 - 2005

                 SIXTH MALAYSIA PLAN       1991 - 1995
OPP 2 (NDP)
                 SEVENTH MALAYSIA PLAN     1996 - 2000

                 FIFTH MALAYSIA PLAN      1986 - 90
OPP 1 (NEP)                               1981 - 85
                 FOURTH MALAYSIA PLAN
                 THIRD MALAYSIA PLAN       1976 - 80
                 SECOND MALAYSIA PLAN      1971 - 75

                 FIRST MALAYSIA PLAN    1966 - 70
                 SECOND MALAYA PLAN     1961 - 65
                 FIRST MALAYA PLAN      1957 - 60

                                                          58
| ICU JPM |

                     Development Cycle
                                 Planning
                         ‘a deliberate, comprehensive time
                       specific effort, initiated and sustained
                    by the central government for the purpose
                    of creating and maintaining conditions that
                    will accelerate economic growth and social
                            development in the country’

          Evaluation                                Implementation
 ‘analytical assessments addressing results      ‘carry into effect planned policies
of public policies, organizations or programs    that are translated into programs
that emphasize reliability and usefulness of                and projects’
findings to improve information and reduce
                 uncertainty’

                                                                                       59
| ICU JPM |

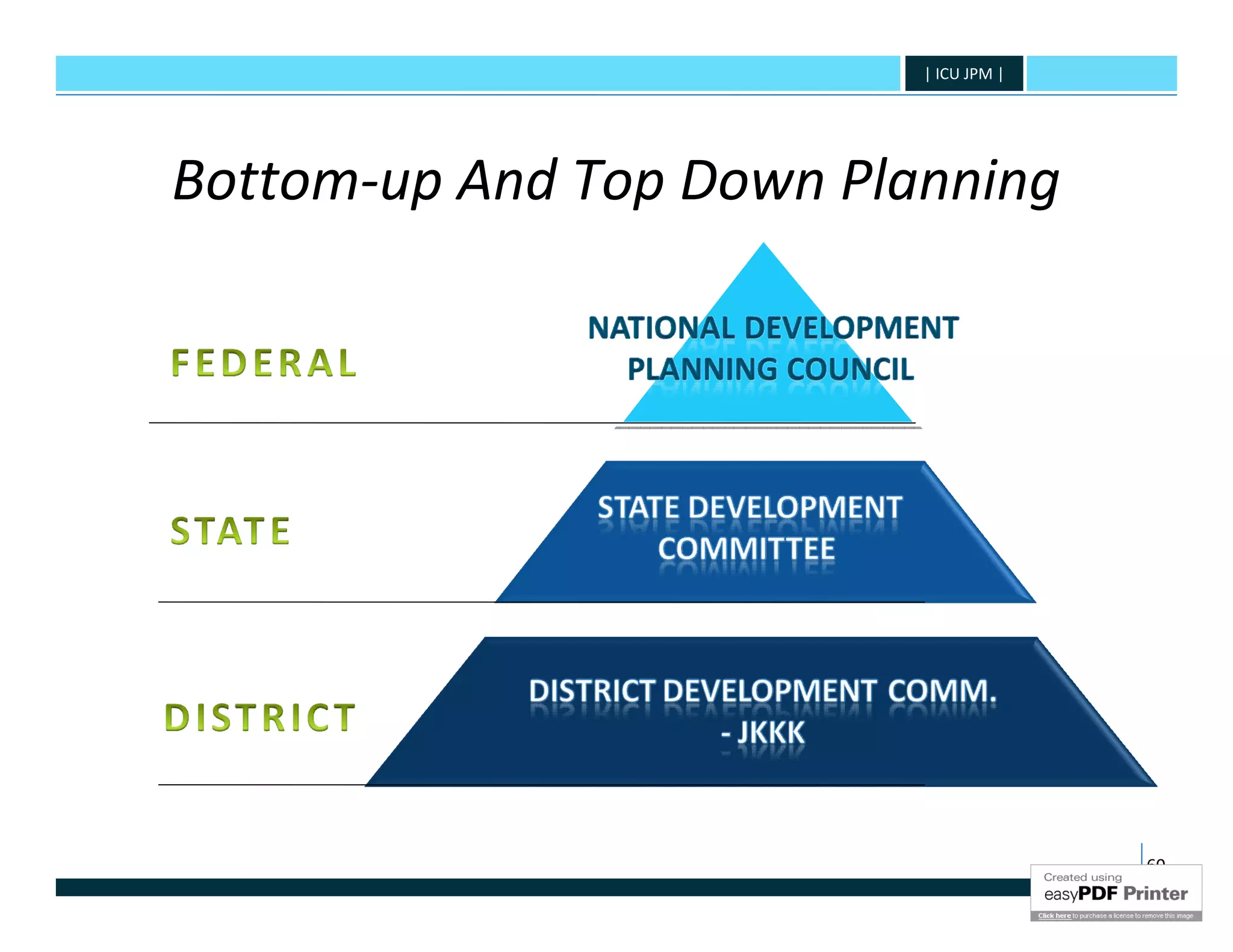

Bottom-up And Top Down Planning

                                        60
| ICU JPM |

Planning, Monitoring And Evaluation Machinery
                              CABINET

                         NATIONAL ACTION
                             COUNCIL
                              (MTN)

    NATIONAL             NATIONAL ACTION
  DEVELOPMENT               WORKING
PLANNING COUNCIL           COMMITTEE
                              (JKTN)

        EPU                  (ICU JPM)

 IAPG         TWG
                    MINISTRY/STATE GOVERNMENT

                                                              61
| ICU JPM |

                                      THE 5 THRUSTS OF RMK-9
 Moving the economy up the value
              chain

    Raising the capacity for
knowledge and innovation and                   Improving the standard and
nurturing “first class mentality”            sustainability of quality of life

   Addressing persistent socio-
economy inequalities constructively          Strengthening the institutional
        and productively                      and implementation capacity

                                                                                 63
| ICU JPM |

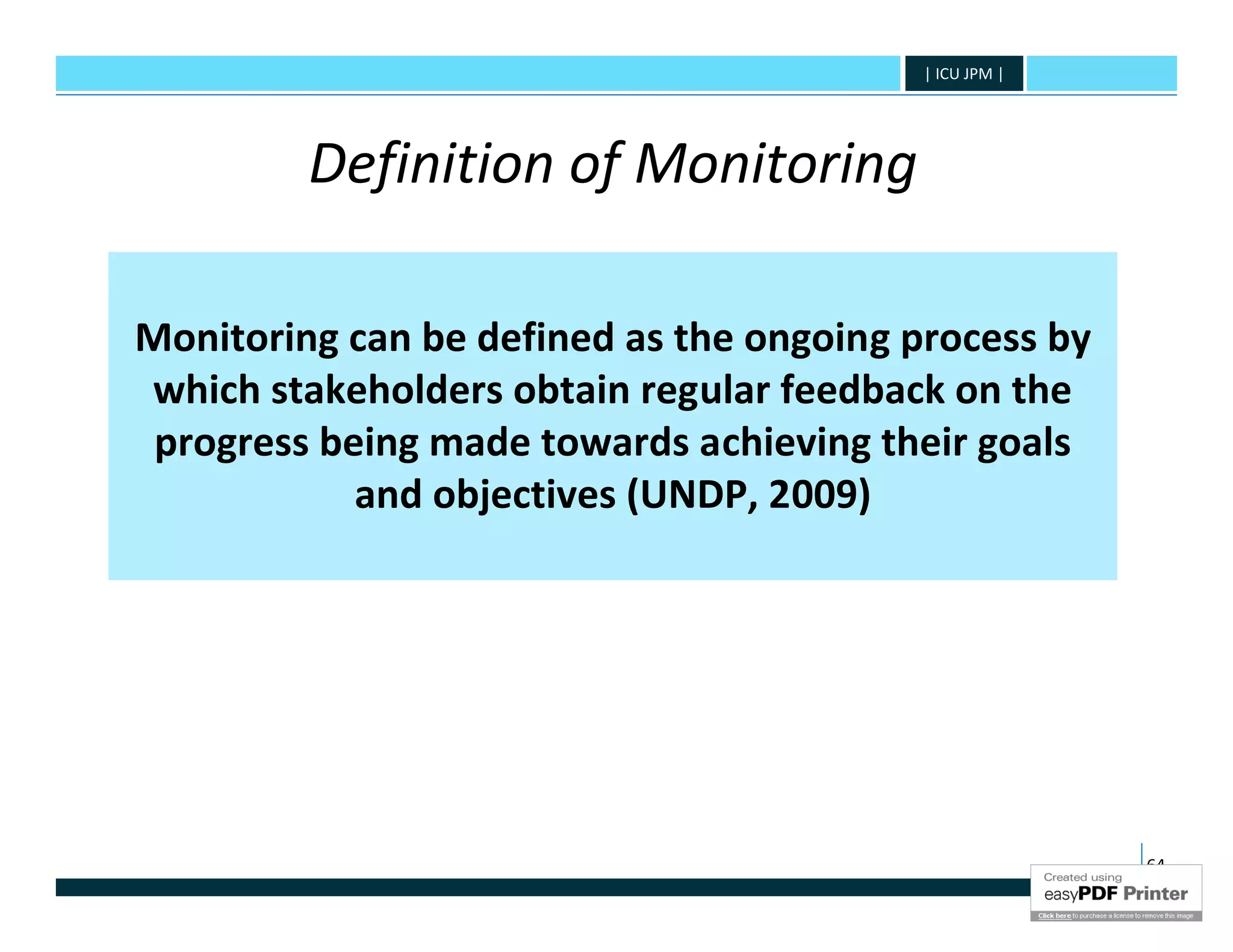

         Definition of Monitoring

Monitoring can be defined as the ongoing process by
which stakeholders obtain regular feedback on the
 progress being made towards achieving their goals
            and objectives (UNDP, 2009)

                                                        64
| ICU JPM |

Directive : No.1, 2004
National Action Council

                                        65

MfDR at the Coordination Unit of the Primes Minister's Department

  • 2.
    | ICU JPM| Introduction of ICU Assessing Where We Are Managing and Administering Development Monitoring and Evaluation(M&E) Mechanisms Outcome Based Approach (OBA) – the new dimension of M&E Summary 2
  • 3.
  • 4.
    ROLE OF GOVERNMENT • Improving Quality • Efficiency of Life • Effectiveness • Increasing • Transparency Implementation of Delivery Of Capacity of People • Multichannel Services Development Projects • Empowering the People Security VOLUME SPEED ACCURACY VOLUME SPEED ACCURACY Source: Khalid Ramli & Osman Md. Yusoff. (2009). Issues and Challenges in Managing Development in Malaysia Implementation Coordintaion Unit (ICU), Putrajaya, Malaysia
  • 5.
    • Sustainability /viability Value at • Value for money Economic Planning Entry • Integration of development • Acquisition management • People Harmony • Environment • Economic benefits • Total Asset Management Technical Planning Balanced • Stakeholder Focused Project •Enhanced project outcomes •Standardised processes & practices Output Source: Khalid Ramli & Osman Md. Yusoff. (2009). Issues and Challenges in Managing Development in Malaysia Implementation Coordintaion Unit (ICU), Putrajaya, Malaysia
  • 7.
  • 8.
    POVERTY ERADICATION Miskin Poor Miskin Tegar Hard Core poor 49.8% 50 40 30 20 10 5.7% 0 1.2 3.6 0.7 1970 2004 37 year 2007 s 92.8% Source: Khalid Ramli & Osman Md. Yusoff. (2009). Issues and Challenges in Managing Development in Malaysia Implementation Coordintaion Unit (ICU), Putrajaya, Malaysia
  • 9.
    GLOBAL COMPETITIVENES INDEX(GCI) AND HUMAN DEVELOPMENT INDEX (HDI) Per Capita Gross Domestic Product (2008)
  • 10.
    GLOBAL COMPETITIVENES INDEX(GCI) AND HUMAN DEVELOPMENT INDEX (HDI)
  • 12.
  • 13.
    Directive No. 1Structure CABINET (Final Decision Maker) National Action Ministerial Committees National Planning Council Council (MTN) National Development National Action Planning Committee Working Committee (JKTN) EPU ICU JPM IAPG State Econ. Private Sector Ministries Planning Communities Department / Agencies Federal Department Under State Govt. At State Level MINISTRY/STATE GOVERNMENT Source: Khalid Ramli & Osman Md. Yusoff. (2009). Issues and Challenges in Managing Development in Malaysia Implementation Coordintaion Unit (ICU), Putrajaya, Malaysia
  • 14.
    | ICU JPM| Source: Khalid Ramli & Osman Md. Yusoff. (2009). Issues and Challenges in Managing Development in Malaysia Implementation Coordintaion Unit (ICU), Putrajaya, Malaysia 14
  • 15.
    | ICU JPM| Implementation Coordination Machinery FEDERAL STATE DISTRICT National Action Council State Action 132 District/ Divisional Council Action Working National Action Working Committee Committee State Action Working Ministerial Action Committee Committee 15
  • 16.
    | ICU JPM| Monitoring Initiatives P-Forensic Regular Visits Trouble Shooting Intervention Data Trading Center Inspection Bilateral HEALTH CHECK 16
  • 17.
    | ICU JPM| Monitoring Network Of ICU SDO Kedah FDD Kelantan SDO Perlis SDO Sabah SDO Terengganu SDO P. Pinang SDO Perak SDO Pahang SDO Selangor Putrajaya SDO F.T KL SDO N. Sembilan SDO Sarawak SDO Melaka SDO Johor 17
  • 18.
    | ICU JPM| DEGREE OF CHALLENGE QUALITY OF PLANNING, IMPLEMENTATION AND PERFORMANCE MANAGEMENT • Inter Ministry / Agency • Inter State • Project Brief • Foreign Loans • CBA • Stakeholder Plan • Scheduling • Reporting Mechanism PERSPECTIVEOF PERSPECTIVE OF MONITORING MONITORING • Leadership • Technical Expertise / Competency OUTCOME DELIVERY • Track Record • Clear Objective CAPACITY TO DRIVE • Targets PROGRESS • Indicator • Measurement RISK OF IMPLEMENTATION / LIKELIHOOD OF DELIVERY Source: Khalid Ramli & Osman Md. Yusoff. (2009). Issues and Challenges in Managing Development in Malaysia Implementation Coordintaion Unit (ICU), Putrajaya, Malaysia 18
  • 19.
    1 Malaysia, PeopleFirst, Performance Now Delivering programs and projects in the context of current environment Meeting the Desired Outcome Projects must be delivered FAST
  • 20.
    Conceptual Framework for Managing Development Results Source: Khalid Ramli & Osman Md. Yusoff. (2009). Issues and Challenges in Managing Development in Malaysia Implementation Coordintaion Unit (ICU), Putrajaya, Malaysia
  • 21.
    Bu id i ng Pro M me ex ject at er tco ation er cee C Ex ia O u lu th din ost -G ls a Ev ea ra W gc ti a eil ate i ng in g pri Ph Sit e nn p ro ost ysi cal La nd Pl a d ap In e ject C g re Ob sta Co Co f er Sit Pro eedin ntr De Exc ling T cle ns ut EO De s ac ul go of of la y Tec s in P to r ta nt din rder nt me wn e r Cei h n re p nt rra n ha O e ors by O ic a a in ent End ign l Sp aratio Tr e W s s Ex-Gratia ec i n spa lay pm De ncy fica sse Utility De velo Ag e Payment t io n rs Ceiling De e cop Allo ct S NOC Proje cati on Pr oj e ct Brief VOP Aw Del ign a Neg ys in ar s VO De d VOP o ti a tion Outcome Evaluation Co Des s Cre ntrac ig n er dib tor Co n rk ilit ’s tio m o ala W y pe n tio sc te eE isi Pr nc c Pri M oje qu y Ac an ct ag em ra o or nt t t en ct Co n b- m e t Su Pay
  • 22.
    Apparent weaknesses in projectplanning and management due to :- • Increase in number of projects • Nature & complexity of projects • Mega projects A drastic increase in the multitude and magnitude of projects being managed Need to strengthen Project Management within Ministries and Agencies
  • 23.
  • 24.
    | ICU JPM| HISTORY OF PROJECT MONITORING SYSTEMS IN MALAYSIA 2001 SPP II 8th & 9th MP Scope covers complete lifecycle from Project Application to Payment, with data capture at source 1996 SMBSS 7th MP Project Information : Financial & Physical Progress. Focus on Monitoring 1991 SIAP 6th MP Stand alone System. Focus on Physical Progress 5th MP 4th MP 1981 SETIA Distributed Processing System. Focus on Financial Progress 3rd MP 1971 PMS I 2nd MP Ministries and agencies sent Project Physical Progress in hard copy to ICU for central processing 1st MP RED BOOK 2nd Malaya Plan 1957 1st Malaya Plan Project information were kept and updated in the RED Book 24 24
  • 25.
    | ICU JPM| Panduan Rancangan Buku Hijau The Red Book 25
  • 26.
    | ICU JPM| Agencies Involved 26
  • 27.
    | ICU JPM| Modules of SPP II - Web based Monitoring • Program • Project • Problem • Attached document • Contract • Works Document • Report Support • References • Organization • User’s Profile • Contractor’s Profile Maintenance • Changes • Announcement • Email massages • Report 27
  • 28.
  • 29.
    | ICU JPM| Benefits of SPP II Producing flexible report writing format Standard and up-to-date information obtained from data centre Information can be submitted online SPPII Featuring maps, graphics and pictures Coordinated projects code Accessible information at anytime 29
  • 30.
  • 31.
    | ICU JPM| OUTCOME & RESULT BASED MONITORING “No Use Of Projects Without Delivering Desired Outcome” Tun Abdullah Badawi “Emphasis – Outcome Not Output” Dato’ Seri Najib Tun Razak 31
  • 32.
    OBJECTIVES OF OUTCOMEBASED MONITORING To evaluate the effectiveness of programs/projects to the target group To assist management in making balanced decisions To develop corrective actions in overcoming issues relating to unachievable desired outcomes Central agencies will distribute resources to ministries based on the real outcomes achieved by programs/projects
  • 33.
    | ICU JPM| Evaluation’s Chain 33
  • 34.
    | ICU JPM| Guideline Circular 24 August 2005: Guideline On Development Program Evaluation 34
  • 35.
    | ICU JPM| Why Evaluation? 1 STRATEGIC TRANSFORMATION 2 SUSTAINABLE 5 PUBLIC BENEFIT DEVELOPMENT 3 6 ACCOUNTABILITY & VALUE FOR MONEY INTEGRITY 4 STAKEHOLDER 7 DELIVERY SYSTEM EXPECTATION 35
  • 36.
    | ICU JPM| Performance measurement must be evaluated to ensure the implementation meets the expected result and desired outcomes Example :: Serdang Hospital Example Serdang Hospital Resource Program Output Outcome Impact -Increase public standard of health - Improved health Budget, Hospital facilities Human resource, A -Increase Development Consultancy, Hospital productivity Project - Reduction in Infrastructure mortality rate -Increase life expectancy Cost : RM624.085 million 36
  • 37.
    | ICU JPM| CURRENT PRACTICES SELECTIVE EVALUATION – 5 CRITERIA ONLY FOR COMPLETED PROGRAM/PROJET ISOLATED EMPHASIS ON PROJECT APPROACH RATHER THAN PROGRAM 37
  • 38.
    | ICU JPM| The Obstacles Of Evaluation Lack Of Stakeholders Incompetent Resources Involvement To Conduct Evaluation Time Consuming For Denial Syndrome – Lack Data Collection And Of Awareness Limited Man Power Output Oriented– Financial And Physical Lack Of Enforcement Evaluation 38
  • 39.
    | ICU JPM| THE SHORTCOMINGS OF 9th MALAYSIA PLAN APPROACH The present There were no monitoring system explicit linkages was mainly focused between The focus was Redundant / on implementation implementation more on projects duplication in and monitoring of levels and the rather than on efforts and physical projects higher level programs. functions (output oriented outcomes at the rather than sectoral as well as outcomes based). national level. Lack of stakeholder Insufficient Unsynchronized engagement in resources (money planning M&E and manpower) for evaluation 39
  • 40.
    | ICU JPM| TRANSFORMATION OF 10th Malaysia Plan N IO U AT Setting the vision AL EV PLA A NN ING Defining the Managing and results map and using evaluation E B RBM Framework Stakeholder participation Implementing Planning for and using C monitoring and D monitoring evaluation MONI TO RING * Source : UNDP 2009 40
  • 41.
    | ICU JPM| The RBM Results Chain How? What do we want? Why? INPUTS ACTIVITIES OUTPUTS OUTCOMES IMPACT Actual or intended The short-term The financial, Action taken changes in human The products, and medium-term human and through which development as capital goods and effects of an material resources inputs are measured by services that result intervention's used for mobilized to people’s well- from development outputs; change in development produce specific being; interventions development intervention outputs improvements in conditions people’s lives Resources Result PLANNING IMPLEMENTATION 41
  • 42.
    | ICU JPM| Outcome-Output-Project Nexus NATIONAL Corporate GOAL Reporting and Strategic Plan Outcome Outcomes e.g. UNDAF Outcome Outcome PLANNING PLANNING MONITORING MONITORING Country Sub Sub UNDP Programs outcomes outcomes Programs Outcomes Outputs Outputs Outputs Outputs Outputs UNDP UNDP Projects Projects Projects Projects Projects Source: Handbook on Planning, Monitoring and Evaluating for Development Results, UNDP,2009 42
  • 43.
    | ICU JPM| Monitoring For Results Framework National KRAs and Dev. Goals Sub-sector Programs and Outcomes MONITORING Ministry/Dept Projects & sub-outcomes PLANNING Expenditure (Input) Evaluation Outputs Outcomes and Impacts IMPLEMENTATION 43
  • 44.
    | ICU JPM| Outcome Based Monitoring Outcome Not Output 1 Clear Objective 2 Specific Target Group 3 Desired Outcome 4 KRA 5 KPI 6 Measurement 7 Enforcement 44
  • 45.
    | ICU JPM| Desired Outcome Measurable KPIs KPIs Clearly Reporting Defined Framework Set Measurement Realistic Objectives Targets Tools KPI FRAMEWORK 45
  • 46.
    | ICU JPM| EXAMPLE OF PROGRAM EVALUATION 46
  • 47.
    | ICU JPM| The Result Framework MEANS OF RESULT INDICATORS BASELINE TARGET RISKS & ASSUMPTIONS VERIFICATION Impact statement Measure of progress Assumptions made from (Ultimate benefits for against impact outcome to impact. Risks 1 1 target population) that impact will not be achieved. Outcome statement Measure of progress Assumptions made from (Short-to-medium-term against outcome outputs to outcome. Risks 2 2 change in development that outcome will not be situation) achieved. Outputs (Products and Measure of progress Assumptions made from services – tangible and against output activities to outputs. Risks 3 3 intangible – delivered or that outputs will not be provided) produced. Activities (Tasks Milestones or key targets Preconditions for undertaken in order to for production of outputs implementation of 4 4 produce research activities. outputs) 47
  • 48.
    | ICU JPM| Example of an Annual Work Plan format with monitoring component 48
  • 49.
    | ICU JPM| llustrative example of Planning Matrix for monitoring: Enhanced Capacity of Electoral management Authority Indicator (with Baselines & M&E Event with Data Time or Schedule Expected Result (Outcomes & Outputs) Indicative Targets) and Collection Methods and Frequency Other Key Areas to Monitor Source: Handbook on Planning, Monitoring and Evaluating for Development Results, UNDP,2009 49
  • 50.
    | ICU JPM| Illustrative example of Planning Matrix for monitoring: Mean of Verification: Responsibilities Resources Risks Data Source and Type Source: Handbook on Planning, Monitoring and Evaluating for Development Results, UNDP,2009 50
  • 52.
    | ICU JPM| Summary To plan programs and projects according to available resources 1 and the end objective in mind, with extensive participation; 2 To monitor programs and projects implementation efficiently and effectively, with good governance; 3 To ensure optimum use of resources and compliance to existing rules and regulations; 4 To assess impact and outcome to ensure national development agenda and objectives are met; and 5 To achieve the ultimate development objective of national unity with balanced physical and spiritual development. 52
  • 53.
    Implementation Coordination Unit Prime Minister’s Department Putrajaya, Malaysia
  • 54.
    | ICU JPM| To be the premier central agency in coordinating and monitoring for ensuring an effective implementation of national development programs. 54
  • 55.
    | ICU JPM| Synergizing the nation’s developments through coordination, monitoring, evaluation of policies, programs and projects implementation through excellent working culture and good governance. 55
  • 57.
    | ICU JPM| Malaysia’s Development Efforrts The New Economic Policy 1971 - 1990 3 National Policies The National Development Policy 1991 - 2000 The National Vision Policy 2001 - 2010 OPP 1 1971 - 1990 3 Outline Perspective OPP 2 1991 - 2000 Plans (OPP) OPP 3 2001 - 2010 1957 - 2006 10 Five-year Development Plans 57
  • 58.
    | ICU JPM| 5 Year Development Plans NINTH MALAYSIA PLAN 2006 - 2010 OPP 3 (NVP) EIGHTH MALAYSIA PLAN 2001 - 2005 SIXTH MALAYSIA PLAN 1991 - 1995 OPP 2 (NDP) SEVENTH MALAYSIA PLAN 1996 - 2000 FIFTH MALAYSIA PLAN 1986 - 90 OPP 1 (NEP) 1981 - 85 FOURTH MALAYSIA PLAN THIRD MALAYSIA PLAN 1976 - 80 SECOND MALAYSIA PLAN 1971 - 75 FIRST MALAYSIA PLAN 1966 - 70 SECOND MALAYA PLAN 1961 - 65 FIRST MALAYA PLAN 1957 - 60 58
  • 59.
    | ICU JPM| Development Cycle Planning ‘a deliberate, comprehensive time specific effort, initiated and sustained by the central government for the purpose of creating and maintaining conditions that will accelerate economic growth and social development in the country’ Evaluation Implementation ‘analytical assessments addressing results ‘carry into effect planned policies of public policies, organizations or programs that are translated into programs that emphasize reliability and usefulness of and projects’ findings to improve information and reduce uncertainty’ 59
  • 60.
    | ICU JPM| Bottom-up And Top Down Planning 60
  • 61.
    | ICU JPM| Planning, Monitoring And Evaluation Machinery CABINET NATIONAL ACTION COUNCIL (MTN) NATIONAL NATIONAL ACTION DEVELOPMENT WORKING PLANNING COUNCIL COMMITTEE (JKTN) EPU (ICU JPM) IAPG TWG MINISTRY/STATE GOVERNMENT 61
  • 63.
    | ICU JPM| THE 5 THRUSTS OF RMK-9 Moving the economy up the value chain Raising the capacity for knowledge and innovation and Improving the standard and nurturing “first class mentality” sustainability of quality of life Addressing persistent socio- economy inequalities constructively Strengthening the institutional and productively and implementation capacity 63
  • 64.
    | ICU JPM| Definition of Monitoring Monitoring can be defined as the ongoing process by which stakeholders obtain regular feedback on the progress being made towards achieving their goals and objectives (UNDP, 2009) 64
  • 65.
    | ICU JPM| Directive : No.1, 2004 National Action Council 65
