Introduction
• Objective: Toimplement a robust IAM
platform that enhances user lifecycle
management and strengthens access control
mechanisms.
• Scope: Covering all phases from planning to
deployment and monitoring.
3.

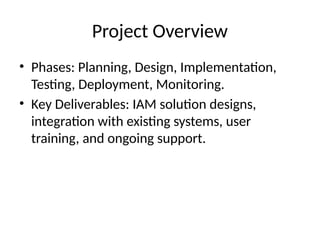

Project Overview
• Phases:Planning, Design, Implementation,
Testing, Deployment, Monitoring.
• Key Deliverables: IAM solution designs,
integration with existing systems, user
training, and ongoing support.
4.

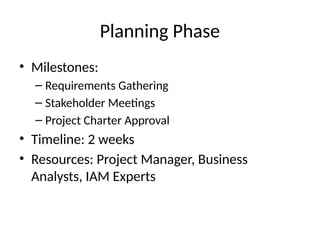

Planning Phase
• Milestones:
–Requirements Gathering
– Stakeholder Meetings
– Project Charter Approval
• Timeline: 2 weeks
• Resources: Project Manager, Business
Analysts, IAM Experts
5.
Design Phase
• Milestones:
–Detailed Solution Design
– Technology Selection
– Integration Planning
• Timeline: 4 weeks
• Resources: IAM Architects, Security Experts, IT
Team

6.
• Milestones:
– InfrastructureSetup
– Software Installation
– Configuration
• Timeline: 6 weeks
• Resources: IT Team, IAM Vendors, Security
Team
7.

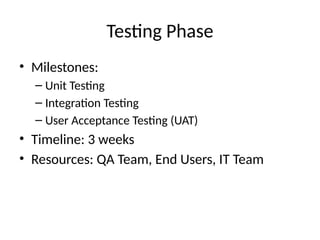

Testing Phase
• Milestones:
–Unit Testing
– Integration Testing
– User Acceptance Testing (UAT)
• Timeline: 3 weeks
• Resources: QA Team, End Users, IT Team
8.

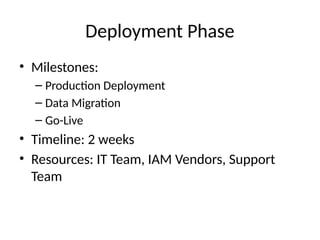

Deployment Phase
• Milestones:
–Production Deployment
– Data Migration
– Go-Live
• Timeline: 2 weeks
• Resources: IT Team, IAM Vendors, Support
Team
9.

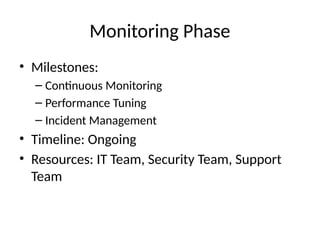

Monitoring Phase
• Milestones:
–Continuous Monitoring
– Performance Tuning
– Incident Management
• Timeline: Ongoing
• Resources: IT Team, Security Team, Support
Team
10.
Resource Requirements
• Personnel:Project Manager, IAM Experts, IT
Team, QA Team, End Users
• Tools: IAM Software, Monitoring Tools, Testing
Tools
• Budget: Estimated costs for software,
hardware, and personnel
