SlideShare a Scribd company logo
“PMI” is a registered trade and service mark of the Project Management Institute, Inc.
©2010 Permission is granted to PMI for PMI® Marketplace use only
Lessons (really) Learned?
How to Retain Project Knowledge
and Avoid Recurring Nightmares
MUSTAFA DÜLGERLER
National Bank of Abu Dhabi
MARCO NEGRI
Anas S.p.A.
1
“PMI” is a registered trade and service mark of the Project Management Institute, Inc.
©2010 Permission is granted to PMI for PMI® Marketplace use only
Marco Negri Mustafa Dülgerler
2
Who I am
Where I come from
IT Manager, PMP, CBAP, COBIT, ITIL
16+ years IT experience
Anas SpA: Italy’s National Roads
Authority
30.500 km of roads and highways
6.500 employees
Who I am
Where I come from
Project Manager, Trainer,
Enterprise Architect
13+ years of experience
National Bank of Abu Dhabi
Presence in 16 countries
5,000 employees
“PMI” is a registered trade and service mark of the Project Management Institute, Inc.
©2010 Permission is granted to PMI for PMI® Marketplace use only
Agenda
Knowledge
Management
Lessons
Learned
Case Study:
KM in
practice
Conclusion

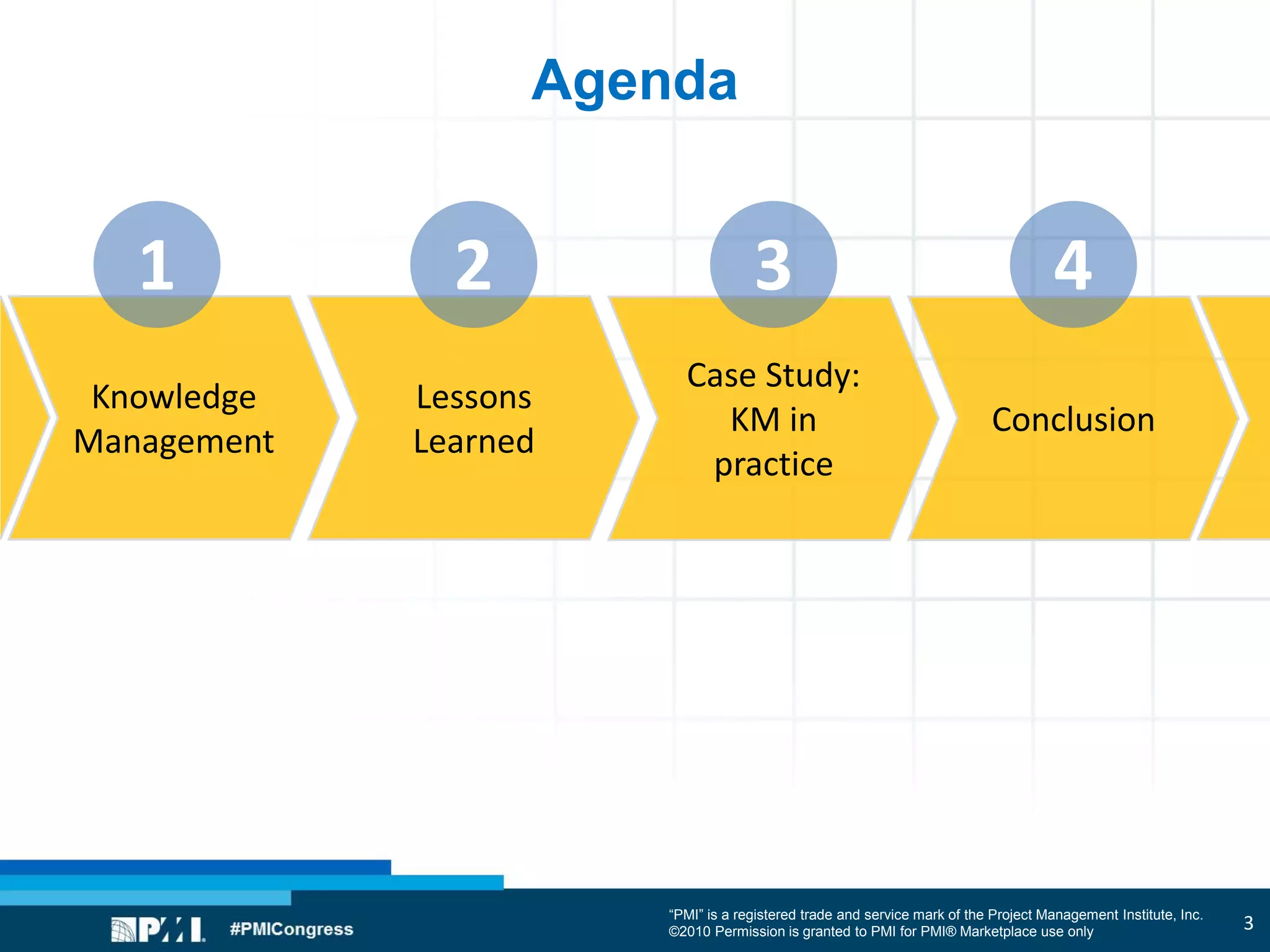

1 2 3 4
3
“PMI” is a registered trade and service mark of the Project Management Institute, Inc.
©2010 Permission is granted to PMI for PMI® Marketplace use only

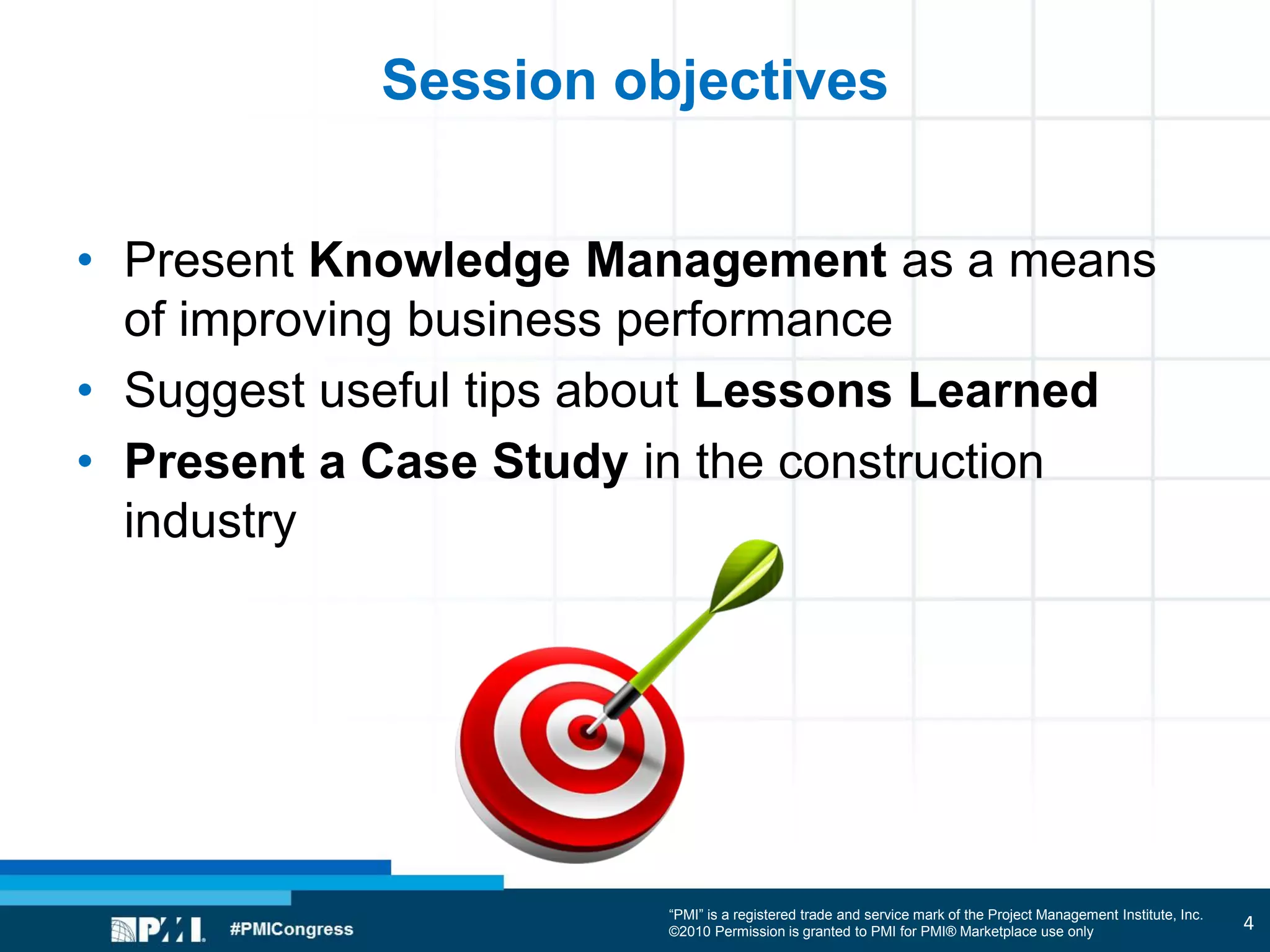

Session objectives
• Present Knowledge Management as a means
of improving business performance
• Suggest useful tips about Lessons Learned
• Present a Case Study in the construction
industry
4
“PMI” is a registered trade and service mark of the Project Management Institute, Inc.
©2010 Permission is granted to PMI for PMI® Marketplace use only
Information is NOT Knowledge
Albert Einstein
5
“PMI” is a registered trade and service mark of the Project Management Institute, Inc.
©2010 Permission is granted to PMI for PMI® Marketplace use only
The definition of “Knowledge” still remains
elusive.
© Image copyright of Dreamworks Pictures
6
“PMI” is a registered trade and service mark of the Project Management Institute, Inc.
©2010 Permission is granted to PMI for PMI® Marketplace use only
Knowledge Fairs
Workshop, Training and
Seminars
Forums and Meetings
Peer Assist, Review
Storytelling
Mentoring Coaching
Communities of Practice

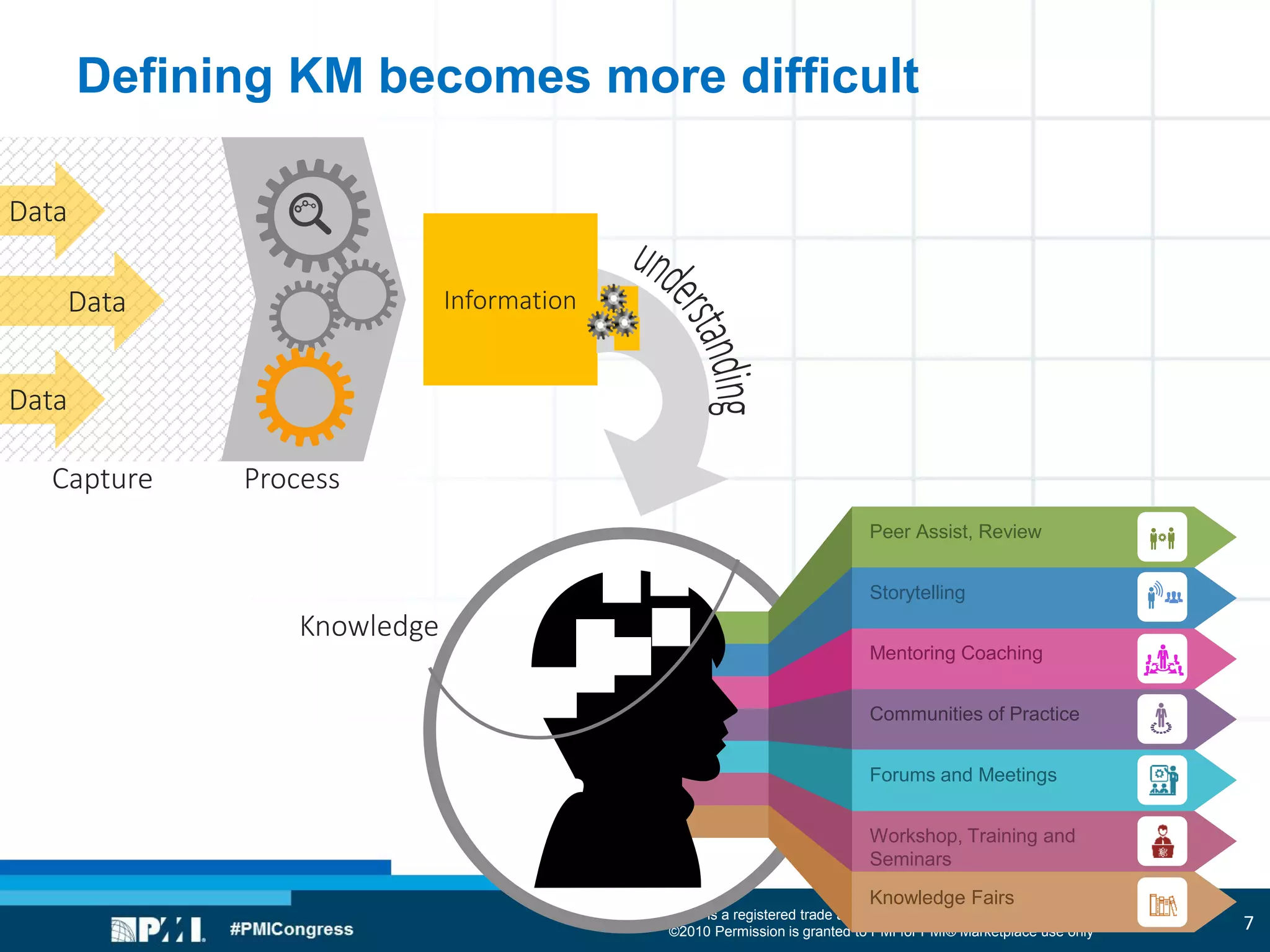

Defining KM becomes more difficult
Data
Data
Data
Information
Capture Process
Knowledge
7
“PMI” is a registered trade and service mark of the Project Management Institute, Inc.
©2010 Permission is granted to PMI for PMI® Marketplace use only

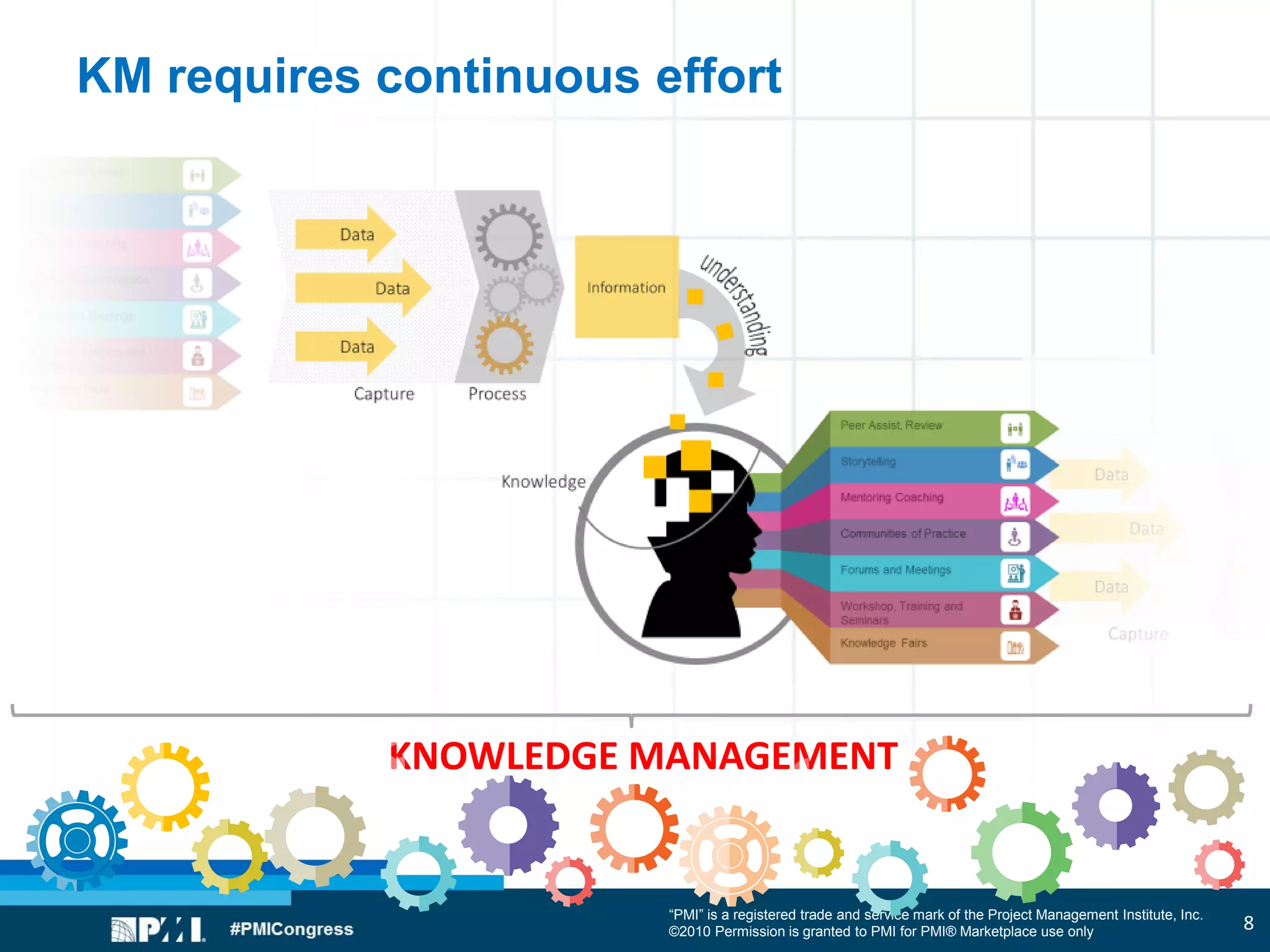

KM requires continuous effort
KNOWLEDGE MANAGEMENT
8
“PMI” is a registered trade and service mark of the Project Management Institute, Inc.
©2010 Permission is granted to PMI for PMI® Marketplace use only
Many models attempt to explain KM from

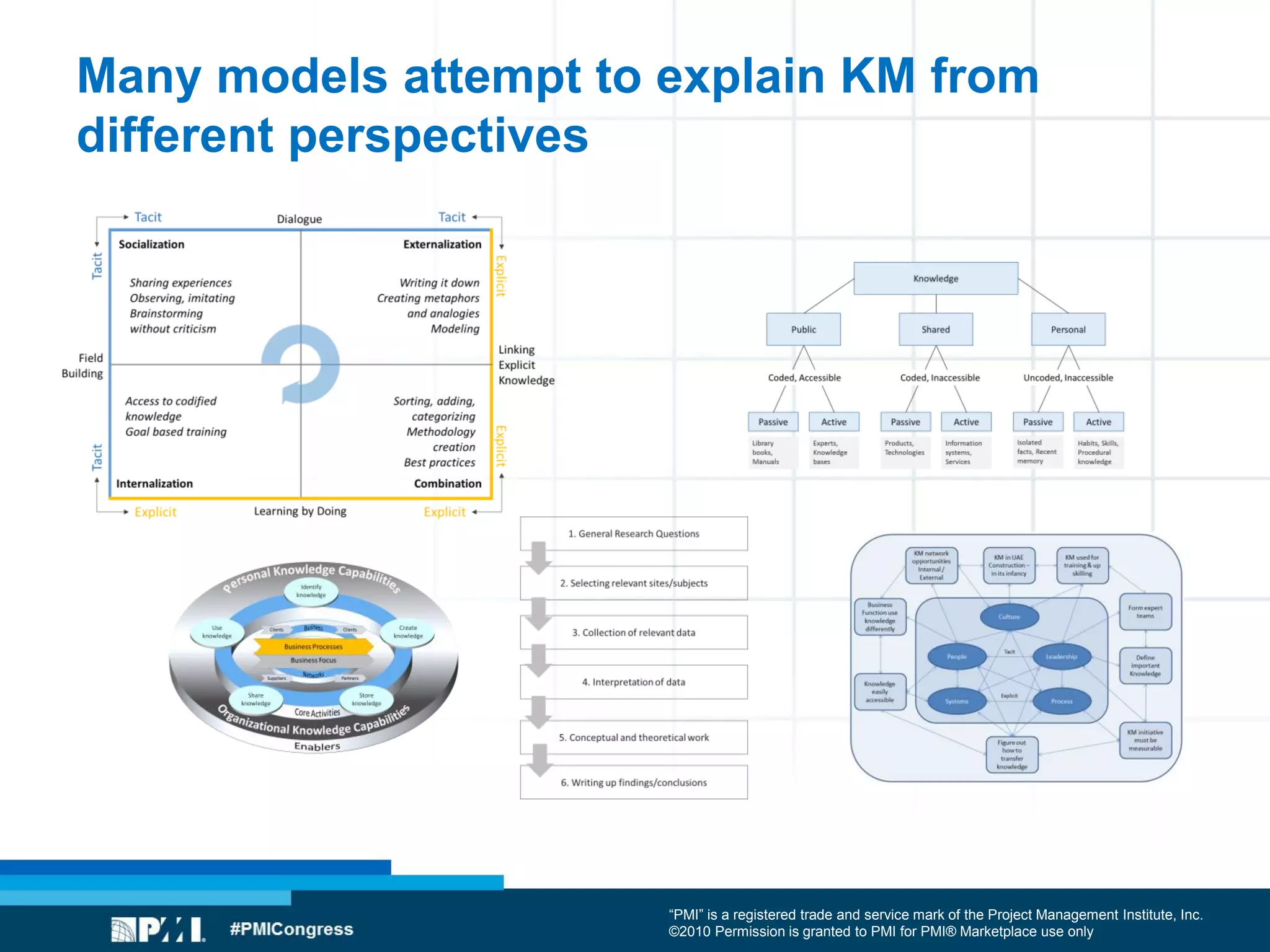

different perspectives
“PMI” is a registered trade and service mark of the Project Management Institute, Inc.
©2010 Permission is granted to PMI for PMI® Marketplace use only

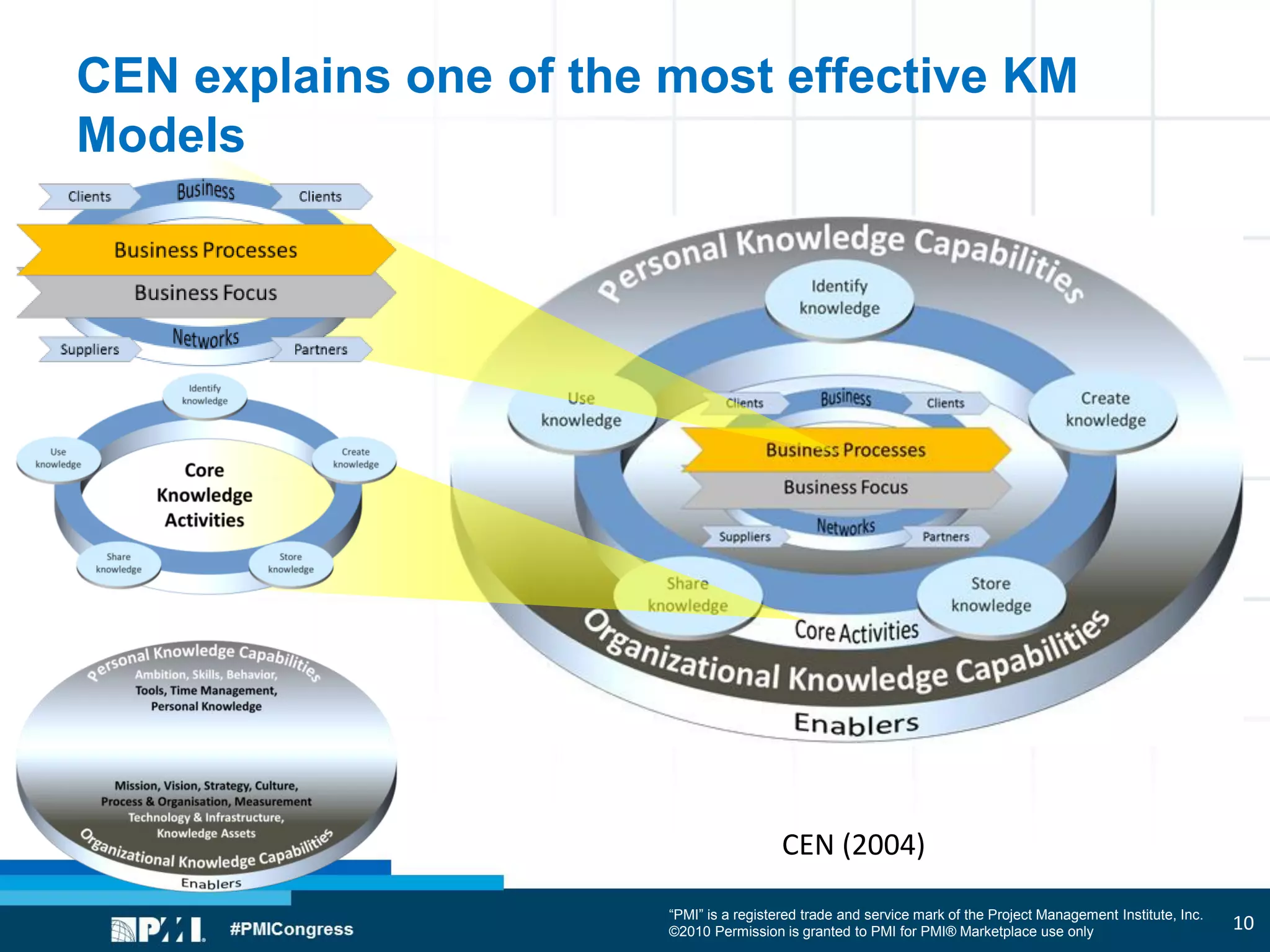

CEN explains one of the most effective KM
Models
CEN (2004)
10
“PMI” is a registered trade and service mark of the Project Management Institute, Inc.
©2010 Permission is granted to PMI for PMI® Marketplace use only 11
“PMI” is a registered trade and service mark of the Project Management Institute, Inc.
©2010 Permission is granted to PMI for PMI® Marketplace use only
What are Lessons Learned?
12
“PMI” is a registered trade and service mark of the Project Management Institute, Inc.
©2010 Permission is granted to PMI for PMI® Marketplace use only

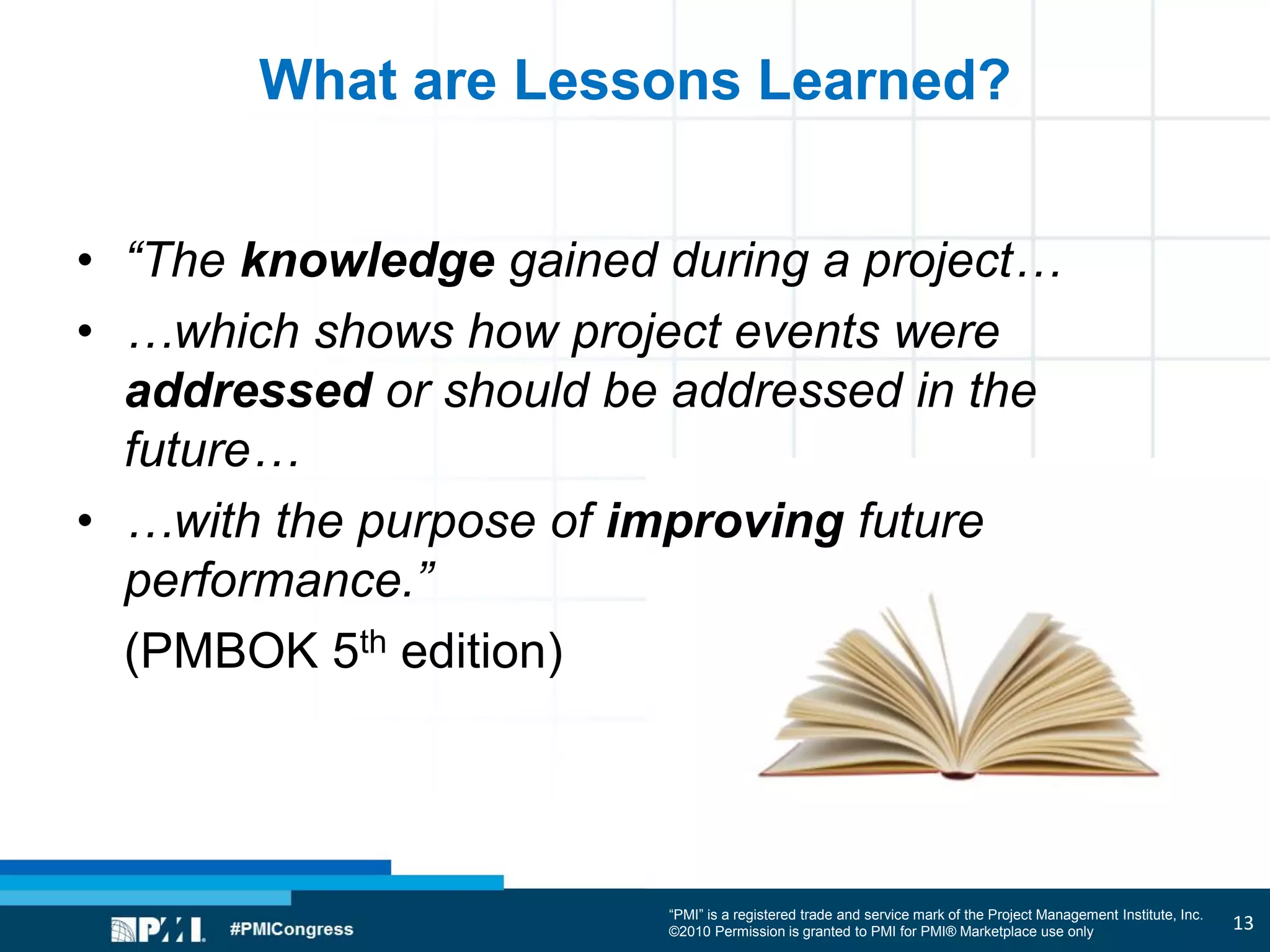

What are Lessons Learned?
• “The knowledge gained during a project…
• …which shows how project events were
addressed or should be addressed in the
future…
• …with the purpose of improving future
performance.”
(PMBOK 5th edition)
13
“PMI” is a registered trade and service mark of the Project Management Institute, Inc.
©2010 Permission is granted to PMI for PMI® Marketplace use only

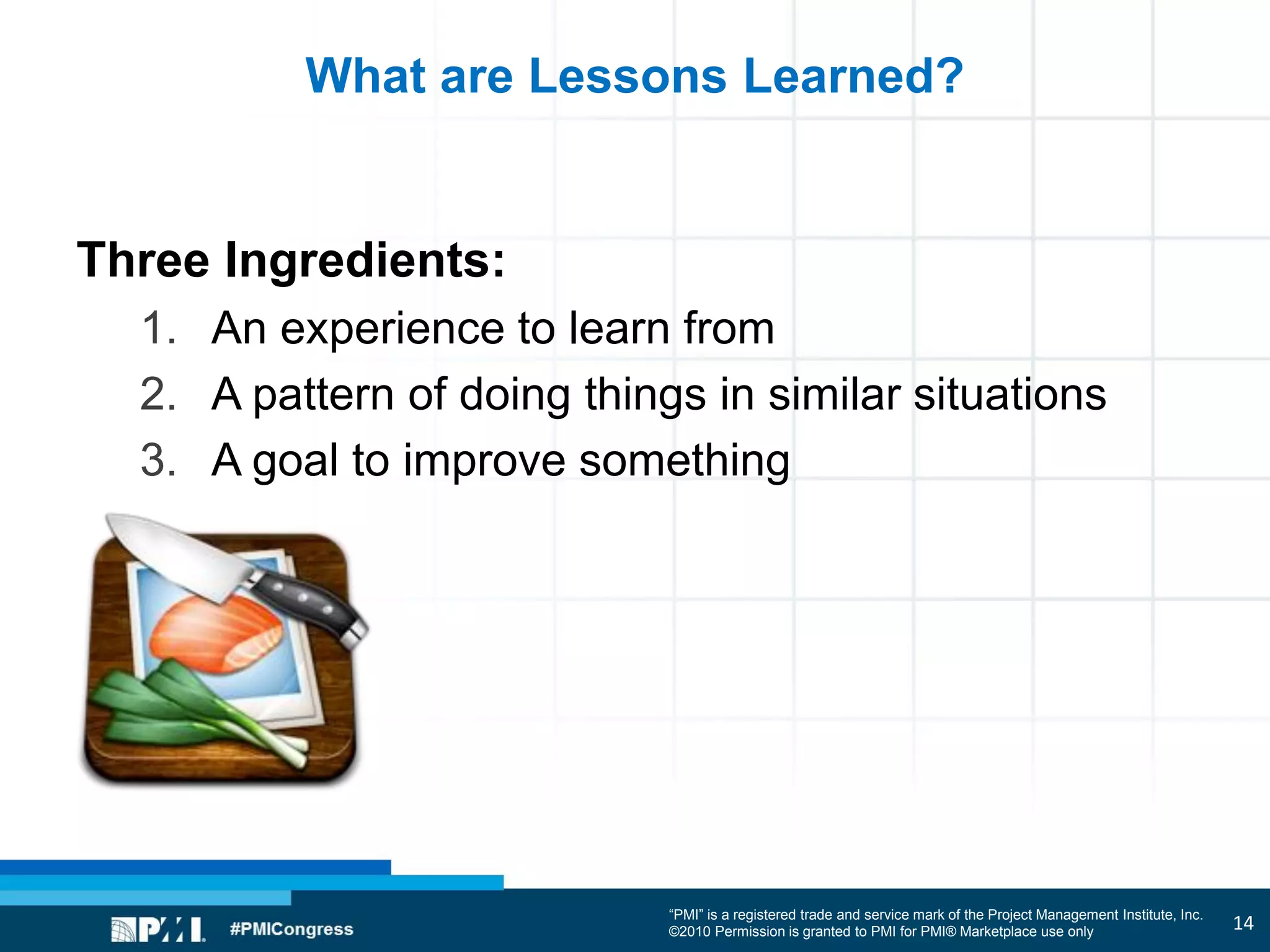

What are Lessons Learned?
Three Ingredients:
1. An experience to learn from
2. A pattern of doing things in similar situations
3. A goal to improve something
14
“PMI” is a registered trade and service mark of the Project Management Institute, Inc.
©2010 Permission is granted to PMI for PMI® Marketplace use only

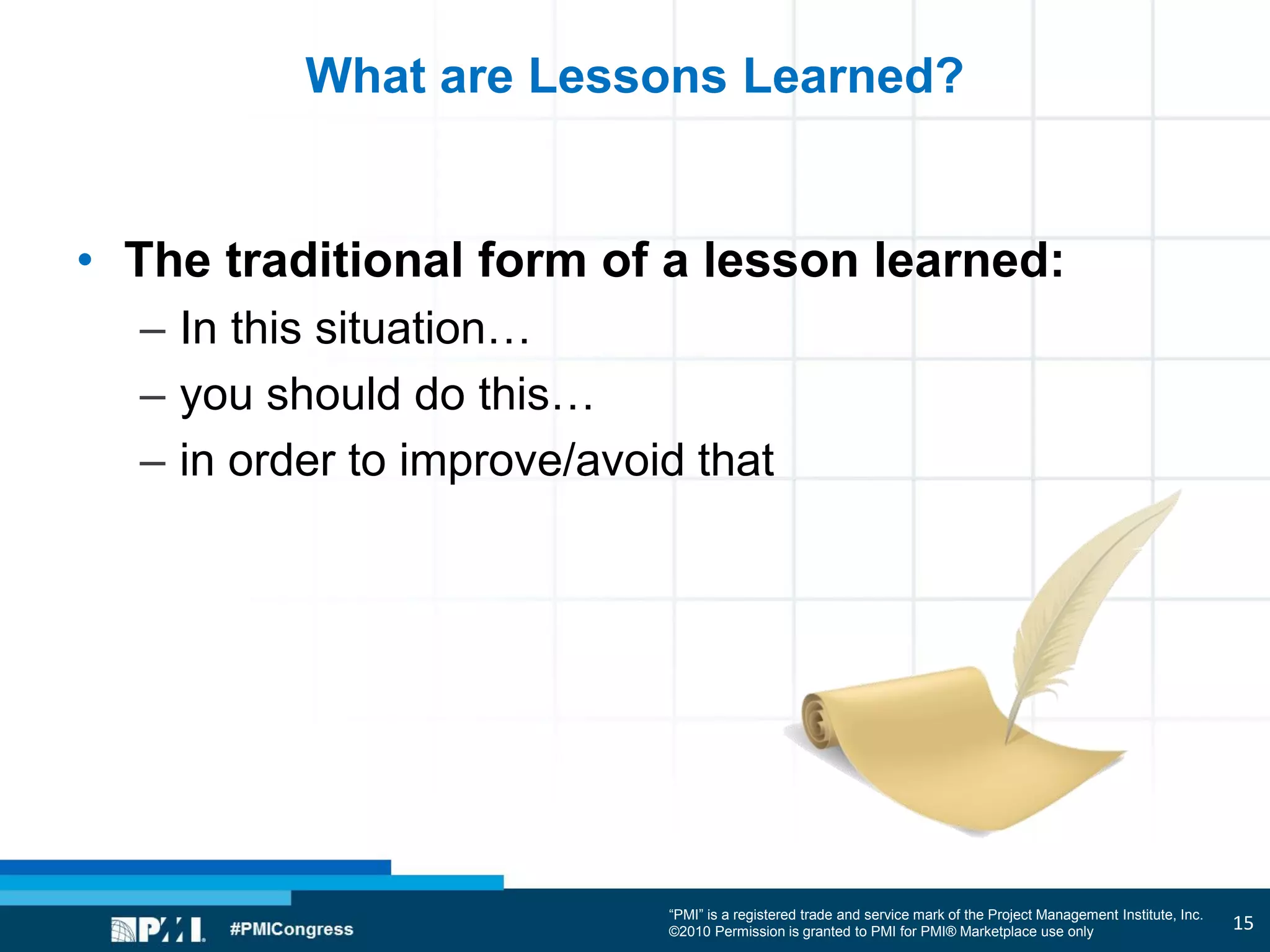

What are Lessons Learned?
• The traditional form of a lesson learned:
– In this situation…
– you should do this…
– in order to improve/avoid that
15
“PMI” is a registered trade and service mark of the Project Management Institute, Inc.
©2010 Permission is granted to PMI for PMI® Marketplace use only
The Lessons Learned Traditional Process
16
“PMI” is a registered trade and service mark of the Project Management Institute, Inc.
©2010 Permission is granted to PMI for PMI® Marketplace use only

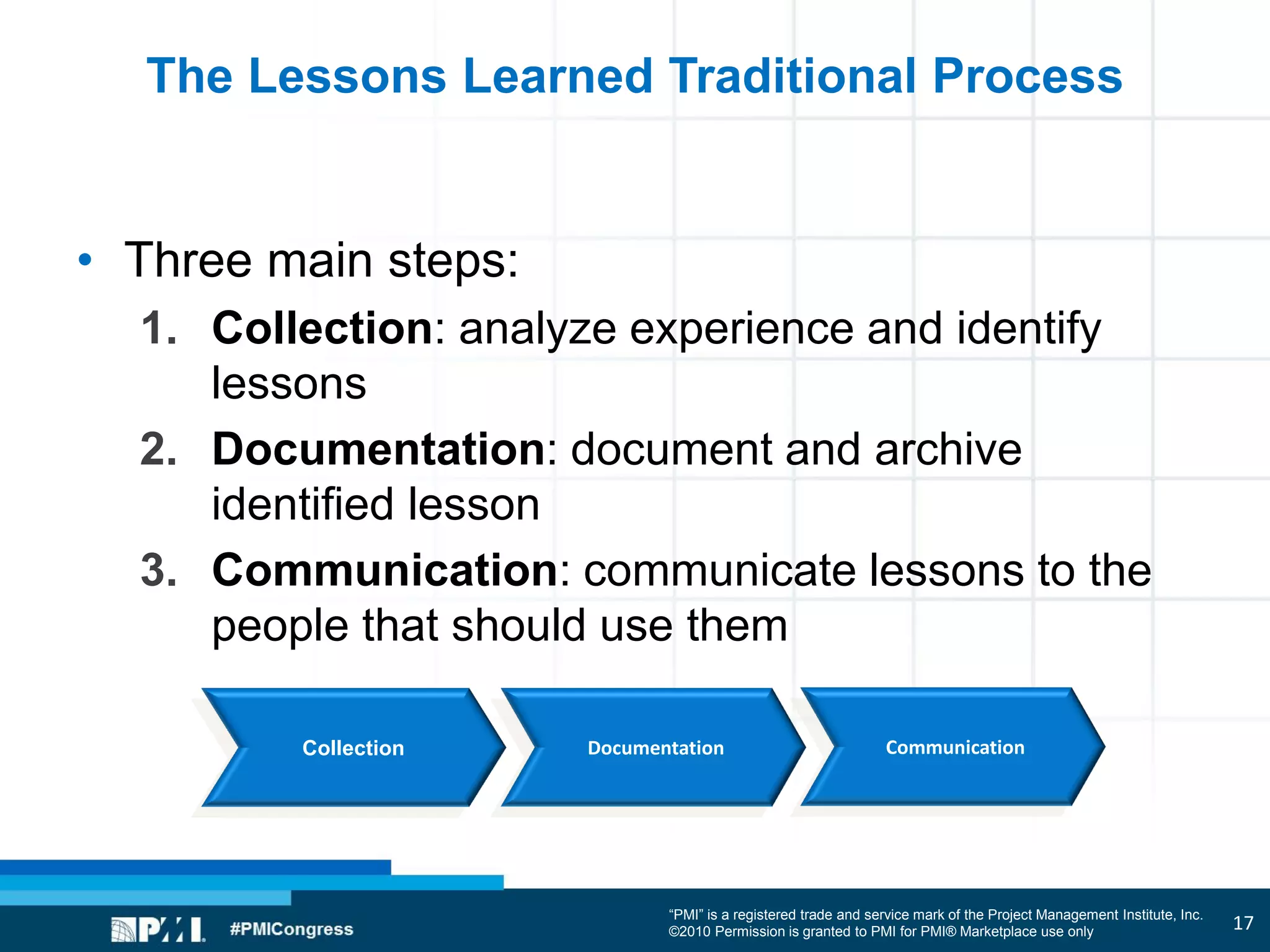

The Lessons Learned Traditional Process
• Three main steps:
1. Collection: analyze experience and identify
lessons
2. Documentation: document and archive
identified lesson
3. Communication: communicate lessons to the
people that should use them
17
Collection Documentation Communication
“PMI” is a registered trade and service mark of the Project Management Institute, Inc.
©2010 Permission is granted to PMI for PMI® Marketplace use only

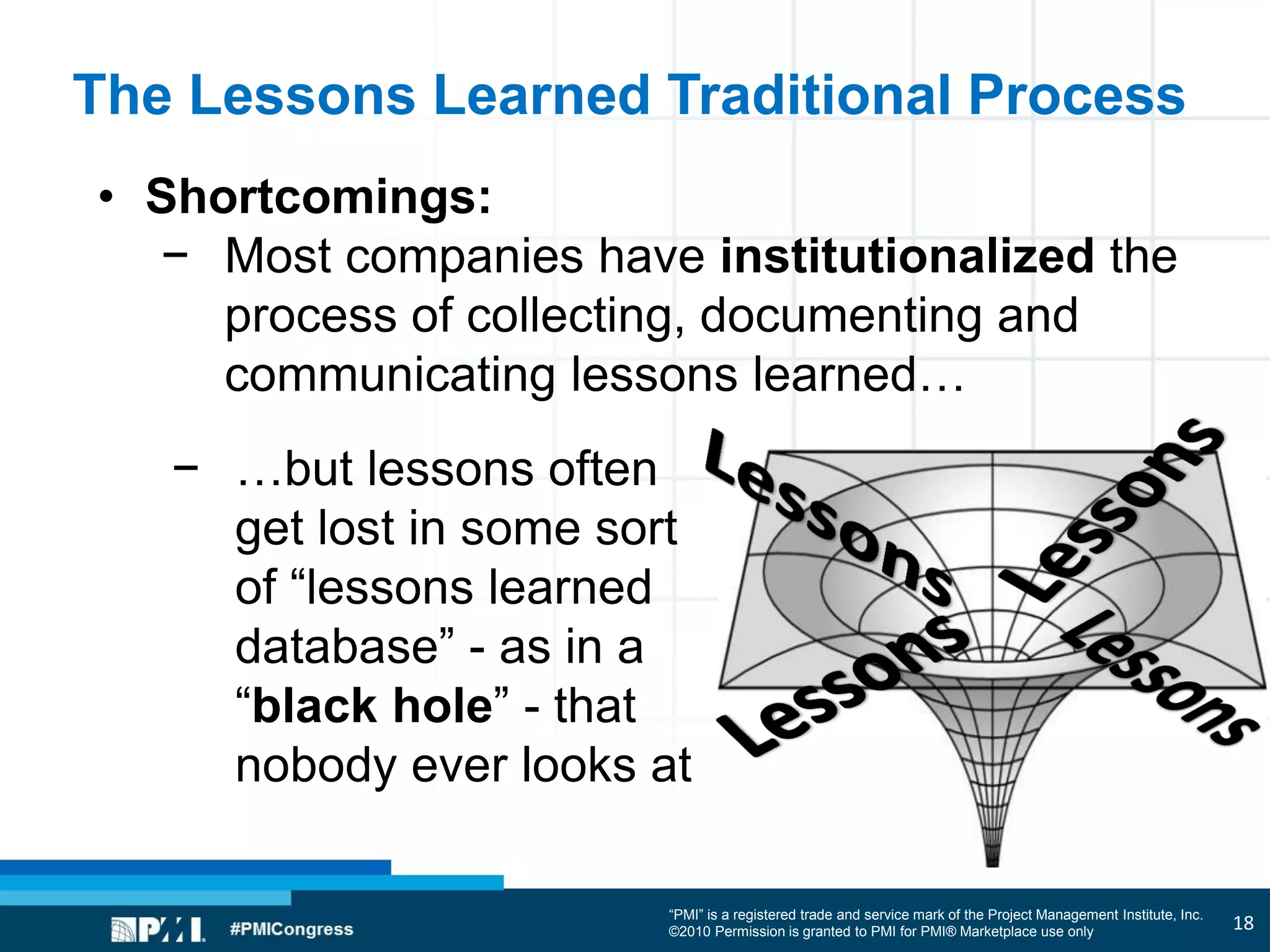

The Lessons Learned Traditional Process
• Shortcomings:
− Most companies have institutionalized the
process of collecting, documenting and
communicating lessons learned…
− …but lessons often
get lost in some sort
of “lessons learned
database” - as in a
“black hole” - that
nobody ever looks at
18
“PMI” is a registered trade and service mark of the Project Management Institute, Inc.
©2010 Permission is granted to PMI for PMI® Marketplace use only

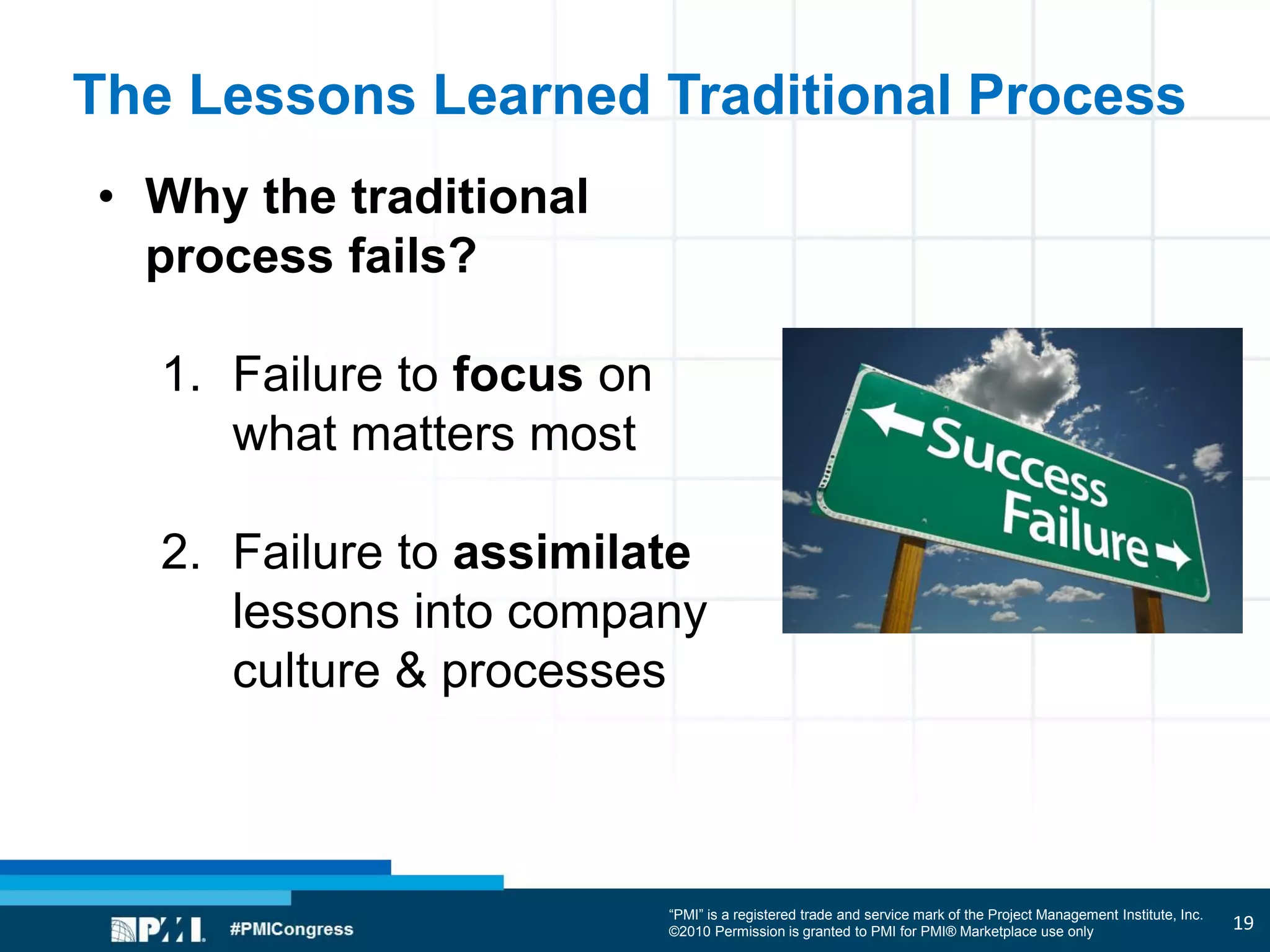

The Lessons Learned Traditional Process
• Why the traditional
process fails?
1. Failure to focus on
what matters most
2. Failure to assimilate
lessons into company
culture & processes
19
“PMI” is a registered trade and service mark of the Project Management Institute, Inc.
©2010 Permission is granted to PMI for PMI® Marketplace use only

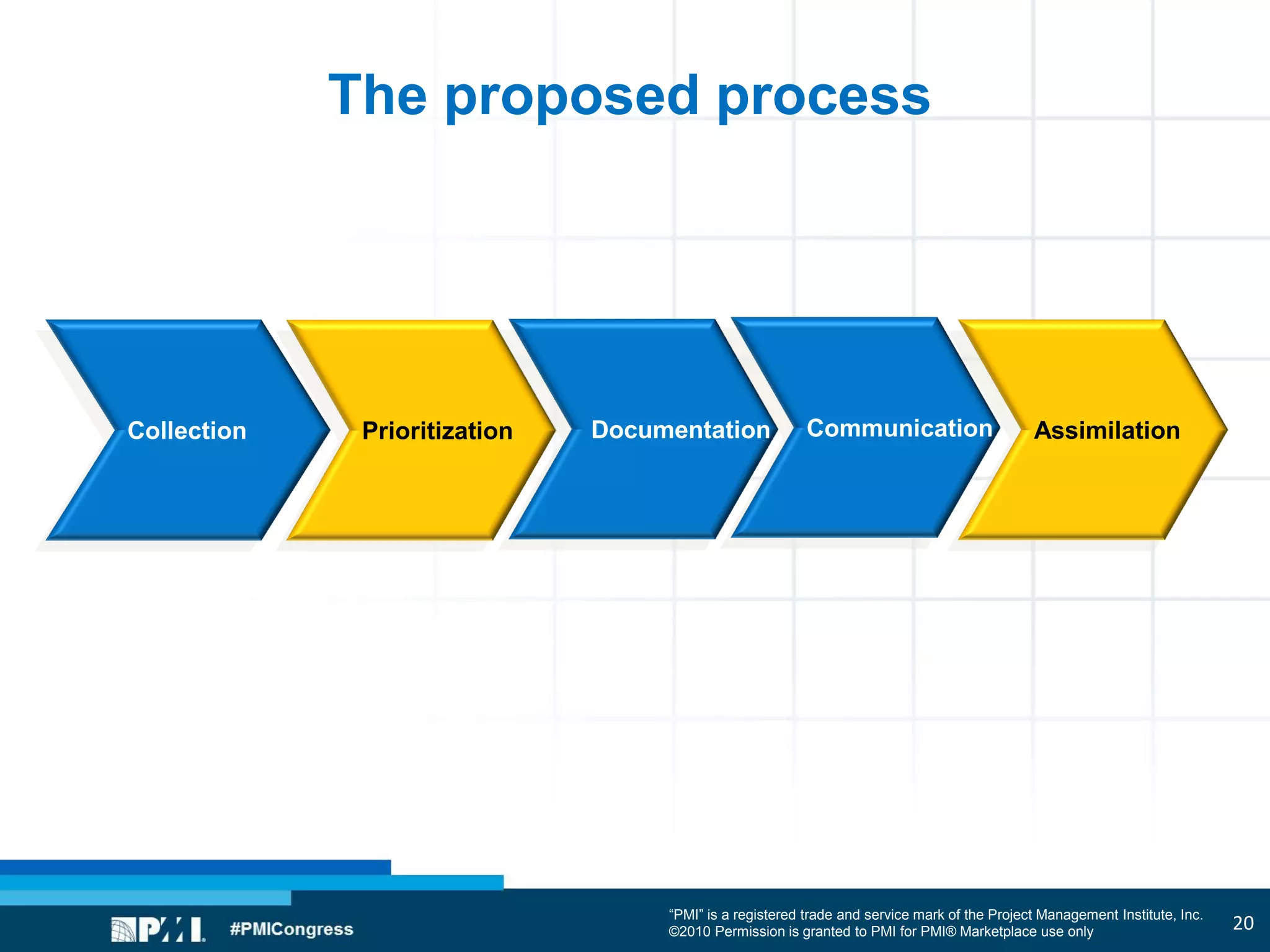

The proposed process
Collection Prioritization Documentation Communication Assimilation
20
“PMI” is a registered trade and service mark of the Project Management Institute, Inc.
©2010 Permission is granted to PMI for PMI® Marketplace use only

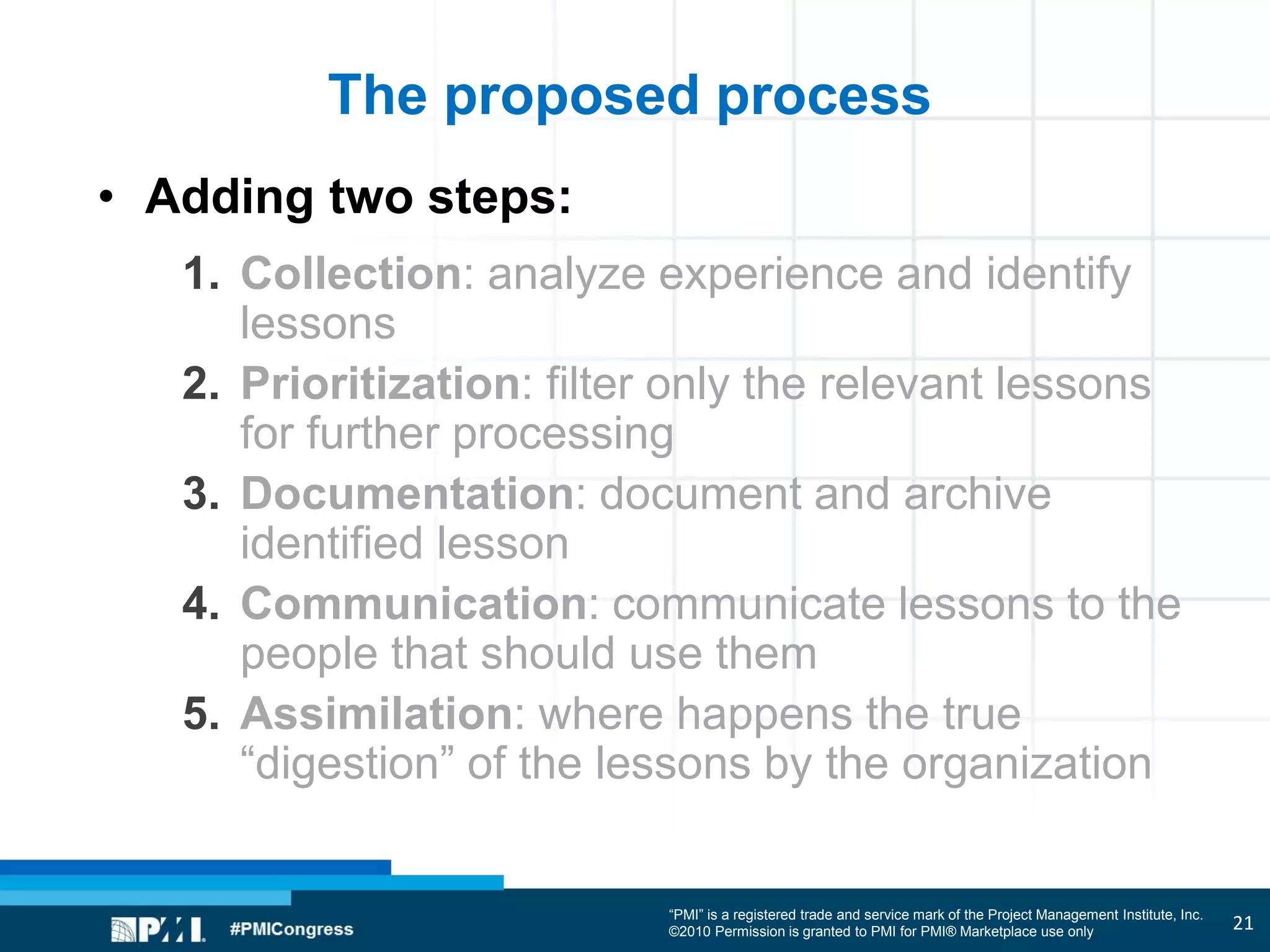

The proposed process
• Adding two steps:
1. Collection: analyze experience and identify
lessons
2. Prioritization: filter only the relevant lessons
for further processing
3. Documentation: document and archive
identified lesson
4. Communication: communicate lessons to the
people that should use them
5. Assimilation: where happens the true
“digestion” of the lessons by the organization
21
“PMI” is a registered trade and service mark of the Project Management Institute, Inc.
©2010 Permission is granted to PMI for PMI® Marketplace use only
Lessons Learned Tips
22
“PMI” is a registered trade and service mark of the Project Management Institute, Inc.
©2010 Permission is granted to PMI for PMI® Marketplace use only
Lessons Learned Tips
• For each of the 5 steps of the proposed process some
typical traps and implementation tips will be
presented…
• …from the real-life experience of the speaker
23
“PMI” is a registered trade and service mark of the Project Management Institute, Inc.
©2010 Permission is granted to PMI for PMI® Marketplace use only
© Image copyright of Dreamworks Animation
Lessons Learned Tips
• Each step will be presented with three points:
–The Common practice
–The Trap
–The Remedy
• Using a cinematographic metaphor from…
24
“PMI” is a registered trade and service mark of the Project Management Institute, Inc.
©2010 Permission is granted to PMI for PMI® Marketplace use only
© Image copyright of Dreamworks Animation
Lessons Learned Tips

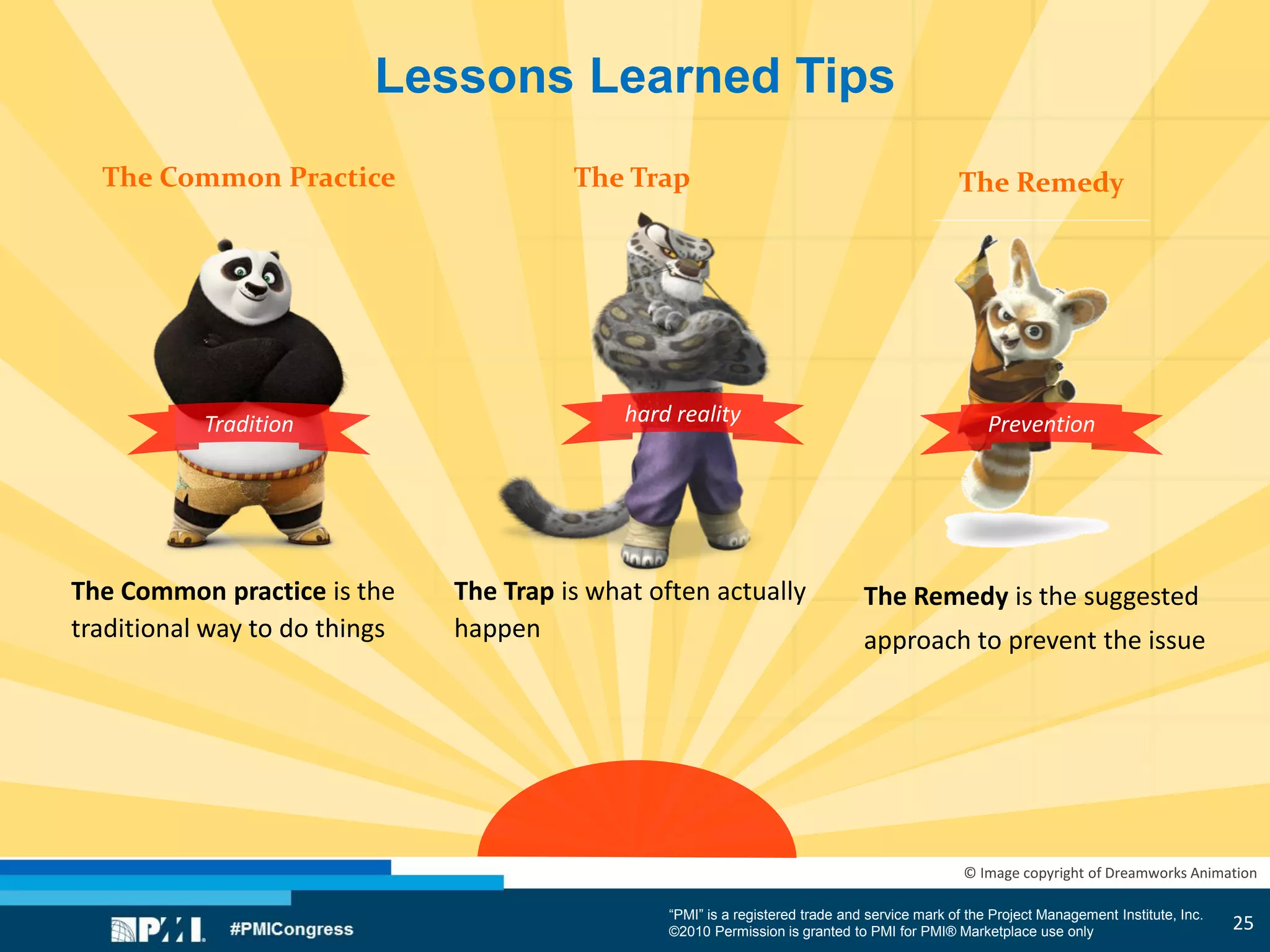

The Common Practice The RemedyThe Trap
The Common practice is the
traditional way to do things
The Trap is what often actually
happen
The Remedy is the suggested
approach to prevent the issue
Tradition hard reality Prevention
25
“PMI” is a registered trade and service mark of the Project Management Institute, Inc.
©2010 Permission is granted to PMI for PMI® Marketplace use only
Collection Prioritization Documentation Communication Assimilation

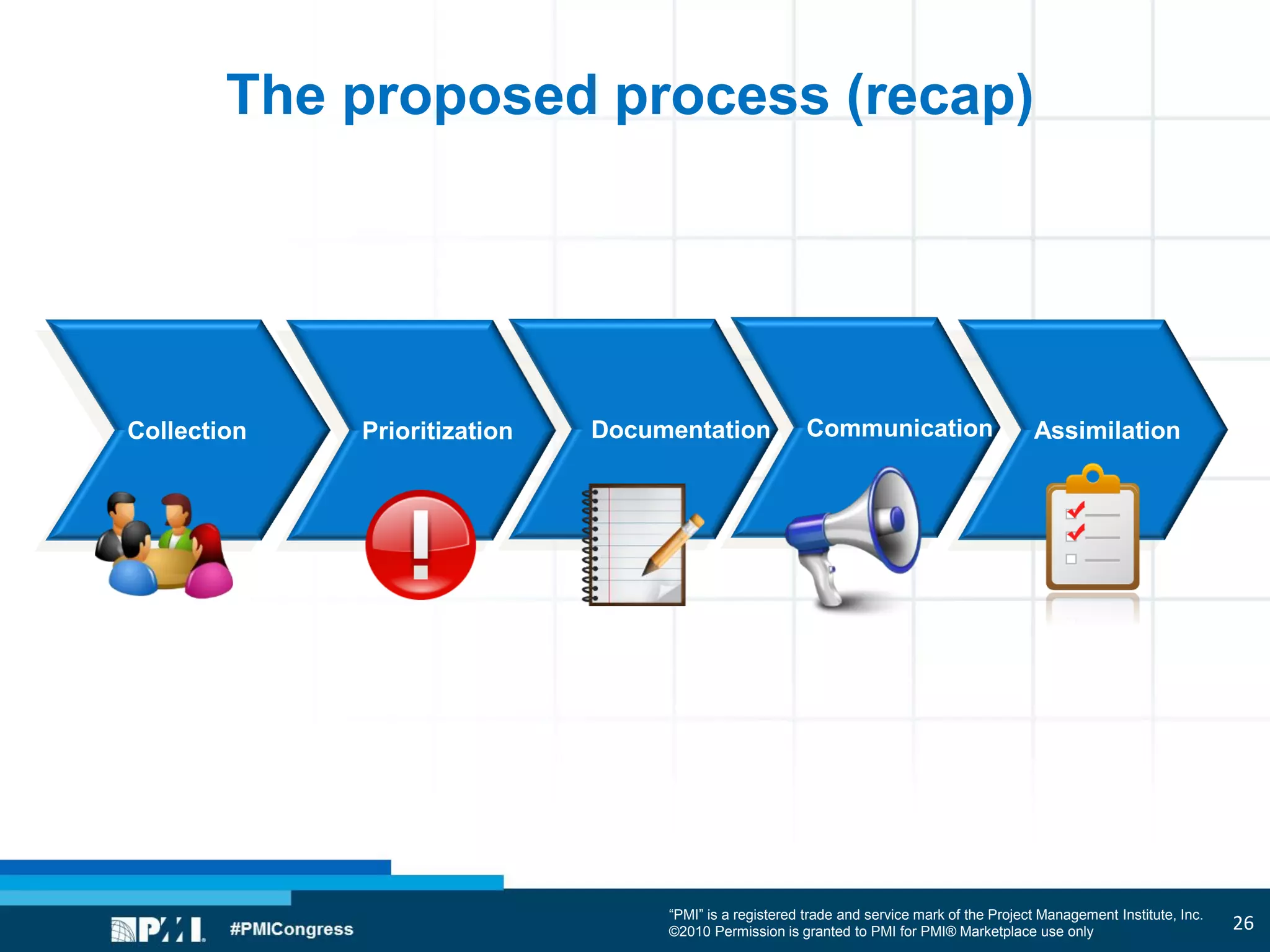

The proposed process (recap)
26
“PMI” is a registered trade and service mark of the Project Management Institute, Inc.
©2010 Permission is granted to PMI for PMI® Marketplace use only
The Common
practice
© Image copyright of Dreamworks Animation
Step #1 - Collection

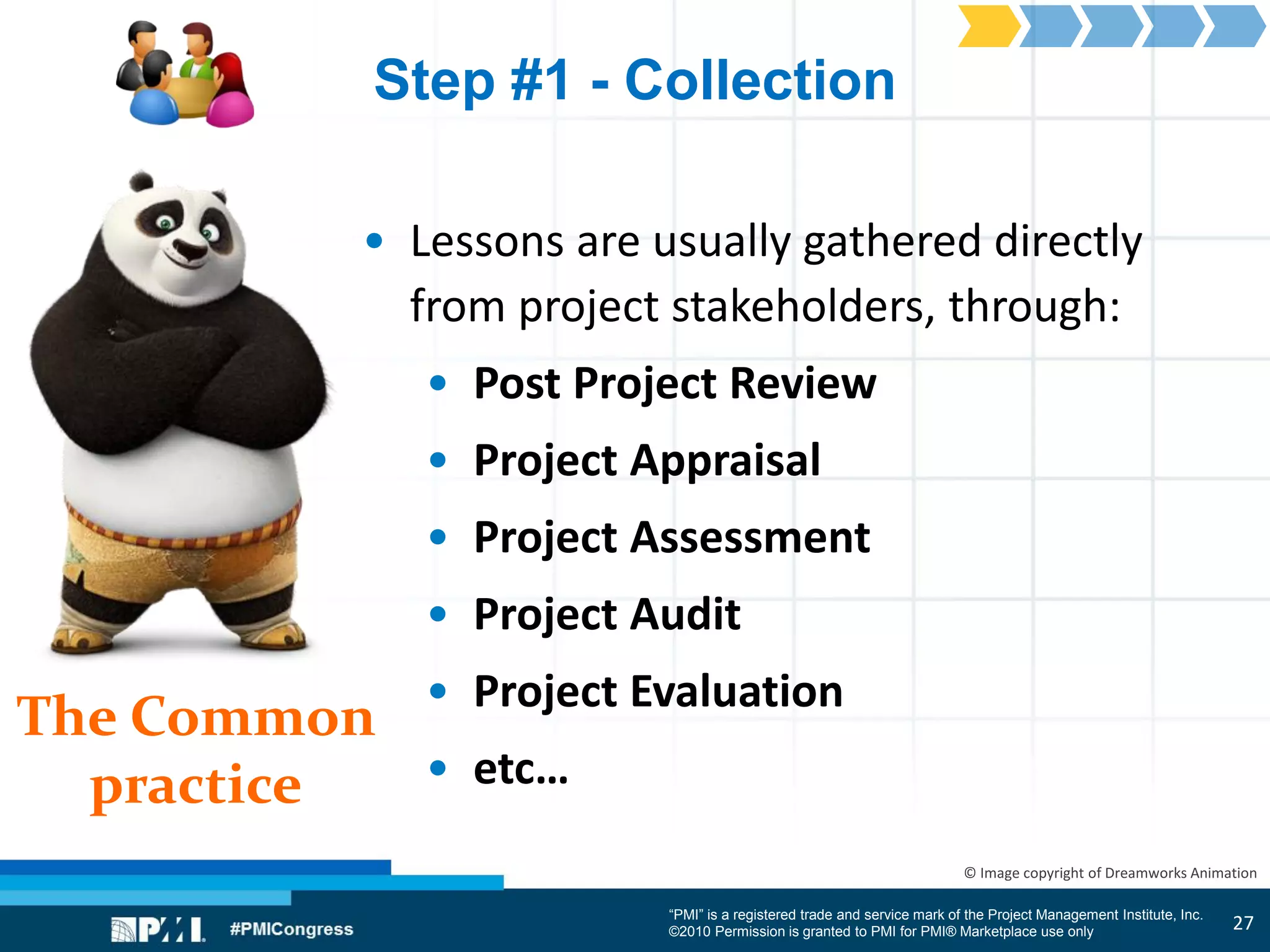

• Lessons are usually gathered directly
from project stakeholders, through:
• Post Project Review
• Project Appraisal
• Project Assessment
• Project Audit
• Project Evaluation
• etc…
27
“PMI” is a registered trade and service mark of the Project Management Institute, Inc.
©2010 Permission is granted to PMI for PMI® Marketplace use only
The Trap
© Image copyright of Dreamworks Animation
Step #1 - Collection

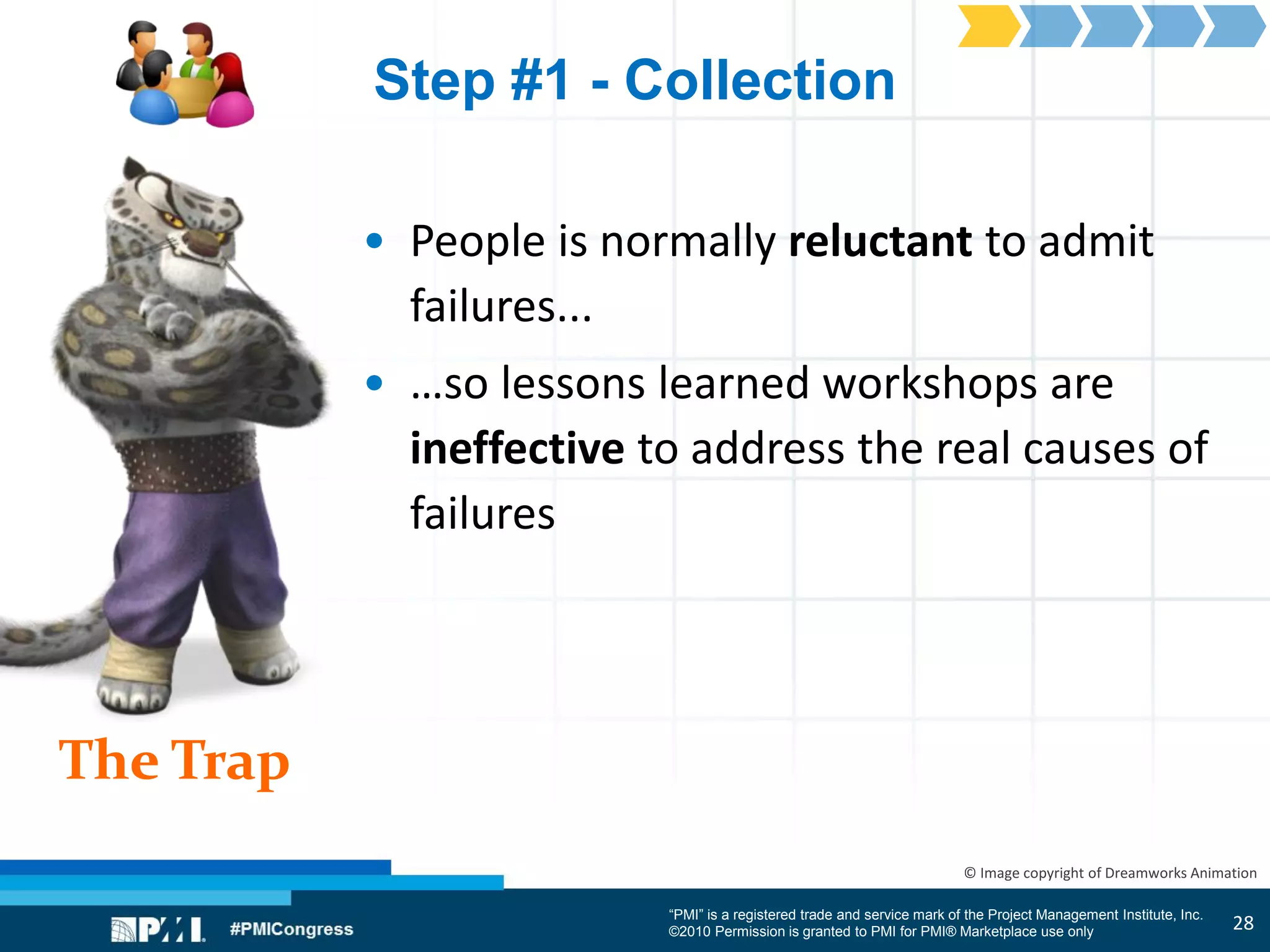

• People is normally reluctant to admit
failures...
• …so lessons learned workshops are
ineffective to address the real causes of
failures
28
“PMI” is a registered trade and service mark of the Project Management Institute, Inc.
©2010 Permission is granted to PMI for PMI® Marketplace use only
The Remedy
© Image copyright of Dreamworks Animation
Step #1 - Collection
• “Delplhi method”:
1. Participants answer questionnaires
(e.g. “what went bad/good?”)
2. After each round a facilitator provides
an anonymous summary
3. Participants are encouraged to revise
their earlier answers in light of the
replies of others
29
“PMI” is a registered trade and service mark of the Project Management Institute, Inc.
©2010 Permission is granted to PMI for PMI® Marketplace use only
The Common
practice
© Image copyright of Dreamworks Animation

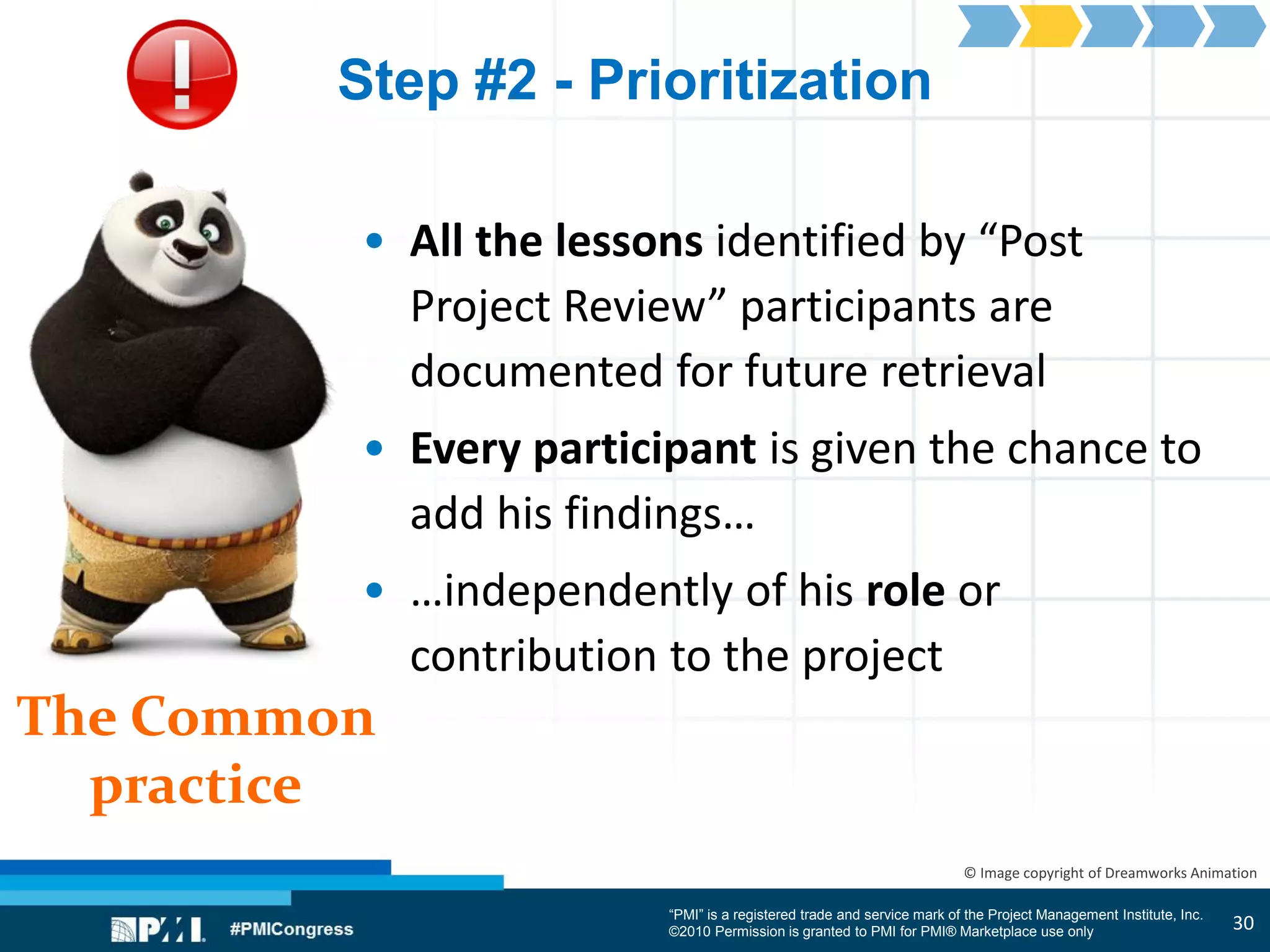

Step #2 - Prioritization
• All the lessons identified by “Post
Project Review” participants are
documented for future retrieval
• Every participant is given the chance to
add his findings…
• …independently of his role or
contribution to the project
30
“PMI” is a registered trade and service mark of the Project Management Institute, Inc.
©2010 Permission is granted to PMI for PMI® Marketplace use only
The Trap
© Image copyright of Dreamworks Animation
Step #2 - Prioritization
• Not every partecipant has the same level
of awareness of project issues and
underlying causes…
• …and everyone has the tendency to
consider his viewpoint the most
important
• The result is a big mess of disarticulated
lessons, that fails to concentrate on the
few main issues that jeopardize projects
31
“PMI” is a registered trade and service mark of the Project Management Institute, Inc.
©2010 Permission is granted to PMI for PMI® Marketplace use only

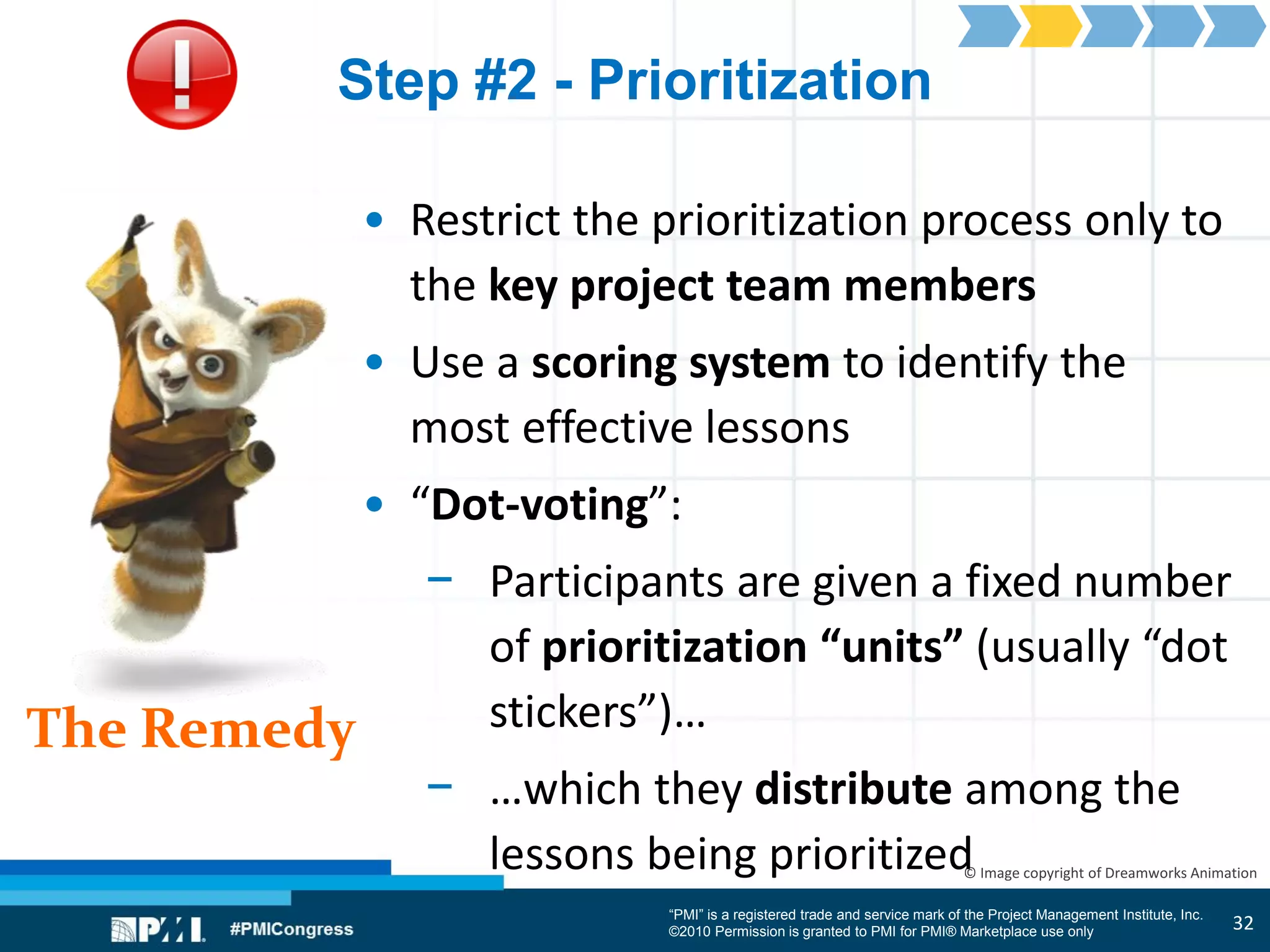

The Remedy
© Image copyright of Dreamworks Animation
Step #2 - Prioritization
• Restrict the prioritization process only to
the key project team members
• Use a scoring system to identify the
most effective lessons
• “Dot-voting”:
− Participants are given a fixed number
of prioritization “units” (usually “dot
stickers”)…
− …which they distribute among the
lessons being prioritized
32
“PMI” is a registered trade and service mark of the Project Management Institute, Inc.
©2010 Permission is granted to PMI for PMI® Marketplace use only
The Common
practice
© Image copyright of Dreamworks Animation
Step #3 - Documentation
• Describe the lessons in a textual
format…
• …linking each lesson to the problem it
should prevent
33
“PMI” is a registered trade and service mark of the Project Management Institute, Inc.
©2010 Permission is granted to PMI for PMI® Marketplace use only
The Trap
© Image copyright of Dreamworks Animation
Step #3 - Documentation
• Often lessons are documented in a “not-
actionable” format…
• …with no practical instruction on how to
implement the lesson
• Generic terms are used, like:
• be careful when…
• we will strive more to…
• etc.
34
“PMI” is a registered trade and service mark of the Project Management Institute, Inc.
©2010 Permission is granted to PMI for PMI® Marketplace use only
The Remedy
© Image copyright of Dreamworks Animation
Step #3 - Documentation
• Try to identify the practical changes in
the way of doing things
• For example:
− further detail the lesson “be careful
when” into “check this and that
when…”
− …or transform “we will strive more
to…” into “you will need at
minimum two people to…”
35
“PMI” is a registered trade and service mark of the Project Management Institute, Inc.
©2010 Permission is granted to PMI for PMI® Marketplace use only
The Common
practice
© Image copyright of Dreamworks Animation
Step #4 - Communication
• Communicate lessons learned by
publishing them in:
• Blogs
• Wikis
• Corporate intranets
• Project sites
• Knowledge Management Systems
• etc.
36
“PMI” is a registered trade and service mark of the Project Management Institute, Inc.
©2010 Permission is granted to PMI for PMI® Marketplace use only

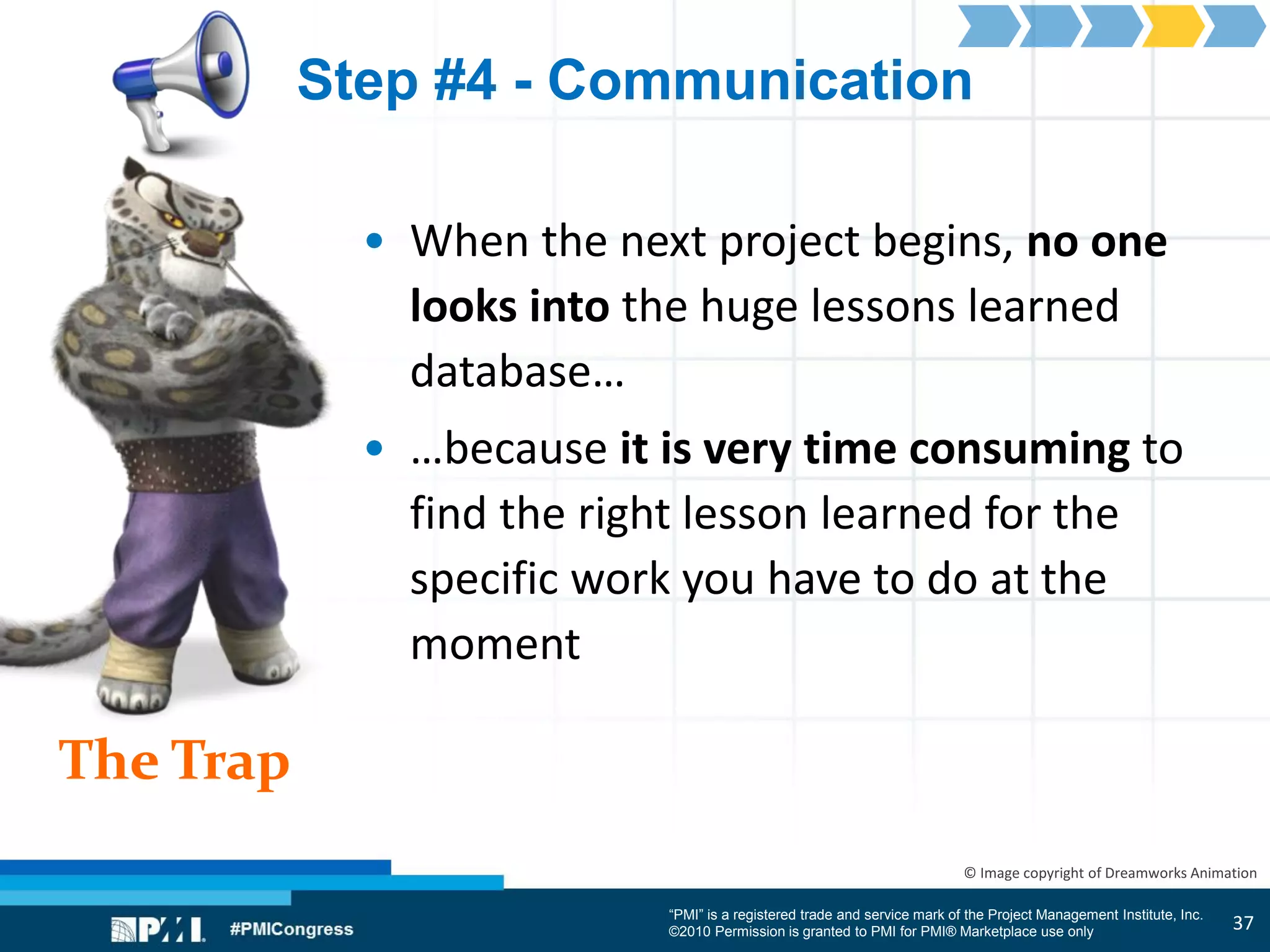

The Trap
© Image copyright of Dreamworks Animation
Step #4 - Communication
• When the next project begins, no one
looks into the huge lessons learned
database…
• …because it is very time consuming to
find the right lesson learned for the
specific work you have to do at the
moment
37
“PMI” is a registered trade and service mark of the Project Management Institute, Inc.
©2010 Permission is granted to PMI for PMI® Marketplace use only
The Remedy
© Image copyright of Dreamworks Animation

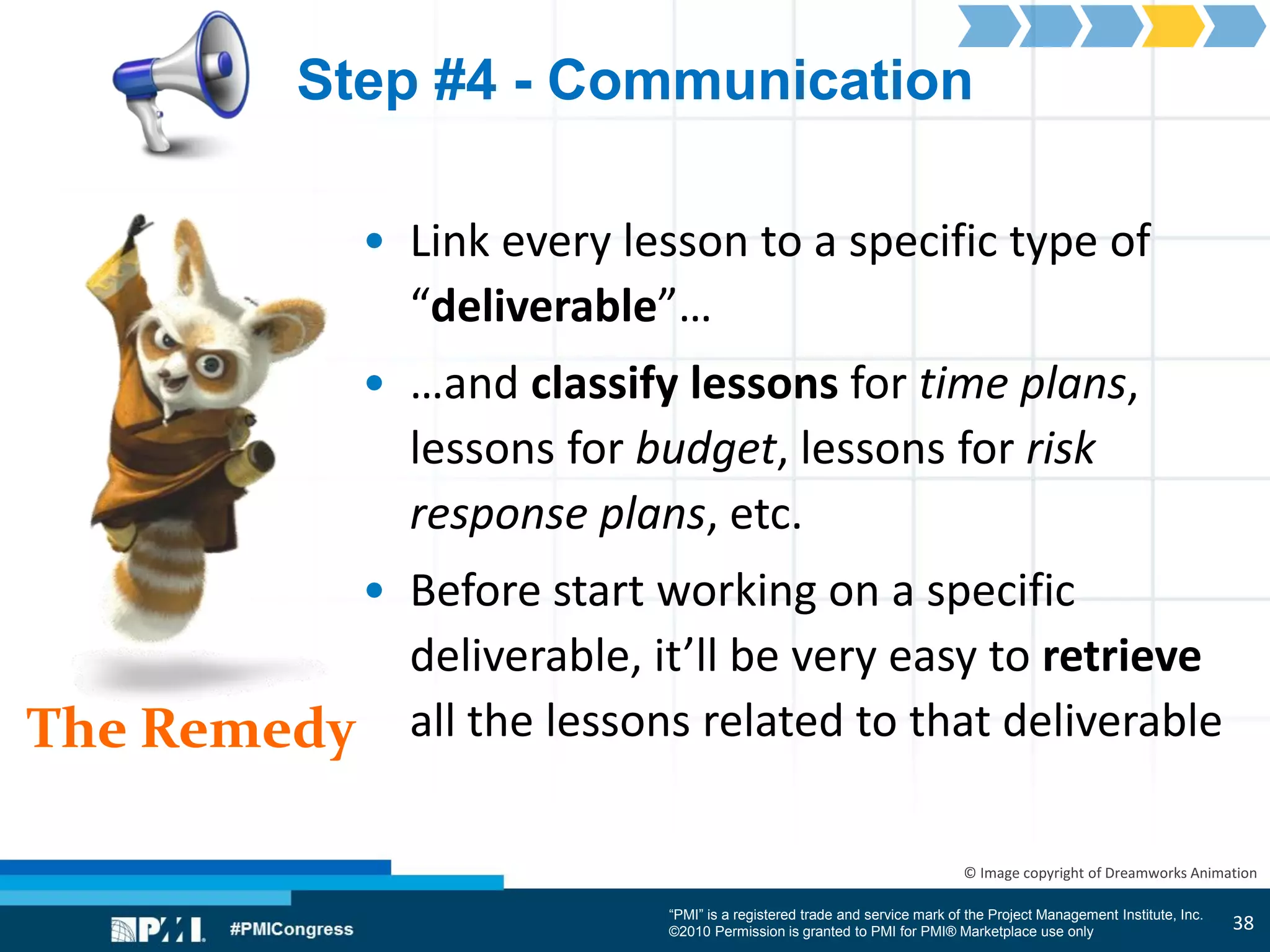

Step #4 - Communication
• Link every lesson to a specific type of
“deliverable”…
• …and classify lessons for time plans,
lessons for budget, lessons for risk
response plans, etc.
• Before start working on a specific
deliverable, it’ll be very easy to retrieve
all the lessons related to that deliverable
38
“PMI” is a registered trade and service mark of the Project Management Institute, Inc.
©2010 Permission is granted to PMI for PMI® Marketplace use only
The Common
practice
© Image copyright of Dreamworks Animation
Step #5 - Assimilation
• Before starting a new project it should
be a good practice to consult the lessons
learned database…
• …to find any applicable knowledge
39
“PMI” is a registered trade and service mark of the Project Management Institute, Inc.
©2010 Permission is granted to PMI for PMI® Marketplace use only
The Trap
© Image copyright of Dreamworks Animation
Step #5 - Assimilation
• When the next project begins, it is hard
to search for any applicable lesson to
the particular situation you have to
face…
• …so often this step is skipped…
• …making useless all the previous efforts
to gather the lessons
40
“PMI” is a registered trade and service mark of the Project Management Institute, Inc.
©2010 Permission is granted to PMI for PMI® Marketplace use only
The Remedy
© Image copyright of Dreamworks Animation

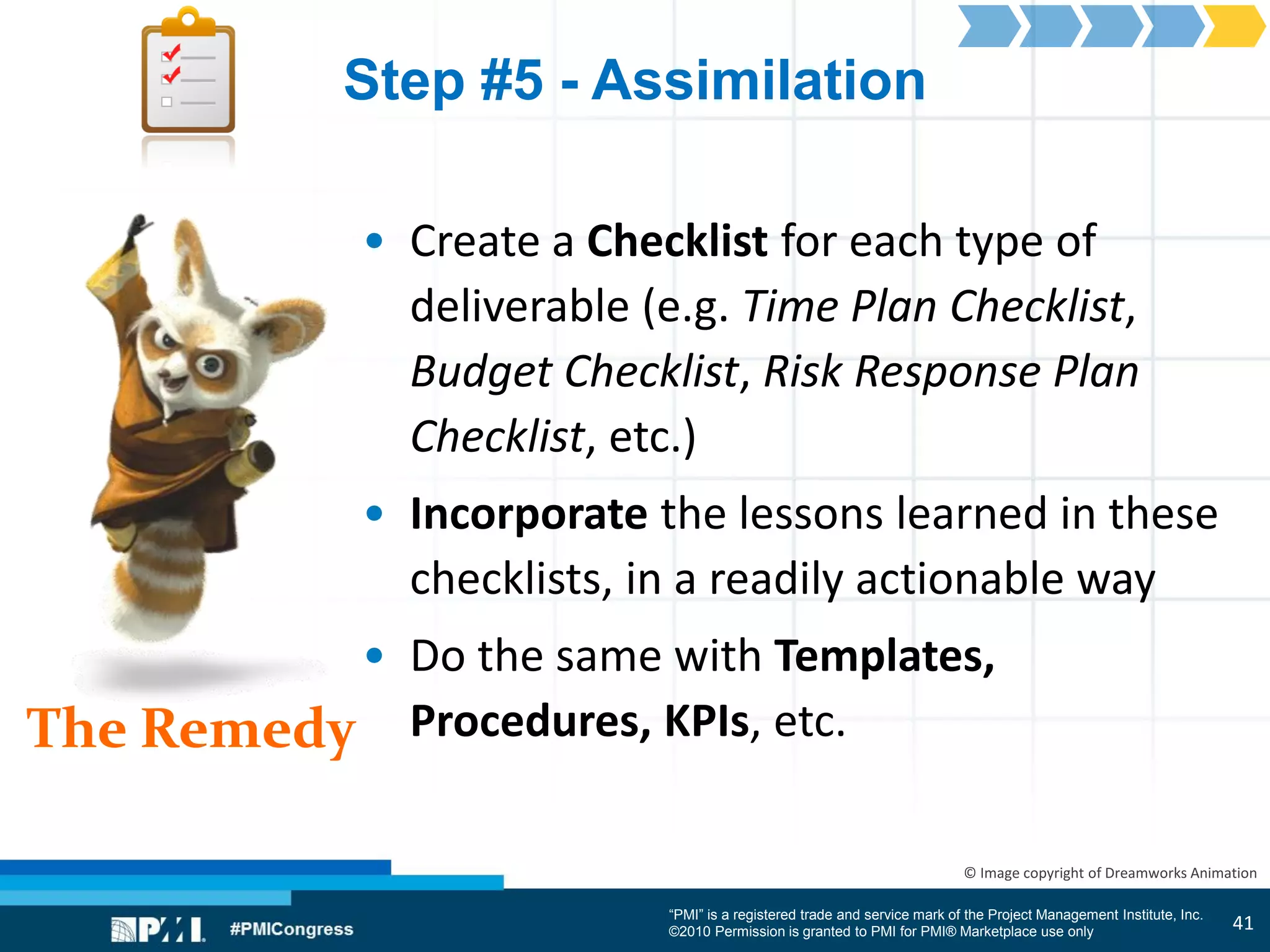

Step #5 - Assimilation
• Create a Checklist for each type of
deliverable (e.g. Time Plan Checklist,
Budget Checklist, Risk Response Plan
Checklist, etc.)
• Incorporate the lessons learned in these
checklists, in a readily actionable way
• Do the same with Templates,
Procedures, KPIs, etc.
41
“PMI” is a registered trade and service mark of the Project Management Institute, Inc.
©2010 Permission is granted to PMI for PMI® Marketplace use only
The Remedy
© Image copyright of Dreamworks Animation

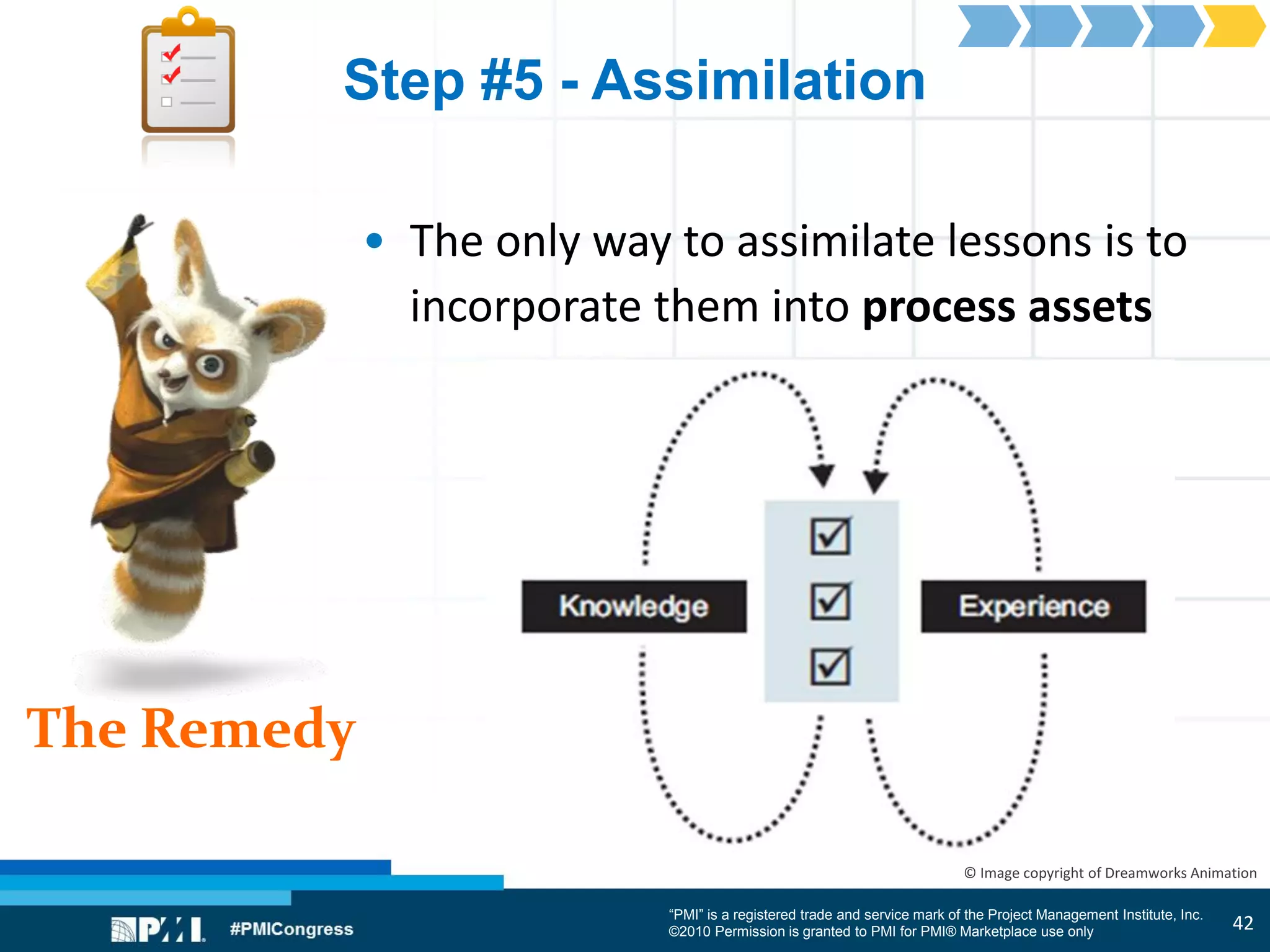

Step #5 - Assimilation
• The only way to assimilate lessons is to
incorporate them into process assets
42
“PMI” is a registered trade and service mark of the Project Management Institute, Inc.
©2010 Permission is granted to PMI for PMI® Marketplace use only
The Remedy
© Image copyright of Dreamworks Animation
Step #5 - Assimilation
• If a lesson is not in the right checklist,
you haven’t learnt it!
43
“PMI” is a registered trade and service mark of the Project Management Institute, Inc.
©2010 Permission is granted to PMI for PMI® Marketplace use only
© Image copyright of Dreamworks Animation
44
Case Study: KM in
construction industry
“PMI” is a registered trade and service mark of the Project Management Institute, Inc.
©2010 Permission is granted to PMI for PMI® Marketplace use only

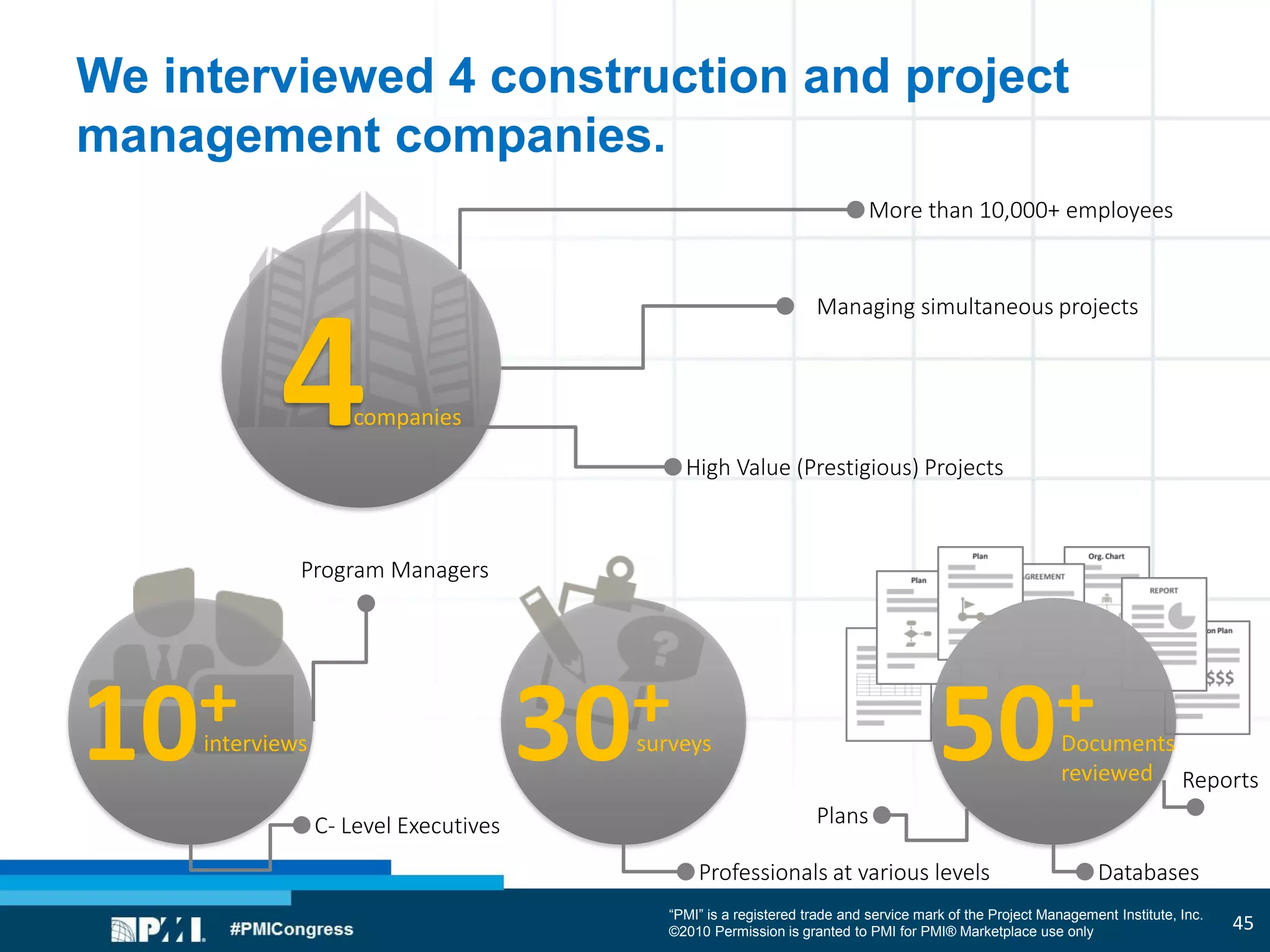

We interviewed 4 construction and project
management companies.
4companies
interviews10+ surveys30+ Documents
reviewed
50+
More than 10,000+ employees
C- Level Executives
Program Managers
Professionals at various levels
Managing simultaneous projects
High Value (Prestigious) Projects
Databases
Reports
Plans
45
“PMI” is a registered trade and service mark of the Project Management Institute, Inc.
©2010 Permission is granted to PMI for PMI® Marketplace use only

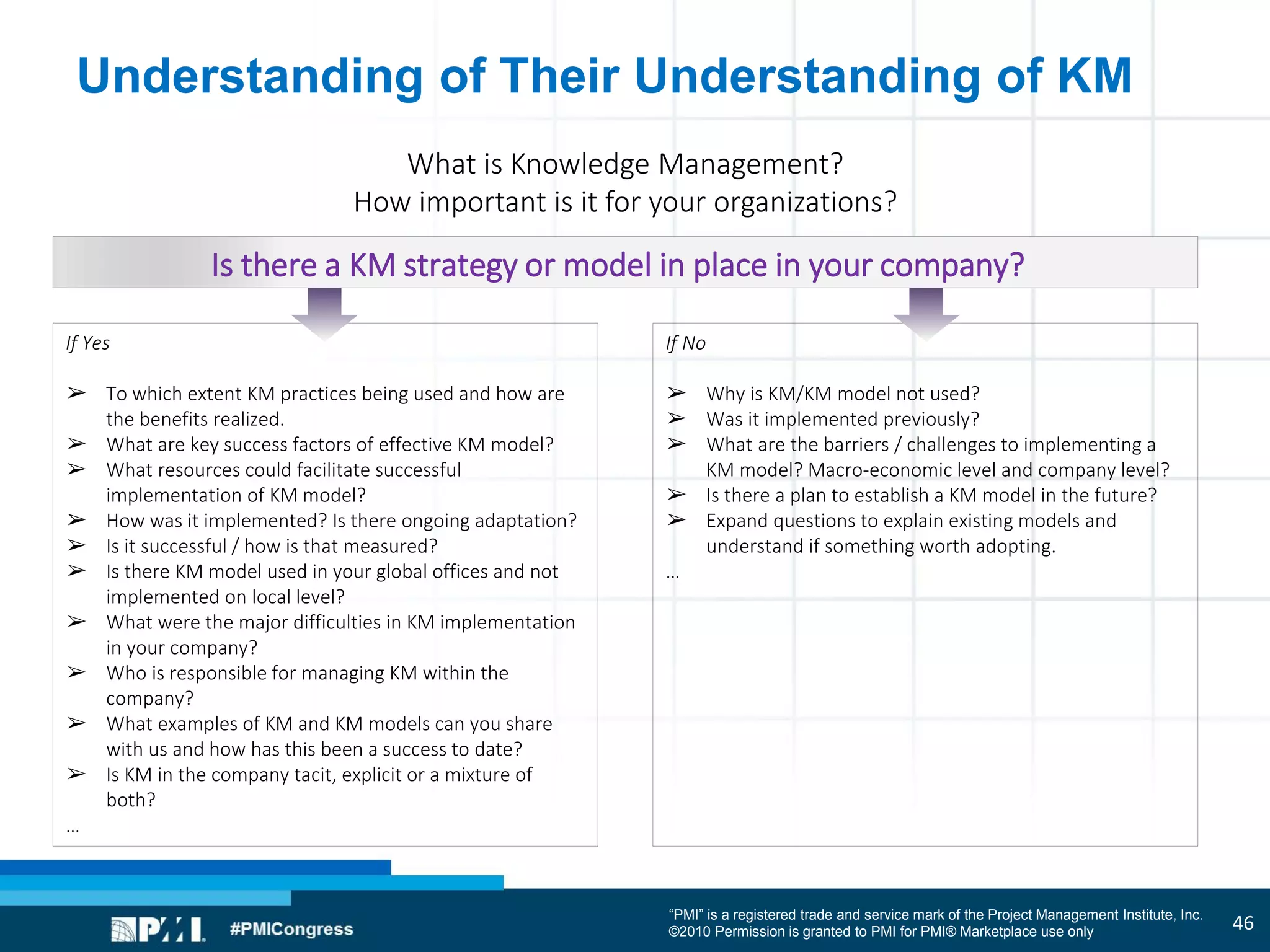

Understanding of Their Understanding of KM
If Yes
➢ To which extent KM practices being used and how are
the benefits realized.
➢ What are key success factors of effective KM model?
➢ What resources could facilitate successful
implementation of KM model?
➢ How was it implemented? Is there ongoing adaptation?
➢ Is it successful / how is that measured?
➢ Is there KM model used in your global offices and not
implemented on local level?
➢ What were the major difficulties in KM implementation
in your company?
➢ Who is responsible for managing KM within the
company?
➢ What examples of KM and KM models can you share
with us and how has this been a success to date?
➢ Is KM in the company tacit, explicit or a mixture of
both?
…
If No
➢ Why is KM/KM model not used?
➢ Was it implemented previously?
➢ What are the barriers / challenges to implementing a
KM model? Macro-economic level and company level?
➢ Is there a plan to establish a KM model in the future?
➢ Expand questions to explain existing models and
understand if something worth adopting.
…
Is there a KM strategy or model in place in your company?
What is Knowledge Management?
How important is it for your organizations?
46
“PMI” is a registered trade and service mark of the Project Management Institute, Inc.
©2010 Permission is granted to PMI for PMI® Marketplace use only

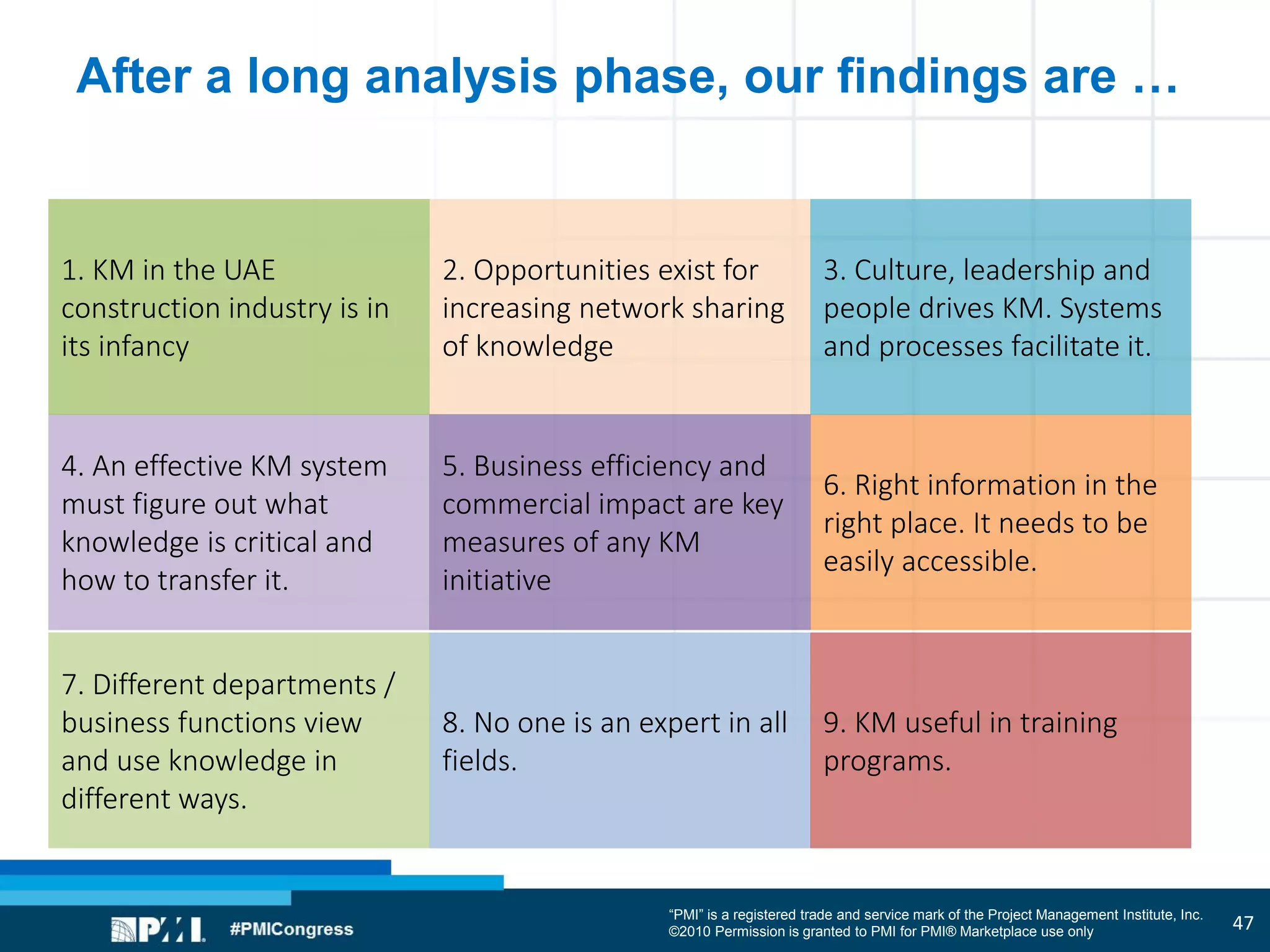

After a long analysis phase, our findings are …
2. Opportunities exist for
increasing network sharing
of knowledge
6. Right information in the
right place. It needs to be
easily accessible.
3. Culture, leadership and
people drives KM. Systems
and processes facilitate it.
4. An effective KM system
must figure out what
knowledge is critical and
how to transfer it.
8. No one is an expert in all
fields.
7. Different departments /
business functions view
and use knowledge in
different ways.
1. KM in the UAE
construction industry is in
its infancy
5. Business efficiency and
commercial impact are key
measures of any KM
initiative
9. KM useful in training
programs.
47
“PMI” is a registered trade and service mark of the Project Management Institute, Inc.
©2010 Permission is granted to PMI for PMI® Marketplace use only

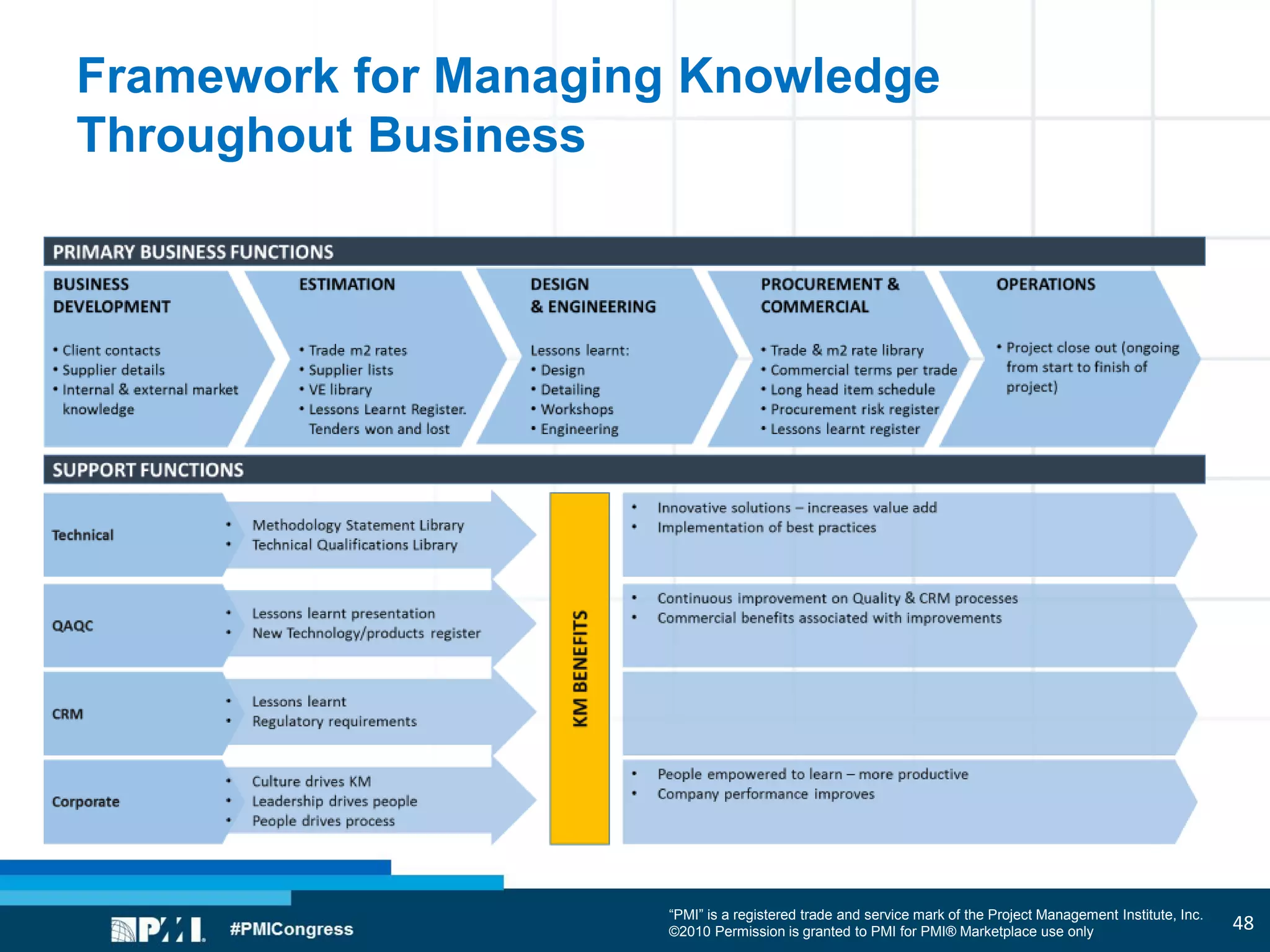

Framework for Managing Knowledge
Throughout Business
48
“PMI” is a registered trade and service mark of the Project Management Institute, Inc.
©2010 Permission is granted to PMI for PMI® Marketplace use only

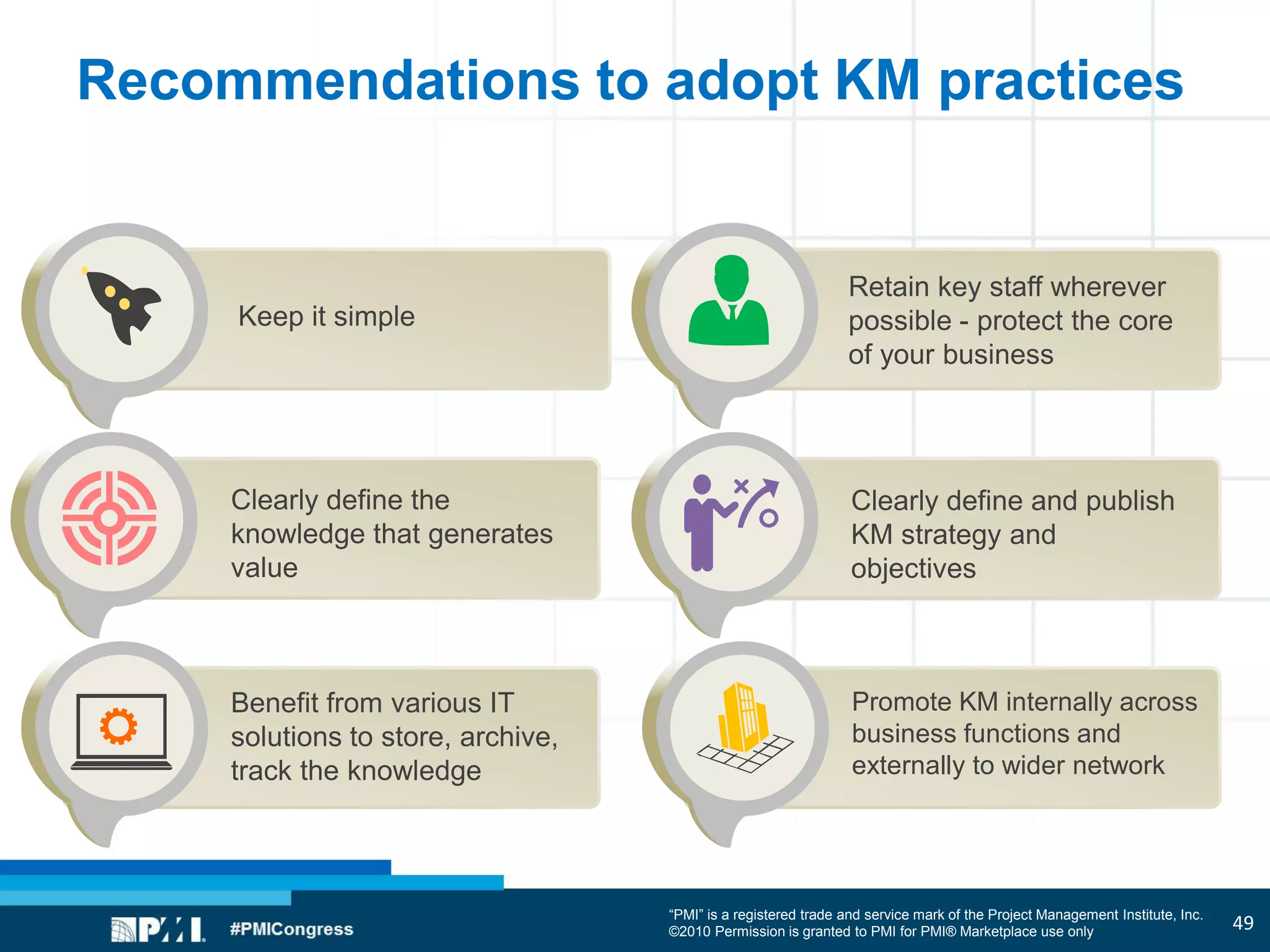

Recommendations to adopt KM practices
Clearly define the
knowledge that generates
value
Clearly define and publish
KM strategy and
objectives
Keep it simple
Retain key staff wherever
possible - protect the core
of your business
Benefit from various IT
solutions to store, archive,
track the knowledge
Promote KM internally across
business functions and
externally to wider network
49
“PMI” is a registered trade and service mark of the Project Management Institute, Inc.
©2010 Permission is granted to PMI for PMI® Marketplace use only
Selected References
1. Alrawi, K. (2008), Knowledge management and organisations perceptions in the United Arab
Emirates: case study, International Journal of Commerce and Management, Volume 18, No.4,
2008, pp. 382 – 394.
2. Carrilo,P.M et al. (2000). Knowledge Management Strategy for Construction: Key IT and
Contextual Issue, Proceedings of CIT 2000, Reykjavik, Iceland, 28-30 June, Gudnason, G. (ed.),
155-165
3. CEN (2004) CEN CWA 14924 European Guide to good Practice in Knowledge Management - Part
1 to 5, Brussels.
4. Siddique, M., (2012), Knowledge management initiatives in the United Arab Emirates: a baseline
study, Journal of Knowledge Management, Vol. 16, Issue 5, pp. 702-723
5. Wiig, K. M. (1993). Knowledge management foundations: Thinking about thinking : how people
and organizations create, represent, and use knowledge. Arlington, Tex: Schema Press.
6. Wong, K., (2005), Critical Success Factors for implementing knowledge management in small and
medium enterprises, Industrial Management and Data Systems, 105 (3), pp 261 -279
7. Yin, R. K. (2009). Case study research: Design and methods (4th ed). Thousand Oaks, CA: Sage
Publications
50
“PMI” is a registered trade and service mark of the Project Management Institute, Inc.
©2010 Permission is granted to PMI for PMI® Marketplace use only 51
That’s all folks!
“PMI” is a registered trade and service mark of the Project Management Institute, Inc.
©2010 Permission is granted to PMI for PMI® Marketplace use only
Questions?
52
“PMI” is a registered trade and service mark of the Project Management Institute, Inc.
©2010 Permission is granted to PMI for PMI® Marketplace use only 53
Our 20th Anniversary
Volunteers: a cast to conquer!
“PMI” is a registered trade and service mark of the Project Management Institute, Inc.
©2010 Permission is granted to PMI for PMI® Marketplace use only
Please rate our session!
Visit the “AoF Sessions” section of
the mobile app and tap on my
session to rate.
marco.negri.330marconegri @piv8tweet mnegri
Name | Marco Negri
Web | www.stradeanas.it
Email | m.negri@stradeanas.it
Thank you!
Lessons (really) Learned?
How to Retain Project Knowledge
and Avoid Recurring Nightmares
Lessons (really) Learned?
Mustafa.dulgerler
Name | Mustafa Dülgerler
Web | www.mustafadulgerler.com
Email | mdulgerler@gmail.com
54

More Related Content

Similar to Lessons (really) Learned? How to Retain Project Knowledge and Avoid Recurring Nightmares

SMAC and Transforming Innovation
SMAC and Transforming InnovationSMAC and Transforming Innovation
Scope: Mastering the Fuzzy Constraint
Scope: Mastering the Fuzzy ConstraintScope: Mastering the Fuzzy Constraint
Scope: Mastering the Fuzzy Constraint
bbigelow

PMI Global Congress 2012
PMI Global Congress 2012PMI Global Congress 2012
PMI Global Congress 2012
DC-DinsmoreCompass

An Introduction to Visual Management Systems
An Introduction to Visual Management SystemsAn Introduction to Visual Management Systems
An Introduction to Visual Management SystemsDerek Huether

Click with Ease
Click with EaseClick with Ease
Click with Ease
ronaslideshare

PMI Global Congress North America 2015 - Change the system, not the people.
PMI Global Congress North America 2015 - Change the system, not the people.PMI Global Congress North America 2015 - Change the system, not the people.
PMI Global Congress North America 2015 - Change the system, not the people.
Michal Raczka

Agile Collaboration in a Virtual World: Harnessing Social Media, Web 2.0 and ...
Agile Collaboration in a Virtual World: Harnessing Social Media, Web 2.0 and ...Agile Collaboration in a Virtual World: Harnessing Social Media, Web 2.0 and ...
Agile Collaboration in a Virtual World: Harnessing Social Media, Web 2.0 and ...
Wrike

Ev08 sep17 pmi_virtual_teams(final)1 (2)
Ev08 sep17 pmi_virtual_teams(final)1 (2)Ev08 sep17 pmi_virtual_teams(final)1 (2)
Ev08 sep17 pmi_virtual_teams(final)1 (2)
Marcia B. Riley

Sneak peek na15 agl01 leading construction industry to lean-agile (leagile)...
Sneak peek na15 agl01   leading construction industry to lean-agile (leagile)...Sneak peek na15 agl01   leading construction industry to lean-agile (leagile)...
Sneak peek na15 agl01 leading construction industry to lean-agile (leagile)...
Iram hasan

Pmi lebanon conference workshop-initiating proftiable projects-saadi adra
Pmi lebanon conference workshop-initiating proftiable projects-saadi adraPmi lebanon conference workshop-initiating proftiable projects-saadi adra
Pmi lebanon conference workshop-initiating proftiable projects-saadi adra
PMILebanonChapter

AOTMP Conference Speaker Presentation: Confessions of a TEM Project Manager
AOTMP Conference Speaker Presentation: Confessions of a TEM Project ManagerAOTMP Conference Speaker Presentation: Confessions of a TEM Project Manager
AOTMP Conference Speaker Presentation: Confessions of a TEM Project Manager
John Venditti

Managing the People Side of Change: An Applied Framework
Managing the People Side of Change:  An Applied FrameworkManaging the People Side of Change:  An Applied Framework
Managing the People Side of Change: An Applied Framework
Richardson Consulting Group, Inc.

Climbing the Ladder Means Letting Go: Attributes that make you good at one le...
Climbing the Ladder Means Letting Go: Attributes that make you good at one le...Climbing the Ladder Means Letting Go: Attributes that make you good at one le...
Climbing the Ladder Means Letting Go: Attributes that make you good at one le...
PM Solutions

3 Questions PM needs to ask for Stakeholder Management
3 Questions PM needs to ask for Stakeholder Management3 Questions PM needs to ask for Stakeholder Management
3 Questions PM needs to ask for Stakeholder Management
Syed Basharat Aziz, PMP, ITIL Expert, ISO, PCIP, MSIT.

E992bba7 95bb-4b05-a1b4-54755c3a6f1d-141210125815-conversion-gate02
E992bba7 95bb-4b05-a1b4-54755c3a6f1d-141210125815-conversion-gate02E992bba7 95bb-4b05-a1b4-54755c3a6f1d-141210125815-conversion-gate02
E992bba7 95bb-4b05-a1b4-54755c3a6f1d-141210125815-conversion-gate02
Ronitmehta1

Managing an ITIL SaaS implementation IT program
Managing an ITIL SaaS implementation IT programManaging an ITIL SaaS implementation IT program
Managing an ITIL SaaS implementation IT programGottfried Rudorfer

PMI NA Global congress 2011
PMI NA Global congress 2011PMI NA Global congress 2011
PMI NA Global congress 2011
Joseph Flahiff

Project management and organizational change management
Project management and organizational change managementProject management and organizational change management
Project management and organizational change managementSusan Boyd


Similar to Lessons (really) Learned? How to Retain Project Knowledge and Avoid Recurring Nightmares (20)

GOV05-final-ppt
GOV05-final-pptGOV05-final-ppt
GOV05-final-ppt

GOV05-final-ppt
GOV05-final-pptGOV05-final-ppt
GOV05-final-ppt

SMAC and Transforming Innovation
SMAC and Transforming InnovationSMAC and Transforming Innovation
SMAC and Transforming Innovation

Scope: Mastering the Fuzzy Constraint
Scope: Mastering the Fuzzy ConstraintScope: Mastering the Fuzzy Constraint
Scope: Mastering the Fuzzy Constraint

PMI Global Congress 2012
PMI Global Congress 2012PMI Global Congress 2012
PMI Global Congress 2012

An Introduction to Visual Management Systems
An Introduction to Visual Management SystemsAn Introduction to Visual Management Systems
An Introduction to Visual Management Systems

Click with Ease
Click with EaseClick with Ease
Click with Ease

PMI Global Congress North America 2015 - Change the system, not the people.
PMI Global Congress North America 2015 - Change the system, not the people.PMI Global Congress North America 2015 - Change the system, not the people.
PMI Global Congress North America 2015 - Change the system, not the people.

Agile Collaboration in a Virtual World: Harnessing Social Media, Web 2.0 and ...
Agile Collaboration in a Virtual World: Harnessing Social Media, Web 2.0 and ...Agile Collaboration in a Virtual World: Harnessing Social Media, Web 2.0 and ...
Agile Collaboration in a Virtual World: Harnessing Social Media, Web 2.0 and ...

Ev08 sep17 pmi_virtual_teams(final)1 (2)
Ev08 sep17 pmi_virtual_teams(final)1 (2)Ev08 sep17 pmi_virtual_teams(final)1 (2)
Ev08 sep17 pmi_virtual_teams(final)1 (2)

Sneak peek na15 agl01 leading construction industry to lean-agile (leagile)...
Sneak peek na15 agl01   leading construction industry to lean-agile (leagile)...Sneak peek na15 agl01   leading construction industry to lean-agile (leagile)...
Sneak peek na15 agl01 leading construction industry to lean-agile (leagile)...

Pmi lebanon conference workshop-initiating proftiable projects-saadi adra
Pmi lebanon conference workshop-initiating proftiable projects-saadi adraPmi lebanon conference workshop-initiating proftiable projects-saadi adra
Pmi lebanon conference workshop-initiating proftiable projects-saadi adra

AOTMP Conference Speaker Presentation: Confessions of a TEM Project Manager
AOTMP Conference Speaker Presentation: Confessions of a TEM Project ManagerAOTMP Conference Speaker Presentation: Confessions of a TEM Project Manager
AOTMP Conference Speaker Presentation: Confessions of a TEM Project Manager

Managing the People Side of Change: An Applied Framework
Managing the People Side of Change:  An Applied FrameworkManaging the People Side of Change:  An Applied Framework
Managing the People Side of Change: An Applied Framework

Climbing the Ladder Means Letting Go: Attributes that make you good at one le...
Climbing the Ladder Means Letting Go: Attributes that make you good at one le...Climbing the Ladder Means Letting Go: Attributes that make you good at one le...
Climbing the Ladder Means Letting Go: Attributes that make you good at one le...

3 Questions PM needs to ask for Stakeholder Management
3 Questions PM needs to ask for Stakeholder Management3 Questions PM needs to ask for Stakeholder Management
3 Questions PM needs to ask for Stakeholder Management

E992bba7 95bb-4b05-a1b4-54755c3a6f1d-141210125815-conversion-gate02
E992bba7 95bb-4b05-a1b4-54755c3a6f1d-141210125815-conversion-gate02E992bba7 95bb-4b05-a1b4-54755c3a6f1d-141210125815-conversion-gate02
E992bba7 95bb-4b05-a1b4-54755c3a6f1d-141210125815-conversion-gate02

Managing an ITIL SaaS implementation IT program
Managing an ITIL SaaS implementation IT programManaging an ITIL SaaS implementation IT program
Managing an ITIL SaaS implementation IT program

PMI NA Global congress 2011
PMI NA Global congress 2011PMI NA Global congress 2011
PMI NA Global congress 2011

Project management and organizational change management
Project management and organizational change managementProject management and organizational change management
Project management and organizational change management


Lessons (really) Learned? How to Retain Project Knowledge and Avoid Recurring Nightmares

  • 1. “PMI” is a registered trade and service mark of the Project Management Institute, Inc. ©2010 Permission is granted to PMI for PMI® Marketplace use only Lessons (really) Learned? How to Retain Project Knowledge and Avoid Recurring Nightmares MUSTAFA DÜLGERLER National Bank of Abu Dhabi MARCO NEGRI Anas S.p.A. 1
  • 2. “PMI” is a registered trade and service mark of the Project Management Institute, Inc. ©2010 Permission is granted to PMI for PMI® Marketplace use only Marco Negri Mustafa Dülgerler 2 Who I am Where I come from IT Manager, PMP, CBAP, COBIT, ITIL 16+ years IT experience Anas SpA: Italy’s National Roads Authority 30.500 km of roads and highways 6.500 employees Who I am Where I come from Project Manager, Trainer, Enterprise Architect 13+ years of experience National Bank of Abu Dhabi Presence in 16 countries 5,000 employees
  • 3. “PMI” is a registered trade and service mark of the Project Management Institute, Inc. ©2010 Permission is granted to PMI for PMI® Marketplace use only Agenda Knowledge Management Lessons Learned Case Study: KM in practice Conclusion 1 2 3 4 3
  • 4. “PMI” is a registered trade and service mark of the Project Management Institute, Inc. ©2010 Permission is granted to PMI for PMI® Marketplace use only Session objectives • Present Knowledge Management as a means of improving business performance • Suggest useful tips about Lessons Learned • Present a Case Study in the construction industry 4
  • 5. “PMI” is a registered trade and service mark of the Project Management Institute, Inc. ©2010 Permission is granted to PMI for PMI® Marketplace use only Information is NOT Knowledge Albert Einstein 5
  • 6. “PMI” is a registered trade and service mark of the Project Management Institute, Inc. ©2010 Permission is granted to PMI for PMI® Marketplace use only The definition of “Knowledge” still remains elusive. © Image copyright of Dreamworks Pictures 6
  • 7. “PMI” is a registered trade and service mark of the Project Management Institute, Inc. ©2010 Permission is granted to PMI for PMI® Marketplace use only Knowledge Fairs Workshop, Training and Seminars Forums and Meetings Peer Assist, Review Storytelling Mentoring Coaching Communities of Practice Defining KM becomes more difficult Data Data Data Information Capture Process Knowledge 7
  • 8. “PMI” is a registered trade and service mark of the Project Management Institute, Inc. ©2010 Permission is granted to PMI for PMI® Marketplace use only KM requires continuous effort KNOWLEDGE MANAGEMENT 8
  • 9. “PMI” is a registered trade and service mark of the Project Management Institute, Inc. ©2010 Permission is granted to PMI for PMI® Marketplace use only Many models attempt to explain KM from different perspectives
  • 10. “PMI” is a registered trade and service mark of the Project Management Institute, Inc. ©2010 Permission is granted to PMI for PMI® Marketplace use only CEN explains one of the most effective KM Models CEN (2004) 10
  • 11. “PMI” is a registered trade and service mark of the Project Management Institute, Inc. ©2010 Permission is granted to PMI for PMI® Marketplace use only 11
  • 12. “PMI” is a registered trade and service mark of the Project Management Institute, Inc. ©2010 Permission is granted to PMI for PMI® Marketplace use only What are Lessons Learned? 12
  • 13. “PMI” is a registered trade and service mark of the Project Management Institute, Inc. ©2010 Permission is granted to PMI for PMI® Marketplace use only What are Lessons Learned? • “The knowledge gained during a project… • …which shows how project events were addressed or should be addressed in the future… • …with the purpose of improving future performance.” (PMBOK 5th edition) 13
  • 14. “PMI” is a registered trade and service mark of the Project Management Institute, Inc. ©2010 Permission is granted to PMI for PMI® Marketplace use only What are Lessons Learned? Three Ingredients: 1. An experience to learn from 2. A pattern of doing things in similar situations 3. A goal to improve something 14
  • 15. “PMI” is a registered trade and service mark of the Project Management Institute, Inc. ©2010 Permission is granted to PMI for PMI® Marketplace use only What are Lessons Learned? • The traditional form of a lesson learned: – In this situation… – you should do this… – in order to improve/avoid that 15
  • 16. “PMI” is a registered trade and service mark of the Project Management Institute, Inc. ©2010 Permission is granted to PMI for PMI® Marketplace use only The Lessons Learned Traditional Process 16
  • 17. “PMI” is a registered trade and service mark of the Project Management Institute, Inc. ©2010 Permission is granted to PMI for PMI® Marketplace use only The Lessons Learned Traditional Process • Three main steps: 1. Collection: analyze experience and identify lessons 2. Documentation: document and archive identified lesson 3. Communication: communicate lessons to the people that should use them 17 Collection Documentation Communication
  • 18. “PMI” is a registered trade and service mark of the Project Management Institute, Inc. ©2010 Permission is granted to PMI for PMI® Marketplace use only The Lessons Learned Traditional Process • Shortcomings: − Most companies have institutionalized the process of collecting, documenting and communicating lessons learned… − …but lessons often get lost in some sort of “lessons learned database” - as in a “black hole” - that nobody ever looks at 18
  • 19. “PMI” is a registered trade and service mark of the Project Management Institute, Inc. ©2010 Permission is granted to PMI for PMI® Marketplace use only The Lessons Learned Traditional Process • Why the traditional process fails? 1. Failure to focus on what matters most 2. Failure to assimilate lessons into company culture & processes 19
  • 20. “PMI” is a registered trade and service mark of the Project Management Institute, Inc. ©2010 Permission is granted to PMI for PMI® Marketplace use only The proposed process Collection Prioritization Documentation Communication Assimilation 20
  • 21. “PMI” is a registered trade and service mark of the Project Management Institute, Inc. ©2010 Permission is granted to PMI for PMI® Marketplace use only The proposed process • Adding two steps: 1. Collection: analyze experience and identify lessons 2. Prioritization: filter only the relevant lessons for further processing 3. Documentation: document and archive identified lesson 4. Communication: communicate lessons to the people that should use them 5. Assimilation: where happens the true “digestion” of the lessons by the organization 21
  • 22. “PMI” is a registered trade and service mark of the Project Management Institute, Inc. ©2010 Permission is granted to PMI for PMI® Marketplace use only Lessons Learned Tips 22
  • 23. “PMI” is a registered trade and service mark of the Project Management Institute, Inc. ©2010 Permission is granted to PMI for PMI® Marketplace use only Lessons Learned Tips • For each of the 5 steps of the proposed process some typical traps and implementation tips will be presented… • …from the real-life experience of the speaker 23
  • 24. “PMI” is a registered trade and service mark of the Project Management Institute, Inc. ©2010 Permission is granted to PMI for PMI® Marketplace use only © Image copyright of Dreamworks Animation Lessons Learned Tips • Each step will be presented with three points: –The Common practice –The Trap –The Remedy • Using a cinematographic metaphor from… 24
  • 25. “PMI” is a registered trade and service mark of the Project Management Institute, Inc. ©2010 Permission is granted to PMI for PMI® Marketplace use only © Image copyright of Dreamworks Animation Lessons Learned Tips The Common Practice The RemedyThe Trap The Common practice is the traditional way to do things The Trap is what often actually happen The Remedy is the suggested approach to prevent the issue Tradition hard reality Prevention 25
  • 26. “PMI” is a registered trade and service mark of the Project Management Institute, Inc. ©2010 Permission is granted to PMI for PMI® Marketplace use only Collection Prioritization Documentation Communication Assimilation The proposed process (recap) 26
  • 27. “PMI” is a registered trade and service mark of the Project Management Institute, Inc. ©2010 Permission is granted to PMI for PMI® Marketplace use only The Common practice © Image copyright of Dreamworks Animation Step #1 - Collection • Lessons are usually gathered directly from project stakeholders, through: • Post Project Review • Project Appraisal • Project Assessment • Project Audit • Project Evaluation • etc… 27
  • 28. “PMI” is a registered trade and service mark of the Project Management Institute, Inc. ©2010 Permission is granted to PMI for PMI® Marketplace use only The Trap © Image copyright of Dreamworks Animation Step #1 - Collection • People is normally reluctant to admit failures... • …so lessons learned workshops are ineffective to address the real causes of failures 28
  • 29. “PMI” is a registered trade and service mark of the Project Management Institute, Inc. ©2010 Permission is granted to PMI for PMI® Marketplace use only The Remedy © Image copyright of Dreamworks Animation Step #1 - Collection • “Delplhi method”: 1. Participants answer questionnaires (e.g. “what went bad/good?”) 2. After each round a facilitator provides an anonymous summary 3. Participants are encouraged to revise their earlier answers in light of the replies of others 29
  • 30. “PMI” is a registered trade and service mark of the Project Management Institute, Inc. ©2010 Permission is granted to PMI for PMI® Marketplace use only The Common practice © Image copyright of Dreamworks Animation Step #2 - Prioritization • All the lessons identified by “Post Project Review” participants are documented for future retrieval • Every participant is given the chance to add his findings… • …independently of his role or contribution to the project 30
  • 31. “PMI” is a registered trade and service mark of the Project Management Institute, Inc. ©2010 Permission is granted to PMI for PMI® Marketplace use only The Trap © Image copyright of Dreamworks Animation Step #2 - Prioritization • Not every partecipant has the same level of awareness of project issues and underlying causes… • …and everyone has the tendency to consider his viewpoint the most important • The result is a big mess of disarticulated lessons, that fails to concentrate on the few main issues that jeopardize projects 31
  • 32. “PMI” is a registered trade and service mark of the Project Management Institute, Inc. ©2010 Permission is granted to PMI for PMI® Marketplace use only The Remedy © Image copyright of Dreamworks Animation Step #2 - Prioritization • Restrict the prioritization process only to the key project team members • Use a scoring system to identify the most effective lessons • “Dot-voting”: − Participants are given a fixed number of prioritization “units” (usually “dot stickers”)… − …which they distribute among the lessons being prioritized 32
  • 33. “PMI” is a registered trade and service mark of the Project Management Institute, Inc. ©2010 Permission is granted to PMI for PMI® Marketplace use only The Common practice © Image copyright of Dreamworks Animation Step #3 - Documentation • Describe the lessons in a textual format… • …linking each lesson to the problem it should prevent 33
  • 34. “PMI” is a registered trade and service mark of the Project Management Institute, Inc. ©2010 Permission is granted to PMI for PMI® Marketplace use only The Trap © Image copyright of Dreamworks Animation Step #3 - Documentation • Often lessons are documented in a “not- actionable” format… • …with no practical instruction on how to implement the lesson • Generic terms are used, like: • be careful when… • we will strive more to… • etc. 34
  • 35. “PMI” is a registered trade and service mark of the Project Management Institute, Inc. ©2010 Permission is granted to PMI for PMI® Marketplace use only The Remedy © Image copyright of Dreamworks Animation Step #3 - Documentation • Try to identify the practical changes in the way of doing things • For example: − further detail the lesson “be careful when” into “check this and that when…” − …or transform “we will strive more to…” into “you will need at minimum two people to…” 35
  • 36. “PMI” is a registered trade and service mark of the Project Management Institute, Inc. ©2010 Permission is granted to PMI for PMI® Marketplace use only The Common practice © Image copyright of Dreamworks Animation Step #4 - Communication • Communicate lessons learned by publishing them in: • Blogs • Wikis • Corporate intranets • Project sites • Knowledge Management Systems • etc. 36
  • 37. “PMI” is a registered trade and service mark of the Project Management Institute, Inc. ©2010 Permission is granted to PMI for PMI® Marketplace use only The Trap © Image copyright of Dreamworks Animation Step #4 - Communication • When the next project begins, no one looks into the huge lessons learned database… • …because it is very time consuming to find the right lesson learned for the specific work you have to do at the moment 37
  • 38. “PMI” is a registered trade and service mark of the Project Management Institute, Inc. ©2010 Permission is granted to PMI for PMI® Marketplace use only The Remedy © Image copyright of Dreamworks Animation Step #4 - Communication • Link every lesson to a specific type of “deliverable”… • …and classify lessons for time plans, lessons for budget, lessons for risk response plans, etc. • Before start working on a specific deliverable, it’ll be very easy to retrieve all the lessons related to that deliverable 38
  • 39. “PMI” is a registered trade and service mark of the Project Management Institute, Inc. ©2010 Permission is granted to PMI for PMI® Marketplace use only The Common practice © Image copyright of Dreamworks Animation Step #5 - Assimilation • Before starting a new project it should be a good practice to consult the lessons learned database… • …to find any applicable knowledge 39
  • 40. “PMI” is a registered trade and service mark of the Project Management Institute, Inc. ©2010 Permission is granted to PMI for PMI® Marketplace use only The Trap © Image copyright of Dreamworks Animation Step #5 - Assimilation • When the next project begins, it is hard to search for any applicable lesson to the particular situation you have to face… • …so often this step is skipped… • …making useless all the previous efforts to gather the lessons 40
  • 41. “PMI” is a registered trade and service mark of the Project Management Institute, Inc. ©2010 Permission is granted to PMI for PMI® Marketplace use only The Remedy © Image copyright of Dreamworks Animation Step #5 - Assimilation • Create a Checklist for each type of deliverable (e.g. Time Plan Checklist, Budget Checklist, Risk Response Plan Checklist, etc.) • Incorporate the lessons learned in these checklists, in a readily actionable way • Do the same with Templates, Procedures, KPIs, etc. 41
  • 42. “PMI” is a registered trade and service mark of the Project Management Institute, Inc. ©2010 Permission is granted to PMI for PMI® Marketplace use only The Remedy © Image copyright of Dreamworks Animation Step #5 - Assimilation • The only way to assimilate lessons is to incorporate them into process assets 42
  • 43. “PMI” is a registered trade and service mark of the Project Management Institute, Inc. ©2010 Permission is granted to PMI for PMI® Marketplace use only The Remedy © Image copyright of Dreamworks Animation Step #5 - Assimilation • If a lesson is not in the right checklist, you haven’t learnt it! 43
  • 44. “PMI” is a registered trade and service mark of the Project Management Institute, Inc. ©2010 Permission is granted to PMI for PMI® Marketplace use only © Image copyright of Dreamworks Animation 44 Case Study: KM in construction industry
  • 45. “PMI” is a registered trade and service mark of the Project Management Institute, Inc. ©2010 Permission is granted to PMI for PMI® Marketplace use only We interviewed 4 construction and project management companies. 4companies interviews10+ surveys30+ Documents reviewed 50+ More than 10,000+ employees C- Level Executives Program Managers Professionals at various levels Managing simultaneous projects High Value (Prestigious) Projects Databases Reports Plans 45
  • 46. “PMI” is a registered trade and service mark of the Project Management Institute, Inc. ©2010 Permission is granted to PMI for PMI® Marketplace use only Understanding of Their Understanding of KM If Yes ➢ To which extent KM practices being used and how are the benefits realized. ➢ What are key success factors of effective KM model? ➢ What resources could facilitate successful implementation of KM model? ➢ How was it implemented? Is there ongoing adaptation? ➢ Is it successful / how is that measured? ➢ Is there KM model used in your global offices and not implemented on local level? ➢ What were the major difficulties in KM implementation in your company? ➢ Who is responsible for managing KM within the company? ➢ What examples of KM and KM models can you share with us and how has this been a success to date? ➢ Is KM in the company tacit, explicit or a mixture of both? … If No ➢ Why is KM/KM model not used? ➢ Was it implemented previously? ➢ What are the barriers / challenges to implementing a KM model? Macro-economic level and company level? ➢ Is there a plan to establish a KM model in the future? ➢ Expand questions to explain existing models and understand if something worth adopting. … Is there a KM strategy or model in place in your company? What is Knowledge Management? How important is it for your organizations? 46
  • 47. “PMI” is a registered trade and service mark of the Project Management Institute, Inc. ©2010 Permission is granted to PMI for PMI® Marketplace use only After a long analysis phase, our findings are … 2. Opportunities exist for increasing network sharing of knowledge 6. Right information in the right place. It needs to be easily accessible. 3. Culture, leadership and people drives KM. Systems and processes facilitate it. 4. An effective KM system must figure out what knowledge is critical and how to transfer it. 8. No one is an expert in all fields. 7. Different departments / business functions view and use knowledge in different ways. 1. KM in the UAE construction industry is in its infancy 5. Business efficiency and commercial impact are key measures of any KM initiative 9. KM useful in training programs. 47
  • 48. “PMI” is a registered trade and service mark of the Project Management Institute, Inc. ©2010 Permission is granted to PMI for PMI® Marketplace use only Framework for Managing Knowledge Throughout Business 48
  • 49. “PMI” is a registered trade and service mark of the Project Management Institute, Inc. ©2010 Permission is granted to PMI for PMI® Marketplace use only Recommendations to adopt KM practices Clearly define the knowledge that generates value Clearly define and publish KM strategy and objectives Keep it simple Retain key staff wherever possible - protect the core of your business Benefit from various IT solutions to store, archive, track the knowledge Promote KM internally across business functions and externally to wider network 49
  • 50. “PMI” is a registered trade and service mark of the Project Management Institute, Inc. ©2010 Permission is granted to PMI for PMI® Marketplace use only Selected References 1. Alrawi, K. (2008), Knowledge management and organisations perceptions in the United Arab Emirates: case study, International Journal of Commerce and Management, Volume 18, No.4, 2008, pp. 382 – 394. 2. Carrilo,P.M et al. (2000). Knowledge Management Strategy for Construction: Key IT and Contextual Issue, Proceedings of CIT 2000, Reykjavik, Iceland, 28-30 June, Gudnason, G. (ed.), 155-165 3. CEN (2004) CEN CWA 14924 European Guide to good Practice in Knowledge Management - Part 1 to 5, Brussels. 4. Siddique, M., (2012), Knowledge management initiatives in the United Arab Emirates: a baseline study, Journal of Knowledge Management, Vol. 16, Issue 5, pp. 702-723 5. Wiig, K. M. (1993). Knowledge management foundations: Thinking about thinking : how people and organizations create, represent, and use knowledge. Arlington, Tex: Schema Press. 6. Wong, K., (2005), Critical Success Factors for implementing knowledge management in small and medium enterprises, Industrial Management and Data Systems, 105 (3), pp 261 -279 7. Yin, R. K. (2009). Case study research: Design and methods (4th ed). Thousand Oaks, CA: Sage Publications 50
  • 51. “PMI” is a registered trade and service mark of the Project Management Institute, Inc. ©2010 Permission is granted to PMI for PMI® Marketplace use only 51 That’s all folks!
  • 52. “PMI” is a registered trade and service mark of the Project Management Institute, Inc. ©2010 Permission is granted to PMI for PMI® Marketplace use only Questions? 52
  • 53. “PMI” is a registered trade and service mark of the Project Management Institute, Inc. ©2010 Permission is granted to PMI for PMI® Marketplace use only 53 Our 20th Anniversary Volunteers: a cast to conquer!
  • 54. “PMI” is a registered trade and service mark of the Project Management Institute, Inc. ©2010 Permission is granted to PMI for PMI® Marketplace use only Please rate our session! Visit the “AoF Sessions” section of the mobile app and tap on my session to rate. marco.negri.330marconegri @piv8tweet mnegri Name | Marco Negri Web | www.stradeanas.it Email | m.negri@stradeanas.it Thank you! Lessons (really) Learned? How to Retain Project Knowledge and Avoid Recurring Nightmares Lessons (really) Learned? Mustafa.dulgerler Name | Mustafa Dülgerler Web | www.mustafadulgerler.com Email | mdulgerler@gmail.com 54
