Vaasa Finland, 23 Sep 2024
Slides: http://slideshare.net/LaBlogga
Melanie Swan, PhD, MBA
DIYgenomics.org (Research Lead)
University College London (Research Associate)
“Do not undertake a project unless it is manifestly
important and nearly impossible”
– Edwin Land, Co-Founder, Polaroid Camera
Digital Transformation
AI Project Management Agents
23 Sep 2024
Digital Transformation 2
Research Agenda
2015 2019 2020
Blockchain Blockchain
Economics
Quantum
Computing
Quantum Computing
for the Brain
2022
Aim: Build long-term futures for humanity through smart
network technologies and science frontiers
Math Agents
2023
Health Agents
2024
“The App will see you now~!”
Blockchain 1.0: Currency
Blockchain 2.0: Contracts
Blockchain 3.0: Beyond
Smart Network
Field Theory
23 Sep 2024
Digital Transformation
Agenda
 Digital Transformation
 Project Management
 Methods
 Waterfall vs Agile (and Scrum)
 Planning and Scheduling Tools

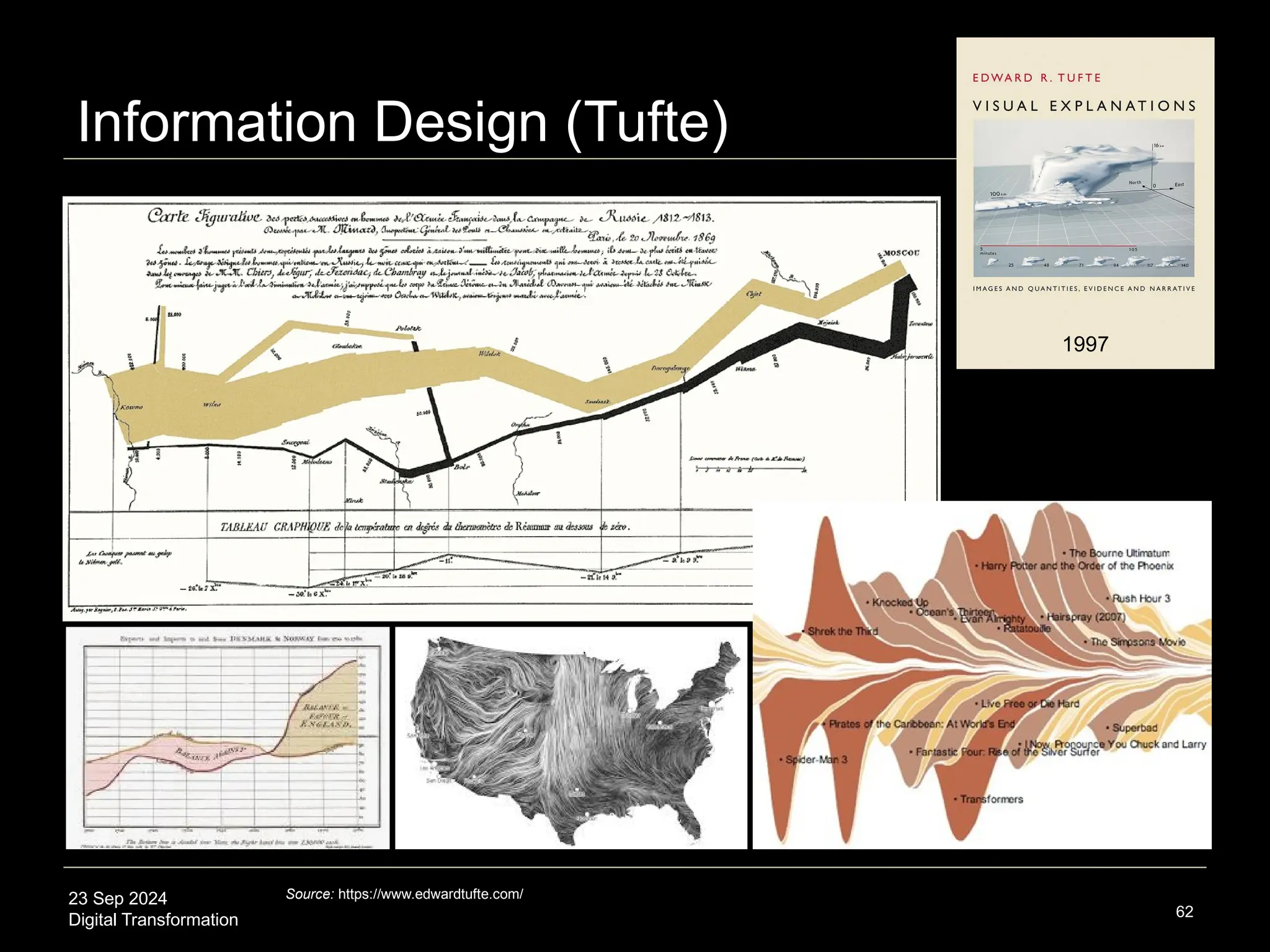

 Information Design & Gantt Chart

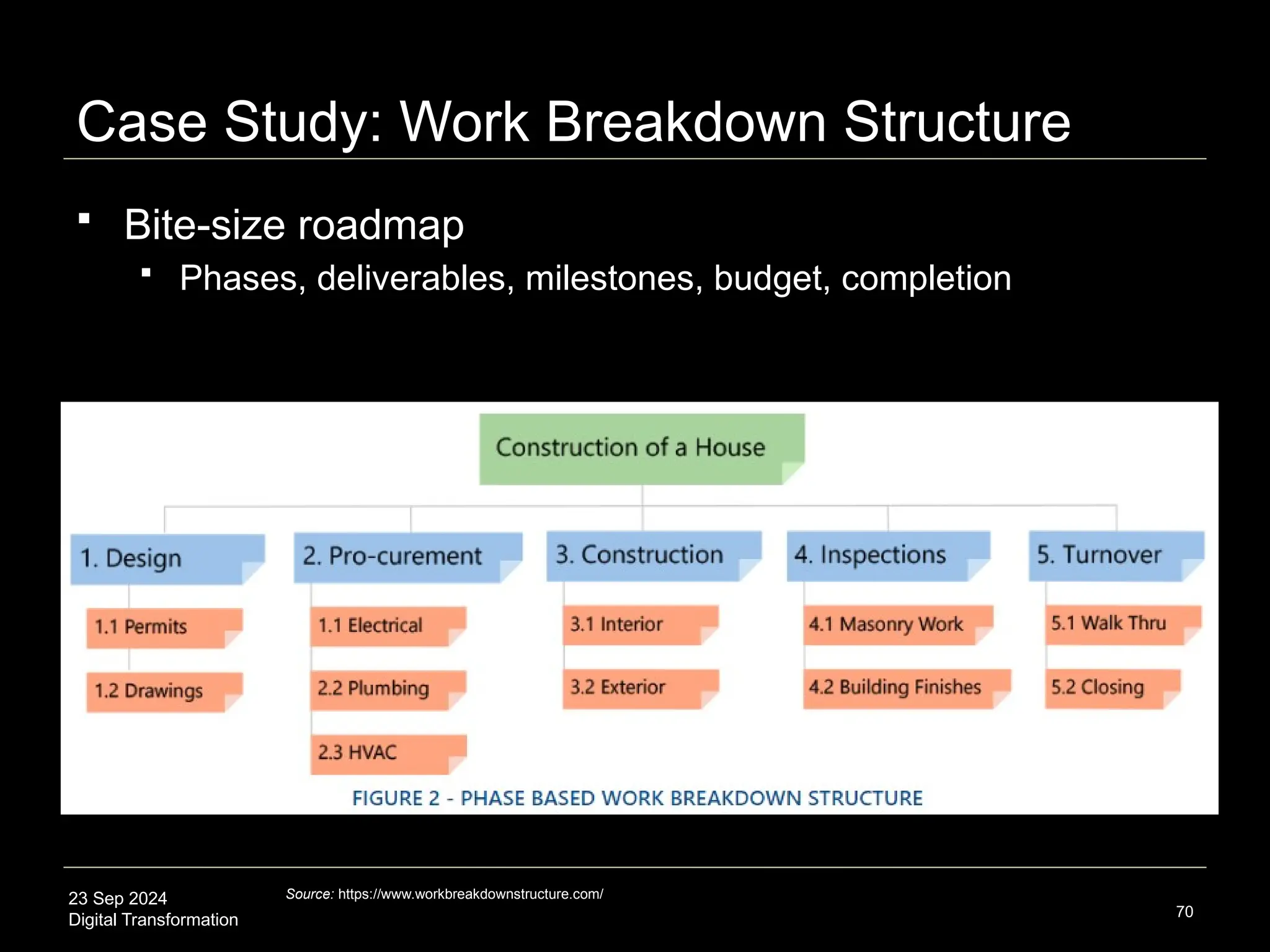

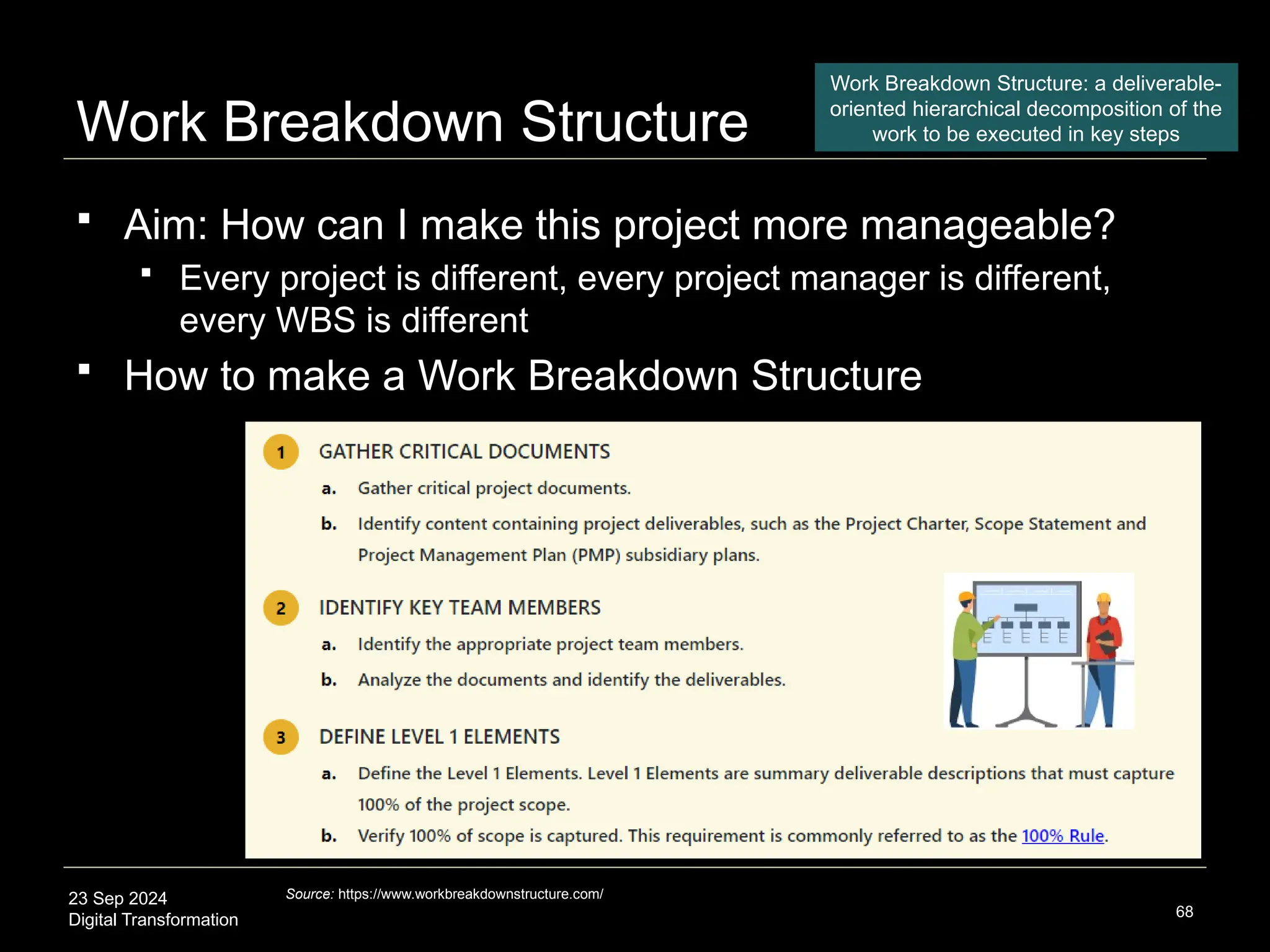

 Work Breakdown Structure

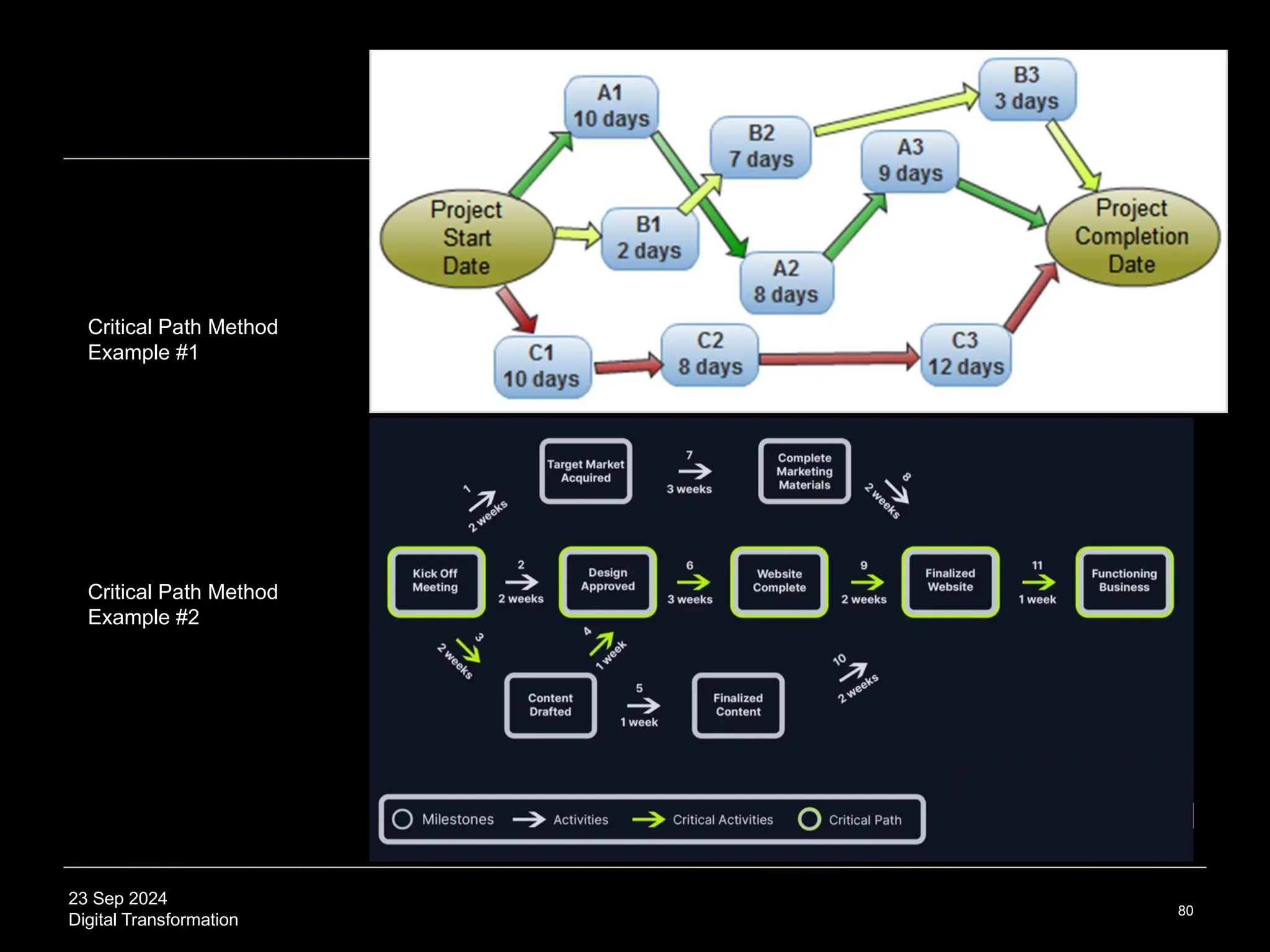

 Critical Path Method
 Case Studies
 AI Project Management
 Advanced Topics
 Digital Twins, Web3-AI-Quantum
3
Cloud
Software
Hardware
Project Management
Math Agents
2024
23 Sep 2024
Digital Transformation
AI Business Model
 Create not just content but form
 Agents
 Chatbot, customer/employee
 Math, health, PM agents
 Content
 Text, images, video, slides, sales
proposal, analysis, code
 Form
 Apps with new functionality
 Internal systems integration
 Public-private data integration
4
2017
Life 1.0: cannot modify software or hardware
Life 3.0: modify software & hardware
Life 2.0 (human): modify software
PM: Project Management
Math Agents
Health Agents
“The App will see you now~!”
Project
Management
Agents
23 Sep 2024
Digital Transformation
The New Statistics
5
Source: Web3 Blockchains. https://www.slideshare.net/slideshow/web3-blockchains-physics-of-prosperity/271065583
Static
Legacy Data Analysis AI Data Analysis
Content
Form
Dynamic
Content
Form
Synthetic Data Generation
Synthetic On-demand
Program/App Generation
Prompt Engineering:
>>Make slides, video, image, text that [conditions]
>>Generate data that meets these [conditions] [high-risk genomic profiles for Alzheimer’s disease]
>>Draft code for a program to analyze project data, timelines, and budget
>>Draft an app for [generative video, blocks game, Rubik’s cube]
Form
Content
 Statistics -> Insights
23 Sep 2024
Digital Transformation
Thesis
6
Humanity is undertaking a new wave of projects unprecedented in size,
scale, scope, and values-based outcomes
These projects, among other aspects, entail orders of magnitude more lines
of software code which must be integrated, connected, tested, and analyzed
Innovation in project management is required, notably via AI agents, digital
twins, blockchain data security, and quantum processing
23 Sep 2024
Digital Transformation
Agenda
 Digital Transformation
 Project Management
 Methods
 Waterfall vs Agile (and Scrum)
 Planning and Scheduling Tools
 Information Design & Gantt Chart
 Work Breakdown Structure
 Critical Path Method
 Case Studies
 AI Project Management
 Advanced Topics
 Digital Twins, Web3-AI-Quantum
7
Cloud
Software
Hardware
Project Management
Math Agents
2024
23 Sep 2024
Digital Transformation

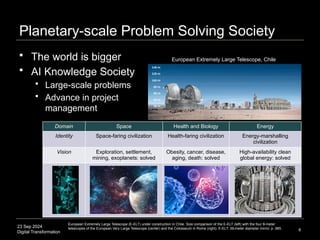

Planetary-scale Problem Solving Society
8
 The world is bigger
 AI Knowledge Society
 Large-scale problems
 Advance in project
management
Domain Space Health and Biology Energy
Identity Space-faring civilization Health-faring civilization Energy-marshalling
civilization
Vision Exploration, settlement,
mining, exoplanets: solved
Obesity, cancer, disease,
aging, death: solved
High-availability clean
global energy: solved
European Extremely Large Telescope, Chile
European Extremely Large Telescope (E-ELT) under construction in Chile. Size comparison of the E-ELT (left) with the four 8-meter
telescopes of the European Very Large Telescope (center) and the Colosseum in Rome (right). E-ELT: 39-meter diameter mirror, p. 985.
23 Sep 2024
Digital Transformation
Global Network Society

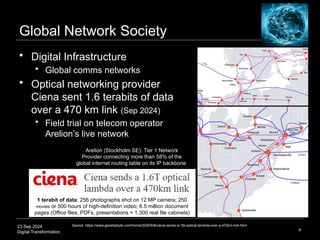

9
 Digital Infrastructure
 Global comms networks
 Optical networking provider
Ciena sent 1.6 terabits of data
over a 470 km link (Sep 2024)
 Field trial on telecom operator
Arelion’s live network
Source: https://www.gazettabyte.com/home/2024/9/8/ciena-sends-a-16t-optical-lambda-over-a-470km-link.html
Arelion (Stockholm SE): Tier 1 Network
Provider connecting more than 58% of the
global internet routing table on its IP backbone
1 terabit of data: 256 photographs shot on 12 MP camera; 250
movies or 500 hours of high-definition video; 6.5 million document
pages (Office files, PDFs, presentations = 1,300 real file cabinets)
23 Sep 2024
Digital Transformation

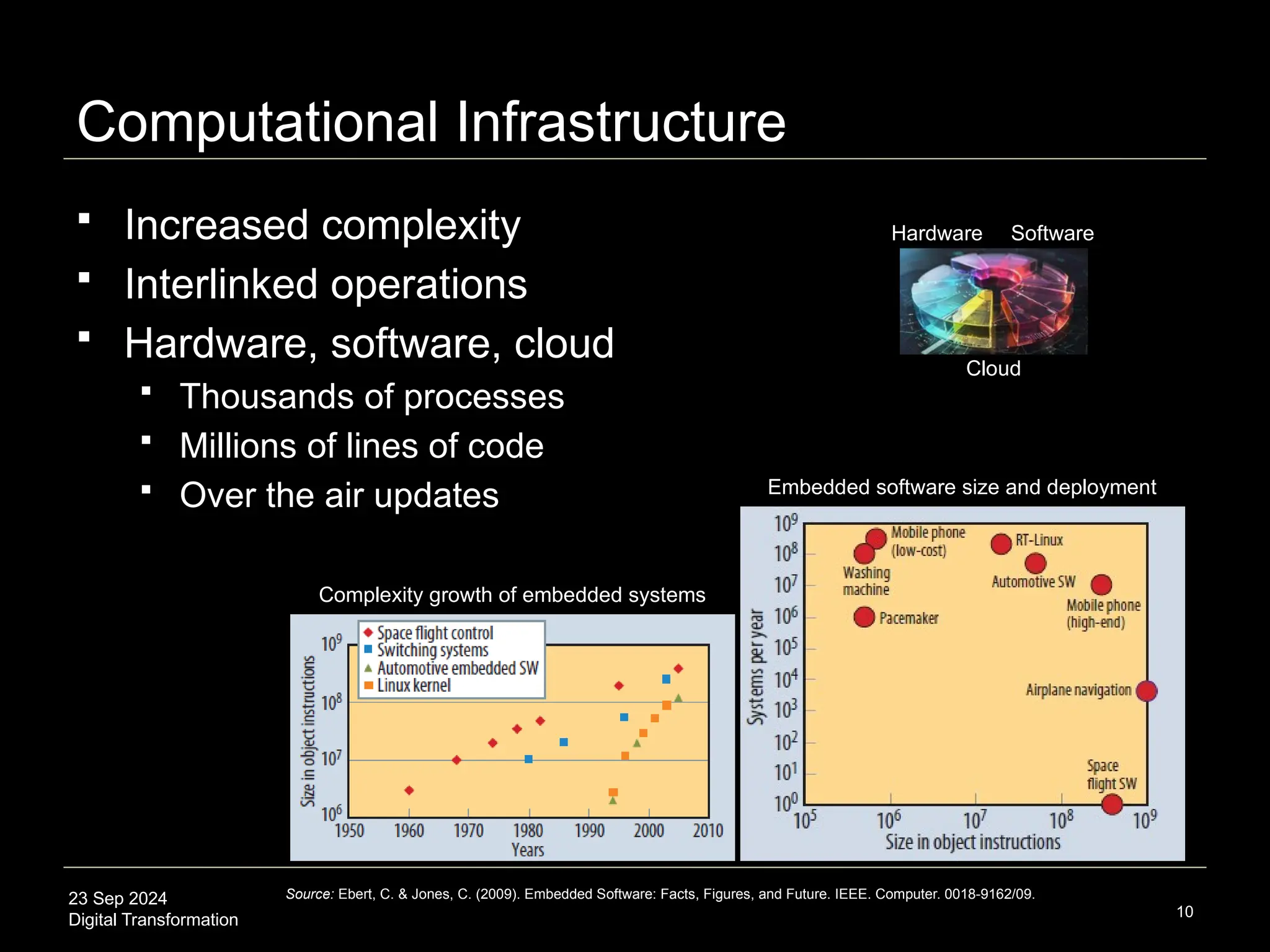

Computational Infrastructure
 Increased complexity
 Interlinked operations
 Hardware, software, cloud
 Thousands of processes
 Millions of lines of code
 Over the air updates
10
Source: Ebert, C. & Jones, C. (2009). Embedded Software: Facts, Figures, and Future. IEEE. Computer. 0018-9162/09.
Embedded software size and deployment
Complexity growth of embedded systems
Cloud
Software
Hardware
23 Sep 2024
Digital Transformation

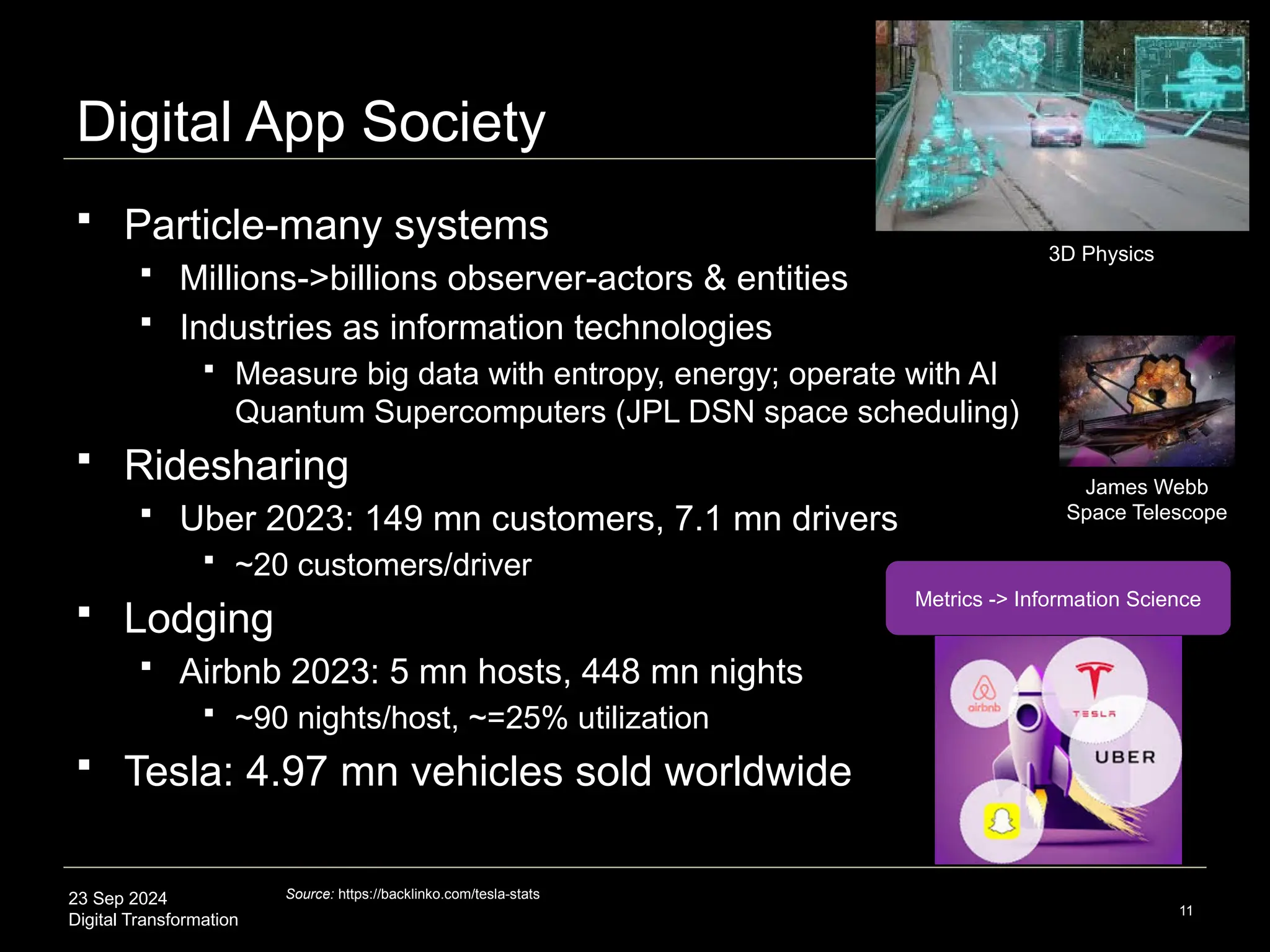

Digital App Society
 Particle-many systems
 Millions->billions observer-actors & entities
 Industries as information technologies
 Measure big data with entropy, energy; operate with AI

Quantum Supercomputers (JPL DSN space scheduling)
 Ridesharing
 Uber 2023: 149 mn customers, 7.1 mn drivers
 ~20 customers/driver
 Lodging
 Airbnb 2023: 5 mn hosts, 448 mn nights
 ~90 nights/host, ~=25% utilization
 Tesla: 4.97 mn vehicles sold worldwide
11
Source: https://backlinko.com/tesla-stats
3D Physics
Metrics -> Information Science
James Webb
Space Telescope
23 Sep 2024
Digital Transformation 12
Blockchain
Smart Network Stack
Quantum
genAI DL NNs
Blockchain: a digital database (ledger & event history)
distributed among the nodes of a peer-to-peer network;
database for resource allocation (cryptocurrency: 1 app)
Web3: community of actors creating a new decentralized internet;
expectation of targeted participation in values-aligned (aesthetic)
efforts; a blockchain-based governance model runs the node network
GenAI: generative artificial intelligence capable of producing text,
images, videos, or other data using generative deep learning neural
network models, often in response to prompts
Quantum: application of quantum mechanics and quantum field theory
to perform computation in chip-based circuits controlling atoms, ions,
and photons with lasers and electromagnetic fields, harnessing the
unique behavior of quantum physics such as superposition,
entanglement, and interference
 Convergence and integration
23 Sep 2024
Digital Transformation
Data & AI-driven Society
13
Source: https://whatsthebigdata.com/data-generated-every-day/
https://www.techtarget.com/searchstorage/definition/Kilo-mega-giga-tera-peta-and-all-that
Data Storage
Measurements
Real-world Data
Storage Capacity

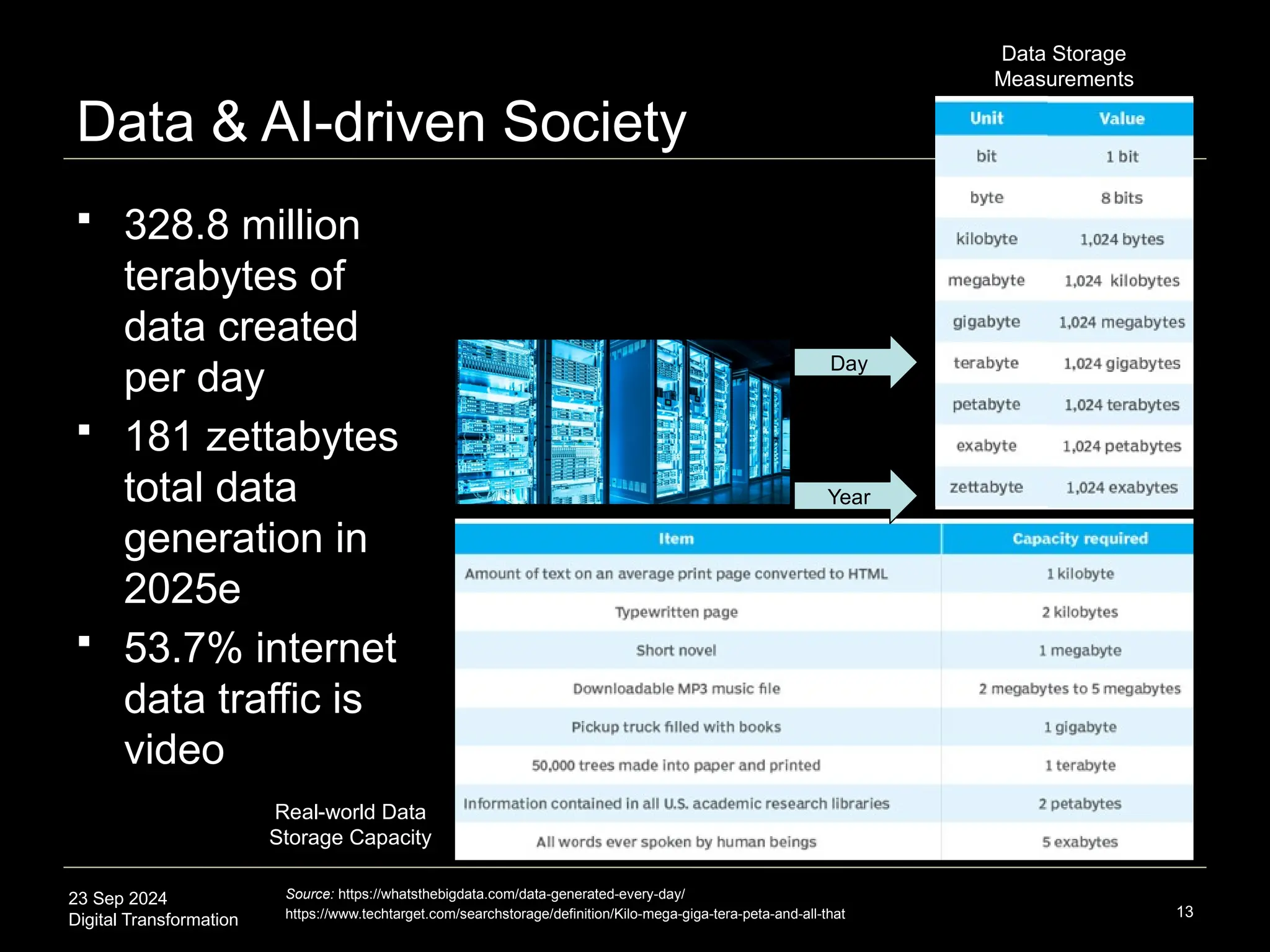

 328.8 million
terabytes of
data created
per day
 181 zettabytes
total data
generation in
2025e
 53.7% internet
data traffic is
video
Year
Day
23 Sep 2024
Digital Transformation

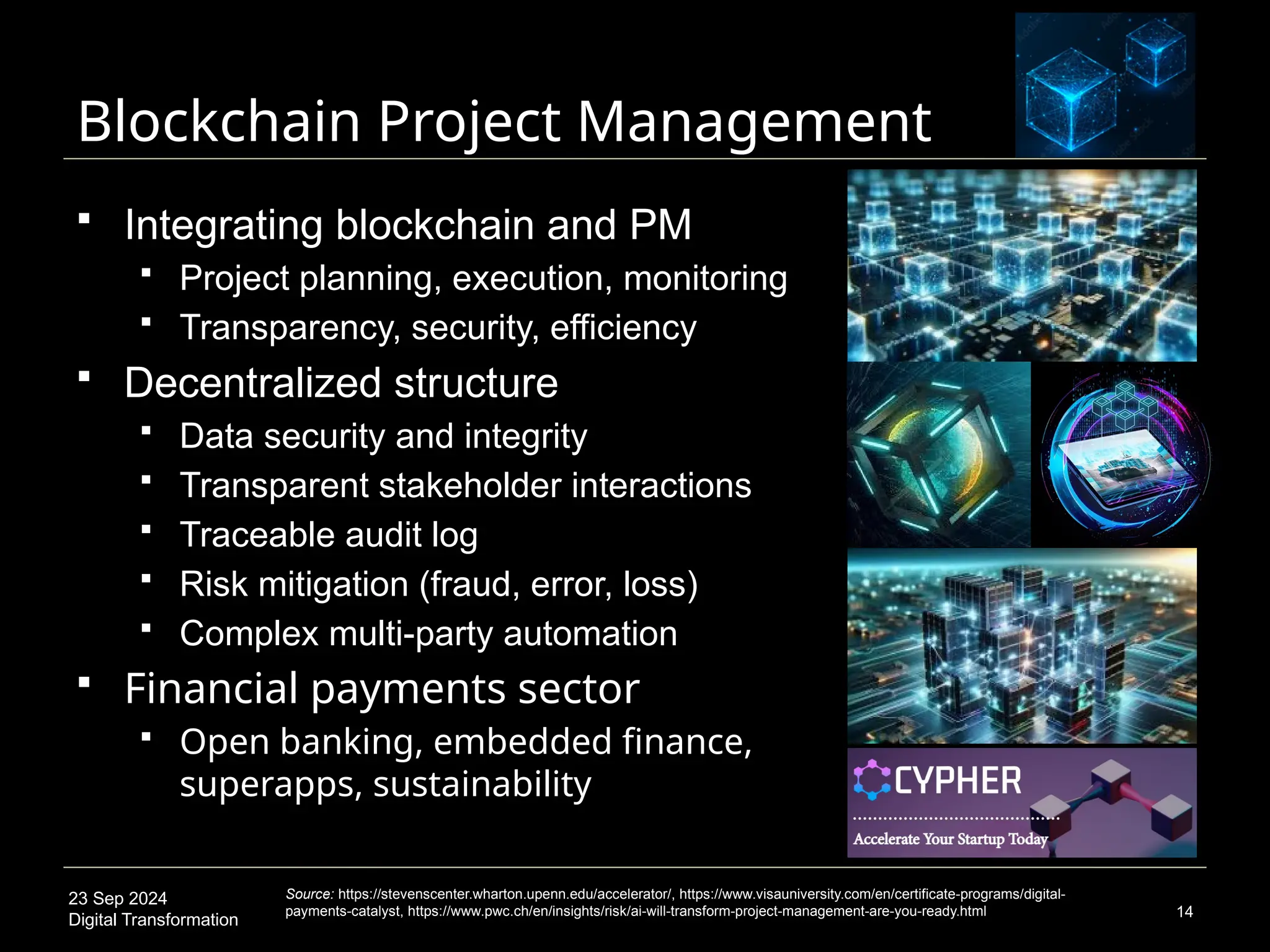

Blockchain Project Management
 Integrating blockchain and PM
 Project planning, execution, monitoring
 Transparency, security, efficiency
 Decentralized structure
 Data security and integrity
 Transparent stakeholder interactions
 Traceable audit log
 Risk mitigation (fraud, error, loss)
 Complex multi-party automation
 Financial payments sector
 Open banking, embedded finance,
superapps, sustainability
14
Source: https://stevenscenter.wharton.upenn.edu/accelerator/, https://www.visauniversity.com/en/certificate-programs/digital-
payments-catalyst, https://www.pwc.ch/en/insights/risk/ai-will-transform-project-management-are-you-ready.html
23 Sep 2024
Digital Transformation

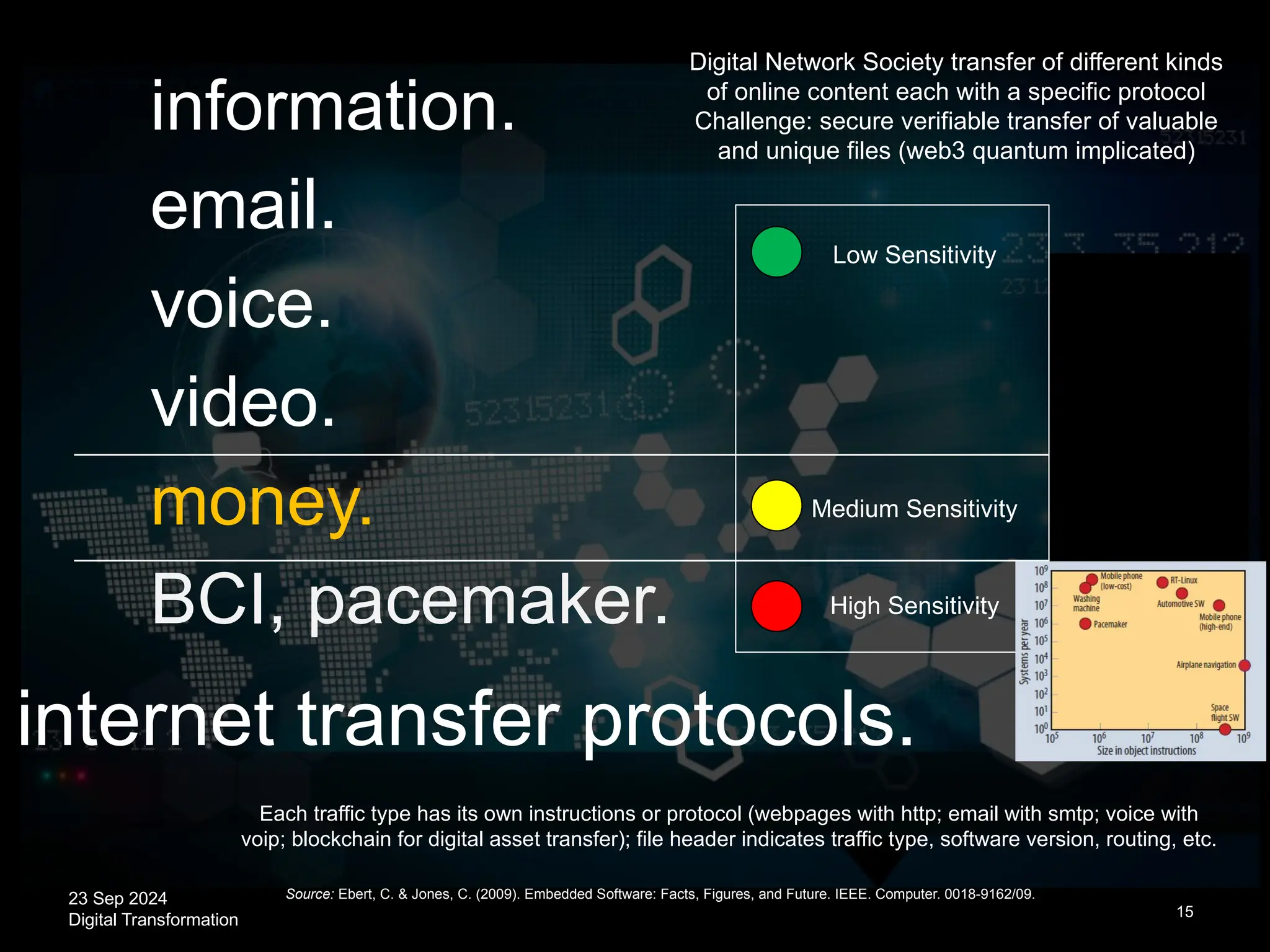

internet transfer protocols.
15
information.
email.
voice.
video.
money.
BCI, pacemaker. High Sensitivity
Low Sensitivity
Medium Sensitivity
Each traffic type has its own instructions or protocol (webpages with http; email with smtp; voice with
voip; blockchain for digital asset transfer); file header indicates traffic type, software version, routing, etc.
Digital Network Society transfer of different kinds
of online content each with a specific protocol
Challenge: secure verifiable transfer of valuable
and unique files (web3 quantum implicated)
Source: Ebert, C. & Jones, C. (2009). Embedded Software: Facts, Figures, and Future. IEEE. Computer. 0018-9162/09.
23 Sep 2024
Digital Transformation

Quantum Project Management
16
 Quantum implications for project management
 Quantum compute
 Complex project planning and optimization
 Greater efficiency, higher workload
 Projects involving quantum-related technologies
 Leading quantum adoption industries:
 Chemical and biological engineering, AI,
cybersecurity, financial services, complex
manufacturing, logistics
Source: https://projectmanagernews.com/news/quantum-computing-project-management/,
https://www.mckinsey.com/capabilities/mckinsey-digital/our-insights/quantum-computing-use-cases-are-getting-real-what-you-need-
to-know
Cleveland Clinic Lobby
McKinsey Study, 2021
23 Sep 2024

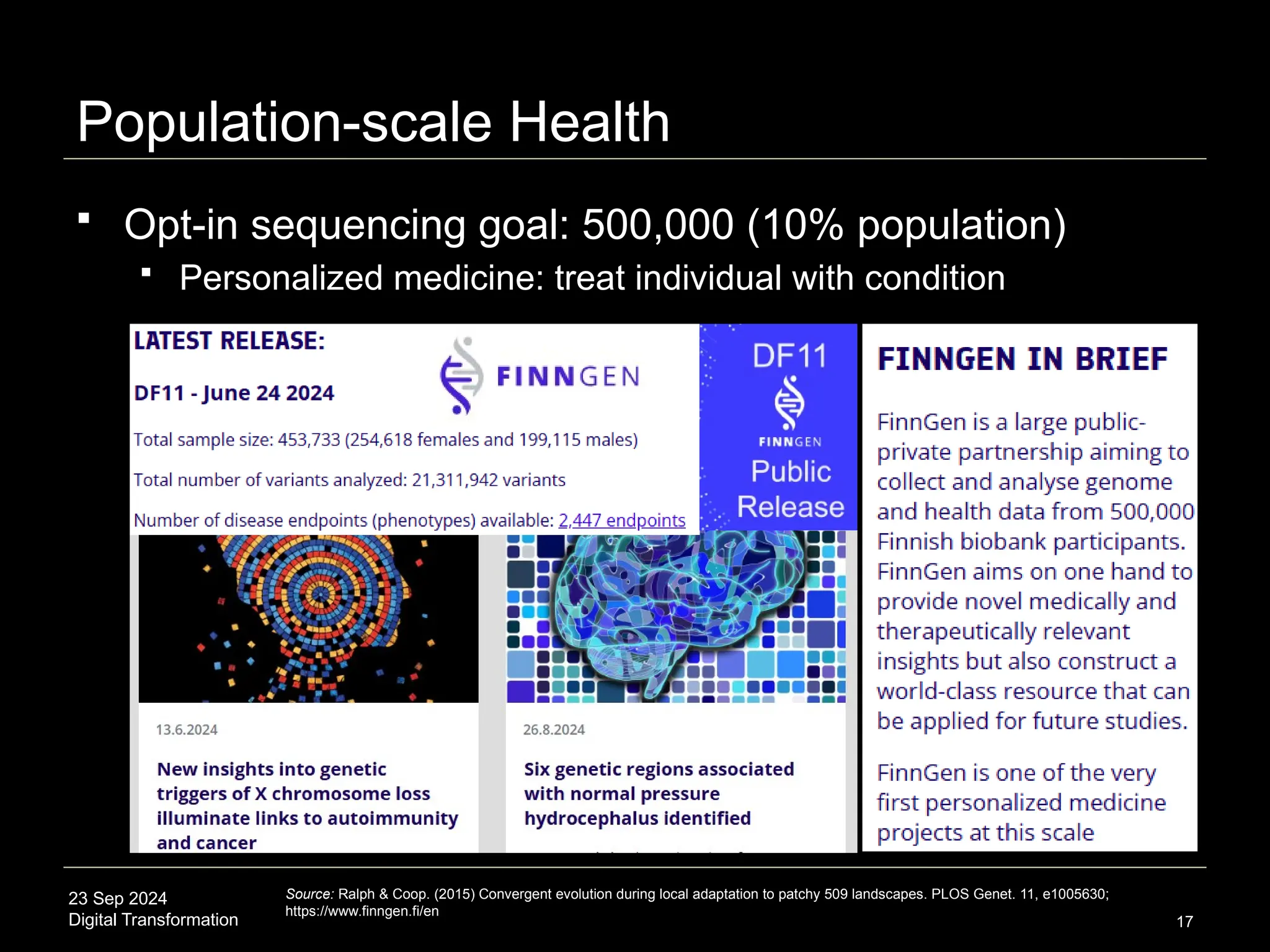

Digital Transformation 17
 Opt-in sequencing goal: 500,000 (10% population)
 Personalized medicine: treat individual with condition
Population-scale Health
Source: Ralph & Coop. (2015) Convergent evolution during local adaptation to patchy 509 landscapes. PLOS Genet. 11, e1005630;
https://www.finngen.fi/en
23 Sep 2024
Digital Transformation

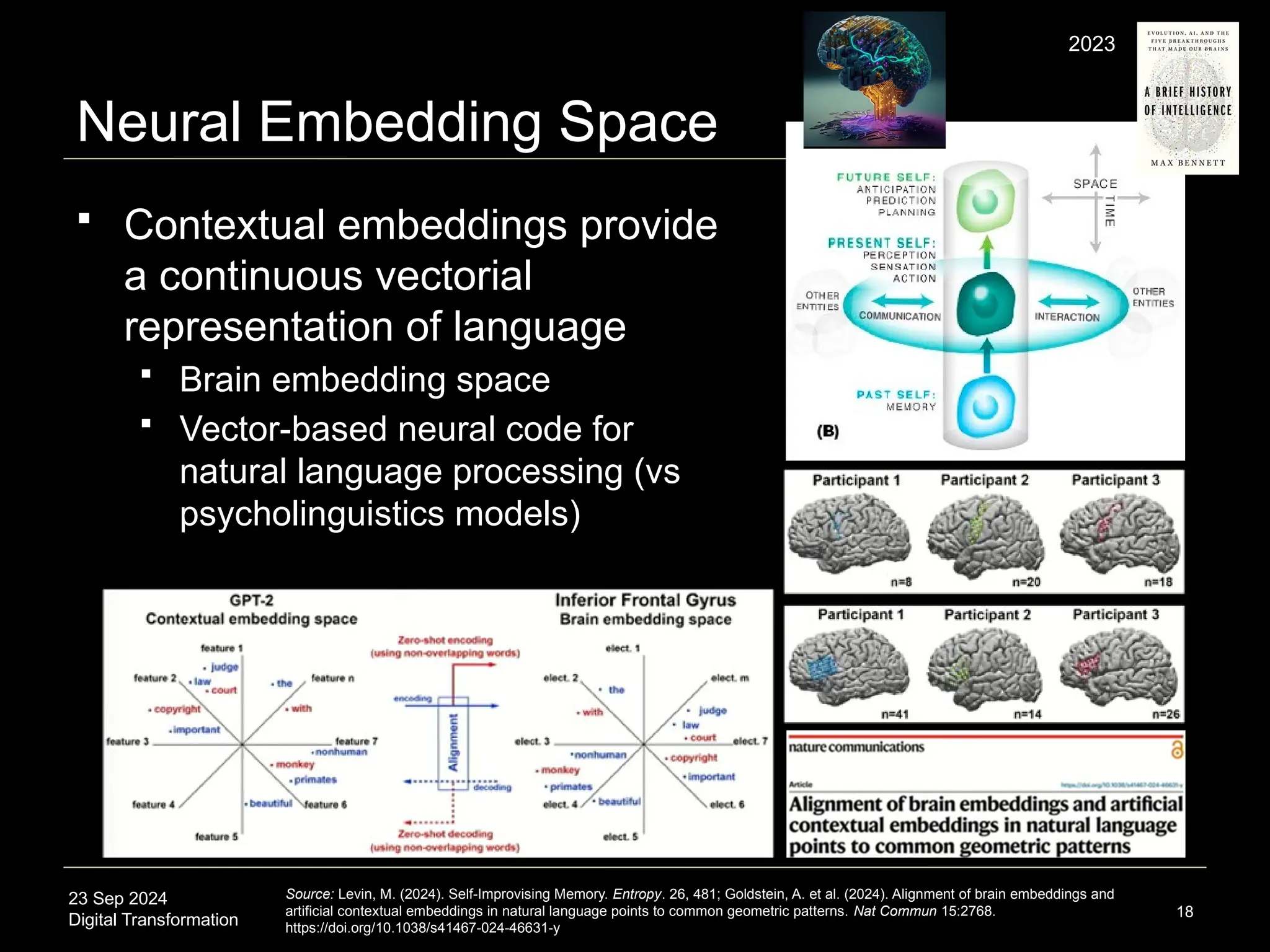

Neural Embedding Space
18
Source: Levin, M. (2024). Self-Improvising Memory. Entropy. 26, 481; Goldstein, A. et al. (2024). Alignment of brain embeddings and
artificial contextual embeddings in natural language points to common geometric patterns. Nat Commun 15:2768.
https://doi.org/10.1038/s41467-024-46631-y
 Contextual embeddings provide
a continuous vectorial
representation of language
 Brain embedding space
 Vector-based neural code for
natural language processing (vs
psycholinguistics models)
2023
23 Sep 2024
Digital Transformation
Large-scale Projects

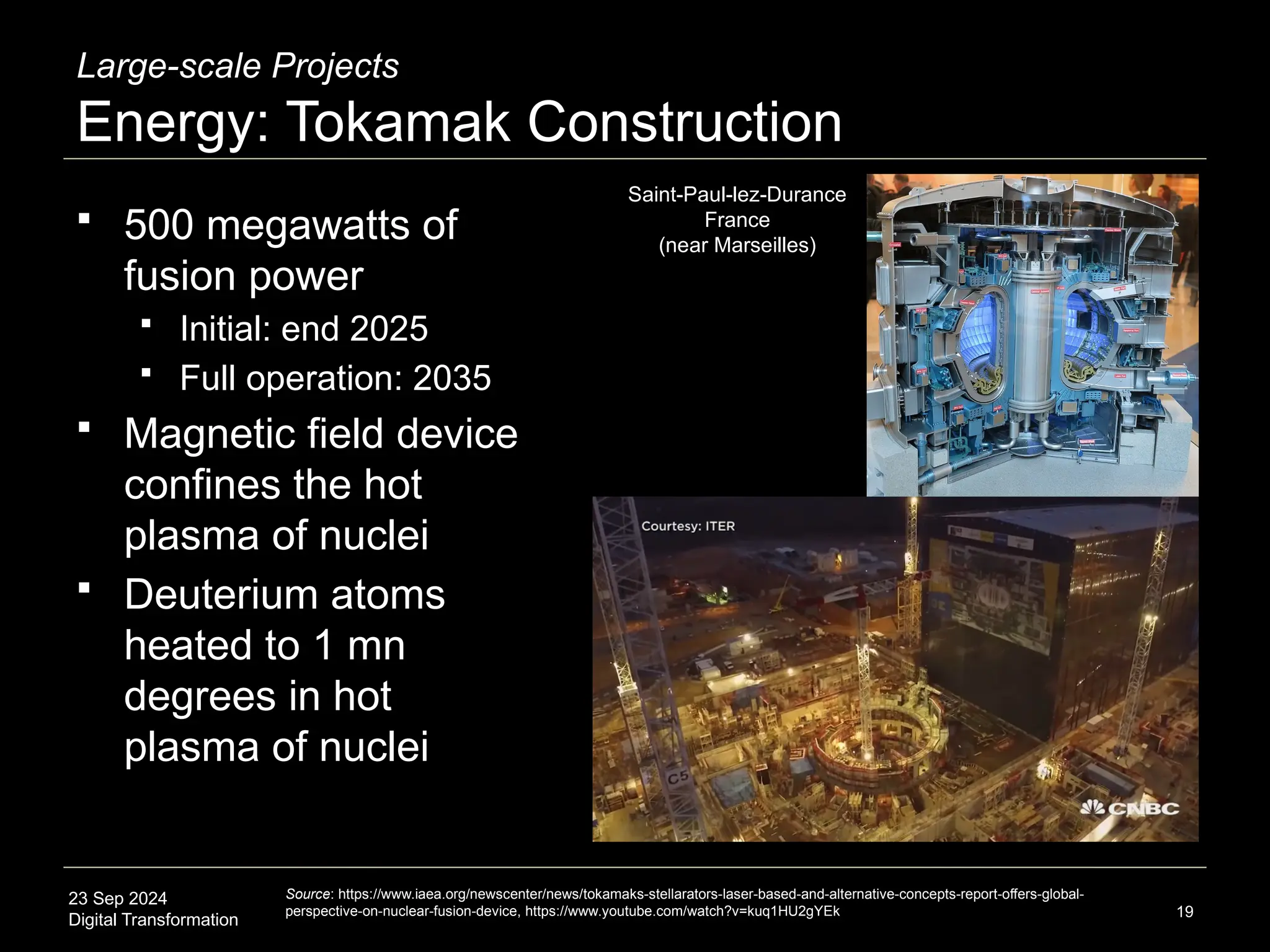

Energy: Tokamak Construction
 500 megawatts of
fusion power
 Initial: end 2025
 Full operation: 2035
 Magnetic field device
confines the hot
plasma of nuclei
 Deuterium atoms
heated to 1 mn
degrees in hot
plasma of nuclei
19
Source: https://www.iaea.org/newscenter/news/tokamaks-stellarators-laser-based-and-alternative-concepts-report-offers-global-
perspective-on-nuclear-fusion-device, https://www.youtube.com/watch?v=kuq1HU2gYEk
Saint-Paul-lez-Durance
France
(near Marseilles)
23 Sep 2024
Digital Transformation
Digital Twins
20
Digital Twin: virtual representation of physical system or entity
Bioavatar: digital representation of physical self, including real-
time biometric data update for longevity precision medicine
Source: https://esrisingapore.com.sg/digital-twins, https://infra.global/singapores-digital-twin-from-science-fiction-to-hi-tech-reality/,
https://www.forbes.com/sites/forbestechcouncil/2023/08/18/bio-digital-twin-getting-the-heart-right/, Amofa et al. (2024). Blockchain-
secure patient Digital Twin in healthcare using smart contracts. PLoS One. 19(2): e0286120.
 Singapore: first nation with a digital twin (2023)
 Health and longevity: digital twins of
 healthcare facilities, patients, bodies & organs, drugs
23 Sep 2024
Digital Transformation
Digital Twins
21
Source: https://www.3ds.com/sites/default/files/2021-01/dassault-systemes-and-accenture-virtual-twin-and-sustainability.pdf
Circular Economy: economic model of resource production and
consumption that involves sharing, leasing, reusing, repairing,
refurbishing, recycling, life-cycle management, and sustainability
23 Sep 2024
Digital Transformation
Agenda
 Digital Transformation
 Project Management
 Methods
 Waterfall vs Agile (and Scrum)
 Planning and Scheduling Tools
 Information Design & Gantt Chart
 Work Breakdown Structure

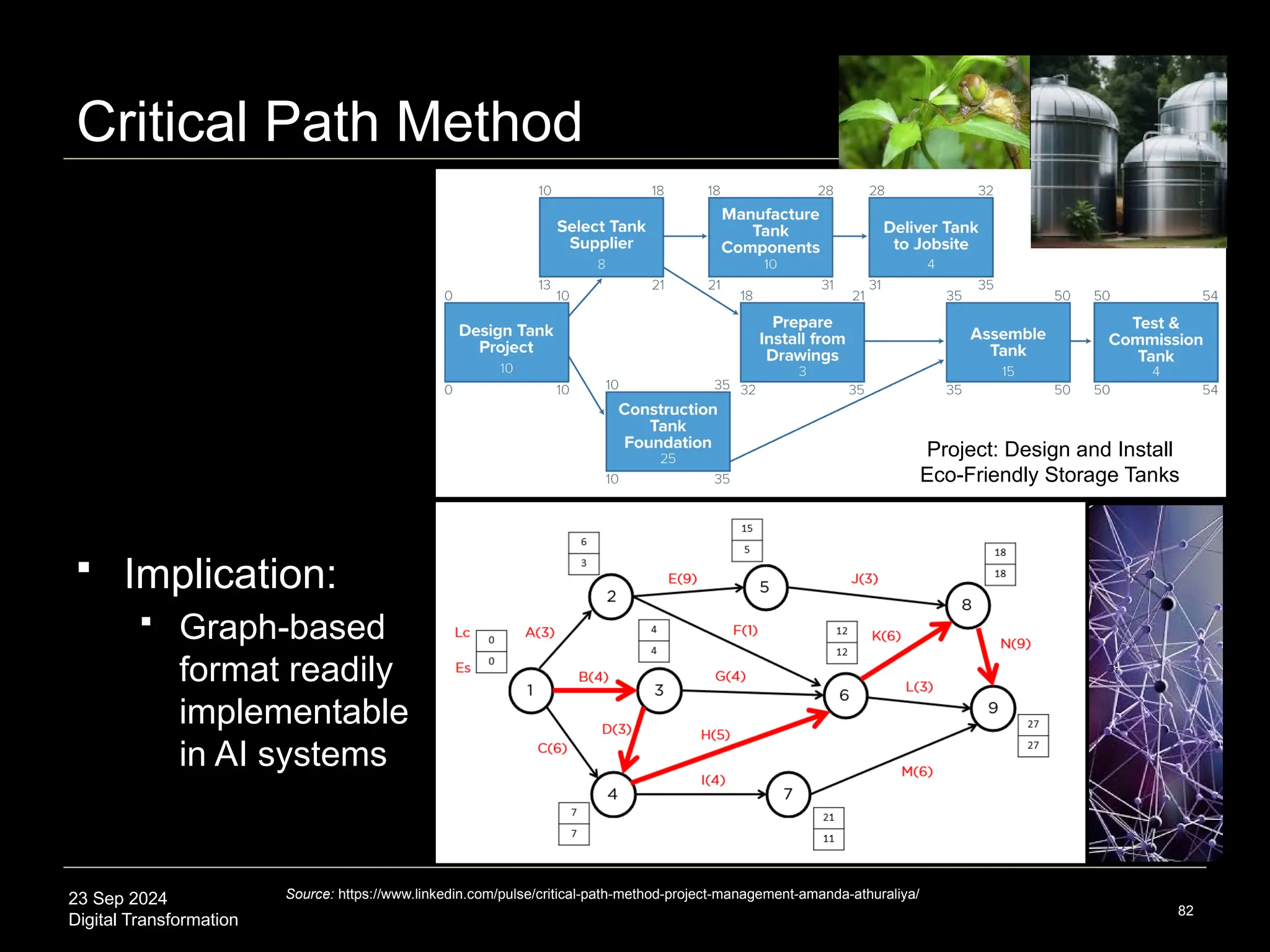

 Critical Path Method
 Case Studies
 AI Project Management
 Advanced Topics
 Digital Twins, Web3-AI-Quantum
22
Cloud
Software
Hardware
Project Management
Math Agents
2024
23 Sep 2024
Digital Transformation
Case Study: LUMI Data Center, Kajaani FI
23
 Project: AI Supercomputer center serving EC
 35-40% enterprise workloads are fully cloud instantiated
 Requirements: sustainable data center ecosystem
Source: https://www.lumi-supercomputer.eu/lumi-consortium/, https://www.youtube.com/watch?v=gZrw58_Cu4g
23 Sep 2024
Digital Transformation 24
Source: https://csc.fi/en/our-expertise/data-center-ecosystem/
Case Study: LUMI Data Center
 GOAL: sustainable data
center ecosystem
 SOLUTION:
 Novel architectural design
using 100% hydropower
 RESULT:
 Waste heat accounts for up
to 20% of annual district
heating needs for local
partner city Kajaani FI
 ~12,400 tons of CO2
reduced annually
23 Sep 2024
Digital Transformation 25
Source: https://www.lumi-supercomputer.eu/lumi-consortium/, https://www.youtube.com/watch?v=gZrw58_Cu4g
Case Study: LUMI Data Center, Kajaani FI
23 Sep 2024
Digital Transformation 26
Source: https://www.youtube.com/watch?v=HB9JUH0mPqI
Logging into an AI Supercomputer
 Remote login access credentials: Login Nodes
 Work processing/simulation: Compute Nodes
23 Sep 2024
Digital Transformation

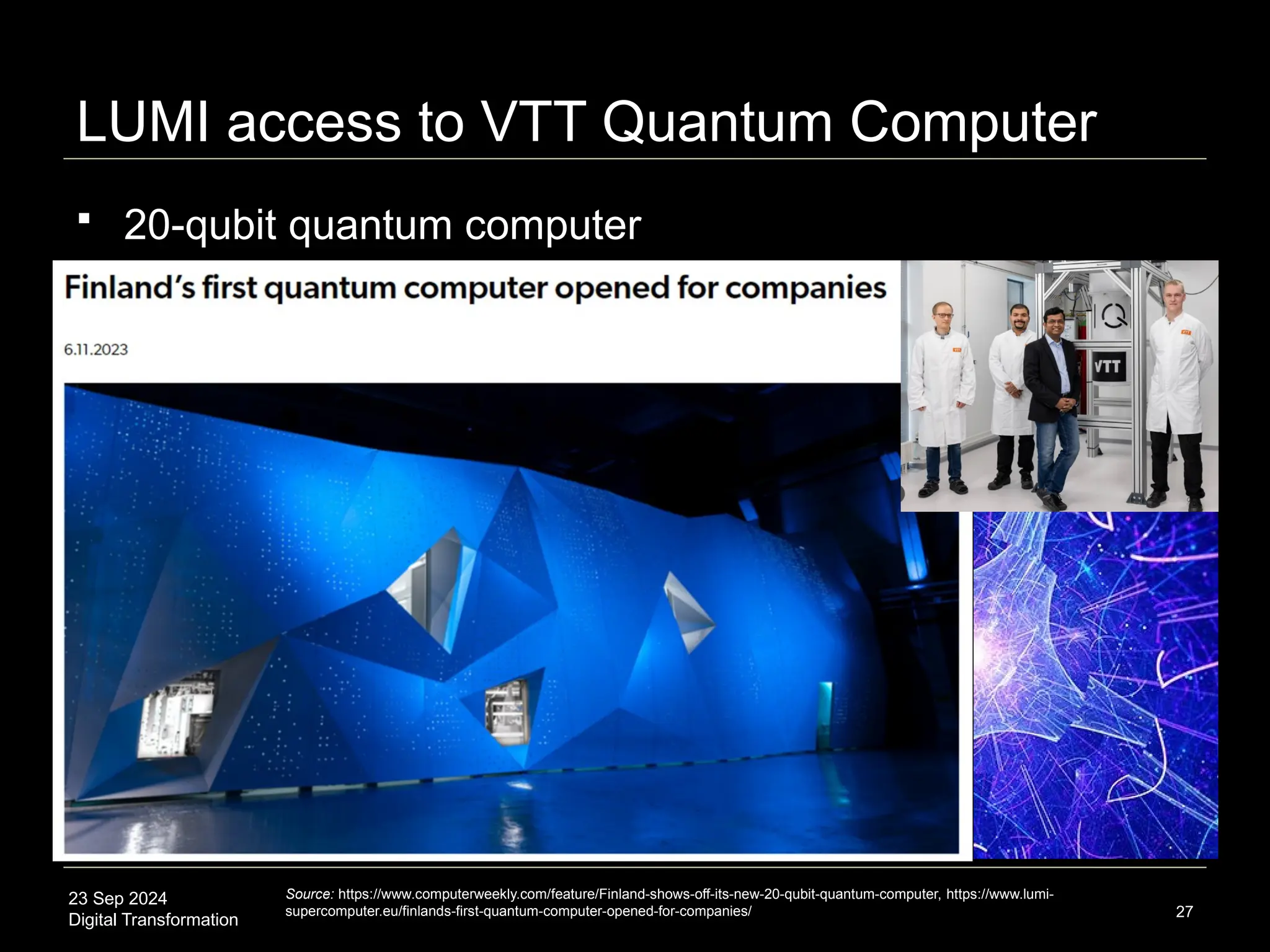

LUMI access to VTT Quantum Computer
27
Source: https://www.computerweekly.com/feature/Finland-shows-off-its-new-20-qubit-quantum-computer, https://www.lumi-
supercomputer.eu/finlands-first-quantum-computer-opened-for-companies/
Quantum and high-performance computing are complementary technologies
 20-qubit quantum computer
23 Sep 2024
Digital Transformation

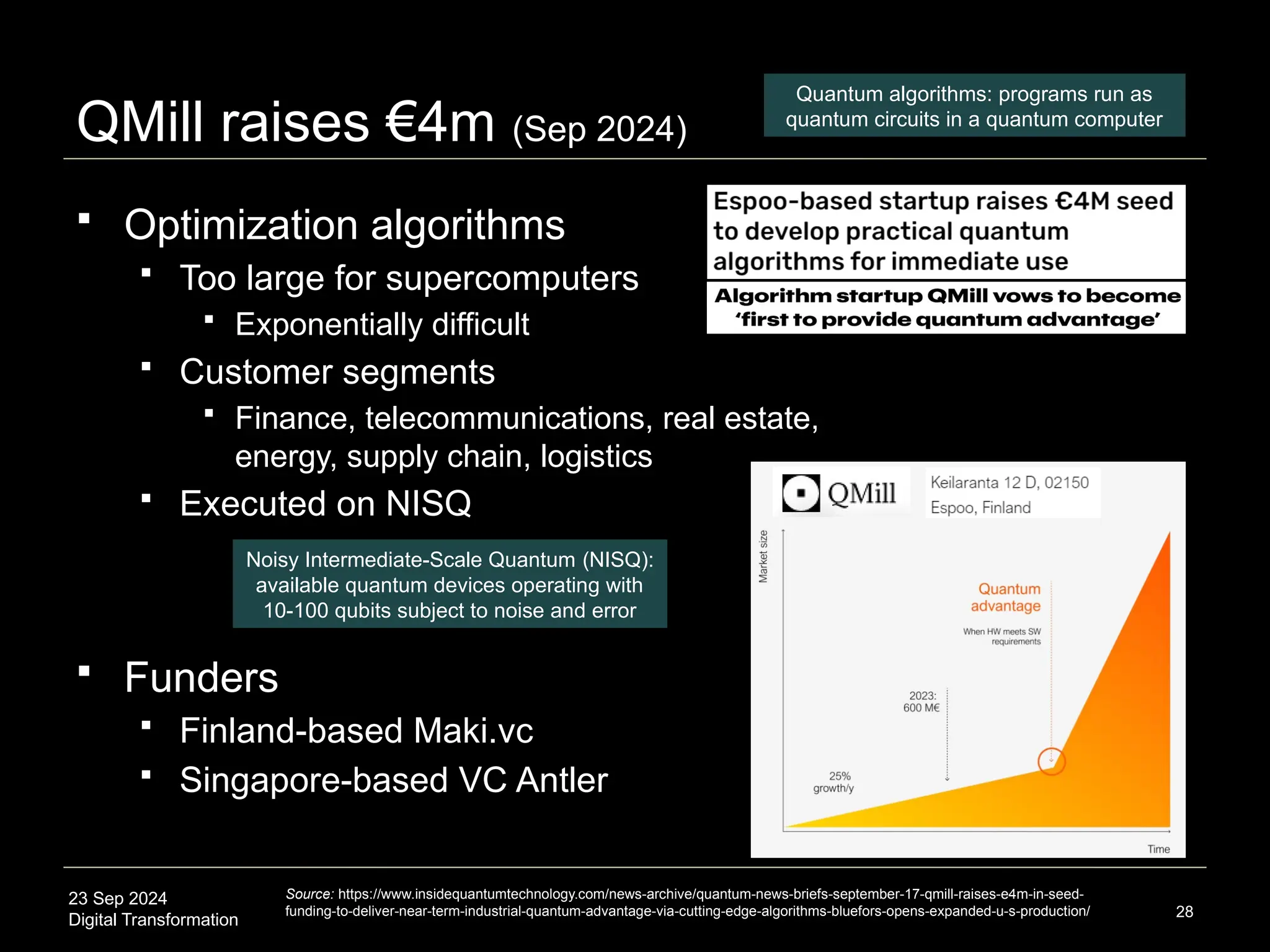

QMill raises €4m (Sep 2024)
28
Source: https://www.insidequantumtechnology.com/news-archive/quantum-news-briefs-september-17-qmill-raises-e4m-in-seed-
funding-to-deliver-near-term-industrial-quantum-advantage-via-cutting-edge-algorithms-bluefors-opens-expanded-u-s-production/
 Optimization algorithms
 Too large for supercomputers
 Exponentially difficult
 Customer segments
 Finance, telecommunications, real estate,
energy, supply chain, logistics
 Executed on NISQ
 Funders
 Finland-based Maki.vc
 Singapore-based VC Antler
Quantum algorithms: programs run as
quantum circuits in a quantum computer
Noisy Intermediate-Scale Quantum (NISQ):
available quantum devices operating with
10-100 qubits subject to noise and error
23 Sep 2024
Digital Transformation
Quantum Plugs into Cloud/Compute Stack
29
Source: https://developer.nvidia.com/cuda-q
 CPU -> GPU -> TPU -> QPU
 GPU (graphics processing unit)
 3D graphics card: matrix multiplication
 TPU (tensor processing unit)
 Flow through matrix multiplications: no
storing interim values in memory
 QPU (quantum processing unit)
 Quadratic & Polynomial speed-up with
superposition, entanglement,
interference
Example: NVIDIA CUDA-Quantum
(Compute Unified Device Architecture):
parallel computing platform and
application programming interface
CUDA-
Quantum
23 Sep 2024
Digital Transformation
JPMorgan Chase
Global Technology Applied Research
30
 Quantum AI Algorithms, Blockchains, Cryptography
 Markets: derivative pricing, risk analysis, portfolio optimization
 Secure data transfer: quantum key distribution, blockchains
Source: https://arxiv.org/search/quant-ph?searchtype=author&query=Pistoia,+Marco
Smart Network
Technology
Stack:
Blockchain
genAI
Quantum
Is it a bank? World’s largest bank is a full-stack
FinTech smart network technology company
Smart contract
automation
23 Sep 2024
Digital Transformation
Moore’s Law
31
Source: Kurzweil, https://www.youtube.com/watch?v=xh2v5oC5Lx4
 The number of transistors on a
chip doubles every 2 years 2005
When Humans
Transcend Biology
2024
When we
merge with AI
??
The
Singularity
[is Here]
23 Sep 2024
Digital Transformation
Doublings: Moore’s Law: 24, Proteins: 158
 Nature: high rate of doubling compared to technology
 Moore’s law: number of transistors on a single chip doubles
every two years at minimal costs (24 total doublings)
 June 2023: 134 billion transistors (Apple ARM-based dual-die
M2 Ultra SoC fabricated using TSMC’s 5 nm process)
32
24
Source: CU 3-09-22 Physics Colloquium - Sadasivan Shankar, SLAC Stanford/Harvard.
23 Sep 2024
Digital Transformation
Biology: Complex, Unknown Ruleset
33
Pathway
Genome
Protein
Natural
Language
LLMs: LLaMa
65 billion parameters
Protein Language Models:
xTrimoPGLM:
100 billion parameters
Genome Language
Models
Parameter: learnable weights between graph nodes (entities)
Source: https://www.biomap.com/sota/
DeepSeekMath
7 billion parameters
Mathematical
Reasoning Agents
23 Sep 2024
Digital Transformation
Quantum needed to “solve” Biology
 Complex domain of
biology requires compute
capability of quantum AI
 Quantum-enhanced
generative AI models
accelerate discovery of new
molecules as viable cancer
drug candidates
 RESULT: Discovered a
new compound to inhibit
KRAS active in the
RAS/MAPK pathway
 Platform: Insilico’s genAI
engine Chemistry42
34
Source: https://aibusiness.com/verticals/quantum-enhanced-generative-ai-creates-viable-cancer-drug-candidates,
https://www.scientific-computing.com/article/quantum-enhanced-generative-ai-generates-viable-cancer-drug-candidates
23 Sep 2024
Digital Transformation
Quantum AI Convergence
Greener LLMs: 1-Bit LLM & 1.58 Bit LLM
 Quantization of LLMs
 From scalar network weights to
binary (1-bit) or ternary (-1-0-1)
 Interpretation: over or under weight
 LLMs without matrix multiplication
 Ternary function replaces attention
in transformer NNs
 BitNet (2023), MatMut (2024)
35
Sources: Wang et al. (2023). BitNet: Scaling 1-bit Transformers for Large Language Models. arXiv:2310.11453v1,
Zhu et al. (2024). Scalable MatMul-free Language Modeling. arXiv:2406.02528v5.
23 Sep 2024
Digital Transformation
Quantum AI Convergence
Hyperbolic Data Compression
36
Source: Taback, J. (2008). On the Geometry of Cayley Automatic Groups. arXiv:2008.02381v4
https://www.youtube.com/watch?v=WBY9EQJTew4
Phylogenetic tree: close in
Euclidean distance, far in
evolutionary distance
ML representation in hyperbolic space: distant
in hyperbolic space and genetic distance
23 Sep 2024
Digital Transformation
Agenda
 Digital Transformation
 Project Management
 Methods
 Waterfall vs Agile (and Scrum)
 Planning and Scheduling Tools
 Information Design & Gantt Chart
 Work Breakdown Structure
 Critical Path Method
 Case Studies
 AI Project Management
 Advanced Topics
 Digital Twins, Web3-AI-Quantum
37
Cloud
Software
Hardware
Project Management
Math Agents
2024
23 Sep 2024
Digital Transformation

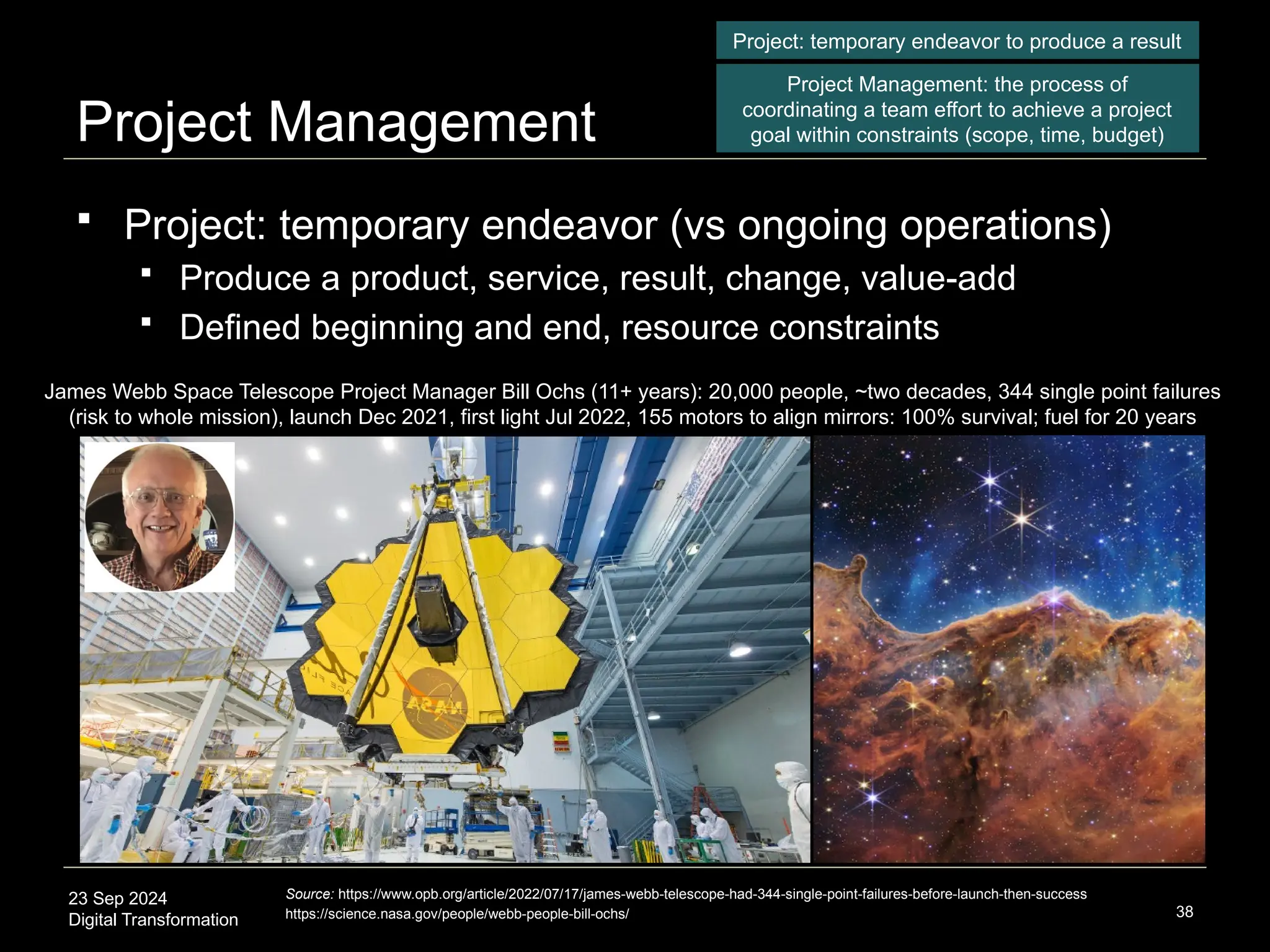

Project Management
 Project: temporary endeavor (vs ongoing operations)
 Produce a product, service, result, change, value-add
 Defined beginning and end, resource constraints
38
Source: https://www.opb.org/article/2022/07/17/james-webb-telescope-had-344-single-point-failures-before-launch-then-success
https://science.nasa.gov/people/webb-people-bill-ochs/
Project Management: the process of
coordinating a team effort to achieve a project
goal within constraints (scope, time, budget)
Project: temporary endeavor to produce a result
James Webb Space Telescope Project Manager Bill Ochs (11+ years): 20,000 people, ~two decades, 344 single point failures
(risk to whole mission), launch Dec 2021, first light Jul 2022, 155 motors to align mirrors: 100% survival; fuel for 20 years
23 Sep 2024
Digital Transformation
History of Project Management
 Systematic approaches to complex projects (1950s)
 Construction, civil engineering, defense, aircraft
 Shift from contractor-managed projects to professionally
trained project management teams (PM Officer) (1970s)
39
Haussmann Renovation of Paris (Pissarro, 1898) Guiana Space Center: Europe’s Spaceport (2024)
23 Sep 2024
Digital Transformation

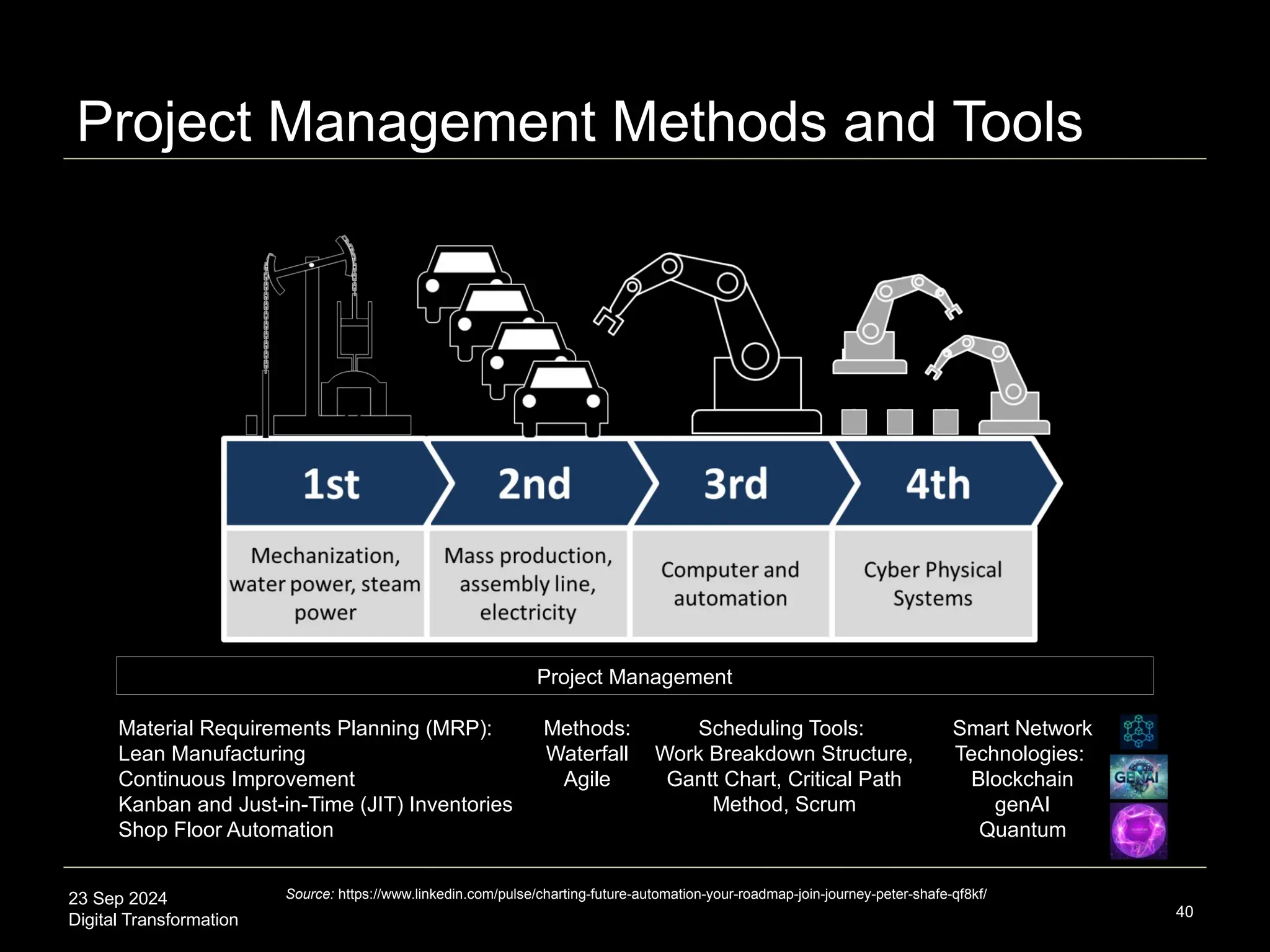

Project Management Methods and Tools
40
Source: https://www.linkedin.com/pulse/charting-future-automation-your-roadmap-join-journey-peter-shafe-qf8kf/
Project Management
Methods:

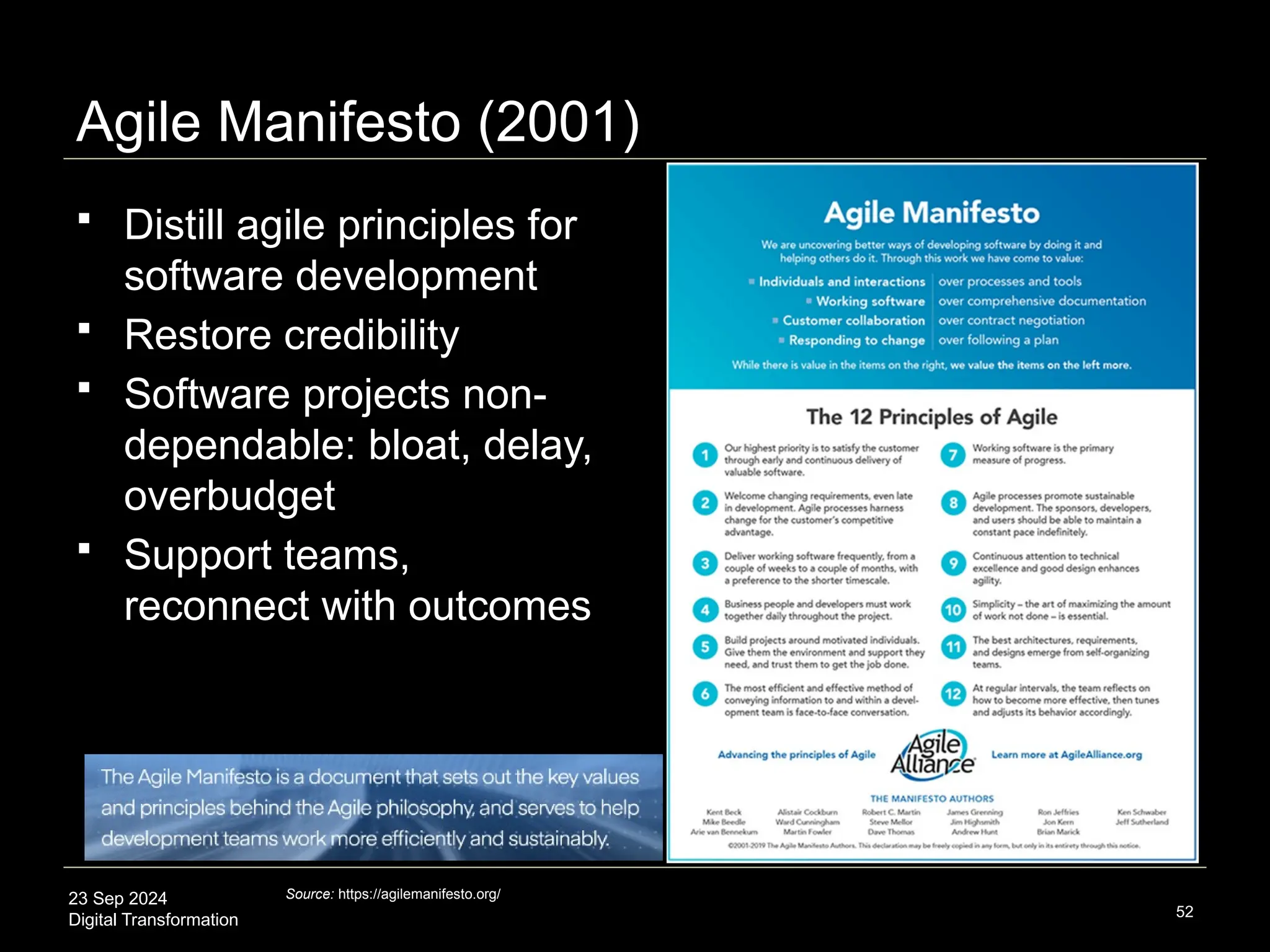

Waterfall
Agile
Scheduling Tools:
Work Breakdown Structure,
Gantt Chart, Critical Path
Method, Scrum
Smart Network
Technologies:
Blockchain
genAI
Quantum
Material Requirements Planning (MRP):
Lean Manufacturing
Continuous Improvement
Kanban and Just-in-Time (JIT) Inventories
Shop Floor Automation
23 Sep 2024
Digital Transformation
Agenda
 Digital Transformation
 Project Management
 Methods
 Waterfall vs Agile (and Scrum)
 Planning and Scheduling Tools
 Information Design & Gantt Chart

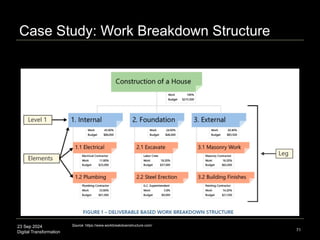

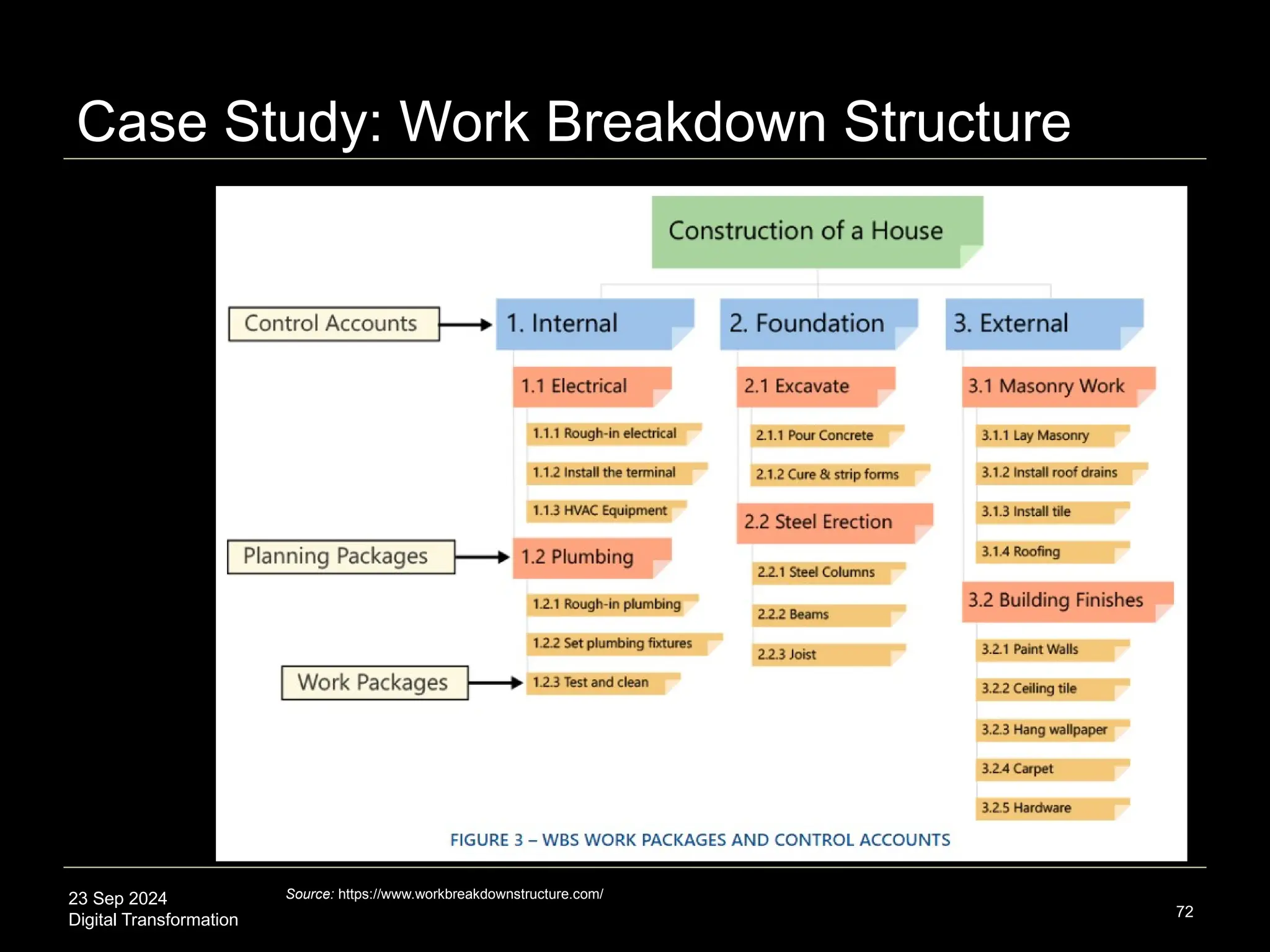

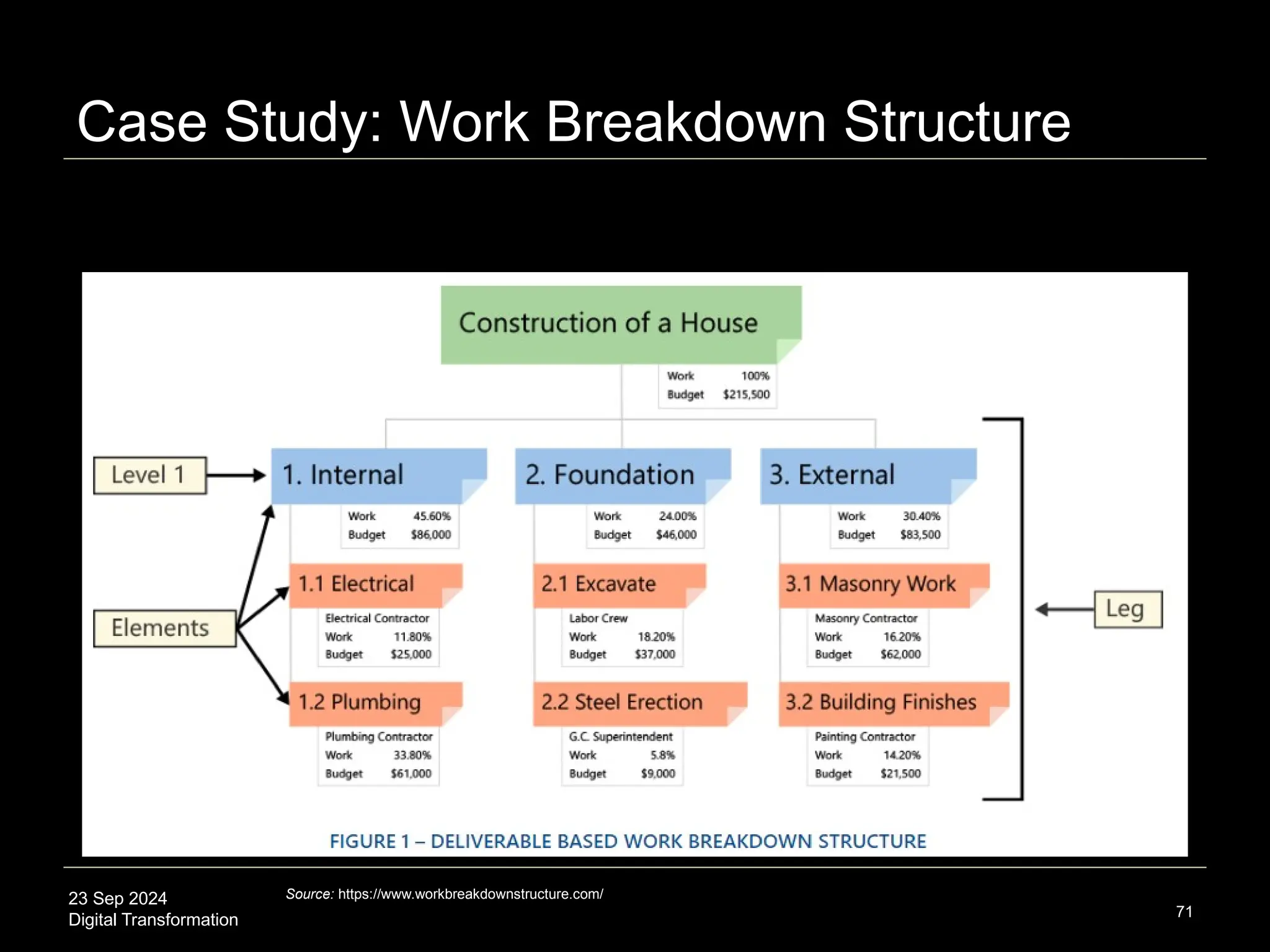

 Work Breakdown Structure
 Critical Path Method
 Case Studies
 AI Project Management
 Advanced Topics
 Digital Twins, Web3-AI-Quantum
41
Cloud
Software
Hardware
Project Management
Math Agents
2024
23 Sep 2024
Digital Transformation
CEO: There’s an App for that~!
 Real-time corporate dashboard apps
 Case study: CEO of a large telecom provider
 Status
 Use app to check on organization’s seven strategic initiatives
 Few-tap review of project status and percent complete
 Key performance indicators
 Team member morale and stakeholder buy-in metrics
 On-demand drill-down to project charters, supporting documents
 Decision-making
 App informs re: changes needing attention
 Prioritizes decisions and potential solutions
 On-demand risk assessment
42
Source: https://www.pmotto.ai/blog/how-ai-will-transform-project-management/
23 Sep 2024
Digital Transformation

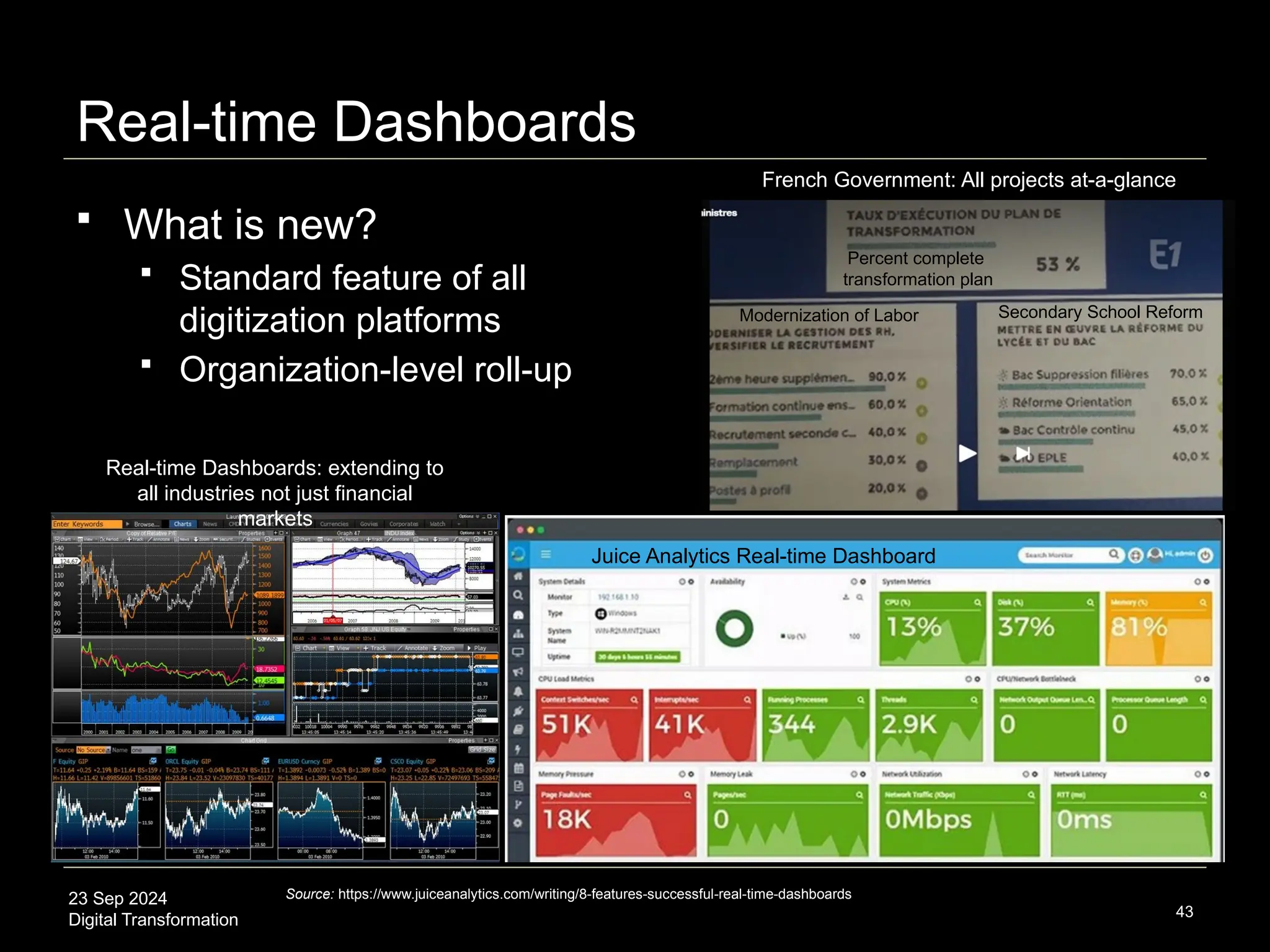

Real-time Dashboards
43
Source: https://www.juiceanalytics.com/writing/8-features-successful-real-time-dashboards
 What is new?
 Standard feature of all
digitization platforms
 Organization-level roll-up

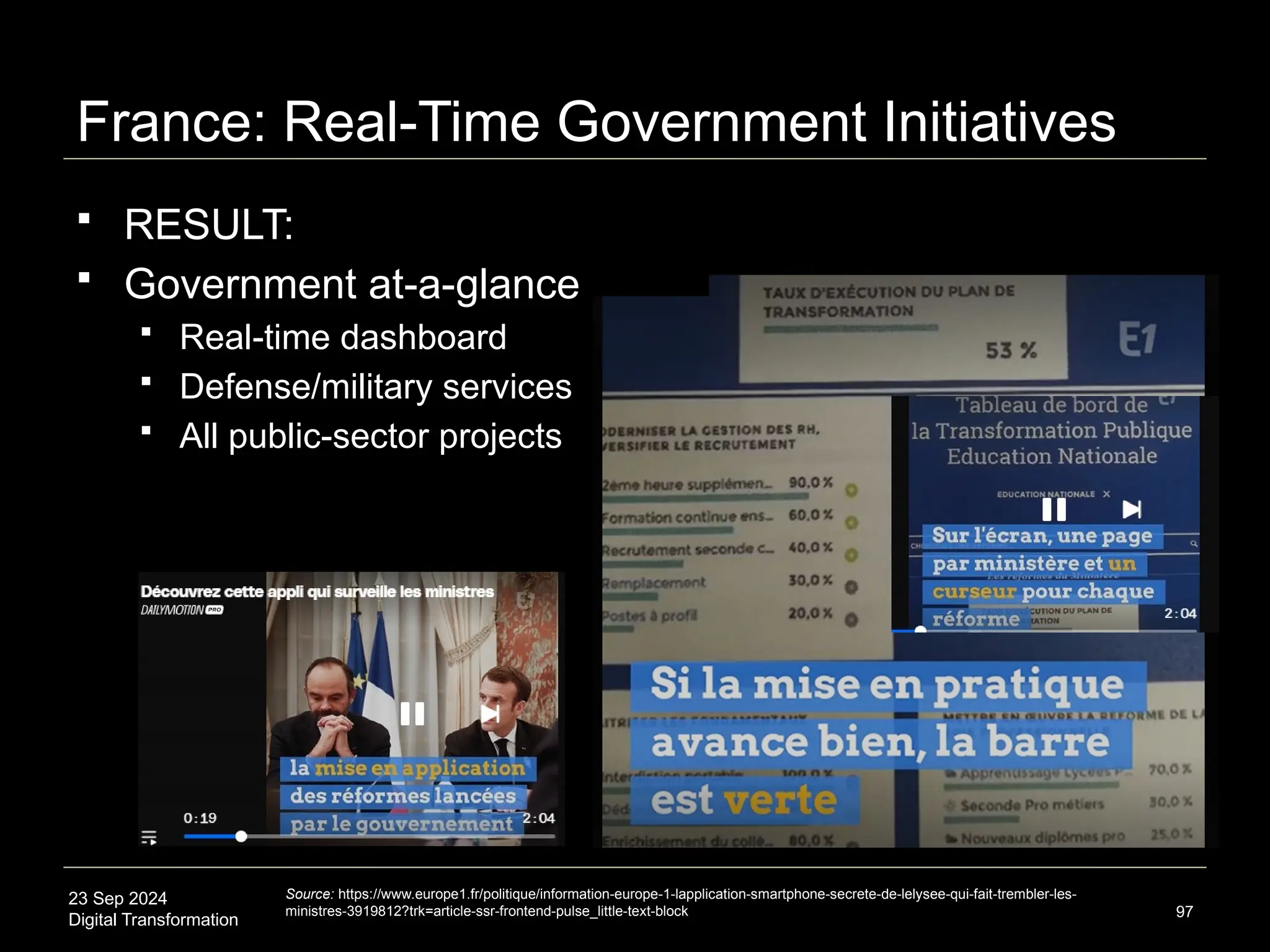

French Government: All projects at-a-glance
Juice Analytics Real-time Dashboard
Real-time Dashboards: extending to
all industries not just financial
markets
Secondary School Reform
Percent complete
transformation plan
Modernization of Labor
23 Sep 2024
Digital Transformation

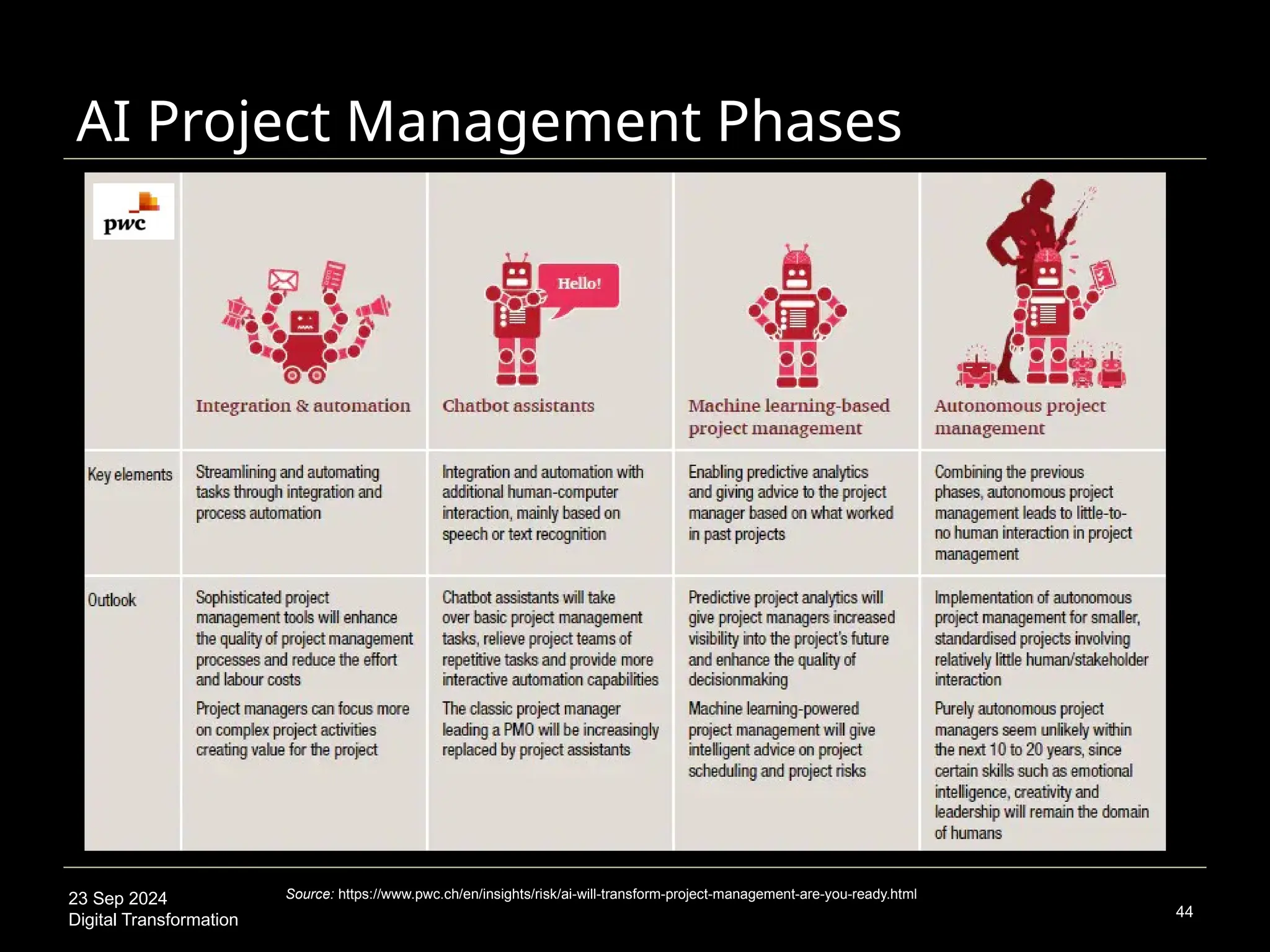

AI Project Management Phases
44
Source: https://www.pwc.ch/en/insights/risk/ai-will-transform-project-management-are-you-ready.html
23 Sep 2024
Digital Transformation 45
Source: https://news.microsoft.com/m365-copilot-Sept-2024/
 Mathematical reasoning benchmarks: GSM8k, MATH
Math Agents
Copilot Agents
• Copilot as one UI for AI
• Agent-based canvas with integrated public-private data
• Web + Work + Pages (public + private + digital artifact/agent canvas)
23 Sep 2024

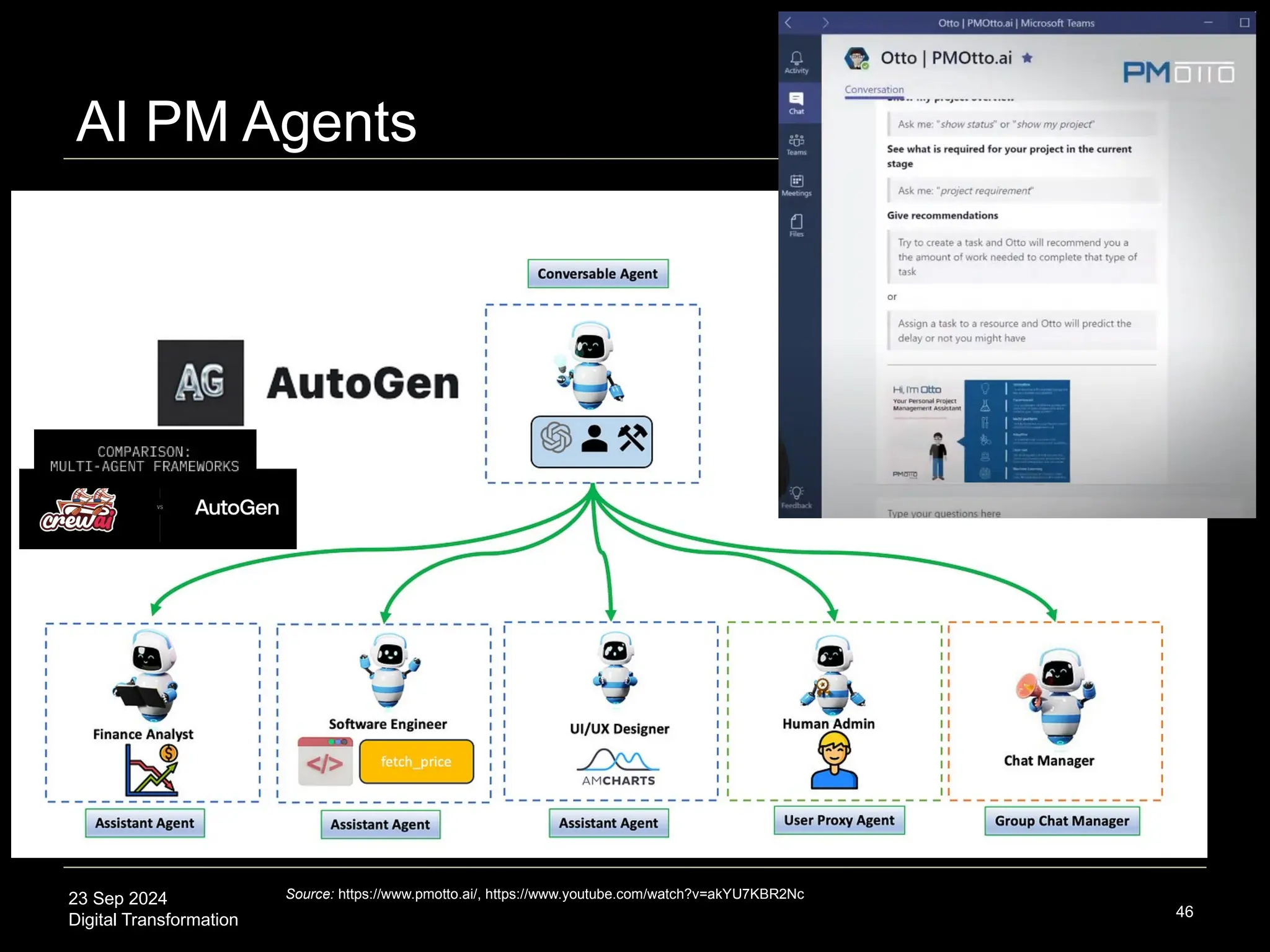

Digital Transformation
AI PM Agents
46
Source: https://www.pmotto.ai/, https://www.youtube.com/watch?v=akYU7KBR2Nc
23 Sep 2024
Digital Transformation

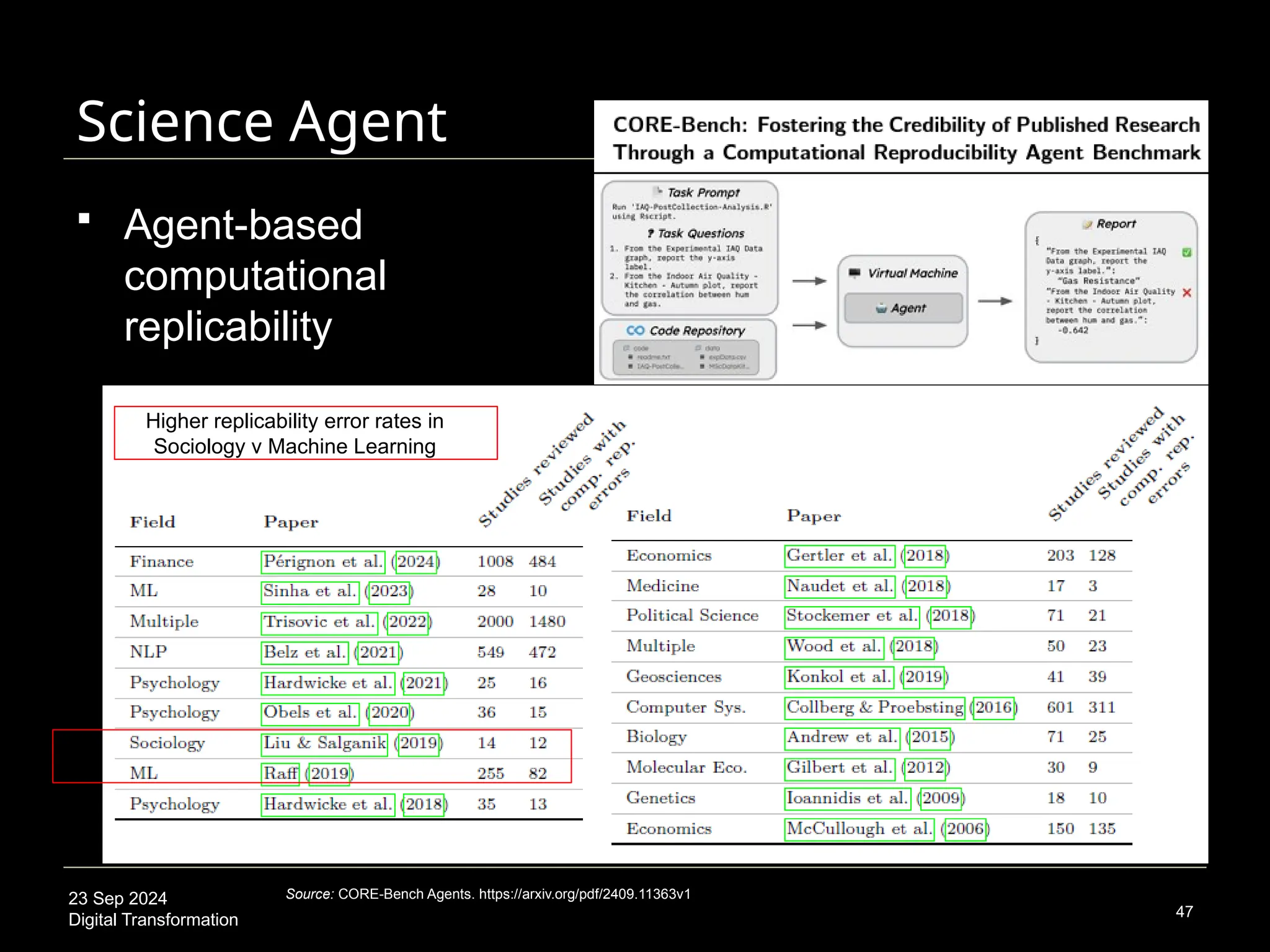

Science Agent
47
Source: CORE-Bench Agents. https://arxiv.org/pdf/2409.11363v1
 Agent-based
computational
replicability
Higher replicability error rates in
Sociology v Machine Learning
23 Sep 2024

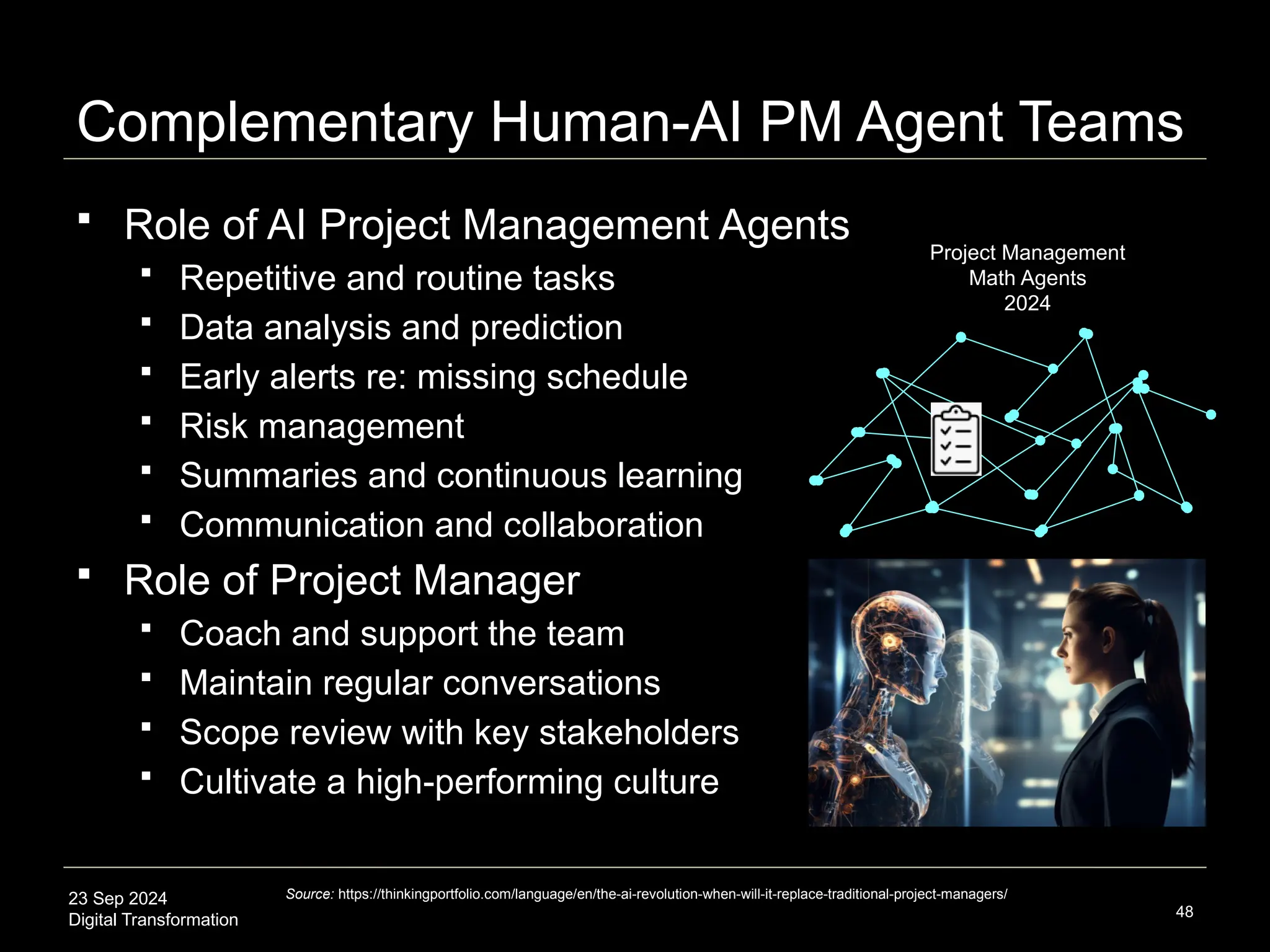

Digital Transformation

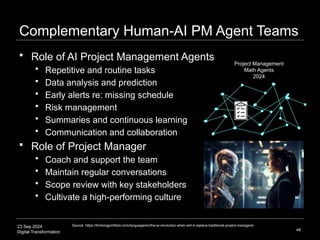

Complementary Human-AI PM Agent Teams
 Role of AI Project Management Agents
 Repetitive and routine tasks
 Data analysis and prediction
 Early alerts re: missing schedule
 Risk management
 Summaries and continuous learning
 Communication and collaboration
 Role of Project Manager
 Coach and support the team
 Maintain regular conversations
 Scope review with key stakeholders
 Cultivate a high-performing culture
48
Source: https://thinkingportfolio.com/language/en/the-ai-revolution-when-will-it-replace-traditional-project-managers/
Project Management
Math Agents
2024
23 Sep 2024
Digital Transformation
Agenda
 Digital Transformation
 Project Management
 Methods
 Waterfall vs Agile (and Scrum)
 Planning and Scheduling Tools
 Information Design & Gantt Chart
 Work Breakdown Structure
 Critical Path Method
 Case Studies
 AI Project Management
 Advanced Topics
 Digital Twins, Web3-AI-Quantum
49
Cloud
Software
Hardware
Project Management
Math Agents
2024
23 Sep 2024
Digital Transformation
Project Management
Methods
50

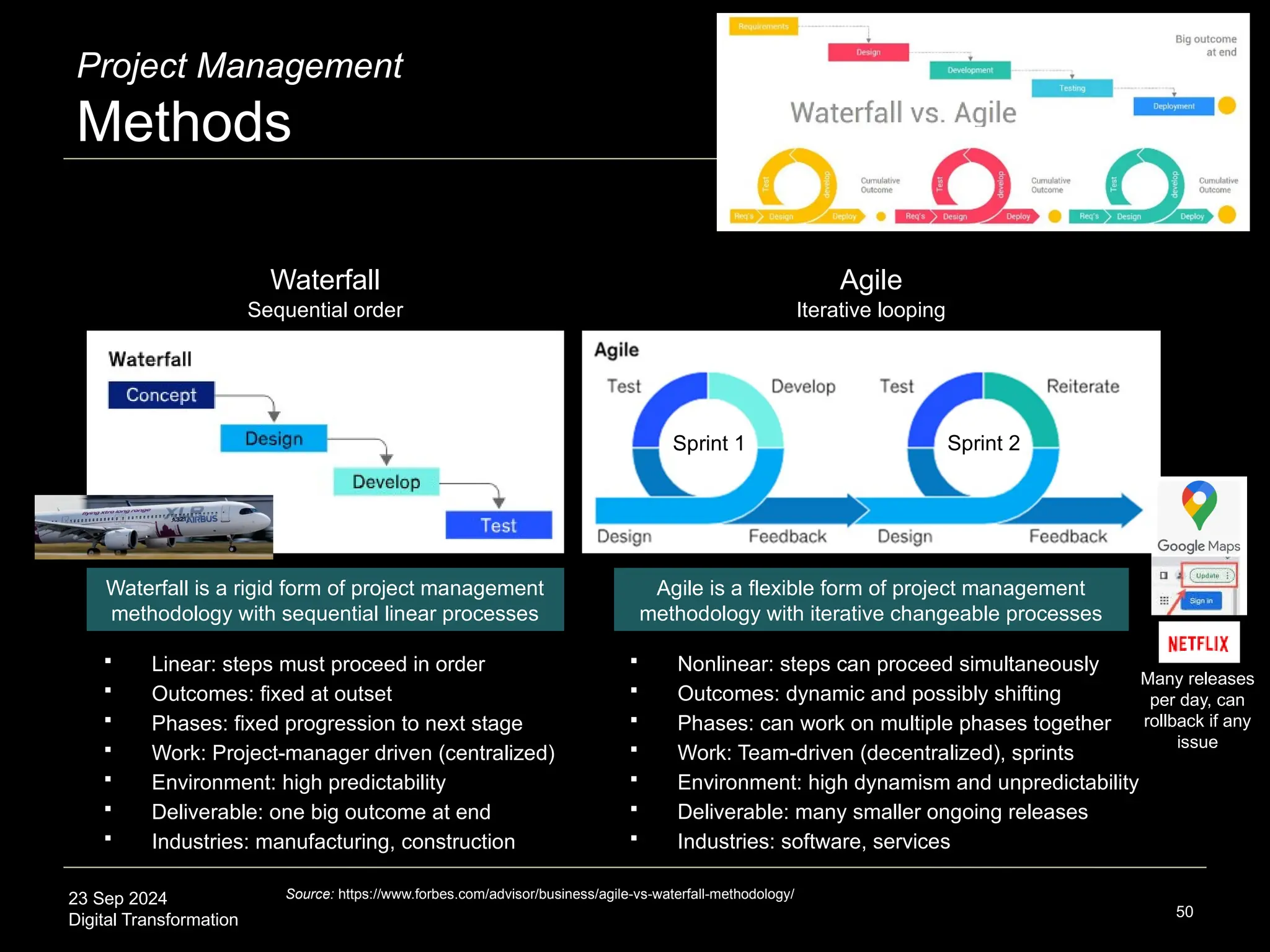

Agile
Waterfall
Source: https://www.forbes.com/advisor/business/agile-vs-waterfall-methodology/
Sequential order Iterative looping
Waterfall is a rigid form of project management
methodology with sequential linear processes
Agile is a flexible form of project management
methodology with iterative changeable processes
 Linear: steps must proceed in order
 Outcomes: fixed at outset
 Phases: fixed progression to next stage
 Work: Project-manager driven (centralized)
 Environment: high predictability
 Deliverable: one big outcome at end
 Industries: manufacturing, construction
 Nonlinear: steps can proceed simultaneously
 Outcomes: dynamic and possibly shifting
 Phases: can work on multiple phases together
 Work: Team-driven (decentralized), sprints
 Environment: high dynamism and unpredictability
 Deliverable: many smaller ongoing releases
 Industries: software, services
Sprint 2
Sprint 1
Many releases
per day, can
rollback if any
issue
23 Sep 2024
Digital Transformation 51

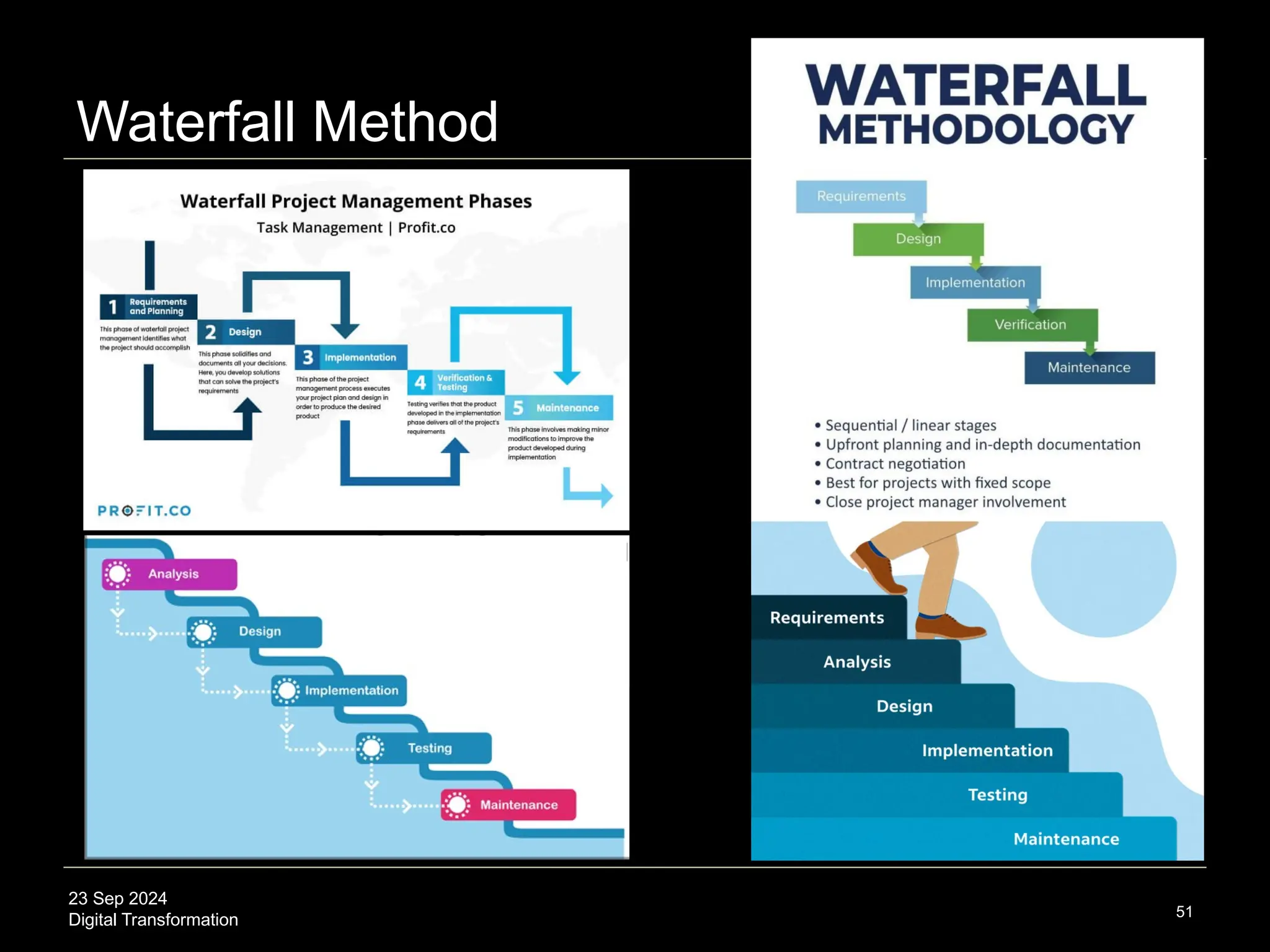

Waterfall Method
23 Sep 2024
Digital Transformation 52
Source: https://agilemanifesto.org/
Agile Manifesto (2001)
 Distill agile principles for
software development
 Restore credibility
 Software projects non-
dependable: bloat, delay,
overbudget
 Support teams,
reconnect with outcomes
23 Sep 2024
Digital Transformation 53
Source: https://agilemanifesto.org/
Agile Principles
23 Sep 2024
Digital Transformation 54
Source: https://agilemanifesto.org/
Agile Principles: People over Processes
23 Sep 2024
Digital Transformation

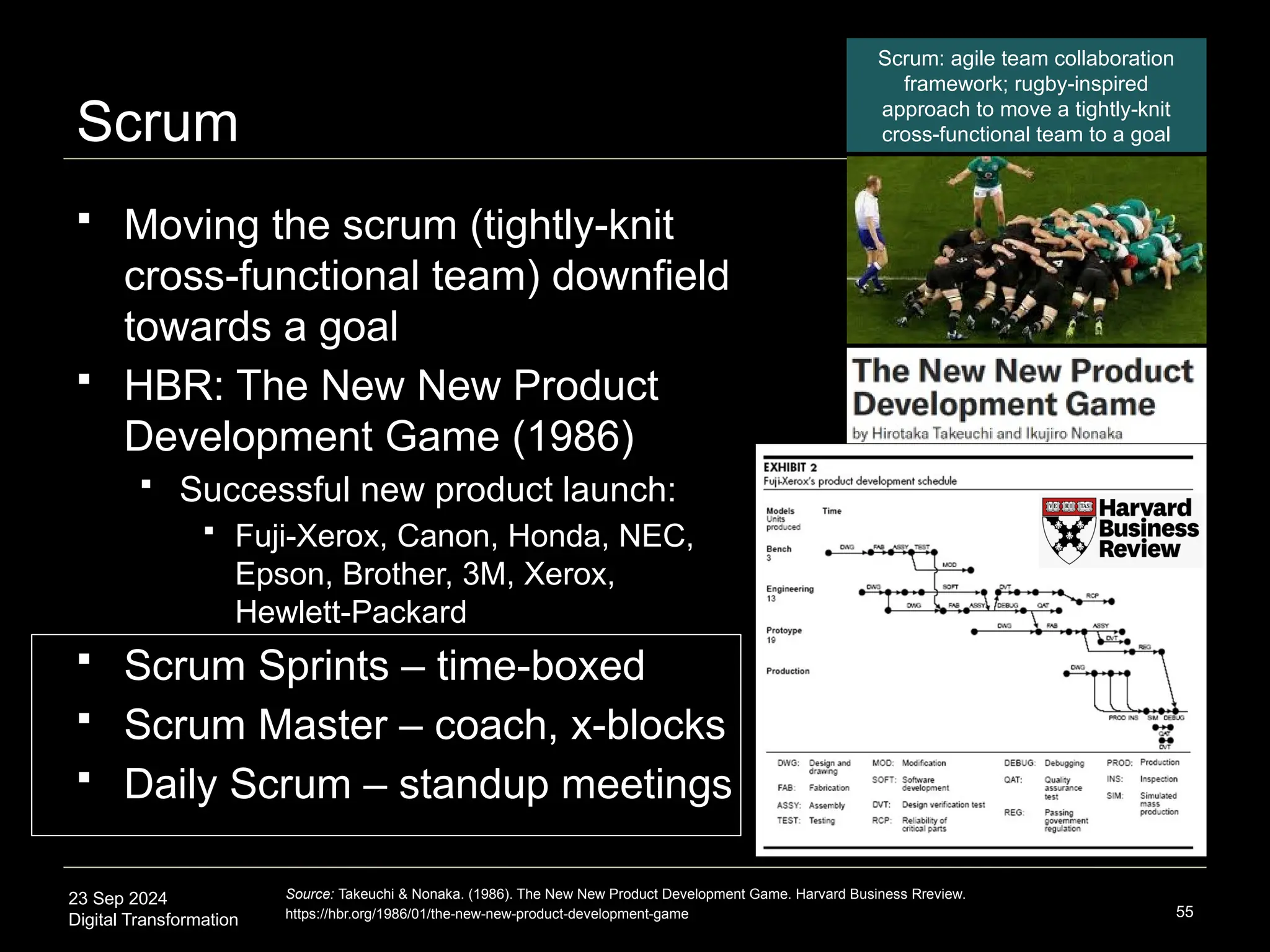

Scrum
 Moving the scrum (tightly-knit
cross-functional team) downfield
towards a goal
 HBR: The New New Product
Development Game (1986)
 Successful new product launch:
 Fuji-Xerox, Canon, Honda, NEC,
Epson, Brother, 3M, Xerox,
Hewlett-Packard
 Scrum Sprints – time-boxed
 Scrum Master – coach, x-blocks
 Daily Scrum – standup meetings
55
Source: Takeuchi & Nonaka. (1986). The New New Product Development Game. Harvard Business Rreview.
https://hbr.org/1986/01/the-new-new-product-development-game
Scrum: agile team collaboration
framework; rugby-inspired
approach to move a tightly-knit
cross-functional team to a goal
23 Sep 2024
Digital Transformation
56
Daily Standup Scrum Meeting
Source: https://agilescrumgroup.nl/daily-scrum/
Agile & Scrum: 2-week Sprints
 Agile (flexible iterative) is always
Scrum (sprints), scrum is not
always Agile
 Energy v inertia
 Focused bursts
1. Plan
2. Design
3. Develop
4. Test
5. Deploy
6. Review
7. Launch
23 Sep 2024
Digital Transformation
Agile Mindset
 “Silicon Valley mindset” : iterative and incremental
 High velocity flow, lean agile principle
 Short stand-up meetings
 What worked well this week?
 What didn't work well this week?
 What are we working on next week?
57
Agile Mindset: customer-driven work break big projects into
small chunks, release early and often, continuous feedback
in dynamic environments of change; energy contra inertia
Source: https://www.youtube.com/watch?v=ljKX2-sgcOg; Bruce Feiler: Agile programming
https://www.ted.com/talks/bruce_feiler_agile_programming_for_your_family?subtitle=en
A350, A330
Bruce Feiler: Agile
Programming
23 Sep 2024
Digital Transformation
Case Study: EV
 AIM: EV infrastructure for major EC auto manufacturer
58
 PROBLEM:
 Hardware
and
software
teams on
different
design and
release
schedules
Source: Rush, David. (2018). Accenture. Using agile processes and digital twin technology: Digital Twin Summit.
https://www.youtube.com/watch?v=ETTlTq88oHU
23 Sep 2024
Digital Transformation

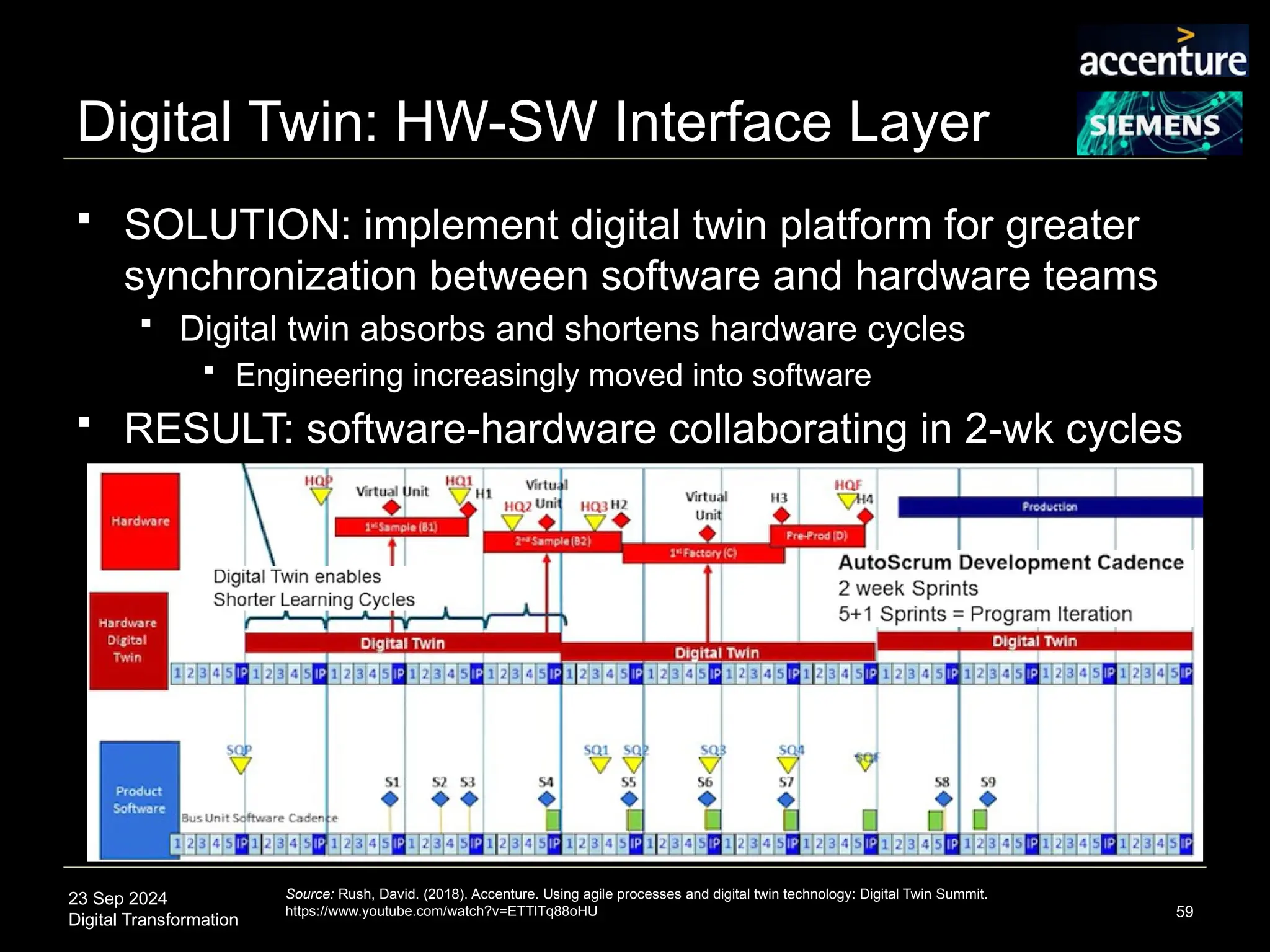

 SOLUTION: implement digital twin platform for greater
synchronization between software and hardware teams
 Digital twin absorbs and shortens hardware cycles
 Engineering increasingly moved into software
 RESULT: software-hardware collaborating in 2-wk cycles
59
Source: Rush, David. (2018). Accenture. Using agile processes and digital twin technology: Digital Twin Summit.
https://www.youtube.com/watch?v=ETTlTq88oHU
Digital Twin: HW-SW Interface Layer
23 Sep 2024
Digital Transformation
Case Study: Digital Twin AutoScrum
60
Source: Rush, David. (2018). Accenture. Using agile processes and digital twin technology: Digital Twin Summit.
https://www.youtube.com/watch?v=ETTlTq88oHU
23 Sep 2024
Digital Transformation
Agenda
 Digital Transformation
 Project Management
 Methods
 Waterfall vs Agile (and Scrum)
 Planning and Scheduling Tools
 Information Design & Gantt Chart
 Work Breakdown Structure
 Critical Path Method
 Case Studies
 AI Project Management
 Advanced Topics
 Digital Twins, Web3-AI-Quantum
61
Cloud
Software
Hardware
Project Management
Math Agents
2024
23 Sep 2024
Digital Transformation
Information Design (Tufte)
62
Source: https://www.edwardtufte.com/
1997
23 Sep 2024
Digital Transformation
Data Visualization
63
Source: https://www.edwardtufte.com/bboard/q-and-a-fetch-msg?msg_id=000076
Energy
23 Sep 2024
Digital Transformation

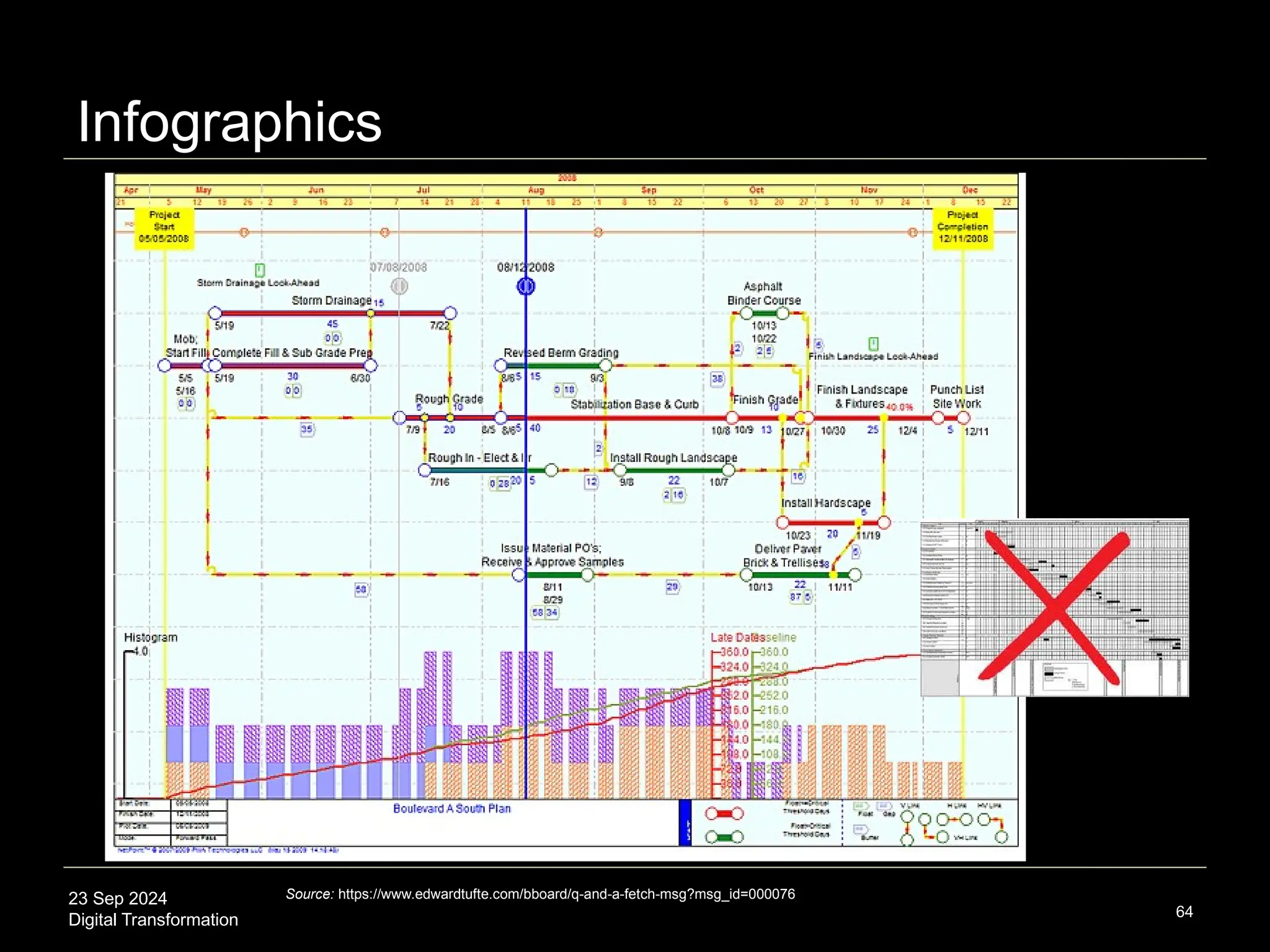

Infographics
64
Source: https://www.edwardtufte.com/bboard/q-and-a-fetch-msg?msg_id=000076
23 Sep 2024
Digital Transformation

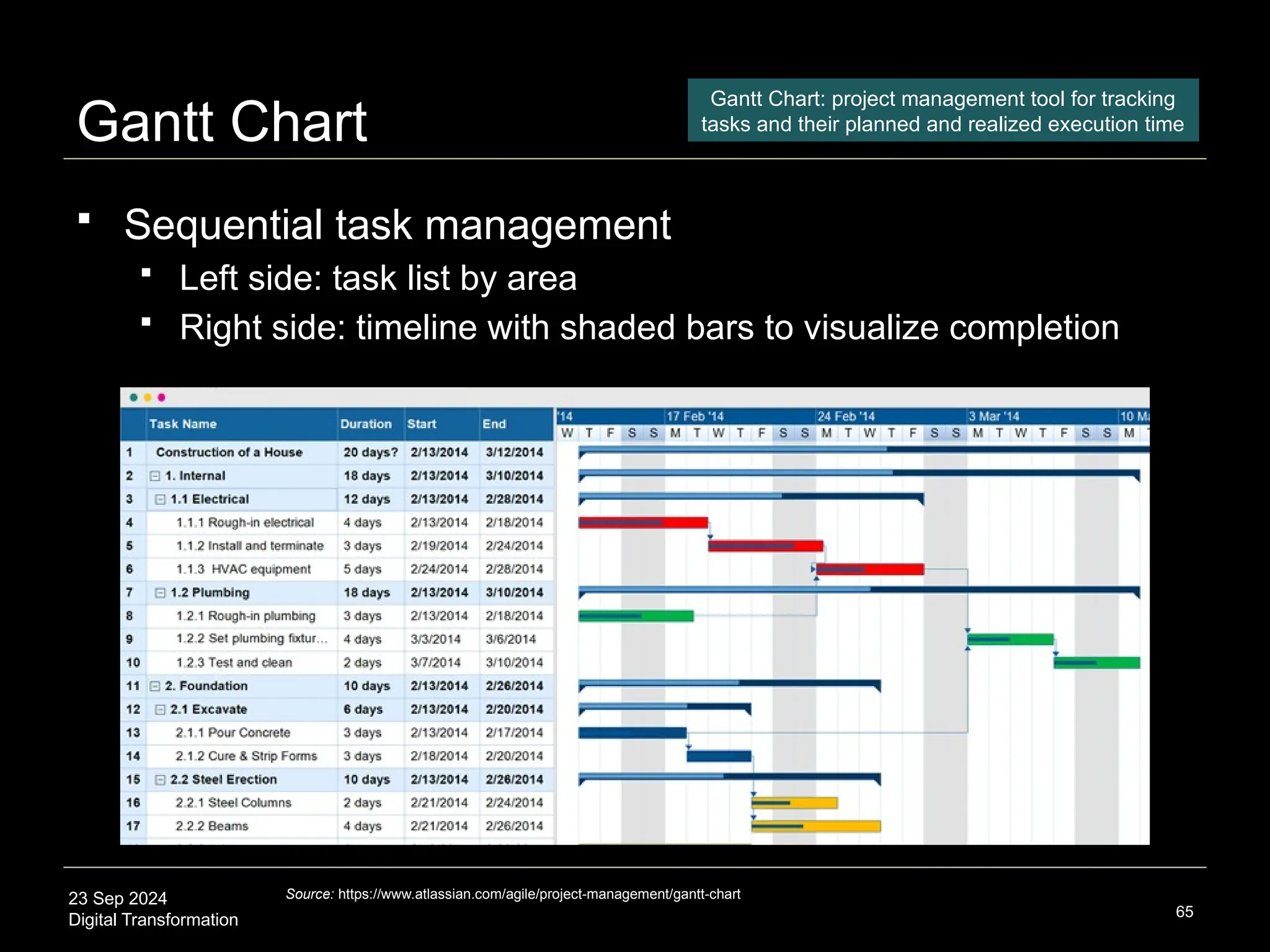

Gantt Chart
 Sequential task management
 Left side: task list by area
 Right side: timeline with shaded bars to visualize completion
65
Source: https://www.atlassian.com/agile/project-management/gantt-chart
Gantt Chart: project management tool for tracking
tasks and their planned and realized execution time
23 Sep 2024
Digital Transformation
66

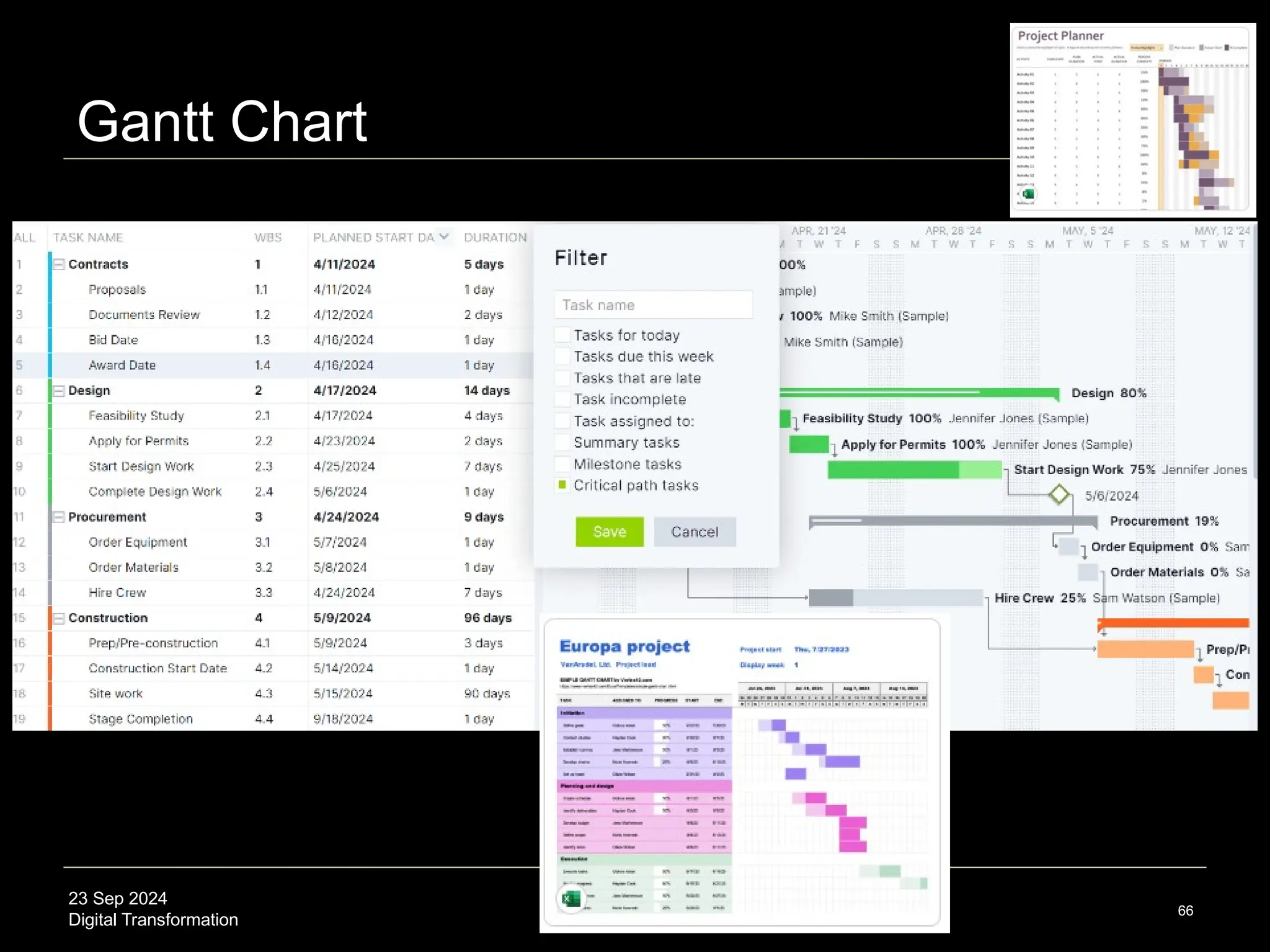

Gantt Chart
23 Sep 2024
Digital Transformation
Agenda
 Digital Transformation
 Project Management
 Methods
 Waterfall vs Agile (and Scrum)
 Planning and Scheduling Tools
 Information Design & Gantt Chart
 Work Breakdown Structure
 Critical Path Method
 Case Studies
 AI Project Management
 Advanced Topics
 Digital Twins, Web3-AI-Quantum
67
Cloud
Software
Hardware
Project Management
Math Agents
2024
23 Sep 2024
Digital Transformation
Work Breakdown Structure
 Aim: How can I make this project more manageable?
 Every project is different, every project manager is different,
every WBS is different
 How to make a Work Breakdown Structure
68
Source: https://www.workbreakdownstructure.com/
Work Breakdown Structure: a deliverable-
oriented hierarchical decomposition of the
work to be executed in key steps
23 Sep 2024
Digital Transformation

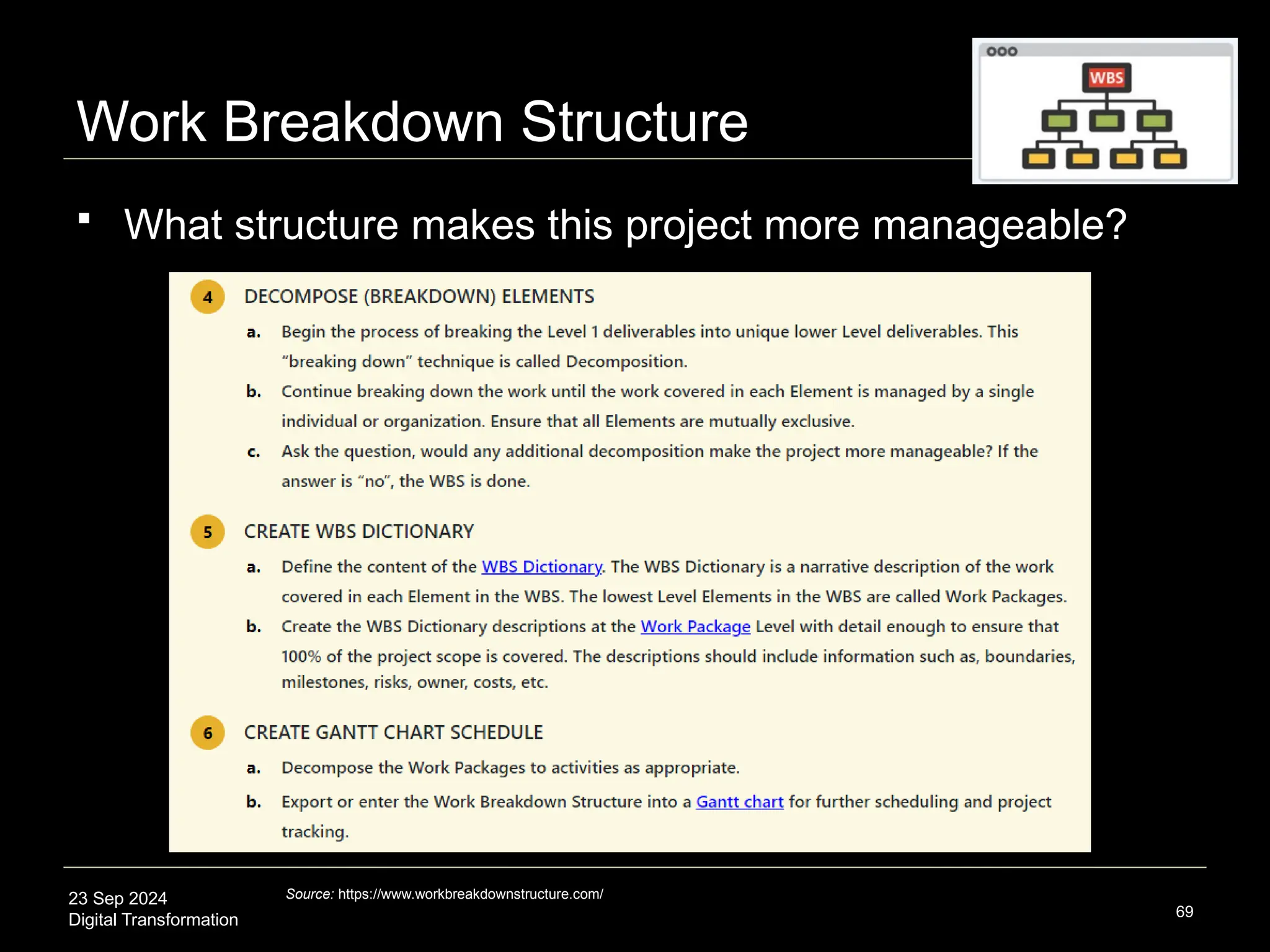

Work Breakdown Structure
 What structure makes this project more manageable?
69
Source: https://www.workbreakdownstructure.com/
23 Sep 2024
Digital Transformation
Case Study: Work Breakdown Structure
 Bite-size roadmap
 Phases, deliverables, milestones, budget, completion
70
Source: https://www.workbreakdownstructure.com/
23 Sep 2024
Digital Transformation
Case Study: Work Breakdown Structure
71
Source: https://www.workbreakdownstructure.com/
23 Sep 2024
Digital Transformation
Case Study: Work Breakdown Structure
72
Source: https://www.workbreakdownstructure.com/
23 Sep 2024
Digital Transformation
Case Study: NASA Scheduling Upgrade
73
 NASA’s Deep Space Network (DSN)
 Managed by Jet Propulsion Laboratory
(JPL) Pasadena CA USA
 Support a wide range of missions
 Communicate with interplanetary
spacecraft for timely action-taking
 Conduct radio and radar astronomy
 Plant footprint
 14 terrestrial antennas located at
 3 complexes: US, Spain, Australia
 Day-to-day operations
 Manage 40+ space missions
concurrently
Suzanne Dodd, Interplanetary
Network Director and Project
Manager for the Voyager
Interstellar Mission, NASA
Source: https://azure.microsoft.com/en-us/blog/quantum/2022/01/27/nasas-jpl-uses-microsofts-azure-quantum-to-manage-
communication-with-space-missions/
23 Sep 2024
Digital Transformation

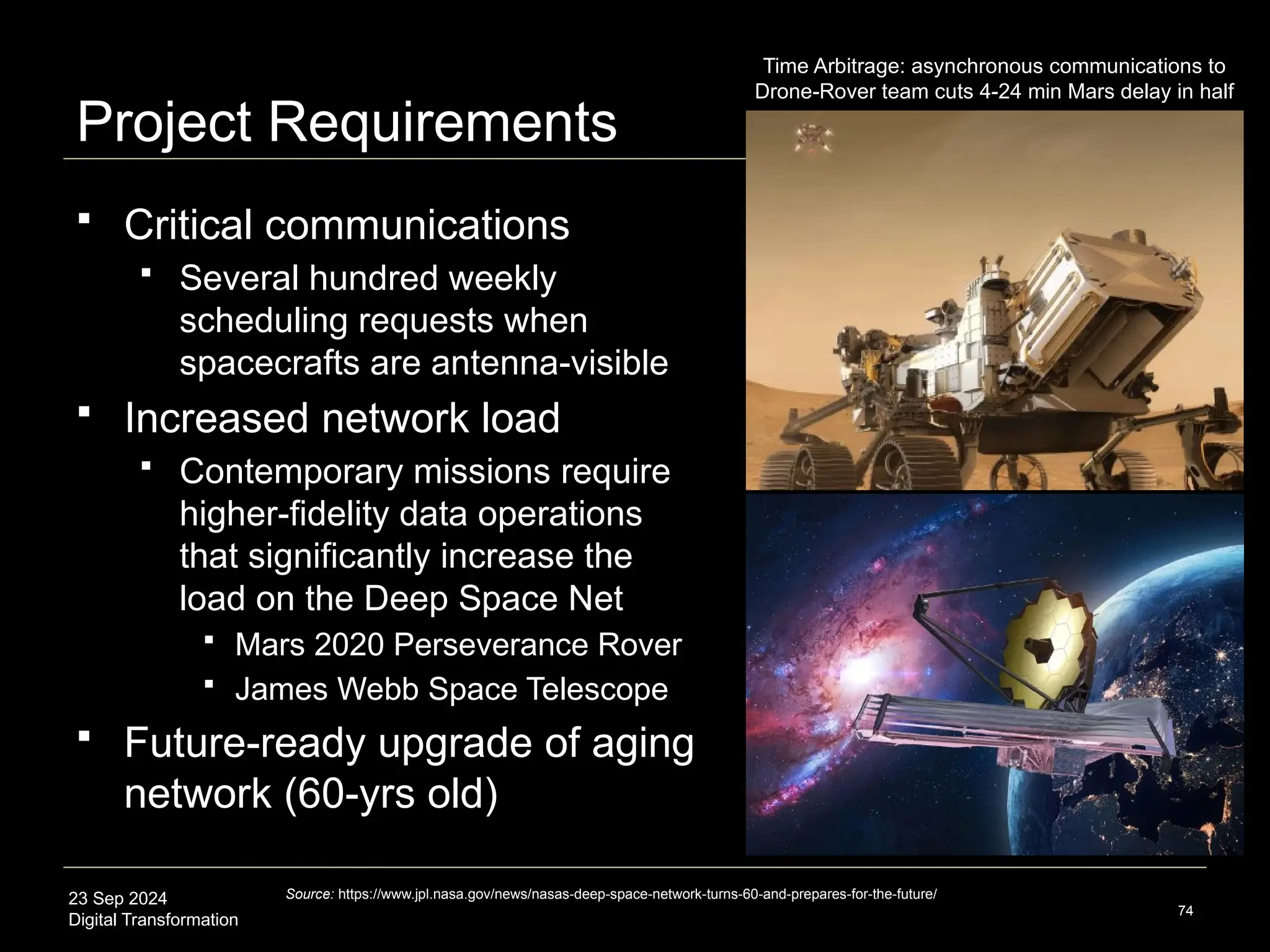

Project Requirements
74
 Critical communications
 Several hundred weekly
scheduling requests when
spacecrafts are antenna-visible
 Increased network load
 Contemporary missions require
higher-fidelity data operations
that significantly increase the
load on the Deep Space Net
 Mars 2020 Perseverance Rover
 James Webb Space Telescope
 Future-ready upgrade of aging
network (60-yrs old)
Source: https://www.jpl.nasa.gov/news/nasas-deep-space-network-turns-60-and-prepares-for-the-future/
Time Arbitrage: asynchronous communications to
Drone-Rover team cuts 4-24 min Mars delay in half
23 Sep 2024
Digital Transformation

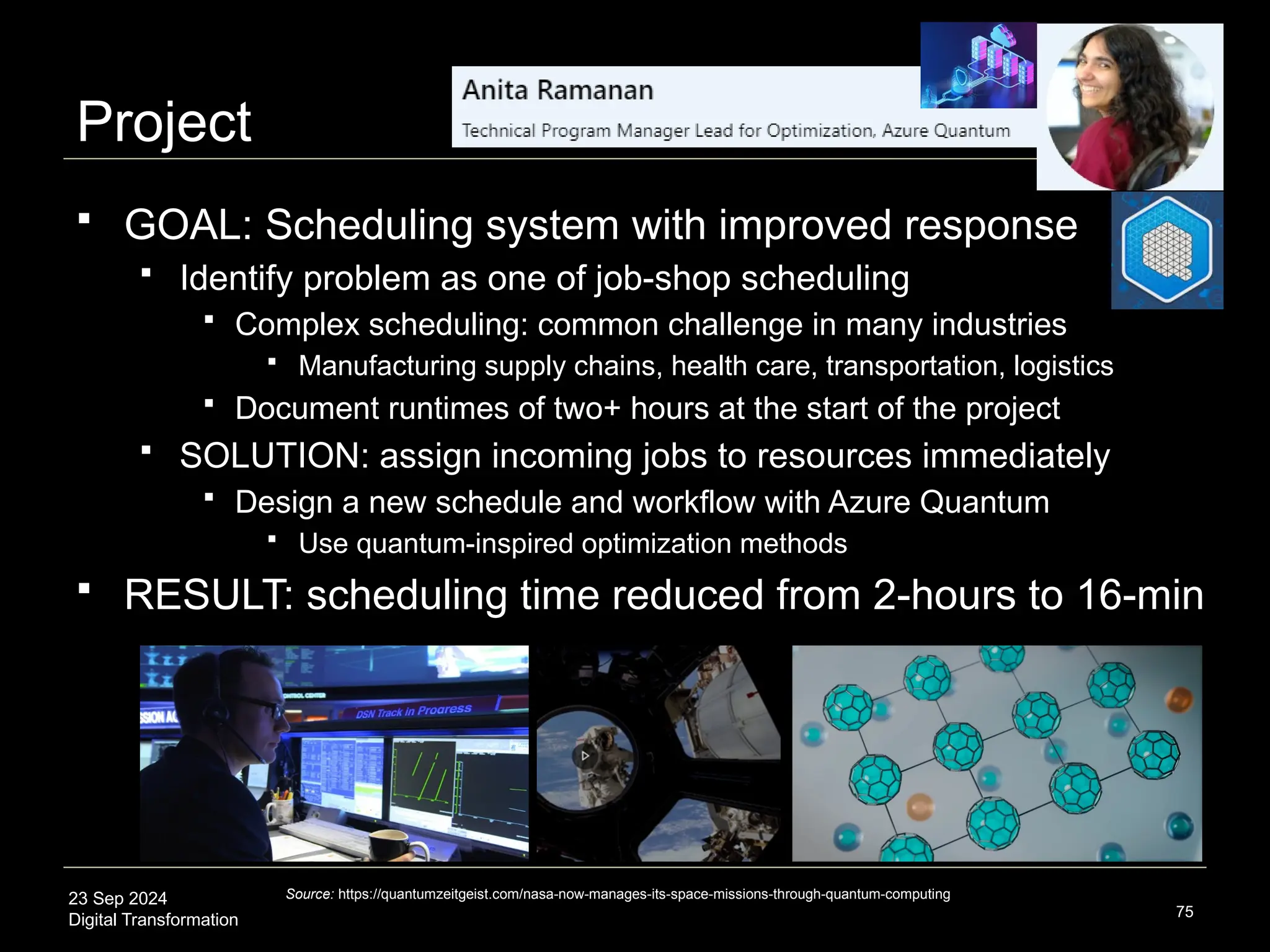

Project
 GOAL: Scheduling system with improved response
 Identify problem as one of job-shop scheduling
 Complex scheduling: common challenge in many industries
 Manufacturing supply chains, health care, transportation, logistics
 Document runtimes of two+ hours at the start of the project
 SOLUTION: assign incoming jobs to resources immediately
 Design a new schedule and workflow with Azure Quantum
 Use quantum-inspired optimization methods
 RESULT: scheduling time reduced from 2-hours to 16-min
75
Source: https://quantumzeitgeist.com/nasa-now-manages-its-space-missions-through-quantum-computing
23 Sep 2024
Digital Transformation
NASA Deep Space Network
76
Source: https://eyes.nasa.gov/dsn/dsn.html
14 terrestrial antennas in 3 complexes
US, Spain, Australia
23 Sep 2024
Digital Transformation
Agenda
 Digital Transformation
 Project Management
 Methods
 Waterfall vs Agile (and Scrum)
 Planning and Scheduling Tools
 Information Design & Gantt Chart
 Work Breakdown Structure
 Critical Path Method
 Case Studies
 AI Project Management
 Advanced Topics
 Digital Twins, Web3-AI-Quantum
77
Cloud
Software
Hardware
Project Management
Math Agents
2024
23 Sep 2024
Digital Transformation

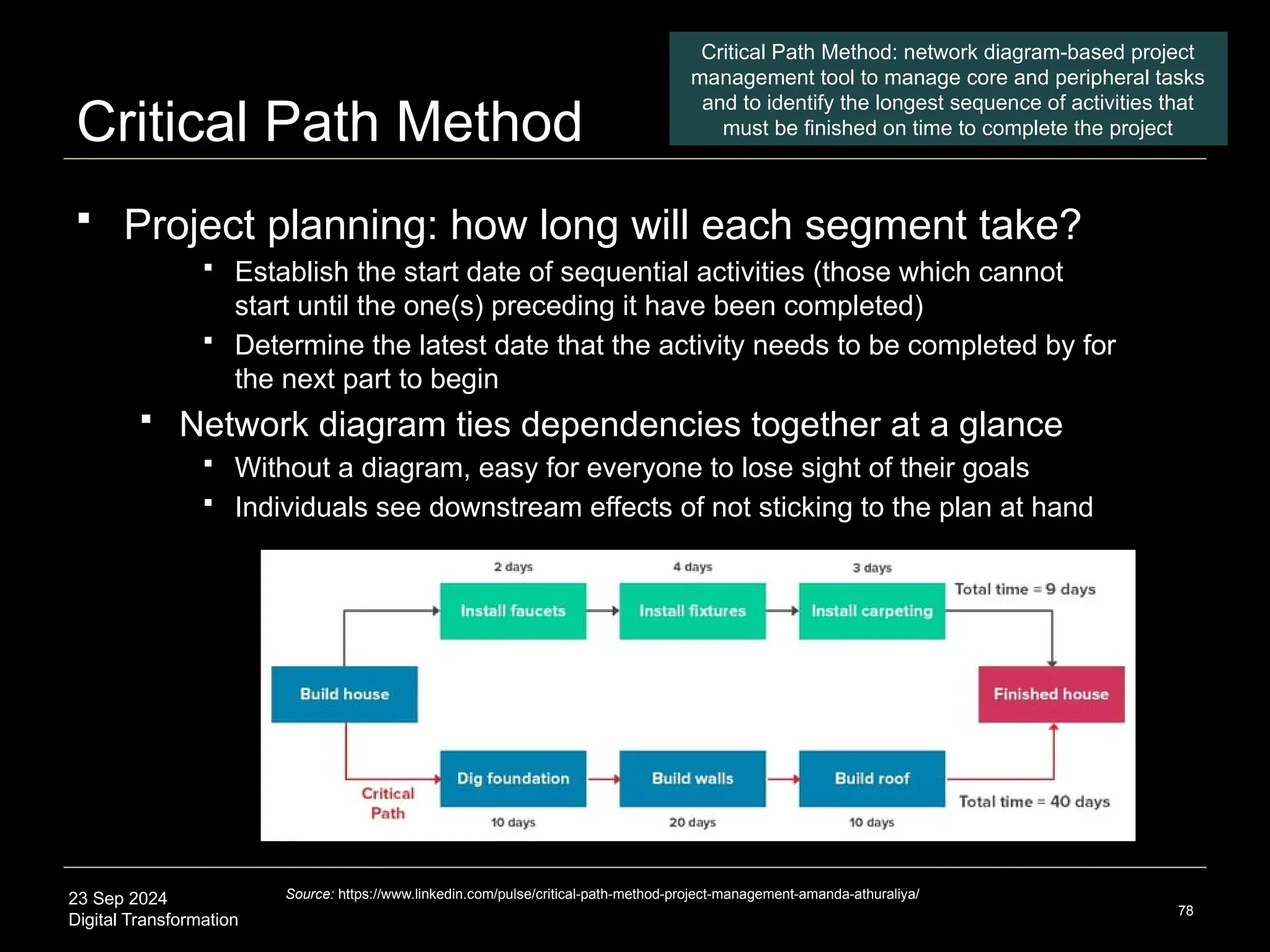

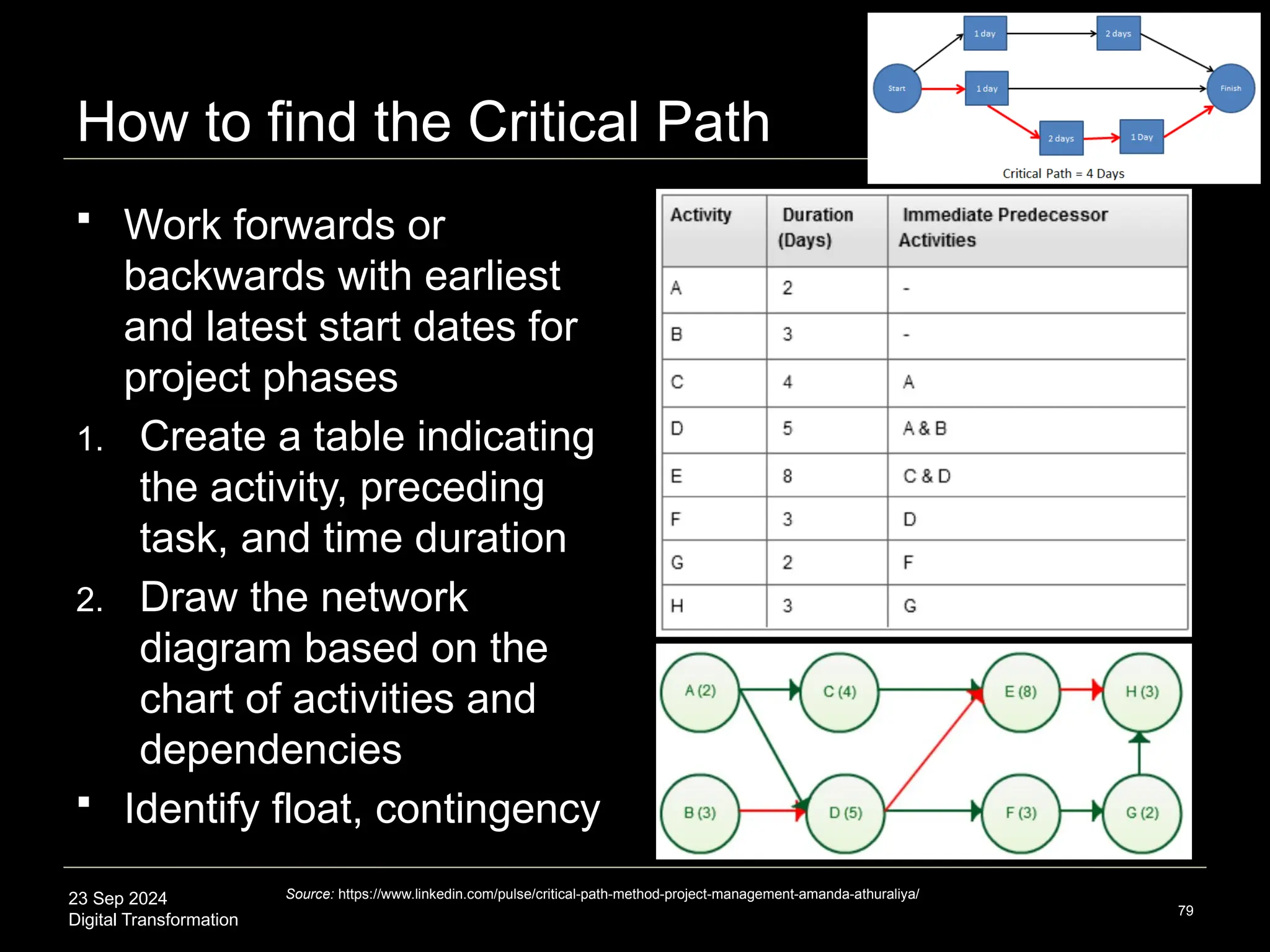

Critical Path Method
78
Critical Path Method: network diagram-based project
management tool to manage core and peripheral tasks
and to identify the longest sequence of activities that
must be finished on time to complete the project
Source: https://www.linkedin.com/pulse/critical-path-method-project-management-amanda-athuraliya/
 Project planning: how long will each segment take?
 Establish the start date of sequential activities (those which cannot
start until the one(s) preceding it have been completed)
 Determine the latest date that the activity needs to be completed by for
the next part to begin
 Network diagram ties dependencies together at a glance
 Without a diagram, easy for everyone to lose sight of their goals
 Individuals see downstream effects of not sticking to the plan at hand
23 Sep 2024
Digital Transformation
How to find the Critical Path
79
Source: https://www.linkedin.com/pulse/critical-path-method-project-management-amanda-athuraliya/
 Work forwards or
backwards with earliest
and latest start dates for
project phases
1. Create a table indicating
the activity, preceding
task, and time duration
2. Draw the network
diagram based on the
chart of activities and
dependencies
 Identify float, contingency
23 Sep 2024
Digital Transformation
80
Critical Path Method
Example #1
Critical Path Method
Example #2
23 Sep 2024
Digital Transformation

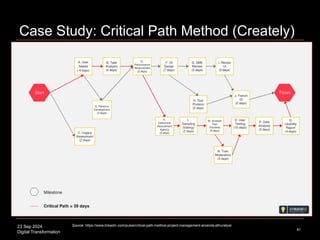

Case Study: Critical Path Method (Creately)
81
Source: https://www.linkedin.com/pulse/critical-path-method-project-management-amanda-athuraliya/
23 Sep 2024
Digital Transformation
Critical Path Method
82
Source: https://www.linkedin.com/pulse/critical-path-method-project-management-amanda-athuraliya/
Project: Design and Install
Eco-Friendly Storage Tanks
 Implication:
 Graph-based
format readily
implementable
in AI systems
23 Sep 2024
Digital Transformation
Agenda
 Digital Transformation
 Project Management
 Methods
 Waterfall vs Agile (and Scrum)
 Planning and Scheduling Tools
 Information Design & Gantt Chart
 Work Breakdown Structure
 Critical Path Method
 Case Studies
 AI Project Management
 Advanced Topics
 Digital Twins, Web3-AI-Quantum
83
Cloud
Software
Hardware
Project Management
Math Agents
2024
23 Sep 2024
Digital Transformation
Case Studies by Topic
84
Source: https://www.pmsolutions.com/case-studies
23 Sep 2024
Digital Transformation

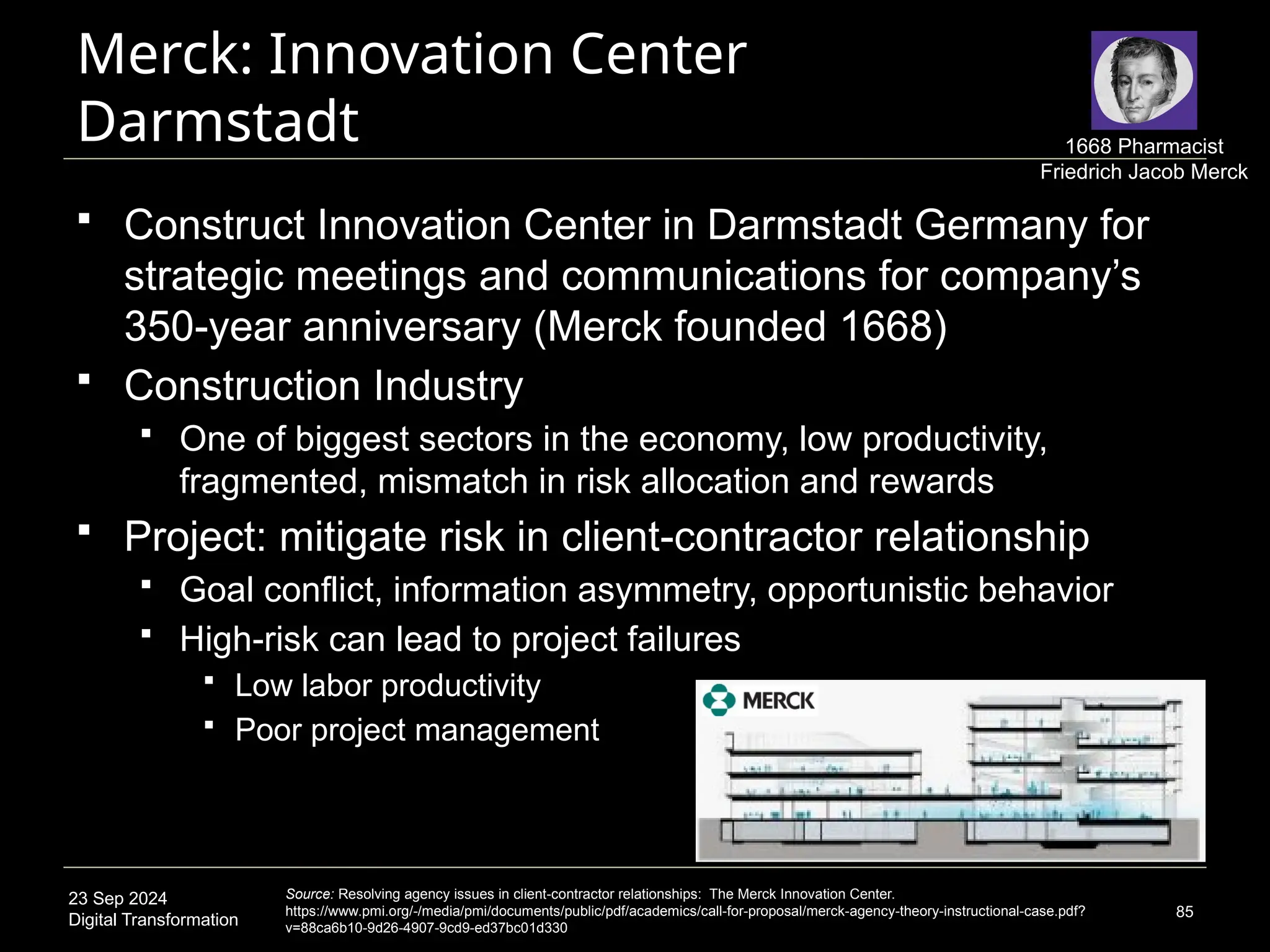

Merck: Innovation Center
Darmstadt
85
Source: Resolving agency issues in client-contractor relationships: The Merck Innovation Center.
https://www.pmi.org/-/media/pmi/documents/public/pdf/academics/call-for-proposal/merck-agency-theory-instructional-case.pdf?
v=88ca6b10-9d26-4907-9cd9-ed37bc01d330
 Construct Innovation Center in Darmstadt Germany for
strategic meetings and communications for company’s
350-year anniversary (Merck founded 1668)
 Construction Industry
 One of biggest sectors in the economy, low productivity,
fragmented, mismatch in risk allocation and rewards
 Project: mitigate risk in client-contractor relationship
 Goal conflict, information asymmetry, opportunistic behavior
 High-risk can lead to project failures
 Low labor productivity
 Poor project management
1668 Pharmacist
Friedrich Jacob Merck
23 Sep 2024
Digital Transformation
Merck: Innovation Center
Darmstadt
86
Source: Resolving agency issues in client-contractor relationships: The Merck Innovation Center.
https://www.pmi.org/-/media/pmi/documents/public/pdf/academics/call-for-proposal/merck-agency-theory-instructional-case.pdf?
v=88ca6b10-9d26-4907-9cd9-ed37bc01d330
 Concrete & Steel Works project phases
 Structural design
 Procurement process
 Execution
 DECISION POINT: procurement method
 Traditional procurement through competitive
tendering
 Sets up adversarial environment
 Innovative forms of procurement such as
open book contracts
 Less familiar to industry and difficult for
corporate governance to accommodate
23 Sep 2024
Digital Transformation

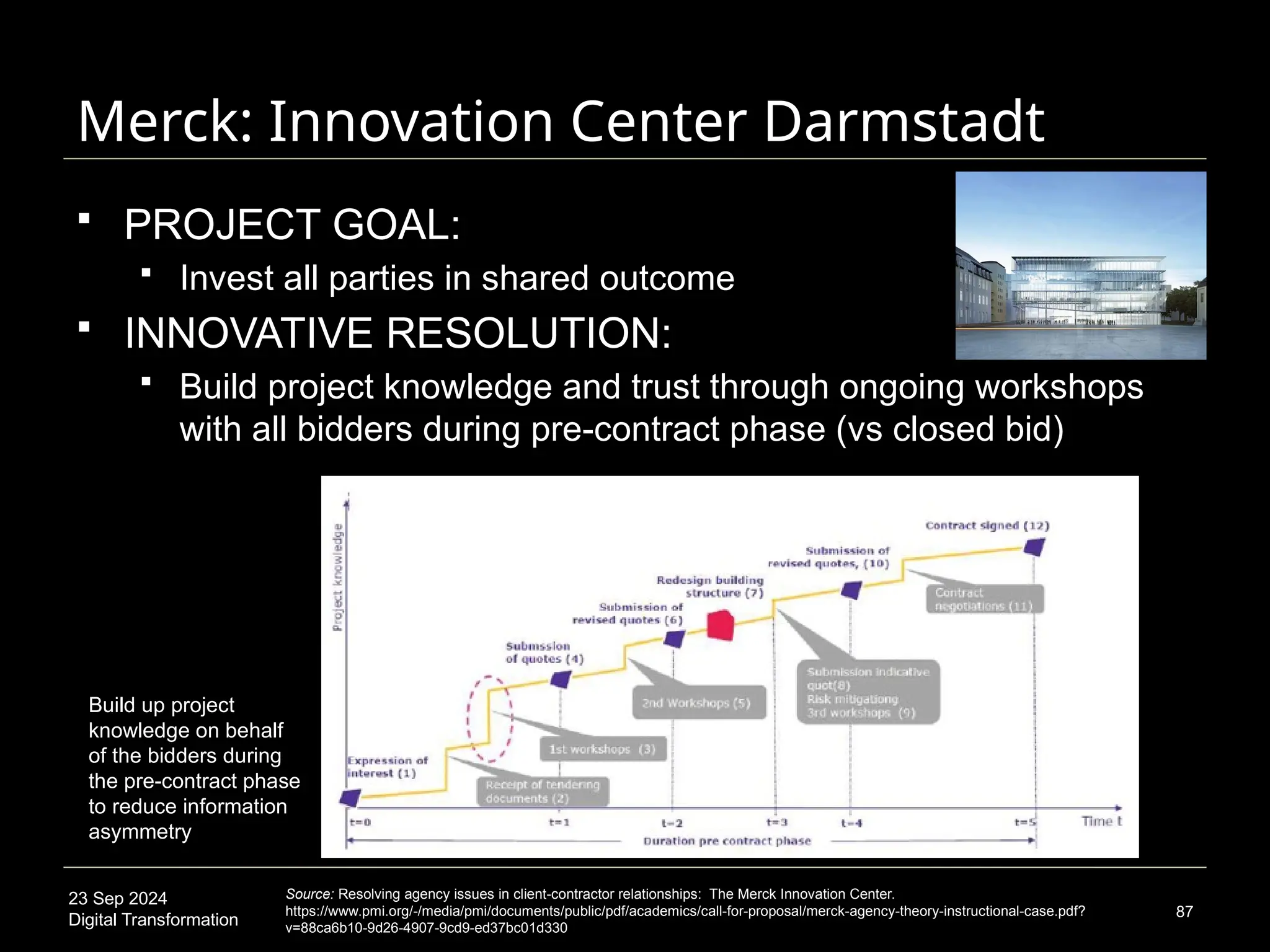

Merck: Innovation Center Darmstadt
87
Source: Resolving agency issues in client-contractor relationships: The Merck Innovation Center.
https://www.pmi.org/-/media/pmi/documents/public/pdf/academics/call-for-proposal/merck-agency-theory-instructional-case.pdf?
v=88ca6b10-9d26-4907-9cd9-ed37bc01d330
 PROJECT GOAL:
 Invest all parties in shared outcome
 INNOVATIVE RESOLUTION:
 Build project knowledge and trust through ongoing workshops
with all bidders during pre-contract phase (vs closed bid)
Build up project
knowledge on behalf
of the bidders during
the pre-contract phase
to reduce information
asymmetry
23 Sep 2024
Digital Transformation
Merck: Innovation Center
88
Source: Resolving agency issues in client-contractor relationships: The Merck Innovation Center.
https://www.pmi.org/-/media/pmi/documents/public/pdf/academics/call-for-proposal/merck-agency-theory-instructional-case.pdf?
v=88ca6b10-9d26-4907-9cd9-ed37bc01d330

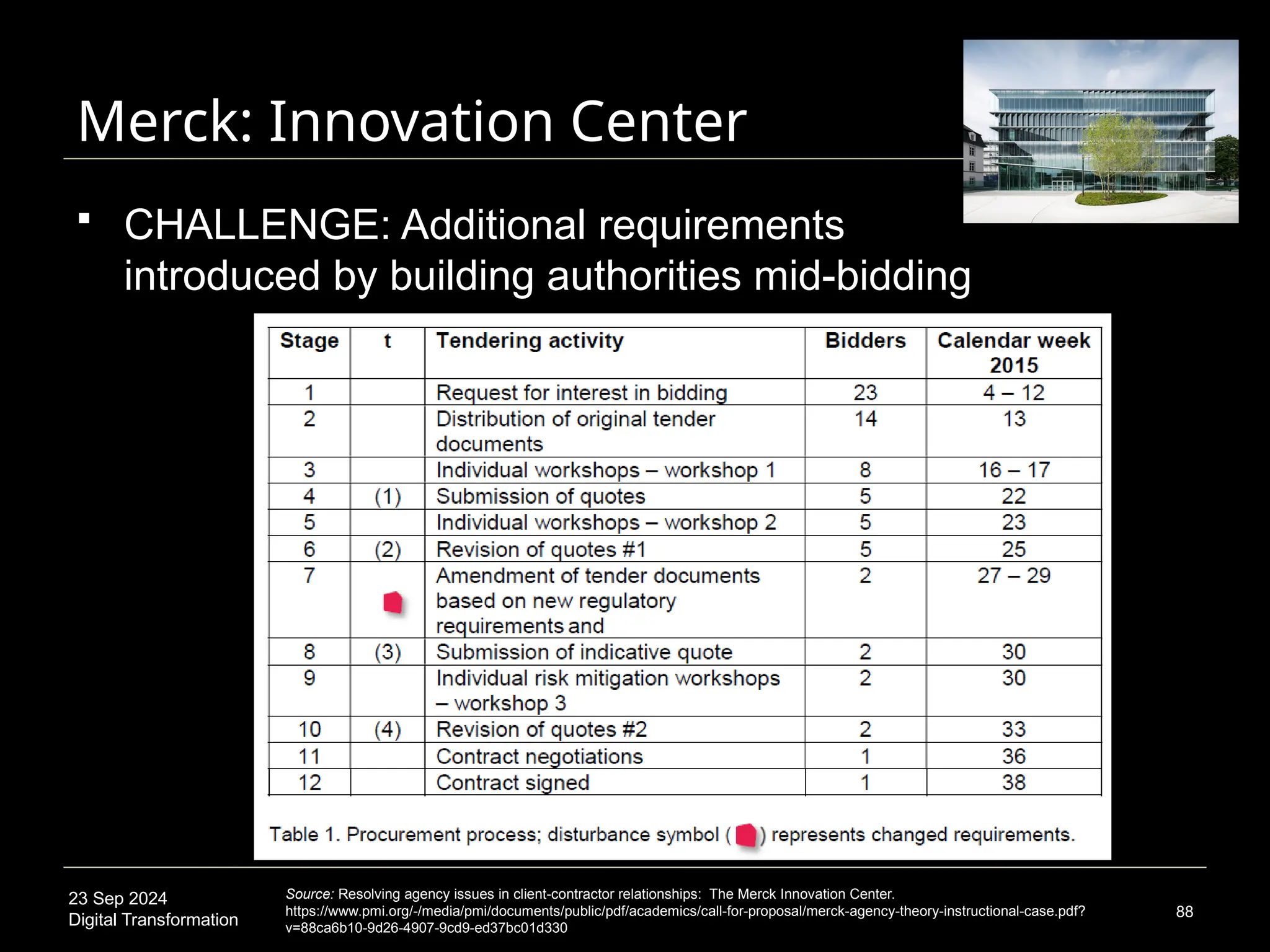

 CHALLENGE: Additional requirements
introduced by building authorities mid-bidding
23 Sep 2024
Digital Transformation
Merck: Innovation Center Darmstadt
89
Source: Resolving agency issues in client-contractor relationships: The Merck Innovation Center.
https://www.pmi.org/-/media/pmi/documents/public/pdf/academics/call-for-proposal/merck-agency-theory-instructional-case.pdf?
v=88ca6b10-9d26-4907-9cd9-ed37bc01d330
 Two final bidders
23 Sep 2024
Digital Transformation
Merck: Innovation Center Darmstadt
90
Source: Resolving agency issues in client-contractor relationships: The Merck Innovation Center.
https://www.pmi.org/-/media/pmi/documents/public/pdf/academics/call-for-proposal/merck-agency-theory-instructional-case.pdf?
v=88ca6b10-9d26-4907-9cd9-ed37bc01d330
 RESULT:
 Foundation work
started on time
 Concrete and steel
works completed in
timely high-quality
fashion
 Construction motivated
through incentives and
actively engaged in
resolving day-to-day
problems on site to
meet intermediate
milestones
23 Sep 2024
Digital Transformation
Agenda
 Digital Transformation
 Project Management
 Methods
 Waterfall vs Agile (and Scrum)
 Planning and Scheduling Tools
 Information Design & Gantt Chart
 Work Breakdown Structure
 Critical Path Method
 Case Studies
 AI Project Management
 Advanced Topics
 Digital Twins, Web3-AI-Quantum
91
Cloud
Software
Hardware
Project Management
Math Agents
2024
23 Sep 2024
Digital Transformation
Service NOW AI Project Management Case Study
French Ministry of Armed Forces
92
Source: https://www.youtube.com/watch?v=QA_-tM97crY
 Aim: military operations
maintaining territory
and sovereignty
 75,000 people, property,
equipment
 HR, finance, inventory
procurement, QA
 More than 3,000 IT
systems
 Goal: deliver superior
service in a highly rapid
and responsive manner
23 Sep 2024
Digital Transformation

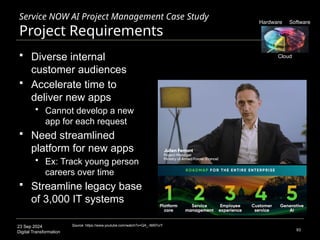

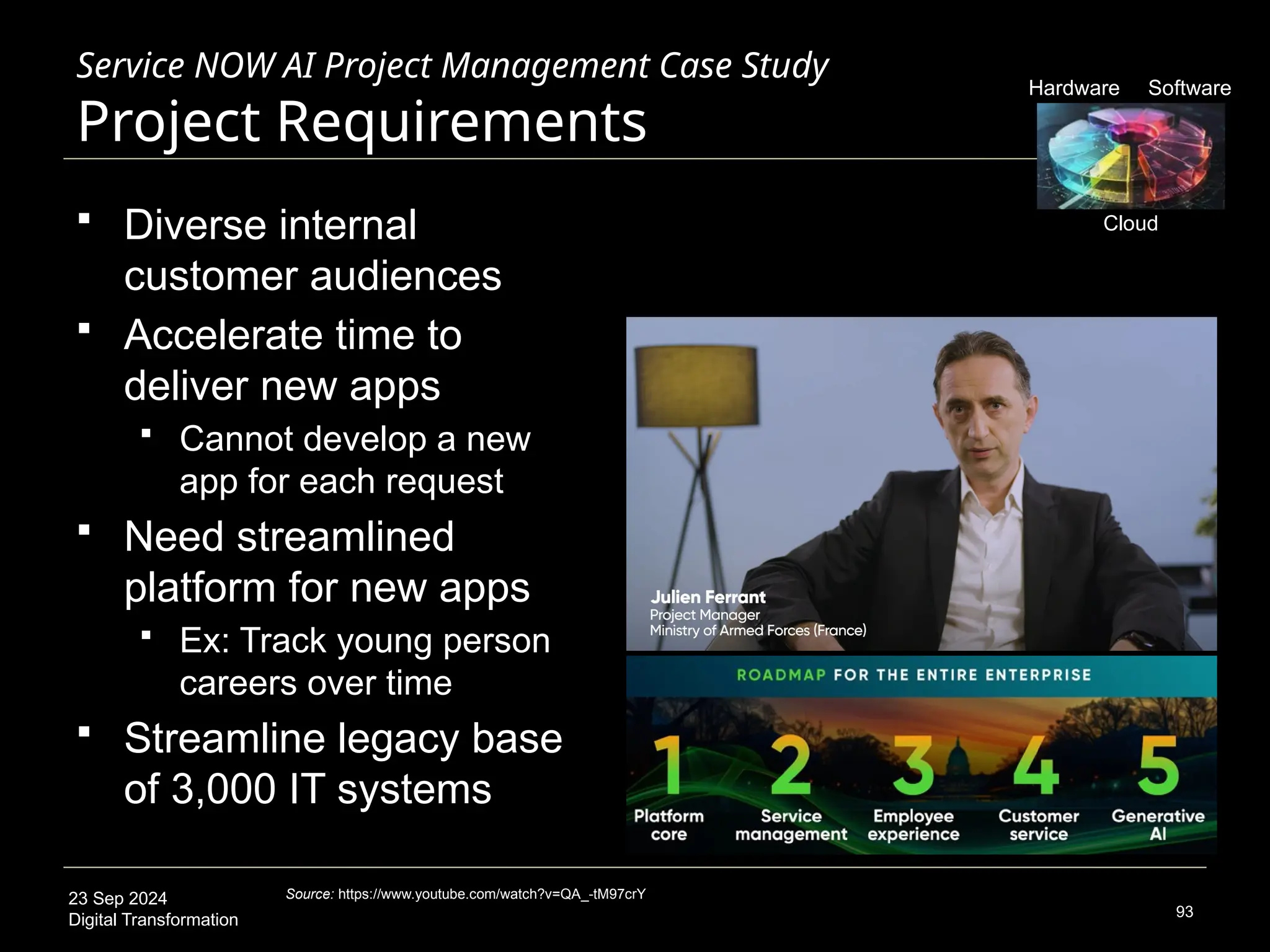

Service NOW AI Project Management Case Study
Project Requirements
93
Source: https://www.youtube.com/watch?v=QA_-tM97crY
 Diverse internal
customer audiences
 Accelerate time to
deliver new apps
 Cannot develop a new
app for each request
 Need streamlined
platform for new apps
 Ex: Track young person
careers over time
 Streamline legacy base
of 3,000 IT systems
Cloud
Software
Hardware
23 Sep 2024
Digital Transformation

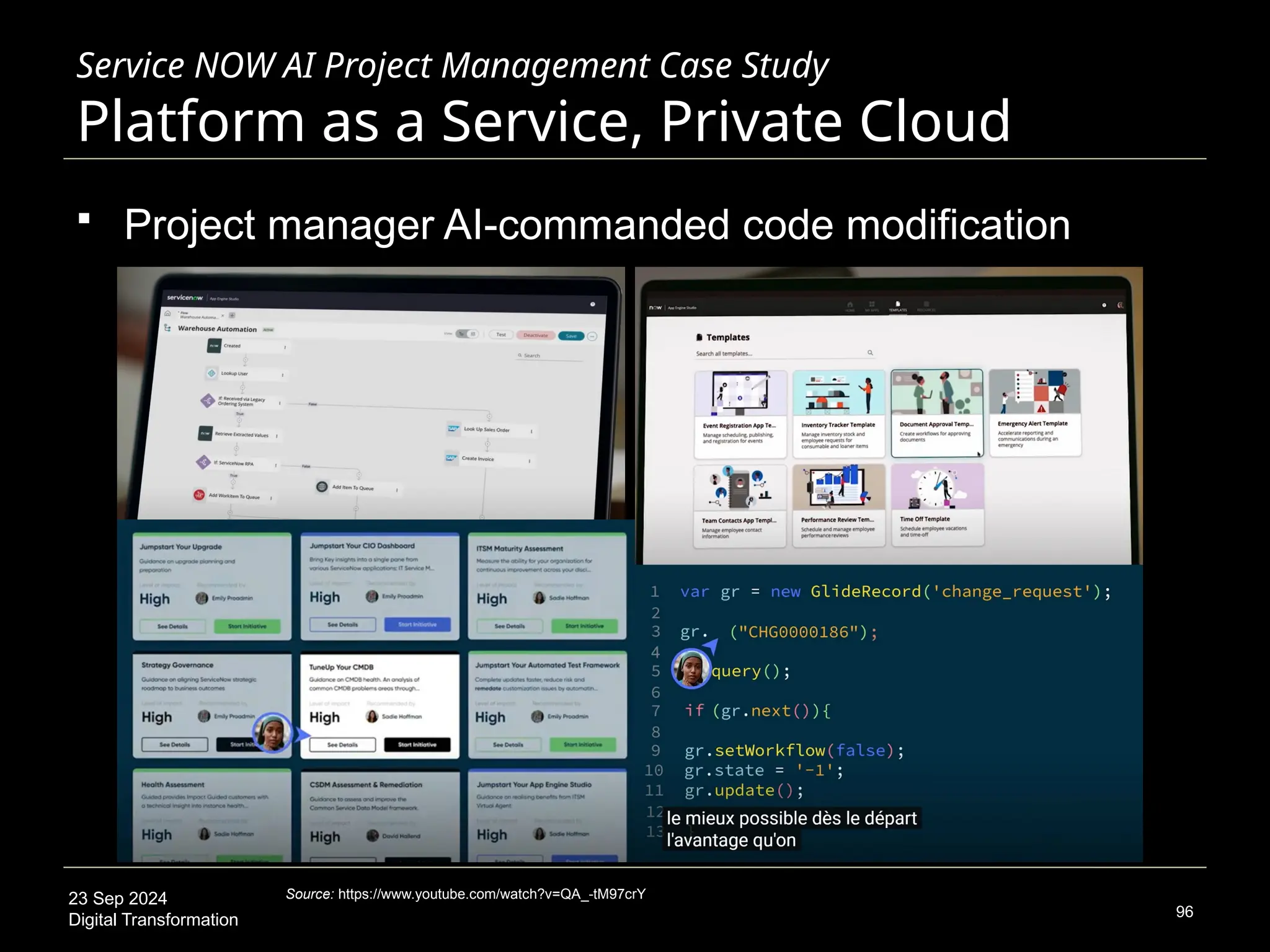

Service NOW AI Project Management Case Study
Platform as a Service, Private Cloud
94
Source: https://www.youtube.com/watch?v=QA_-tM97crY
 Select Service Now cloud, platform, and packages
 Advanced Impact, Strategic Portfolio Management, App
Portfolio Management, App Engine, Customer Svc Mgt
 Tech stack: cloud, platform, workflow apps
1
2
3
Quantum
23 Sep 2024
Digital Transformation
Service NOW AI Project Management Case Study
Platform as a Service, Private Cloud
95
Source: https://www.youtube.com/watch?v=QA_-tM97crY
 Tech stack: cloud, platform, workflow apps
1
2
3
23 Sep 2024
Digital Transformation
Service NOW AI Project Management Case Study
Platform as a Service, Private Cloud
96
Source: https://www.youtube.com/watch?v=QA_-tM97crY
 Project manager AI-commanded code modification
23 Sep 2024
Digital Transformation
France: Real-Time Government Initiatives
 RESULT:
 Government at-a-glance
 Real-time dashboard
 Defense/military services
 All public-sector projects
97
Source: https://www.europe1.fr/politique/information-europe-1-lapplication-smartphone-secrete-de-lelysee-qui-fait-trembler-les-
ministres-3919812?trk=article-ssr-frontend-pulse_little-text-block
23 Sep 2024
Digital Transformation
Agenda
 Digital Transformation
 Project Management
 Methods
 Waterfall vs Agile (and Scrum)
 Planning and Scheduling Tools
 Information Design & Gantt Chart
 Work Breakdown Structure
 Critical Path Method
 Case Studies
 AI Project Management
 Advanced Topics
 Digital Twins, Web3-AI-Quantum
98
Cloud
Software
Hardware
Project Management
Math Agents
2024
23 Sep 2024
Digital Transformation
Digital Transformation Society
99
 Digital Transformation
 Continues to accelerate
 All industries and sectors
 Much larger projects
 Terrestrial and beyond
 All sectors
 Public
 Corporate
 Scientific
 Start-ups
2020 2021 2023 2024
Source:
23 Sep 2024
Digital Transformation
Risks and Limitations
 Decarbonization: slow adoption
 Energy: AI energy demand
 The explosive growth of artificial intelligence comes with
soaring demand for electricity to power data centers
 As much as 5% per year in the next few years
 Utilities (developed world): no electricity demand growth for
more than a decade
 Shuttering coal-powered plants to meet decarbonization goals
 Meeting data center demand poses a quandary for utilities
and technology firm
 Expected to grow 10-30% over the next five years
 Social reaction to technology: overwhelm, alienation
 Mechanistic aspect is unpalatable, detracts from qualitative
100
Source: https://www.bain.com/insights/how-to-feed-ais-hunger-for-power/
23 Sep 2024
Digital Transformation
Project Management is Complicated
101
23 Sep 2024
Digital Transformation
Many Opportunities for the Future
102
Institute for Molecular
Medicine Finland
23 Sep 2024
Digital Transformation
Thesis
103
Humanity is undertaking a new wave of projects which are unprecedented in
size, scale, scope, and values-based outcomes
These projects, among other aspects, entail orders of magnitude more lines
of software code which must be written, integrated, tested, and analyzed
Innovation in project management is required, notably via AI agents, digital
twins, blockchain data security, and quantum processing
Vaasa Finland, 23 Sep 2024
Slides: http://slideshare.net/LaBlogga
Melanie Swan, PhD, MBA
DIYgenomics.org (Research Lead)
University College London (Research Associate)
“Do not undertake a project unless it is manifestly
important and nearly impossible”
– Edwin Land, Co-Founder, Polaroid Camera
Digital Transformation
AI Project Management Agents
Thank you~!
Questions?
23 Sep 2024
Digital Transformation
Abstract
105
Digital Transformation and AI Project Management
This lecture describes the foundations of project planning and scheduling
including waterfall vs. agile methods and tools such as Gantt charts (information
visualization), the Work Breakdown Structure, the Critical Path Method, and
Scrum (short sprints by cross-functional teams). Project management case studies
(Merck and the French Military) are presented to highlight decision processes in
real-life settings. Innovative project management skills will be crucial to realizing
the next generation of large-scale digital transformation projects in the
contemporary smart network stack of web3 blockchains, AI, and quantum. The AI
Project Management Agent joins humans as a symbiotic and complementary
team-member. Enterprise AI means not only LLM-chat enabled content
generation, but a rich AI backbone of integrated systems within and across
organizations for the dynamic genesis of new systems and apps on demand.
23 Sep 2024
Digital Transformation
Appendix: AI PM Tools IRL
 Trello boards with AI integration
 Claude Artifacts: draft me an app, slides
106
23 Sep 2024
Digital Transformation 107
Lightweight Web-based Project Management
Trello Integrated AI
Source: https://www.youtube.com/watch?v=bmEeIbzPNQo
23 Sep 2024
Digital Transformation 108

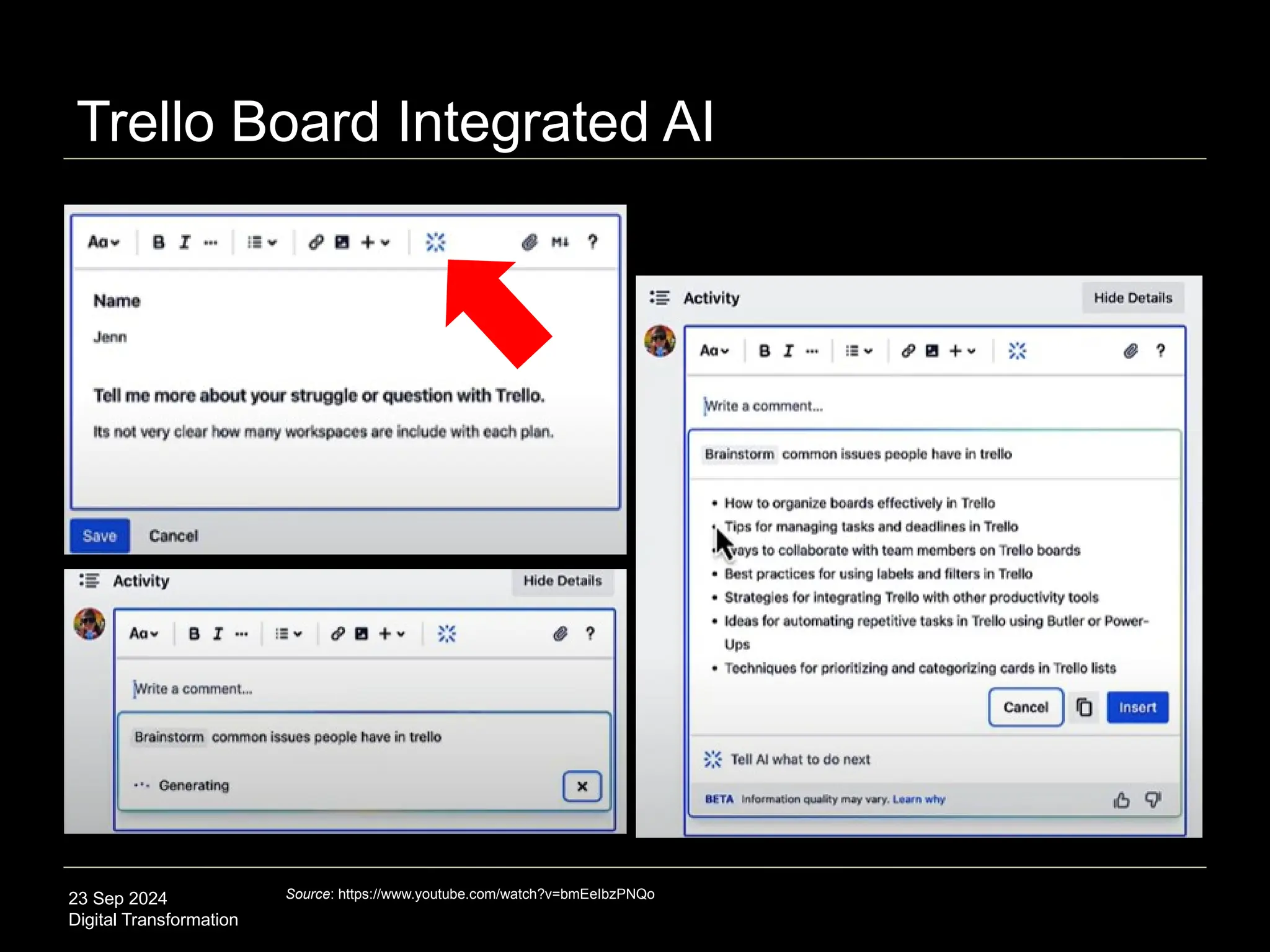

Trello Board Integrated AI
Source: https://www.youtube.com/watch?v=bmEeIbzPNQo
 text
Math Agents
23 Sep 2024
Digital Transformation 109

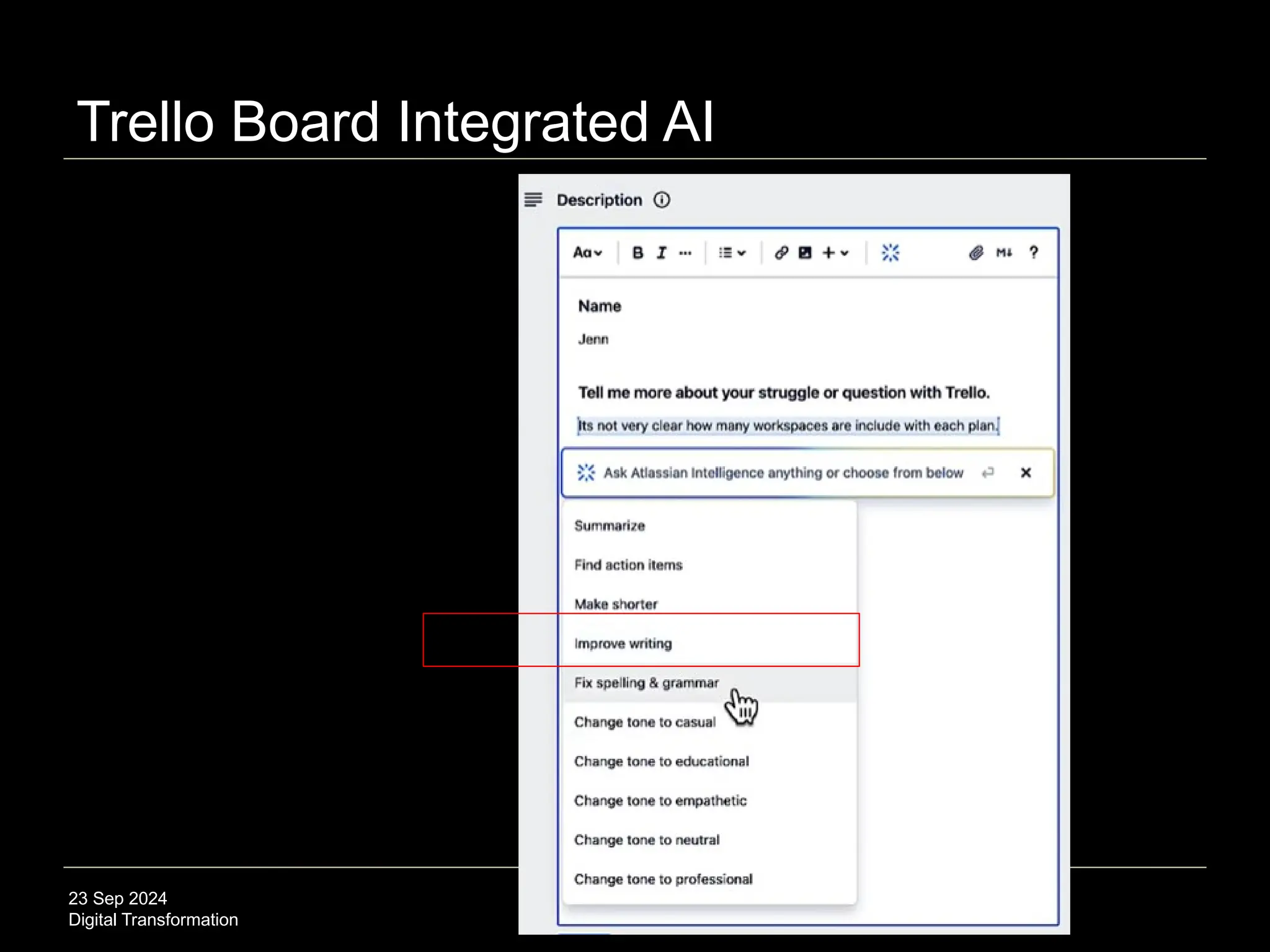

Trello Board Integrated AI
 text
Math Agents
23 Sep 2024
Digital Transformation 110
Claude Artifacts (Programs, Apps, Files)
Source: https://www.youtube.com/watch?v=GegAvpiWd_Q
 text
23 Sep 2024
Digital Transformation 111
Project Management Slides
Source: https://www.youtube.com/watch?v=GegAvpiWd_Q
Toggle between modes:
Preview and Code, copy-paste-
save
23 Sep 2024
Digital Transformation 112
Slides and Code
Source: https://www.youtube.com/watch?v=vUdNaAAc4FY
UX: Preview Mode
Code Mode
23 Sep 2024
Digital Transformation 113

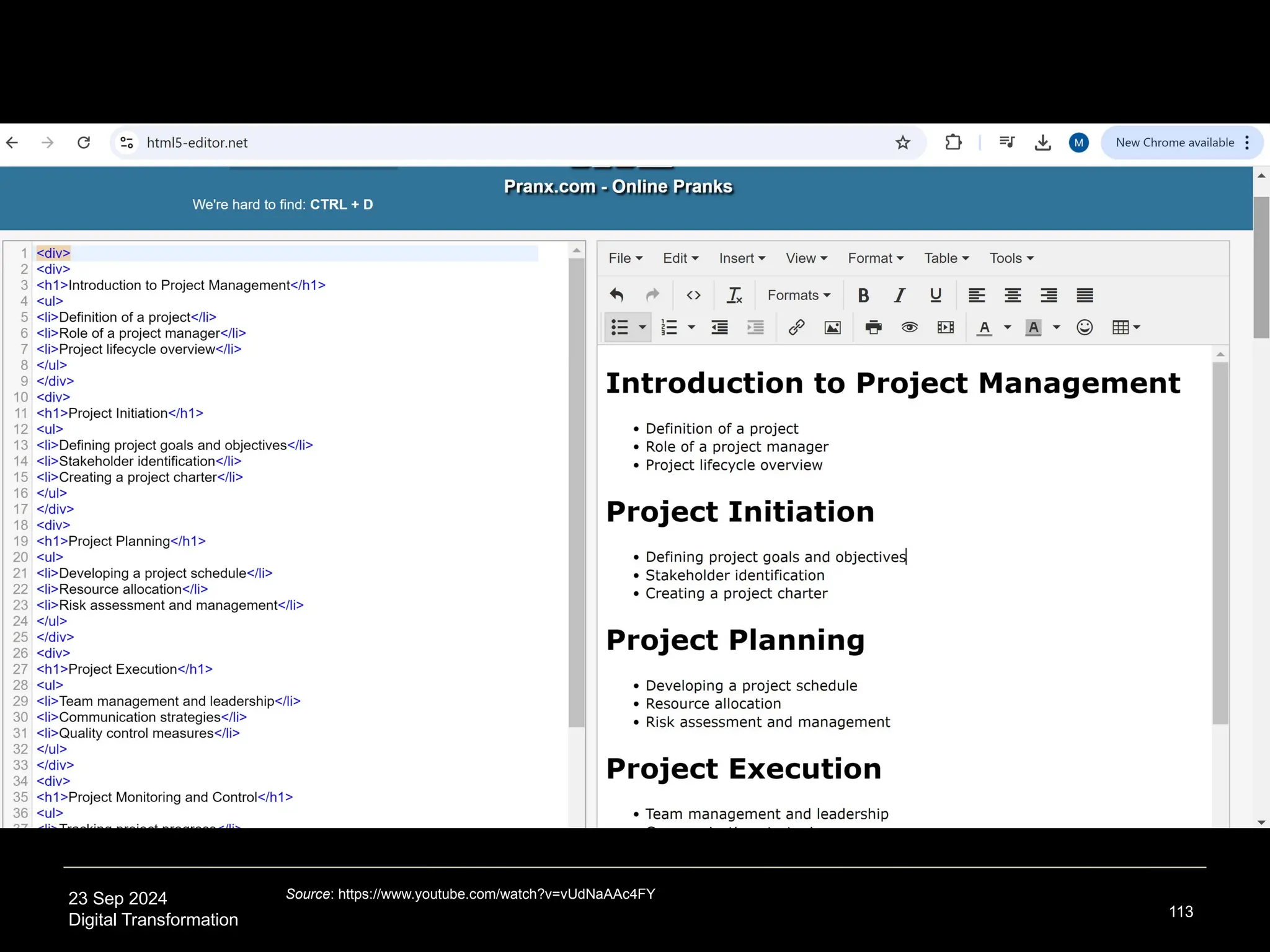

Source: https://www.youtube.com/watch?v=vUdNaAAc4FY
23 Sep 2024
Digital Transformation 114
Draft a Website that …
Source: https://www.youtube.com/watch?v=GegAvpiWd_Q
23 Sep 2024
Digital Transformation 115
Immediate On-screen Rendering
Source: https://www.youtube.com/watch?v=GegAvpiWd_Q
23 Sep 2024
Digital Transformation 116
Usual Prompt Engineering, Write me a …
Source: https://www.youtube.com/watch?v=GegAvpiWd_Q
 text
23 Sep 2024
Digital Transformation
Auto-renders Html Code and UX
117
Source: https://www.youtube.com/watch?v=GegAvpiWd_Q
23 Sep 2024
Digital Transformation
Example Claude Artifacts: Apps with Code
118
Source: https://www.youtube.com/watch?v=GegAvpiWd_Q

Digital Transformation - AI Agents Interface Layer in the Computational Infrastructure

  • 1.
    Vaasa Finland, 23Sep 2024 Slides: http://slideshare.net/LaBlogga Melanie Swan, PhD, MBA DIYgenomics.org (Research Lead) University College London (Research Associate) “Do not undertake a project unless it is manifestly important and nearly impossible” – Edwin Land, Co-Founder, Polaroid Camera Digital Transformation AI Project Management Agents
  • 2.
    23 Sep 2024 DigitalTransformation 2 Research Agenda 2015 2019 2020 Blockchain Blockchain Economics Quantum Computing Quantum Computing for the Brain 2022 Aim: Build long-term futures for humanity through smart network technologies and science frontiers Math Agents 2023 Health Agents 2024 “The App will see you now~!” Blockchain 1.0: Currency Blockchain 2.0: Contracts Blockchain 3.0: Beyond Smart Network Field Theory
  • 3.
    23 Sep 2024 DigitalTransformation Agenda  Digital Transformation  Project Management  Methods  Waterfall vs Agile (and Scrum)  Planning and Scheduling Tools  Information Design & Gantt Chart  Work Breakdown Structure  Critical Path Method  Case Studies  AI Project Management  Advanced Topics  Digital Twins, Web3-AI-Quantum 3 Cloud Software Hardware Project Management Math Agents 2024
  • 4.
    23 Sep 2024 DigitalTransformation AI Business Model  Create not just content but form  Agents  Chatbot, customer/employee  Math, health, PM agents  Content  Text, images, video, slides, sales proposal, analysis, code  Form  Apps with new functionality  Internal systems integration  Public-private data integration 4 2017 Life 1.0: cannot modify software or hardware Life 3.0: modify software & hardware Life 2.0 (human): modify software PM: Project Management Math Agents Health Agents “The App will see you now~!” Project Management Agents
  • 5.
    23 Sep 2024 DigitalTransformation The New Statistics 5 Source: Web3 Blockchains. https://www.slideshare.net/slideshow/web3-blockchains-physics-of-prosperity/271065583 Static Legacy Data Analysis AI Data Analysis Content Form Dynamic Content Form Synthetic Data Generation Synthetic On-demand Program/App Generation Prompt Engineering: >>Make slides, video, image, text that [conditions] >>Generate data that meets these [conditions] [high-risk genomic profiles for Alzheimer’s disease] >>Draft code for a program to analyze project data, timelines, and budget >>Draft an app for [generative video, blocks game, Rubik’s cube] Form Content  Statistics -> Insights
  • 6.
    23 Sep 2024 DigitalTransformation Thesis 6 Humanity is undertaking a new wave of projects unprecedented in size, scale, scope, and values-based outcomes These projects, among other aspects, entail orders of magnitude more lines of software code which must be integrated, connected, tested, and analyzed Innovation in project management is required, notably via AI agents, digital twins, blockchain data security, and quantum processing
  • 7.
    23 Sep 2024 DigitalTransformation Agenda  Digital Transformation  Project Management  Methods  Waterfall vs Agile (and Scrum)  Planning and Scheduling Tools  Information Design & Gantt Chart  Work Breakdown Structure  Critical Path Method  Case Studies  AI Project Management  Advanced Topics  Digital Twins, Web3-AI-Quantum 7 Cloud Software Hardware Project Management Math Agents 2024
  • 8.
    23 Sep 2024 DigitalTransformation Planetary-scale Problem Solving Society 8  The world is bigger  AI Knowledge Society  Large-scale problems  Advance in project management Domain Space Health and Biology Energy Identity Space-faring civilization Health-faring civilization Energy-marshalling civilization Vision Exploration, settlement, mining, exoplanets: solved Obesity, cancer, disease, aging, death: solved High-availability clean global energy: solved European Extremely Large Telescope, Chile European Extremely Large Telescope (E-ELT) under construction in Chile. Size comparison of the E-ELT (left) with the four 8-meter telescopes of the European Very Large Telescope (center) and the Colosseum in Rome (right). E-ELT: 39-meter diameter mirror, p. 985.
  • 9.
    23 Sep 2024 DigitalTransformation Global Network Society 9  Digital Infrastructure  Global comms networks  Optical networking provider Ciena sent 1.6 terabits of data over a 470 km link (Sep 2024)  Field trial on telecom operator Arelion’s live network Source: https://www.gazettabyte.com/home/2024/9/8/ciena-sends-a-16t-optical-lambda-over-a-470km-link.html Arelion (Stockholm SE): Tier 1 Network Provider connecting more than 58% of the global internet routing table on its IP backbone 1 terabit of data: 256 photographs shot on 12 MP camera; 250 movies or 500 hours of high-definition video; 6.5 million document pages (Office files, PDFs, presentations = 1,300 real file cabinets)
  • 10.
    23 Sep 2024 DigitalTransformation Computational Infrastructure  Increased complexity  Interlinked operations  Hardware, software, cloud  Thousands of processes  Millions of lines of code  Over the air updates 10 Source: Ebert, C. & Jones, C. (2009). Embedded Software: Facts, Figures, and Future. IEEE. Computer. 0018-9162/09. Embedded software size and deployment Complexity growth of embedded systems Cloud Software Hardware
  • 11.
    23 Sep 2024 DigitalTransformation Digital App Society  Particle-many systems  Millions->billions observer-actors & entities  Industries as information technologies  Measure big data with entropy, energy; operate with AI Quantum Supercomputers (JPL DSN space scheduling)  Ridesharing  Uber 2023: 149 mn customers, 7.1 mn drivers  ~20 customers/driver  Lodging  Airbnb 2023: 5 mn hosts, 448 mn nights  ~90 nights/host, ~=25% utilization  Tesla: 4.97 mn vehicles sold worldwide 11 Source: https://backlinko.com/tesla-stats 3D Physics Metrics -> Information Science James Webb Space Telescope
  • 12.
    23 Sep 2024 DigitalTransformation 12 Blockchain Smart Network Stack Quantum genAI DL NNs Blockchain: a digital database (ledger & event history) distributed among the nodes of a peer-to-peer network; database for resource allocation (cryptocurrency: 1 app) Web3: community of actors creating a new decentralized internet; expectation of targeted participation in values-aligned (aesthetic) efforts; a blockchain-based governance model runs the node network GenAI: generative artificial intelligence capable of producing text, images, videos, or other data using generative deep learning neural network models, often in response to prompts Quantum: application of quantum mechanics and quantum field theory to perform computation in chip-based circuits controlling atoms, ions, and photons with lasers and electromagnetic fields, harnessing the unique behavior of quantum physics such as superposition, entanglement, and interference  Convergence and integration
  • 13.
    23 Sep 2024 DigitalTransformation Data & AI-driven Society 13 Source: https://whatsthebigdata.com/data-generated-every-day/ https://www.techtarget.com/searchstorage/definition/Kilo-mega-giga-tera-peta-and-all-that Data Storage Measurements Real-world Data Storage Capacity  328.8 million terabytes of data created per day  181 zettabytes total data generation in 2025e  53.7% internet data traffic is video Year Day
  • 14.
    23 Sep 2024 DigitalTransformation Blockchain Project Management  Integrating blockchain and PM  Project planning, execution, monitoring  Transparency, security, efficiency  Decentralized structure  Data security and integrity  Transparent stakeholder interactions  Traceable audit log  Risk mitigation (fraud, error, loss)  Complex multi-party automation  Financial payments sector  Open banking, embedded finance, superapps, sustainability 14 Source: https://stevenscenter.wharton.upenn.edu/accelerator/, https://www.visauniversity.com/en/certificate-programs/digital- payments-catalyst, https://www.pwc.ch/en/insights/risk/ai-will-transform-project-management-are-you-ready.html
  • 15.
    23 Sep 2024 DigitalTransformation internet transfer protocols. 15 information. email. voice. video. money. BCI, pacemaker. High Sensitivity Low Sensitivity Medium Sensitivity Each traffic type has its own instructions or protocol (webpages with http; email with smtp; voice with voip; blockchain for digital asset transfer); file header indicates traffic type, software version, routing, etc. Digital Network Society transfer of different kinds of online content each with a specific protocol Challenge: secure verifiable transfer of valuable and unique files (web3 quantum implicated) Source: Ebert, C. & Jones, C. (2009). Embedded Software: Facts, Figures, and Future. IEEE. Computer. 0018-9162/09.
  • 16.
    23 Sep 2024 DigitalTransformation Quantum Project Management 16  Quantum implications for project management  Quantum compute  Complex project planning and optimization  Greater efficiency, higher workload  Projects involving quantum-related technologies  Leading quantum adoption industries:  Chemical and biological engineering, AI, cybersecurity, financial services, complex manufacturing, logistics Source: https://projectmanagernews.com/news/quantum-computing-project-management/, https://www.mckinsey.com/capabilities/mckinsey-digital/our-insights/quantum-computing-use-cases-are-getting-real-what-you-need- to-know Cleveland Clinic Lobby McKinsey Study, 2021
  • 17.
    23 Sep 2024 DigitalTransformation 17  Opt-in sequencing goal: 500,000 (10% population)  Personalized medicine: treat individual with condition Population-scale Health Source: Ralph & Coop. (2015) Convergent evolution during local adaptation to patchy 509 landscapes. PLOS Genet. 11, e1005630; https://www.finngen.fi/en
  • 18.
    23 Sep 2024 DigitalTransformation Neural Embedding Space 18 Source: Levin, M. (2024). Self-Improvising Memory. Entropy. 26, 481; Goldstein, A. et al. (2024). Alignment of brain embeddings and artificial contextual embeddings in natural language points to common geometric patterns. Nat Commun 15:2768. https://doi.org/10.1038/s41467-024-46631-y  Contextual embeddings provide a continuous vectorial representation of language  Brain embedding space  Vector-based neural code for natural language processing (vs psycholinguistics models) 2023
  • 19.
    23 Sep 2024 DigitalTransformation Large-scale Projects Energy: Tokamak Construction  500 megawatts of fusion power  Initial: end 2025  Full operation: 2035  Magnetic field device confines the hot plasma of nuclei  Deuterium atoms heated to 1 mn degrees in hot plasma of nuclei 19 Source: https://www.iaea.org/newscenter/news/tokamaks-stellarators-laser-based-and-alternative-concepts-report-offers-global- perspective-on-nuclear-fusion-device, https://www.youtube.com/watch?v=kuq1HU2gYEk Saint-Paul-lez-Durance France (near Marseilles)
  • 20.
    23 Sep 2024 DigitalTransformation Digital Twins 20 Digital Twin: virtual representation of physical system or entity Bioavatar: digital representation of physical self, including real- time biometric data update for longevity precision medicine Source: https://esrisingapore.com.sg/digital-twins, https://infra.global/singapores-digital-twin-from-science-fiction-to-hi-tech-reality/, https://www.forbes.com/sites/forbestechcouncil/2023/08/18/bio-digital-twin-getting-the-heart-right/, Amofa et al. (2024). Blockchain- secure patient Digital Twin in healthcare using smart contracts. PLoS One. 19(2): e0286120.  Singapore: first nation with a digital twin (2023)  Health and longevity: digital twins of  healthcare facilities, patients, bodies & organs, drugs
  • 21.
    23 Sep 2024 DigitalTransformation Digital Twins 21 Source: https://www.3ds.com/sites/default/files/2021-01/dassault-systemes-and-accenture-virtual-twin-and-sustainability.pdf Circular Economy: economic model of resource production and consumption that involves sharing, leasing, reusing, repairing, refurbishing, recycling, life-cycle management, and sustainability
  • 22.
    23 Sep 2024 DigitalTransformation Agenda  Digital Transformation  Project Management  Methods  Waterfall vs Agile (and Scrum)  Planning and Scheduling Tools  Information Design & Gantt Chart  Work Breakdown Structure  Critical Path Method  Case Studies  AI Project Management  Advanced Topics  Digital Twins, Web3-AI-Quantum 22 Cloud Software Hardware Project Management Math Agents 2024
  • 23.
    23 Sep 2024 DigitalTransformation Case Study: LUMI Data Center, Kajaani FI 23  Project: AI Supercomputer center serving EC  35-40% enterprise workloads are fully cloud instantiated  Requirements: sustainable data center ecosystem Source: https://www.lumi-supercomputer.eu/lumi-consortium/, https://www.youtube.com/watch?v=gZrw58_Cu4g
  • 24.
    23 Sep 2024 DigitalTransformation 24 Source: https://csc.fi/en/our-expertise/data-center-ecosystem/ Case Study: LUMI Data Center  GOAL: sustainable data center ecosystem  SOLUTION:  Novel architectural design using 100% hydropower  RESULT:  Waste heat accounts for up to 20% of annual district heating needs for local partner city Kajaani FI  ~12,400 tons of CO2 reduced annually
  • 25.
    23 Sep 2024 DigitalTransformation 25 Source: https://www.lumi-supercomputer.eu/lumi-consortium/, https://www.youtube.com/watch?v=gZrw58_Cu4g Case Study: LUMI Data Center, Kajaani FI
  • 26.
    23 Sep 2024 DigitalTransformation 26 Source: https://www.youtube.com/watch?v=HB9JUH0mPqI Logging into an AI Supercomputer  Remote login access credentials: Login Nodes  Work processing/simulation: Compute Nodes
  • 27.
    23 Sep 2024 DigitalTransformation LUMI access to VTT Quantum Computer 27 Source: https://www.computerweekly.com/feature/Finland-shows-off-its-new-20-qubit-quantum-computer, https://www.lumi- supercomputer.eu/finlands-first-quantum-computer-opened-for-companies/ Quantum and high-performance computing are complementary technologies  20-qubit quantum computer
  • 28.
    23 Sep 2024 DigitalTransformation QMill raises €4m (Sep 2024) 28 Source: https://www.insidequantumtechnology.com/news-archive/quantum-news-briefs-september-17-qmill-raises-e4m-in-seed- funding-to-deliver-near-term-industrial-quantum-advantage-via-cutting-edge-algorithms-bluefors-opens-expanded-u-s-production/  Optimization algorithms  Too large for supercomputers  Exponentially difficult  Customer segments  Finance, telecommunications, real estate, energy, supply chain, logistics  Executed on NISQ  Funders  Finland-based Maki.vc  Singapore-based VC Antler Quantum algorithms: programs run as quantum circuits in a quantum computer Noisy Intermediate-Scale Quantum (NISQ): available quantum devices operating with 10-100 qubits subject to noise and error
  • 29.
    23 Sep 2024 DigitalTransformation Quantum Plugs into Cloud/Compute Stack 29 Source: https://developer.nvidia.com/cuda-q  CPU -> GPU -> TPU -> QPU  GPU (graphics processing unit)  3D graphics card: matrix multiplication  TPU (tensor processing unit)  Flow through matrix multiplications: no storing interim values in memory  QPU (quantum processing unit)  Quadratic & Polynomial speed-up with superposition, entanglement, interference Example: NVIDIA CUDA-Quantum (Compute Unified Device Architecture): parallel computing platform and application programming interface CUDA- Quantum
  • 30.
    23 Sep 2024 DigitalTransformation JPMorgan Chase Global Technology Applied Research 30  Quantum AI Algorithms, Blockchains, Cryptography  Markets: derivative pricing, risk analysis, portfolio optimization  Secure data transfer: quantum key distribution, blockchains Source: https://arxiv.org/search/quant-ph?searchtype=author&query=Pistoia,+Marco Smart Network Technology Stack: Blockchain genAI Quantum Is it a bank? World’s largest bank is a full-stack FinTech smart network technology company Smart contract automation
  • 31.
    23 Sep 2024 DigitalTransformation Moore’s Law 31 Source: Kurzweil, https://www.youtube.com/watch?v=xh2v5oC5Lx4  The number of transistors on a chip doubles every 2 years 2005 When Humans Transcend Biology 2024 When we merge with AI ?? The Singularity [is Here]
  • 32.
    23 Sep 2024 DigitalTransformation Doublings: Moore’s Law: 24, Proteins: 158  Nature: high rate of doubling compared to technology  Moore’s law: number of transistors on a single chip doubles every two years at minimal costs (24 total doublings)  June 2023: 134 billion transistors (Apple ARM-based dual-die M2 Ultra SoC fabricated using TSMC’s 5 nm process) 32 24 Source: CU 3-09-22 Physics Colloquium - Sadasivan Shankar, SLAC Stanford/Harvard.
  • 33.
    23 Sep 2024 DigitalTransformation Biology: Complex, Unknown Ruleset 33 Pathway Genome Protein Natural Language LLMs: LLaMa 65 billion parameters Protein Language Models: xTrimoPGLM: 100 billion parameters Genome Language Models Parameter: learnable weights between graph nodes (entities) Source: https://www.biomap.com/sota/ DeepSeekMath 7 billion parameters Mathematical Reasoning Agents
  • 34.
    23 Sep 2024 DigitalTransformation Quantum needed to “solve” Biology  Complex domain of biology requires compute capability of quantum AI  Quantum-enhanced generative AI models accelerate discovery of new molecules as viable cancer drug candidates  RESULT: Discovered a new compound to inhibit KRAS active in the RAS/MAPK pathway  Platform: Insilico’s genAI engine Chemistry42 34 Source: https://aibusiness.com/verticals/quantum-enhanced-generative-ai-creates-viable-cancer-drug-candidates, https://www.scientific-computing.com/article/quantum-enhanced-generative-ai-generates-viable-cancer-drug-candidates
  • 35.
    23 Sep 2024 DigitalTransformation Quantum AI Convergence Greener LLMs: 1-Bit LLM & 1.58 Bit LLM  Quantization of LLMs  From scalar network weights to binary (1-bit) or ternary (-1-0-1)  Interpretation: over or under weight  LLMs without matrix multiplication  Ternary function replaces attention in transformer NNs  BitNet (2023), MatMut (2024) 35 Sources: Wang et al. (2023). BitNet: Scaling 1-bit Transformers for Large Language Models. arXiv:2310.11453v1, Zhu et al. (2024). Scalable MatMul-free Language Modeling. arXiv:2406.02528v5.
  • 36.
    23 Sep 2024 DigitalTransformation Quantum AI Convergence Hyperbolic Data Compression 36 Source: Taback, J. (2008). On the Geometry of Cayley Automatic Groups. arXiv:2008.02381v4 https://www.youtube.com/watch?v=WBY9EQJTew4 Phylogenetic tree: close in Euclidean distance, far in evolutionary distance ML representation in hyperbolic space: distant in hyperbolic space and genetic distance
  • 37.
    23 Sep 2024 DigitalTransformation Agenda  Digital Transformation  Project Management  Methods  Waterfall vs Agile (and Scrum)  Planning and Scheduling Tools  Information Design & Gantt Chart  Work Breakdown Structure  Critical Path Method  Case Studies  AI Project Management  Advanced Topics  Digital Twins, Web3-AI-Quantum 37 Cloud Software Hardware Project Management Math Agents 2024
  • 38.
    23 Sep 2024 DigitalTransformation Project Management  Project: temporary endeavor (vs ongoing operations)  Produce a product, service, result, change, value-add  Defined beginning and end, resource constraints 38 Source: https://www.opb.org/article/2022/07/17/james-webb-telescope-had-344-single-point-failures-before-launch-then-success https://science.nasa.gov/people/webb-people-bill-ochs/ Project Management: the process of coordinating a team effort to achieve a project goal within constraints (scope, time, budget) Project: temporary endeavor to produce a result James Webb Space Telescope Project Manager Bill Ochs (11+ years): 20,000 people, ~two decades, 344 single point failures (risk to whole mission), launch Dec 2021, first light Jul 2022, 155 motors to align mirrors: 100% survival; fuel for 20 years
  • 39.
    23 Sep 2024 DigitalTransformation History of Project Management  Systematic approaches to complex projects (1950s)  Construction, civil engineering, defense, aircraft  Shift from contractor-managed projects to professionally trained project management teams (PM Officer) (1970s) 39 Haussmann Renovation of Paris (Pissarro, 1898) Guiana Space Center: Europe’s Spaceport (2024)
  • 40.
    23 Sep 2024 DigitalTransformation Project Management Methods and Tools 40 Source: https://www.linkedin.com/pulse/charting-future-automation-your-roadmap-join-journey-peter-shafe-qf8kf/ Project Management Methods: Waterfall Agile Scheduling Tools: Work Breakdown Structure, Gantt Chart, Critical Path Method, Scrum Smart Network Technologies: Blockchain genAI Quantum Material Requirements Planning (MRP): Lean Manufacturing Continuous Improvement Kanban and Just-in-Time (JIT) Inventories Shop Floor Automation
  • 41.
    23 Sep 2024 DigitalTransformation Agenda  Digital Transformation  Project Management  Methods  Waterfall vs Agile (and Scrum)  Planning and Scheduling Tools  Information Design & Gantt Chart  Work Breakdown Structure  Critical Path Method  Case Studies  AI Project Management  Advanced Topics  Digital Twins, Web3-AI-Quantum 41 Cloud Software Hardware Project Management Math Agents 2024
  • 42.
    23 Sep 2024 DigitalTransformation CEO: There’s an App for that~!  Real-time corporate dashboard apps  Case study: CEO of a large telecom provider  Status  Use app to check on organization’s seven strategic initiatives  Few-tap review of project status and percent complete  Key performance indicators  Team member morale and stakeholder buy-in metrics  On-demand drill-down to project charters, supporting documents  Decision-making  App informs re: changes needing attention  Prioritizes decisions and potential solutions  On-demand risk assessment 42 Source: https://www.pmotto.ai/blog/how-ai-will-transform-project-management/
  • 43.
    23 Sep 2024 DigitalTransformation Real-time Dashboards 43 Source: https://www.juiceanalytics.com/writing/8-features-successful-real-time-dashboards  What is new?  Standard feature of all digitization platforms  Organization-level roll-up French Government: All projects at-a-glance Juice Analytics Real-time Dashboard Real-time Dashboards: extending to all industries not just financial markets Secondary School Reform Percent complete transformation plan Modernization of Labor
  • 44.
    23 Sep 2024 DigitalTransformation AI Project Management Phases 44 Source: https://www.pwc.ch/en/insights/risk/ai-will-transform-project-management-are-you-ready.html
  • 45.
    23 Sep 2024 DigitalTransformation 45 Source: https://news.microsoft.com/m365-copilot-Sept-2024/  Mathematical reasoning benchmarks: GSM8k, MATH Math Agents Copilot Agents • Copilot as one UI for AI • Agent-based canvas with integrated public-private data • Web + Work + Pages (public + private + digital artifact/agent canvas)
  • 46.
    23 Sep 2024 DigitalTransformation AI PM Agents 46 Source: https://www.pmotto.ai/, https://www.youtube.com/watch?v=akYU7KBR2Nc
  • 47.
    23 Sep 2024 DigitalTransformation Science Agent 47 Source: CORE-Bench Agents. https://arxiv.org/pdf/2409.11363v1  Agent-based computational replicability Higher replicability error rates in Sociology v Machine Learning
  • 48.
    23 Sep 2024 DigitalTransformation Complementary Human-AI PM Agent Teams  Role of AI Project Management Agents  Repetitive and routine tasks  Data analysis and prediction  Early alerts re: missing schedule  Risk management  Summaries and continuous learning  Communication and collaboration  Role of Project Manager  Coach and support the team  Maintain regular conversations  Scope review with key stakeholders  Cultivate a high-performing culture 48 Source: https://thinkingportfolio.com/language/en/the-ai-revolution-when-will-it-replace-traditional-project-managers/ Project Management Math Agents 2024
  • 49.
    23 Sep 2024 DigitalTransformation Agenda  Digital Transformation  Project Management  Methods  Waterfall vs Agile (and Scrum)  Planning and Scheduling Tools  Information Design & Gantt Chart  Work Breakdown Structure  Critical Path Method  Case Studies  AI Project Management  Advanced Topics  Digital Twins, Web3-AI-Quantum 49 Cloud Software Hardware Project Management Math Agents 2024
  • 50.
    23 Sep 2024 DigitalTransformation Project Management Methods 50 Agile Waterfall Source: https://www.forbes.com/advisor/business/agile-vs-waterfall-methodology/ Sequential order Iterative looping Waterfall is a rigid form of project management methodology with sequential linear processes Agile is a flexible form of project management methodology with iterative changeable processes  Linear: steps must proceed in order  Outcomes: fixed at outset  Phases: fixed progression to next stage  Work: Project-manager driven (centralized)  Environment: high predictability  Deliverable: one big outcome at end  Industries: manufacturing, construction  Nonlinear: steps can proceed simultaneously  Outcomes: dynamic and possibly shifting  Phases: can work on multiple phases together  Work: Team-driven (decentralized), sprints  Environment: high dynamism and unpredictability  Deliverable: many smaller ongoing releases  Industries: software, services Sprint 2 Sprint 1 Many releases per day, can rollback if any issue
  • 51.
    23 Sep 2024 DigitalTransformation 51 Waterfall Method
  • 52.
    23 Sep 2024 DigitalTransformation 52 Source: https://agilemanifesto.org/ Agile Manifesto (2001)  Distill agile principles for software development  Restore credibility  Software projects non- dependable: bloat, delay, overbudget  Support teams, reconnect with outcomes
  • 53.
    23 Sep 2024 DigitalTransformation 53 Source: https://agilemanifesto.org/ Agile Principles
  • 54.
    23 Sep 2024 DigitalTransformation 54 Source: https://agilemanifesto.org/ Agile Principles: People over Processes
  • 55.
    23 Sep 2024 DigitalTransformation Scrum  Moving the scrum (tightly-knit cross-functional team) downfield towards a goal  HBR: The New New Product Development Game (1986)  Successful new product launch:  Fuji-Xerox, Canon, Honda, NEC, Epson, Brother, 3M, Xerox, Hewlett-Packard  Scrum Sprints – time-boxed  Scrum Master – coach, x-blocks  Daily Scrum – standup meetings 55 Source: Takeuchi & Nonaka. (1986). The New New Product Development Game. Harvard Business Rreview. https://hbr.org/1986/01/the-new-new-product-development-game Scrum: agile team collaboration framework; rugby-inspired approach to move a tightly-knit cross-functional team to a goal
  • 56.
    23 Sep 2024 DigitalTransformation 56 Daily Standup Scrum Meeting Source: https://agilescrumgroup.nl/daily-scrum/ Agile & Scrum: 2-week Sprints  Agile (flexible iterative) is always Scrum (sprints), scrum is not always Agile  Energy v inertia  Focused bursts 1. Plan 2. Design 3. Develop 4. Test 5. Deploy 6. Review 7. Launch
  • 57.
    23 Sep 2024 DigitalTransformation Agile Mindset  “Silicon Valley mindset” : iterative and incremental  High velocity flow, lean agile principle  Short stand-up meetings  What worked well this week?  What didn't work well this week?  What are we working on next week? 57 Agile Mindset: customer-driven work break big projects into small chunks, release early and often, continuous feedback in dynamic environments of change; energy contra inertia Source: https://www.youtube.com/watch?v=ljKX2-sgcOg; Bruce Feiler: Agile programming https://www.ted.com/talks/bruce_feiler_agile_programming_for_your_family?subtitle=en A350, A330 Bruce Feiler: Agile Programming
  • 58.
    23 Sep 2024 DigitalTransformation Case Study: EV  AIM: EV infrastructure for major EC auto manufacturer 58  PROBLEM:  Hardware and software teams on different design and release schedules Source: Rush, David. (2018). Accenture. Using agile processes and digital twin technology: Digital Twin Summit. https://www.youtube.com/watch?v=ETTlTq88oHU
  • 59.
    23 Sep 2024 DigitalTransformation  SOLUTION: implement digital twin platform for greater synchronization between software and hardware teams  Digital twin absorbs and shortens hardware cycles  Engineering increasingly moved into software  RESULT: software-hardware collaborating in 2-wk cycles 59 Source: Rush, David. (2018). Accenture. Using agile processes and digital twin technology: Digital Twin Summit. https://www.youtube.com/watch?v=ETTlTq88oHU Digital Twin: HW-SW Interface Layer
  • 60.
    23 Sep 2024 DigitalTransformation Case Study: Digital Twin AutoScrum 60 Source: Rush, David. (2018). Accenture. Using agile processes and digital twin technology: Digital Twin Summit. https://www.youtube.com/watch?v=ETTlTq88oHU
  • 61.
    23 Sep 2024 DigitalTransformation Agenda  Digital Transformation  Project Management  Methods  Waterfall vs Agile (and Scrum)  Planning and Scheduling Tools  Information Design & Gantt Chart  Work Breakdown Structure  Critical Path Method  Case Studies  AI Project Management  Advanced Topics  Digital Twins, Web3-AI-Quantum 61 Cloud Software Hardware Project Management Math Agents 2024
  • 62.
    23 Sep 2024 DigitalTransformation Information Design (Tufte) 62 Source: https://www.edwardtufte.com/ 1997
  • 63.
    23 Sep 2024 DigitalTransformation Data Visualization 63 Source: https://www.edwardtufte.com/bboard/q-and-a-fetch-msg?msg_id=000076 Energy
  • 64.
    23 Sep 2024 DigitalTransformation Infographics 64 Source: https://www.edwardtufte.com/bboard/q-and-a-fetch-msg?msg_id=000076
  • 65.
    23 Sep 2024 DigitalTransformation Gantt Chart  Sequential task management  Left side: task list by area  Right side: timeline with shaded bars to visualize completion 65 Source: https://www.atlassian.com/agile/project-management/gantt-chart Gantt Chart: project management tool for tracking tasks and their planned and realized execution time
  • 66.
    23 Sep 2024 DigitalTransformation 66 Gantt Chart
  • 67.
    23 Sep 2024 DigitalTransformation Agenda  Digital Transformation  Project Management  Methods  Waterfall vs Agile (and Scrum)  Planning and Scheduling Tools  Information Design & Gantt Chart  Work Breakdown Structure  Critical Path Method  Case Studies  AI Project Management  Advanced Topics  Digital Twins, Web3-AI-Quantum 67 Cloud Software Hardware Project Management Math Agents 2024
  • 68.
    23 Sep 2024 DigitalTransformation Work Breakdown Structure  Aim: How can I make this project more manageable?  Every project is different, every project manager is different, every WBS is different  How to make a Work Breakdown Structure 68 Source: https://www.workbreakdownstructure.com/ Work Breakdown Structure: a deliverable- oriented hierarchical decomposition of the work to be executed in key steps
  • 69.
    23 Sep 2024 DigitalTransformation Work Breakdown Structure  What structure makes this project more manageable? 69 Source: https://www.workbreakdownstructure.com/
  • 70.
    23 Sep 2024 DigitalTransformation Case Study: Work Breakdown Structure  Bite-size roadmap  Phases, deliverables, milestones, budget, completion 70 Source: https://www.workbreakdownstructure.com/
  • 71.
    23 Sep 2024 DigitalTransformation Case Study: Work Breakdown Structure 71 Source: https://www.workbreakdownstructure.com/
  • 72.
    23 Sep 2024 DigitalTransformation Case Study: Work Breakdown Structure 72 Source: https://www.workbreakdownstructure.com/
  • 73.
    23 Sep 2024 DigitalTransformation Case Study: NASA Scheduling Upgrade 73  NASA’s Deep Space Network (DSN)  Managed by Jet Propulsion Laboratory (JPL) Pasadena CA USA  Support a wide range of missions  Communicate with interplanetary spacecraft for timely action-taking  Conduct radio and radar astronomy  Plant footprint  14 terrestrial antennas located at  3 complexes: US, Spain, Australia  Day-to-day operations  Manage 40+ space missions concurrently Suzanne Dodd, Interplanetary Network Director and Project Manager for the Voyager Interstellar Mission, NASA Source: https://azure.microsoft.com/en-us/blog/quantum/2022/01/27/nasas-jpl-uses-microsofts-azure-quantum-to-manage- communication-with-space-missions/
  • 74.
    23 Sep 2024 DigitalTransformation Project Requirements 74  Critical communications  Several hundred weekly scheduling requests when spacecrafts are antenna-visible  Increased network load  Contemporary missions require higher-fidelity data operations that significantly increase the load on the Deep Space Net  Mars 2020 Perseverance Rover  James Webb Space Telescope  Future-ready upgrade of aging network (60-yrs old) Source: https://www.jpl.nasa.gov/news/nasas-deep-space-network-turns-60-and-prepares-for-the-future/ Time Arbitrage: asynchronous communications to Drone-Rover team cuts 4-24 min Mars delay in half
  • 75.
    23 Sep 2024 DigitalTransformation Project  GOAL: Scheduling system with improved response  Identify problem as one of job-shop scheduling  Complex scheduling: common challenge in many industries  Manufacturing supply chains, health care, transportation, logistics  Document runtimes of two+ hours at the start of the project  SOLUTION: assign incoming jobs to resources immediately  Design a new schedule and workflow with Azure Quantum  Use quantum-inspired optimization methods  RESULT: scheduling time reduced from 2-hours to 16-min 75 Source: https://quantumzeitgeist.com/nasa-now-manages-its-space-missions-through-quantum-computing
  • 76.
    23 Sep 2024 DigitalTransformation NASA Deep Space Network 76 Source: https://eyes.nasa.gov/dsn/dsn.html 14 terrestrial antennas in 3 complexes US, Spain, Australia
  • 77.
    23 Sep 2024 DigitalTransformation Agenda  Digital Transformation  Project Management  Methods  Waterfall vs Agile (and Scrum)  Planning and Scheduling Tools  Information Design & Gantt Chart  Work Breakdown Structure  Critical Path Method  Case Studies  AI Project Management  Advanced Topics  Digital Twins, Web3-AI-Quantum 77 Cloud Software Hardware Project Management Math Agents 2024
  • 78.
    23 Sep 2024 DigitalTransformation Critical Path Method 78 Critical Path Method: network diagram-based project management tool to manage core and peripheral tasks and to identify the longest sequence of activities that must be finished on time to complete the project Source: https://www.linkedin.com/pulse/critical-path-method-project-management-amanda-athuraliya/  Project planning: how long will each segment take?  Establish the start date of sequential activities (those which cannot start until the one(s) preceding it have been completed)  Determine the latest date that the activity needs to be completed by for the next part to begin  Network diagram ties dependencies together at a glance  Without a diagram, easy for everyone to lose sight of their goals  Individuals see downstream effects of not sticking to the plan at hand
  • 79.
    23 Sep 2024 DigitalTransformation How to find the Critical Path 79 Source: https://www.linkedin.com/pulse/critical-path-method-project-management-amanda-athuraliya/  Work forwards or backwards with earliest and latest start dates for project phases 1. Create a table indicating the activity, preceding task, and time duration 2. Draw the network diagram based on the chart of activities and dependencies  Identify float, contingency
  • 80.
    23 Sep 2024 DigitalTransformation 80 Critical Path Method Example #1 Critical Path Method Example #2
  • 81.
    23 Sep 2024 DigitalTransformation Case Study: Critical Path Method (Creately) 81 Source: https://www.linkedin.com/pulse/critical-path-method-project-management-amanda-athuraliya/
  • 82.
    23 Sep 2024 DigitalTransformation Critical Path Method 82 Source: https://www.linkedin.com/pulse/critical-path-method-project-management-amanda-athuraliya/ Project: Design and Install Eco-Friendly Storage Tanks  Implication:  Graph-based format readily implementable in AI systems
  • 83.
    23 Sep 2024 DigitalTransformation Agenda  Digital Transformation  Project Management  Methods  Waterfall vs Agile (and Scrum)  Planning and Scheduling Tools  Information Design & Gantt Chart  Work Breakdown Structure  Critical Path Method  Case Studies  AI Project Management  Advanced Topics  Digital Twins, Web3-AI-Quantum 83 Cloud Software Hardware Project Management Math Agents 2024
  • 84.
    23 Sep 2024 DigitalTransformation Case Studies by Topic 84 Source: https://www.pmsolutions.com/case-studies
  • 85.
    23 Sep 2024 DigitalTransformation Merck: Innovation Center Darmstadt 85 Source: Resolving agency issues in client-contractor relationships: The Merck Innovation Center. https://www.pmi.org/-/media/pmi/documents/public/pdf/academics/call-for-proposal/merck-agency-theory-instructional-case.pdf? v=88ca6b10-9d26-4907-9cd9-ed37bc01d330  Construct Innovation Center in Darmstadt Germany for strategic meetings and communications for company’s 350-year anniversary (Merck founded 1668)  Construction Industry  One of biggest sectors in the economy, low productivity, fragmented, mismatch in risk allocation and rewards  Project: mitigate risk in client-contractor relationship  Goal conflict, information asymmetry, opportunistic behavior  High-risk can lead to project failures  Low labor productivity  Poor project management 1668 Pharmacist Friedrich Jacob Merck
  • 86.
    23 Sep 2024 DigitalTransformation Merck: Innovation Center Darmstadt 86 Source: Resolving agency issues in client-contractor relationships: The Merck Innovation Center. https://www.pmi.org/-/media/pmi/documents/public/pdf/academics/call-for-proposal/merck-agency-theory-instructional-case.pdf? v=88ca6b10-9d26-4907-9cd9-ed37bc01d330  Concrete & Steel Works project phases  Structural design  Procurement process  Execution  DECISION POINT: procurement method  Traditional procurement through competitive tendering  Sets up adversarial environment  Innovative forms of procurement such as open book contracts  Less familiar to industry and difficult for corporate governance to accommodate
  • 87.
    23 Sep 2024 DigitalTransformation Merck: Innovation Center Darmstadt 87 Source: Resolving agency issues in client-contractor relationships: The Merck Innovation Center. https://www.pmi.org/-/media/pmi/documents/public/pdf/academics/call-for-proposal/merck-agency-theory-instructional-case.pdf? v=88ca6b10-9d26-4907-9cd9-ed37bc01d330  PROJECT GOAL:  Invest all parties in shared outcome  INNOVATIVE RESOLUTION:  Build project knowledge and trust through ongoing workshops with all bidders during pre-contract phase (vs closed bid) Build up project knowledge on behalf of the bidders during the pre-contract phase to reduce information asymmetry
  • 88.
    23 Sep 2024 DigitalTransformation Merck: Innovation Center 88 Source: Resolving agency issues in client-contractor relationships: The Merck Innovation Center. https://www.pmi.org/-/media/pmi/documents/public/pdf/academics/call-for-proposal/merck-agency-theory-instructional-case.pdf? v=88ca6b10-9d26-4907-9cd9-ed37bc01d330  CHALLENGE: Additional requirements introduced by building authorities mid-bidding
  • 89.
    23 Sep 2024 DigitalTransformation Merck: Innovation Center Darmstadt 89 Source: Resolving agency issues in client-contractor relationships: The Merck Innovation Center. https://www.pmi.org/-/media/pmi/documents/public/pdf/academics/call-for-proposal/merck-agency-theory-instructional-case.pdf? v=88ca6b10-9d26-4907-9cd9-ed37bc01d330  Two final bidders
  • 90.
    23 Sep 2024 DigitalTransformation Merck: Innovation Center Darmstadt 90 Source: Resolving agency issues in client-contractor relationships: The Merck Innovation Center. https://www.pmi.org/-/media/pmi/documents/public/pdf/academics/call-for-proposal/merck-agency-theory-instructional-case.pdf? v=88ca6b10-9d26-4907-9cd9-ed37bc01d330  RESULT:  Foundation work started on time  Concrete and steel works completed in timely high-quality fashion  Construction motivated through incentives and actively engaged in resolving day-to-day problems on site to meet intermediate milestones
  • 91.
    23 Sep 2024 DigitalTransformation Agenda  Digital Transformation  Project Management  Methods  Waterfall vs Agile (and Scrum)  Planning and Scheduling Tools  Information Design & Gantt Chart  Work Breakdown Structure  Critical Path Method  Case Studies  AI Project Management  Advanced Topics  Digital Twins, Web3-AI-Quantum 91 Cloud Software Hardware Project Management Math Agents 2024
  • 92.
    23 Sep 2024 DigitalTransformation Service NOW AI Project Management Case Study French Ministry of Armed Forces 92 Source: https://www.youtube.com/watch?v=QA_-tM97crY  Aim: military operations maintaining territory and sovereignty  75,000 people, property, equipment  HR, finance, inventory procurement, QA  More than 3,000 IT systems  Goal: deliver superior service in a highly rapid and responsive manner
  • 93.
    23 Sep 2024 DigitalTransformation Service NOW AI Project Management Case Study Project Requirements 93 Source: https://www.youtube.com/watch?v=QA_-tM97crY  Diverse internal customer audiences  Accelerate time to deliver new apps  Cannot develop a new app for each request  Need streamlined platform for new apps  Ex: Track young person careers over time  Streamline legacy base of 3,000 IT systems Cloud Software Hardware
  • 94.
    23 Sep 2024 DigitalTransformation Service NOW AI Project Management Case Study Platform as a Service, Private Cloud 94 Source: https://www.youtube.com/watch?v=QA_-tM97crY  Select Service Now cloud, platform, and packages  Advanced Impact, Strategic Portfolio Management, App Portfolio Management, App Engine, Customer Svc Mgt  Tech stack: cloud, platform, workflow apps 1 2 3 Quantum
  • 95.
    23 Sep 2024 DigitalTransformation Service NOW AI Project Management Case Study Platform as a Service, Private Cloud 95 Source: https://www.youtube.com/watch?v=QA_-tM97crY  Tech stack: cloud, platform, workflow apps 1 2 3
  • 96.
    23 Sep 2024 DigitalTransformation Service NOW AI Project Management Case Study Platform as a Service, Private Cloud 96 Source: https://www.youtube.com/watch?v=QA_-tM97crY  Project manager AI-commanded code modification
  • 97.
    23 Sep 2024 DigitalTransformation France: Real-Time Government Initiatives  RESULT:  Government at-a-glance  Real-time dashboard  Defense/military services  All public-sector projects 97 Source: https://www.europe1.fr/politique/information-europe-1-lapplication-smartphone-secrete-de-lelysee-qui-fait-trembler-les- ministres-3919812?trk=article-ssr-frontend-pulse_little-text-block
  • 98.
    23 Sep 2024 DigitalTransformation Agenda  Digital Transformation  Project Management  Methods  Waterfall vs Agile (and Scrum)  Planning and Scheduling Tools  Information Design & Gantt Chart  Work Breakdown Structure  Critical Path Method  Case Studies  AI Project Management  Advanced Topics  Digital Twins, Web3-AI-Quantum 98 Cloud Software Hardware Project Management Math Agents 2024
  • 99.
    23 Sep 2024 DigitalTransformation Digital Transformation Society 99  Digital Transformation  Continues to accelerate  All industries and sectors  Much larger projects  Terrestrial and beyond  All sectors  Public  Corporate  Scientific  Start-ups 2020 2021 2023 2024 Source:
  • 100.
    23 Sep 2024 DigitalTransformation Risks and Limitations  Decarbonization: slow adoption  Energy: AI energy demand  The explosive growth of artificial intelligence comes with soaring demand for electricity to power data centers  As much as 5% per year in the next few years  Utilities (developed world): no electricity demand growth for more than a decade  Shuttering coal-powered plants to meet decarbonization goals  Meeting data center demand poses a quandary for utilities and technology firm  Expected to grow 10-30% over the next five years  Social reaction to technology: overwhelm, alienation  Mechanistic aspect is unpalatable, detracts from qualitative 100 Source: https://www.bain.com/insights/how-to-feed-ais-hunger-for-power/
  • 101.
    23 Sep 2024 DigitalTransformation Project Management is Complicated 101
  • 102.
    23 Sep 2024 DigitalTransformation Many Opportunities for the Future 102 Institute for Molecular Medicine Finland
  • 103.
    23 Sep 2024 DigitalTransformation Thesis 103 Humanity is undertaking a new wave of projects which are unprecedented in size, scale, scope, and values-based outcomes These projects, among other aspects, entail orders of magnitude more lines of software code which must be written, integrated, tested, and analyzed Innovation in project management is required, notably via AI agents, digital twins, blockchain data security, and quantum processing
  • 104.
    Vaasa Finland, 23Sep 2024 Slides: http://slideshare.net/LaBlogga Melanie Swan, PhD, MBA DIYgenomics.org (Research Lead) University College London (Research Associate) “Do not undertake a project unless it is manifestly important and nearly impossible” – Edwin Land, Co-Founder, Polaroid Camera Digital Transformation AI Project Management Agents Thank you~! Questions?
  • 105.
    23 Sep 2024 DigitalTransformation Abstract 105 Digital Transformation and AI Project Management This lecture describes the foundations of project planning and scheduling including waterfall vs. agile methods and tools such as Gantt charts (information visualization), the Work Breakdown Structure, the Critical Path Method, and Scrum (short sprints by cross-functional teams). Project management case studies (Merck and the French Military) are presented to highlight decision processes in real-life settings. Innovative project management skills will be crucial to realizing the next generation of large-scale digital transformation projects in the contemporary smart network stack of web3 blockchains, AI, and quantum. The AI Project Management Agent joins humans as a symbiotic and complementary team-member. Enterprise AI means not only LLM-chat enabled content generation, but a rich AI backbone of integrated systems within and across organizations for the dynamic genesis of new systems and apps on demand.
  • 106.
    23 Sep 2024 DigitalTransformation Appendix: AI PM Tools IRL  Trello boards with AI integration  Claude Artifacts: draft me an app, slides 106
  • 107.
    23 Sep 2024 DigitalTransformation 107 Lightweight Web-based Project Management Trello Integrated AI Source: https://www.youtube.com/watch?v=bmEeIbzPNQo
  • 108.
    23 Sep 2024 DigitalTransformation 108 Trello Board Integrated AI Source: https://www.youtube.com/watch?v=bmEeIbzPNQo  text Math Agents
  • 109.
    23 Sep 2024 DigitalTransformation 109 Trello Board Integrated AI  text Math Agents
  • 110.
    23 Sep 2024 DigitalTransformation 110 Claude Artifacts (Programs, Apps, Files) Source: https://www.youtube.com/watch?v=GegAvpiWd_Q  text
  • 111.
    23 Sep 2024 DigitalTransformation 111 Project Management Slides Source: https://www.youtube.com/watch?v=GegAvpiWd_Q Toggle between modes: Preview and Code, copy-paste- save
  • 112.
    23 Sep 2024 DigitalTransformation 112 Slides and Code Source: https://www.youtube.com/watch?v=vUdNaAAc4FY UX: Preview Mode Code Mode
  • 113.
    23 Sep 2024 DigitalTransformation 113 Source: https://www.youtube.com/watch?v=vUdNaAAc4FY
  • 114.
    23 Sep 2024 DigitalTransformation 114 Draft a Website that … Source: https://www.youtube.com/watch?v=GegAvpiWd_Q
  • 115.
    23 Sep 2024 DigitalTransformation 115 Immediate On-screen Rendering Source: https://www.youtube.com/watch?v=GegAvpiWd_Q
  • 116.
    23 Sep 2024 DigitalTransformation 116 Usual Prompt Engineering, Write me a … Source: https://www.youtube.com/watch?v=GegAvpiWd_Q  text
  • 117.
    23 Sep 2024 DigitalTransformation Auto-renders Html Code and UX 117 Source: https://www.youtube.com/watch?v=GegAvpiWd_Q
  • 118.
    23 Sep 2024 DigitalTransformation Example Claude Artifacts: Apps with Code 118 Source: https://www.youtube.com/watch?v=GegAvpiWd_Q
