Kajaani
  Datacenter
  Case-­‐Study

Peter
  Jenkins

System
  Specialist
  &
  Project
  Manager

CSC
  –
  IT
  Centre
  for
  Science

Contents
! About CSC
–  High Performance Computing
! Drivers
–  Why a new datacenter?
–  Why Kajaani?
! The project
! What we built
! Construction and commissioning
! Lessons learned
I’m from
there

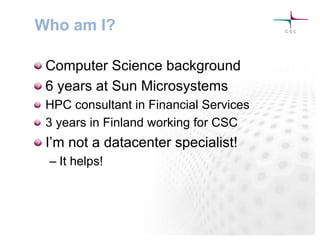

Who am I?
! Computer Science background
! 6 years at Sun Microsystems
! HPC consultant in Financial Services
! 3 years in Finland working for CSC
! I’m not a datacenter specialist!
– It helps!

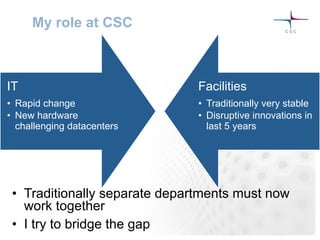

My role at CSC
IT
•  Rapid change
•  New hardware
challenging datacenters
Facilities
•  Traditionally very stable
•  Disruptive innovations in
last 5 years
•  Traditionally separate departments must now
work together
•  I try to bridge the gap
About
  CSC

•  100%
  owned
  by
  ministry
  of
  educaGon

– Public
  sector,
  Non
  profit

•  Major
  service
  areas:

– High
  Performance
  CompuGng
  (HPC)

– Storage
  and
  archive

– FUNET
  –
  Academic
  network
  in
  Finland

– Managed
  services
  and
  IaaS
  cloud

– Server
  hosGng
  and
  co-­‐lo

CSC and High Performance Computing

CSC
  CompuGng
  Capacity
  1989–2011

338

227

146

141

124

95

42

37

35

34

167

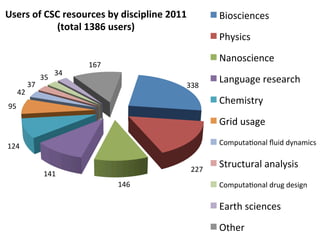

Users
  of
  CSC
  resources
  by
  discipline
  2011

(total
  1386
  users)

Biosciences

Physics

Nanoscience

Language
  research

Chemistry

Grid
  usage

ComputaGonal
  fluid
  dynamics

Structural
  analysis

ComputaGonal
  drug
  design

Earth
  sciences

Other

WHY A NEW DATACENTER?
0

1

2

3

4

5

6

7

8

9

10

2005
   2006
   2007
   2008
   2009
   2010
   2011

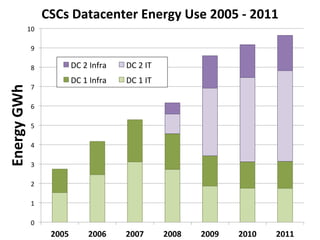

Energy
  GWh
   CSCs
  Datacenter
  Energy
  Use
  2005
  -­‐
  2011

DC
  2
  Infra
   DC
  2
  IT

DC
  1
  Infra
   DC
  1
  IT

 -­‐
  €

  10
  €

  20
  €

  30
  €

  40
  €

  50
  €

  60
  €

2000
   2001
   2002
   2003
   2004
   2005
   2006
   2007
   2008
   2009
   2010
   2011

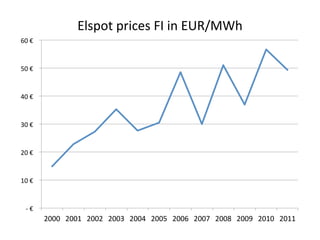

Elspot
  prices
  FI
  in
  EUR/MWh

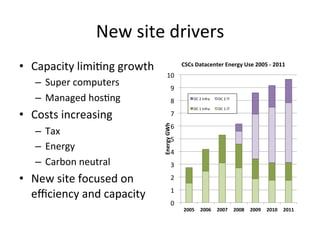

New
  site
  drivers

•  Capacity
  limiGng
  growth

–  Super
  computers

–  Managed
  hosGng

•  Costs
  increasing

–  Tax

–  Energy

–  Carbon
  neutral

•  New
  site
  focused
  on

efficiency
  and
  capacity

0

1

2

3

4

5

6

7

8

9

10

2005
   2006
   2007
   2008
   2009
   2010
   2011

Energy
  GWh

CSCs
  Datacenter
  Energy
  Use
  2005
  -­‐
  2011

DC
  2
  Infra
   DC
  2
  IT

DC
  1
  Infra
   DC
  1
  IT

2011 Energy cost per MW/hour
Espoo Kajaani
VAT
Tax
Transfer
Electricity
WHY KAJAANI?
10/10/2012 18

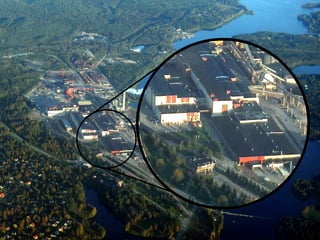

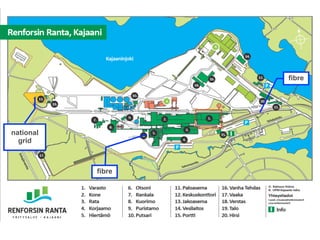

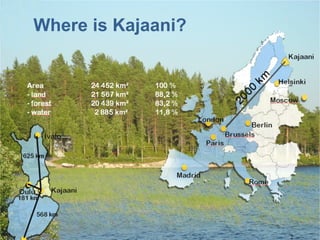

Where is Kajaani?
national
grid
fibre
fibre
Electricity

  reliability

29

Finnish
  naGonal
  grid
   Renforsin
  Ranta
  substaGon

Fingrid connections
to Kajaani

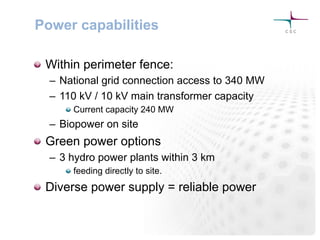

Power capabilities
! Within perimeter fence:
–  National grid connection access to 340 MW
–  110 kV / 10 kV main transformer capacity
!  Current capacity 240 MW
–  Biopower on site
! Green power options
–  3 hydro power plants within 3 km
!  feeding directly to site.
! Diverse power supply = reliable power

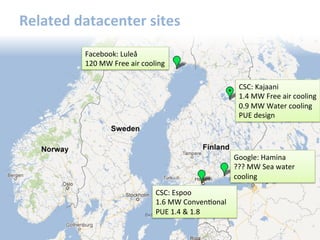

Related
  datacenter
  sites

Facebook:
  Luleå

120
  MW
  Free
  air
  cooling

CSC:
  Kajaani

1.4
  MW
  Free
  air
  cooling

0.9
  MW
  Water
  cooling

PUE
  design

Google:
  Hamina

???
  MW
  Sea
  water

cooling

CSC:
  Espoo

1.6
  MW
  ConvenGonal

PUE
  1.4
  &
  1.8

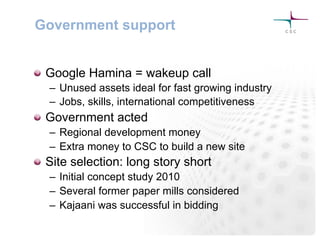

Government support
! Google Hamina = wakeup call
–  Unused assets ideal for fast growing industry
–  Jobs, skills, international competitiveness
! Government acted
–  Regional development money
–  Extra money to CSC to build a new site
! Site selection: long story short
–  Initial concept study 2010
–  Several former paper mills considered
–  Kajaani was successful in bidding
THE PROJECT

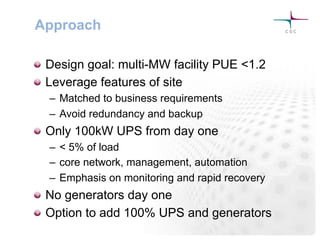

Approach
! Design goal: multi-MW facility PUE <1.2
! Leverage features of site
–  Matched to business requirements
–  Avoid redundancy and backup
! Only 100kW UPS from day one
–  < 5% of load
–  core network, management, automation
–  Emphasis on monitoring and rapid recovery
! No generators day one
! Option to add 100% UPS and generators

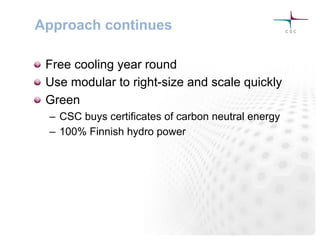

Approach continues
! Free cooling year round
! Use modular to right-size and scale quickly
! Green
–  CSC buys certificates of carbon neutral energy
–  100% Finnish hydro power
Out
side

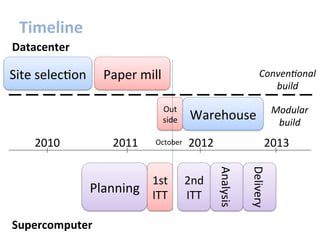

Timeline

Paper
  mill

2010
   2011
   2012

Site
  selecGon

Planning

Warehouse

2013

1st

ITT

Datacenter

Supercomputer

October

2nd

ITT

Analysis

Delivery

Conven&onal

build

Modular

build

WHAT DID WE BUILD?

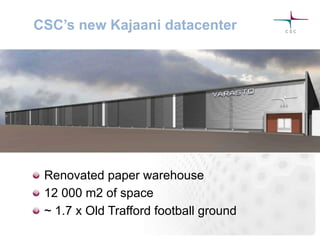

CSC’s new Kajaani datacenter
!   Renovated paper warehouse
!   12 000 m2 of space
!   ~ 1.7 x Old Trafford football ground

Warehouse
  has
  two
  DC
  tenants

Hub

datacenter

SGI
  Ice
  Cube
  R80

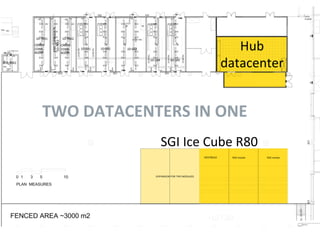

TWO
  DATACENTERS
  IN
  ONE

3D WALKTHROUGH VIDEO

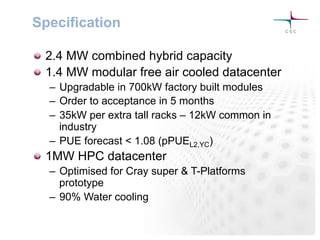

Specification
! 2.4 MW combined hybrid capacity
! 1.4 MW modular free air cooled datacenter
–  Upgradable in 700kW factory built modules
–  Order to acceptance in 5 months
–  35kW per extra tall racks – 12kW common in
industry
–  PUE forecast < 1.08 (pPUEL2,YC)
! 1MW HPC datacenter
–  Optimised for Cray super & T-Platforms
prototype
–  90% Water cooling
Hub

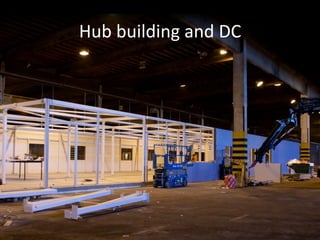

  building
  and
  DC

Hub
datacenter

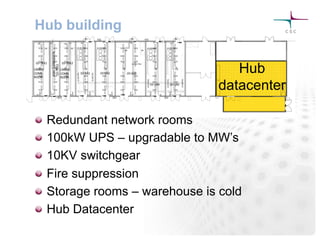

Hub building
! Redundant network rooms
! 100kW UPS – upgradable to MW’s
! 10KV switchgear
! Fire suppression
! Storage rooms – warehouse is cold
! Hub Datacenter

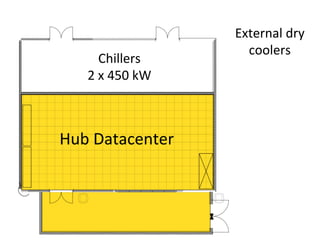

Hub
  Datacenter

Chillers

2
  x
  450
  kW

External
  dry

coolers

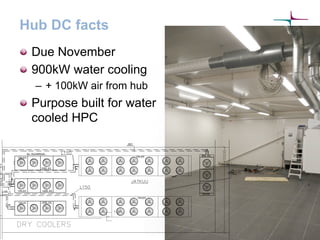

Hub DC facts
! Due November
! 900kW water cooling
–  + 100kW air from hub
! Purpose built for water
cooled HPC

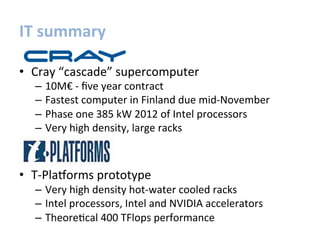

IT
  summary

•  Cray
  “cascade”
  supercomputer

–  10M€
  -­‐
  five
  year
  contract

–  Fastest
  computer
  in
  Finland
  due
  mid-­‐November

–  Phase
  one
  385
  kW
  2012
  of
  Intel
  processors

–  Very
  high
  density,
  large
  racks

•  T-­‐Plamorms
  prototype

–  Very
  high
  density
  hot-­‐water
  cooled
  racks

–  Intel
  processors,
  Intel
  and
  NVIDIA
  accelerators

–  TheoreGcal
  400
  TFlops
  performance

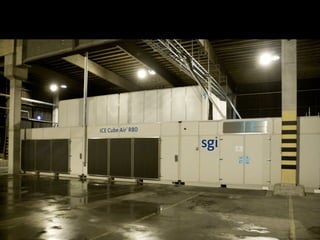

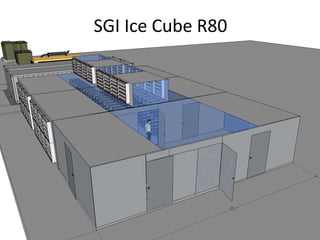

SGI
  Ice
  Cube
  R80

SGI
  Ice
  Cube
  R80

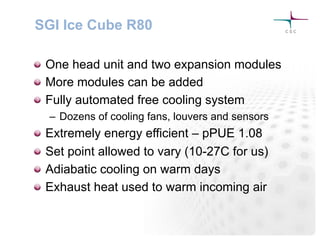

SGI Ice Cube R80
! One head unit and two expansion modules
! More modules can be added
! Fully automated free cooling system
–  Dozens of cooling fans, louvers and sensors
! Extremely energy efficient – pPUE 1.08
! Set point allowed to vary (10-27C for us)
! Adiabatic cooling on warm days
! Exhaust heat used to warm incoming air

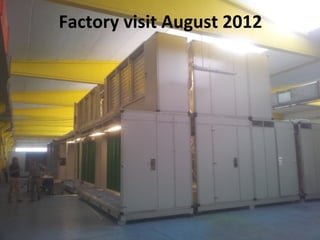

Factory
  visit
  August
  2012

! “Super Cluster”
–  4.5M€ five year contract
–  1,152 Intel CPUs
–  190 TFlop/s
–  30kW 47U racks
! HPC storage
–  3PB of fast parallel storage
–  Supports Cray and HP systems
IT summary

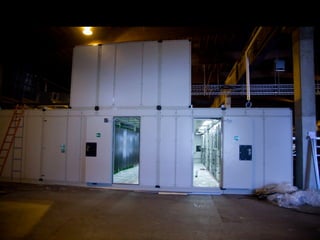

CONSTRUCTION

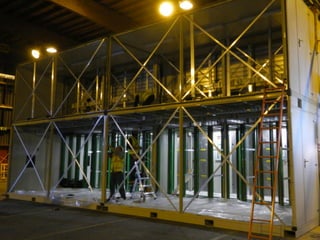

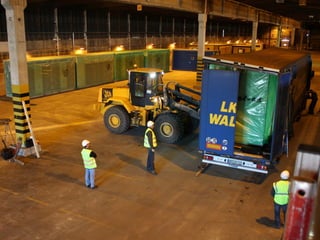

Site
  in
  January
  2012

MDC TIME LAPSE VIDEO

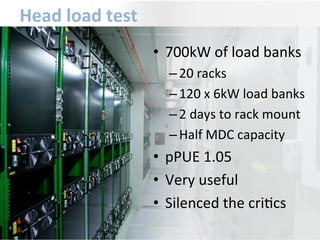

Head
  load
  test

•  700kW
  of
  load
  banks

– 20
  racks

– 120
  x
  6kW
  load
  banks

– 2
  days
  to
  rack
  mount

– Half
  MDC
  capacity

•  pPUE
  1.05

•  Very
  useful

•  Silenced
  the
  criGcs

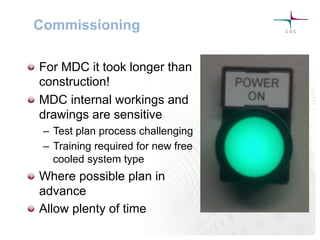

Commissioning
!   For MDC it took longer than
construction!
!   MDC internal workings and
drawings are sensitive
–  Test plan process challenging
–  Training required for new free
cooled system type
!   Where possible plan in
advance
!   Allow plenty of time
LESSONS LEARNED

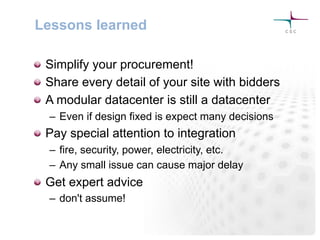

Lessons learned
! Simplify your procurement!
! Share every detail of your site with bidders
! A modular datacenter is still a datacenter
–  Even if design fixed is expect many decisions
! Pay special attention to integration
–  fire, security, power, electricity, etc.
–  Any small issue can cause major delay
! Get expert advice
–  don't assume!

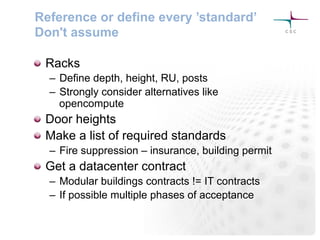

Reference or define every ’standard’
Don't assume
! Racks
–  Define depth, height, RU, posts
–  Strongly consider alternatives like
opencompute
! Door heights
! Make a list of required standards
–  Fire suppression – insurance, building permit
! Get a datacenter contract
–  Modular buildings contracts != IT contracts
–  If possible multiple phases of acceptance

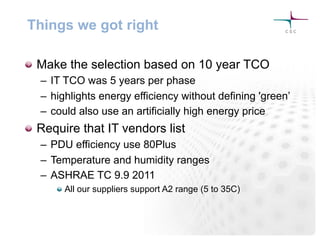

Things we got right
! Make the selection based on 10 year TCO
–  IT TCO was 5 years per phase
–  highlights energy efficiency without defining 'green’
–  could also use an artificially high energy price
! Require that IT vendors list
–  PDU efficiency use 80Plus
–  Temperature and humidity ranges
–  ASHRAE TC 9.9 2011
!  All our suppliers support A2 range (5 to 35C)
Datacenter operations team
QUESTIONS?
Thanks

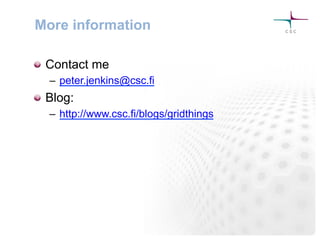

More information
! Contact me
–  peter.jenkins@csc.fi
! Blog:
–  http://www.csc.fi/blogs/gridthings

CSC Modular Datacenter

  • 1.
    Kajaani  Datacenter  Case-­‐Study   Peter  Jenkins   System  Specialist  &  Project  Manager   CSC  –  IT  Centre  for  Science
  • 3.
    Contents ! About CSC – High Performance Computing ! Drivers –  Why a new datacenter? –  Why Kajaani? ! The project ! What we built ! Construction and commissioning ! Lessons learned
  • 4.
  • 5.
    Who am I? !Computer Science background ! 6 years at Sun Microsystems ! HPC consultant in Financial Services ! 3 years in Finland working for CSC ! I’m not a datacenter specialist! – It helps!
  • 6.
    My role atCSC IT •  Rapid change •  New hardware challenging datacenters Facilities •  Traditionally very stable •  Disruptive innovations in last 5 years •  Traditionally separate departments must now work together •  I try to bridge the gap
  • 7.
    About  CSC   • 100%  owned  by  ministry  of  educaGon   – Public  sector,  Non  profit   •  Major  service  areas:   – High  Performance  CompuGng  (HPC)   – Storage  and  archive   – FUNET  –  Academic  network  in  Finland   – Managed  services  and  IaaS  cloud   – Server  hosGng  and  co-­‐lo
  • 8.
    CSC and HighPerformance Computing
  • 9.
  • 10.
  • 12.
    338   227   146   141   124   95   42   37   35   34   167   Users  of  CSC  resources  by  discipline  2011   (total  1386  users)     Biosciences   Physics   Nanoscience   Language  research   Chemistry   Grid  usage   ComputaGonal  fluid  dynamics   Structural  analysis   ComputaGonal  drug  design   Earth  sciences   Other
  • 13.
    WHY A NEWDATACENTER?
  • 14.
    0   1   2   3   4   5   6   7   8   9   10   2005   2006   2007   2008   2009   2010   2011   Energy  GWh   CSCs  Datacenter  Energy  Use  2005  -­‐  2011   DC  2  Infra   DC  2  IT   DC  1  Infra   DC  1  IT
  • 15.
     -­‐  €      10  €      20  €      30  €      40  €      50  €      60  €     2000   2001   2002   2003   2004   2005   2006   2007   2008   2009   2010   2011   Elspot  prices  FI  in  EUR/MWh
  • 16.
    New  site  drivers   •  Capacity  limiGng  growth   –  Super  computers   –  Managed  hosGng   •  Costs  increasing   –  Tax   –  Energy   –  Carbon  neutral   •  New  site  focused  on   efficiency  and  capacity   0   1   2   3   4   5   6   7   8   9   10   2005   2006   2007   2008   2009   2010   2011   Energy  GWh   CSCs  Datacenter  Energy  Use  2005  -­‐  2011   DC  2  Infra   DC  2  IT   DC  1  Infra   DC  1  IT
  • 17.
    2011 Energy costper MW/hour Espoo Kajaani VAT Tax Transfer Electricity
  • 18.
  • 19.
  • 23.
  • 29.
    Electricity  reliability   29       Finnish  naGonal  grid   Renforsin  Ranta  substaGon
  • 30.
  • 31.
    Power capabilities ! Withinperimeter fence: –  National grid connection access to 340 MW –  110 kV / 10 kV main transformer capacity !  Current capacity 240 MW –  Biopower on site ! Green power options –  3 hydro power plants within 3 km !  feeding directly to site. ! Diverse power supply = reliable power
  • 33.
    Related  datacenter  sites   Facebook:  Luleå   120  MW  Free  air  cooling   CSC:  Kajaani   1.4  MW  Free  air  cooling   0.9  MW  Water  cooling   PUE  design   Google:  Hamina   ???  MW  Sea  water   cooling   CSC:  Espoo   1.6  MW  ConvenGonal   PUE  1.4  &  1.8
  • 34.
    Government support ! GoogleHamina = wakeup call –  Unused assets ideal for fast growing industry –  Jobs, skills, international competitiveness ! Government acted –  Regional development money –  Extra money to CSC to build a new site ! Site selection: long story short –  Initial concept study 2010 –  Several former paper mills considered –  Kajaani was successful in bidding
  • 35.
  • 36.
    Approach ! Design goal:multi-MW facility PUE <1.2 ! Leverage features of site –  Matched to business requirements –  Avoid redundancy and backup ! Only 100kW UPS from day one –  < 5% of load –  core network, management, automation –  Emphasis on monitoring and rapid recovery ! No generators day one ! Option to add 100% UPS and generators
  • 37.
    Approach continues ! Freecooling year round ! Use modular to right-size and scale quickly ! Green –  CSC buys certificates of carbon neutral energy –  100% Finnish hydro power
  • 38.
    Out side   Timeline   Paper  mill   2010   2011   2012   Site  selecGon   Planning   Warehouse   2013   1st   ITT   Datacenter   Supercomputer   October   2nd   ITT   Analysis   Delivery   Conven&onal   build   Modular   build
  • 39.
  • 40.
    CSC’s new Kajaanidatacenter !   Renovated paper warehouse !   12 000 m2 of space !   ~ 1.7 x Old Trafford football ground
  • 41.
    Warehouse  has  two  DC  tenants
  • 42.
    Hub   datacenter   SGI  Ice  Cube  R80   TWO  DATACENTERS  IN  ONE
  • 43.
  • 44.
    Specification ! 2.4 MWcombined hybrid capacity ! 1.4 MW modular free air cooled datacenter –  Upgradable in 700kW factory built modules –  Order to acceptance in 5 months –  35kW per extra tall racks – 12kW common in industry –  PUE forecast < 1.08 (pPUEL2,YC) ! 1MW HPC datacenter –  Optimised for Cray super & T-Platforms prototype –  90% Water cooling
  • 45.
  • 46.
    Hub datacenter Hub building ! Redundantnetwork rooms ! 100kW UPS – upgradable to MW’s ! 10KV switchgear ! Fire suppression ! Storage rooms – warehouse is cold ! Hub Datacenter
  • 47.
    Hub  Datacenter   Chillers   2  x  450  kW   External  dry   coolers
  • 49.
    Hub DC facts !Due November ! 900kW water cooling –  + 100kW air from hub ! Purpose built for water cooled HPC
  • 50.
    IT  summary   • Cray  “cascade”  supercomputer   –  10M€  -­‐  five  year  contract   –  Fastest  computer  in  Finland  due  mid-­‐November   –  Phase  one  385  kW  2012  of  Intel  processors   –  Very  high  density,  large  racks   •  T-­‐Plamorms  prototype   –  Very  high  density  hot-­‐water  cooled  racks   –  Intel  processors,  Intel  and  NVIDIA  accelerators   –  TheoreGcal  400  TFlops  performance
  • 51.
  • 53.
  • 54.

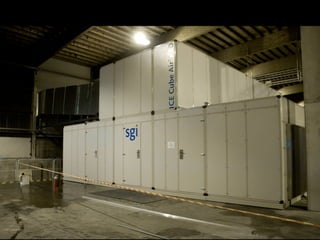

    SGI Ice CubeR80 ! One head unit and two expansion modules ! More modules can be added ! Fully automated free cooling system –  Dozens of cooling fans, louvers and sensors ! Extremely energy efficient – pPUE 1.08 ! Set point allowed to vary (10-27C for us) ! Adiabatic cooling on warm days ! Exhaust heat used to warm incoming air
  • 55.
  • 59.
    ! “Super Cluster” – 4.5M€ five year contract –  1,152 Intel CPUs –  190 TFlop/s –  30kW 47U racks ! HPC storage –  3PB of fast parallel storage –  Supports Cray and HP systems IT summary
  • 60.
  • 61.
  • 62.
  • 63.
    Head  load  test   •  700kW  of  load  banks   – 20  racks   – 120  x  6kW  load  banks   – 2  days  to  rack  mount   – Half  MDC  capacity   •  pPUE  1.05   •  Very  useful   •  Silenced  the  criGcs
  • 64.
    Commissioning !   ForMDC it took longer than construction! !   MDC internal workings and drawings are sensitive –  Test plan process challenging –  Training required for new free cooled system type !   Where possible plan in advance !   Allow plenty of time
  • 65.
  • 66.
    Lessons learned ! Simplifyyour procurement! ! Share every detail of your site with bidders ! A modular datacenter is still a datacenter –  Even if design fixed is expect many decisions ! Pay special attention to integration –  fire, security, power, electricity, etc. –  Any small issue can cause major delay ! Get expert advice –  don't assume!
  • 67.
    Reference or defineevery ’standard’ Don't assume ! Racks –  Define depth, height, RU, posts –  Strongly consider alternatives like opencompute ! Door heights ! Make a list of required standards –  Fire suppression – insurance, building permit ! Get a datacenter contract –  Modular buildings contracts != IT contracts –  If possible multiple phases of acceptance
  • 68.
    Things we gotright ! Make the selection based on 10 year TCO –  IT TCO was 5 years per phase –  highlights energy efficiency without defining 'green’ –  could also use an artificially high energy price ! Require that IT vendors list –  PDU efficiency use 80Plus –  Temperature and humidity ranges –  ASHRAE TC 9.9 2011 !  All our suppliers support A2 range (5 to 35C)
  • 69.
  • 70.
  • 71.
    More information ! Contactme –  peter.jenkins@csc.fi ! Blog: –  http://www.csc.fi/blogs/gridthings
