Alga Norte Community Park
                                                                             Contract No. 3837A



Construction Management Plan Guideline
Table of Contents

Project Description

   1. Project Management Plans
          a. Project Organization
          b. Communication Plan
          c. Roles and Responsibilities Matrix
          d. Progress Meetings
          e. Subcontractor Selection Process
          f. Document Management
          g. As-builts, Commissioning, and Project Close-out
          h. Community Outreach
   2. Safety Management
          a. Public Safety and Site Security Plan
          b. Project Safety Plan
          c. Earthquake Preparedness Plan
   3. Environmental and Sustainability Plans
          a. Air & Dust Management Plan
          b. Noise Pollution Prevention Pan
          c. Tree Protection Plan
          d. Sustainable Construction Practices Plan
          e. Storm Water Management Plan
   4. Quality Management Plan
          a. QA/QC Plan
   5. Time Management Plan
          a. Schedule Control Procedures
   6. Cost Management Plan

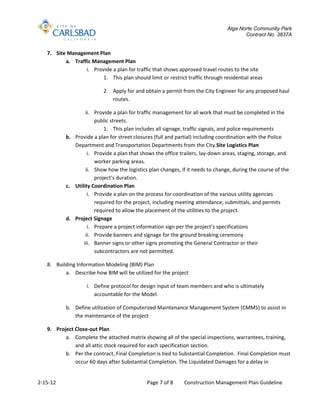

   7. Site Management Plan
          a. Traffic Management Plan
          b. Site Logistics Plan
          c. Utility Coordination
          d. Project Signage
   8. Building Information Modeling (BIM) Plan
   9. Project Close-out Plan

2-15-12                                 Page 1 of 8   Construction Management Plan Guideline
Alga Norte Community Park
                                                                                       Contract No. 3837A




   1. Project Management Plan
          a. Project Organization
                  i. Provide an organization chart including reporting responsibilities
          b. Communication
                  i. Create and maintain a project Directory showing the names and contact information
                     of all members of the project team and first tier subcontractors and suppliers
                 ii. Create an Emergency Communication Plan
                iii. Provide contact information for key employees that can be contacted after hours
                iv. Rotate key members of the construction team that will be “On Call” and will be
                     available to travel to the site if needed
                 v. Reporting Procedures
                          1. Progress Reports – Report on Project Progress – define measures that define
                             the project’s progress and issues. Define frequency and delivery method,
                             define who sees
          c. Roles and Responsibilities
                  i. Provide a roles and responsibilities matrix defining the primary and secondary roles
                     for the project.

          d. Progress Meetings
                  i. Define the approach and frequency of Progress Meetings with the City. Develop
                     methods to track deliverables and action items that occur during the meetings
                     (meeting minutes, etc.).
          e. Subcontractor Selection Process
                  i. Provide a plan on selecting subcontractors that allows for a “Best Value” selection
                     that takes the Subcontractor’s qualifications into consideration.
          f. Document Management Plan
                  i. Provide a Document Management Plan that can be shared by the City via the
                     internet.

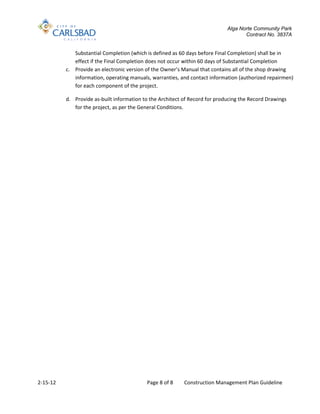

          g. As-builts, Commissioning and Project Close-out
                  i. Develop a matrix of all the tasks, warranties, special inspections, special warranties,
                     testing, inspections, attic stock and training for each specification section.
                 ii. Provide as-builts on PDF and AutoCAD formats, per the General Conditions.
                iii. Cooperate with City’s Commissioning Agent on access to the work and any reports
                     from subcontractors.

          h. Community Outreach
                 i. Provide a plan on how the project will be shared with the local community. Town
                    Hall type meetings with various stakeholders, etc.
                ii. Attend meetings coordinated by the City to meet with local business members that
                    have certain trades or business that can participate in the project. Without
2-15-12                                      Page 2 of 8     Construction Management Plan Guideline
Alga Norte Community Park
                                                                                      Contract No. 3837A


                       increasing the cost of the project, local businesses are preferred by the City to be
                       utilized as appropriate.
   2. Safety Management Plan
          a. Public Safety and Site Security
                    i. Define a plan to keep the general public off the site
                   ii. Define badging system or other method to ensure site visitors are authorized to be
                       on the site
                  iii. Define and mitigate any “attractive nuisances”
                  iv. Prepare a visitor waiver of claim for all persons who walk onto the site
                   v. Maintain a visitor log for all visitors
                  vi. Publish standards for safety for all visitors including appropriate attire, shoes and
                       eye protection
                 vii. Prepare a plan for off hour security
                            1. Video surveillance
                            2. Security personnel on site after hours
                viii. Define hours of operations and noise limitations
          b. Project Safety
                    i. Provide copies of the company’s Safety Program for all key members of the project
                       team
                   ii. Conduct orientation training for all new employees or contractors working on this
                       project
                  iii. Collect signed agreements from all workers on the site that they have been given an
                       orientation regarding the project’s safety procedures and that they understand the
                       safety rules for the project
                  iv. Conduct periodic safety meetings on site with all subcontractors
                   v. Comply with all requirements of the Safety Plan
                  vi. Develop a “hot” work permit for all activities that involve flame
          c. Earthquake Preparedness
                    i. Provide a plan that demonstrates how the project will be prepared for an
                       earthquake
                   ii. Include furniture bracing for office trailers
                  iii. Evacuation plan
                  iv. Materials stored for the specific purpose of an earthquake event

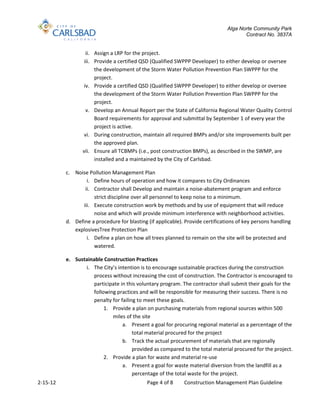

   3. Environment & Sustainability Plan
          a. Air & Dust Management
                    i. Provide a plan on how the project will mitigate airborne dust.
                   ii. Ensure project complies with all applicable air and dust regulations.
          b. Storm Water Management Plan
                    i. Secure and maintain a Construction General Permit per the requirements of the
                       California State Regional Water Quality Control Board.
2-15-12                                      Page 3 of 8     Construction Management Plan Guideline
Alga Norte Community Park
                                                                                       Contract No. 3837A


                   ii. Assign a LRP for the project.
                  iii. Provide a certified QSD (Qualified SWPPP Developer) to either develop or oversee
                       the development of the Storm Water Pollution Prevention Plan SWPPP for the
                       project.
                  iv. Provide a certified QSD (Qualified SWPPP Developer) to either develop or oversee
                       the development of the Storm Water Pollution Prevention Plan SWPPP for the
                       project.
                   v. Develop an Annual Report per the State of California Regional Water Quality Control
                       Board requirements for approval and submittal by September 1 of every year the
                       project is active.
                  vi. During construction, maintain all required BMPs and/or site improvements built per
                       the approved plan.
                 vii. Ensure all TCBMPs (i.e., post construction BMPs), as described in the SWMP, are
                       installed and a maintained by the City of Carlsbad.

          c. Noise Pollution Management Plan
                  i. Define hours of operation and how it compares to City Ordinances
                 ii. Contractor shall Develop and maintain a noise-abatement program and enforce
                     strict discipline over all personnel to keep noise to a minimum.
                iii. Execute construction work by methods and by use of equipment that will reduce
                     noise and which will provide minimum interference with neighborhood activities.
          d. Define a procedure for blasting (if applicable). Provide certifications of key persons handling
             explosivesTree Protection Plan
                  i. Define a plan on how all trees planned to remain on the site will be protected and
                     watered.

          e. Sustainable Construction Practices
                 i. The City’s intention is to encourage sustainable practices during the construction
                    process without increasing the cost of construction. The Contractor is encouraged to
                    participate in this voluntary program. The contractor shall submit their goals for the
                    following practices and will be responsible for measuring their success. There is no
                    penalty for failing to meet these goals.
                         1. Provide a plan on purchasing materials from regional sources within 500
                            miles of the site
                                 a. Present a goal for procuring regional material as a percentage of the
                                      total material procured for the project
                                 b. Track the actual procurement of materials that are regionally
                                      provided as compared to the total material procured for the project.
                         2. Provide a plan for waste and material re-use
                                 a. Present a goal for waste material diversion from the landfill as a
                                      percentage of the total waste for the project.
2-15-12                                      Page 4 of 8     Construction Management Plan Guideline
Alga Norte Community Park
                                                                                        Contract No. 3837A


                                   b. Track the actual waste diverted as compared to the total waste
                                      produced by this project.

                                   c. Present a plan for handling hazardous waste removal, spill
                                      prevention/mitigation, and battery disposal.
                                   d. Define standard practices for debris removal at the site.

                           3. Provide a plan to ensure the indoor air quality for the project is protected
                           4. Provide a plan on purchasing products with recycled content
                                    a. Present a goal for procuring recycled content materials as a
                                         percentage of the total materials purchased for the project.
                                    b. Track the actual value of the recycled content as compared to all
                                         products purchased for the project.
   4. Quality Assurance/Quality Control
         a. QA/QC Plan
                    i. Provide a detailed program to ensure the project’s quality is protected and
                       maintained.
                   ii. Define the testing of the project’s quality.
                  iii. Define the remedy plans for quality that is determined to be inadequate.
                  iv. Define the mock-up plans for any work that is required to have a mock-up provided.
                   v. 2 weeks before starting a new trade, conduct a field pre-construction meeting to
                       verify the subcontractor has the up to date plans, aware of changes, submittal
                       approval status and provides an opportunity to resolve conflicts before the
                       subcontractor is mobilized onsite reducing delays.
                  vi. Cooperate with the Commissioning Agent (Owner’s Representative)
                 vii. Testing and Balancing the HVAC system will be by the Owner.
   5. Time Management Plan

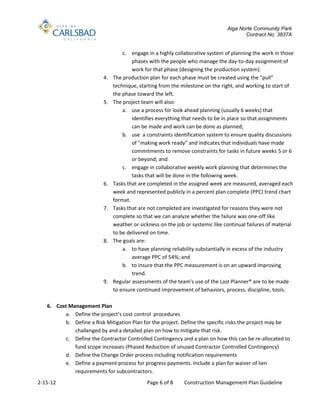

         a. Schedule Control Procedures
                    i. Provide a detailed schedule for the project
                           1. The General Contractor shall use the Last Planner® (or equal) System of
                                production control for scheduling and planning delivery of the project. All of
                                the following must be part of that system:
                           2. The Last Planner® (or equal) is a production planning system designed to
                                produce predictable work flow and rapid learning
                           3. The project team will:
                                    a. validate the required CPM schedule with a Milestone schedule
                                         developed collaboratively with the City, Construction Manager, and
                                         other stakeholders;
                                    b. develop appropriate milestones that take those chunks of work that
                                         ought to be done and break them into phases; and

2-15-12                                       Page 5 of 8     Construction Management Plan Guideline
Alga Norte Community Park
                                                                                       Contract No. 3837A


                                   c. engage in a highly collaborative system of planning the work in those
                                       phases with the people who manage the day-to-day assignment of
                                       work for that phase (designing the production system).
                          4.   The production plan for each phase must be created using the "pull"
                               technique, starting from the milestone on the right, and working to start of
                               the phase toward the left.
                          5.   The project team will also:
                                   a. use a process for look ahead planning (usually 6 weeks) that
                                       identifies everything that needs to be in place so that assignments
                                       can be made and work can be done as planned;
                                   b. use a constraints identification system to ensure quality discussions
                                       of "making work ready" and indicates that individuals have made
                                       commitments to remove constraints for tasks in future weeks 5 or 6
                                       or beyond; and
                                   c. engage in collaborative weekly work planning that determines the
                                       tasks that will be done in the following week.
                          6.   Tasks that are completed in the assigned week are measured, averaged each
                               week and represented publicly in a percent plan complete (PPC) trend chart
                               format.
                          7.   Tasks that are not completed are investigated for reasons they were not
                               complete so that we can analyze whether the failure was one-off like
                               weather or sickness on the job or systemic like continual failures of material
                               to be delivered on time.
                          8.   The goals are:
                                   a. to have planning reliability substantially in excess of the industry
                                       average PPC of 54%; and
                                   b. to insure that the PPC measurement is on an upward improving
                                       trend.
                          9.   Regular assessments of the team's use of the Last Planner® are to be made
                               to ensure continued improvement of behaviors, process, discipline, tools.

   6. Cost Management Plan
         a. Define the project’s cost control procedures
         b. Define a Risk Mitigation Plan for the project. Define the specific risks the project may be
             challenged by and a detailed plan on how to mitigate that risk.
         c. Define the Contractor Controlled Contingency and a plan on how this can be re-allocated to
             fund scope increases (Phased Reduction of unused Contractor Controlled Contingency)
         d. Define the Change Order process including notification requirements
         e. Define a payment process for progress payments. Include a plan for waiver of lien
             requirements for subcontractors.
2-15-12                                      Page 6 of 8     Construction Management Plan Guideline
Alga Norte Community Park
                                                                                       Contract No. 3837A


   7. Site Management Plan
          a. Traffic Management Plan
                  i. Provide a plan for traffic that shows approved travel routes to the site
                         1. This plan should limit or restrict traffic through residential areas

                           2. Apply for and obtain a permit from the City Engineer for any proposed haul
                              routes.

                   ii. Provide a plan for traffic management for all work that must be completed in the
                       public streets.
                           1. This plan includes all signage, traffic signals, and police requirements
           b. Provide a plan for street closures (full and partial) including coordination with the Police
              Department and Transportation Departments from the City.Site Logistics Plan
                    i. Provide a plan that shows the office trailers, lay-down areas, staging, storage, and
                       worker parking areas.
                   ii. Show how the logistics plan changes, if it needs to change, during the course of the
                       project’s duration.
           c. Utility Coordination Plan
                    i. Provide a plan on the process for coordination of the various utility agencies
                       required for the project, including meeting attendance, submittals, and permits
                       required to allow the placement of the utilities to the project.
           d. Project Signage
                    i. Prepare a project information sign per the project’s specifications
                   ii. Provide banners and signage for the ground breaking ceremony
                  iii. Banner signs or other signs promoting the General Contractor or their
                       subcontractors are not permitted.

   8. Building Information Modeling (BIM) Plan
          a. Describe how BIM will be utilized for the project

                    i. Define protocol for design input of team members and who is ultimately
                       accountable for the Model.

           b. Define utilization of Computerized Maintenance Management System (CMMS) to assist in
              the maintenance of the project

   9. Project Close-out Plan
          a. Complete the attached matrix showing all of the special inspections, warrantees, training,
              and all attic stock required for each specification section.
          b. Per the contract, Final Completion is tied to Substantial Completion. Final Completion must
              occur 60 days after Substantial Completion. The Liquidated Damages for a delay in


2-15-12                                       Page 7 of 8     Construction Management Plan Guideline
Alga Norte Community Park
                                                                                    Contract No. 3837A


             Substantial Completion (which is defined as 60 days before Final Completion) shall be in
             effect if the Final Completion does not occur within 60 days of Substantial Completion
          c. Provide an electronic version of the Owner’s Manual that contains all of the shop drawing
             information, operating manuals, warranties, and contact information (authorized repairmen)
             for each component of the project.

          d. Provide as-built information to the Architect of Record for producing the Record Drawings
             for the project, as per the General Conditions.




2-15-12                                    Page 8 of 8     Construction Management Plan Guideline

Construction Management Plan Guideline 2 15 12

  • 1.
    Alga Norte CommunityPark Contract No. 3837A Construction Management Plan Guideline Table of Contents Project Description 1. Project Management Plans a. Project Organization b. Communication Plan c. Roles and Responsibilities Matrix d. Progress Meetings e. Subcontractor Selection Process f. Document Management g. As-builts, Commissioning, and Project Close-out h. Community Outreach 2. Safety Management a. Public Safety and Site Security Plan b. Project Safety Plan c. Earthquake Preparedness Plan 3. Environmental and Sustainability Plans a. Air & Dust Management Plan b. Noise Pollution Prevention Pan c. Tree Protection Plan d. Sustainable Construction Practices Plan e. Storm Water Management Plan 4. Quality Management Plan a. QA/QC Plan 5. Time Management Plan a. Schedule Control Procedures 6. Cost Management Plan 7. Site Management Plan a. Traffic Management Plan b. Site Logistics Plan c. Utility Coordination d. Project Signage 8. Building Information Modeling (BIM) Plan 9. Project Close-out Plan 2-15-12 Page 1 of 8 Construction Management Plan Guideline
  • 2.
    Alga Norte CommunityPark Contract No. 3837A 1. Project Management Plan a. Project Organization i. Provide an organization chart including reporting responsibilities b. Communication i. Create and maintain a project Directory showing the names and contact information of all members of the project team and first tier subcontractors and suppliers ii. Create an Emergency Communication Plan iii. Provide contact information for key employees that can be contacted after hours iv. Rotate key members of the construction team that will be “On Call” and will be available to travel to the site if needed v. Reporting Procedures 1. Progress Reports – Report on Project Progress – define measures that define the project’s progress and issues. Define frequency and delivery method, define who sees c. Roles and Responsibilities i. Provide a roles and responsibilities matrix defining the primary and secondary roles for the project. d. Progress Meetings i. Define the approach and frequency of Progress Meetings with the City. Develop methods to track deliverables and action items that occur during the meetings (meeting minutes, etc.). e. Subcontractor Selection Process i. Provide a plan on selecting subcontractors that allows for a “Best Value” selection that takes the Subcontractor’s qualifications into consideration. f. Document Management Plan i. Provide a Document Management Plan that can be shared by the City via the internet. g. As-builts, Commissioning and Project Close-out i. Develop a matrix of all the tasks, warranties, special inspections, special warranties, testing, inspections, attic stock and training for each specification section. ii. Provide as-builts on PDF and AutoCAD formats, per the General Conditions. iii. Cooperate with City’s Commissioning Agent on access to the work and any reports from subcontractors. h. Community Outreach i. Provide a plan on how the project will be shared with the local community. Town Hall type meetings with various stakeholders, etc. ii. Attend meetings coordinated by the City to meet with local business members that have certain trades or business that can participate in the project. Without 2-15-12 Page 2 of 8 Construction Management Plan Guideline
  • 3.
    Alga Norte CommunityPark Contract No. 3837A increasing the cost of the project, local businesses are preferred by the City to be utilized as appropriate. 2. Safety Management Plan a. Public Safety and Site Security i. Define a plan to keep the general public off the site ii. Define badging system or other method to ensure site visitors are authorized to be on the site iii. Define and mitigate any “attractive nuisances” iv. Prepare a visitor waiver of claim for all persons who walk onto the site v. Maintain a visitor log for all visitors vi. Publish standards for safety for all visitors including appropriate attire, shoes and eye protection vii. Prepare a plan for off hour security 1. Video surveillance 2. Security personnel on site after hours viii. Define hours of operations and noise limitations b. Project Safety i. Provide copies of the company’s Safety Program for all key members of the project team ii. Conduct orientation training for all new employees or contractors working on this project iii. Collect signed agreements from all workers on the site that they have been given an orientation regarding the project’s safety procedures and that they understand the safety rules for the project iv. Conduct periodic safety meetings on site with all subcontractors v. Comply with all requirements of the Safety Plan vi. Develop a “hot” work permit for all activities that involve flame c. Earthquake Preparedness i. Provide a plan that demonstrates how the project will be prepared for an earthquake ii. Include furniture bracing for office trailers iii. Evacuation plan iv. Materials stored for the specific purpose of an earthquake event 3. Environment & Sustainability Plan a. Air & Dust Management i. Provide a plan on how the project will mitigate airborne dust. ii. Ensure project complies with all applicable air and dust regulations. b. Storm Water Management Plan i. Secure and maintain a Construction General Permit per the requirements of the California State Regional Water Quality Control Board. 2-15-12 Page 3 of 8 Construction Management Plan Guideline
  • 4.
    Alga Norte CommunityPark Contract No. 3837A ii. Assign a LRP for the project. iii. Provide a certified QSD (Qualified SWPPP Developer) to either develop or oversee the development of the Storm Water Pollution Prevention Plan SWPPP for the project. iv. Provide a certified QSD (Qualified SWPPP Developer) to either develop or oversee the development of the Storm Water Pollution Prevention Plan SWPPP for the project. v. Develop an Annual Report per the State of California Regional Water Quality Control Board requirements for approval and submittal by September 1 of every year the project is active. vi. During construction, maintain all required BMPs and/or site improvements built per the approved plan. vii. Ensure all TCBMPs (i.e., post construction BMPs), as described in the SWMP, are installed and a maintained by the City of Carlsbad. c. Noise Pollution Management Plan i. Define hours of operation and how it compares to City Ordinances ii. Contractor shall Develop and maintain a noise-abatement program and enforce strict discipline over all personnel to keep noise to a minimum. iii. Execute construction work by methods and by use of equipment that will reduce noise and which will provide minimum interference with neighborhood activities. d. Define a procedure for blasting (if applicable). Provide certifications of key persons handling explosivesTree Protection Plan i. Define a plan on how all trees planned to remain on the site will be protected and watered. e. Sustainable Construction Practices i. The City’s intention is to encourage sustainable practices during the construction process without increasing the cost of construction. The Contractor is encouraged to participate in this voluntary program. The contractor shall submit their goals for the following practices and will be responsible for measuring their success. There is no penalty for failing to meet these goals. 1. Provide a plan on purchasing materials from regional sources within 500 miles of the site a. Present a goal for procuring regional material as a percentage of the total material procured for the project b. Track the actual procurement of materials that are regionally provided as compared to the total material procured for the project. 2. Provide a plan for waste and material re-use a. Present a goal for waste material diversion from the landfill as a percentage of the total waste for the project. 2-15-12 Page 4 of 8 Construction Management Plan Guideline
  • 5.
    Alga Norte CommunityPark Contract No. 3837A b. Track the actual waste diverted as compared to the total waste produced by this project. c. Present a plan for handling hazardous waste removal, spill prevention/mitigation, and battery disposal. d. Define standard practices for debris removal at the site. 3. Provide a plan to ensure the indoor air quality for the project is protected 4. Provide a plan on purchasing products with recycled content a. Present a goal for procuring recycled content materials as a percentage of the total materials purchased for the project. b. Track the actual value of the recycled content as compared to all products purchased for the project. 4. Quality Assurance/Quality Control a. QA/QC Plan i. Provide a detailed program to ensure the project’s quality is protected and maintained. ii. Define the testing of the project’s quality. iii. Define the remedy plans for quality that is determined to be inadequate. iv. Define the mock-up plans for any work that is required to have a mock-up provided. v. 2 weeks before starting a new trade, conduct a field pre-construction meeting to verify the subcontractor has the up to date plans, aware of changes, submittal approval status and provides an opportunity to resolve conflicts before the subcontractor is mobilized onsite reducing delays. vi. Cooperate with the Commissioning Agent (Owner’s Representative) vii. Testing and Balancing the HVAC system will be by the Owner. 5. Time Management Plan a. Schedule Control Procedures i. Provide a detailed schedule for the project 1. The General Contractor shall use the Last Planner® (or equal) System of production control for scheduling and planning delivery of the project. All of the following must be part of that system: 2. The Last Planner® (or equal) is a production planning system designed to produce predictable work flow and rapid learning 3. The project team will: a. validate the required CPM schedule with a Milestone schedule developed collaboratively with the City, Construction Manager, and other stakeholders; b. develop appropriate milestones that take those chunks of work that ought to be done and break them into phases; and 2-15-12 Page 5 of 8 Construction Management Plan Guideline
  • 6.
    Alga Norte CommunityPark Contract No. 3837A c. engage in a highly collaborative system of planning the work in those phases with the people who manage the day-to-day assignment of work for that phase (designing the production system). 4. The production plan for each phase must be created using the "pull" technique, starting from the milestone on the right, and working to start of the phase toward the left. 5. The project team will also: a. use a process for look ahead planning (usually 6 weeks) that identifies everything that needs to be in place so that assignments can be made and work can be done as planned; b. use a constraints identification system to ensure quality discussions of "making work ready" and indicates that individuals have made commitments to remove constraints for tasks in future weeks 5 or 6 or beyond; and c. engage in collaborative weekly work planning that determines the tasks that will be done in the following week. 6. Tasks that are completed in the assigned week are measured, averaged each week and represented publicly in a percent plan complete (PPC) trend chart format. 7. Tasks that are not completed are investigated for reasons they were not complete so that we can analyze whether the failure was one-off like weather or sickness on the job or systemic like continual failures of material to be delivered on time. 8. The goals are: a. to have planning reliability substantially in excess of the industry average PPC of 54%; and b. to insure that the PPC measurement is on an upward improving trend. 9. Regular assessments of the team's use of the Last Planner® are to be made to ensure continued improvement of behaviors, process, discipline, tools. 6. Cost Management Plan a. Define the project’s cost control procedures b. Define a Risk Mitigation Plan for the project. Define the specific risks the project may be challenged by and a detailed plan on how to mitigate that risk. c. Define the Contractor Controlled Contingency and a plan on how this can be re-allocated to fund scope increases (Phased Reduction of unused Contractor Controlled Contingency) d. Define the Change Order process including notification requirements e. Define a payment process for progress payments. Include a plan for waiver of lien requirements for subcontractors. 2-15-12 Page 6 of 8 Construction Management Plan Guideline
  • 7.
    Alga Norte CommunityPark Contract No. 3837A 7. Site Management Plan a. Traffic Management Plan i. Provide a plan for traffic that shows approved travel routes to the site 1. This plan should limit or restrict traffic through residential areas 2. Apply for and obtain a permit from the City Engineer for any proposed haul routes. ii. Provide a plan for traffic management for all work that must be completed in the public streets. 1. This plan includes all signage, traffic signals, and police requirements b. Provide a plan for street closures (full and partial) including coordination with the Police Department and Transportation Departments from the City.Site Logistics Plan i. Provide a plan that shows the office trailers, lay-down areas, staging, storage, and worker parking areas. ii. Show how the logistics plan changes, if it needs to change, during the course of the project’s duration. c. Utility Coordination Plan i. Provide a plan on the process for coordination of the various utility agencies required for the project, including meeting attendance, submittals, and permits required to allow the placement of the utilities to the project. d. Project Signage i. Prepare a project information sign per the project’s specifications ii. Provide banners and signage for the ground breaking ceremony iii. Banner signs or other signs promoting the General Contractor or their subcontractors are not permitted. 8. Building Information Modeling (BIM) Plan a. Describe how BIM will be utilized for the project i. Define protocol for design input of team members and who is ultimately accountable for the Model. b. Define utilization of Computerized Maintenance Management System (CMMS) to assist in the maintenance of the project 9. Project Close-out Plan a. Complete the attached matrix showing all of the special inspections, warrantees, training, and all attic stock required for each specification section. b. Per the contract, Final Completion is tied to Substantial Completion. Final Completion must occur 60 days after Substantial Completion. The Liquidated Damages for a delay in 2-15-12 Page 7 of 8 Construction Management Plan Guideline
  • 8.
    Alga Norte CommunityPark Contract No. 3837A Substantial Completion (which is defined as 60 days before Final Completion) shall be in effect if the Final Completion does not occur within 60 days of Substantial Completion c. Provide an electronic version of the Owner’s Manual that contains all of the shop drawing information, operating manuals, warranties, and contact information (authorized repairmen) for each component of the project. d. Provide as-built information to the Architect of Record for producing the Record Drawings for the project, as per the General Conditions. 2-15-12 Page 8 of 8 Construction Management Plan Guideline
