1
April 16, 2014
Ops and Chefs: Lessons learned while working on
OpenStack deployment cookbooks
#chefconf 2014
RACKSPACE® HOSTING | WWW.RACKSPACE.COM
Who Are We?
Justin Shepherd
Principal Architect
Rackspace Private Cloud
github.com/galstrom21
Joseph Breu
Software Dev Team Lead US
Rackspace Private Cloud
github.com/rackerjoe
@rackerjoe
3RACKSPACE® HOSTING | WWW.RACKSPACE.COM

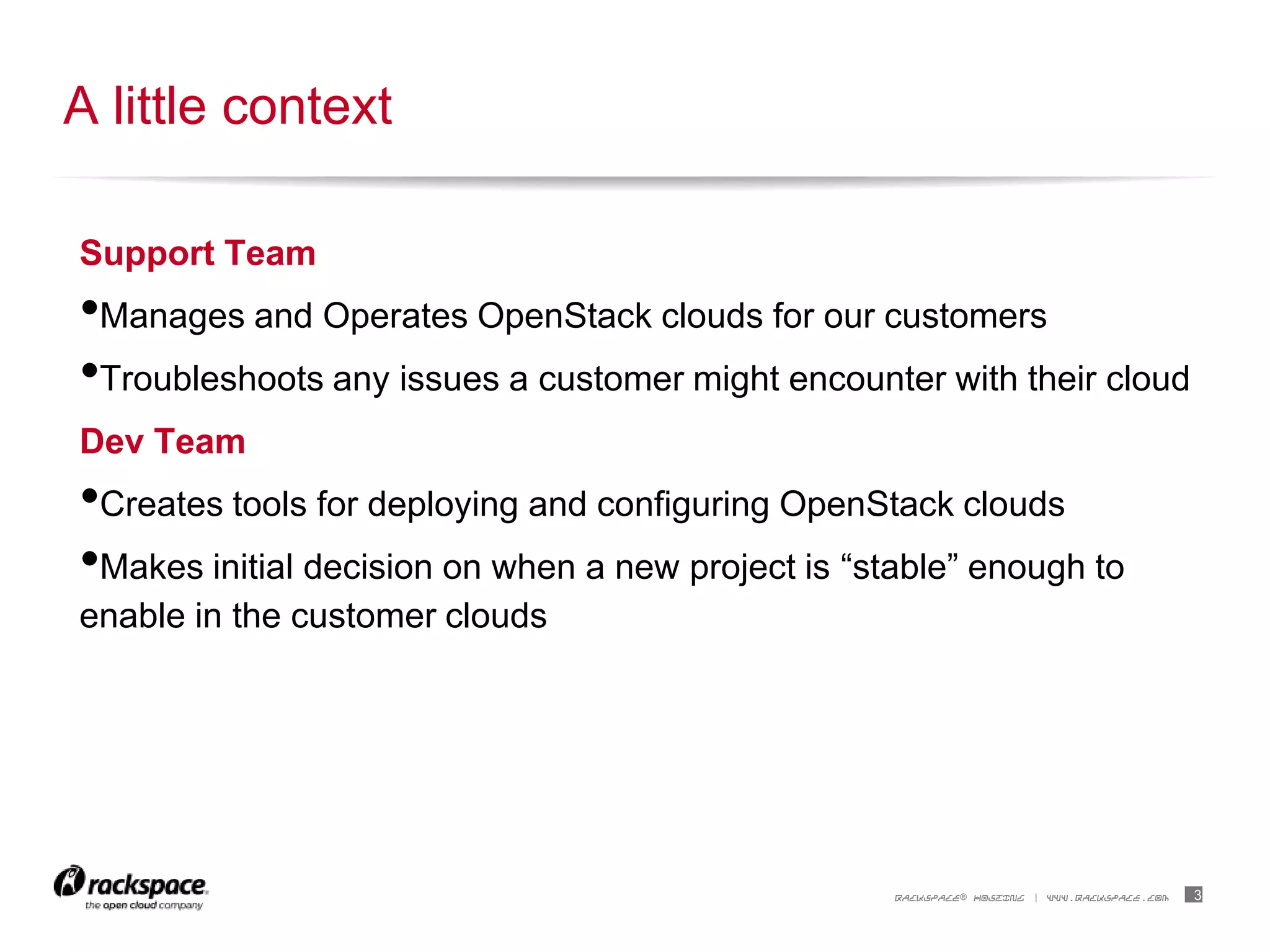

Support Team
•Manages and Operates OpenStack clouds for our customers
•Troubleshoots any issues a customer might encounter with their cloud
Dev Team
•Creates tools for deploying and configuring OpenStack clouds
•Makes initial decision on when a new project is “stable” enough to
enable in the customer clouds
A little context
4RACKSPACE® HOSTING | WWW.RACKSPACE.COM

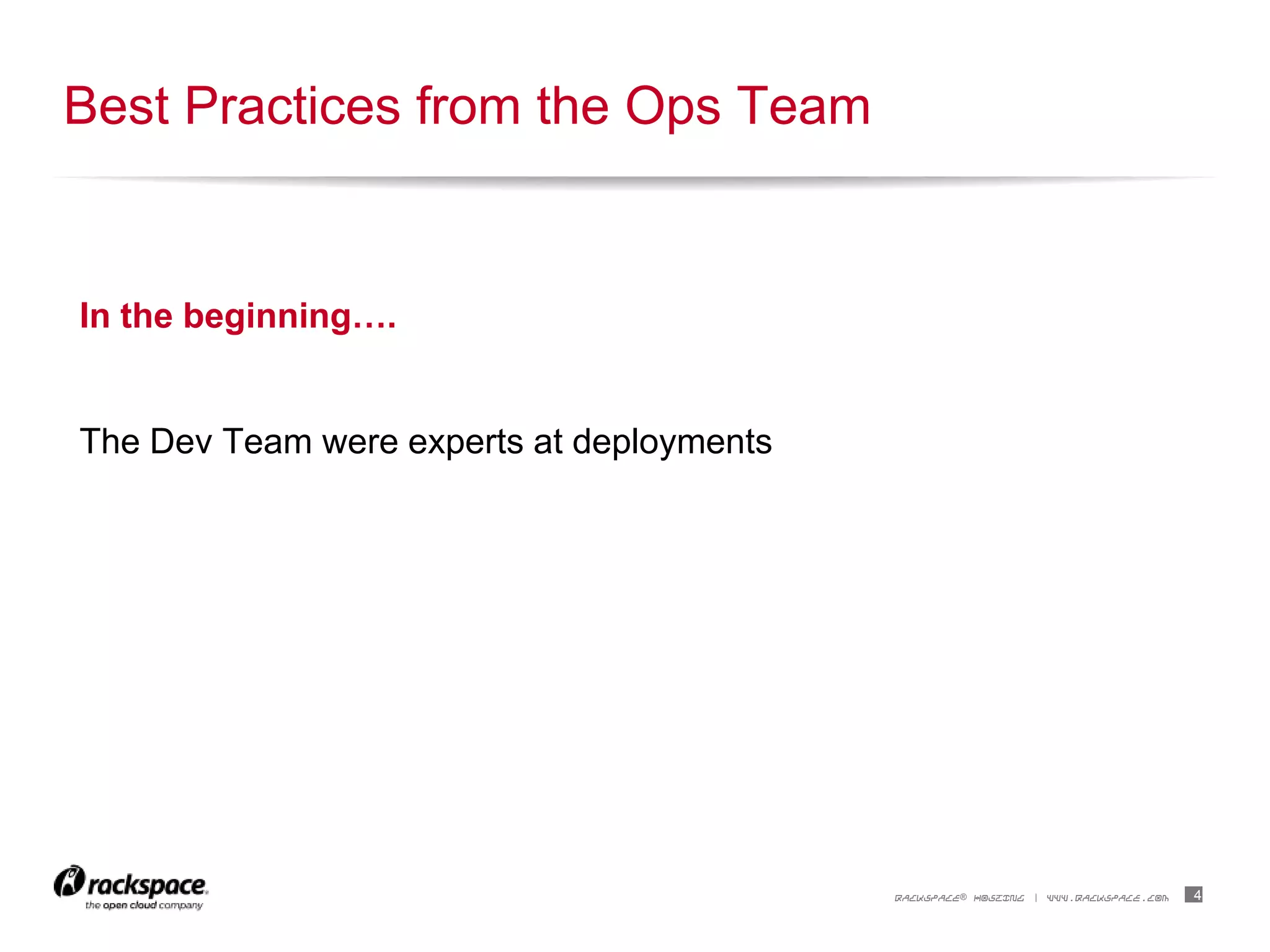

In the beginning….
The Dev Team were experts at deployments
Best Practices from the Ops Team
5RACKSPACE® HOSTING | WWW.RACKSPACE.COM

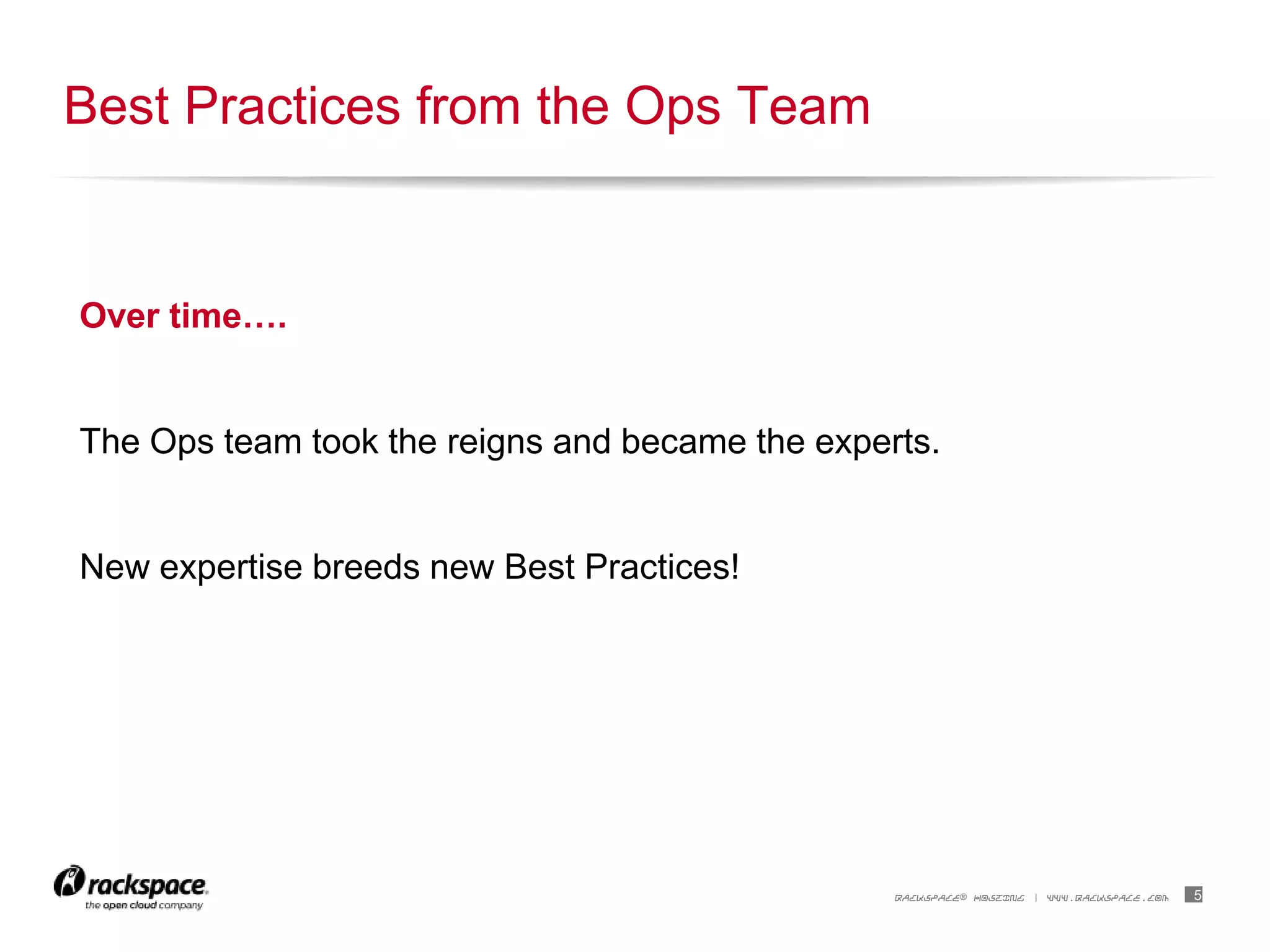

Over time….
The Ops team took the reigns and became the experts.
New expertise breeds new Best Practices!
Best Practices from the Ops Team
6RACKSPACE® HOSTING | WWW.RACKSPACE.COM

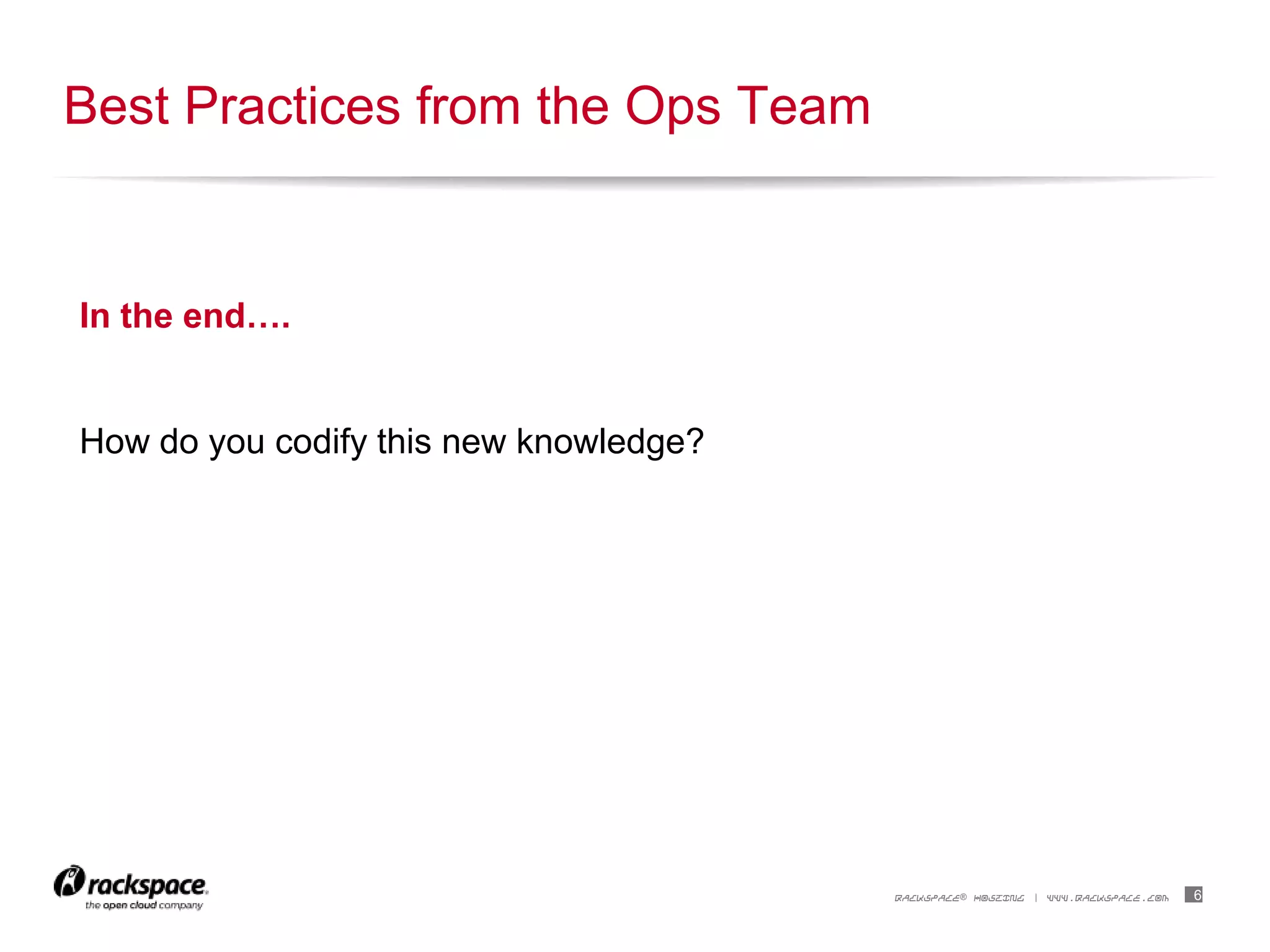

In the end….
How do you codify this new knowledge?
Best Practices from the Ops Team
7RACKSPACE® HOSTING | WWW.RACKSPACE.COM

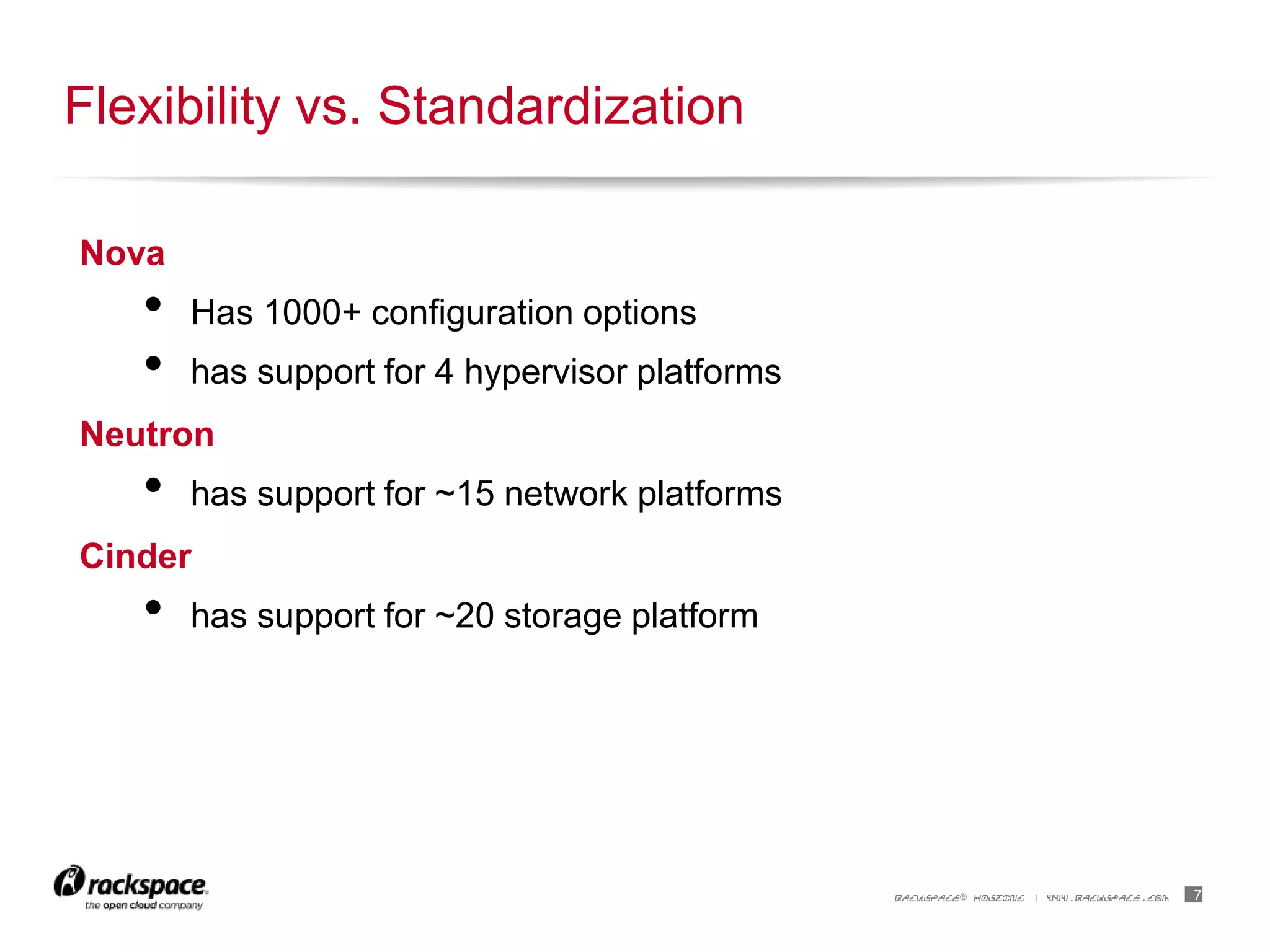

Nova
• Has 1000+ configuration options
• has support for 4 hypervisor platforms
Neutron
• has support for ~15 network platforms
Cinder
• has support for ~20 storage platform
Flexibility vs. Standardization
8RACKSPACE® HOSTING | WWW.RACKSPACE.COM

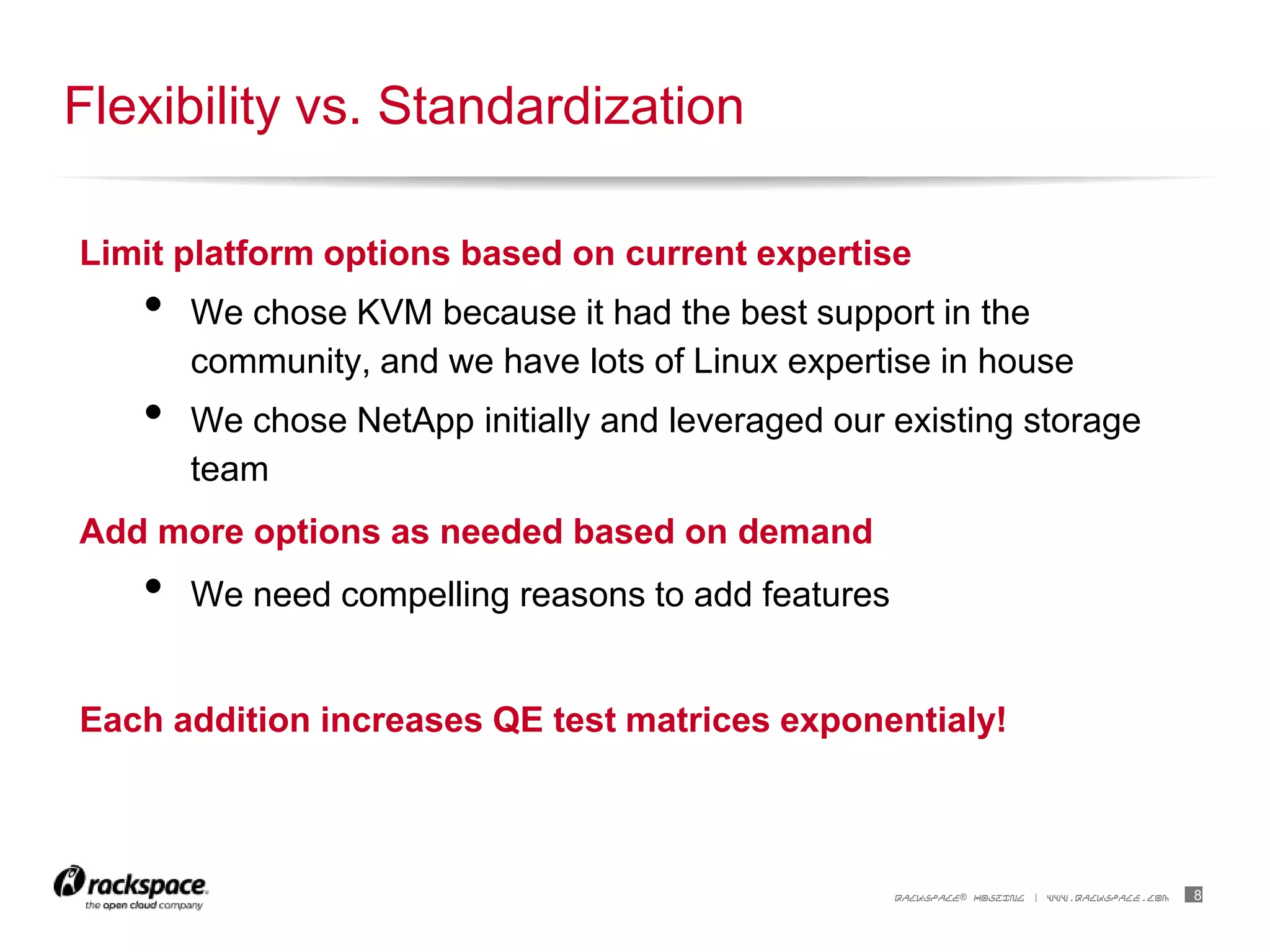

Limit platform options based on current expertise
• We chose KVM because it had the best support in the
community, and we have lots of Linux expertise in house
• We chose NetApp initially and leveraged our existing storage
team
Add more options as needed based on demand
• We need compelling reasons to add features
Each addition increases QE test matrices exponentialy!
Flexibility vs. Standardization
9RACKSPACE® HOSTING | WWW.RACKSPACE.COM

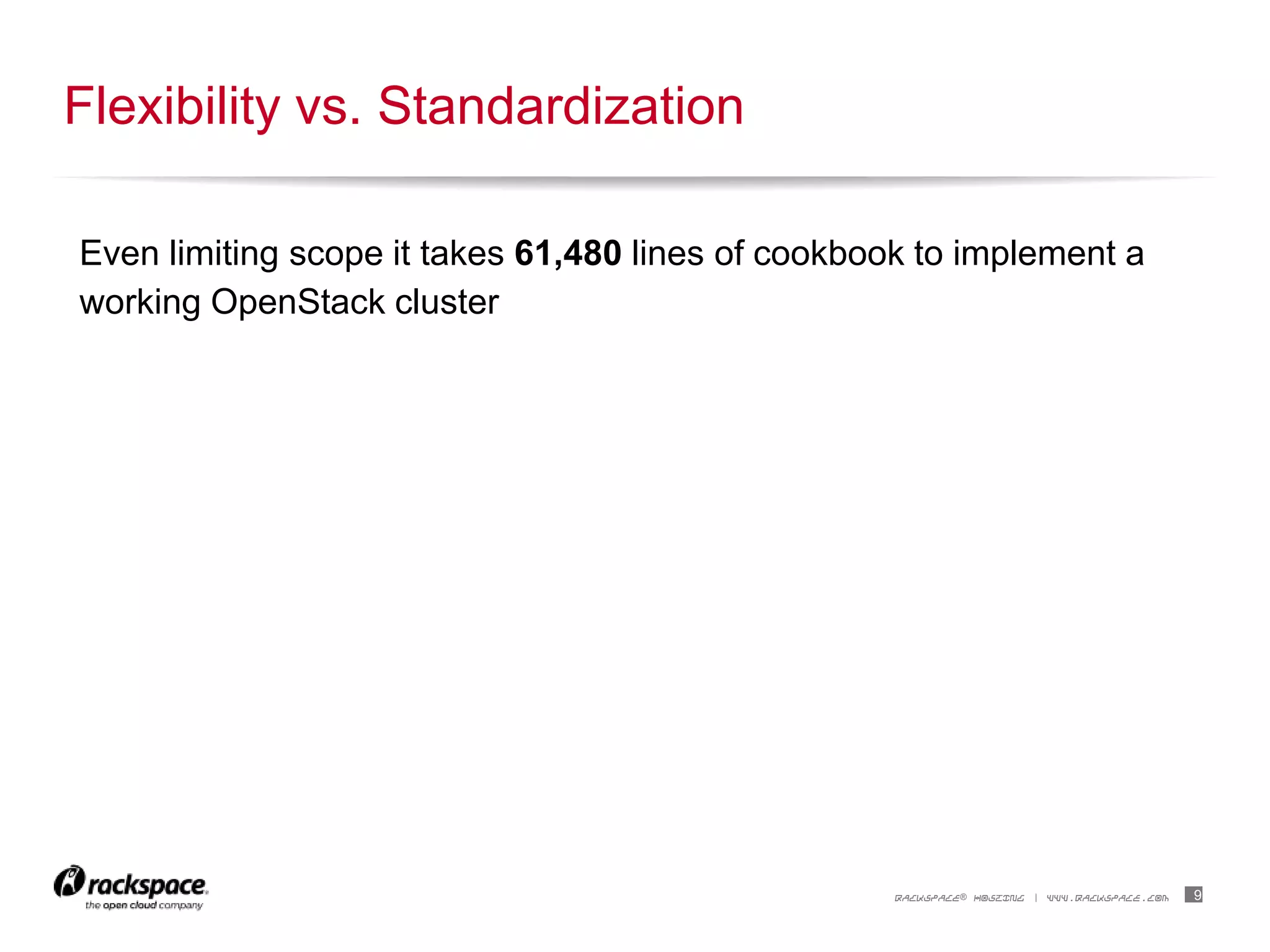

Even limiting scope it takes 61,480 lines of cookbook to implement a
working OpenStack cluster
Flexibility vs. Standardization
10RACKSPACE® HOSTING | WWW.RACKSPACE.COM
Issues with cookbooks
• Setting an incorrect value in nova‟s config file
• Absence of a useful attribute
• Cookbook dependencies and upstream breakage (COOK-2676)
Issues in the upstream OpenStack projects
• Hopefully these are known issues, and the community is addressing them
Issues in the upstream OS packages
• Vendor X breaks a package (i.e. kernel and openvswitch)-where X is all of them!
Issues in foundation technologies
• MySQL
• RabbitMQ

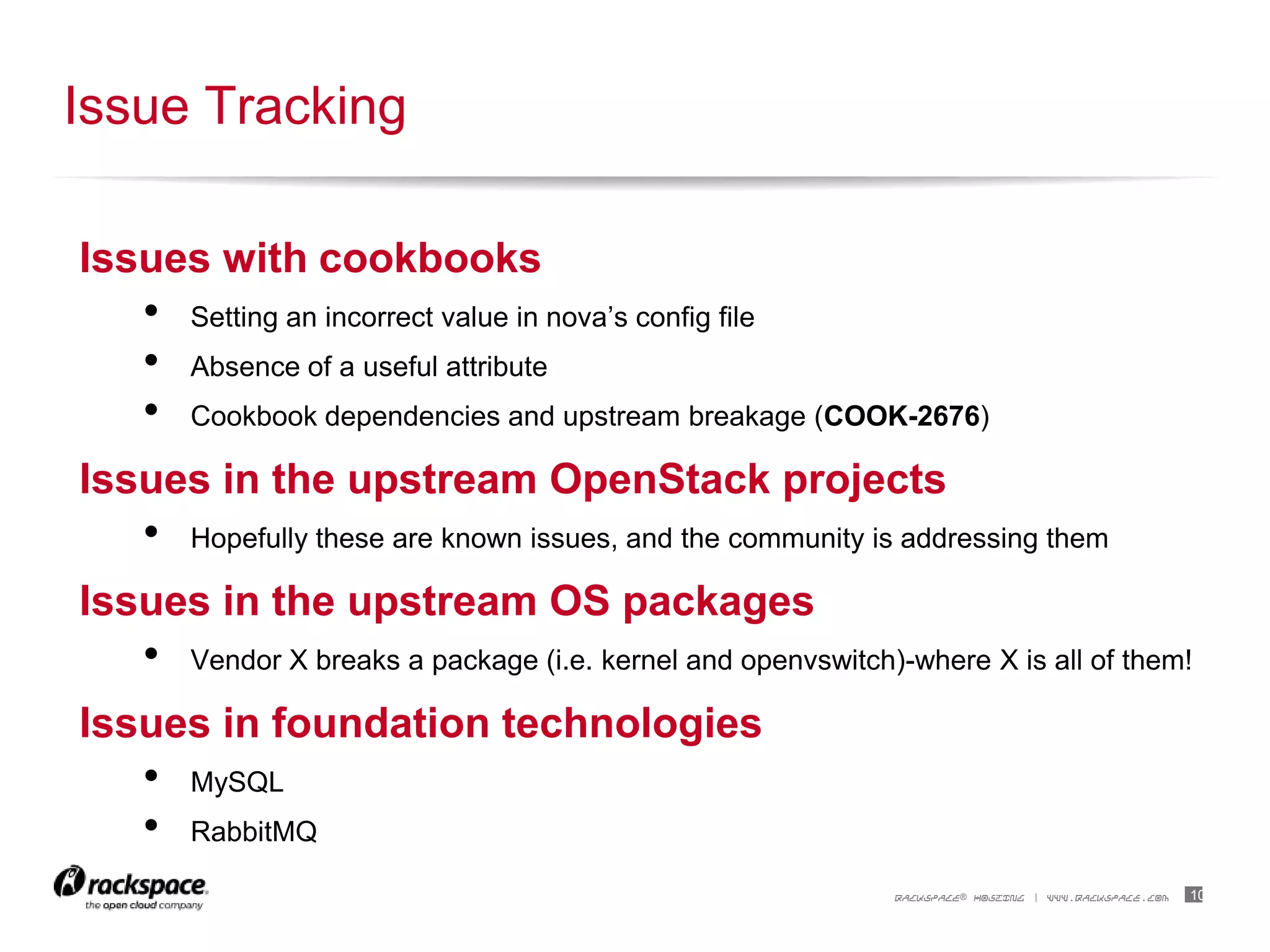

Issue Tracking
11RACKSPACE® HOSTING | WWW.RACKSPACE.COM

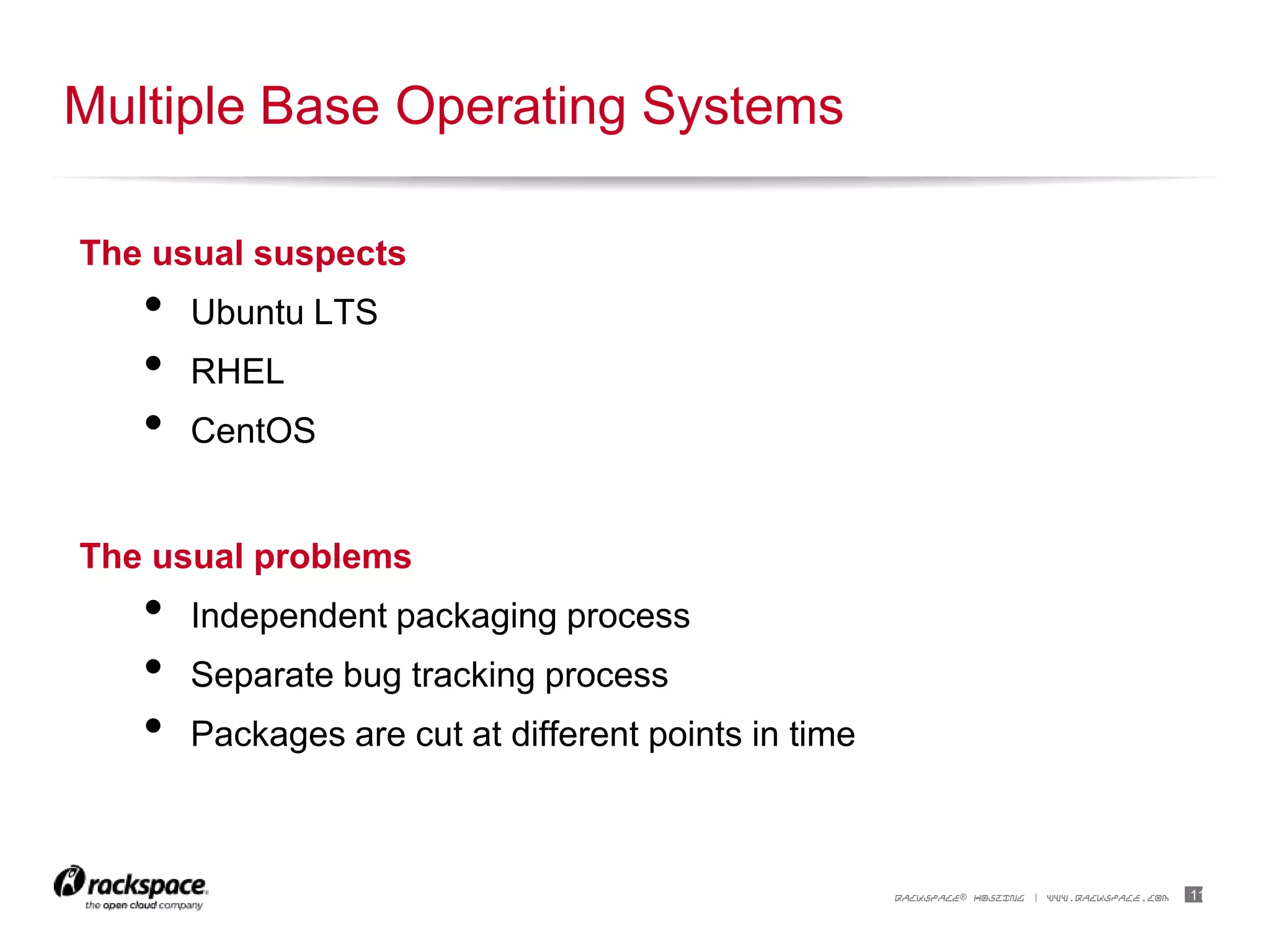

The usual suspects
• Ubuntu LTS
• RHEL
• CentOS
The usual problems
• Independent packaging process
• Separate bug tracking process
• Packages are cut at different points in time
Multiple Base Operating Systems
12RACKSPACE® HOSTING | WWW.RACKSPACE.COM

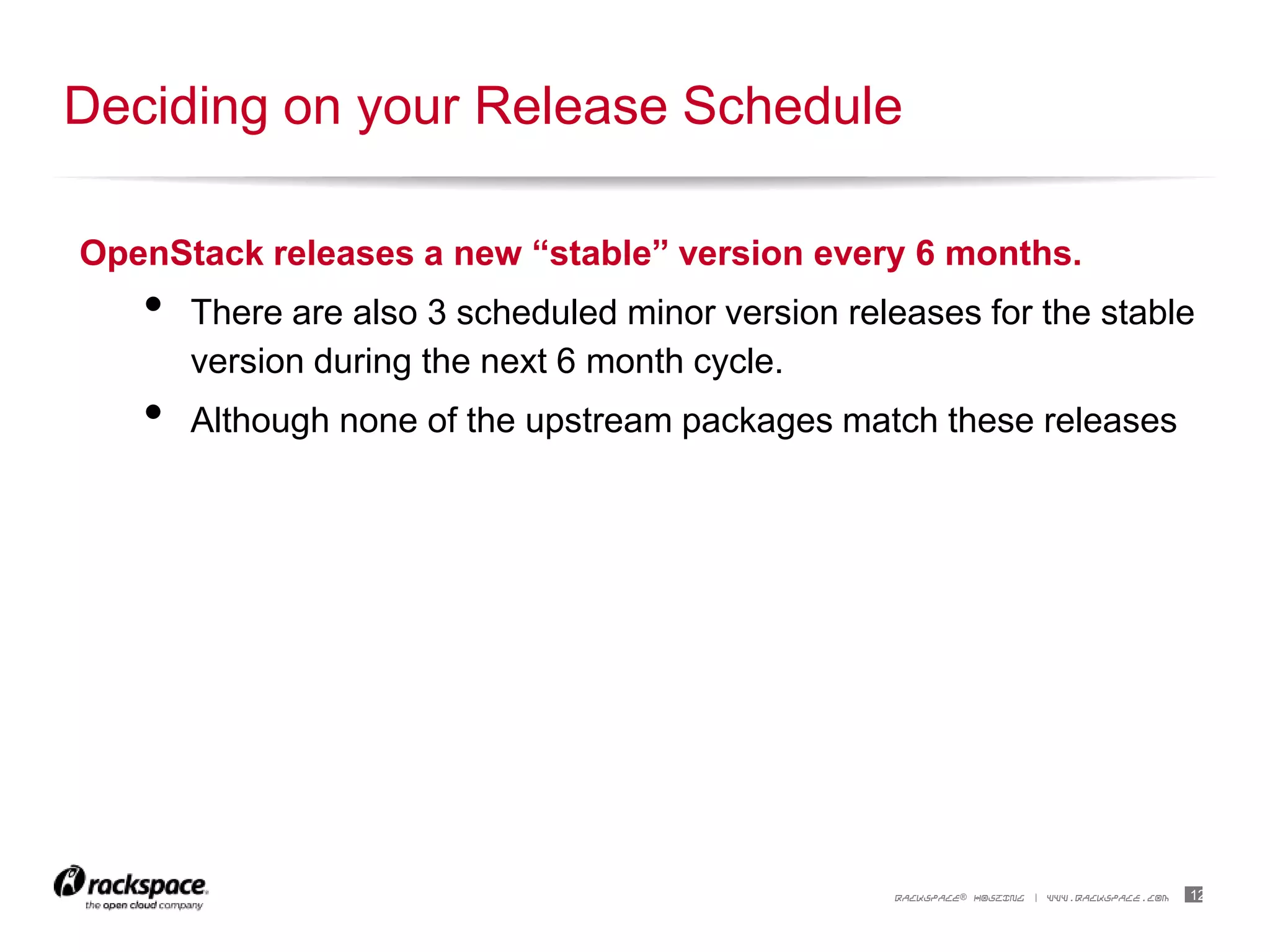

OpenStack releases a new “stable” version every 6 months.
• There are also 3 scheduled minor version releases for the stable
version during the next 6 month cycle.
• Although none of the upstream packages match these releases
Deciding on your Release Schedule
13RACKSPACE® HOSTING | WWW.RACKSPACE.COM

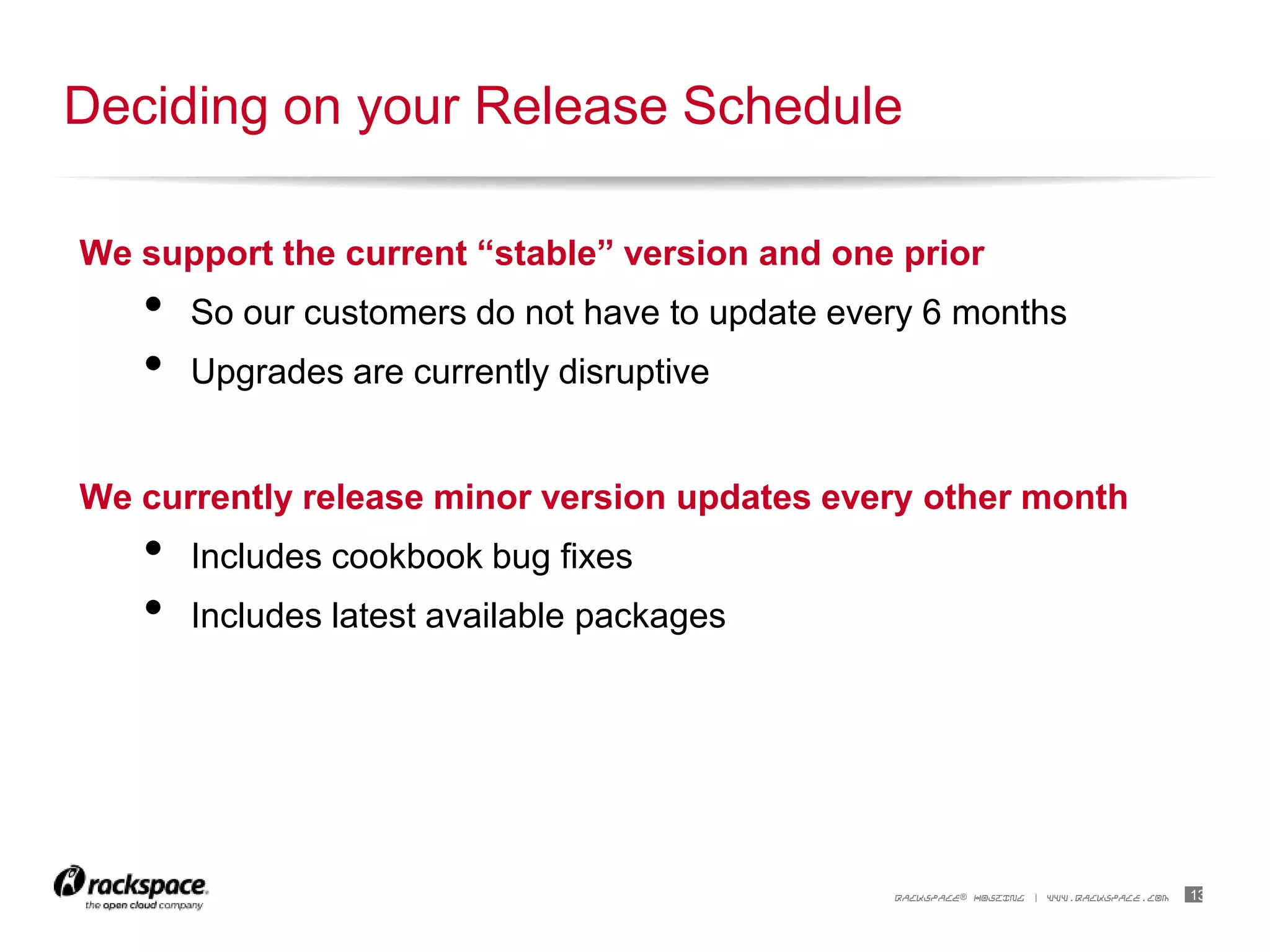

We support the current “stable” version and one prior
• So our customers do not have to update every 6 months
• Upgrades are currently disruptive
We currently release minor version updates every other month
• Includes cookbook bug fixes
• Includes latest available packages
Deciding on your Release Schedule
14RACKSPACE® HOSTING | WWW.RACKSPACE.COM

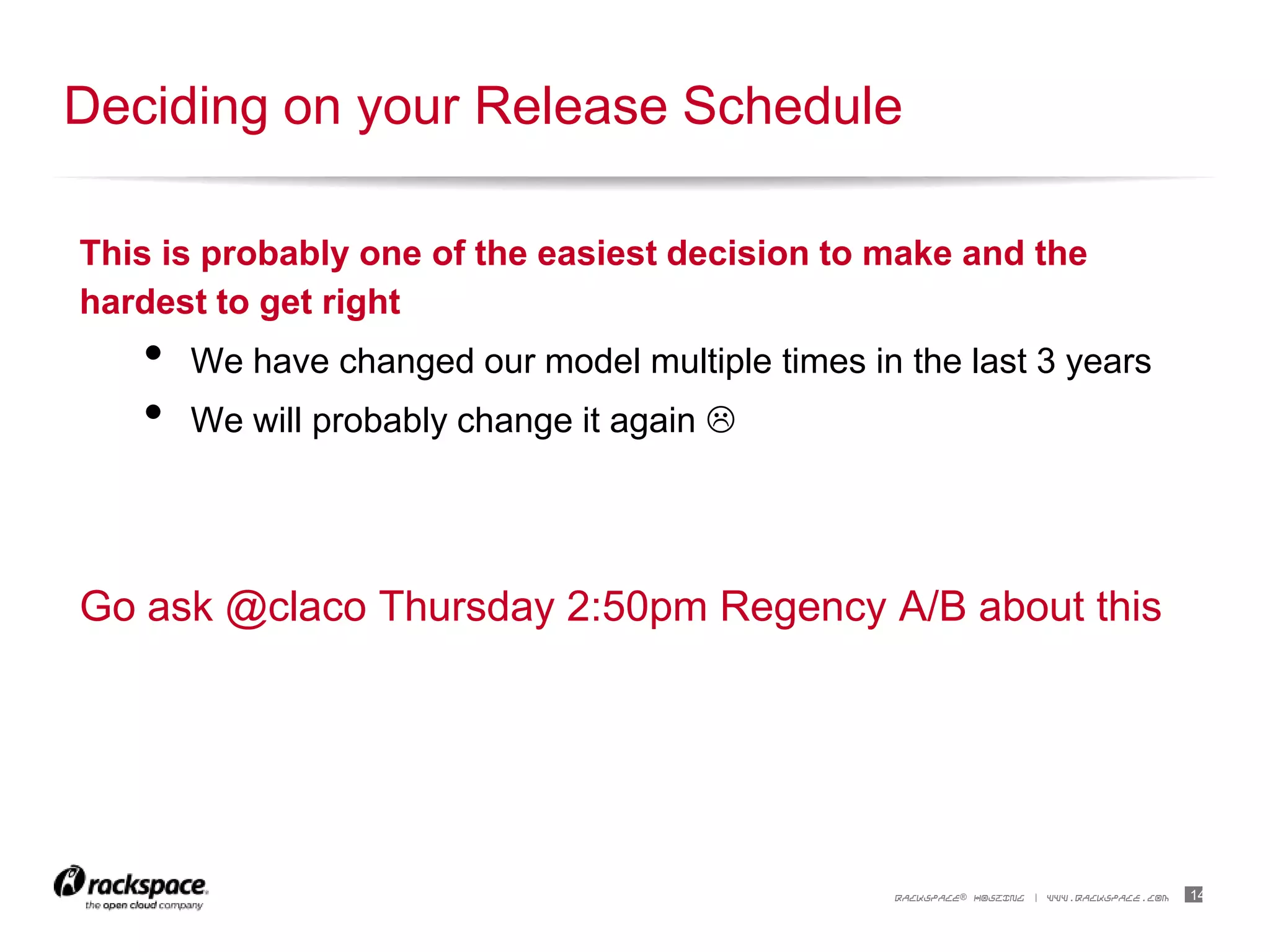

This is probably one of the easiest decision to make and the
hardest to get right
• We have changed our model multiple times in the last 3 years
• We will probably change it again 
Go ask @claco Thursday 2:50pm Regency A/B about this
Deciding on your Release Schedule
15RACKSPACE® HOSTING | WWW.RACKSPACE.COM

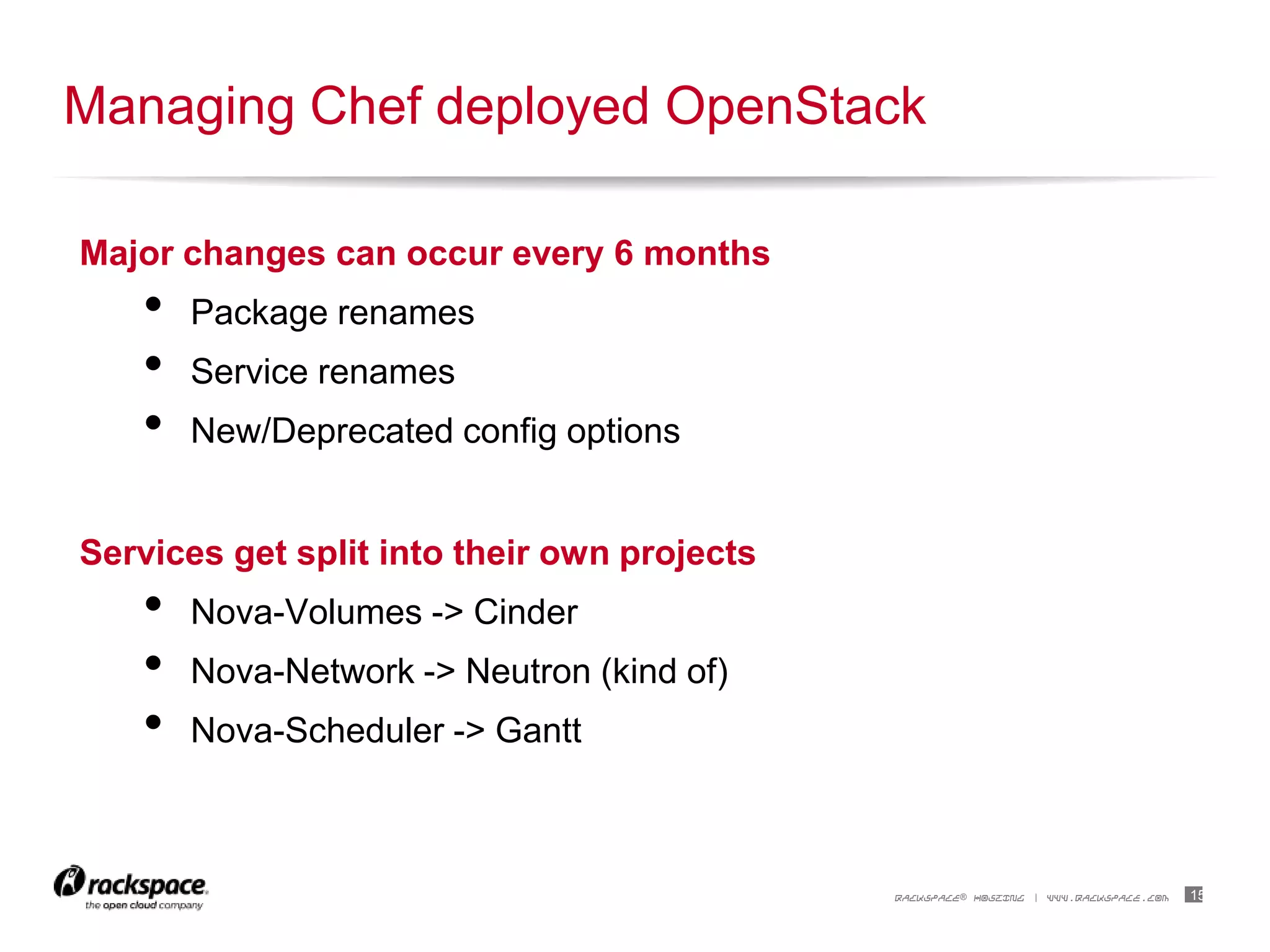

Major changes can occur every 6 months
• Package renames
• Service renames
• New/Deprecated config options
Services get split into their own projects
• Nova-Volumes -> Cinder
• Nova-Network -> Neutron (kind of)
• Nova-Scheduler -> Gantt
Managing Chef deployed OpenStack
16RACKSPACE® HOSTING | WWW.RACKSPACE.COM

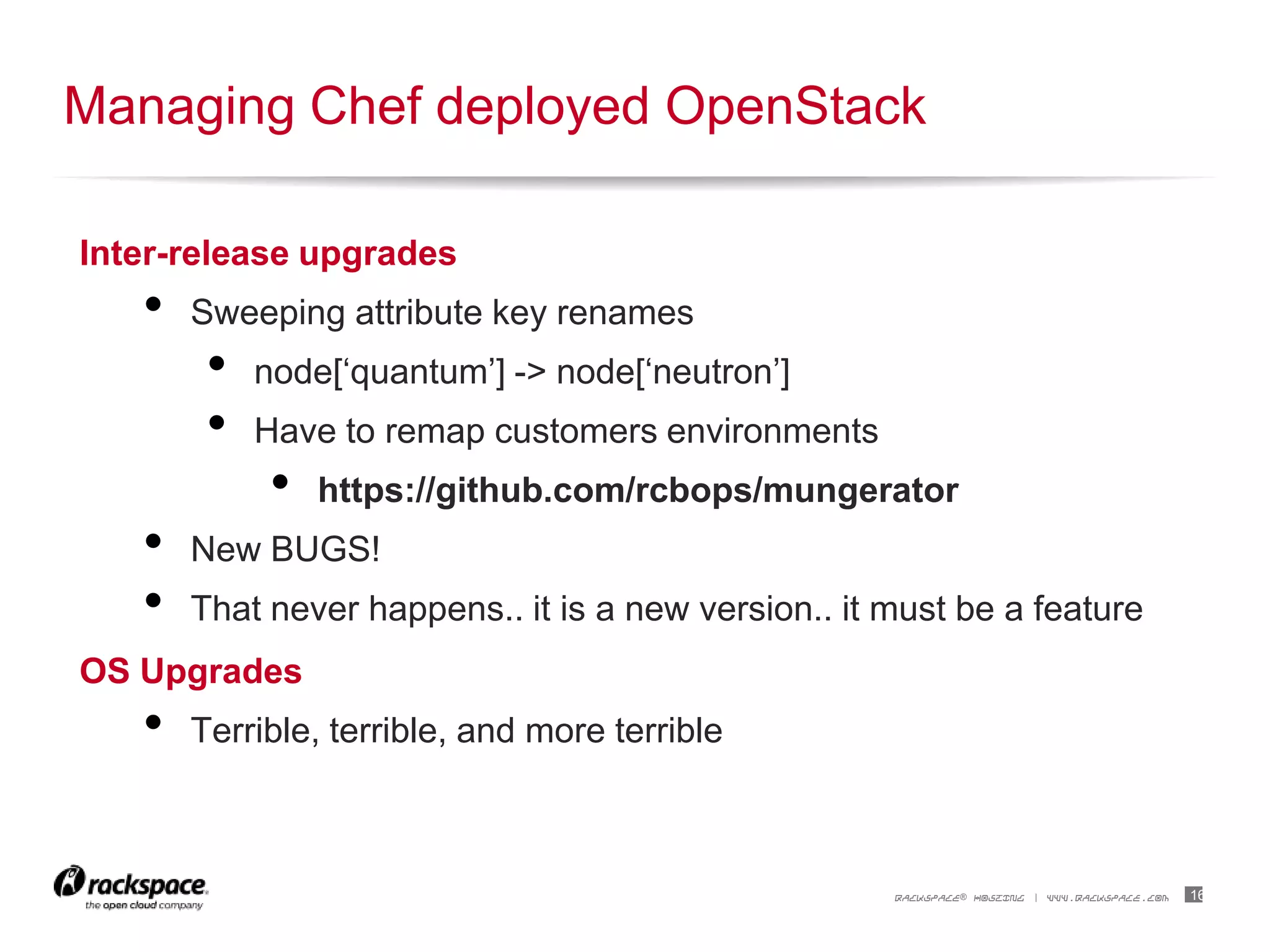

Inter-release upgrades
• Sweeping attribute key renames
• node[„quantum‟] -> node[„neutron‟]
• Have to remap customers environments
• https://github.com/rcbops/mungerator
• New BUGS!
• That never happens.. it is a new version.. it must be a feature
OS Upgrades
• Terrible, terrible, and more terrible
Managing Chef deployed OpenStack
17RACKSPACE® HOSTING | WWW.RACKSPACE.COM

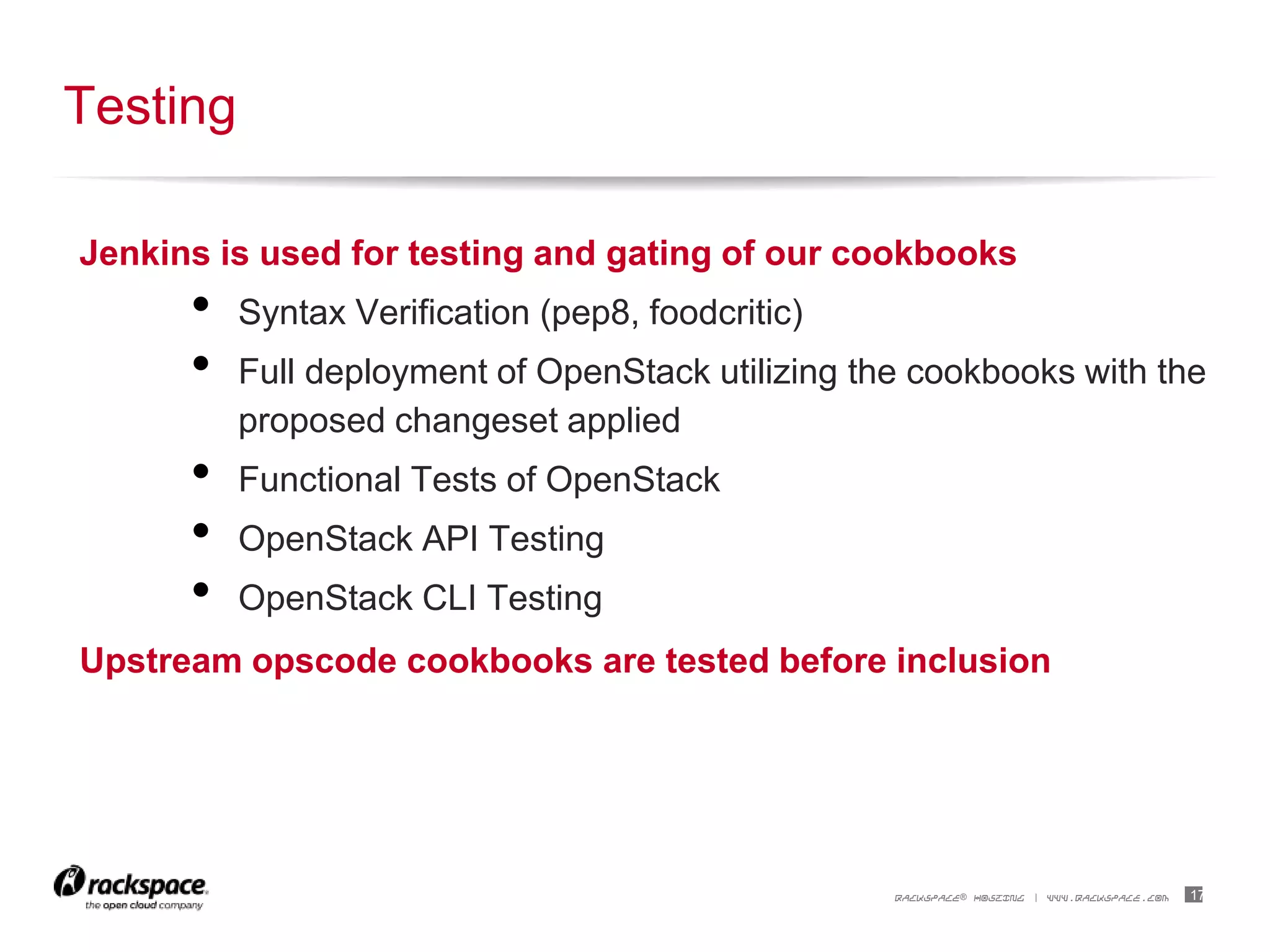

Jenkins is used for testing and gating of our cookbooks
• Syntax Verification (pep8, foodcritic)
• Full deployment of OpenStack utilizing the cookbooks with the
proposed changeset applied
• Functional Tests of OpenStack
• OpenStack API Testing
• OpenStack CLI Testing
Upstream opscode cookbooks are tested before inclusion
Testing
1818
RACKSPACE® HOSTING | 5000 WALZEM ROAD | SAN ANTONIO, TX 78218
US SALES: 1-800-961-2888 | US SUPPORT: 1-800-961-4454 | WWW.RACKSPACE.COM
RACKSPACE® HOSTING | © RACKSPACE US, INC. | RACKSPACE® AND FANATICAL SUPPORT® ARE SERVICE MARKS OF RACKSPACE US, INC. REGISTERED IN THE UNITED STATES AND OTHER COUNTRIES. | WWW.RACKSPACE.COM
QUESTIONS?
