CGC CONSTRUCTIONS
  (INDIA) PVT. LTD.
COMPANY PROFILE
CGC Constructions (India) Pvt. Ltd. is a part of the Choice Group of
Companies USA, which is a leading company, offering services and
solutions to major Telecom Carriers in USA and India. CGC’s
consolidated Global revenues for FY 20010-11 ending December 31,
2011 stood at (USD) $57 million. CGC aims at providing single window
solution to all infrastructural requirements of Telecom service providers.
CGC is emerging as turnkey service provider in telecom industry.
Headquartered at New York, Group stretching wings in India , Hong
Kong , Dubai, China and South America.
We are professionally managed group, and are providing supply and
services like Project Management Services, Civil and Electrical works,
OFC route construction, Call Center/Contact Center, Operations &
Maintenance (All Type), Shelter & DG Supply and Installation, Intelligent
Power Supply unit, Site Acquisition, BTS Microwave projects installation
and Commissioning etc., and are willing to work for forth coming projects
of telecom operators in PAN India.

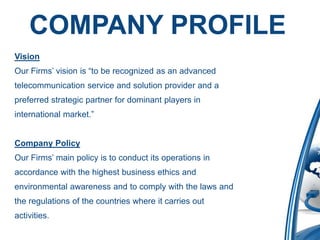

COMPANY PROFILE
Vision
Our Firms’ vision is “to be recognized as an advanced
telecommunication service and solution provider and a
preferred strategic partner for dominant players in
international market.”


Company Policy
Our Firms’ main policy is to conduct its operations in
accordance with the highest business ethics and
environmental awareness and to comply with the laws and
the regulations of the countries where it carries out
activities.
COMPANY PROFILE

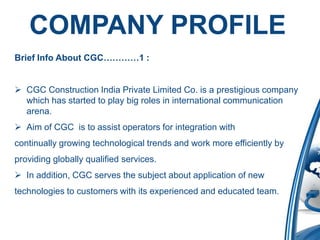

Brief Info About CGC…………1 :


 CGC Construction India Private Limited Co. is a prestigious company
  which has started to play big roles in international communication
  arena.
 Aim of CGC is to assist operators for integration with
continually growing technological trends and work more efficiently by
providing globally qualified services.
 In addition, CGC serves the subject about application of new
technologies to customers with its experienced and educated team.
COMPANY PROFILE
Brief Info About CGC…………2 :
•   CGC offers high quality services that can feed the responses and
    fulfill the prospects of companies in Telecom sector.


•   CGC is able to provide turnkey solutions to customers by its
    experienced and professional stuff.


•   CGC carries out mobile network deployments and network support
    for operators by providing maintenance services and turnkey
    projects deployment in the field of both mobile and fixed line
    telecommunication market.


•   CGC is an engineering and technology-based company, which provides
    customers with advanced telecommunications network products and services,
    which are highly reliable and value for money.

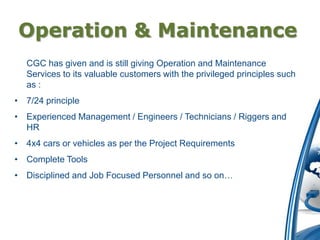

Operation & Maintenance
  CGC has given and is still giving Operation and Maintenance
  Services to its valuable customers with the privileged principles such
  as :
• 7/24 principle
• Experienced Management / Engineers / Technicians / Riggers and
  HR
• 4x4 cars or vehicles as per the Project Requirements
• Complete Tools
• Disciplined and Job Focused Personnel and so on…

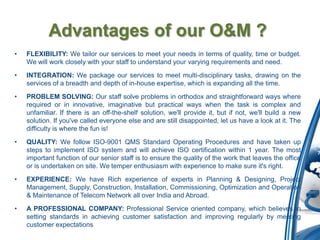

Advantages of our O&M ?
•   FLEXIBILITY: We tailor our services to meet your needs in terms of quality, time or budget.
    We will work closely with your staff to understand your varying requirements and need.

•   INTEGRATION: We package our services to meet multi-disciplinary tasks, drawing on the
    services of a breadth and depth of in-house expertise, which is expanding all the time.
•   PROBLEM SOLVING: Our staff solve problems in orthodox and straightforward ways where
    required or in innovative, imaginative but practical ways when the task is complex and
    unfamiliar. If there is an off-the-shelf solution, we'll provide it, but if not, we'll build a new
    solution. If you've called everyone else and are still disappointed, let us have a look at it. The
    difficulty is where the fun is!

•   QUALITY: We follow ISO-9001 QMS Standard Operating Procedures and have taken up
    steps to implement ISO system and will achieve ISO certification within 1 year. The most
    important function of our senior staff is to ensure the quality of the work that leaves the office
    or is undertaken on site. We temper enthusiasm with experience to make sure it's right.

•   EXPERIENCE: We have Rich experience of experts in Planning & Designing, Project
    Management, Supply, Construction, Installation, Commissioning, Optimization and Operation
    & Maintenance of Telecom Network all over India and Abroad.

•   A PROFESSIONAL COMPANY: Professional Service oriented company, which believes in
    setting standards in achieving customer satisfaction and improving regularly by meeting
    customer expectations
Advantages of our O&M ?
•   MANPOWER: We have a large pool of talented and trained Manpower at disposal.
    Training is provided to our Manpower on regular intervals basing on customer Enquiry in
    order to enhance his services to the customers. We encourage employees to put forward
    their new ideas in the challenging Industry. We encourage a work environment
    characterized by respect for the individual, a strong work ethics and client empathy. All
    individuals who work, putting forth their unique blend of talent, enthusiasm and ambition
    are the reasons that we are continued to be recognized for quality at on-time

•   CAPABILITY: We undertook several projects and executed successfully in stipulated time
    frames set forth thereby customer satisfaction result in achieving the growth and expansion
    of our wings at various levels.

•   Single Point of Contact: We are offering free and 24*7, a most unique and valuable
    service for data maintenance, tracking & movement of vehicles, SLA time monitoring
    and secure data by providing single point of contact center (Complaint and Solution
    remedial).

•   GPS Devices: All vehicle used in operations business will be equipped with latest
    GPS system to locate and monitor there movement.
BTS Cell Site Maintenance
Scope broadly covers the Maintenance of below mentioned Telecom Infrastructure:-

BTS (Base Transceiver Station)       Shelters
Diesel Generator Engine              Cables
Diesel Generator Alternator          Lightning Arrester
PMU (Power Management Unit)          Aviation Lamp(s)
Fire Alarm System                    AC & DC Power Supplies
Electrical Installation              Mobile DG Services
Batteries                            Fire Extinguishers
Integrated Panel                     Tower / Mast / Pole
Air Conditioner Unit(s)              Earth Pits
BTS Cell Site Maintenance
Scope covers the measurements and necessary corrective actions as
Mentioned below:-
•   Radiation Power Measurement
•   Voltage Standing Wave Ratio (VSWR) Measurement for RF feeder cables
•   Verification and correction of Connectorization of RF / IF cables
•   Validation of antennae orientations and correction if any required
•   Verification, Upgradation / replacement of cards / devises
•   Firmware / hardware modification for cards / devises locally
Tower Maintenance
Scope of Work for Tower Maintenance
 l. No..                       Item                                                Work Involved

   1       Aviation Lamp                                Checking of Aviation Lamp




           Feeder & power cables between RR station &   Checking cables and couplings for breakage, loose fittings, other
   2
           Tower                                        faults and replacing /rectifying the same




                                                        Checking for any possible antenna faults, dismounting if faulty and
   3       Antenna
                                                        mounting the repaired new antenna




   4       Antenna Alignment                            Checking for Antenna misalignment and correcting the same




   5       Physical checking of Telecom Towers          Checking of correct torque of nut bolts & replacing if any faulty
O&M SERVICES
Diesel Filling, Electricity Bill and Rent Payments
• We will provide Diesel Fillers so as to ensure the
  availability of 70% of HSD in the DG tank at any point of
  time
• Proper Co-ordination with EB (Electricity Board) for timely
  collection of Electricity bills, Collection of payments for the
  same from the customer's office and timely deposit of the
  payments at the respective EBs
• The same activity will be carried out for rent payments if
  any tenants demands
Preventive and Corrective Maintenance Services


 Fault Remedy Activity is the most critical service which should be done in a very
  professional manner.
 Being aware of this, CGC can offer the Operation and Maintenance Services for
  following network elements and might be more depending on the customer
  requirements and SOW.
 All measurements for preventive maintenance shall be carried out as per prior
  agreed time schedule, which is given by the Customer.
 While Monitoring at BTS Cell Sites the site reports shall be prepared and reports
  shall be submitted to costumer CI . Any defects observed in the BTS Sites in any
  of the associated equipment shall be attended in consultation with the Customer
  Eng at site. During every visit to the site for measurements, shall monitor the
  condition of the optical equipments installed for any alarms, DG maintenance,
  Diesel Filling, First level maintenance for DG, AMF Panel, SMPS, Fire Alarms
  Systems, PIU follow up for alarms, order wire, battery voltage, level of distilled
  water in the secondary cells, top up distilled water if required and observe the
  condition of the battery charger and electrical installation of the prefabs / building
  and report to CI in case any discrepancies are observed.

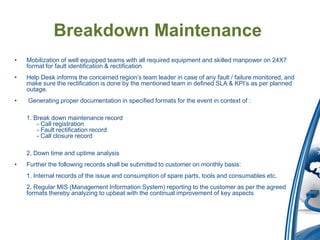

Breakdown Maintenance
•   Mobilization of well equipped teams with all required equipment and skilled manpower on 24X7
    format for fault identification & rectification
•   Help Desk informs the concerned region’s team leader in case of any fault / failure monitored, and
    make sure the rectification is done by the mentioned team in defined SLA & KPI’s as per planned
    outage.
•   Generating proper documentation in specified formats for the event in context of :

    1. Break down maintenance record
        - Call registration
        - Fault rectification record
        - Call closure record

    2. Down time and uptime analysis
•   Further the following records shall be submitted to customer on monthly basis:
    1. Internal records of the issue and consumption of spare parts, tools and consumables etc.
    2. Regular MIS (Management Information System) reporting to the customer as per the agreed
    formats thereby analyzing to upbeat with the continual improvement of key aspects
Outage Analysis
Detailed outage analysis to be carried out on daily basis as per the specified format:
1.         Sr. No
2.        Date Site Identification
3.        Location
4.        No of Operator s
5.        Outage start time
6.        Outage end time
7.        Duration (In Minutes)
8.        Reason of Outage
9.        Action Taken
10.       Who's Responsible (Technician's Name)
11.       Field Report
12.       Remarks

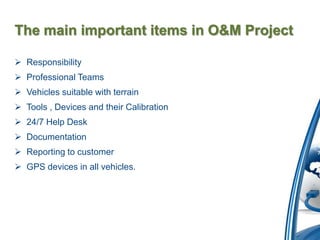

The main important items in O&M Project

 Responsibility
 Professional Teams
 Vehicles suitable with terrain
 Tools , Devices and their Calibration
 24/7 Help Desk
 Documentation
 Reporting to customer
 GPS devices in all vehicles.
Main Tools List
•   Portable Laptops
•   Site Master
•   Multi Meter
•   Optical power meter
•   Portable tool kits.
•   Camera (Digital)
•   Safety belts.
•   Required software (Vendor Specific).
•   Dust cleaners
•   Cable cutters
•   Special tool to make IF connectors
•   GPS
•   Cell Site Health Check
•   All the other necessary equipments and tools necessary to perform the project.
Documentation
• All the records including ( Alarms, Screen shots, panoramic, event
  logs ) collected by Corrective and/or Preventive maintenance teams
  will be forwarded to O&M Manager. And O&M Manager will be
  responsible for forwarding these information/reporting to customer on
  weekly basis and the frequency of the reporting can even be
  arranged as per the customer requirements.
• All the spare parts will be recorded by Warehouse Responsible and
  will report to O&M Manager by proper inventory reports.
• MIS will prepare their own daily reports and send to O & M Manager
  on daily basis. Therefore, O&M Manager also will be aware for any
  issue and will have the opportunity to be under service at any time for
  the customer and/or its representatives.
Reporting to Customer
• Routine reports to be sent to the customer in hourly / daily / weekly /
  monthly basis
• Routine reports for diesel supply according to CPH to be sent to the
  customer in daily / weekly / monthly basis
• Separate record will be maintained for abnormalities exceeding the
  SLA if any.
   NOTE : Reporting frequency can be arranged as per the
   customer needs.
Warehousing & Logistics
• All electronic equipments used in the projects, are stored on the
  proper shelves and suitable air conditioned environment for
  protection from humidity, extremely hot weather etc…
• All electronic equipments are transferred/transported to the sites with
  their original packs or antistatic bags.
• Warehouse Stock Management and Inventory Control is regularly
  monitored. The delivery reports are arranged for any kind of material
  coming in or going out and the necessary track database is strictly
  followed by Warehouse / Logistic Manager.
Outage –Escalation Matrix

         Escalation Matrix – Outage
                      0-hours   2-hours      4-hours
                                Technical
            Info       Sup                  OME-Head
                                Manager
Alarms
                                            Technical
         Escalation    Tech       Sup
                                            Manager
OME Team (1000 Sites)
                                       OME Head
                                     8 – 10 Yrs Exp


                                          ZOM
                                     5 – 7 Yrs Exp.


               Asst Manager                                Asst Manager
                                      MIS & Estate
                 Electrical                                  Electrical
                                       Manager
                 Engineer                                    Engineer

                                CI / Supervisors x 10**

                               Field Technicians x 100*
Note :- * Per Field Technicians on 8 – 10 Sites and will Amend as per Site Allotment
       ** Per CI / Supervisor on 8-10 Technicians
        Above Calculation on 1000 Sites.
Patrons
Patrons
Management
–   Mr. Sidharth Kumar , CEO and Managing Director

    MBA

    Worked with Cincom Systems India Pvt. Ltd.

    7 years + in Telecom industry in India



–   Mr. Devendra Kumar Gupta

    Advisor, Finance & Corporate Planning

    Over 15 years in Finance Sector, etc



–   Mr. Ashutosh Mani Tripathi, Head of Operations

    MBA

    5+ years in Telecom industry in India



–   Mr. Shailesh Kumar, Sr. Manager - Commercial & Business

    B.Com , MBA

    5+ years in Telecom industry in India
Contact US :
CGC CONSTRUCTIONS (INDIA) PRIVATE LIMITED

                                  Corporate Office
                           CGC Constructions India Pvt. Ltd.
                   E-171, Sector - 63, / Noida –201301,U.P. , India.
       Tel: +91 (0) 120 42 849 81 , 82 , 83 , 84 / Fax: +91 (0)120 42 849 85
           E-Mail: enquiry@cgcindia.com / URL : www.cgcindia.com

                                           Circle Offices :-

  Delhi (NCR), UP-E, UP-W , Bihar , Jharkhand , Himachal , Punjab & Haryana, Rajasthan & West Bengal

                                        Up Coming Circle Offices

                            Gujarat & Maharashtra (Including ROM & Goa)
CGC CONSTRUCTIONS (INDIA) PRIVATE LIMITED




    Thank You

CGC OME Presentation

  • 1.
    CGC CONSTRUCTIONS (INDIA) PVT. LTD.
  • 2.
    COMPANY PROFILE CGC Constructions(India) Pvt. Ltd. is a part of the Choice Group of Companies USA, which is a leading company, offering services and solutions to major Telecom Carriers in USA and India. CGC’s consolidated Global revenues for FY 20010-11 ending December 31, 2011 stood at (USD) $57 million. CGC aims at providing single window solution to all infrastructural requirements of Telecom service providers. CGC is emerging as turnkey service provider in telecom industry. Headquartered at New York, Group stretching wings in India , Hong Kong , Dubai, China and South America. We are professionally managed group, and are providing supply and services like Project Management Services, Civil and Electrical works, OFC route construction, Call Center/Contact Center, Operations & Maintenance (All Type), Shelter & DG Supply and Installation, Intelligent Power Supply unit, Site Acquisition, BTS Microwave projects installation and Commissioning etc., and are willing to work for forth coming projects of telecom operators in PAN India.
  • 3.
    COMPANY PROFILE Vision Our Firms’vision is “to be recognized as an advanced telecommunication service and solution provider and a preferred strategic partner for dominant players in international market.” Company Policy Our Firms’ main policy is to conduct its operations in accordance with the highest business ethics and environmental awareness and to comply with the laws and the regulations of the countries where it carries out activities.
  • 4.
    COMPANY PROFILE Brief InfoAbout CGC…………1 :  CGC Construction India Private Limited Co. is a prestigious company which has started to play big roles in international communication arena.  Aim of CGC is to assist operators for integration with continually growing technological trends and work more efficiently by providing globally qualified services.  In addition, CGC serves the subject about application of new technologies to customers with its experienced and educated team.
  • 5.
    COMPANY PROFILE Brief InfoAbout CGC…………2 : • CGC offers high quality services that can feed the responses and fulfill the prospects of companies in Telecom sector. • CGC is able to provide turnkey solutions to customers by its experienced and professional stuff. • CGC carries out mobile network deployments and network support for operators by providing maintenance services and turnkey projects deployment in the field of both mobile and fixed line telecommunication market. • CGC is an engineering and technology-based company, which provides customers with advanced telecommunications network products and services, which are highly reliable and value for money.
  • 6.
    Operation & Maintenance CGC has given and is still giving Operation and Maintenance Services to its valuable customers with the privileged principles such as : • 7/24 principle • Experienced Management / Engineers / Technicians / Riggers and HR • 4x4 cars or vehicles as per the Project Requirements • Complete Tools • Disciplined and Job Focused Personnel and so on…
  • 7.
    Advantages of ourO&M ? • FLEXIBILITY: We tailor our services to meet your needs in terms of quality, time or budget. We will work closely with your staff to understand your varying requirements and need. • INTEGRATION: We package our services to meet multi-disciplinary tasks, drawing on the services of a breadth and depth of in-house expertise, which is expanding all the time. • PROBLEM SOLVING: Our staff solve problems in orthodox and straightforward ways where required or in innovative, imaginative but practical ways when the task is complex and unfamiliar. If there is an off-the-shelf solution, we'll provide it, but if not, we'll build a new solution. If you've called everyone else and are still disappointed, let us have a look at it. The difficulty is where the fun is! • QUALITY: We follow ISO-9001 QMS Standard Operating Procedures and have taken up steps to implement ISO system and will achieve ISO certification within 1 year. The most important function of our senior staff is to ensure the quality of the work that leaves the office or is undertaken on site. We temper enthusiasm with experience to make sure it's right. • EXPERIENCE: We have Rich experience of experts in Planning & Designing, Project Management, Supply, Construction, Installation, Commissioning, Optimization and Operation & Maintenance of Telecom Network all over India and Abroad. • A PROFESSIONAL COMPANY: Professional Service oriented company, which believes in setting standards in achieving customer satisfaction and improving regularly by meeting customer expectations
  • 8.
    Advantages of ourO&M ? • MANPOWER: We have a large pool of talented and trained Manpower at disposal. Training is provided to our Manpower on regular intervals basing on customer Enquiry in order to enhance his services to the customers. We encourage employees to put forward their new ideas in the challenging Industry. We encourage a work environment characterized by respect for the individual, a strong work ethics and client empathy. All individuals who work, putting forth their unique blend of talent, enthusiasm and ambition are the reasons that we are continued to be recognized for quality at on-time • CAPABILITY: We undertook several projects and executed successfully in stipulated time frames set forth thereby customer satisfaction result in achieving the growth and expansion of our wings at various levels. • Single Point of Contact: We are offering free and 24*7, a most unique and valuable service for data maintenance, tracking & movement of vehicles, SLA time monitoring and secure data by providing single point of contact center (Complaint and Solution remedial). • GPS Devices: All vehicle used in operations business will be equipped with latest GPS system to locate and monitor there movement.
  • 9.
    BTS Cell SiteMaintenance Scope broadly covers the Maintenance of below mentioned Telecom Infrastructure:- BTS (Base Transceiver Station) Shelters Diesel Generator Engine Cables Diesel Generator Alternator Lightning Arrester PMU (Power Management Unit) Aviation Lamp(s) Fire Alarm System AC & DC Power Supplies Electrical Installation Mobile DG Services Batteries Fire Extinguishers Integrated Panel Tower / Mast / Pole Air Conditioner Unit(s) Earth Pits
  • 10.
    BTS Cell SiteMaintenance Scope covers the measurements and necessary corrective actions as Mentioned below:- • Radiation Power Measurement • Voltage Standing Wave Ratio (VSWR) Measurement for RF feeder cables • Verification and correction of Connectorization of RF / IF cables • Validation of antennae orientations and correction if any required • Verification, Upgradation / replacement of cards / devises • Firmware / hardware modification for cards / devises locally
  • 11.
    Tower Maintenance Scope ofWork for Tower Maintenance l. No.. Item Work Involved 1 Aviation Lamp Checking of Aviation Lamp Feeder & power cables between RR station & Checking cables and couplings for breakage, loose fittings, other 2 Tower faults and replacing /rectifying the same Checking for any possible antenna faults, dismounting if faulty and 3 Antenna mounting the repaired new antenna 4 Antenna Alignment Checking for Antenna misalignment and correcting the same 5 Physical checking of Telecom Towers Checking of correct torque of nut bolts & replacing if any faulty
  • 12.
    O&M SERVICES Diesel Filling,Electricity Bill and Rent Payments • We will provide Diesel Fillers so as to ensure the availability of 70% of HSD in the DG tank at any point of time • Proper Co-ordination with EB (Electricity Board) for timely collection of Electricity bills, Collection of payments for the same from the customer's office and timely deposit of the payments at the respective EBs • The same activity will be carried out for rent payments if any tenants demands
  • 13.
    Preventive and CorrectiveMaintenance Services  Fault Remedy Activity is the most critical service which should be done in a very professional manner.  Being aware of this, CGC can offer the Operation and Maintenance Services for following network elements and might be more depending on the customer requirements and SOW.  All measurements for preventive maintenance shall be carried out as per prior agreed time schedule, which is given by the Customer.  While Monitoring at BTS Cell Sites the site reports shall be prepared and reports shall be submitted to costumer CI . Any defects observed in the BTS Sites in any of the associated equipment shall be attended in consultation with the Customer Eng at site. During every visit to the site for measurements, shall monitor the condition of the optical equipments installed for any alarms, DG maintenance, Diesel Filling, First level maintenance for DG, AMF Panel, SMPS, Fire Alarms Systems, PIU follow up for alarms, order wire, battery voltage, level of distilled water in the secondary cells, top up distilled water if required and observe the condition of the battery charger and electrical installation of the prefabs / building and report to CI in case any discrepancies are observed.
  • 14.
    Breakdown Maintenance • Mobilization of well equipped teams with all required equipment and skilled manpower on 24X7 format for fault identification & rectification • Help Desk informs the concerned region’s team leader in case of any fault / failure monitored, and make sure the rectification is done by the mentioned team in defined SLA & KPI’s as per planned outage. • Generating proper documentation in specified formats for the event in context of : 1. Break down maintenance record - Call registration - Fault rectification record - Call closure record 2. Down time and uptime analysis • Further the following records shall be submitted to customer on monthly basis: 1. Internal records of the issue and consumption of spare parts, tools and consumables etc. 2. Regular MIS (Management Information System) reporting to the customer as per the agreed formats thereby analyzing to upbeat with the continual improvement of key aspects
  • 15.
    Outage Analysis Detailed outageanalysis to be carried out on daily basis as per the specified format: 1. Sr. No 2. Date Site Identification 3. Location 4. No of Operator s 5. Outage start time 6. Outage end time 7. Duration (In Minutes) 8. Reason of Outage 9. Action Taken 10. Who's Responsible (Technician's Name) 11. Field Report 12. Remarks
  • 16.
    The main importantitems in O&M Project  Responsibility  Professional Teams  Vehicles suitable with terrain  Tools , Devices and their Calibration  24/7 Help Desk  Documentation  Reporting to customer  GPS devices in all vehicles.
  • 17.
    Main Tools List • Portable Laptops • Site Master • Multi Meter • Optical power meter • Portable tool kits. • Camera (Digital) • Safety belts. • Required software (Vendor Specific). • Dust cleaners • Cable cutters • Special tool to make IF connectors • GPS • Cell Site Health Check • All the other necessary equipments and tools necessary to perform the project.
  • 18.
    Documentation • All therecords including ( Alarms, Screen shots, panoramic, event logs ) collected by Corrective and/or Preventive maintenance teams will be forwarded to O&M Manager. And O&M Manager will be responsible for forwarding these information/reporting to customer on weekly basis and the frequency of the reporting can even be arranged as per the customer requirements. • All the spare parts will be recorded by Warehouse Responsible and will report to O&M Manager by proper inventory reports. • MIS will prepare their own daily reports and send to O & M Manager on daily basis. Therefore, O&M Manager also will be aware for any issue and will have the opportunity to be under service at any time for the customer and/or its representatives.
  • 19.
    Reporting to Customer •Routine reports to be sent to the customer in hourly / daily / weekly / monthly basis • Routine reports for diesel supply according to CPH to be sent to the customer in daily / weekly / monthly basis • Separate record will be maintained for abnormalities exceeding the SLA if any. NOTE : Reporting frequency can be arranged as per the customer needs.
  • 20.
    Warehousing & Logistics •All electronic equipments used in the projects, are stored on the proper shelves and suitable air conditioned environment for protection from humidity, extremely hot weather etc… • All electronic equipments are transferred/transported to the sites with their original packs or antistatic bags. • Warehouse Stock Management and Inventory Control is regularly monitored. The delivery reports are arranged for any kind of material coming in or going out and the necessary track database is strictly followed by Warehouse / Logistic Manager.
  • 21.
    Outage –Escalation Matrix Escalation Matrix – Outage 0-hours 2-hours 4-hours Technical Info Sup OME-Head Manager Alarms Technical Escalation Tech Sup Manager
  • 22.
    OME Team (1000Sites) OME Head 8 – 10 Yrs Exp ZOM 5 – 7 Yrs Exp. Asst Manager Asst Manager MIS & Estate Electrical Electrical Manager Engineer Engineer CI / Supervisors x 10** Field Technicians x 100* Note :- * Per Field Technicians on 8 – 10 Sites and will Amend as per Site Allotment ** Per CI / Supervisor on 8-10 Technicians Above Calculation on 1000 Sites.
  • 23.
  • 24.
  • 25.
    Management – Mr. Sidharth Kumar , CEO and Managing Director MBA Worked with Cincom Systems India Pvt. Ltd. 7 years + in Telecom industry in India – Mr. Devendra Kumar Gupta Advisor, Finance & Corporate Planning Over 15 years in Finance Sector, etc – Mr. Ashutosh Mani Tripathi, Head of Operations MBA 5+ years in Telecom industry in India – Mr. Shailesh Kumar, Sr. Manager - Commercial & Business B.Com , MBA 5+ years in Telecom industry in India
  • 26.
    Contact US : CGCCONSTRUCTIONS (INDIA) PRIVATE LIMITED Corporate Office CGC Constructions India Pvt. Ltd. E-171, Sector - 63, / Noida –201301,U.P. , India. Tel: +91 (0) 120 42 849 81 , 82 , 83 , 84 / Fax: +91 (0)120 42 849 85 E-Mail: enquiry@cgcindia.com / URL : www.cgcindia.com Circle Offices :- Delhi (NCR), UP-E, UP-W , Bihar , Jharkhand , Himachal , Punjab & Haryana, Rajasthan & West Bengal Up Coming Circle Offices Gujarat & Maharashtra (Including ROM & Goa)
  • 27.
    CGC CONSTRUCTIONS (INDIA)PRIVATE LIMITED Thank You
