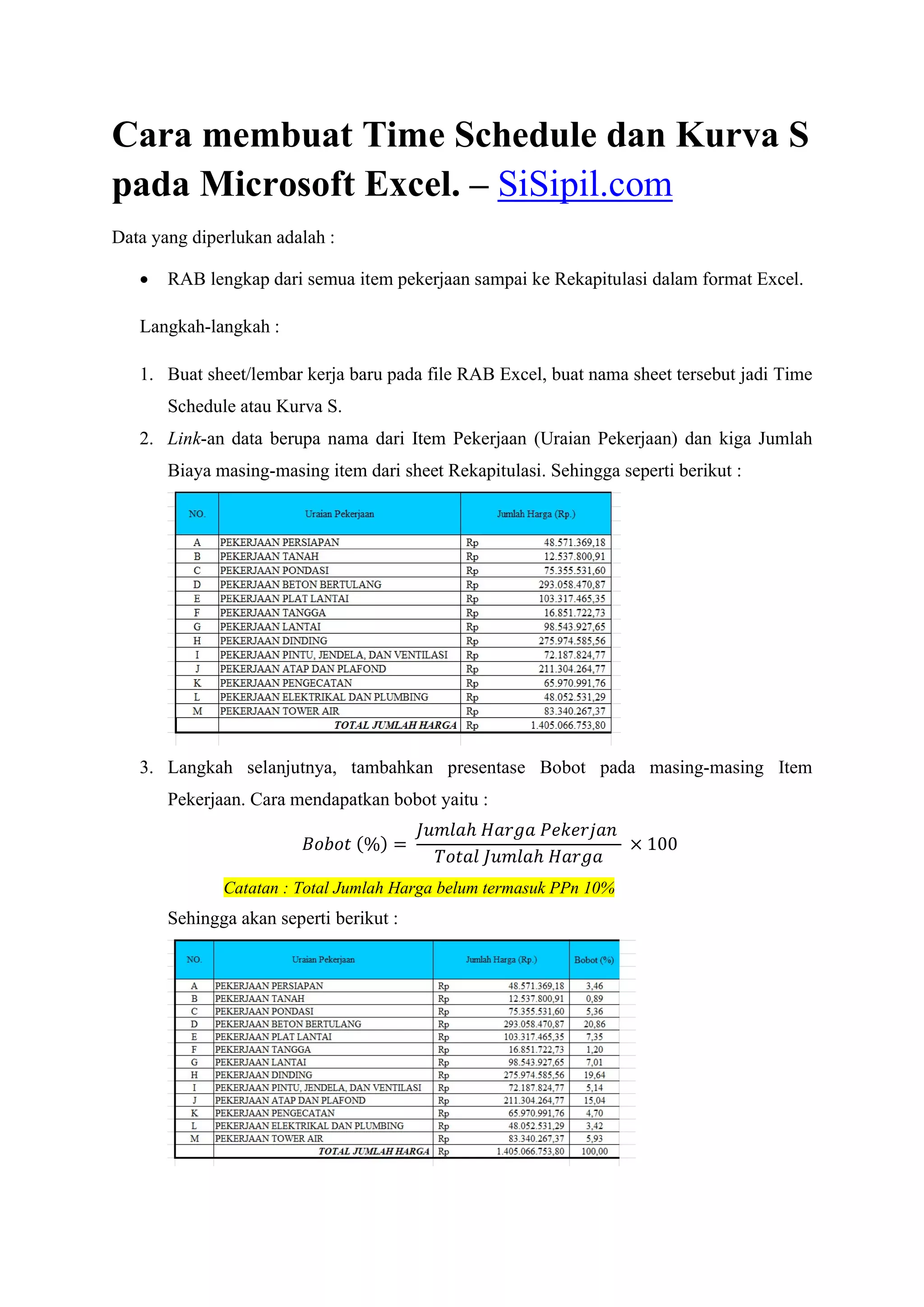

Document provides a step-by-step guide on how to create a time schedule and S-curve in Microsoft Excel for project management. It includes essential data requirements, calculations for item weights, and instructions on creating bar charts and cumulative progress tracking. The final steps involve adding the S-curve through an insert line chart and adjusting it for better visualization alongside the bar chart.
