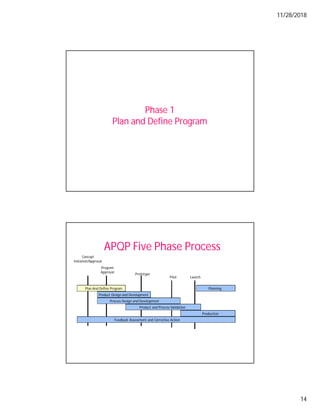

Agile management, or agile process management, or simply agile refers to an iterative, incremental method of managing the design and build activities of engineering, information technology and other business areas that aim to provide new product or service development in a highly flexible and interactive manner; an example is its application in Scrum, an original form of agile software development.
Episode 21 : Project Scope Management
Introduction to Project scope management
Initiation
Scope Planning
Scope Definition
Scope Verification
Scope Change Control
SAJJAD KHUDHUR ABBAS
Chemical Engineering , Al-Muthanna University, Iraq
Oil & Gas Safety and Health Professional – OSHACADEMY
Trainer of Trainers (TOT) - Canadian Center of Human
Development
Eliminate Bottlenecks in Software Development & DeliveryMicro Focus
Great approach demonstrated via slides from a recent @archie_borland @MarkKulak webinar for Borland Software.

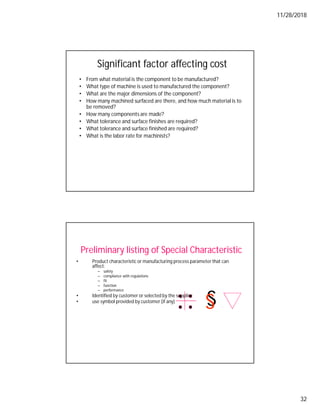

Key take-aways:
- Agile is filled with benefits, but has some unintended consequences which “bottleneck” delivery
- The market trend has this getting worse – backed by analysts & customers
- Take practical steps now to overcome with a few key process improvements to eliminate
The frantic pace of change, driven by mobile, cloud and the rise of the consumer, is introducing new levels of complexity to the software industry and forces organizations into more fragmented ways of working. Today's development managers are subjected to constant change that they cannot control, yet must manage, and are responsible for delivering the applications their customers need at an unprecedented scale and pace. To stay relevant and meet customer demand in the face of constant change requires a truly optimized approach.
Apqp bumming you out briefing may 30 2013John Cachat
Sales can’t update the customer on launch status. Engineering spends more time updating Gantt charts than they do actually engineering stuff. Quality can’t find the documentation. Purchasing has no idea when the supplier status is. Sound familiar?
What this means is:
• Products are late
• Quality is unacceptable
• Resources are wasted
• Problems are repeated
What we have found is that Project Management is done with the wrong tools and/or people
• Resources are over-scheduled
• Issues are not resolved
• True costs are unknown / inaccurate
What we have found with Project Management Software
• Tools are cumbersome, force detailed information that is unknown
• People resort back to XLS
• Management cannot support the team and resort to firefighting issues
Learn about an approach to APQP and a SaaS technology that allows you to implement APQP the right way and engage your people and suppliers to improve communication, and launch higher quality products faster and on-time and under budget.
Episode 20 : PROJECT MANAGEMENT CONTEXT
Project phase and the Project Life Cycle
Project Stakeholders
Organizational Influences
Key General Management Skills
Social-Economic-Environmental Influences
SAJJAD KHUDHUR ABBAS
Chemical Engineering , Al-Muthanna University, Iraq
Oil & Gas Safety and Health Professional – OSHACADEMY
Trainer of Trainers (TOT) - Canadian Center of Human
Development
What Does the PARKTRONIC Inoperative, See Owner's Manual Message Mean for You...Autohaus Service and Sales
Learn what "PARKTRONIC Inoperative, See Owner's Manual" means for your Mercedes-Benz. This message indicates a malfunction in the parking assistance system, potentially due to sensor issues or electrical faults. Prompt attention is crucial to ensure safety and functionality. Follow steps outlined for diagnosis and repair in the owner's manual.
Ever been troubled by the blinking sign and didn’t know what to do?
Here’s a handy guide to dashboard symbols so that you’ll never be confused again!
Save them for later and save the trouble!
More Related Content
Similar to Automotive Core Tools APQP Training.pdf
Agile software development development explainedServan Huegen
Explanation of different types of project approaches. From classic waterfall via Agile, Scrum, Kanban, LeSS, SAFe, Spotify Engineering Culture to Lean Startup and some eye opening tips and tricks.
Agile management, or agile process management, or simply agile refers to an iterative, incremental method of managing the design and build activities of engineering, information technology and other business areas that aim to provide new product or service development in a highly flexible and interactive manner; an example is its application in Scrum, an original form of agile software development.
Episode 21 : Project Scope Management
Introduction to Project scope management
Initiation
Scope Planning
Scope Definition
Scope Verification
Scope Change Control
SAJJAD KHUDHUR ABBAS
Chemical Engineering , Al-Muthanna University, Iraq
Oil & Gas Safety and Health Professional – OSHACADEMY
Trainer of Trainers (TOT) - Canadian Center of Human
Development
Eliminate Bottlenecks in Software Development & DeliveryMicro Focus
Great approach demonstrated via slides from a recent @archie_borland @MarkKulak webinar for Borland Software.
Key take-aways:
- Agile is filled with benefits, but has some unintended consequences which “bottleneck” delivery
- The market trend has this getting worse – backed by analysts & customers
- Take practical steps now to overcome with a few key process improvements to eliminate
The frantic pace of change, driven by mobile, cloud and the rise of the consumer, is introducing new levels of complexity to the software industry and forces organizations into more fragmented ways of working. Today's development managers are subjected to constant change that they cannot control, yet must manage, and are responsible for delivering the applications their customers need at an unprecedented scale and pace. To stay relevant and meet customer demand in the face of constant change requires a truly optimized approach.
Apqp bumming you out briefing may 30 2013John Cachat
Sales can’t update the customer on launch status. Engineering spends more time updating Gantt charts than they do actually engineering stuff. Quality can’t find the documentation. Purchasing has no idea when the supplier status is. Sound familiar?
What this means is:
• Products are late
• Quality is unacceptable
• Resources are wasted
• Problems are repeated
What we have found is that Project Management is done with the wrong tools and/or people
• Resources are over-scheduled
• Issues are not resolved
• True costs are unknown / inaccurate
What we have found with Project Management Software
• Tools are cumbersome, force detailed information that is unknown
• People resort back to XLS
• Management cannot support the team and resort to firefighting issues
Learn about an approach to APQP and a SaaS technology that allows you to implement APQP the right way and engage your people and suppliers to improve communication, and launch higher quality products faster and on-time and under budget.
Episode 20 : PROJECT MANAGEMENT CONTEXT
Project phase and the Project Life Cycle
Project Stakeholders
Organizational Influences
Key General Management Skills
Social-Economic-Environmental Influences
SAJJAD KHUDHUR ABBAS
Chemical Engineering , Al-Muthanna University, Iraq
Oil & Gas Safety and Health Professional – OSHACADEMY
Trainer of Trainers (TOT) - Canadian Center of Human
Development
What Does the PARKTRONIC Inoperative, See Owner's Manual Message Mean for You...Autohaus Service and Sales
Learn what "PARKTRONIC Inoperative, See Owner's Manual" means for your Mercedes-Benz. This message indicates a malfunction in the parking assistance system, potentially due to sensor issues or electrical faults. Prompt attention is crucial to ensure safety and functionality. Follow steps outlined for diagnosis and repair in the owner's manual.
Ever been troubled by the blinking sign and didn’t know what to do?
Here’s a handy guide to dashboard symbols so that you’ll never be confused again!
Save them for later and save the trouble!
Why Is Your BMW X3 Hood Not Responding To Release CommandsDart Auto
Experiencing difficulty opening your BMW X3's hood? This guide explores potential issues like mechanical obstruction, hood release mechanism failure, electrical problems, and emergency release malfunctions. Troubleshooting tips include basic checks, clearing obstructions, applying pressure, and using the emergency release.
Fleet management these days is next to impossible without connected vehicle solutions. Why? Well, fleet trackers and accompanying connected vehicle management solutions tend to offer quite a few hard-to-ignore benefits to fleet managers and businesses alike. Let’s check them out!
Symptoms like intermittent starting and key recognition errors signal potential problems with your Mercedes’ EIS. Use diagnostic steps like error code checks and spare key tests. Professional diagnosis and solutions like EIS replacement ensure safe driving. Consult a qualified technician for accurate diagnosis and repair.
Core technology of Hyundai Motor Group's EV platform 'E-GMP'Hyundai Motor Group
What’s the force behind Hyundai Motor Group's EV performance and quality?
Maximized driving performance and quick charging time through high-density battery pack and fast charging technology and applicable to various vehicle types!
Discover more about Hyundai Motor Group’s EV platform ‘E-GMP’!
In this presentation, we have discussed a very important feature of BMW X5 cars… the Comfort Access. Things that can significantly limit its functionality. And things that you can try to restore the functionality of such a convenient feature of your vehicle.
5 Warning Signs Your BMW's Intelligent Battery Sensor Needs AttentionBertini's German Motors
IBS monitors and manages your BMW’s battery performance. If it malfunctions, you will have to deal with an array of electrical issues in your vehicle. Recognize warning signs like dimming headlights, frequent battery replacements, and electrical malfunctions to address potential IBS issues promptly.
"Trans Failsafe Prog" on your BMW X5 indicates potential transmission issues requiring immediate action. This safety feature activates in response to abnormalities like low fluid levels, leaks, faulty sensors, electrical or mechanical failures, and overheating.
Things to remember while upgrading the brakes of your carjennifermiller8137
Upgrading the brakes of your car? Keep these things in mind before doing so. Additionally, start using an OBD 2 GPS tracker so that you never miss a vehicle maintenance appointment. On top of this, a car GPS tracker will also let you master good driving habits that will let you increase the operational life of your car’s brakes.
What Exactly Is The Common Rail Direct Injection System & How Does It WorkMotor Cars International
Learn about Common Rail Direct Injection (CRDi) - the revolutionary technology that has made diesel engines more efficient. Explore its workings, advantages like enhanced fuel efficiency and increased power output, along with drawbacks such as complexity and higher initial cost. Compare CRDi with traditional diesel engines and discover why it's the preferred choice for modern engines.
Comprehensive program for Agricultural Finance, the Automotive Sector, and Empowerment . We will define the full scope and provide a detailed two-week plan for identifying strategic partners in each area within Limpopo, including target areas.:
1. Agricultural : Supporting Primary and Secondary Agriculture
• Scope: Provide support solutions to enhance agricultural productivity and sustainability.
• Target Areas: Polokwane, Tzaneen, Thohoyandou, Makhado, and Giyani.
2. Automotive Sector: Partnerships with Mechanics and Panel Beater Shops
• Scope: Develop collaborations with automotive service providers to improve service quality and business operations.
• Target Areas: Polokwane, Lephalale, Mokopane, Phalaborwa, and Bela-Bela.
3. Empowerment : Focusing on Women Empowerment
• Scope: Provide business support support and training to women-owned businesses, promoting economic inclusion.
• Target Areas: Polokwane, Thohoyandou, Musina, Burgersfort, and Louis Trichardt.
We will also prioritize Industrial Economic Zone areas and their priorities.
Sign up on https://profilesmes.online/welcome/
To be eligible:
1. You must have a registered business and operate in Limpopo
2. Generate revenue
3. Sectors : Agriculture ( primary and secondary) and Automative
Women and Youth are encouraged to apply even if you don't fall in those sectors.
1. 11/28/2018
1
Automotive Core Tools APQP Training
on understanding, workshop and
competency assessment
For
FEC CABLES Sdn Bhd
Presented by
ABDUL RASHID HM
ADVANCE PRODUCT QUALITY PLANNING (APQP)
2ND EDITION
PART 1
2. 11/28/2018
2
Course objective
• To understand the purpose of APQP
• To understand appropriate activities for
each phase of APQP
• To understand the required inputs and
outputs of each phase
• To understand the relationship of quality
core tools
• The goal of PQP is to facilitate
communication between all persons and
activities involved during product
development program and ensure that
all required steps are completed on time,
at acceptable cost and quality levels.
The Goal of PQP
3. 11/28/2018
3

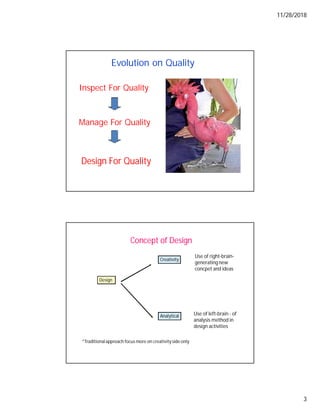

Design For Quality
Evolution on Quality
Inspect For Quality
Manage For Quality
Concept of Design
Design
Creativity
Analytical
Use of right-brain-
generating new
concpet and ideas
Use of left-brain - of
analysis method in
design activities
*Traditionalapproach focus more on creativityside only
4. 11/28/2018
4
What is Advanced Product Quality Planning
• A structured method and steps for product development
process.
• Initiated by Ford during Ford Taurus development - 1980
• Applied to both products and manufacturing process design
• A simultaneous product development system that replaces
sequential phases/ pass-off system
ORGANIZATION WITHOUT SYSTEM
5. 11/28/2018
5
• Can reduce lead time of new product to market
• Can facilitate effectivecommunication with
everyone involved during development stage.
• Can improve communication process between
supplier and their customer
• Can prevent defect at the early stage
• Can produce a quality product on time at the
lowest cost.
Benefit of APQP

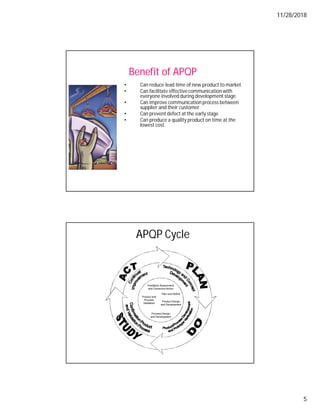

APQP Cycle
Feedback Assessment
and Corrective Action
Process Design
and Development
Plan and Define
Product Design
and Development
Product and
Process
Validation
6. 11/28/2018
6

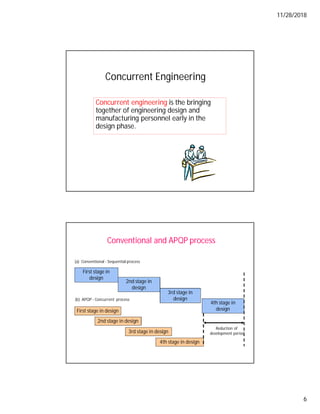

Concurrent Engineering
Concurrent engineering is the bringing
together of engineering design and
manufacturing personnel early in the
design phase.
Conventional and APQP process
First stage in
design
2nd stage in
design
3rd stage in
design
4th stage in
design
First stage in design
2nd stage in design
3rd stage in design
4th stage in design
(a) Conventional - Sequential process
(b) APQP - Concurrent process
Reduction of
development period
7. 11/28/2018
7

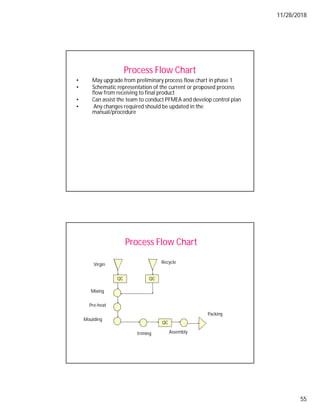

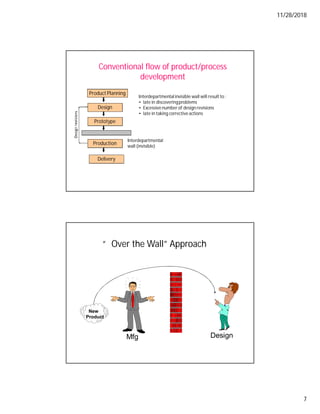

Conventional flow of product/process
development
Product Planning
Design
Prototype
Production
Delivery
Interdepartmental
wall (invisible)
Interdepartmentalinvisible wall will result to :
• late in discoveringproblems
• Excessive number of design revisions
• late in taking corrective actions
“Over the Wall” Approach
Design
Mfg
New
Product
8. 11/28/2018

8
Concurrent Engineering vs. “Over
the wall”
• Manufacturing personnel are able to identify
production capabilities and capacities
• Early opportunities for design or procurement of
critical tooling
• Early consideration of the technical feasibility of a
particular design
• The emphasis can be on the problem resolution
instead of conflict resolution
APQP process may reduce mistake during
development
Mistakes
Previous
Method
Concurrent
Engineering
9. 11/28/2018
9
Engineering Changes during development
Company B
Company A
Time
The effect of design on manufacturing cost
Poor Design Average Design Good Design
Efficient Manufacturing
Average Manufacturing
Inefficient Manufacturing
11. 11/28/2018
11
Multidisciplinary approach in APQP
• To assign responsibility to a multidisciplinaryteam that include
different function such as:
– Design
– Marketing
– Quality Assurance
– Manufacturing
– other appropriate personnel
• Encourageto involve customer/ supplier
Function
Process
Product
Planning
Design Purchasing W’housing Sales Marketing
Quality
Cost
Delivery
a)New
Products
b)Existing
Products
Cross
Function
Management
Customers
Cross
Function
Management
Customers
functional Management
Strong Relation
Strong Relation Relation
Relation Little Relation
Little Relation
Cross Functional
Management
12. 11/28/2018
12
Multidisciplinary approach in APQP
Product Planning
Design
Prototype
Production
Delivery
Quality
Marketing
Objective: Pass through
once only
The Five Phases of APQP
• Phase 1: Plan and Define Program
• Phase 2 : Product Design and Development
• Phase 3 : Process Design and Development
• Phase 4 : Product and Process Validation
• Phase 5 : Feedback, Assessment and
Corrective Action
13. 11/28/2018
13
APQP Five Phase Process
Plan And Define Program
Product Design and Development
Process Design and Development
Product and Process Validation
Production
Feedback Assessment and Corrective Action
Pilot Launch
Concept
Initiation/Approval
Program
Approval
Prototype
Planning
APQP Timing Schedule
Start Finish Start Finish Jan Feb Mac Apr May Jun Jul Aug Sep
Task Name
No
Plan Actual 2003
Duration
14. 11/28/2018
14
Phase 1
Plan and Define Program
APQP Five Phase Process
Plan And Define Program
Product Design and Development
Process Design and Development
Product and Process Validation
Production
Feedback Assessment and Corrective Action
Pilot Launch
Concept
Initiation/Approval
Program
Approval
Prototype
Planning
15. 11/28/2018
15

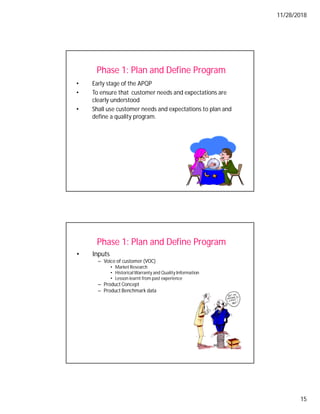

Phase 1: Plan and Define Program
• Early stage of the APQP
• To ensure that customer needs and expectations are
clearly understood
• Shall use customer needs and expectations to plan and
define a quality program.
Phase 1: Plan and Define Program
• Inputs
– Voice of customer (VOC)
• Market Research
• HistoricalWarranty and Quality Information
• Lesson learnt from past experience
– Product Concept
– Product Benchmark data
16. 11/28/2018
16
Voice Of Customer
Conventional design process
focus more on engineering
capabilities and less on
customer needs
WHAT IS QUALITY ?
Customer requirements
As manufactured
As delivered
Quality gap
“Qualityis meeting customer
requirements and expectation”
“The only real measure of business
successis a satisfiedcustomer,all else
is a distraction”
Barrie Hopson
18. 11/28/2018
18

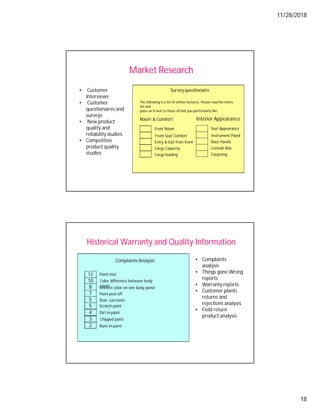

Market Research
Surveyquestionaire
The following is a list of vehicle features. Please read the entire
list and
place an X next to those of that you particlularly like
Room & Comfort
Front Room
Front Seat Comfort
Entry & Exit from front
Cargo Capacity
Cargo loading
Interior Appearance
Seat Appearance
Instrument Panel
Door Panels
Console Box
Carpeting
• Customer
Interviews
• Customer
questionaires and
surveys
• New product
quality and
reliability studies
• Competitive
product quality
studies
Historical Warranty and Quality Information
• Complaints
analysis
• Things gone Wrong
reports
• Warranty reports
• Customer plants
returns and
rejections analysis
• Field return
product analysis
Complaints Analysis
12
10
8
7
5
Paint mist
Color difference between body
panel
Uneven color on one body panel
Paint peel off
Rust, corrosion
5 Scratch paint
4
3
2
Dirt in paint
Chipped paint
Runs in paint
19. 11/28/2018
19

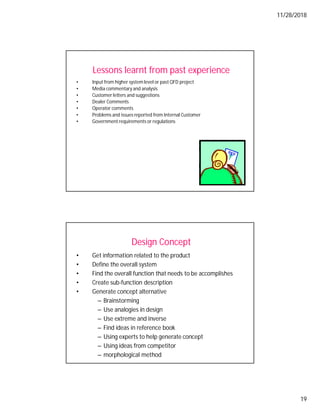

Lessons learnt from past experience
• Input from higher systemlevel or past QFD project
• Media commentary and analysis
• Customer letters and suggestions
• Dealer Comments
• Operator comments
• Problems and issues reported from Internal Customer
• Government requirements or regulations
Design Concept
• Get information related to the product
• Define the overall system
• Find the overall function that needs to be accomplishes
• Create sub-function description
• Generate concept alternative
– Brainstorming
– Use analogies in design
– Use extreme and inverse
– Find ideas in reference book
– Using experts to help generate concept
– Using ideas from competitor
– morphological method
20. 11/28/2018
20
Product Information
• Product Information shall include the
following:
– What is the intended use of this product; heavy duty,
normal duty,
– Who are using this product; youngster,family
– Where it shall be used; town, corrosive environment
– When it will be used; at night, morning, evening
– How it will be used;
Define the overall system
• Shall understand the appropriate level -
System, subsystem or component
• The team member must decide on what
constitutes a system,subsystem or
component
• The actual boundaries that divide a system,
subsystem and component are arbitrary
22. 11/28/2018
22
Create sub-function description

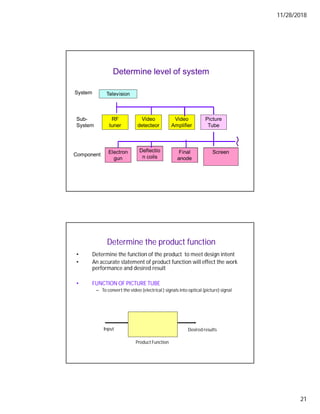

• Electron gun : To shoot and control flow of electrons to the
screen.
• Deflection coils: To deflect the electron beam in horizontal and
vertical direction using electromagnetic system
• Final anode; to provide sufficient and energy for the electron
beam.
• Screen: To integrate the electron into color and optical view
Design concept alternative
23. 11/28/2018
23

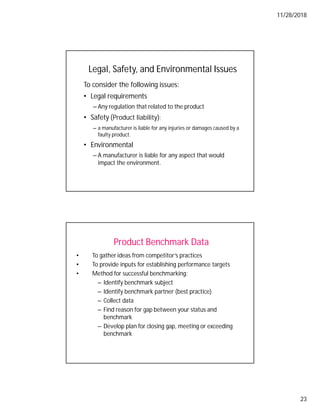

To consider the following issues:
• Legal requirements
– Any regulation that related to the product
• Safety (Product liability);
– a manufacturer is liable for any injuries or damages caused by a
faulty product.
• Environmental
– A manufacturer is liable for any aspect that would
impact the environment.
Legal, Safety, and Environmental Issues
Product Benchmark Data
• To gather ideas from competitor’s practices
• To provide inputs for establishing performance targets
• Method for successful benchmarking:
– Identify benchmark subject
– Identify benchmark partner (best practice)
– Collect data
– Find reason for gap between your status and
benchmark
– Develop plan for closing gap, meeting or exceeding
benchmark
24. 11/28/2018
24

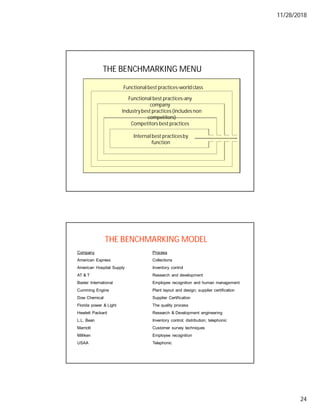

THE BENCHMARKING MENU
Internal best practicesby
function
Functional best practices-any
company
Industrybest practices (includes non
competitors)
Competitors best practices
Functional best practices-world class
THE BENCHMARKING MODEL
Company Process
American Express Collections
American Hospital Supply Inventory control
AT & T Research and development
Baxter International Employee recognition and human management
Cumming Engine Plant layout and design; supplier certification
Dow Chemical Supplier Certification
Florida power & Light The quality process
Hewlett Packard Research & Development engineering
L.L. Bean Inventory control; distribution; telephonic
Marriott Customer survey techniques
Milliken Employee recognition
USAA Telephonic
25. 11/28/2018
25
Identify benchmarking partners
Industry survey
Customer/Supplier
interview
Knowledge sharing
consortium
1:1
Easy to get, cheap
Hard to get, costly
Benchmark with other industry
No
1
Long admission times in
hospitals
Hotel
Receptions
2 Lengthy machine setup
Formula One pit
crew
3 Delivery of fresh concrete
Hot pizza
delivery
4
Unstructured maintenance
of power turbines
Maintenance of
aircraft engines
5
Difficult to manufacture
cylindrical shape
Manufacturing of
lipstick tubes
Problem
Compared
with
26. 11/28/2018
26

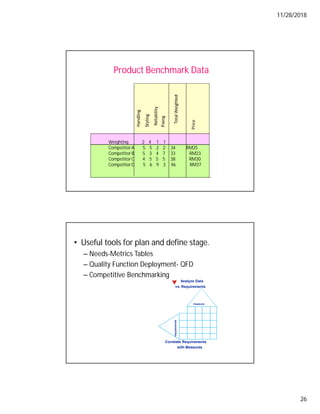

Product Benchmark Data
Weighting 2 4 1 1
Competitor A 5 5 2 2 34 RM25
Competitor B 5 3 4 7 33 RM23
Competitor C 4 5 5 5 38 RM30
Competitor D 5 6 9 3 46 RM37
• Useful tools for plan and define stage.
– Needs-Metrics Tables
– Quality Function Deployment- QFD
– Competitive Benchmarking
Analyze Data
vs. Requirements
Correlate Requirements
with Measures
measure
requirements
27. 11/28/2018
27

Quality Function
Deployment (Example)
Phase 1: Plan and Define Program
• Outputs
– APQP timing schedule
– Design and Quality goals
– Product Costing
– Preliminary Listing of Special Characteristics
– Feasibility and risk analysis
28. 11/28/2018
28
To plan and control the process of design and development
Shall include :
design and developments stages
The required activities in development stages
Responsibilities and authorities
To manage the interfaces between groups involved
To update Plan as and when required
APQP Timing schedule
APQP Timing Schedule
Start Finish Start Finish Jan Feb Mac Apr May Jun Jul Aug Sep
Task Name
No
Plan Actual 2003
Duration
29. 11/28/2018
29

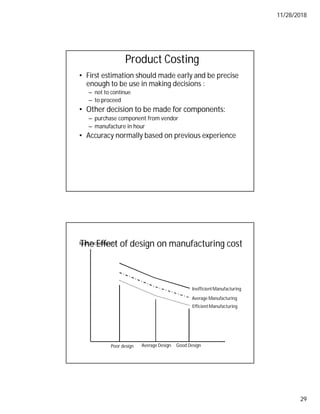

Product Costing
• First estimation should made early and be precise
enough to be use in making decisions :
– not to continue
– to proceed
• Other decision to be made for components:
– purchase component from vendor
– manufacture in hour
• Accuracy normally based on previous experience
The Effect of design on manufacturing cost
Poor design Average Design Good Design
EfficientManufacturing
Average Manufacturing
InefficientManufacturing
Manufacturing cost
30. 11/28/2018
30
Product Costing
• Fixed costs
– Overhead; all cost for administration,engineering, utilities that occur
day to day, even if no product rolls out of door.
– Tooling; cost include all jig, fixtures and mold
• Variable Costs
– Purchased part; expenses of all the materials/part that are purchased
for a product including scrap
– Labor; cost of wages and benefits to the workforce
– Selling expenses
– Profit
Fixed Costs vs. Variable Costs
• Fixed Costs – incurred in a predetermined
amount, regardless of number of units
produced (i.e. setting up the factory work
area or cost of an injection mold)
• Variable Costs – incurred in direct proportion
to the number of units produced (i.e. cost of
raw materials)
31. 11/28/2018
31

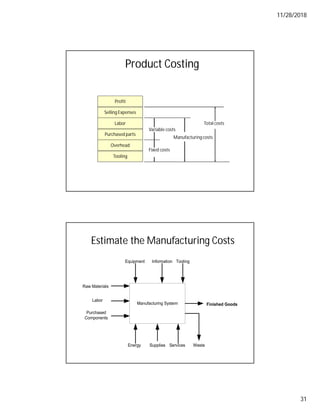

Product Costing
Purchased parts
Labor
Tooling
Overhead
Selling Expenses
Profit
Fixed costs
Variable costs
Manufacturing costs
Total costs
Estimate the Manufacturing Costs
Finished Goods
Manufacturing System
Equipment Information Tooling
Waste
Services
Supplies
Energy
Raw Materials
Labor
Purchased
Components
32. 11/28/2018
32
Significant factor affecting cost
• From what material is the component to be manufactured?
• What type of machine is used to manufactured the component?
• What are the major dimensions of the component?
• How many machined surfaced are there, and how much material is to
be removed?
• How many components are made?
• What tolerance and surface finishes are required?
• What tolerance and surface finished are required?
• What is the labor rate for machinists?
Preliminary listing of Special Characteristic
• Product characteristic or manufacturing process parameter that can
affect:
– safety
– compliance with regulations
– fit
– function
– performance
• Identified by customer or selected by the supplier
• use symbol provided by customer(if any)
S
S
33. 11/28/2018
33
Feasibility and risk analysis
• Shall investigate, confirm and document manufacturing feasibility of the
proposed products.
• Shall determine whether the proposed design can be manufactured,
assembled, tested, packaged and delivered in sufficient quantity, at an
acceptable cost
• Proposed design should be documentedand presented to management
for their support.
Feasibility and risk analysis
• Usually has one or three reactions:
– It is not feasible, it will never work
– It might work if something else happens
– It is worth considering
34. 11/28/2018
34
Risk Assessment
• Risk analysis should include :
– High warranty of current models
– New supplier
– New manufacturing location
– New product or manufacturing technology
– High product or process complexity
– Program timing is compressed
– Cost targets are aggressive
– Reliability goals will be difficultto achieve
Feasibility Analysis (example)
Customer: ____________________________________ Date: ___________________
Part Number : _________________________________ Part Name :______________
YES NO CONSIDERATION
Is product adequately defined (application requirements, etc) to enable feasibility
evaluation ?
Can Engineering Performance Specifications be met as written ?
Can product be manufactured to tolerance specified on drawing ?
Can product be manufactured with Cpk's that meet requirements ?
Is there adequate capacity to produce product
Does the design allow the use of efficient material handling techniques ?
Can the product be manufactured without incurring any unusual:
* Costs for capital equipment?
* Cost for tooling ?
Alternative manufacturing methods ?
Is statistical process control required on product?
Is statistical process control presently used on similar products:
* Are the process in control and stable ?
* Are the Cpk's greater than 1.33 ?
Conclusion
Feasible Product can be produced as specified with no revisions
Feasible Change recommended (see attached)
Not Feasible Design revision required to produce product within the specified requirements
Sign-Off
TEAM FEASIBILITY COMMITMENT
35. 11/28/2018
35

Risk Assessment
No. Type of Risk Risk
(low, medium or
high)
1
Product failure due to new design
2 Product failure due to manufacturing techniques are new to
industry
3 Product failure due to high product or process complexity
4 Product failure because the product is strategically important
due to high visibility or functional performance
5 Design goal is difficult to achieve
6
Reliability goals are difficult to achieve
7 Quality goals (warranty, TGW, scrap rates, rework rates) will
be difficult to achieve
8 Prototype is not able to deliver on time because program
timing is compressed
9 Product is not able to deliver on time because program timing
is compressed
10 Chance of a product recall
11
Others
For risk evaluated to be high or medium, controls or action plans are required. If
controls or action plans are deemed to be ineffective, the company should consider to
decline the order.
Conclusion:
_______________________________________________________________
Phase 2
Product Design and Development
36. 11/28/2018
36
APQP Five Phase Process
Plan And Define Program
Product Design and Development
Process Design and Development
Product and Process Validation
Production
Feedback Assessment and Corrective Action
Pilot Launch
Concept
Initiation/Approval
Program
Approval
Prototype
Planning
Phase 2: Product Design and Development
Outputs
• Target for Product Quality
• Engineering drawings
• Engineering Specification
• Safety and Regulatory Requirements
• Design For Manufacturability and Assembly
• Special Characteristics
• DFMEA
• Design Verification
New Equipment, tooling and
facilities requirements
Gages/ Testing Equipment
Requirements
Product Mistake Proofing
37. 11/28/2018
37
Target for Product Quality
• To identify, document and review targets for product design:
• Eg:
– MTBF = Mean Time Between Failure
– MTTR = Mean Time To Repair
– Life
– Reliability
– Durability
– Maintainability
– Timing and cost
• Customer Needs lead to Product Specs
The Customer expresses the need in terms of What the
product must do.
The robot can quickly change alignment without forward
motion.
The Product Specification sets metrics and values that allow
quantification of the user need.
The Robot can rotate 360 degrees in 2 secs without
forward motion .
38. 11/28/2018
38
A extension of the short-term memory after idea generation.
To represent concept that are more abstract and best represented.
To archive the geometric form of design
Communicate ideas between designers and other related personnel.
Simulate the operation of the product
To check the completeness of design

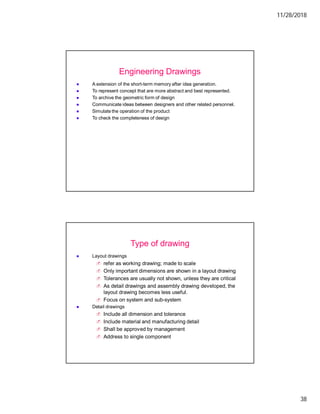

Engineering Drawings
Layout drawings
refer as working drawing; made to scale
Only important dimensions are shown in a layout drawing
Tolerances are usually not shown, unless they are critical
As detail drawings and assembly drawing developed, the
layout drawing becomes less useful.
Focus on system and sub-system
Detail drawings
Include all dimension and tolerance
Include material and manufacturing detail
Shall be approved by management
Address to single component
Type of drawing
39. 11/28/2018
39

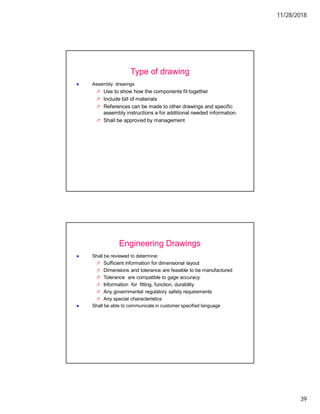

Assembly drawings
Use to show how the components fit together
Include bill of materials
References can be made to other drawings and specific
assembly instructions a for additional needed information.
Shall be approved by management
Type of drawing
Shall be reviewed to determine:
Sufficient information for dimensional layout
Dimensions and tolerance are feasible to be manufactured
Tolerance are compatible to gage accuracy
Information for fitting, function, durability
Any governmental regulatory safety requirements
Any special characteristics
Shall be able to communicate in customer specified language

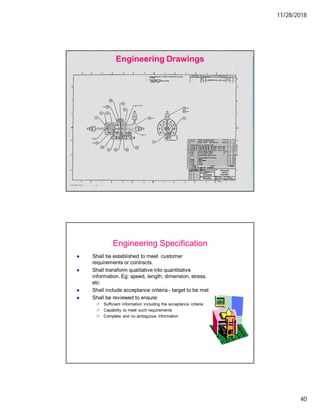

Engineering Drawings
40. 11/28/2018
40
Engineering Drawings
Shall be established to meet customer
requirements or contracts.
Shall transform qualitative into quantitative
information. Eg: speed, length, dimension, stress,
etc
Shall include acceptance criteria - target to be met
Shall be reviewed to ensure:
Sufficient information including the acceptance criteria
Capability to meet such requirements
Complete and no ambiguous information
Engineering Specification
41. 11/28/2018
41

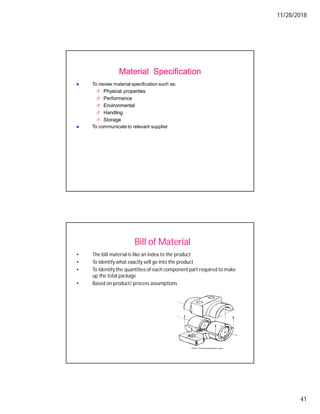

To review material specification such as:
Physical properties
Performance
Environmental
Handling
Storage
To communicate to relevant supplier
Material Specification

Bill of Material
• The bill material is like an index to the product
• To identify what exactly will go into the product
• To identify the quantities of each component part required to make
up the total package
• Based on product/ process assumptions
42. 11/28/2018
42
Bill of Material
Typical information in bill of material
• The item number
• The part number
• The quantity needed in the assembly
• The name or description of the component
• The material flow from which the component is made
• The source of the component
Bill of Material
No Item Product Code Quantity used Weight Supplier
43. 11/28/2018
43
Safety and Regulatory Requirements
• To identify applicable safety standards and regulation
• To analyze safety in design, purchased component and manufacturing.
• carry out design evaluation test for safety
• Prepare instruction and warning to the user, maintenance manual and
labeling
To improve the design concept for easy
and low-cost assembly/ manufacturing by:
reducing the number of parts
optimising manufacturing processes
simplifying parts handling
improving product assembly
Design for manufacture and Assembly (DFMA)
44. 11/28/2018
44
AEM & DFS: Pneumatic Pump
•Assembly Sequence:
6. Two screws
5. One cover
4. One spring
3. One piston stop
2. One piston
1. One main body
•Tool:
–A screw driver
DFMA : Example
45. 11/28/2018
45
DFMA : Example
Advantages of Standardization
• Fewer parts to deal with in inventory & manufacturing
• Design costs are generally lower
• Reduced training costs and time
• More routine purchasing, handling, and inspection procedures
• Orders fillable from inventory
• Opportunities for long production runs and automation
• Need for fewer parts justifies increased expenditures on
perfecting designs and improving quality control procedures
46. 11/28/2018
46
Design for Reliability
• To ensure quality over the long term
• Is the ability of product to perform its
intended function over a period of time and
under prescribed environmental conditions.
THE FAILURE ‘BATH TUB’
CHANGE FAILURE
PHASES
WEAROUT
PHASES
EARLY FAILURE
PHASE
Operating Time (Componentage or time)
47. 11/28/2018
47
DESIGN FOR RELIABILITY
Equipment
deterioration
Safety Margin
Design Strength
Distribution of stress
Areas where the two
(stesses and strength)
overlap
(Time ), t
Be aware of the environmental
effects of the materials used in
product
Design the product with high
separability
Design components that can be
reused or recycle
Be aware of the environmental
effects of the material not reused.
Design for Environment (DFE)
48. 11/28/2018
48
To analyse what could go wrong in the design system
such as component, subsystem or system
To develop a ranked list of potential failure modes
according to their effects on system and vehicle
operations
To establish a priority system for design improvements,
development and validation
Design FMEA
Design FMEA
Item Potential Potential Current R. Recommended Action Results R.
Function Failure Effect(s) of Process P. Action(s) Taken P.
Mode Failure Controls N. N.
Requirements
S
e
v
C
l
a
s
s
O
c
c
u
r
D
e
t
e
c
ofFailure
Action Results
Potential Responsibility S
e
v
O
c
c
D
e
t
Cause (s) / & Target
Mechanism(s) Completion Date
49. 11/28/2018
49

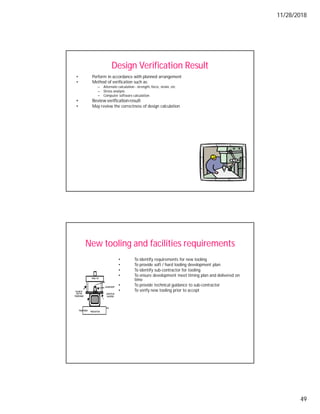

Design Verification Result
• Perform in accordance with planned arrangement
• Method of verification such as:
– Alternate calculation - strength, force, strain, etc
– Stress analysis
– Computer software calculation
• Review verificationresult
• May review the correctness of design calculation
New tooling and facilities requirements
• To identify requirements for new tooling
• To provide soft / hard tooling development plan
• To identify sub-contractor for tooling
• To ensure development meet timing plan and delivered on
time
• To provide technical guidance to sub-contractor
• To verify new tooling prior to accept
50. 11/28/2018
50
Gages and testing Equipment requirements
• To identify new inspection, test and measurement
equipment
• To identify the accuracy required
• To ensure equipment is ready on time
Gages and testing Equipment requirements
No Testing required Test Equipment unit available Accuracy
GAGES/ TESTING REQUIREMENT
51. 11/28/2018
51

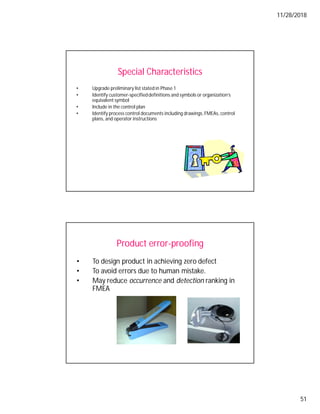

Special Characteristics
• Upgrade preliminary list stated in Phase 1
• Identify customer-specifieddefinitions and symbols or organization’s
equivalent symbol
• Include in the control plan
• Identify process control documents including drawings,FMEAs, control
plans, and operator instructions
Product error-proofing
• To design product in achieving zero defect
• To avoid errors due to human mistake.
• May reduce occurrence and detection ranking in
FMEA
52. 11/28/2018
52
Product error-proofing
Prototype Program
• Shall have a prototype program and control plan when required by
customer
• Whenever possible, use same suppliers, tooling and manufacturing
processes
• Monitor Performance-testingfor timely completion and conformity to
requirements
• Provide technical leadership for any services outsource
53. 11/28/2018
53
Phase 3
Process Design and Development
APQP Five Phase Process
Plan And Define Program
Product Design and Development
Process Design and Development
Product and Process Validation
Production
Feedback Assessment and Corrective Action
Pilot Launch
Concept
Initiation/Approval
Program
Approval
Prototype
Planning
54. 11/28/2018
54
Phase 3: Process Design And Development
Outputs
• Target for Manufacturing
process
• Process Flow Chart
• Control Plan
• Process FMEA
• Work Instructions
• Packaging Standards
• Floor Plant Layout
• Process Error Proofing
Measurement Systems
Analysis Plan
Preliminary Process Capability
Study Plan
Management Support
Target for manufacturing Process
• To identify, document and review targets for
manufacturing process design:
• Eg:
– Quality
– process capability
– productivity
– Manufacturibility
– Timing
55. 11/28/2018
55
Process Flow Chart
• May upgrade from preliminary process flow chart in phase 1
• Schematic representation of the current or proposed process
flow from receiving to final product
• Can assist the team to conduct PFMEA and develop control plan
• Any changes required should be updated in the
manual/procedure
Process Flow Chart
Virgin
QC
Mixing
Pre-heat
Moulding
QC
Recycle
QC
triming Assembly
Packing
56. 11/28/2018
56
Control Plan
• Type of control plan:
– prototype
– pre-launch
– production
• The control plan shall :
– list the control used for the manufacturing process
control
– Include methods for monitoring of control exercised
over special characteristics
– identify the specified reaction plan and corrective
action
• Shall be reviewed when any change occurs
Control Plan
• The control plan shall include:
– Process name
– Machine
– Product characteristics
– Process characteristics
– Special characteristics
– Product/process specification
– Measuring technique
– Sample size and frequency
– Control method
– Reaction Plan
– Corrective Action
57. 11/28/2018
57
Control Plan
No
11 a Overall height of form cup Ø 24.0 ± 0.4 Height gauge issue CAR for
b Inside diameter Ø 15.6 ref Caliper repeated problem
c Appearance Free from chip mark Visual
d Setting parameter Refer Tool Setting Sheet (BMSB 0915)
12 a Overall diameter Ø163.5 ref Caliper issue CAR for
b Distance from center to center holes 90.0 ± 0.5 Caliper repeated problem
c Hole diameter Ø36.0 ± 0.3 Caliper
d Appearance Free from burr Visual
e Setting parameter Refer Tool Setting Sheet (BMSB 0915)
13 a Redrawheight (outside) 2.2 -0/ +0.4 Height gauge issue CAR for
b Redrawheight (inside) 1.9 -0/ +0.5 Height gauge repeated problem
c Waviness 0.15 max Height gauge
d Appearance Free from chip mark Visual
e Setting parameter Refer Tool Setting Sheet (BMSB 0915)
14 a Overall diameter Ø161.0 ± 0.1 Caliper issue CAR for
b Appearance Free from burr Visual repeated problem
Corrective
Action
1/4 hours
batch Periodical insp
1 batch 1st sample
Every
F
1/4 hours
set up
set up C
H
Process
Size
Measuring
Technique
1st sample
Characteristic
Special
Char.
1
1
batch
1
1
1/4 hours
batch
F
Control
Method
2
Reaction
Plan
Sample
H
OP 130
HME 30T
OP 110
Center piercing
Redraw Li Chin H 250T
1
Method
Clip & Pierce Li Chin 200T
No Process Name/ Machine, Jig Product/ Process Spec/
Tol
Product
Visual insp.
batch
Freq
batch
1st sample C
1st sample C
C
Visual C
part
set up
Every
2
1st sample C
E
batch 1st sample
1st sample
1st sample
1st sample
Visual insp.
OP120 batch H
H
H
1
Visual insp.
2
batch 1st sample
1
Every C
1st sample
Every
C
OP 140
Trimming Suga 5
Update the Control Plan
Process
Flow
Control
Plan
FMEA Work
Instruction
Scrap, Rework Data
Warranty & Assembly Plant Data
58. 11/28/2018
58
Process FMEA
• To identify potential failure due to manufacturing or assembly
process.
• To assess the effects of the potential failures on the customer
• To focus controls for occurrence reduction or detection
• To establish a ranked list of potential failure modes based on RPN
calculated
FMEA
Design
Potential
Failure
PotentialCause Effects
59. 11/28/2018
59
Establish Potential Failure Mode
Process Function / Requirements PotentialFailure Mode
Component Insertion
Insert LED of differentcolours on to PC Board
with the right polarity and in the right sequence
1. Wrong colour LED used
2. Wrong polarity
3. Wrong sequence
Soldering of components
Solder the component leads to PC Board using
soldering iron
1. Cold Solder Joint
2. Not enough solder
Trim Leads
Cut the component leads to shorter length
1. Lead length too long
2. Burrs on lead
Burn in
Stabilize the LED and eliminateinfant
1. ElectricalOver stress
Example :
Product
Function
Potential
Failure
Mode
Potential
Effect(s) of
failure
S
e
v
C
l
a
s
s
Potential
Cause(s) of
Failure
O
c
c
ur
Current
Control
(Prevention)
Current
Control
(Detection)
D
et
ec
R
P
N
Recommend
ed Action
Responsibility
and
Completion
Date
Action
Taken
Severity
Occurrence
Detection
RPN
PROCESS FAILURE MODE AND EFFECTS ANALYSIS (PFMEA)
Add positive
depth stop to
sprayer
Use Design of
Experiements
(DOE)
None
Install spray
timer
A Tate-Body
Engrg
9X 15 15
Mfg Eng
9X 10 01
Maintenance
9X 09 15
Stop added,
sprayer
checked on-
line
Temp and
pressure were
determined -
result Cpk =
1.85
Automatic
spray timer
installed,
Cpk = 2.05
7 2 5 70
7 1 5 35
7 1 7 49
280
175
70
392
2
5
8
8
Manually
inserted - spray
head not
inserted far
enough
Spray heads
clogged
Spray head
deformed
due to impact
Spray time
insufficient
Front Door
L.H
H8HX-0000-A
• Ingress to
and egress
from
vehicle
• Occupant
protection
from
weather,
noise and
side impact
• Support
anchorage
for door
hardware
including
mirror,hing
es, lacth
and
window
regulator
Corroded
interior lower
door panels
Deteriorated
life of door
leading to:
•
unsatisfactor
y
appearance
due to rust
through
paint over
time
• Impaire
function of
interior door
hardware
7++
Test spray
pattern at
start-up and
after ideal
period
Preventive
maintenance
program
Visual check
each hour for
film thickness
and coverage
Visual check
each hour for
film thickness
Visual check
each hour for
film thickness
Lot sampling(10
doors/shift) to
check coverage
for critical areas
5
5
5
7
60. 11/28/2018
60
Work Instructions
• Prepare documented work instruction for employees having responsibilities for
operation that impact quality
• Instruction shall be accessible for use at the work station
• Derived from sources such as:
– control plan,
– PFMEA
– Engineering drawing
– DFMEA
Part Number: KB 01/19 Op. Number: - 140
Issue - 1
Part Description: - PULLEY: -
(POWER STEERING )
Op. Description: Trim & Chamfer
Date : 17/6/2002
Process Eng: - CM TAN
PPC: - WY SIT QA: - HUSAINI
(2)
Kasut Keselamatan
Persiapan
Keselamatan Diri
Penutup
Telinga
Sarung
Tangan
MINYAKDAN
GRIS BOLEH
MEROSAKAN
KULIT
Gambarajah Aliran Proses
Arahan Proses / Work Instructions
(1) (4)
(3) (5)
(6)
Rev. : 0
Doc. No. : WI-KB01/19-140/A
(1) Ambil ‘Part’dari bin (2) Letakkan ‘part’ pada
‘mandrel’
denganbetul.
(3) Pasangkanpemegang ‘part’
melalui lubangskru, dan
pastikania dimasukkandengan
betul.
(4) Pulaskantuaske fungsi ‘Auto’
mengetatkan ‘part’pada mandrel.
Panel Operasi Mesin
Butang ‘cycle
start’ atauoperasi
(A) Butang
kecemasan
‘return’
(B)
Butang
Kecemasan
berhenti
(C)
Keadaan Tempat Kerja
(1) Pastikansemuasisalebihankerjaseperti
sarung tangan,kainburukdansisabesi
dibersihkandari mesin sebelummesin
digunakan.
(2) Jikaterdapat‘part’pada mesin,
asingkanyakedalam‘polybox’ataubakul
‘reject’merah.
(3) Pastikanterdapatsekurang-kurangnya1
bin
WIP & binkosongdisediakanuntuksyif
berikutnyasebelumpulang.
(4) Pastikan’machine&operatormonitoring
sheet’
di isi denganbetul setiapjamapabilamesin
beroperasi.,sertaisikan‘Route card’untuk
setiapbinyang telahdisiapkan
Kawalan Kualiti
(1) Perhatikan‘part’ denganmata kasar
untukmasalahseperti berikut:
a) ‘Burr’ yangberlebihanpada
bahagian‘part’yangdipotong.
b) Pemotonganbersudutyangtidak
seragam.
c) Bahan terkupasdari permukaan
‘part’.
( 2) Jikamasalahseperti diatas dikenal
pasti olehoperatordania berlaku
5 kali berturut-turut,berhentikan
mesindanrujukkepadasupervisor
untuk langkahseterusnya.
(3) ‘Part’yang dikenalpastisebagai
‘reject’harusdibuangke dalam
‘polybox’ ataubakul ‘reject’
merah.
Keselamatan & Kecemasan
1) Pastikanpintumesinditutupapabilamesinberoperasi supayasisadari ‘part’
tidakterkenaanggotabadanoperator.
2) Pastikanpemegang‘Part’dipegangdenganbetul seperti gambar3untuk
mengelak dari terkepitnyajari.
3) Jikakeadaankecemasanberlakupadamesinketikaiadioperasikan,tekan
butang(B) danjikaia tidakberhasil gunakanbutang (C) seperti yang
ditunjukkanpada‘PanelOperasi Mesin’.
(5) Tutup pintukeselamatan
mesin
Machine Type: Suga (T1)
Ulangi langkah 1 untuk
langkah seterusnya.
(6) Tekan butanghitam‘cycle
start’ untuk memulakan
operasi.
(8)
(7) (10)
(8) Keluarkan pemegang
‘part’
(7) Setelah ‘part’siap dipotong
pulaskantuas ke fungsi
‘manual’untukmelonggarkan
pemegang ‘part’dari
‘mandrel’
(9)
(9) Keluarkan ‘part’yang
telah siapdan
masukkankedalam bin.
Mandrel
Part
Pemegang ‘part’
61. 11/28/2018
61

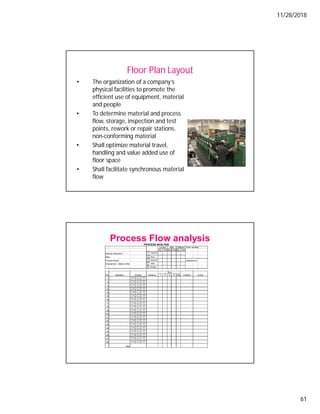

Floor Plan Layout
• The organization of a company’s
physical facilities to promote the
efficient use of equipment, material
and people
• To determine material and process
flow, storage, inspection and test
points, rework or repair stations,
non-conforming material
• Shall optimize material travel,
handling and value added use of
floor space
• Shall facilitate synchronous material
flow
Process Flow analysis
Team member:
Qty Time Qty Time Qty Time
Monthly production :
Date:
Process Name: Approved by:
Improvement : Before/ After
1 2 3 4 Avg
1
2
3
13
14
15
16
17
18
19
20
21
22
23
24
25
26
27
28
Total
Symbol
Operation
No
Current
Time
Distance
After Different
Problem Action
PROCESS ANALYSIS
Operation
Move
Inspection
Delay
Storage
62. 11/28/2018

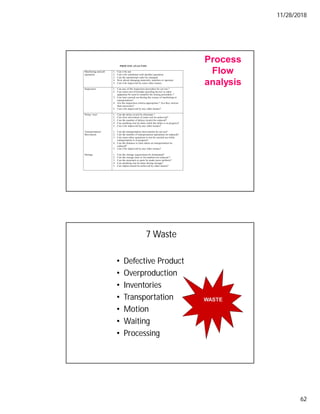

62
Process
Flow
analysis
PROCESS ANALYSIS
Machining and job
operation
1. Can it be out
2. Can it be combined with another operation
3. Can the operational order be changed
4. How about changing materials, machine or operator
5. Can it be improved by some other means
Inspection 1. Can any of the inspection procedure be cut out ?
2. Can some sort of mistake proofing device or other
apparatus be used to simplify the testing procedure ?
3. Can tests carried out during the course of machining or
transportation?
4. Are the inspection criteria appropriate ? Are they stricter
than necessary?
5. Can it be improved by any other means?
Delay/ wait 1. Can the delay (wait) be eliminate ?
2. Can slow movement of some sort be achieved?
3. Can the number of delays (waits) be reduced?
4. Can anything else be done while the delay is in progress?
5. Can it be improved by any other means?
Transportation/
Movement
1. Can the transportation (movement) be cut out?
2. Can the number of transportation operations be reduced?
3. Can some other operation or test be carried out while
transportation is in progress?
4. Can the distance or time taken on transportation be
reduced?
5. Can it be improved by any other means?
Storage 1. Can the storage requirement be eliminated?
2. Can the storage time or lot numbers be reduced ?
3. Can the materials or parts be made more uniform?
4. Can anything else be done during storage?
5. Can improvement be achieved by other means?
7 Waste
• Defective Product
• Overproduction
• Inventories
• Transportation
• Motion
• Waiting
• Processing
WASTE
63. 11/28/2018
63

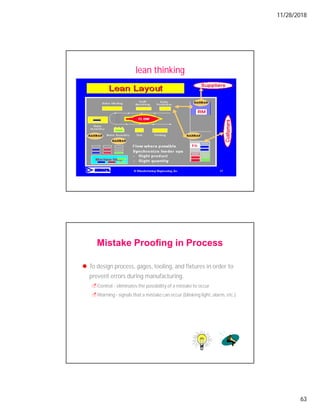

lean thinking
To design process, gages, tooling, and fixtures in order to
prevent errors during manufacturing.
Control - eliminates the possibility of a mistake to occur
Warning - signals that a mistake can occur (blinking light, alarm, etc.)
Mistake Proofing in Process
64. 11/28/2018
64

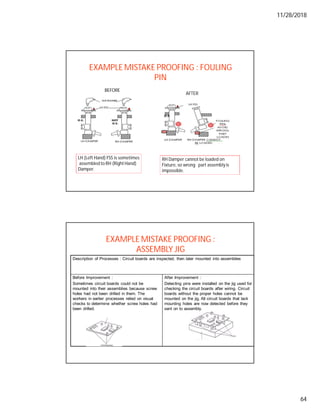

BEFORE
LH (Left Hand) FSS is sometimes
assembled to RH (RightHand)
Damper.
RH Damper cannot be loaded on
Fixture, so wrong part assemblyis
impossible.
AFTER
EXAMPLE MISTAKE PROOFING : FOULING
PIN
After Improvement :
Detecting pins were installed on the jig used for
checking the circuit boards after wiring. Circuit
boards without the proper holes cannot be
mounted on the jig. All circuit boards that lack
mounting holes are now detected before they
sent on to assembly.
Before Improvement :
Sometimes circuit boards could not be
mounted into their assemblies because screw
holes had not been drilled in them. The
workers in earlier processes relied on visual
checks to determine whether screw holes had
been drilled.
Description of Processes : Circuit boards are inspected, then later mounted into assemblies
EXAMPLE MISTAKE PROOFING :
ASSEMBLY JIG
65. 11/28/2018
65
Packaging Standard
• To identify any packaging standard required by customer
• Must assure packaging design meet customer requirements
• Packaging design must assure product performance and
characteristics remain unchanged during packing and delivery
• Compatibility with all material handling equipment including
robots
Packaging Standard
Part Name Length
Part No. Width
Model Height
Customer Weight/pcs
Sensitive to:
Packaging Method Packaging Type
Quantity / Packing No of Layer
Packaging Weight Layering material
Packaging Size Packaging Identification
Sketch
Date Name Sign Date Name Sign Date Name Sign
Customer Review
Supplier Proposal
Approved By
Approved By
Prepared By
Part Information
Packaging Information
Part Packaging Data Sheet
Part
Dimension
(mm)
ARI-FRM-QA-007
66. 11/28/2018
66

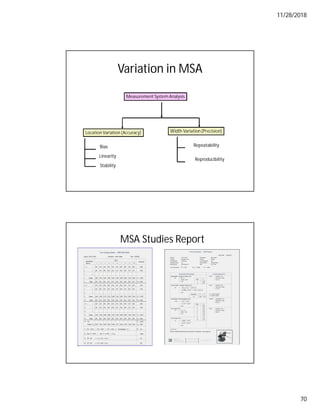

Measurement System Analysis Plan
• Plan to accomplish the required MSA
• Include as a minimum, the responsibility to ensure
gage linearity, accuracy, repeatability and
reproducibility
Preliminary Process Capability Plan
• Must include characteristics identified in control plan
• Include as a minimum:
– responsibility
– Cpk/ Ppk value
– time
67. 11/28/2018
67
Phase 4
Product and Process Validation
APQP Five Phase Process
Plan And Define Program
Product Design and Development
Process Design and Development
Product and Process Validation
Production
Feedback Assessment and Corrective Action
Pilot Launch
Concept
Initiation/Approval
Program
Approval
Prototype
Planning
68. 11/28/2018

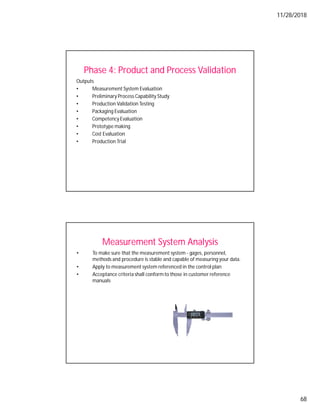

68
Phase 4: Product and Process Validation
Outputs
• Measurement System Evaluation
• Preliminary Process Capability Study
• Production Validation Testing
• Packaging Evaluation
• Competency Evaluation
• Prototype making
• Cost Evaluation
• Production Trial
Measurement System Analysis
• To make sure that the measurement system - gages, personnel,
methods and procedure is stable and capable of measuring your data.
• Apply to measurement system referenced in the control plan
• Acceptance criteria shall conformto those in customer reference
manuals
69. 11/28/2018
69
What Is a Measurement System Analysis
Input Measurement
System
Measurements
Outputs
Instruments
Methods
Materials
(Reference)
Manpower
Environment
Measurement System Analysis (MSA)
Continuous Improvement
Numbers (data)
• To assess the quality of a measurement system.
• To ensure that the variation in the measurement system is acceptable.
• To minimize the effects of measurement system error
• product decision
• process decision
• New process Acceptance
PURPOSE OF MSA
71. 11/28/2018
71

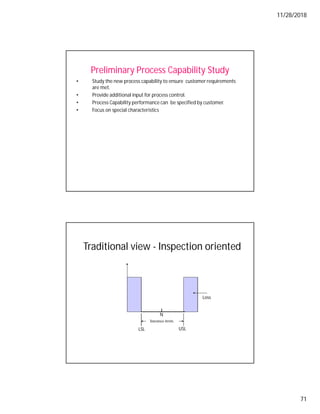

Preliminary Process Capability Study
• Study the new process capability to ensure customer requirements
are met.
• Provide additional input for process control.
• Process Capability performance can be specified by customer.
• Focus on special characteristics
Traditional view - Inspection oriented
Loss
N
USL
LSL
Tolerance limits
72. 11/28/2018
72

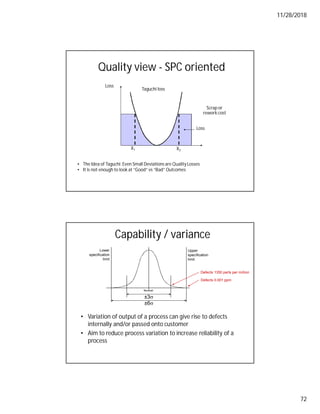

Quality view - SPC oriented
• The Idea of Taguchi: Even Small Deviations are Quality Losses
• It is not enough to look at “Good” vs “Bad” Outcomes
X1 X2
Loss
Scrap or
reworkcost
Taguchi loss
Loss
Capability / variance
• Variation of output of a process can give rise to defects
internally and/or passed onto customer
• Aim to reduce process variation to increase reliability of a
process
Nominal
Upper
specification
limit
Lower
specification
limit
±3
±6
Defects 1350 parts per million
Defects 0.001 ppm
73. 11/28/2018
73
• Actual
• Meet Specification
• Improvement
USL
T
LSL
USL
T
LSL
T
USL
LSL
USL’
LSL’
The Strategy
The goal should not be 100% conformanceto specification(zero defect), but
the never-ending reduction of processes variation so that product/services are
as close to nominal
UCL
LCL
LCL
LCL
UCL
UCL
Process not centered
and not stable
Process centered
and stable
Additional improvements
made to the process
Improvements
74. 11/28/2018
74

1 2 3 4 5 6 7 8 9 10 11 12 13 14 15 16 17
n 1 2 3 4 5 6 7 8 9 10 11 12 13 14 15 16 17
1 44.46 44.43 44.45 44.44 44.46 44.44 44.44 44.46 44.44 44.43 44.44 44.44 44.45 44.47 44.46 44.44 44.44
2 44.46 44.46 44.46 44.44 44.47 44.45 44.43 44.43 44.45 44.44 44.44 44.45 44.46 44.42 44.47 44.42 44.43
3 44.44 44.45 44.45 44.43 44.45 44.43 44.44 44.42 44.46 44.43 44.44 44.45 44.48 44.43 44.45 44.43 44.44
4 44.45 44.46 44.44 44.44 44.48 44.45 44.43 44.45 44.43 44.45 44.45 44.46 44.48 44.46 44.48 44.45 44.46
5 44.43 44.45 44.45 44.45 44.45 44.44 44.43 44.46 44.45 44.45 44.43 44.45 44.45 44.45 44.43 44.44 44.43
Average 44.448 44.45 44.45 44.44 44.462 44.442 44.434 44.444 44.446 44.44 44.44 44.45 44.464 44.446 44.458 44.436 44.44
Ra nge 0.03 0.03 0.02 0.02 0.03 0.02 0.01 0.04 0.03 0.02 0.02 0.02 0.03 0.05 0.05 0.03 0.03
Value
21 22 23 24 25 125
44.48
n 21 22 23 24 25 44.42
1 44.44 44.44 44.45 44.44 44.44 45.7
2 44.44 44.44 44.46 44.47 44.47 44.3
3 44.44 44.45 44.44 44.45 44.45 105.762
4 44.45 44.46 44.44 44.45 44.44 12.427
5 44.46 44.45 44.45 44.45 44.45 17.879
3.75968
19.698
12.427
4.142
0 25
ITEM
Number of readings
Max
imum
Minim um
Upper Spec Lim it (USL)
Lower Spec Lim it (LSL)
ZUSL
ZLSL
Perform ance index (Pp)
Capability Index (Cpk)
SW-34253 Characteristic
Company XYZ Sdn Bhd Part Name
AVERAGE X BAR AND R CONTROL CHART
Specification Lower Spe c 44.3
Description Bra cket Sample Size 5
Part Number
Performance Index (Ppk)
Capability Index (Cp)
Zm in
Upper Spe c 45.7
AV ERAGES ( X BAR CHART)
44.425
44.43
44.435
44.44
44.445
44.45
44.455
44.46
44.465
44.47
1 2 3 4 5 6 7 8 9 10 11 12 13 14 15 16 17 18 19 20 21 22
X BAR A VG OF X BAR UCL-XBAR LCL-XBAR
HIST OGR A M
44. 3
44.45
19
34
38
20
20
30
40
50
60
70
80
HISTOGRAM WITHOUT LIM IT
19
34
38
20
7
10
15
20
25
30
35
40
RANGE (R CHART)
0
0.01
0.02
0.03
0.04
0.05
0.06
0.07
1 2 3 4 5 6 7 8 9 10 11 12 13 14 15 16 17 18 19 20 21 22
R
A
N
G
E
R R BAR UCL-R LCL-R
Production Validation Testing
• Shall be performed in accordance with planned arrangement
• To ensure resulting product is capable to meet specified requirements
• Validation required such as
– material specification
– functional
– Dimensional
– Realibility/ Durability
75. 11/28/2018
75

Product Validation (Example)
Prepared by:
No: Characteristic or parameter to be validated Specification Result Remarks
No:
Approved by:
Effective date:
TITLE:
Packaging Evaluation
• Assess the protection of the product from normal
transportation damage and adverse environmental factors
• Customer-specified packaging does not preclude in
evaluating the packaging method
76. 11/28/2018
76
Packaging Evaluation: Example
Parts Packaging/Shipping Specifications
STATUS
(G/Y/R)
1 1 Has adequate protective packaging for finished product been defined?
1 2 Have records of test shipping containers and trips been documented? (Ex: What was used on PV build?)
1 3 Does the label meet AIAG and ASG requirements?
1 4 Have you completed and submitted ASG Packaging Data Forms (PDF) for all components?
1 5 Is your system ready to send Advance Ship Notices (ASN) for these parts?
1 6 Have you received a copy of the ASG routing instructions?
1 7
Has the shipping system been established to include:
1) Ship to Location & Dock Code
2) Shipment Frequency & Window
3) Primary Carrier
4) Expedite Carrier (Use NLM's One-Call only!)
5) Container Return/Maintenance
6) Saturday <Weekend?> Shipments
7
Quality Planning Sign-Off
• To review relevant documents to ensure
– Process instructions in place and followed
– Flow charts in place and followed
– Process Instruction is consistent with PFMEA and control plan
– GR&R meets the acceptable limit
77. 11/28/2018
77
Quality Planning Sign-Off
DATE :
PRODUCT NAME PART NUMBER
CUSTOMER MANUFACTURING PLANT
1. PRELIMINARY PROCES S CAPABILITY STUDY
Ppk- SPECIAL CHARACTERISTICS
2. CONTROL PLAN APPROVAL (If required) APPROVED : YES/NO * DATE APPROVED :
3. INITIAL PRODUCTION S AMPLES
CHARACTERIS TIC CATEGORY
S AMPLES PENDING
DIMENSIONAL
VISUAL
LABORATORY
PERFORMANCE
4. GAGE AND TEST EQUIPMENT
MEASUREMENT SYSTEM ANALYSIS
SPECIAL CHARACTERISTIC
5. PROCESS MONITORING
PROCESS MONITORING INSTRUCTIONS
PROCESS SHEETS
VISUAL AIDS
6. PACKAGING / SHIPPING
PACKAGING APPROVAL
SHIPPING TRIALS
7. SIGN-OFF
QUANTITY
REQUIRED ACCEPTABLE PENDING *
QUANTITY
REQUIRED ACCEPTABLE PENDING *
QUANTITY
REQUIRED ACCEPTABLE PENDING *
QUANTITY
CHARACTERIS TICS
PER SAMPLE ACCEPTABLE
PRODUCT QUALITY PLANNING SUMMARY AND SIGN-OFF
QUANTITY
REQUIRED ACCEPTABLE PENDING *
Reduce the Cost of Components
• Understand the Process Constraints and Cost Drivers
• Redesign Components to Eliminate Processing Steps
• Choose the Appropriate Economic Scale for the Part
Process
• Standardize Components and Processes
• Adhere to “Black Box” Component Procurement
78. 11/28/2018
78

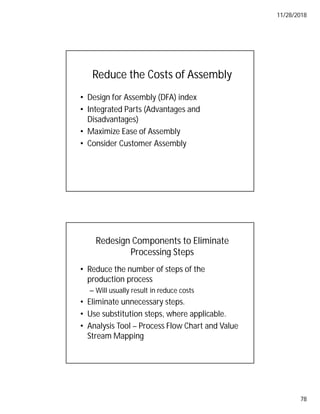

Reduce the Costs of Assembly
• Design for Assembly (DFA) index
• Integrated Parts (Advantages and
Disadvantages)
• Maximize Ease of Assembly
• Consider Customer Assembly
Redesign Components to Eliminate
Processing Steps
• Reduce the number of steps of the
production process
– Will usually result in reduce costs
• Eliminate unnecessary steps.
• Use substitution steps, where applicable.
• Analysis Tool – Process Flow Chart and Value
Stream Mapping
79. 11/28/2018
79
Production Trial Run
• Shall be conducted using production tooling,
equipment, environment, facility and cycle time
• Minimum quantity for a production trial run is
usually set by the customer
Product Approval Process
• The organization shall conform to a product and
manufacturing process approval procedure recognized by
the customer.
• This product and manufacturing process approval
procedure shall also be applied to suppliers
81. 11/28/2018
81

Common techniques for process improvement
Input/output analysis Flow charts Scatter diagrams
Cause-effect diagrams Pareto diagrams Why-why analysis
Input Output
x
x
x x
x x
x
x
x
x x
Why?
Why?
Why?
Corrective Action Log
Quest. # Issue
Person
Responsible
Target
due date
Completion
date
Corrective Action Plan
82. 11/28/2018
82

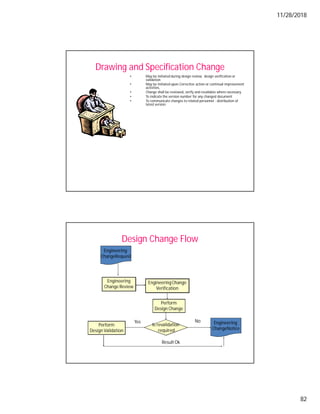

Drawing and Specification Change
• May be initiated during design review, design verification or
validation
• May be initiated upon Corrective action or continual improvement
activities,
• Change shall be reviewed, verify and revalidate where necessary
• To indicate the version number for any changed document
• To communicate changes to related personnel - distribution of
latest version
Design Change Flow
Engineering
Change Review
EngineeringChange
Verification
Perform
Design Change
Is revalidation
required
Perform
Design Validation
Engineering
ChangeNotice
Engineering
ChangeRequest
No
Yes
Result Ok
83. 11/28/2018
83

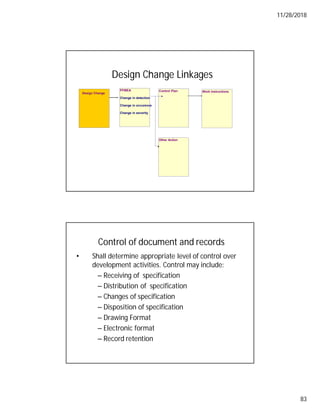

Design Change Linkages
Work Instructions
PFMEA
Change in detection
Change in occurence
Change in severity
Control Plan
Design Change
Other Action
Control of document and records
• Shall determine appropriate level of control over
development activities. Control may include:
– Receiving of specification
– Distribution of specification
– Changes of specification
– Disposition of specification
– Drawing Format
– Electronic format
– Record retention
