Agile Projects Series
Sizing and Estimation
https://medium.com/expedia-group-tech/demystifying-story-points-d642f9879952
Agile Projects Sizing and Estimation

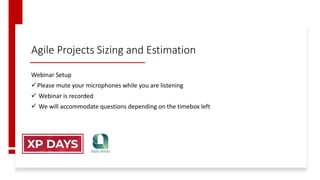

Webinar Setup
Please mute your microphones while you are listening
 Webinar is recorded
 We will accommodate questions depending on the timebox left
XP Days
 It's an initiative for gathering people
interested in Agile, eXtreme Programming,
Scrum, Coding, etc…
 It’s our 8th event
 Webinar is co-hosted with Agile Arena
 www.xpdays.org

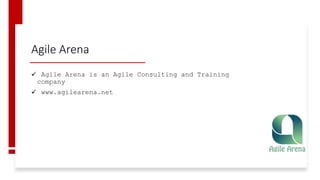

Agile Arena
 Agile Arena is an Agile Consulting and Training
company
 www.agilearena.net
Ahmed Helmy
• Software Consultant
• Founder of XP Days
• Certified Scrum Master
• Certified Scrum Developer
• Certified Scrum Product Owner
@helmy204
ahmedhelmy204@hotmail.com
www.linkedin.com/in/helmy204
www.github.com/helmy204
Agenda
• Product Backlogs
• Estimation units and scales
• Agile Sizing and Estimation Techniques
How long will it take to read this book?
Scrum Artifacts
Product Level (Shared Vision)
• Product Backlog
Sprint Level (Sprint Goal)
• Sprint Backlog
• Product Increment
https://www.scrum.org/resources/scrum-framework-poster
Product Backlog Sources
• Requirements – New Features
• Compliance
• Defects
• Technical Work
• Infrastructure Enhancements

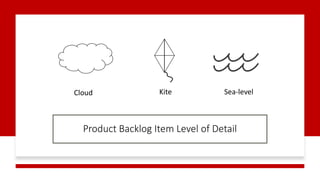

Product Backlog Item Level of Detail
Kite Sea-levelCloud

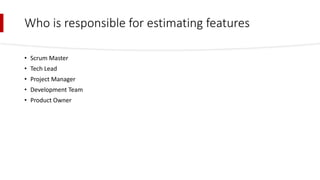

Who is responsible for estimating features
• Scrum Master
• Tech Lead
• Project Manager
• Development Team
• Product Owner
How long will it take to read these books?
Group 1 Group 2 Group 3 Group 4 Group 5
‫سمرقند‬ ‫علي‬ ‫قمر‬ 45 30
How to enjoy your life and your
job
30 10
The Hobbit 30 15.5
‫خالد‬ ‫عبقرية‬ 15 7.5
Thinking fast and slow 5 23
‫الصغار‬ ‫لمعانقة‬ ‫الصغير‬ ‫الكتاب‬ 1 3
Estimation units
Story Points
• How long a user story will
take (effort)
• Influenced by complexity,
uncertainty, risk, volume
of work, etc.
• Relative values are what is
important
Ideal Time
• The time needed to complete a
given task as if
• It’s all you work on
• No one interrupts you
• And everything you need is
available
• Simple and easy to use, yet it can
be easily understood by and
explained to all stakeholders
• The measure of ideal time varies
from one person to another
based on their own skills and
competencies

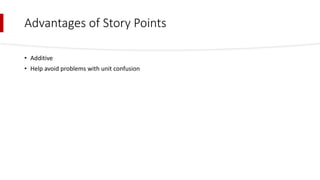

Advantages of Story Points
• Additive
• Help avoid problems with unit confusion

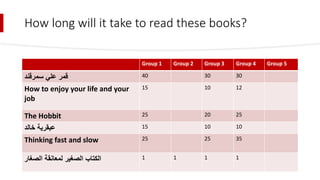

How long will it take to read these books?
Group 1 Group 2 Group 3 Group 4 Group 5
‫سمرقند‬ ‫علي‬ ‫قمر‬ 40 30 30
How to enjoy your life and your
job
15 10 12
The Hobbit 25 20 25
‫خالد‬ ‫عبقرية‬ 15 10 10
Thinking fast and slow 25 25 35
‫الصغار‬ ‫لمعانقة‬ ‫الصغير‬ ‫الكتاب‬ 1 1 1 1
Planning in a week!
The XP solution is to accept more
risk in the plan by having bigger
stories. Write stories you can
estimate in terms of ideal
programming months instead of
ideal programming weeks
Estimation Scale
• 1, 2, 3, 5, and 8 (Fibonacci sequence)
• The gaps in the sequence become appropriately larger as the numbers
increase
• 1, 2, 4, and 8 (each number is twice the number that precedes it)
• These non-linear sequences work well because they reflect the
greater uncertainty associated with estimates for larger units of work.
Either sequence works well although my slight personal preference is
for the first
What are sizing and
estimation techniques you
used to work with?
Agile Sizing and
Estimation
Bottom-up vs Top-down approaches
T-Shirt Sizing
Planning Poker
Wideband Delphi
Affinity Estimating
Estimating with Pomodoros

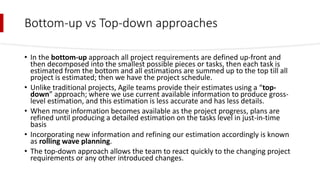

Bottom-up vs Top-down approaches
• In the bottom-up approach all project requirements are defined up-front and
then decomposed into the smallest possible pieces or tasks, then each task is
estimated from the bottom and all estimations are summed up to the top till all
project is estimated; then we have the project schedule.
• Unlike traditional projects, Agile teams provide their estimates using a “top-
down” approach; where we use current available information to produce gross-
level estimation, and this estimation is less accurate and has less details.
• When more information becomes available as the project progress, plans are
refined until producing a detailed estimation on the tasks level in just-in-time
basis
• Incorporating new information and refining our estimation accordingly is known
as rolling wave planning.
• The top-down approach allows the team to react quickly to the changing project
requirements or any other introduced changes.
T-Shirt Sizing

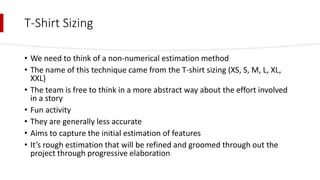

T-Shirt Sizing
• We need to think of a non-numerical estimation method
• The name of this technique came from the T-shirt sizing (XS, S, M, L, XL,
XXL)
• The team is free to think in a more abstract way about the effort involved
in a story
• Fun activity
• They are generally less accurate
• Aims to capture the initial estimation of features
• It’s rough estimation that will be refined and groomed through out the
project through progressive elaboration

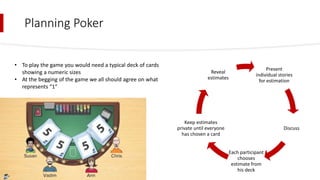

Planning Poker
Present
individual stories
for estimation
Discuss
Each participant
chooses
estimate from
his deck
Keep estimates
private until everyone
has chosen a card
Reveal
estimates
• To play the game you would need a typical deck of cards
showing a numeric sizes
• At the begging of the game we all should agree on what
represents “1”
Wideband Delphi
• Each of the participants submits his/her estimation in anonymous
rounds
• Define the problem
• Create an estimation form for the work
• Participants work alone to come up with the estimation
• Facilitator collects the estimates and plot them on a graph
• Participants discuss the estimates that vary widely
• Estimation round is repeated till consensus starts to emerge
Affinity Estimating
• Similarity
• Grouping into affinities of similar size
Affinity Estimating
• The size of each of the user stories is compared to other stories to
ensure that all the estimates remain consistent
• User stories are estimated collaboratively, using any estimating
technique (T-Shirt sizing, Wideband Delphi, or Planning Poker,…)
• Affinity estimation is not a technique for estimating the size of user
stories, but it’s a technique for grouping the previously estimated
user stories into affinities to ensure the consistency in size
Estimating with Pomodoros
• 25 minute work sessions followed by 5 minute breaks
sessions
• Cycle of fixed time boxes prevent mental fatigue
• Each 25-5 minute cycle is called a Pomodoro
• Every 4 Pomodoros is called a set
• After each set you take 15 minutes break
Let’s try it!

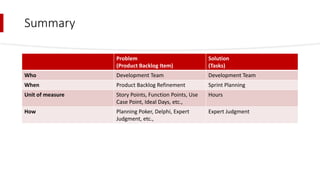

Summary
Problem
(Product Backlog Item)
Solution
(Tasks)
Who Development Team Development Team
When Product Backlog Refinement Sprint Planning
Unit of measure Story Points, Function Points, Use
Case Point, Ideal Days, etc.,
Hours
How Planning Poker, Delphi, Expert
Judgment, etc.,
Expert Judgment
Questions
Thank You
www.agilearena.netwww.xpdays.org
