© 2011 TeamProsource3
CLICK TO EDIT MASTER TITLE STYLE
Click to edit Master text styles
CAN WE COMBINE
PLAN-DRIVEN PROJECT MANAGEMENT
WITH
AGILE EXECUTION ?
© 2011 TeamProsource44

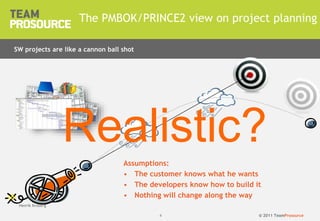

The PMBOK/PRINCE2 view on project planning
Henrik Kniberg
Assumptions:
• The customer knows what he wants
• The developers know how to build it
• Nothing will change along the way
SW projects are like a cannon ball shot
Realistic?
© 2011 TeamProsource55
The Agile view on project planning
Henrik Kniberg
Assumptions:
The customer discovers what he wants
The developers discover how to build it
Things change along the way
Product
vision
SW projects are like homing missiles
Realistic?
© 2011 TeamProsource66
Content of presentation
• Plan-driven versus agile project management
• How to initiate agile projects?
• How to monitor & control agile projects?
• Roles and responsibilities revisited
• PMBOK knowledge area’s revisited
Can we combine best of both worlds?
© 2011 TeamProsource77

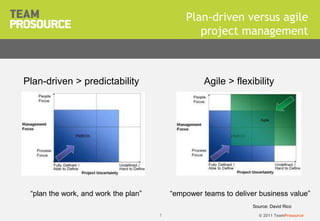

Plan-driven versus agile
project management
Plan-driven > predictability Agile > flexibility
Source: David Rico
“plan the work, and work the plan” “empower teams to deliver business value”
© 2011 TeamProsource8

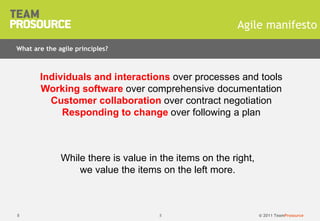

Agile manifesto
Individuals and interactions over processes and tools
Working software over comprehensive documentation
Customer collaboration over contract negotiation
Responding to change over following a plan
8
What are the agile principles?
While there is value in the items on the right,
we value the items on the left more.
© 2011 TeamProsource99
Scrum roles
© 2011 TeamProsource10
Scrum process
Title Presentation | Version x.x

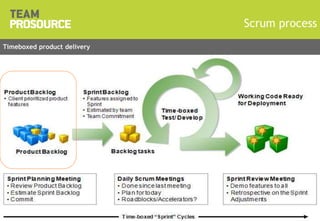

Timeboxed product delivery
© 2011 TeamProsource1111

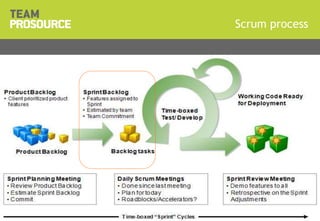

Scrum process
Title Presentation | Version x.x
© 2011 TeamProsource1212
Scrum process
Title Presentation | Version x.x
© 2011 TeamProsource1313
Scrum process
Title Presentation | Version x.x

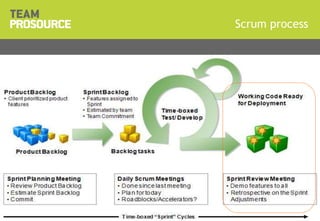

© 2011 TeamProsource1414
Scrum process
Title Presentation | Version x.x
© 2011 TeamProsource1515
Choosing between plan-driven and agile
Plan-driven Indicators Agile
Solution delivery Type of project Experimental discovery
Multiple interdependencies & interface complexity Few interdependencies
Regulated (pharma) Regulatory context Unregulated
Fixed or quite certain Scope Dynamic & Uncertain
Passive or unavailable Stakeholders Ongoing involvement
All or nothing Value creation incremental ROI
Big bang Delivery incremental (small steps)
Distributed & fluctuating Team Collocated & stable
Command & control or micromanagement Company culture Empowerment & self management
Title Presentation | Version x.x
Some criteria to select the most effective approach
Problem
The assessment is
seldom clearcut
© 2011 TeamProsource1616
Agile project management
Title Presentation | Version x.x
Combining project governance with agile development (example)
© 2011 TeamProsource17

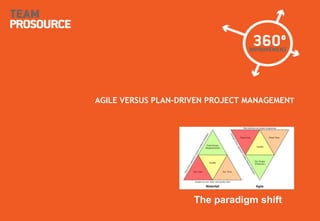

CLICK TO EDIT MASTER TITLE STYLE
Click to edit Master text styles
AGILE VERSUS PLAN-DRIVEN PROJECT MANAGEMENT
The paradigm shift
© 2011 TeamProsource1818

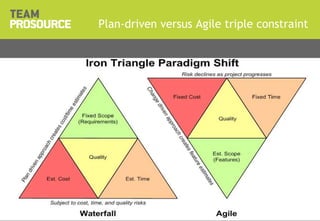

Plan-driven versus Agile triple constraint
Title Presentation | Version x.x
© 2011 TeamProsource1919
• Agile focuses on delivering
value increments
Title Presentation | Version x.x
Flexible scope
© 2011 TeamProsource2020
Flexible scope

Agile focuses on delivering value increments
20Standish Group Study Reported at XP2002 by Jim Johnson, Chairman
Always
7%
Often
13%
Sometimes
16%
Rarely
19%
Never
45%
Rarely or Never
Used: 64%
Often or Always
Used: 20%
Delivering value is hard…..
© 2011 TeamProsource2121

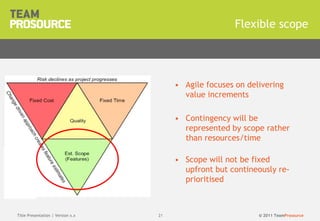

Flexible scope
• Agile focuses on delivering
value increments
• Contingency will be
represented by scope rather
than resources/time
• Scope will not be fixed
upfront but contineously re-
prioritised
Title Presentation | Version x.x
© 2011 TeamProsource2222

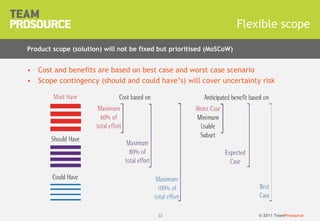

• Cost and benefits are based on best case and worst case scenario
• Scope contingency (shouid and could have’s) will cover uncertainty risk
Flexible scope
Product scope (solution) will not be fixed but prioritised (MoSCoW)
© 2011 TeamProsource2323

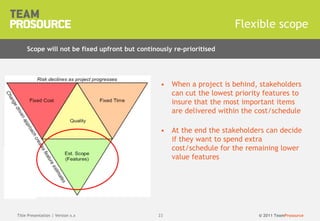

• When a project is behind, stakeholders
can cut the lowest priority features to
insure that the most important items
are delivered within the cost/schedule
• At the end the stakeholders can decide
if they want to spend extra
cost/schedule for the remaining lower
value features
Flexible scope
Title Presentation | Version x.x
Scope will not be fixed upfront but continously re-prioritised
© 2011 TeamProsource2424

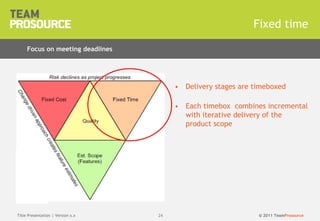

• Delivery stages are timeboxed
• Each timebox combines incremental
with iterative delivery of the
product scope
Fixed time
Title Presentation | Version x.x
Focus on meeting deadlines
© 2011 TeamProsource2525
Incremental delivery
Early delivery of business benefit where possible (= incremental)
Incremental delivery enables early
Return on Investment (ROI)
• Continually confirm correct solution is
being built
• Formally re-assess priorities and ongoing
project viability with each delivered
increment
© 2011 TeamProsource2626
Iterative delivery
Planned rework strategy allows team to converge to an accurate solution
• Iterative delivery builds customer
feedback into each iteration
• Acknowledge that things may get
wrong before getting right
• Accept that most details emerge later
rather than sooner
• Embrace change – the right solution
will not evolve without it
• Sometimes difficult to determine
upfront how many improvement
passes will be needed
© 2011 TeamProsource2727

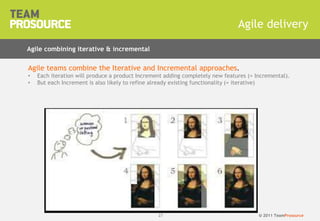

Agile delivery
Agile combining iterative & incremental
Agile teams combine the Iterative and Incremental approaches.
• Each iteration will produce a product Increment adding completely new features (= Incremental).
• But each Increment is also likely to refine already existing functionality (= iterative)
© 2011 TeamProsource2828
• As the team members go through the
“must have” list of features they can
estimate how many sprints (iterations)
they will need to complete the project
Fixed costs
Title Presentation | Version x.x
Fixed cost per iteration
© 2011 TeamProsource2929
• Initial Rough Order of Magnitude
estimate (ROM)
• At the beginning of the project the
accuracy may be +/- 50%.
• The risks of more iterations to be
added later on should be
acknowledged
Fixed costs
Upfront estimation of agile projects
© 2011 TeamProsource3030

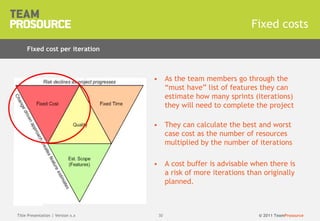

• As the team members go through the
“must have” list of features they can
estimate how many sprints (iterations)
they will need to complete the project
• They can calculate the best and worst
case cost as the number of resources
multiplied by the number of iterations
• A cost buffer is advisable when there is
a risk of more iterations than originally
planned.
Fixed costs
Title Presentation | Version x.x
Fixed cost per iteration
© 2011 TeamProsource3131

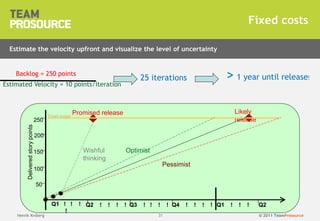

50
100
150
200
250
Pessimist
OptimistWishful
thinking
Q1 ! ! !Q1 ! ! !
!
Q2 ! ! ! ! Q3 ! ! ! ! Q4 ! ! ! ! Q2
Promised release Likely
release
Deliveredstorypoints
Fixed scope
Fixed costs
Henrik Kniberg
Estimate the velocity upfront and visualize the level of uncertainty
Estimated Velocity = 10 points/iteration
Backlog = 250 points
25 iterations > 1 year until release!
© 2011 TeamProsource32
PROJECT GOVERNANCE
HOW TO INITIATE AGILE
PROJECTS ?
© 2011 TeamProsource3333
Agile project initiation (inception)
Title Presentation | Version x.x

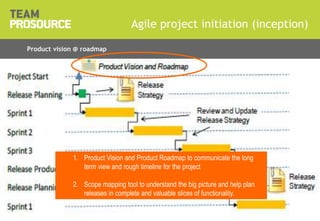

Product vision @ roadmap
1. Product Vision and Product Roadmap to communicate the long
term view and rough timeline for the project
2. Scope mapping tool to understand the big picture and help plan
releases in complete and valuable slices of functionality.
© 2011 TeamProsource3434
Backlog modeling
Story mapping
Title Presentation | Version x.x
A user story map is a useful technique to help understand the product vision and
functionality of the system
© 2011 TeamProsource3535
Backlog modeling
Story mapping
Title Presentation | Version x.x
© 2011 TeamProsource3636

Backlog modeling
Story mapping
Story map integrating the different persona’s participating in the workflow
User stories to be detailed and prioritised during
release and sprint planning
© 2011 TeamProsource3737
Agile project initiation (inception)

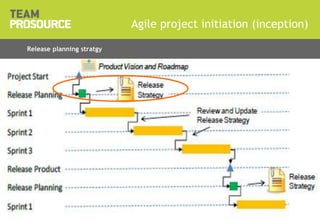

Title Presentation | Version x.x
Release planning stratgy
© 2011 TeamProsource3838

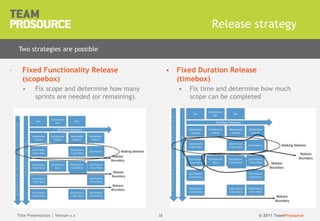

Release strategy
– Fixed Functionality Release
(scopebox)
• Fix scope and determine how many
sprints are needed (or remaining).
• Fixed Duration Release
(timebox)
• Fix time and determine how much
scope can be completed
Title Presentation | Version x.x
Two strategies are possible
© 2011 TeamProsource393939© Jeff Patton, all rights reserved, www.AgileProductDesign.com

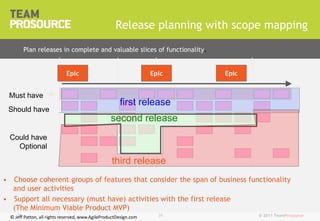

Release planning with scope mapping
• Choose coherent groups of features that consider the span of business functionality
and user activities
• Support all necessary (must have) activities with the first release
(The Minimum Viable Product MVP)
Must have
Should have
first release
second release
third release
Could have
Optional
Epic Epic Epic
Plan releases in complete and valuable slices of functionality.
© 2011 TeamProsource4040

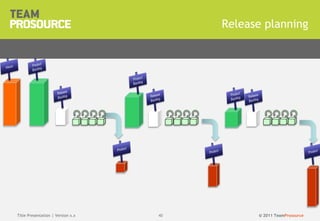

Release planning
Title Presentation | Version x.x
© 2011 TeamProsource4141

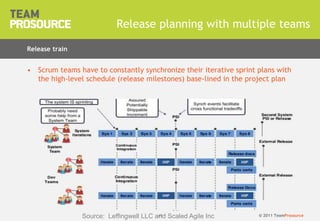

• Scrum teams have to constantly synchronize their iterative sprint plans with
the high-level schedule (release milestones) base-lined in the project plan
Release planning with multiple teams
Release train
Source: Leffingwell LLC and Scaled Agile Inc
© 2011 TeamProsource42
PROJECT GOVERNANCE
HOW TO MONITOR & CONTROL
AGILE PROJECTS ?
© 2011 TeamProsource4343
Relevant metrics for management
Title Presentation | Version x.x
Focus on Business Value
© 2011 TeamProsource4444

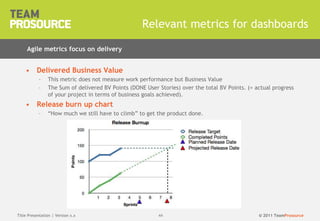

• Delivered Business Value
– This metric does not measure work performance but Business Value
– The Sum of delivered BV Points (DONE User Stories) over the total BV Points. (= actual progress
of your project in terms of business goals achieved).
• Release burn up chart
– “How much we still have to climb” to get the product done.
Relevant metrics for dashboards
Title Presentation | Version x.x
Agile metrics focus on delivery
© 2011 TeamProsource4545

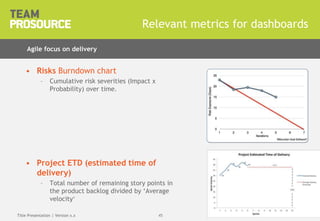

• Risks Burndown chart
– Cumulative risk severities (Impact x
Probability) over time.
• Project ETD (estimated time of
delivery)
– Total number of remaining story points in
the product backlog divided by ‘Average
velocity’
Relevant metrics for dashboards
Title Presentation | Version x.x
Agile focus on delivery
© 2011 TeamProsource4646

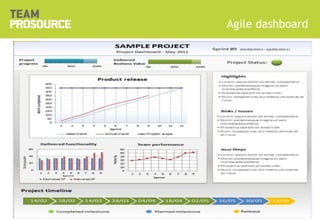

Agile dashboard
© 2011 TeamProsource47
ROLES &
RESPONSIBILITIES
REVISITED
© 2011 TeamProsource4848
Scrum roles
© 2011 TeamProsource4949© 2006-2007 Jeff Patton,

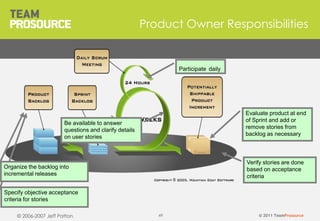

Product Owner Responsibilities
Specify objective acceptance
criteria for stories
Participate daily
Be available to answer
questions and clarify details
on user stories
Verify stories are done
based on acceptance
criteria
Evaluate product at end
of Sprint and add or
remove stories from
backlog as necessary
Organize the backlog into
incremental releases
© 2011 TeamProsource5050
Roles and responsibilities revisited
Title Presentation | Version x.x
What about the traditional roles in agile projects?
© 2011 TeamProsource51

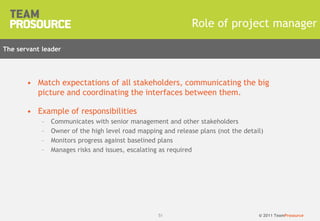

Role of project manager
• Match expectations of all stakeholders, communicating the big
picture and coordinating the interfaces between them.
• Example of responsibilities
– Communicates with senior management and other stakeholders
– Owner of the high level road mapping and release plans (not the detail)
– Monitors progress against baselined plans
– Manages risks and issues, escalating as required
The servant leader
© 2011 TeamProsource5252
Role of business analyst
Title Presentation | Version x.x
© 2011 TeamProsource5353

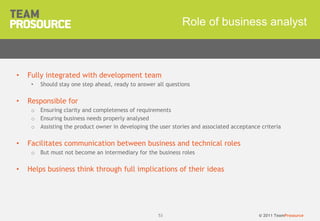

Role of business analyst
• Fully integrated with development team
• Should stay one step ahead, ready to answer all questions
• Responsible for
o Ensuring clarity and completeness of requirements
o Ensuring business needs properly analysed
o Assisting the product owner in developing the user stories and associated acceptance criteria
• Facilitates communication between business and technical roles
o But must not become an intermediary for the business roles
• Helps business think through full implications of their ideas
© 2011 TeamProsource5454
• Technical design authority for the project
– Ensures consistency and coherence across Development Teams
– Ensures adherence to agreed standards
– The “glue” that holds the project together for technology and innovation
• Example of responsibilities
– Agrees and controls technical architecture
• Determines technical environments
• Ensures non-functional requirements are achievable

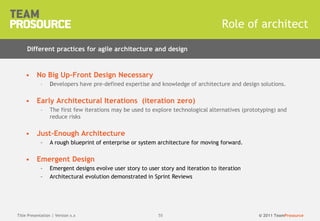

Role of project architect
From Big Design Up Front to Just Enough Design Up Front
© 2011 TeamProsource5555
• No Big Up-Front Design Necessary
– Developers have pre-defined expertise and knowledge of architecture and design solutions.
• Early Architectural Iterations (iteration zero)
– The first few iterations may be used to explore technological alternatives (prototyping) and
reduce risks
• Just-Enough Architecture
– A rough blueprint of enterprise or system architecture for moving forward.
• Emergent Design
– Emergent designs evolve user story to user story and iteration to iteration
– Architectural evolution demonstrated in Sprint Reviews
Role of architect
Title Presentation | Version x.x
Different practices for agile architecture and design
© 2011 TeamProsource56
PMBOK KNOWLEDGE AREA’S
REVISITED
© 2011 TeamProsource5757
Project
Initiation
Product
Increment
Sprint
Planning
Sprint
Sprint
Review
Sprint
Retrospective
Hybrid project management framework
Combining PMBOK and Scrum
© 2011 TeamProsource5858

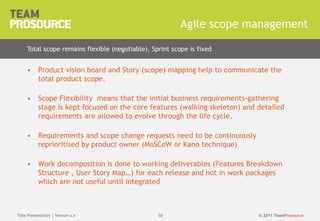

• Product vision board and Story (scope) mapping help to communicate the
total product scope.
• Scope Flexibility means that the initial business requirements-gathering
stage is kept focused on the core features (walking skeleton) and detailed
requirements are allowed to evolve through the life cycle.
• Requirements and scope change requests need to be continuously
reprioritised by product owner (MoSCoW or Kano technique)
• Work decomposition is done to working deliverables (Features Breakdown
Structure , User Story Map…) for each release and not in work packages
which are not useful until integrated
Agile scope management
Title Presentation | Version x.x
Total scope remains flexible (negotiable). Sprint scope is fixed
© 2011 TeamProsource5959

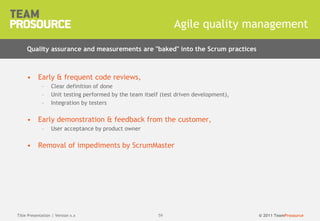

• Early & frequent code reviews,
– Clear definition of done
– Unit testing performed by the team itself (test driven development),
– Integration by testers
• Early demonstration & feedback from the customer,
– User acceptance by product owner
• Removal of impediments by ScrumMaster
Agile quality management
Title Presentation | Version x.x
Quality assurance and measurements are "baked" into the Scrum practices
© 2011 TeamProsource6060
• Release planning
– Release plan details iterations of first release (the first increment) and planned dates for
deployment of later Increments
– High level estimates are based on
• Historical data (comparable team)
• empirical data (team velocity based on try-out sprint)
• Normalised velocity (based on company norm)
– The risks of more iterations to be added later on should be acknowledged
• Iteration planning
– Only the features targeted for the sprints
are elaborated and estimated (just in time planning)
Agile time management
Only a high level release schedule is developed for project control
© 2011 TeamProsource6161
• Initial cost estimates are based on scope mapping and release plan
– Initial estimates based on analogy or expert experience (estimated velocity)
– As the team members go through the “must have” list of features they can estimate the minimal
number of sprints (iterations)
• This initial cost baseline can be revised after a couple of sprints when actual team
velocity is known
• A cost buffer is advisable when there is a risk of more iterations than originally
planned.
Agile cost management
Best and worst case cost as the number of people on the project multiplied by the
number of sprints
50
100
150
200
250
Pessimist
OptimistWishful
thinking
Q1 ! ! !Q1 ! ! !
!
Q2 ! ! ! ! Q3 ! ! ! ! Q4 ! ! ! ! Q2
Promised release Likely
release
Deliveredstorypoints
Fixed scope
© 2011 TeamProsource6262
• Reduce risk through just enough architecture
– Multiple architectural options may emerge, which then need to be reduced to one. By the
end of the elaboration phase the high-risk elements in the project will have been eradicated.
Agile risk management
The entire team is involved during sprint planning, daily scrums and retrospectives
Risk-adjusted backlogs and risk burndowns tools
• A risk-adjusted backlog contains a smart blend of value-
generating features and risk-reduction actions.
© 2011 TeamProsource6363Title Presentation | Version x.x
michel.coens@teamprosource.eu

Agile project management

  • 1.
    Click to editMaster title style Click to edit Master subtitle style www.teamprosource.eu Agile Project Management Best of both worlds ? michel.coens@teamprosource.eu
  • 2.
    © 2011 TeamProsource22 Acompetence improvement platform, including public training, in-company training programmes, and coaching Flexible staffing of highly skilled resources with quality guarantee 360°diagnostic and improvement to accelerate the flow of projects and services Prosource services
  • 3.
    © 2011 TeamProsource3 CLICKTO EDIT MASTER TITLE STYLE Click to edit Master text styles CAN WE COMBINE PLAN-DRIVEN PROJECT MANAGEMENT WITH AGILE EXECUTION ?
  • 4.
    © 2011 TeamProsource44 ThePMBOK/PRINCE2 view on project planning Henrik Kniberg Assumptions: • The customer knows what he wants • The developers know how to build it • Nothing will change along the way SW projects are like a cannon ball shot Realistic?
  • 5.
    © 2011 TeamProsource55 TheAgile view on project planning Henrik Kniberg Assumptions: The customer discovers what he wants The developers discover how to build it Things change along the way Product vision SW projects are like homing missiles Realistic?
  • 6.
    © 2011 TeamProsource66 Contentof presentation • Plan-driven versus agile project management • How to initiate agile projects? • How to monitor & control agile projects? • Roles and responsibilities revisited • PMBOK knowledge area’s revisited Can we combine best of both worlds?
  • 7.
    © 2011 TeamProsource77 Plan-drivenversus agile project management Plan-driven > predictability Agile > flexibility Source: David Rico “plan the work, and work the plan” “empower teams to deliver business value”
  • 8.
    © 2011 TeamProsource8 Agilemanifesto Individuals and interactions over processes and tools Working software over comprehensive documentation Customer collaboration over contract negotiation Responding to change over following a plan 8 What are the agile principles? While there is value in the items on the right, we value the items on the left more.
  • 9.
  • 10.
    © 2011 TeamProsource10 Scrumprocess Title Presentation | Version x.x Timeboxed product delivery
  • 11.
    © 2011 TeamProsource1111 Scrumprocess Title Presentation | Version x.x
  • 12.
    © 2011 TeamProsource1212 Scrumprocess Title Presentation | Version x.x
  • 13.
    © 2011 TeamProsource1313 Scrumprocess Title Presentation | Version x.x
  • 14.
    © 2011 TeamProsource1414 Scrumprocess Title Presentation | Version x.x
  • 15.
    © 2011 TeamProsource1515 Choosingbetween plan-driven and agile Plan-driven Indicators Agile Solution delivery Type of project Experimental discovery Multiple interdependencies & interface complexity Few interdependencies Regulated (pharma) Regulatory context Unregulated Fixed or quite certain Scope Dynamic & Uncertain Passive or unavailable Stakeholders Ongoing involvement All or nothing Value creation incremental ROI Big bang Delivery incremental (small steps) Distributed & fluctuating Team Collocated & stable Command & control or micromanagement Company culture Empowerment & self management Title Presentation | Version x.x Some criteria to select the most effective approach Problem The assessment is seldom clearcut
  • 16.
    © 2011 TeamProsource1616 Agileproject management Title Presentation | Version x.x Combining project governance with agile development (example)
  • 17.
    © 2011 TeamProsource17 CLICKTO EDIT MASTER TITLE STYLE Click to edit Master text styles AGILE VERSUS PLAN-DRIVEN PROJECT MANAGEMENT The paradigm shift
  • 18.
    © 2011 TeamProsource1818 Plan-drivenversus Agile triple constraint Title Presentation | Version x.x
  • 19.
    © 2011 TeamProsource1919 •Agile focuses on delivering value increments Title Presentation | Version x.x Flexible scope
  • 20.
    © 2011 TeamProsource2020 Flexiblescope Agile focuses on delivering value increments 20Standish Group Study Reported at XP2002 by Jim Johnson, Chairman Always 7% Often 13% Sometimes 16% Rarely 19% Never 45% Rarely or Never Used: 64% Often or Always Used: 20% Delivering value is hard…..
  • 21.
    © 2011 TeamProsource2121 Flexiblescope • Agile focuses on delivering value increments • Contingency will be represented by scope rather than resources/time • Scope will not be fixed upfront but contineously re- prioritised Title Presentation | Version x.x
  • 22.
    © 2011 TeamProsource2222 •Cost and benefits are based on best case and worst case scenario • Scope contingency (shouid and could have’s) will cover uncertainty risk Flexible scope Product scope (solution) will not be fixed but prioritised (MoSCoW)
  • 23.
    © 2011 TeamProsource2323 •When a project is behind, stakeholders can cut the lowest priority features to insure that the most important items are delivered within the cost/schedule • At the end the stakeholders can decide if they want to spend extra cost/schedule for the remaining lower value features Flexible scope Title Presentation | Version x.x Scope will not be fixed upfront but continously re-prioritised
  • 24.
    © 2011 TeamProsource2424 •Delivery stages are timeboxed • Each timebox combines incremental with iterative delivery of the product scope Fixed time Title Presentation | Version x.x Focus on meeting deadlines
  • 25.
    © 2011 TeamProsource2525 Incrementaldelivery Early delivery of business benefit where possible (= incremental) Incremental delivery enables early Return on Investment (ROI) • Continually confirm correct solution is being built • Formally re-assess priorities and ongoing project viability with each delivered increment
  • 26.
    © 2011 TeamProsource2626 Iterativedelivery Planned rework strategy allows team to converge to an accurate solution • Iterative delivery builds customer feedback into each iteration • Acknowledge that things may get wrong before getting right • Accept that most details emerge later rather than sooner • Embrace change – the right solution will not evolve without it • Sometimes difficult to determine upfront how many improvement passes will be needed
  • 27.
    © 2011 TeamProsource2727 Agiledelivery Agile combining iterative & incremental Agile teams combine the Iterative and Incremental approaches. • Each iteration will produce a product Increment adding completely new features (= Incremental). • But each Increment is also likely to refine already existing functionality (= iterative)
  • 28.
    © 2011 TeamProsource2828 •As the team members go through the “must have” list of features they can estimate how many sprints (iterations) they will need to complete the project Fixed costs Title Presentation | Version x.x Fixed cost per iteration
  • 29.
    © 2011 TeamProsource2929 •Initial Rough Order of Magnitude estimate (ROM) • At the beginning of the project the accuracy may be +/- 50%. • The risks of more iterations to be added later on should be acknowledged Fixed costs Upfront estimation of agile projects
  • 30.
    © 2011 TeamProsource3030 •As the team members go through the “must have” list of features they can estimate how many sprints (iterations) they will need to complete the project • They can calculate the best and worst case cost as the number of resources multiplied by the number of iterations • A cost buffer is advisable when there is a risk of more iterations than originally planned. Fixed costs Title Presentation | Version x.x Fixed cost per iteration
  • 31.
    © 2011 TeamProsource3131 50 100 150 200 250 Pessimist OptimistWishful thinking Q1! ! !Q1 ! ! ! ! Q2 ! ! ! ! Q3 ! ! ! ! Q4 ! ! ! ! Q2 Promised release Likely release Deliveredstorypoints Fixed scope Fixed costs Henrik Kniberg Estimate the velocity upfront and visualize the level of uncertainty Estimated Velocity = 10 points/iteration Backlog = 250 points 25 iterations > 1 year until release!
  • 32.
    © 2011 TeamProsource32 PROJECTGOVERNANCE HOW TO INITIATE AGILE PROJECTS ?
  • 33.
    © 2011 TeamProsource3333 Agileproject initiation (inception) Title Presentation | Version x.x Product vision @ roadmap 1. Product Vision and Product Roadmap to communicate the long term view and rough timeline for the project 2. Scope mapping tool to understand the big picture and help plan releases in complete and valuable slices of functionality.
  • 34.
    © 2011 TeamProsource3434 Backlogmodeling Story mapping Title Presentation | Version x.x A user story map is a useful technique to help understand the product vision and functionality of the system
  • 35.
    © 2011 TeamProsource3535 Backlogmodeling Story mapping Title Presentation | Version x.x
  • 36.
    © 2011 TeamProsource3636 Backlogmodeling Story mapping Story map integrating the different persona’s participating in the workflow User stories to be detailed and prioritised during release and sprint planning
  • 37.
    © 2011 TeamProsource3737 Agileproject initiation (inception) Title Presentation | Version x.x Release planning stratgy
  • 38.
    © 2011 TeamProsource3838 Releasestrategy – Fixed Functionality Release (scopebox) • Fix scope and determine how many sprints are needed (or remaining). • Fixed Duration Release (timebox) • Fix time and determine how much scope can be completed Title Presentation | Version x.x Two strategies are possible
  • 39.
    © 2011 TeamProsource393939©Jeff Patton, all rights reserved, www.AgileProductDesign.com Release planning with scope mapping • Choose coherent groups of features that consider the span of business functionality and user activities • Support all necessary (must have) activities with the first release (The Minimum Viable Product MVP) Must have Should have first release second release third release Could have Optional Epic Epic Epic Plan releases in complete and valuable slices of functionality.
  • 40.
    © 2011 TeamProsource4040 Releaseplanning Title Presentation | Version x.x
  • 41.
    © 2011 TeamProsource4141 •Scrum teams have to constantly synchronize their iterative sprint plans with the high-level schedule (release milestones) base-lined in the project plan Release planning with multiple teams Release train Source: Leffingwell LLC and Scaled Agile Inc
  • 42.
    © 2011 TeamProsource42 PROJECTGOVERNANCE HOW TO MONITOR & CONTROL AGILE PROJECTS ?
  • 43.
    © 2011 TeamProsource4343 Relevantmetrics for management Title Presentation | Version x.x Focus on Business Value
  • 44.
    © 2011 TeamProsource4444 •Delivered Business Value – This metric does not measure work performance but Business Value – The Sum of delivered BV Points (DONE User Stories) over the total BV Points. (= actual progress of your project in terms of business goals achieved). • Release burn up chart – “How much we still have to climb” to get the product done. Relevant metrics for dashboards Title Presentation | Version x.x Agile metrics focus on delivery
  • 45.
    © 2011 TeamProsource4545 •Risks Burndown chart – Cumulative risk severities (Impact x Probability) over time. • Project ETD (estimated time of delivery) – Total number of remaining story points in the product backlog divided by ‘Average velocity’ Relevant metrics for dashboards Title Presentation | Version x.x Agile focus on delivery
  • 46.
  • 47.
    © 2011 TeamProsource47 ROLES& RESPONSIBILITIES REVISITED
  • 48.
  • 49.
    © 2011 TeamProsource4949©2006-2007 Jeff Patton, Product Owner Responsibilities Specify objective acceptance criteria for stories Participate daily Be available to answer questions and clarify details on user stories Verify stories are done based on acceptance criteria Evaluate product at end of Sprint and add or remove stories from backlog as necessary Organize the backlog into incremental releases
  • 50.
    © 2011 TeamProsource5050 Rolesand responsibilities revisited Title Presentation | Version x.x What about the traditional roles in agile projects?
  • 51.
    © 2011 TeamProsource51 Roleof project manager • Match expectations of all stakeholders, communicating the big picture and coordinating the interfaces between them. • Example of responsibilities – Communicates with senior management and other stakeholders – Owner of the high level road mapping and release plans (not the detail) – Monitors progress against baselined plans – Manages risks and issues, escalating as required The servant leader
  • 52.
    © 2011 TeamProsource5252 Roleof business analyst Title Presentation | Version x.x
  • 53.
    © 2011 TeamProsource5353 Roleof business analyst • Fully integrated with development team • Should stay one step ahead, ready to answer all questions • Responsible for o Ensuring clarity and completeness of requirements o Ensuring business needs properly analysed o Assisting the product owner in developing the user stories and associated acceptance criteria • Facilitates communication between business and technical roles o But must not become an intermediary for the business roles • Helps business think through full implications of their ideas
  • 54.
    © 2011 TeamProsource5454 •Technical design authority for the project – Ensures consistency and coherence across Development Teams – Ensures adherence to agreed standards – The “glue” that holds the project together for technology and innovation • Example of responsibilities – Agrees and controls technical architecture • Determines technical environments • Ensures non-functional requirements are achievable Role of project architect From Big Design Up Front to Just Enough Design Up Front
  • 55.
    © 2011 TeamProsource5555 •No Big Up-Front Design Necessary – Developers have pre-defined expertise and knowledge of architecture and design solutions. • Early Architectural Iterations (iteration zero) – The first few iterations may be used to explore technological alternatives (prototyping) and reduce risks • Just-Enough Architecture – A rough blueprint of enterprise or system architecture for moving forward. • Emergent Design – Emergent designs evolve user story to user story and iteration to iteration – Architectural evolution demonstrated in Sprint Reviews Role of architect Title Presentation | Version x.x Different practices for agile architecture and design
  • 56.
    © 2011 TeamProsource56 PMBOKKNOWLEDGE AREA’S REVISITED
  • 57.
  • 58.
    © 2011 TeamProsource5858 •Product vision board and Story (scope) mapping help to communicate the total product scope. • Scope Flexibility means that the initial business requirements-gathering stage is kept focused on the core features (walking skeleton) and detailed requirements are allowed to evolve through the life cycle. • Requirements and scope change requests need to be continuously reprioritised by product owner (MoSCoW or Kano technique) • Work decomposition is done to working deliverables (Features Breakdown Structure , User Story Map…) for each release and not in work packages which are not useful until integrated Agile scope management Title Presentation | Version x.x Total scope remains flexible (negotiable). Sprint scope is fixed
  • 59.
    © 2011 TeamProsource5959 •Early & frequent code reviews, – Clear definition of done – Unit testing performed by the team itself (test driven development), – Integration by testers • Early demonstration & feedback from the customer, – User acceptance by product owner • Removal of impediments by ScrumMaster Agile quality management Title Presentation | Version x.x Quality assurance and measurements are "baked" into the Scrum practices
  • 60.
    © 2011 TeamProsource6060 •Release planning – Release plan details iterations of first release (the first increment) and planned dates for deployment of later Increments – High level estimates are based on • Historical data (comparable team) • empirical data (team velocity based on try-out sprint) • Normalised velocity (based on company norm) – The risks of more iterations to be added later on should be acknowledged • Iteration planning – Only the features targeted for the sprints are elaborated and estimated (just in time planning) Agile time management Only a high level release schedule is developed for project control
  • 61.
    © 2011 TeamProsource6161 •Initial cost estimates are based on scope mapping and release plan – Initial estimates based on analogy or expert experience (estimated velocity) – As the team members go through the “must have” list of features they can estimate the minimal number of sprints (iterations) • This initial cost baseline can be revised after a couple of sprints when actual team velocity is known • A cost buffer is advisable when there is a risk of more iterations than originally planned. Agile cost management Best and worst case cost as the number of people on the project multiplied by the number of sprints 50 100 150 200 250 Pessimist OptimistWishful thinking Q1 ! ! !Q1 ! ! ! ! Q2 ! ! ! ! Q3 ! ! ! ! Q4 ! ! ! ! Q2 Promised release Likely release Deliveredstorypoints Fixed scope
  • 62.
    © 2011 TeamProsource6262 •Reduce risk through just enough architecture – Multiple architectural options may emerge, which then need to be reduced to one. By the end of the elaboration phase the high-risk elements in the project will have been eradicated. Agile risk management The entire team is involved during sprint planning, daily scrums and retrospectives Risk-adjusted backlogs and risk burndowns tools • A risk-adjusted backlog contains a smart blend of value- generating features and risk-reduction actions.
  • 63.
    © 2011 TeamProsource6363TitlePresentation | Version x.x michel.coens@teamprosource.eu
