UNIVERSITY OF CALIFORNIA,
HASTINGS COLLEGE OF THE LAW
200 McALLISTER: KANE HALL PROGRAMMING + PLANNING UPDATE
06.16.14
proprietary and confidential
UC Hastings College of the Law Kane Hall Programming and Planning

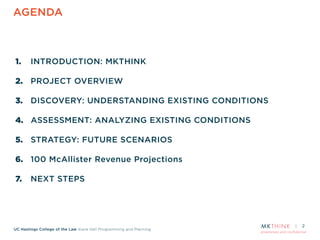

AGENDA
2
1. INTRODUCTION: MKTHINK
2. PROJECT OVERVIEW
3. DISCOVERY: UNDERSTANDING EXISTING CONDITIONS
4. ASSESSMENT: ANALYZING EXISTING CONDITIONS
5. STRATEGY: FUTURE SCENARIOS
6. 100 McAllister Revenue Projections
7. NEXT STEPS
INTRODUCTION:
MKTHINK
1.
proprietary and confidential
UC Hastings College of the Law Kane Hall Programming and Planning

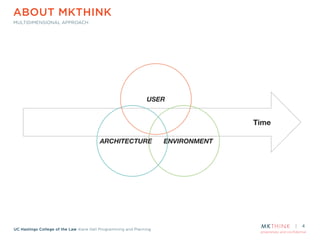

ABOUT MKTHINK
MULTIDIMENSIONAL APPROACH
4
USER
ARCHITECTURE ENVIRONMENT
Time
proprietary and confidential
UC Hastings College of the Law Kane Hall Programming and Planning
ABOUT MKTHINK
PROJECT EXPERIENCE
5
LAW SCHOOL CLIENTS
OTHER HIGHER-ED CLIENTS
California College of the Arts
Menlo College
New College of California
San Francisco Art Institute
Santa Clara University
Stanford Graduate School of Business
Stanford School of Education
Stanford School of Engineering (d.School)
Stanford University
University California Berkeley
University of San Francisco
proprietary and confidential
UC Hastings College of the Law Kane Hall Programming and Planning
LAW SCHOOL EXPERIENCE
STANFORD LAW SCHOOL COMPLETED PROJECTS
6
COMPLETED PROJECTS
Law Clinics
Law Library
Lecture Halls
Moot Court
Office Environments
Interiors
Campus Master Plan
!
proprietary and confidential
UC Hastings College of the Law Kane Hall Programming and Planning
LAW SCHOOL EXPERIENCE

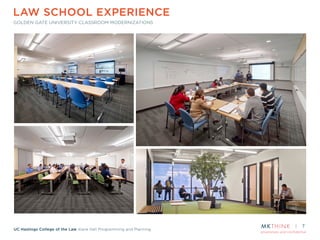

GOLDEN GATE UNIVERSITY CLASSROOM MODERNIZATIONS
7
proprietary and confidential
UC Hastings College of the Law Kane Hall Programming and Planning

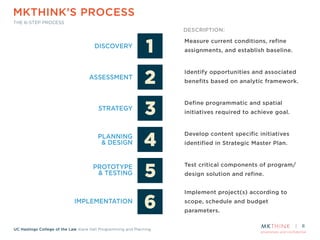

MKTHINK’S PROCESS
THE 6-STEP PROCESS
8
Measure current conditions, refine
assignments, and establish baseline.
Identify opportunities and associated
benefits based on analytic framework.
Define programmatic and spatial
initiatives required to achieve goal.
Develop content specific initiatives
identified in Strategic Master Plan.
Test critical components of program/
design solution and refine.
Implement project(s) according to
scope, schedule and budget
parameters.
DISCOVERY
ASSESSMENT
STRATEGY
PLANNING
& DESIGN
PROTOTYPE
& TESTING
IMPLEMENTATION
DESCRIPTION:
proprietary and confidential
UC Hastings College of the Law Kane Hall Programming and Planning

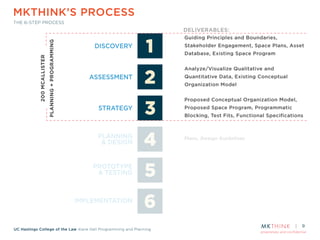

MKTHINK’S PROCESS
THE 6-STEP PROCESS
9
Guiding Principles and Boundaries,
Stakeholder Engagement, Space Plans, Asset
Database, Existing Space Program
Analyze/Visualize Qualitative and
Quantitative Data, Existing Conceptual
Organization Model
Proposed Conceptual Organization Model,
Proposed Space Program, Programmatic
Blocking, Test Fits, Functional Specifications
DELIVERABLES:
DISCOVERY
ASSESSMENT
STRATEGY
PLANNING
& DESIGN
PROTOTYPE
& TESTING
IMPLEMENTATION
Plans, Design Guidelines
200MCALLISTER
PLANNING+PROGRAMMING
PROJECT
OVERVIEW
2.
proprietary and confidential
UC Hastings College of the Law Kane Hall Programming and Planning
PROJECT GOALS
STRENGTHENING THE HEART OF CAMPUS
11
CLASSROOMS
STUDENT LIFE
LIBRARY
FACULTY
THE BEACH
DINING
ALUMNI SERVICES
CLASSROOMS
STUDENT LIFE
LIBRARY
FACULTY
THE BEACH
DINING
ALUMNI SERVICES
CLINICS
CENTERS
JOURNALS
FACULTY
CLINICS
CENTERS
JOURNALS
FACULTY
proprietary and confidential

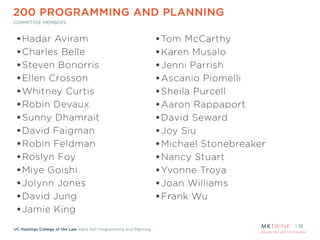

UC Hastings College of the Law Kane Hall Programming and Planning
200 PROGRAMMING AND PLANNING
COMMITTEE MEMBERS

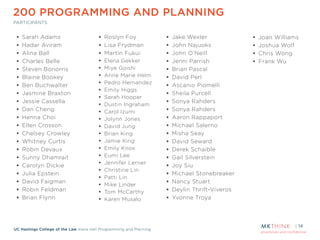

12
•Hadar Aviram
•Charles Belle
•Steven Bonorris
•Ellen Crosson
•Whitney Curtis
•Robin Devaux
•Sunny Dhamrait
•David Faigman
•Robin Feldman
•Roslyn Foy
•Miye Goishi
•Jolynn Jones
•David Jung
•Jamie King
•Tom McCarthy
•Karen Musalo
•Jenni Parrish
•Ascanio Piomelli
•Sheila Purcell
•Aaron Rappaport
•David Seward
•Joy Siu
•Michael Stonebreaker
•Nancy Stuart
•Yvonne Troya
•Joan Williams
•Frank Wu
proprietary and confidential
UC Hastings College of the Law Kane Hall Programming and Planning

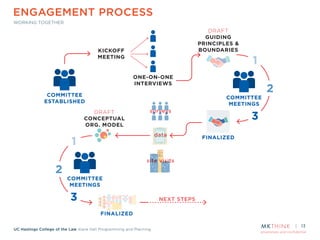

ENGAGEMENT PROCESS
WORKING TOGETHER
13
KICKOFF
MEETING
ONE-ON-ONE
INTERVIEWS
DRAFT
GUIDING
PRINCIPLES &
BOUNDARIES
DRAFT
CONCEPTUAL
ORG. MODEL
FINALIZEDFINALIZED
NEXT STEPS
FINALIZEDFINALIZED
COMMITTEE
ESTABLISHED
COMMITTEE
ESTABLISHED
COMMITTEE
MEETINGS
COMMITTEE
MEETINGS
1
2
3
COMMITTEE
MEETINGS
COMMITTEE
MEETINGS
1
2
3
surveys
data
site visits
proprietary and confidential
UC Hastings College of the Law Kane Hall Programming and Planning
200 PROGRAMMING AND PLANNING
PARTICIPANTS
14
• Sarah Adams
• Hadar Aviram
• Alina Ball
• Charles Belle
• Steven Bonorris
• Blaine Bookey
• Ben Buchwalter
• Jasmine Braxton
• Jessie Cassella
• Dan Cheng
• Henna Choi
• Ellen Crosson
• Chelsey Crowley
• Whitney Curtis
• Robin Devaux
• Sunny Dhamrait
• Carolyn Dickie
• Julia Epstein
• David Faigman
• Robin Feldman
• Brian Flynn
• Jake Wexler
• John Najuoks
• John O’Neill
• Jenni Parrish
• Brian Pascal
• David Perl
• Ascanio Piomelli
• Sheila Purcell
• Sonya Rahders
• Sonya Rahders
• Aaron Rappaport
• Michael Salerno
• Misha Seay
• David Seward
• Derek Schaible
• Gail Silverstein
• Joy Siu
• Michael Stonebreaker
• Nancy Stuart
• Deylin Thrift-Viveros
• Yvonne Troya
• Roslyn Foy
• Lisa Frydman
• Martin Fukui
• Elena Gekker
• Miye Goishi
• Anne Marie Helm
• Pedro Hernandez
• Emily Higgs
• Sarah Hooper
• Dustin Ingraham
• Carol Izumi
• Jolynn Jones
• David Jung
• Brian King
• Jamie King
• Emily Knox
• Eumi Lee
• Jennifer Lerner
• Christine Lin
• Patti Lin
• Mike Linder
• Tom McCarthy
• Karen Musalo
• Joan Williams
• Joshua Wolf
• Chris Wong
• Frank Wu
proprietary and confidential
UC Hastings College of the Law Kane Hall Programming and Planning
TAKING INVENTORY
CENTERS, CLINICS, AND JOURNALS
15
proprietary and confidential
UC Hastings College of the Law Kane Hall Programming and Planning

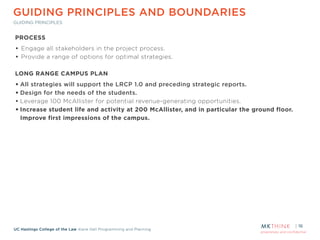

GUIDING PRINCIPLES AND BOUNDARIES
GUIDING PRINCIPLES
16
PROCESS
• Engage all stakeholders in the project process.
• Provide a range of options for optimal strategies.
!
LONG RANGE CAMPUS PLAN
• All strategies will support the LRCP 1.0 and preceding strategic reports.
• Design for the needs of the students.
• Leverage 100 McAllister for potential revenue-generating opportunities.
• Increase student life and activity at 200 McAllister, and in particular the ground floor.
Improve first impressions of the campus.
proprietary and confidential
UC Hastings College of the Law Kane Hall Programming and Planning
GUIDING PRINCIPLES AND BOUNDARIES
GUIDING PRINCIPLES
17
CLINICS, CENTERS, AND JOURNALS PROGRAMS
• Design to serve the mission(s), teachings, services, and scholarship of each clinic, center,
and journal.
• Serve the needs of both the individuals and the group for all programs.
• Integrate programs into the intellectual life of the students and the College.
• Provide opportunities for students and practitioners to work together and collaborate.
• Maintain and strengthen the unique identity and brand of each program.
• Maintain and improve the operations and physical relationships for each clinic, center,
and journal, as well as the inter-relationships between programs.
• Design with flexibility in mind – grants and funding swings often cause staff fluctuation.
• Design with clients in mind, which considers confidentiality and accessibility.
• Remain cutting-edge and innovative with regard to tools and technology in order to
remain competitive.
• Design with the consideration of economies of scale by maximizing staffing spaces and
developing common area spaces for similar or overlapping programs.
• Improve wayfinding and path of travel to the clinics, centers, and journals. Make them easily
accessible to the broader community.
• Ensure the security of students, faculty, staff, and the clinics, centers, and journals.
• Employ sustainable design by considering the use of natural light, material choices, and
furniture selection.
• Preserve the window line for shared and multi-functional space.
proprietary and confidential
UC Hastings College of the Law Kane Hall Programming and Planning
GUIDING PRINCIPLES AND BOUNDARIES

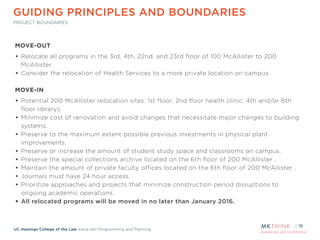

PROJECT BOUNDARIES
18
MOVE-OUT
• Relocate all programs in the 3rd, 4th, 22nd, and 23rd floor of 100 McAllister to 200
McAllister.
• Consider the relocation of Health Services to a more private location on campus.

MOVE-IN
• Potential 200 McAllister relocation sites: 1st floor; 2nd floor health clinic; 4th and/or 6th
floor library).
• Minimize cost of renovation and avoid changes that necessitate major changes to building
systems.
• Preserve to the maximum extent possible previous investments in physical plant
improvements.
• Preserve or increase the amount of student study space and classrooms on campus.
• Preserve the special collections archive located on the 6th floor of 200 McAllister .
• Maintain the amount of private faculty offices located on the 6th floor of 200 McAllister .
• Journals must have 24 hour access.
• Prioritize approaches and projects that minimize construction period disruptions to
ongoing academic operations.
• All relocated programs will be moved in no later than January 2016.
proprietary and confidential
UC Hastings College of the Law Kane Hall Programming and Planning
2014
Jan. Feb. Mar. Apr. May June July Aug. Sept. Oct. No
SPACE PROGRAM
FINALIZED
KICK-OFF DES
FINAL
PROGRAM DEVELOPMENT DESIGN DEVELOPMENT
FINAL PROGRAM
SCENARIO
SELECTED
GP & B
Database Development
Benchmarking
Interviews + Analysis (Large group, small, & individual interviews/meetings)
Analyze Existing Conditions
Develop + Refine Space Program
Develop + Refine Program Scenarios
Design Development
Finalize Program
TIMELINE

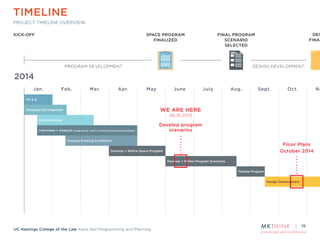

PROJECT TIMELINE OVERVIEW
19
WE ARE HERE
06.16.2014
Develop program
scenarios
Floor Plans
October 2014

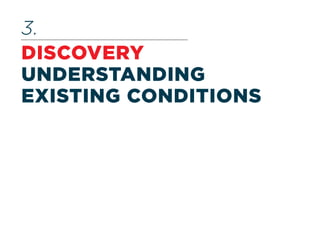

DISCOVERY
UNDERSTANDING
EXISTING CONDITIONS
3.
proprietary and confidential
UC Hastings College of the Law Kane Hall Programming and Planning

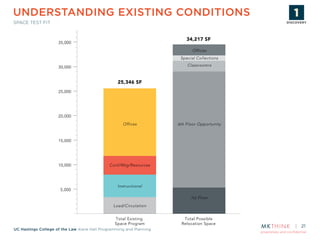

UNDERSTANDING EXISTING CONDITIONS
SPACE TEST FIT
21
5,000
10,000
15,000
20,000
25,000
30,000
35,000
Total Existing
Space Program
Total Possible
Relocation Space
34,217 SF
25,346 SF
100 McAllister
198 McAllister
200 McAllister
1st Floor
6th Floor Opportunity
Classroomrs
Special Collections
Offices
Offices
Conf/Mtg/Resources
Instructional
Load/Circulation
DISCOVERY
ASSESSMENT
STRATEGY
PLANNING
& DESIGN
PROTOTYPE
& TESTING
IMPLEMENTATION
DISCOVERY
proprietary and confidential
UC Hastings College of the Law Kane Hall Programming and Planning
100 MCALLISTER 3RD FLOOR

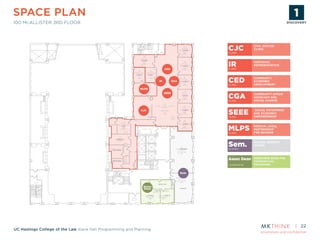

22
100 MCALLISTER 3RD
FLOOR
CIVIL JUSTICE
CLINICCJCCLINIC
INDIVIDUAL
REPRESENTATIONIRCLINIC
COMMUNITY
ECONOMIC
DEVELOPMENT
CEDCLINIC
COMMUNITY GROUP
ADVOCACY AND
SOCIAL CHANGE
CGACLINIC
MEDICAL LEGAL
PARTNERSHIP
FOR SENIORS
MLPSCLINIC
SHARED SEMINAR
ROOMSSem.SHARED
ASSOCIATE DEAN FOR
EXPERIENTIAL
PROGRAMS
Assoc Dean
LEADERSHIP
MLPS
CED
SEEE
CJC
CGAIR
Assoc
Dean
Sem.
SOCIAL ENTERPRISE
AND ECONOMIC
EMPOWERMENT
SEEECLINIC
SEMINAR
SEMINAR
OFFICE
OFFICE OFFICE
RECEPTION
OFFICE
OFFICE
OFFICE
OFFICE
OFFICE
OFFICE
OFFICE
CONF.
CONF.
BREAK
BATHROOM
BATHROOM

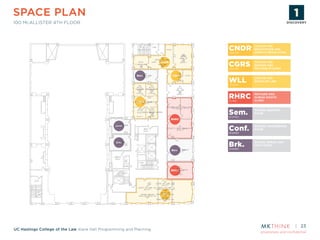

SPACE PLAN DISCOVERY
ASSESSMENT
STRATEGY
PLANNING
& DESIGN
PROTOTYPE
& TESTING
IMPLEMENTATION
DISCOVERY
proprietary and confidential
UC Hastings College of the Law Kane Hall Programming and Planning
SPACE PLAN
100 MCALLISTER 4TH FLOOR
23
100 MCALLISTER 4TH
FLOOR
OFFICE
SEMINAR
OFFICE
OFFICE OFFICE
LOBBY
OFFICE
OFFICE
OFFICE
OFFICEOFFICE
OFFICE
OFFICE
LOBBY
OFFICE
CENTER FOR
NEGOTIATION AND
DISPUTE RESOLUTION
CNDRCENTER
CENTER FOR
GENDER AND
REFUGEE STUDIES
CGRSCENTER
CENTER FOR
WORKLIFE LAWWLLCENTER
REFUGEE AND
HUMAN RIGHTS
CLINIC
RHRCCLINIC
SHARED SEMINAR
ROOMSem.SHARED
CNDR
CGRS
CGRS
WLL
RHRC
RHRC
Sem.
Sem.
Brk.
Conf. SHARED CONFERENCE
ROOMConf.SHAREDSHARED
SHARED BREAK AND
COPY ROOMBrk.SHAREDSHARED
DISCOVERY
ASSESSMENT
STRATEGY
PLANNING
& DESIGN
PROTOTYPE
& TESTING
IMPLEMENTATION
DISCOVERY
proprietary and confidential
UC Hastings College of the Law Kane Hall Programming and Planning
SPACE PLAN
100 MCALLISTER 22ND FLOOR
24
100 MCALLISTER 22ND
FLOOR
HASTINGS
WOMEN’S LAW
JOURNAL
HWLJJOURNAL
HASTINGS
RACE & POVERTY
LAW JOURNAL
HRPLJ
JOURNAL
COMMUNICATIONS
AND ENTERTAINMENT
LAW JOURNAL
COMM/ENT
JOURNAL
NORTH-NORTHWEST
JOURNAL OF
ENVIRONMENTAL LAW
WNWJOURNAL
HWLJ
HRPLJ
COMM
/ENT
WNW
Copy
OSP
OFFICE OF
SCHOLARLY
PUBLICATIONS
OSPJOURNAL
SHARED
COPY ROOMCopySHARED
DISCOVERY
ASSESSMENT
STRATEGY
PLANNING
& DESIGN
PROTOTYPE
& TESTING
IMPLEMENTATION
DISCOVERY
proprietary and confidential
UC Hastings College of the Law Kane Hall Programming and Planning

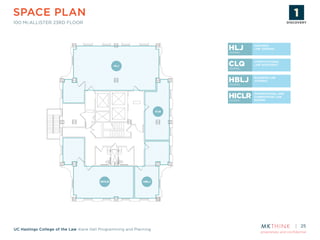

SPACE PLAN
100 MCALLISTER 23RD FLOOR
25
100 MCALLISTER 23RD
FLOOR
HASTINGS
LAW JOURNALHLJJOURNAL
CONSTITUTIONAL
LAW QUARTERLYCLQJOURNAL
BUSINESS LAW
JOURNALHBLJJOURNAL
INTERNATIONAL AND
COMPARATIVE LAW
REVIEW
HICLRJOURNAL
HLJ
CLQ
HBLJHICLR
DISCOVERY
ASSESSMENT
STRATEGY
PLANNING
& DESIGN
PROTOTYPE
& TESTING
IMPLEMENTATION
DISCOVERY
proprietary and confidential
UC Hastings College of the Law Kane Hall Programming and Planning
SPACE PLAN
198 MCALLISTER 2ND FLOOR
26
98 MCALLISTER 2ND
FLOOR
OFFICE
OFFICE
OFFICE
OFFICE
SEMINAR
SEMINAR
CENTER FOR STATE
AND LOCAL
GOVERNMENT LAW
CSLGL
CENTER
SHARED SEMINAR
ROOMSem.SHARED
CSLGL
CSLGL
CSLGL
Sem.
Sem.
198 MCALLISTER 2ND
FLOOR
OFFICE
OFFICE
OFFICE
OFFICE
SEMINAR
SEMINAR
CENTER FOR STATE
AND LOCAL
GOVERNMENT LAW
CSLGL
CENTER
SHARED SEMINAR
ROOMSem.SHARED
CSLGL
CSLGL
CSLGL
Sem.
Sem.
DISCOVERY
ASSESSMENT
STRATEGY
PLANNING
& DESIGN
PROTOTYPE
& TESTING
IMPLEMENTATION
DISCOVERY
proprietary and confidential
UC Hastings College of the Law Kane Hall Programming and Planning
SPACE PLAN

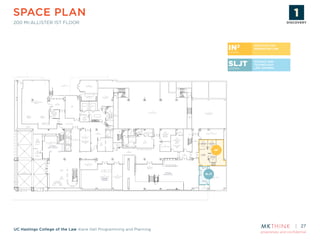

200 MCALLISTER 1ST FLOOR
27
00 MCALLISTER 1ST
FLOOR
INSTITUTE FOR
INNOVATION LAWIN2
CENTER
SCIENCE AND
TECHNOLOGY
LAW JOURNAL
SLJTJOURNAL
SLJT
i-i
OFFICE
OFFICE
OFFICE
FORMER
BOOKSTORE
BUSINESS
CENTER
CONF.
LOBBY
STUDENT
INFO CENTER
INSTITUTE FOR
INNOVATION LAWIN2
CENTER
SCIENCE AND
TECHNOLOGY
LAW JOURNAL
SLJTJOURNAL
SLJT
IN2
OFFICE
OFFICE
OFFICE
FORMER
BOOKSTORE
BUSINESS
CENTER
CONF.
LOBBY
STUDENT
INFO CENTER
DISCOVERY
ASSESSMENT
STRATEGY
PLANNING
& DESIGN
PROTOTYPE
& TESTING
IMPLEMENTATION
DISCOVERY
proprietary and confidential
UC Hastings College of the Law Kane Hall Programming and Planning
SPACE PLAN
200 MCALLISTER 3RD FLOOR
28
00 MCALLISTER 3RD
FLOOR
CONS.
CONS.
CONS.
i-i
UCSF/UC HASTINGS
CONSORTIUMCONS.CENTER
INSTITUTE FOR
INNOVATION LAWIN2
CENTER
OFFICE
OFFICE
OFFICE
OFFICE
OFFICE
OFFICE
CONS.
CONS.
CONS.
IN2
UCSF/UC HASTINGS
CONSORTIUMCONS.CENTER
INSTITUTE FOR
INNOVATION LAWIN2
CENTER
OFFICE
OFFICE
OFFICE
OFFICE
OFFICE
OFFICE
DISCOVERY
ASSESSMENT
STRATEGY
PLANNING
& DESIGN
PROTOTYPE
& TESTING
IMPLEMENTATION
DISCOVERY
proprietary and confidential
UC Hastings College of the Law Kane Hall Programming and Planning
OPPORTUNITY AREAS
COSTING-OUT ALTERNATIVES
29
PROGRAMS TO BE RELOCATED
DINING COMMONS
CAFETERIA
ALUMNI RECEPTION CENTER
CAREER SERVICES
STUDENT SERVICES
ALUMNI SERVICES
FINANCIAL AID
RECORDS OFFICE
HEALTH CENTER
200 MCALLISTER - 2ND FLOOR
2ND FLOOR (MINUS CORE) = 26,717 SF
MOVE CLINICS, CENTERS, AND JOURNALS = $129,000
RENOVATE FUTURE SPACE FOR
EXISTING 2nd FLOOR DEPARTMENTS = $150 / SF
ESTIMATED COST = $9.5 MM
MOVE 2nd FLOOR DEPARTMENTS = $43,000
RENOVATE 1st AND 2nd FLOORS FOR
CLINICS, CENTER, AND JOURNALS = $200 / SF
200 MCALLISTER - 6TH FLOOR
6TH FLOOR (MINUS CORE) = 28,892 SF
RENOVATION COST ESTIMATE = $105/ SF
ESTIMATED COST = $3 MM
PROGRAMS TO BE RELOCATED
LIBRARY BOOKS / STACKS
DISCOVERY
ASSESSMENT
STRATEGY
PLANNING
& DESIGN
PROTOTYPE
& TESTING
IMPLEMENTATION
DISCOVERY
proprietary and confidential
UC Hastings College of the Law Kane Hall Programming and Planning
30

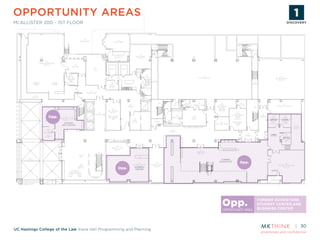

OPPORTUNITY AREAS
MCALLISTER 200 – 1ST FLOOR
Opp.
Opp.
Opp.
OFFICE
OFFICE
OFFICE
FORMER
BOOKSTORE
BUSINESS
CENTER
CONF.
LOBBY
STUDENT
INFO CENTER
SCIENCE AND
TECHNOLOGY
LAW JOURNAL
SLJTJOURNAL
FORMER BOOKSTORE,
STUDENT CENTER,AND
BUSINESS CENTER
Opp.
OPPORTUNITY AREA
DISCOVERY
ASSESSMENT
STRATEGY
PLANNING
& DESIGN
PROTOTYPE
& TESTING
IMPLEMENTATION
DISCOVERY
proprietary and confidential
UC Hastings College of the Law Kane Hall Programming and Planning
31
OPPORTUNITY AREAS
200 MCALLISTER– 6TH FLOOR
Opp.
6TH
FLOOR
OF LIBRARYOpp.
OPPORTUNITY AREA
DISCOVERY
ASSESSMENT
STRATEGY
PLANNING
& DESIGN
PROTOTYPE
& TESTING
IMPLEMENTATION
DISCOVERY
proprietary and confidential
UC Hastings College of the Law Kane Hall Programming and Planning
EXISTING CONDITIONS
SPACE PROGRAM
32
UC HASTINGS - 200 MCALLISTER PROGRAMMING & PLANNING
CLINICS, CENTERS, JOURNALS - ASSIGNABLE SPACE PROGRAM
EXISTING OFFICE INTERACTIVE INSTRUCTION
100*MCALLISTER*3*3RD*FLOOR
CIVIL JUSTICE CLINIC
Building Floor Room Room Type O/C WrkStn SF Organization
100 McAllister 3 300 STAFF OFFICE OPEN 1 100 CIVIL JUSTICE
100 McAllister 3 303 STAFF OFFICE CLOSED 1 140 CIVIL JUSTICE
100 McAllister 3 304 STAFF OFFICE CLOSED 1 140 CIVIL JUSTICE
100 McAllister 3 307 STAFF OFFICE CLOSED 1 130 COMMUNITY E
100 McAllister 3 306 STAFF OFFICE CLOSED 1 175 INDIVIDUAL RE
100 McAllister 3 308 STAFF OFFICE CLOSED 1 190 INDIVIDUAL RE
100 McAllister 3 302 STAFF OFFICE CLOSED 1 130 MEDIATION CLI
100 McAllister 4 407 STAFF OFFICE CLOSED 1 230 MEDIATION CLI
100 McAllister 3 310 STAFF OFFICE CLOSED 1 115 MEDICAL LEGA
100 McAllister 3 305 STAFF OFFICE CLOSED 1 140 SOCIAL ENTER
100 McAllister 3 300B STUDENT OFFICE OPEN 12 736 CIVIL JUSTICE
100 McAllister 3 300D STUDENT OFFICE OPEN 6 184 MEDICAL LEGA
Building Floor Room Room Type Open/Closed Capacity SF User
100 McAllister 3 300A RECEPTION OPEN 1 387 CIVIL JUSTICE
100 McAllister 3 311 CONFERENCE CLOSED 8 150 CIVIL JUSTICE
100 McAllister 3 309 CONFERENCE NA 6 115 CIVIL JUSTICE
100 McAllister 3 312 BREAK NA 150 CIVIL JUSTICE
100 McAllister 3 300C COPY/RESOURCE OPEN 281 CIVIL JUSTICE
100 McAllister 3 372 STORAGE NA 60 CIVIL JUSTICE
Building Floor Room Room Type Open/Closed Capacity SF User
100 McAllister 3 301 SEMINAR NA 24 700 CIVIL JUSTICE
100 McAllister 3 325 SEMINAR Na 16 400 CIVIL JUSTICE
TOTAL 28 4,653
EXPERIENTIAL PROGRAMS
Building Floor Room Room Type O/C WrkStn SF Position
100 McAllister 3 350A STAFF OFFICE CLOSED 1 189
100 McAllister 3 350B STAFF OFFICE CLOSED 1 230 ASSOCIATE DE
100 McAllister 3 350C STAFF OFFICE CLOSED 1 132
TOTAL 3 551
100*MCALLISTER*3*4TH*FLOOR
6/4/14
UC HASTINGS - 200 MCALLISTER PROGRAMMING & PLANNING
CLINICS, CENTERS, JOURNALS - ASSIGNABLE SPACE PROGRAM
EXISTING OFFICE INTERACTIVE INSTRUCTION
DRAFT*5/14/14
100*MCALLISTER*3*3RD*FLOOR
CIVIL JUSTICE CLINIC
Building Floor Room Room Type O/C WrkStn SF Organization Position
100 McAllister 3 300 STAFF OFFICE OPEN 1 100 CIVIL JUSTICE CLINIC (shared) RECEPTIONIST
100 McAllister 3 303 STAFF OFFICE CLOSED 1 140 CIVIL JUSTICE CLINIC (shared) OFFICE MANAGER
100 McAllister 3 304 STAFF OFFICE CLOSED 1 140 CIVIL JUSTICE CLINIC (shared) LAWYERING FELLOW
100 McAllister 3 307 STAFF OFFICE CLOSED 1 130 COMMUNITY ECONOMIC DEVELOPMENT; COMMUNITY GROUP ADVOCACY DIRECTOR
100 McAllister 3 306 STAFF OFFICE CLOSED 1 175 INDIVIDUAL REPRESENTATION CLINICAL PROFESSOR
100 McAllister 3 308 STAFF OFFICE CLOSED 1 190 INDIVIDUAL REPRESENTATION DIRECTOR
100 McAllister 3 302 STAFF OFFICE CLOSED 1 130 MEDIATION CLINIC CLINICAL PROFESSOR
100 McAllister 4 407 STAFF OFFICE CLOSED 1 230 MEDIATION CLINIC CLINICAL PROFESSOR
100 McAllister 3 310 STAFF OFFICE CLOSED 1 115 MEDICAL LEGAL PARTNERSHIP FOR SENIORS DIRECTOR
100 McAllister 3 305 STAFF OFFICE CLOSED 1 140 SOCIAL ENTERPRISE AND ECONOMIC EMPOWERMENT CLINICAL PROFESSOR
100 McAllister 3 300B STUDENT OFFICE OPEN 12 736 CIVIL JUSTICE CLINIC (shared)
100 McAllister 3 300D STUDENT OFFICE OPEN 6 184 MEDICAL LEGAL PARTNERSHIP FOR SENIORS
Building Floor Room Room Type Open/Closed Capacity SF User
100 McAllister 3 300A RECEPTION OPEN 1 387 CIVIL JUSTICE CLINIC (shared)
100 McAllister 3 311 CONFERENCE CLOSED 8 150 CIVIL JUSTICE CLINIC (shared)
100 McAllister 3 309 CONFERENCE NA 6 115 CIVIL JUSTICE CLINIC (shared)
100 McAllister 3 312 BREAK NA 150 CIVIL JUSTICE CLINIC (shared)
100 McAllister 3 300C COPY/RESOURCE OPEN 281 CIVIL JUSTICE CLINIC (shared)
100 McAllister 3 372 STORAGE NA 60 CIVIL JUSTICE CLINIC (shared)
Building Floor Room Room Type Open/Closed Capacity SF User
100 McAllister 3 301 SEMINAR NA 24 700 CIVIL JUSTICE CLINIC (shared)
100 McAllister 3 325 SEMINAR Na 16 400 CIVIL JUSTICE CLINIC (shared)
TOTAL 28 4,653
EXPERIENTIAL PROGRAMS
Building Floor Room Room Type O/C WrkStn SF Position
100 McAllister 3 350A STAFF OFFICE CLOSED 1 189
100 McAllister 3 350B STAFF OFFICE CLOSED 1 230 ASSOCIATE DEAN FOR EXPERIENTIAL PROGRAMS
100 McAllister 3 350C STAFF OFFICE CLOSED 1 132
TOTAL 3 551
100*MCALLISTER*3*4TH*FLOOR
CENTER FOR GENDER & REFUGEE STUDIES
Building Floor Room Room Type O/C WrkStn SF Position
100 McAllister 4 403 STAFF OFFICE CLOSED 1 330 DIRECTOR
100 McAllister 4 409A STAFF OFFICE CLOSED 1 150 ASSOCIATE DIRECTOR / STAFF ATTORNEY
100 McAllister 4 409B STAFF OFFICE CLOSED 1 92 STAFF ATTORNEY
100 McAllister 4 411 STAFF OFFICE CLOSED 2 350
100 McAllister 4 411A STAFF OFFICE CLOSED 1 110
100 McAllister 4 411B STAFF OFFICE CLOSED 1 110
100 McAllister 4 411C STAFF OFFICE CLOSED 1 100
100 McAllister 4 411D STAFF OFFICE CLOSED 2 100
TOTAL 10 1,342
REFUGEE & HUMAN RIGHTS CLINIC
Building Floor Room Room Type O/C WrkStn SF Position
100 McAllister 4 405 STAFF OFFICE CLOSED 4 350
100 McAllister 4 406A STAFF OFFICE CLOSED 2 360
100 McAllister 4 406B STAFF OFFICE CLOSED 1 171
TOTAL 7 881
CENTER FOR NEGOTIATION & DISPUTE RESOLUTION
Building Floor Room Room Type O/C WrkStn SF Position
100 McAllister 4 408A STAFF OFFICE CLOSED 1 300 DIRECTOR
100 McAllister 4 408C STAFF OFFICE OPEN 1 292 ACADEMIC PROGRAM COORDINATOR
100 McAllister 4 408D STAFF OFFICE CLOSED 1 156 VACANT
TOTAL 3 748
CENTER FOR WORKLIFE LAW
Building Floor Room Room Type O/C WrkStn SF Position
100 McAllister 4 401 STAFF OFFICE OPEN 2 350 MANAGING DIRECTOR; DEVELOPMENT ASSOCIATE
100 McAllister 4 402 STAFF OFFICE OPEN 2 575 ASSOCIATE DIRECTOR; PROGRAM ASSOCIATE
100 McAllister 4 423 FACULTY OFFICE CLOSED 1 310 DIRECTOR
TOTAL 5 1,235
SHARED ON FLOOR
Building Floor Room Room Type Open/Closed Capacity SF User
100 McAllister 4 413 BREAK NA 250 SHARED
100 McAllister 4 412 CONFERENCE NA 8 220 SHARED
Building Floor Room Room Type Open/Closed Capacity SF User
100 McAllister 4 410 SEMINAR NA 10 230 SHARED
100 McAllister 4 404 SEMINAR NA 20 400 SHARED
TOTAL 1,100
100*MCALLISTER*3*JOURNALS
OFFICE OF SCHOLARLY PUBLICATIONS
Building Floor Room Room Type O/C WrkStn SF Organization Position
100 McAllister 22 2204 STAFF OFFICE CLOSED 1 158 OFFICE OF SCHOLARLY PUBLICATIONS DIRECTOR
100 McAllister 22 2205 STUDENT OFFICE OPEN 7 453 COMMUNICATIONS & ENTERTAINMENT
100 McAllister 22 2208 STUDENT OFFICE CLOSED 1 123 COMMUNICATIONS & ENTERTAINMENT
100 McAllister 22 2203 STUDENT OFFICE OPEN 4 230 RACE AND POVERTY
200 McAllister 1 109A STUDENT OFFICE OPEN 1 320 SCIENCE & TECHNOLOGY
100 McAllister 22 2201 STUDENT OFFICE OPEN 6 385 WEST-NORTHWEST JOURNAL OF ENVIRONMENTAL
100 McAllister 22 2209 STUDENT OFFICE CLOSED 1 121 WEST-NORTHWEST JOURNAL OF ENVIRONMENTAL
100 McAllister 22 2207 STUDENT OFFICE OPEN 5 300 WOMEN'S LAW JOURNAL
100 McAllister 22 2207A STUDENT OFFICE CLOSED 1 95 WOMEN'S LAW JOURNAL
100 McAllister 23 2303 STUDENT OFFICE CLOSED 2 129 BUSINESS LAW JOURNAL
100 McAllister 23 2304 STUDENT OFFICE CLOSED 2 175 BUSINESS LAW JOURNAL
100 McAllister 23 2302 STUDENT OFFICE CLOSED 5 197 CONSTITUTIONAL LAW QUARTERLY
100 McAllister 23 2302A STUDENT OFFICE CLOSED 5 95 CONSTITUTIONAL LAW QUARTERLY
100 McAllister 23 2301 STUDENT OFFICE CLOSED 9 813 HASTINGS LAW JOURNAL
100 McAllister 23 2308 STUDENT OFFICE CLOSED 1 107 HASTINGS LAW JOURNAL
100 McAllister 23 2305 STUDENT OFFICE CLOSED 6 437 INTERNATIONAL & COMPARATIVE LAW REVIEW
100 McAllister 23 2306 STUDENT OFFICE CLOSED 1 123 INTERNATIONAL & COMPARATIVE LAW REVIEW
Building Floor Room Room Type Open/Closed Capacity SF Organization
100 McAllister 22 2202 BREAK/RESOURCE NA 96 LAW JOURNALS
100 McAllister 11 STORAGE NA 400 LAW JOURNALS
100 McAllister 12 STORAGE NA 300 LAW JOURNALS
100 McAllister 13 STORAGE NA 400 LAW JOURNALS
TOTAL 58 5,457
DETAIL
EXISTING SPACE PROGRAM
DISCOVERY
ASSESSMENT
STRATEGY
PLANNING
& DESIGN
PROTOTYPE
& TESTING
IMPLEMENTATION
DISCOVERY
ASSESSMENT
ANALYZING
EXISTING CONDITIONS
4.
proprietary and confidential
UC Hastings College of the Law Kane Hall Programming and Planning
ANALYZING EXISTING CONDITIONS
ORGANIZATIONAL TYPOLOGIES – UNCOVERING INEFFICIENCIES
34
RESOURCES
OFFICES/
WORKSTATIONS
OFFICES/
WORKSTATIONS
OFFICES/
WORKSTATIONS RESOURCES
RESOURCES
SCATTERED
OFFICES/
WORKSTATIONS
RESOURCES
OFFICES/
WORKSTATIONS
RESOURCES
OFFICES/
WORKSTATIONS
RESOURCES
INDEPENDENT
SHARED
RESOURCES
OFFICES/
WORKSTATIONS
OFFICES/
WORKSTATIONS
OFFICES/
WORKSTATIONS
CO-LOCATED
OFFICES/
WORKSTATIONS
OFFICES/
WORKSTATIONS
RESOURCES
RESOURCES
OFFICES/
WORKSTATIONS
RESOURCES
CLUSTER
ASSESSMENT
STRATEGY
PLANNING
& DESIGN
PROTOTYPE
& TESTING
IMPLEMENTATION
ASSESSMENT
proprietary and confidential
UC Hastings College of the Law Kane Hall Programming and Planning
ANALYZING EXISTING CONDITIONS
CONCEPTUAL ORGANIZATION MODEL – 100 MCALLISTER
35

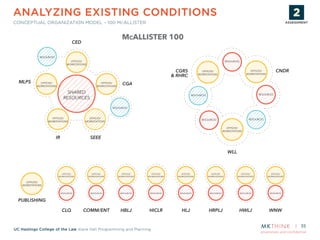

MCALLISTER 100
RESOURCES
RESOURCES
SHARED
RESOURCES
OFFICES/
WORKSTATIONS
OFFICES/
WORKSTATIONS
OFFICES/
WORKSTATIONS
OFFICES/
WORKSTATIONS
OFFICES/
WORKSTATIONS
CGAMLPS
IR SEEE
CED
CNDRCGRS
& RHRC
WLL
OFFICES/
WORKSTATIONS
OFFICES/
WORKSTATIONS
OFFICES/
WORKSTATIONS
RESOURCES
RESOURCESRESOURCES
RESOURCES
RESOURCES
OFFICES/
WORKSTATIONS
RESOURCES
OFFICES/
WORKSTATIONS
RESOURCES
OFFICES/
WORKSTATIONS
RESOURCES
OFFICES/
WORKSTATIONS
RESOURCES
OFFICES/
WORKSTATIONS
RESOURCES
OFFICES/
WORKSTATIONS
OFFICES/
WORKSTATIONS
RESOURCES
OFFICES/
WORKSTATIONS
RESOURCES
OFFICES/
WORKSTATIONS
RESOURCES
CLQ
PUBLISHING
COMM/ENT HBLJ HICLR HLJ HRPLJ HWLJ WNW
ASSESSMENT
STRATEGY
PLANNING
& DESIGN
PROTOTYPE
& TESTING
IMPLEMENTATION
ASSESSMENT
proprietary and confidential
UC Hastings College of the Law Kane Hall Programming and Planning
CONCEPTUAL ORGANIZATION MODEL – 198 MCALLISTER
36
ANALYZING EXISTING CONDITIONS
MCALLISTER 198
RESOURCES
OFFICES/
WORKSTATIONS
RESOURCES
CLSGL
ASSESSMENT
STRATEGY
PLANNING
& DESIGN
PROTOTYPE
& TESTING
IMPLEMENTATION
ASSESSMENT
proprietary and confidential
UC Hastings College of the Law Kane Hall Programming and Planning
CONCEPTUAL ORGANIZATION MODEL – 200 MCALLISTER
37
MCALLISTER 200
ANALYZING EXISTING CONDITIONS
OFFICES/
WORKSTATIONS
RESOURCES
IN2
OFFICES/
WORKSTATIONS
RESOURCES
STLJ
RESOURCES
OFFICES/
WORKSTATIONS
OFFICES/
WORKSTATIONS
OFFICES/
WORKSTATIONS RESOURCES
RESOURCES
CONS.
RESOURCES RESOURCES RESOURCES
ASSESSMENT
STRATEGY
PLANNING
& DESIGN
PROTOTYPE
& TESTING
IMPLEMENTATION
ASSESSMENT
proprietary and confidential
UC Hastings College of the Law Kane Hall Programming and Planning
SURVEY WORKBOOK
38
SURVEY WORKBOOK
ANALYZING EXISTING CONDITIONS ASSESSMENT
STRATEGY
PLANNING
& DESIGN
PROTOTYPE
& TESTING
IMPLEMENTATION
ASSESSMENT
proprietary and confidential
UC Hastings College of the Law Kane Hall Programming and Planning
39
SURVEY WORKBOOK

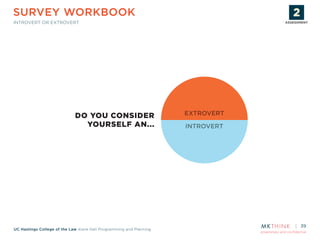

INTROVERT OR EXTROVERT
INTROVERT
EXTROVERTDO YOU CONSIDER
YOURSELF AN...
ASSESSMENT
STRATEGY
PLANNING
& DESIGN
PROTOTYPE
& TESTING
IMPLEMENTATION
ASSESSMENT
proprietary and confidential
UC Hastings College of the Law Kane Hall Programming and Planning
40

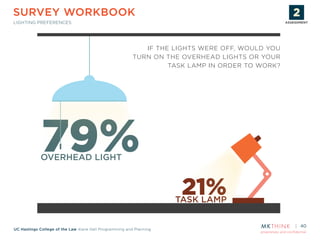

TASK LAMP
21%
79%OVERHEAD LIGHT
IF THE LIGHTS WERE OFF, WOULD YOU
TURN ON THE OVERHEAD LIGHTS OR YOUR
TASK LAMP IN ORDER TO WORK?
SURVEY WORKBOOK
LIGHTING PREFERENCES
ASSESSMENT
STRATEGY
PLANNING
& DESIGN
PROTOTYPE
& TESTING
IMPLEMENTATION
ASSESSMENT
proprietary and confidential
UC Hastings College of the Law Kane Hall Programming and Planning
41
HOW OFTEN DO YOU
MEET WITH CLIENTS...
50% 7% 7% 14%22%
in your office
43% 18% 14%25%
in a conference room
50% 11% 11% 3%25%
off-site
MORE THAN
ONCE A DAY
ONCE A
DAY
2-3 TIMES
A WEEK
ONCE A
WEEK
LESS THAN
ONCE A WEEK
NEVER
SURVEY WORKBOOK
CLIENT MEETINGS
ASSESSMENT
STRATEGY
PLANNING
& DESIGN
PROTOTYPE
& TESTING
IMPLEMENTATION
ASSESSMENT
proprietary and confidential
UC Hastings College of the Law Kane Hall Programming and Planning
42
SURVEY WORKBOOK
TOP-5 ACTIVITIES
0%
TOGETHERALONE
100%
EATING
MEALS
0%
CONDUCTING
OUTREACH
13%
7%
MEETING
WITH
CLIENTS
OFF-SITE
17%
MEETING
WITH
CLIENTS
ON-SITE
20%
PLANNING
EVENTS
57%
COLLABORATING
WITH A TEAM
ATTENDING
A TEAM
MEETING
50%
WORKING
WITH
STUDENTS
47%
WORKING
WITH
FACULTY
MEMBERS
43%
13%
PREPARING
CASE
WORK
20%
OTHER
10%
TRAVELING
PLACE TO
PLACE
40%
DEVELOPING
A LESSON
PLAN
43%
MAKING
PHONE
CALLS
47%
RESEARCHING
WRITING
63%
ASSESSMENT
STRATEGY
PLANNING
& DESIGN
PROTOTYPE
& TESTING
IMPLEMENTATION
ASSESSMENT
proprietary and confidential
UC Hastings College of the Law Kane Hall Programming and Planning
43
SURVEY WORKBOOK

TOP-5 PLACES
CONFERENCE
ROOM
47%
SEMINAR
ROOM
43%
COPY
ROOM
37%BREAK
ROOM
10%
LIBRARY
13%
WORKROOM
7%
CAFÉ
7%
KITCHEN
7%
STUDY
ROOM
0%
READING
ROOM
0%
LOUNGE
3%
CAFETERIA
3%
OFF-SITE
43%
100%
MY OFFICE
50%
AN OFFICE
THAT IS NOT
MY OWN
27%
OTHER
0%
SHAREDPRIVATE
100%
ASSESSMENT
STRATEGY
PLANNING
& DESIGN
PROTOTYPE
& TESTING
IMPLEMENTATION
ASSESSMENT
STRATEGY
FUTURE
SCENARIOS
5.
proprietary and confidential
UC Hastings College of the Law Kane Hall Programming and Planning
45
CLASSROOM/
SEMINAR
CLASSROOM/
SEMINAR
CLASSROOM/
SEMINAR
CLASSROOM/
SEMINAR
CLASSROOM/
SEMINAR
CLASSROOM/
SEMINAR

CED
OFFICE/
WORKSTATIONS
CGA
OFFICE/
WORKSTATIONS
SEEE
OFFICE/
WORKSTATIONS
IR
OFFICE/
WORKSTATIONS
SMALL
MEETING
(2-6)
NEW CLINIC
OFFICE/
WORKSTATIONS
STUDENT
WORKSTATIONS
RECEPTION/
LOBBY

JOURNAL
OFFICE
JOURNAL
OFFICE
JOURNAL
OFFICE
JOURNAL
OFFICE
JOURNAL
OFFICE
JOURNAL
OFFICE
JOURNAL
OFFICE
JOURNAL
OFFICE
JOURNAL
OFFICE
PUBLISHING
OFFICE
MEETING
OFFICES/
WORKSTATIONS
RESOURCE
W
LL
RECEPTION
IN
2
MEETING
OFFICES/
WORKSTATIONS
RESOURCE
RECEPTION
C
O
NS.
MEETING
OFFICES/
WORKSTATIONS
RESOURCE
RECEPTION
FU
TURE
MEETING
OFFICES/
WORKSTATIONS
RESOURCE
RECEPTION
C
SLGL
MEETING
OFFICES/
WORKSTATIONS
RESOURCE
RECEPTION
C
GRS
MEETING
OFFICES/
WORKSTATIONS
RESOURCE
RECEPTION
CND
R
/ ME.
MEETING
OFFICES/
WORKSTATIONS
RESOURCE
RECEPTION
SMALL
MEETING
(2-6)
BREAKOUT BREAKOUT
BREAKOUT
BREAKOUTBREAKOUT
BREAKOUT
COPY
ROOM/
STORAGE
LOUNGE
BREAK/
KITCHEN
MEDIUM
MEETING
ROOM /
BREAK-OUT
(6-12)
COPY
ROOM/
STORAGE
RESOURCE
LIBRARY
LOUNGE
BREAK/
KITCHEN
SMALL
MEETING
(2-6)
SMALL
MEETING
(2-6)
MEDIUM
MEETING
ROOM /
BREAK-OUT
(6-12)
CLINICSCENTERS JOURNALS
GENERAL
FACULTY
MLPS
OFFICE/
WORKSTATIONS
RHRC
OFFICE/
WORKSTATIONS
FUTURE SCENARIOS
CONCEPTUAL ORGANIZATION MODEL – ALL PROGRAMS
STRATEGY
PLANNING
& DESIGN
PROTOTYPE
& TESTING
IMPLEMENTATION
STRATEGY
proprietary and confidential
UC Hastings College of the Law Kane Hall Programming and Planning
CONCEPTUAL ORGANIZATION MODEL – CENTERS
46
MEETING
OFFICES/
WORKSTATIONS
RESOURCE
W
LL
RECEPTION
IN
2
MEETING
OFFICES/
WORKSTATIONS
RESOURCE
RECEPTION
C
O
NS.
MEETING
OFFICES/
WORKSTATIONS
RESOURCE
RECEPTION
FU
TURE
MEETING
OFFICES/
WORKSTATIONS
RESOURCE
RECEPTION
C
SLGL
MEETING
OFFICES/
WORKSTATIONS
RESOURCE
RECEPTION
C
GRS
MEETING
OFFICES/
WORKSTATIONS
RESOURCE
RECEPTION
CND
R
/ ME.
MEETING
OFFICES/
WORKSTATIONS
RESOURCE
RECEPTION
CENTERS
CLASSROOM/
SEMINAR
CLASSROOM/
SEMINAR
CLASSROOM/
SEMINAR
CLASSROOM/
SEMINAR
CED
OFFICE/
WORKSTATIONS
CGA
OFFICE/
WORKSTATIONS
SEEE
OFFICE/
WORKSTATIONS
IR
OFFICE/
WORKSTATIONS
SMALL
MEETING
(2-6)
NEW CLINIC
OFFICE/
WORKSTATIONS
STUDENT
WORKSTATIONS
RECEPTION/
LOBBY
MEETING
OFFICES/
WORKSTATIONS
RESOURCE
W
LL
RECEPTION
IN
2
MEETING
OFFICES/
WORKSTATIONS
RESOURCE
RECEPTION
C
O
NS.
MEETING
OFFICES/
WORKSTATIONS
RESOURCE
RECEPTION
FU
TURE
MEETING
OFFICES/
WORKSTATIONS
RESOURCE
RECEPTION
C
SLGL
MEETING
OFFICES/
WORKSTATIONS
RESOURCE
RECEPTION
C
GRS
MEETING
OFFICES/
WORKSTATIONS
RESOURCE
RECEPTION
CND
R
/ ME.
MEETING
OFFICES/
WORKSTATIONS
RESOURCE
RECEPTION
SMALL
MEETING
(2-6)
BREAKOUTBREAKOUT
MEDIUM
MEETING
ROOM /
BREAK-OUT
(6-12)
COPY
ROOM/
STORAGE
RESOURCE
LIBRARY
LOUNGE
BREAK/
KITCHEN
SMALL
MEETING
(2-6)
SMALL
MEETING
(2-6)
MEDIUM
MEETING
ROOM /
BREAK-OUT
(6-12)
CLINICSCENTERS
MLPS
OFFICE/
WORKSTATIONS
RHRC
OFFICE/
WORKSTATIONS
FUTURE SCENARIOS STRATEGY
PLANNING
& DESIGN
PROTOTYPE
& TESTING
IMPLEMENTATION
STRATEGY
proprietary and confidential
UC Hastings College of the Law Kane Hall Programming and Planning
CONCEPTUAL ORGANIZATION MODEL – CLINICS
47
CLASSROOM/
SEMINAR
CLASSROOM/
SEMINAR
CED
OFFICE/
WORKSTATIONS
CGA
OFFICE/
WORKSTATIONS
SEEE
OFFICE/
WORKSTATIONS
IR
OFFICE/
WORKSTATIONS
SMALL
MEETING
(2-6)
NEW CLINIC
OFFICE/
WORKSTATIONS
STUDENT
WORKSTATIONS
RECEPTION/
LOBBY
SMALL
MEETING
(2-6)
MEDIUM
MEETING
ROOM /
BREAK-OUT
(6-12)
COPY
ROOM/
STORAGE
RESOURCE
LIBRARY
SMALL
MEETING
(2-6)
SMALL
MEETING
(2-6)
MEDIUM
MEETING
ROOM /
BREAK-OUT
(6-12)
CLINICS
MLPS
OFFICE/
WORKSTATIONS
RHRC
OFFICE/
WORKSTATIONS
CLASSROOM/
SEMINAR
CLASSROOM/
SEMINAR
CLASSROOM/
SEMINAR
CLASSROOM/
SEMINAR
CLASSROOM/
SEMINAR
CLASSROOM/
SEMINAR
CED
OFFICE/
WORKSTATIONS
CGA
OFFICE/
WORKSTATIONS
SEEE
OFFICE/
WORKSTATIONS
IR
OFFICE/
WORKSTATIONS
SMALL
MEETING
(2-6)
NEW CLINIC
OFFICE/
WORKSTATIONS
STUDENT
WORKSTATIONS
RECEPTION/
LOBBY
MEETING
RECEPTION
MEETING
RECEPTION
MEETING
RECEPTION
MEETING
RECEPTION
SMALL
MEETING
(2-6)
BREAKOUT BREAKOUT
BREAKOUT
BREAKOUTBREAKOUT
BREAKOUT
MEDIUM
MEETING
ROOM /
BREAK-OUT
(6-12)
COPY
ROOM/
STORAGE
RESOURCE
LIBRARY
LOUNGE
BREAK/
KITCHEN
SMALL
MEETING
(2-6)
SMALL
MEETING
(2-6)
MEDIUM
MEETING
ROOM /
BREAK-OUT
(6-12)
CLINICS JOURN
GENERAL
FACULTY
MLPS
OFFICE/
WORKSTATIONS
RHRC
OFFICE/
WORKSTATIONS
FUTURE SCENARIOS STRATEGY
PLANNING
& DESIGN
PROTOTYPE
& TESTING
IMPLEMENTATION
STRATEGY
proprietary and confidential
UC Hastings College of the Law Kane Hall Programming and Planning
48
JOURNAL
OFFICE
JOURNAL
OFFICE
JOURNAL
OFFICE
JOURNAL
OFFICE
JOURNAL
OFFICE
JOURNAL
OFFICE
JOURNAL
OFFICE
JOURNAL
OFFICE
JOURNAL
OFFICE
PUBLISHING
OFFICE
COPY
ROOM/
STORAGE
LOUNGE
BREAK/
KITCHEN
JOURNALS
CONCEPTUAL ORGANIZATION MODEL – JOURNALS
CLASSROOM/
SEMINAR
CLASSROOM/
SEMINAR
CLASSROOM/
SEMINAR
JOURNAL
OFFICE
JOURNAL
OFFICE
JOURNAL
OFFICE
JOURNAL
OFFICE
JOURNAL
OFFICE
JOURNAL
OFFICE
JOURNAL
OFFICE
JOURNAL
OFFICE
JOURNAL
OFFICE
PUBLISHING
OFFICE
SMALL
MEETING
(2-6)
BREAKOUT BREAKOUT
BREAKOUT BREAKOUT
COPY
ROOM/
STORAGE
LOUNGE
BREAK/
KITCHEN
MEDIUM
MEETING
ROOM /
BREAK-OUT
(6-12)
COPY
ROOM/
STORAGE
JOURNALS
FUTURE SCENARIOS STRATEGY
PLANNING
& DESIGN
PROTOTYPE
& TESTING
IMPLEMENTATION
STRATEGY
proprietary and confidential
UC Hastings College of the Law Kane Hall Programming and Planning
49
CLASSROOM/
SEMINAR
CLASSROOM/
SEMINAR
CLASSROOM/
SEMINAR
CLASSROOM/
SEMINAR
CLASSROOM/
SEMINAR
CLASSROOM/
SEMINAR
CED
OFFICE/
WORKSTATIONS
CGA
OFFICE/
WORKSTATIONS
SEEE
OFFICE/
WORKSTATIONS
IR
OFFICE/
WORKSTATIONS
SMALL
MEETING
(2-6)
NEW CLINIC
OFFICE/
WORKSTATIONS
STUDENT
WORKSTATIONS
RECEPTION/
LOBBY
JOURNAL
OFFICE
JOURNAL
OFFICE
JOURNAL
OFFICE
JOURNAL
OFFICE
JOURNAL
OFFICE
JOURNAL
OFFICE
JOURNAL
OFFICE
JOURNAL
OFFICE
JOURNAL
OFFICE
PUBLISHING
OFFICE
MEETING
OFFICES/
WORKSTATIONS
RESOURCE
W
LL
RECEPTION
IN
2
MEETING
OFFICES/
WORKSTATIONS
RESOURCE
RECEPTION
C
O
NS.
MEETING
OFFICES/
WORKSTATIONS
RESOURCE
RECEPTION
FU
TURE
MEETING
OFFICES/
WORKSTATIONS
RESOURCE
RECEPTION
C
SLGL
MEETING
OFFICES/
WORKSTATIONS
RESOURCE
RECEPTION
C
GRS
MEETING
OFFICES/
WORKSTATIONS
RESOURCE
RECEPTION
CND
R
/ ME.
MEETING
OFFICES/
WORKSTATIONS
RESOURCE
RECEPTION
SMALL
MEETING
(2-6)
BREAKOUT BREAKOUT
BREAKOUT
BREAKOUTBREAKOUT
BREAKOUT
COPY
ROOM/
STORAGE
LOUNGE
BREAK/
KITCHEN
MEDIUM
MEETING
ROOM /
BREAK-OUT
(6-12)
COPY
ROOM/
STORAGE
RESOURCE
LIBRARY
LOUNGE
BREAK/
KITCHEN
SMALL
MEETING
(2-6)
SMALL
MEETING
(2-6)
MEDIUM
MEETING
ROOM /
BREAK-OUT
(6-12)
CLINICSCENTERS JOURNALS
GENERAL
FACULTY
MLPS
OFFICE/
WORKSTATIONS
RHRC
OFFICE/
WORKSTATIONS
FUTURE SCENARIOS
CONCEPTUAL ORGANIZATION MODEL – ALL PROGRAMS
STRATEGY
PLANNING
& DESIGN
PROTOTYPE
& TESTING
IMPLEMENTATION
STRATEGY
100 MCALLISTER:
REVENUE
PROJECTIONS
6.
proprietary and confidential
UC Hastings College of the Law Kane Hall Programming and Planning
PROJECTED TOWER REVENUE
51
Total of 17,410 rentable square feet available
• Additional housing is achieved on the 22nd and 23rd floors
addressing an important student need and generating additional
revenue
• 3rd and 4th floors converted to office rentals, generating additional
revenue
Revenue Estimate
• Low estimate for additional revenue from rent $552,000
• High estimate for additional revenue from rent $610,000
proprietary and confidential
UC Hastings College of the Law Kane Hall Programming and Planning
NEXT STEPS
52
• Upcoming Summer meetings with 200 Programming and Planning
Committee:
• Wednesday July 9 / 1pm - 2pm / CJC Seminar Room
• Wednesday July 23 / 1pm - 2pm / CJC Seminar Room
• Meeting with the Library in order to begin plan for the consolidation of
the 4th and 5th floors
We welcome your input or concerns. For additional
questions about the 200 Programming and Planning
process please contact Evelyn Lee at lee@mkthink.com

UC Hastings 200 Programming and Planning Update

  • 1.
    UNIVERSITY OF CALIFORNIA, HASTINGSCOLLEGE OF THE LAW 200 McALLISTER: KANE HALL PROGRAMMING + PLANNING UPDATE 06.16.14
  • 2.
    proprietary and confidential UCHastings College of the Law Kane Hall Programming and Planning AGENDA 2 1. INTRODUCTION: MKTHINK 2. PROJECT OVERVIEW 3. DISCOVERY: UNDERSTANDING EXISTING CONDITIONS 4. ASSESSMENT: ANALYZING EXISTING CONDITIONS 5. STRATEGY: FUTURE SCENARIOS 6. 100 McAllister Revenue Projections 7. NEXT STEPS
  • 3.
  • 4.
    proprietary and confidential UCHastings College of the Law Kane Hall Programming and Planning ABOUT MKTHINK MULTIDIMENSIONAL APPROACH 4 USER ARCHITECTURE ENVIRONMENT Time
  • 5.
    proprietary and confidential UCHastings College of the Law Kane Hall Programming and Planning ABOUT MKTHINK PROJECT EXPERIENCE 5 LAW SCHOOL CLIENTS OTHER HIGHER-ED CLIENTS California College of the Arts Menlo College New College of California San Francisco Art Institute Santa Clara University Stanford Graduate School of Business Stanford School of Education Stanford School of Engineering (d.School) Stanford University University California Berkeley University of San Francisco
  • 6.
    proprietary and confidential UCHastings College of the Law Kane Hall Programming and Planning LAW SCHOOL EXPERIENCE STANFORD LAW SCHOOL COMPLETED PROJECTS 6 COMPLETED PROJECTS Law Clinics Law Library Lecture Halls Moot Court Office Environments Interiors Campus Master Plan !
  • 7.
    proprietary and confidential UCHastings College of the Law Kane Hall Programming and Planning LAW SCHOOL EXPERIENCE GOLDEN GATE UNIVERSITY CLASSROOM MODERNIZATIONS 7
  • 8.
    proprietary and confidential UCHastings College of the Law Kane Hall Programming and Planning MKTHINK’S PROCESS THE 6-STEP PROCESS 8 Measure current conditions, refine assignments, and establish baseline. Identify opportunities and associated benefits based on analytic framework. Define programmatic and spatial initiatives required to achieve goal. Develop content specific initiatives identified in Strategic Master Plan. Test critical components of program/ design solution and refine. Implement project(s) according to scope, schedule and budget parameters. DISCOVERY ASSESSMENT STRATEGY PLANNING & DESIGN PROTOTYPE & TESTING IMPLEMENTATION DESCRIPTION:
  • 9.
    proprietary and confidential UCHastings College of the Law Kane Hall Programming and Planning MKTHINK’S PROCESS THE 6-STEP PROCESS 9 Guiding Principles and Boundaries, Stakeholder Engagement, Space Plans, Asset Database, Existing Space Program Analyze/Visualize Qualitative and Quantitative Data, Existing Conceptual Organization Model Proposed Conceptual Organization Model, Proposed Space Program, Programmatic Blocking, Test Fits, Functional Specifications DELIVERABLES: DISCOVERY ASSESSMENT STRATEGY PLANNING & DESIGN PROTOTYPE & TESTING IMPLEMENTATION Plans, Design Guidelines 200MCALLISTER PLANNING+PROGRAMMING
  • 10.
  • 11.
    proprietary and confidential UCHastings College of the Law Kane Hall Programming and Planning PROJECT GOALS STRENGTHENING THE HEART OF CAMPUS 11 CLASSROOMS STUDENT LIFE LIBRARY FACULTY THE BEACH DINING ALUMNI SERVICES CLASSROOMS STUDENT LIFE LIBRARY FACULTY THE BEACH DINING ALUMNI SERVICES CLINICS CENTERS JOURNALS FACULTY CLINICS CENTERS JOURNALS FACULTY
  • 12.
    proprietary and confidential UCHastings College of the Law Kane Hall Programming and Planning 200 PROGRAMMING AND PLANNING COMMITTEE MEMBERS 12 •Hadar Aviram •Charles Belle •Steven Bonorris •Ellen Crosson •Whitney Curtis •Robin Devaux •Sunny Dhamrait •David Faigman •Robin Feldman •Roslyn Foy •Miye Goishi •Jolynn Jones •David Jung •Jamie King •Tom McCarthy •Karen Musalo •Jenni Parrish •Ascanio Piomelli •Sheila Purcell •Aaron Rappaport •David Seward •Joy Siu •Michael Stonebreaker •Nancy Stuart •Yvonne Troya •Joan Williams •Frank Wu
  • 13.
    proprietary and confidential UCHastings College of the Law Kane Hall Programming and Planning ENGAGEMENT PROCESS WORKING TOGETHER 13 KICKOFF MEETING ONE-ON-ONE INTERVIEWS DRAFT GUIDING PRINCIPLES & BOUNDARIES DRAFT CONCEPTUAL ORG. MODEL FINALIZEDFINALIZED NEXT STEPS FINALIZEDFINALIZED COMMITTEE ESTABLISHED COMMITTEE ESTABLISHED COMMITTEE MEETINGS COMMITTEE MEETINGS 1 2 3 COMMITTEE MEETINGS COMMITTEE MEETINGS 1 2 3 surveys data site visits
  • 14.
    proprietary and confidential UCHastings College of the Law Kane Hall Programming and Planning 200 PROGRAMMING AND PLANNING PARTICIPANTS 14 • Sarah Adams • Hadar Aviram • Alina Ball • Charles Belle • Steven Bonorris • Blaine Bookey • Ben Buchwalter • Jasmine Braxton • Jessie Cassella • Dan Cheng • Henna Choi • Ellen Crosson • Chelsey Crowley • Whitney Curtis • Robin Devaux • Sunny Dhamrait • Carolyn Dickie • Julia Epstein • David Faigman • Robin Feldman • Brian Flynn • Jake Wexler • John Najuoks • John O’Neill • Jenni Parrish • Brian Pascal • David Perl • Ascanio Piomelli • Sheila Purcell • Sonya Rahders • Sonya Rahders • Aaron Rappaport • Michael Salerno • Misha Seay • David Seward • Derek Schaible • Gail Silverstein • Joy Siu • Michael Stonebreaker • Nancy Stuart • Deylin Thrift-Viveros • Yvonne Troya • Roslyn Foy • Lisa Frydman • Martin Fukui • Elena Gekker • Miye Goishi • Anne Marie Helm • Pedro Hernandez • Emily Higgs • Sarah Hooper • Dustin Ingraham • Carol Izumi • Jolynn Jones • David Jung • Brian King • Jamie King • Emily Knox • Eumi Lee • Jennifer Lerner • Christine Lin • Patti Lin • Mike Linder • Tom McCarthy • Karen Musalo • Joan Williams • Joshua Wolf • Chris Wong • Frank Wu
  • 15.
    proprietary and confidential UCHastings College of the Law Kane Hall Programming and Planning TAKING INVENTORY CENTERS, CLINICS, AND JOURNALS 15
  • 16.
    proprietary and confidential UCHastings College of the Law Kane Hall Programming and Planning GUIDING PRINCIPLES AND BOUNDARIES GUIDING PRINCIPLES 16 PROCESS • Engage all stakeholders in the project process. • Provide a range of options for optimal strategies. ! LONG RANGE CAMPUS PLAN • All strategies will support the LRCP 1.0 and preceding strategic reports. • Design for the needs of the students. • Leverage 100 McAllister for potential revenue-generating opportunities. • Increase student life and activity at 200 McAllister, and in particular the ground floor. Improve first impressions of the campus.
  • 17.
    proprietary and confidential UCHastings College of the Law Kane Hall Programming and Planning GUIDING PRINCIPLES AND BOUNDARIES GUIDING PRINCIPLES 17 CLINICS, CENTERS, AND JOURNALS PROGRAMS • Design to serve the mission(s), teachings, services, and scholarship of each clinic, center, and journal. • Serve the needs of both the individuals and the group for all programs. • Integrate programs into the intellectual life of the students and the College. • Provide opportunities for students and practitioners to work together and collaborate. • Maintain and strengthen the unique identity and brand of each program. • Maintain and improve the operations and physical relationships for each clinic, center, and journal, as well as the inter-relationships between programs. • Design with flexibility in mind – grants and funding swings often cause staff fluctuation. • Design with clients in mind, which considers confidentiality and accessibility. • Remain cutting-edge and innovative with regard to tools and technology in order to remain competitive. • Design with the consideration of economies of scale by maximizing staffing spaces and developing common area spaces for similar or overlapping programs. • Improve wayfinding and path of travel to the clinics, centers, and journals. Make them easily accessible to the broader community. • Ensure the security of students, faculty, staff, and the clinics, centers, and journals. • Employ sustainable design by considering the use of natural light, material choices, and furniture selection. • Preserve the window line for shared and multi-functional space.
  • 18.
    proprietary and confidential UCHastings College of the Law Kane Hall Programming and Planning GUIDING PRINCIPLES AND BOUNDARIES PROJECT BOUNDARIES 18 MOVE-OUT • Relocate all programs in the 3rd, 4th, 22nd, and 23rd floor of 100 McAllister to 200 McAllister. • Consider the relocation of Health Services to a more private location on campus.
 MOVE-IN • Potential 200 McAllister relocation sites: 1st floor; 2nd floor health clinic; 4th and/or 6th floor library). • Minimize cost of renovation and avoid changes that necessitate major changes to building systems. • Preserve to the maximum extent possible previous investments in physical plant improvements. • Preserve or increase the amount of student study space and classrooms on campus. • Preserve the special collections archive located on the 6th floor of 200 McAllister . • Maintain the amount of private faculty offices located on the 6th floor of 200 McAllister . • Journals must have 24 hour access. • Prioritize approaches and projects that minimize construction period disruptions to ongoing academic operations. • All relocated programs will be moved in no later than January 2016.
  • 19.
    proprietary and confidential UCHastings College of the Law Kane Hall Programming and Planning 2014 Jan. Feb. Mar. Apr. May June July Aug. Sept. Oct. No SPACE PROGRAM FINALIZED KICK-OFF DES FINAL PROGRAM DEVELOPMENT DESIGN DEVELOPMENT FINAL PROGRAM SCENARIO SELECTED GP & B Database Development Benchmarking Interviews + Analysis (Large group, small, & individual interviews/meetings) Analyze Existing Conditions Develop + Refine Space Program Develop + Refine Program Scenarios Design Development Finalize Program TIMELINE PROJECT TIMELINE OVERVIEW 19 WE ARE HERE 06.16.2014 Develop program scenarios Floor Plans October 2014
  • 20.
  • 21.
    proprietary and confidential UCHastings College of the Law Kane Hall Programming and Planning UNDERSTANDING EXISTING CONDITIONS SPACE TEST FIT 21 5,000 10,000 15,000 20,000 25,000 30,000 35,000 Total Existing Space Program Total Possible Relocation Space 34,217 SF 25,346 SF 100 McAllister 198 McAllister 200 McAllister 1st Floor 6th Floor Opportunity Classroomrs Special Collections Offices Offices Conf/Mtg/Resources Instructional Load/Circulation DISCOVERY ASSESSMENT STRATEGY PLANNING & DESIGN PROTOTYPE & TESTING IMPLEMENTATION DISCOVERY
  • 22.
    proprietary and confidential UCHastings College of the Law Kane Hall Programming and Planning 100 MCALLISTER 3RD FLOOR 22 100 MCALLISTER 3RD FLOOR CIVIL JUSTICE CLINICCJCCLINIC INDIVIDUAL REPRESENTATIONIRCLINIC COMMUNITY ECONOMIC DEVELOPMENT CEDCLINIC COMMUNITY GROUP ADVOCACY AND SOCIAL CHANGE CGACLINIC MEDICAL LEGAL PARTNERSHIP FOR SENIORS MLPSCLINIC SHARED SEMINAR ROOMSSem.SHARED ASSOCIATE DEAN FOR EXPERIENTIAL PROGRAMS Assoc Dean LEADERSHIP MLPS CED SEEE CJC CGAIR Assoc Dean Sem. SOCIAL ENTERPRISE AND ECONOMIC EMPOWERMENT SEEECLINIC SEMINAR SEMINAR OFFICE OFFICE OFFICE RECEPTION OFFICE OFFICE OFFICE OFFICE OFFICE OFFICE OFFICE CONF. CONF. BREAK BATHROOM BATHROOM SPACE PLAN DISCOVERY ASSESSMENT STRATEGY PLANNING & DESIGN PROTOTYPE & TESTING IMPLEMENTATION DISCOVERY
  • 23.
    proprietary and confidential UCHastings College of the Law Kane Hall Programming and Planning SPACE PLAN 100 MCALLISTER 4TH FLOOR 23 100 MCALLISTER 4TH FLOOR OFFICE SEMINAR OFFICE OFFICE OFFICE LOBBY OFFICE OFFICE OFFICE OFFICEOFFICE OFFICE OFFICE LOBBY OFFICE CENTER FOR NEGOTIATION AND DISPUTE RESOLUTION CNDRCENTER CENTER FOR GENDER AND REFUGEE STUDIES CGRSCENTER CENTER FOR WORKLIFE LAWWLLCENTER REFUGEE AND HUMAN RIGHTS CLINIC RHRCCLINIC SHARED SEMINAR ROOMSem.SHARED CNDR CGRS CGRS WLL RHRC RHRC Sem. Sem. Brk. Conf. SHARED CONFERENCE ROOMConf.SHAREDSHARED SHARED BREAK AND COPY ROOMBrk.SHAREDSHARED DISCOVERY ASSESSMENT STRATEGY PLANNING & DESIGN PROTOTYPE & TESTING IMPLEMENTATION DISCOVERY
  • 24.
    proprietary and confidential UCHastings College of the Law Kane Hall Programming and Planning SPACE PLAN 100 MCALLISTER 22ND FLOOR 24 100 MCALLISTER 22ND FLOOR HASTINGS WOMEN’S LAW JOURNAL HWLJJOURNAL HASTINGS RACE & POVERTY LAW JOURNAL HRPLJ JOURNAL COMMUNICATIONS AND ENTERTAINMENT LAW JOURNAL COMM/ENT JOURNAL NORTH-NORTHWEST JOURNAL OF ENVIRONMENTAL LAW WNWJOURNAL HWLJ HRPLJ COMM /ENT WNW Copy OSP OFFICE OF SCHOLARLY PUBLICATIONS OSPJOURNAL SHARED COPY ROOMCopySHARED DISCOVERY ASSESSMENT STRATEGY PLANNING & DESIGN PROTOTYPE & TESTING IMPLEMENTATION DISCOVERY
  • 25.
    proprietary and confidential UCHastings College of the Law Kane Hall Programming and Planning SPACE PLAN 100 MCALLISTER 23RD FLOOR 25 100 MCALLISTER 23RD FLOOR HASTINGS LAW JOURNALHLJJOURNAL CONSTITUTIONAL LAW QUARTERLYCLQJOURNAL BUSINESS LAW JOURNALHBLJJOURNAL INTERNATIONAL AND COMPARATIVE LAW REVIEW HICLRJOURNAL HLJ CLQ HBLJHICLR DISCOVERY ASSESSMENT STRATEGY PLANNING & DESIGN PROTOTYPE & TESTING IMPLEMENTATION DISCOVERY
  • 26.
    proprietary and confidential UCHastings College of the Law Kane Hall Programming and Planning SPACE PLAN 198 MCALLISTER 2ND FLOOR 26 98 MCALLISTER 2ND FLOOR OFFICE OFFICE OFFICE OFFICE SEMINAR SEMINAR CENTER FOR STATE AND LOCAL GOVERNMENT LAW CSLGL CENTER SHARED SEMINAR ROOMSem.SHARED CSLGL CSLGL CSLGL Sem. Sem. 198 MCALLISTER 2ND FLOOR OFFICE OFFICE OFFICE OFFICE SEMINAR SEMINAR CENTER FOR STATE AND LOCAL GOVERNMENT LAW CSLGL CENTER SHARED SEMINAR ROOMSem.SHARED CSLGL CSLGL CSLGL Sem. Sem. DISCOVERY ASSESSMENT STRATEGY PLANNING & DESIGN PROTOTYPE & TESTING IMPLEMENTATION DISCOVERY
  • 27.
    proprietary and confidential UCHastings College of the Law Kane Hall Programming and Planning SPACE PLAN 200 MCALLISTER 1ST FLOOR 27 00 MCALLISTER 1ST FLOOR INSTITUTE FOR INNOVATION LAWIN2 CENTER SCIENCE AND TECHNOLOGY LAW JOURNAL SLJTJOURNAL SLJT i-i OFFICE OFFICE OFFICE FORMER BOOKSTORE BUSINESS CENTER CONF. LOBBY STUDENT INFO CENTER INSTITUTE FOR INNOVATION LAWIN2 CENTER SCIENCE AND TECHNOLOGY LAW JOURNAL SLJTJOURNAL SLJT IN2 OFFICE OFFICE OFFICE FORMER BOOKSTORE BUSINESS CENTER CONF. LOBBY STUDENT INFO CENTER DISCOVERY ASSESSMENT STRATEGY PLANNING & DESIGN PROTOTYPE & TESTING IMPLEMENTATION DISCOVERY
  • 28.
    proprietary and confidential UCHastings College of the Law Kane Hall Programming and Planning SPACE PLAN 200 MCALLISTER 3RD FLOOR 28 00 MCALLISTER 3RD FLOOR CONS. CONS. CONS. i-i UCSF/UC HASTINGS CONSORTIUMCONS.CENTER INSTITUTE FOR INNOVATION LAWIN2 CENTER OFFICE OFFICE OFFICE OFFICE OFFICE OFFICE CONS. CONS. CONS. IN2 UCSF/UC HASTINGS CONSORTIUMCONS.CENTER INSTITUTE FOR INNOVATION LAWIN2 CENTER OFFICE OFFICE OFFICE OFFICE OFFICE OFFICE DISCOVERY ASSESSMENT STRATEGY PLANNING & DESIGN PROTOTYPE & TESTING IMPLEMENTATION DISCOVERY
  • 29.
    proprietary and confidential UCHastings College of the Law Kane Hall Programming and Planning OPPORTUNITY AREAS COSTING-OUT ALTERNATIVES 29 PROGRAMS TO BE RELOCATED DINING COMMONS CAFETERIA ALUMNI RECEPTION CENTER CAREER SERVICES STUDENT SERVICES ALUMNI SERVICES FINANCIAL AID RECORDS OFFICE HEALTH CENTER 200 MCALLISTER - 2ND FLOOR 2ND FLOOR (MINUS CORE) = 26,717 SF MOVE CLINICS, CENTERS, AND JOURNALS = $129,000 RENOVATE FUTURE SPACE FOR EXISTING 2nd FLOOR DEPARTMENTS = $150 / SF ESTIMATED COST = $9.5 MM MOVE 2nd FLOOR DEPARTMENTS = $43,000 RENOVATE 1st AND 2nd FLOORS FOR CLINICS, CENTER, AND JOURNALS = $200 / SF 200 MCALLISTER - 6TH FLOOR 6TH FLOOR (MINUS CORE) = 28,892 SF RENOVATION COST ESTIMATE = $105/ SF ESTIMATED COST = $3 MM PROGRAMS TO BE RELOCATED LIBRARY BOOKS / STACKS DISCOVERY ASSESSMENT STRATEGY PLANNING & DESIGN PROTOTYPE & TESTING IMPLEMENTATION DISCOVERY
  • 30.
    proprietary and confidential UCHastings College of the Law Kane Hall Programming and Planning 30 OPPORTUNITY AREAS MCALLISTER 200 – 1ST FLOOR Opp. Opp. Opp. OFFICE OFFICE OFFICE FORMER BOOKSTORE BUSINESS CENTER CONF. LOBBY STUDENT INFO CENTER SCIENCE AND TECHNOLOGY LAW JOURNAL SLJTJOURNAL FORMER BOOKSTORE, STUDENT CENTER,AND BUSINESS CENTER Opp. OPPORTUNITY AREA DISCOVERY ASSESSMENT STRATEGY PLANNING & DESIGN PROTOTYPE & TESTING IMPLEMENTATION DISCOVERY
  • 31.
    proprietary and confidential UCHastings College of the Law Kane Hall Programming and Planning 31 OPPORTUNITY AREAS 200 MCALLISTER– 6TH FLOOR Opp. 6TH FLOOR OF LIBRARYOpp. OPPORTUNITY AREA DISCOVERY ASSESSMENT STRATEGY PLANNING & DESIGN PROTOTYPE & TESTING IMPLEMENTATION DISCOVERY
  • 32.
    proprietary and confidential UCHastings College of the Law Kane Hall Programming and Planning EXISTING CONDITIONS SPACE PROGRAM 32 UC HASTINGS - 200 MCALLISTER PROGRAMMING & PLANNING CLINICS, CENTERS, JOURNALS - ASSIGNABLE SPACE PROGRAM EXISTING OFFICE INTERACTIVE INSTRUCTION 100*MCALLISTER*3*3RD*FLOOR CIVIL JUSTICE CLINIC Building Floor Room Room Type O/C WrkStn SF Organization 100 McAllister 3 300 STAFF OFFICE OPEN 1 100 CIVIL JUSTICE 100 McAllister 3 303 STAFF OFFICE CLOSED 1 140 CIVIL JUSTICE 100 McAllister 3 304 STAFF OFFICE CLOSED 1 140 CIVIL JUSTICE 100 McAllister 3 307 STAFF OFFICE CLOSED 1 130 COMMUNITY E 100 McAllister 3 306 STAFF OFFICE CLOSED 1 175 INDIVIDUAL RE 100 McAllister 3 308 STAFF OFFICE CLOSED 1 190 INDIVIDUAL RE 100 McAllister 3 302 STAFF OFFICE CLOSED 1 130 MEDIATION CLI 100 McAllister 4 407 STAFF OFFICE CLOSED 1 230 MEDIATION CLI 100 McAllister 3 310 STAFF OFFICE CLOSED 1 115 MEDICAL LEGA 100 McAllister 3 305 STAFF OFFICE CLOSED 1 140 SOCIAL ENTER 100 McAllister 3 300B STUDENT OFFICE OPEN 12 736 CIVIL JUSTICE 100 McAllister 3 300D STUDENT OFFICE OPEN 6 184 MEDICAL LEGA Building Floor Room Room Type Open/Closed Capacity SF User 100 McAllister 3 300A RECEPTION OPEN 1 387 CIVIL JUSTICE 100 McAllister 3 311 CONFERENCE CLOSED 8 150 CIVIL JUSTICE 100 McAllister 3 309 CONFERENCE NA 6 115 CIVIL JUSTICE 100 McAllister 3 312 BREAK NA 150 CIVIL JUSTICE 100 McAllister 3 300C COPY/RESOURCE OPEN 281 CIVIL JUSTICE 100 McAllister 3 372 STORAGE NA 60 CIVIL JUSTICE Building Floor Room Room Type Open/Closed Capacity SF User 100 McAllister 3 301 SEMINAR NA 24 700 CIVIL JUSTICE 100 McAllister 3 325 SEMINAR Na 16 400 CIVIL JUSTICE TOTAL 28 4,653 EXPERIENTIAL PROGRAMS Building Floor Room Room Type O/C WrkStn SF Position 100 McAllister 3 350A STAFF OFFICE CLOSED 1 189 100 McAllister 3 350B STAFF OFFICE CLOSED 1 230 ASSOCIATE DE 100 McAllister 3 350C STAFF OFFICE CLOSED 1 132 TOTAL 3 551 100*MCALLISTER*3*4TH*FLOOR 6/4/14 UC HASTINGS - 200 MCALLISTER PROGRAMMING & PLANNING CLINICS, CENTERS, JOURNALS - ASSIGNABLE SPACE PROGRAM EXISTING OFFICE INTERACTIVE INSTRUCTION DRAFT*5/14/14 100*MCALLISTER*3*3RD*FLOOR CIVIL JUSTICE CLINIC Building Floor Room Room Type O/C WrkStn SF Organization Position 100 McAllister 3 300 STAFF OFFICE OPEN 1 100 CIVIL JUSTICE CLINIC (shared) RECEPTIONIST 100 McAllister 3 303 STAFF OFFICE CLOSED 1 140 CIVIL JUSTICE CLINIC (shared) OFFICE MANAGER 100 McAllister 3 304 STAFF OFFICE CLOSED 1 140 CIVIL JUSTICE CLINIC (shared) LAWYERING FELLOW 100 McAllister 3 307 STAFF OFFICE CLOSED 1 130 COMMUNITY ECONOMIC DEVELOPMENT; COMMUNITY GROUP ADVOCACY DIRECTOR 100 McAllister 3 306 STAFF OFFICE CLOSED 1 175 INDIVIDUAL REPRESENTATION CLINICAL PROFESSOR 100 McAllister 3 308 STAFF OFFICE CLOSED 1 190 INDIVIDUAL REPRESENTATION DIRECTOR 100 McAllister 3 302 STAFF OFFICE CLOSED 1 130 MEDIATION CLINIC CLINICAL PROFESSOR 100 McAllister 4 407 STAFF OFFICE CLOSED 1 230 MEDIATION CLINIC CLINICAL PROFESSOR 100 McAllister 3 310 STAFF OFFICE CLOSED 1 115 MEDICAL LEGAL PARTNERSHIP FOR SENIORS DIRECTOR 100 McAllister 3 305 STAFF OFFICE CLOSED 1 140 SOCIAL ENTERPRISE AND ECONOMIC EMPOWERMENT CLINICAL PROFESSOR 100 McAllister 3 300B STUDENT OFFICE OPEN 12 736 CIVIL JUSTICE CLINIC (shared) 100 McAllister 3 300D STUDENT OFFICE OPEN 6 184 MEDICAL LEGAL PARTNERSHIP FOR SENIORS Building Floor Room Room Type Open/Closed Capacity SF User 100 McAllister 3 300A RECEPTION OPEN 1 387 CIVIL JUSTICE CLINIC (shared) 100 McAllister 3 311 CONFERENCE CLOSED 8 150 CIVIL JUSTICE CLINIC (shared) 100 McAllister 3 309 CONFERENCE NA 6 115 CIVIL JUSTICE CLINIC (shared) 100 McAllister 3 312 BREAK NA 150 CIVIL JUSTICE CLINIC (shared) 100 McAllister 3 300C COPY/RESOURCE OPEN 281 CIVIL JUSTICE CLINIC (shared) 100 McAllister 3 372 STORAGE NA 60 CIVIL JUSTICE CLINIC (shared) Building Floor Room Room Type Open/Closed Capacity SF User 100 McAllister 3 301 SEMINAR NA 24 700 CIVIL JUSTICE CLINIC (shared) 100 McAllister 3 325 SEMINAR Na 16 400 CIVIL JUSTICE CLINIC (shared) TOTAL 28 4,653 EXPERIENTIAL PROGRAMS Building Floor Room Room Type O/C WrkStn SF Position 100 McAllister 3 350A STAFF OFFICE CLOSED 1 189 100 McAllister 3 350B STAFF OFFICE CLOSED 1 230 ASSOCIATE DEAN FOR EXPERIENTIAL PROGRAMS 100 McAllister 3 350C STAFF OFFICE CLOSED 1 132 TOTAL 3 551 100*MCALLISTER*3*4TH*FLOOR CENTER FOR GENDER & REFUGEE STUDIES Building Floor Room Room Type O/C WrkStn SF Position 100 McAllister 4 403 STAFF OFFICE CLOSED 1 330 DIRECTOR 100 McAllister 4 409A STAFF OFFICE CLOSED 1 150 ASSOCIATE DIRECTOR / STAFF ATTORNEY 100 McAllister 4 409B STAFF OFFICE CLOSED 1 92 STAFF ATTORNEY 100 McAllister 4 411 STAFF OFFICE CLOSED 2 350 100 McAllister 4 411A STAFF OFFICE CLOSED 1 110 100 McAllister 4 411B STAFF OFFICE CLOSED 1 110 100 McAllister 4 411C STAFF OFFICE CLOSED 1 100 100 McAllister 4 411D STAFF OFFICE CLOSED 2 100 TOTAL 10 1,342 REFUGEE & HUMAN RIGHTS CLINIC Building Floor Room Room Type O/C WrkStn SF Position 100 McAllister 4 405 STAFF OFFICE CLOSED 4 350 100 McAllister 4 406A STAFF OFFICE CLOSED 2 360 100 McAllister 4 406B STAFF OFFICE CLOSED 1 171 TOTAL 7 881 CENTER FOR NEGOTIATION & DISPUTE RESOLUTION Building Floor Room Room Type O/C WrkStn SF Position 100 McAllister 4 408A STAFF OFFICE CLOSED 1 300 DIRECTOR 100 McAllister 4 408C STAFF OFFICE OPEN 1 292 ACADEMIC PROGRAM COORDINATOR 100 McAllister 4 408D STAFF OFFICE CLOSED 1 156 VACANT TOTAL 3 748 CENTER FOR WORKLIFE LAW Building Floor Room Room Type O/C WrkStn SF Position 100 McAllister 4 401 STAFF OFFICE OPEN 2 350 MANAGING DIRECTOR; DEVELOPMENT ASSOCIATE 100 McAllister 4 402 STAFF OFFICE OPEN 2 575 ASSOCIATE DIRECTOR; PROGRAM ASSOCIATE 100 McAllister 4 423 FACULTY OFFICE CLOSED 1 310 DIRECTOR TOTAL 5 1,235 SHARED ON FLOOR Building Floor Room Room Type Open/Closed Capacity SF User 100 McAllister 4 413 BREAK NA 250 SHARED 100 McAllister 4 412 CONFERENCE NA 8 220 SHARED Building Floor Room Room Type Open/Closed Capacity SF User 100 McAllister 4 410 SEMINAR NA 10 230 SHARED 100 McAllister 4 404 SEMINAR NA 20 400 SHARED TOTAL 1,100 100*MCALLISTER*3*JOURNALS OFFICE OF SCHOLARLY PUBLICATIONS Building Floor Room Room Type O/C WrkStn SF Organization Position 100 McAllister 22 2204 STAFF OFFICE CLOSED 1 158 OFFICE OF SCHOLARLY PUBLICATIONS DIRECTOR 100 McAllister 22 2205 STUDENT OFFICE OPEN 7 453 COMMUNICATIONS & ENTERTAINMENT 100 McAllister 22 2208 STUDENT OFFICE CLOSED 1 123 COMMUNICATIONS & ENTERTAINMENT 100 McAllister 22 2203 STUDENT OFFICE OPEN 4 230 RACE AND POVERTY 200 McAllister 1 109A STUDENT OFFICE OPEN 1 320 SCIENCE & TECHNOLOGY 100 McAllister 22 2201 STUDENT OFFICE OPEN 6 385 WEST-NORTHWEST JOURNAL OF ENVIRONMENTAL 100 McAllister 22 2209 STUDENT OFFICE CLOSED 1 121 WEST-NORTHWEST JOURNAL OF ENVIRONMENTAL 100 McAllister 22 2207 STUDENT OFFICE OPEN 5 300 WOMEN'S LAW JOURNAL 100 McAllister 22 2207A STUDENT OFFICE CLOSED 1 95 WOMEN'S LAW JOURNAL 100 McAllister 23 2303 STUDENT OFFICE CLOSED 2 129 BUSINESS LAW JOURNAL 100 McAllister 23 2304 STUDENT OFFICE CLOSED 2 175 BUSINESS LAW JOURNAL 100 McAllister 23 2302 STUDENT OFFICE CLOSED 5 197 CONSTITUTIONAL LAW QUARTERLY 100 McAllister 23 2302A STUDENT OFFICE CLOSED 5 95 CONSTITUTIONAL LAW QUARTERLY 100 McAllister 23 2301 STUDENT OFFICE CLOSED 9 813 HASTINGS LAW JOURNAL 100 McAllister 23 2308 STUDENT OFFICE CLOSED 1 107 HASTINGS LAW JOURNAL 100 McAllister 23 2305 STUDENT OFFICE CLOSED 6 437 INTERNATIONAL & COMPARATIVE LAW REVIEW 100 McAllister 23 2306 STUDENT OFFICE CLOSED 1 123 INTERNATIONAL & COMPARATIVE LAW REVIEW Building Floor Room Room Type Open/Closed Capacity SF Organization 100 McAllister 22 2202 BREAK/RESOURCE NA 96 LAW JOURNALS 100 McAllister 11 STORAGE NA 400 LAW JOURNALS 100 McAllister 12 STORAGE NA 300 LAW JOURNALS 100 McAllister 13 STORAGE NA 400 LAW JOURNALS TOTAL 58 5,457 DETAIL EXISTING SPACE PROGRAM DISCOVERY ASSESSMENT STRATEGY PLANNING & DESIGN PROTOTYPE & TESTING IMPLEMENTATION DISCOVERY
  • 33.
  • 34.
    proprietary and confidential UCHastings College of the Law Kane Hall Programming and Planning ANALYZING EXISTING CONDITIONS ORGANIZATIONAL TYPOLOGIES – UNCOVERING INEFFICIENCIES 34 RESOURCES OFFICES/ WORKSTATIONS OFFICES/ WORKSTATIONS OFFICES/ WORKSTATIONS RESOURCES RESOURCES SCATTERED OFFICES/ WORKSTATIONS RESOURCES OFFICES/ WORKSTATIONS RESOURCES OFFICES/ WORKSTATIONS RESOURCES INDEPENDENT SHARED RESOURCES OFFICES/ WORKSTATIONS OFFICES/ WORKSTATIONS OFFICES/ WORKSTATIONS CO-LOCATED OFFICES/ WORKSTATIONS OFFICES/ WORKSTATIONS RESOURCES RESOURCES OFFICES/ WORKSTATIONS RESOURCES CLUSTER ASSESSMENT STRATEGY PLANNING & DESIGN PROTOTYPE & TESTING IMPLEMENTATION ASSESSMENT
  • 35.
    proprietary and confidential UCHastings College of the Law Kane Hall Programming and Planning ANALYZING EXISTING CONDITIONS CONCEPTUAL ORGANIZATION MODEL – 100 MCALLISTER 35 MCALLISTER 100 RESOURCES RESOURCES SHARED RESOURCES OFFICES/ WORKSTATIONS OFFICES/ WORKSTATIONS OFFICES/ WORKSTATIONS OFFICES/ WORKSTATIONS OFFICES/ WORKSTATIONS CGAMLPS IR SEEE CED CNDRCGRS & RHRC WLL OFFICES/ WORKSTATIONS OFFICES/ WORKSTATIONS OFFICES/ WORKSTATIONS RESOURCES RESOURCESRESOURCES RESOURCES RESOURCES OFFICES/ WORKSTATIONS RESOURCES OFFICES/ WORKSTATIONS RESOURCES OFFICES/ WORKSTATIONS RESOURCES OFFICES/ WORKSTATIONS RESOURCES OFFICES/ WORKSTATIONS RESOURCES OFFICES/ WORKSTATIONS OFFICES/ WORKSTATIONS RESOURCES OFFICES/ WORKSTATIONS RESOURCES OFFICES/ WORKSTATIONS RESOURCES CLQ PUBLISHING COMM/ENT HBLJ HICLR HLJ HRPLJ HWLJ WNW ASSESSMENT STRATEGY PLANNING & DESIGN PROTOTYPE & TESTING IMPLEMENTATION ASSESSMENT
  • 36.
    proprietary and confidential UCHastings College of the Law Kane Hall Programming and Planning CONCEPTUAL ORGANIZATION MODEL – 198 MCALLISTER 36 ANALYZING EXISTING CONDITIONS MCALLISTER 198 RESOURCES OFFICES/ WORKSTATIONS RESOURCES CLSGL ASSESSMENT STRATEGY PLANNING & DESIGN PROTOTYPE & TESTING IMPLEMENTATION ASSESSMENT
  • 37.
    proprietary and confidential UCHastings College of the Law Kane Hall Programming and Planning CONCEPTUAL ORGANIZATION MODEL – 200 MCALLISTER 37 MCALLISTER 200 ANALYZING EXISTING CONDITIONS OFFICES/ WORKSTATIONS RESOURCES IN2 OFFICES/ WORKSTATIONS RESOURCES STLJ RESOURCES OFFICES/ WORKSTATIONS OFFICES/ WORKSTATIONS OFFICES/ WORKSTATIONS RESOURCES RESOURCES CONS. RESOURCES RESOURCES RESOURCES ASSESSMENT STRATEGY PLANNING & DESIGN PROTOTYPE & TESTING IMPLEMENTATION ASSESSMENT
  • 38.
    proprietary and confidential UCHastings College of the Law Kane Hall Programming and Planning SURVEY WORKBOOK 38 SURVEY WORKBOOK ANALYZING EXISTING CONDITIONS ASSESSMENT STRATEGY PLANNING & DESIGN PROTOTYPE & TESTING IMPLEMENTATION ASSESSMENT
  • 39.
    proprietary and confidential UCHastings College of the Law Kane Hall Programming and Planning 39 SURVEY WORKBOOK INTROVERT OR EXTROVERT INTROVERT EXTROVERTDO YOU CONSIDER YOURSELF AN... ASSESSMENT STRATEGY PLANNING & DESIGN PROTOTYPE & TESTING IMPLEMENTATION ASSESSMENT
  • 40.
    proprietary and confidential UCHastings College of the Law Kane Hall Programming and Planning 40 TASK LAMP 21% 79%OVERHEAD LIGHT IF THE LIGHTS WERE OFF, WOULD YOU TURN ON THE OVERHEAD LIGHTS OR YOUR TASK LAMP IN ORDER TO WORK? SURVEY WORKBOOK LIGHTING PREFERENCES ASSESSMENT STRATEGY PLANNING & DESIGN PROTOTYPE & TESTING IMPLEMENTATION ASSESSMENT
  • 41.
    proprietary and confidential UCHastings College of the Law Kane Hall Programming and Planning 41 HOW OFTEN DO YOU MEET WITH CLIENTS... 50% 7% 7% 14%22% in your office 43% 18% 14%25% in a conference room 50% 11% 11% 3%25% off-site MORE THAN ONCE A DAY ONCE A DAY 2-3 TIMES A WEEK ONCE A WEEK LESS THAN ONCE A WEEK NEVER SURVEY WORKBOOK CLIENT MEETINGS ASSESSMENT STRATEGY PLANNING & DESIGN PROTOTYPE & TESTING IMPLEMENTATION ASSESSMENT
  • 42.
    proprietary and confidential UCHastings College of the Law Kane Hall Programming and Planning 42 SURVEY WORKBOOK TOP-5 ACTIVITIES 0% TOGETHERALONE 100% EATING MEALS 0% CONDUCTING OUTREACH 13% 7% MEETING WITH CLIENTS OFF-SITE 17% MEETING WITH CLIENTS ON-SITE 20% PLANNING EVENTS 57% COLLABORATING WITH A TEAM ATTENDING A TEAM MEETING 50% WORKING WITH STUDENTS 47% WORKING WITH FACULTY MEMBERS 43% 13% PREPARING CASE WORK 20% OTHER 10% TRAVELING PLACE TO PLACE 40% DEVELOPING A LESSON PLAN 43% MAKING PHONE CALLS 47% RESEARCHING WRITING 63% ASSESSMENT STRATEGY PLANNING & DESIGN PROTOTYPE & TESTING IMPLEMENTATION ASSESSMENT
  • 43.
    proprietary and confidential UCHastings College of the Law Kane Hall Programming and Planning 43 SURVEY WORKBOOK TOP-5 PLACES CONFERENCE ROOM 47% SEMINAR ROOM 43% COPY ROOM 37%BREAK ROOM 10% LIBRARY 13% WORKROOM 7% CAFÉ 7% KITCHEN 7% STUDY ROOM 0% READING ROOM 0% LOUNGE 3% CAFETERIA 3% OFF-SITE 43% 100% MY OFFICE 50% AN OFFICE THAT IS NOT MY OWN 27% OTHER 0% SHAREDPRIVATE 100% ASSESSMENT STRATEGY PLANNING & DESIGN PROTOTYPE & TESTING IMPLEMENTATION ASSESSMENT
  • 44.
  • 45.
    proprietary and confidential UCHastings College of the Law Kane Hall Programming and Planning 45 CLASSROOM/ SEMINAR CLASSROOM/ SEMINAR CLASSROOM/ SEMINAR CLASSROOM/ SEMINAR CLASSROOM/ SEMINAR CLASSROOM/ SEMINAR CED OFFICE/ WORKSTATIONS CGA OFFICE/ WORKSTATIONS SEEE OFFICE/ WORKSTATIONS IR OFFICE/ WORKSTATIONS SMALL MEETING (2-6) NEW CLINIC OFFICE/ WORKSTATIONS STUDENT WORKSTATIONS RECEPTION/ LOBBY JOURNAL OFFICE JOURNAL OFFICE JOURNAL OFFICE JOURNAL OFFICE JOURNAL OFFICE JOURNAL OFFICE JOURNAL OFFICE JOURNAL OFFICE JOURNAL OFFICE PUBLISHING OFFICE MEETING OFFICES/ WORKSTATIONS RESOURCE W LL RECEPTION IN 2 MEETING OFFICES/ WORKSTATIONS RESOURCE RECEPTION C O NS. MEETING OFFICES/ WORKSTATIONS RESOURCE RECEPTION FU TURE MEETING OFFICES/ WORKSTATIONS RESOURCE RECEPTION C SLGL MEETING OFFICES/ WORKSTATIONS RESOURCE RECEPTION C GRS MEETING OFFICES/ WORKSTATIONS RESOURCE RECEPTION CND R / ME. MEETING OFFICES/ WORKSTATIONS RESOURCE RECEPTION SMALL MEETING (2-6) BREAKOUT BREAKOUT BREAKOUT BREAKOUTBREAKOUT BREAKOUT COPY ROOM/ STORAGE LOUNGE BREAK/ KITCHEN MEDIUM MEETING ROOM / BREAK-OUT (6-12) COPY ROOM/ STORAGE RESOURCE LIBRARY LOUNGE BREAK/ KITCHEN SMALL MEETING (2-6) SMALL MEETING (2-6) MEDIUM MEETING ROOM / BREAK-OUT (6-12) CLINICSCENTERS JOURNALS GENERAL FACULTY MLPS OFFICE/ WORKSTATIONS RHRC OFFICE/ WORKSTATIONS FUTURE SCENARIOS CONCEPTUAL ORGANIZATION MODEL – ALL PROGRAMS STRATEGY PLANNING & DESIGN PROTOTYPE & TESTING IMPLEMENTATION STRATEGY
  • 46.
    proprietary and confidential UCHastings College of the Law Kane Hall Programming and Planning CONCEPTUAL ORGANIZATION MODEL – CENTERS 46 MEETING OFFICES/ WORKSTATIONS RESOURCE W LL RECEPTION IN 2 MEETING OFFICES/ WORKSTATIONS RESOURCE RECEPTION C O NS. MEETING OFFICES/ WORKSTATIONS RESOURCE RECEPTION FU TURE MEETING OFFICES/ WORKSTATIONS RESOURCE RECEPTION C SLGL MEETING OFFICES/ WORKSTATIONS RESOURCE RECEPTION C GRS MEETING OFFICES/ WORKSTATIONS RESOURCE RECEPTION CND R / ME. MEETING OFFICES/ WORKSTATIONS RESOURCE RECEPTION CENTERS CLASSROOM/ SEMINAR CLASSROOM/ SEMINAR CLASSROOM/ SEMINAR CLASSROOM/ SEMINAR CED OFFICE/ WORKSTATIONS CGA OFFICE/ WORKSTATIONS SEEE OFFICE/ WORKSTATIONS IR OFFICE/ WORKSTATIONS SMALL MEETING (2-6) NEW CLINIC OFFICE/ WORKSTATIONS STUDENT WORKSTATIONS RECEPTION/ LOBBY MEETING OFFICES/ WORKSTATIONS RESOURCE W LL RECEPTION IN 2 MEETING OFFICES/ WORKSTATIONS RESOURCE RECEPTION C O NS. MEETING OFFICES/ WORKSTATIONS RESOURCE RECEPTION FU TURE MEETING OFFICES/ WORKSTATIONS RESOURCE RECEPTION C SLGL MEETING OFFICES/ WORKSTATIONS RESOURCE RECEPTION C GRS MEETING OFFICES/ WORKSTATIONS RESOURCE RECEPTION CND R / ME. MEETING OFFICES/ WORKSTATIONS RESOURCE RECEPTION SMALL MEETING (2-6) BREAKOUTBREAKOUT MEDIUM MEETING ROOM / BREAK-OUT (6-12) COPY ROOM/ STORAGE RESOURCE LIBRARY LOUNGE BREAK/ KITCHEN SMALL MEETING (2-6) SMALL MEETING (2-6) MEDIUM MEETING ROOM / BREAK-OUT (6-12) CLINICSCENTERS MLPS OFFICE/ WORKSTATIONS RHRC OFFICE/ WORKSTATIONS FUTURE SCENARIOS STRATEGY PLANNING & DESIGN PROTOTYPE & TESTING IMPLEMENTATION STRATEGY
  • 47.
    proprietary and confidential UCHastings College of the Law Kane Hall Programming and Planning CONCEPTUAL ORGANIZATION MODEL – CLINICS 47 CLASSROOM/ SEMINAR CLASSROOM/ SEMINAR CED OFFICE/ WORKSTATIONS CGA OFFICE/ WORKSTATIONS SEEE OFFICE/ WORKSTATIONS IR OFFICE/ WORKSTATIONS SMALL MEETING (2-6) NEW CLINIC OFFICE/ WORKSTATIONS STUDENT WORKSTATIONS RECEPTION/ LOBBY SMALL MEETING (2-6) MEDIUM MEETING ROOM / BREAK-OUT (6-12) COPY ROOM/ STORAGE RESOURCE LIBRARY SMALL MEETING (2-6) SMALL MEETING (2-6) MEDIUM MEETING ROOM / BREAK-OUT (6-12) CLINICS MLPS OFFICE/ WORKSTATIONS RHRC OFFICE/ WORKSTATIONS CLASSROOM/ SEMINAR CLASSROOM/ SEMINAR CLASSROOM/ SEMINAR CLASSROOM/ SEMINAR CLASSROOM/ SEMINAR CLASSROOM/ SEMINAR CED OFFICE/ WORKSTATIONS CGA OFFICE/ WORKSTATIONS SEEE OFFICE/ WORKSTATIONS IR OFFICE/ WORKSTATIONS SMALL MEETING (2-6) NEW CLINIC OFFICE/ WORKSTATIONS STUDENT WORKSTATIONS RECEPTION/ LOBBY MEETING RECEPTION MEETING RECEPTION MEETING RECEPTION MEETING RECEPTION SMALL MEETING (2-6) BREAKOUT BREAKOUT BREAKOUT BREAKOUTBREAKOUT BREAKOUT MEDIUM MEETING ROOM / BREAK-OUT (6-12) COPY ROOM/ STORAGE RESOURCE LIBRARY LOUNGE BREAK/ KITCHEN SMALL MEETING (2-6) SMALL MEETING (2-6) MEDIUM MEETING ROOM / BREAK-OUT (6-12) CLINICS JOURN GENERAL FACULTY MLPS OFFICE/ WORKSTATIONS RHRC OFFICE/ WORKSTATIONS FUTURE SCENARIOS STRATEGY PLANNING & DESIGN PROTOTYPE & TESTING IMPLEMENTATION STRATEGY
  • 48.
    proprietary and confidential UCHastings College of the Law Kane Hall Programming and Planning 48 JOURNAL OFFICE JOURNAL OFFICE JOURNAL OFFICE JOURNAL OFFICE JOURNAL OFFICE JOURNAL OFFICE JOURNAL OFFICE JOURNAL OFFICE JOURNAL OFFICE PUBLISHING OFFICE COPY ROOM/ STORAGE LOUNGE BREAK/ KITCHEN JOURNALS CONCEPTUAL ORGANIZATION MODEL – JOURNALS CLASSROOM/ SEMINAR CLASSROOM/ SEMINAR CLASSROOM/ SEMINAR JOURNAL OFFICE JOURNAL OFFICE JOURNAL OFFICE JOURNAL OFFICE JOURNAL OFFICE JOURNAL OFFICE JOURNAL OFFICE JOURNAL OFFICE JOURNAL OFFICE PUBLISHING OFFICE SMALL MEETING (2-6) BREAKOUT BREAKOUT BREAKOUT BREAKOUT COPY ROOM/ STORAGE LOUNGE BREAK/ KITCHEN MEDIUM MEETING ROOM / BREAK-OUT (6-12) COPY ROOM/ STORAGE JOURNALS FUTURE SCENARIOS STRATEGY PLANNING & DESIGN PROTOTYPE & TESTING IMPLEMENTATION STRATEGY
  • 49.
    proprietary and confidential UCHastings College of the Law Kane Hall Programming and Planning 49 CLASSROOM/ SEMINAR CLASSROOM/ SEMINAR CLASSROOM/ SEMINAR CLASSROOM/ SEMINAR CLASSROOM/ SEMINAR CLASSROOM/ SEMINAR CED OFFICE/ WORKSTATIONS CGA OFFICE/ WORKSTATIONS SEEE OFFICE/ WORKSTATIONS IR OFFICE/ WORKSTATIONS SMALL MEETING (2-6) NEW CLINIC OFFICE/ WORKSTATIONS STUDENT WORKSTATIONS RECEPTION/ LOBBY JOURNAL OFFICE JOURNAL OFFICE JOURNAL OFFICE JOURNAL OFFICE JOURNAL OFFICE JOURNAL OFFICE JOURNAL OFFICE JOURNAL OFFICE JOURNAL OFFICE PUBLISHING OFFICE MEETING OFFICES/ WORKSTATIONS RESOURCE W LL RECEPTION IN 2 MEETING OFFICES/ WORKSTATIONS RESOURCE RECEPTION C O NS. MEETING OFFICES/ WORKSTATIONS RESOURCE RECEPTION FU TURE MEETING OFFICES/ WORKSTATIONS RESOURCE RECEPTION C SLGL MEETING OFFICES/ WORKSTATIONS RESOURCE RECEPTION C GRS MEETING OFFICES/ WORKSTATIONS RESOURCE RECEPTION CND R / ME. MEETING OFFICES/ WORKSTATIONS RESOURCE RECEPTION SMALL MEETING (2-6) BREAKOUT BREAKOUT BREAKOUT BREAKOUTBREAKOUT BREAKOUT COPY ROOM/ STORAGE LOUNGE BREAK/ KITCHEN MEDIUM MEETING ROOM / BREAK-OUT (6-12) COPY ROOM/ STORAGE RESOURCE LIBRARY LOUNGE BREAK/ KITCHEN SMALL MEETING (2-6) SMALL MEETING (2-6) MEDIUM MEETING ROOM / BREAK-OUT (6-12) CLINICSCENTERS JOURNALS GENERAL FACULTY MLPS OFFICE/ WORKSTATIONS RHRC OFFICE/ WORKSTATIONS FUTURE SCENARIOS CONCEPTUAL ORGANIZATION MODEL – ALL PROGRAMS STRATEGY PLANNING & DESIGN PROTOTYPE & TESTING IMPLEMENTATION STRATEGY
  • 50.
  • 51.
    proprietary and confidential UCHastings College of the Law Kane Hall Programming and Planning PROJECTED TOWER REVENUE 51 Total of 17,410 rentable square feet available • Additional housing is achieved on the 22nd and 23rd floors addressing an important student need and generating additional revenue • 3rd and 4th floors converted to office rentals, generating additional revenue Revenue Estimate • Low estimate for additional revenue from rent $552,000 • High estimate for additional revenue from rent $610,000
  • 52.
    proprietary and confidential UCHastings College of the Law Kane Hall Programming and Planning NEXT STEPS 52 • Upcoming Summer meetings with 200 Programming and Planning Committee: • Wednesday July 9 / 1pm - 2pm / CJC Seminar Room • Wednesday July 23 / 1pm - 2pm / CJC Seminar Room • Meeting with the Library in order to begin plan for the consolidation of the 4th and 5th floors We welcome your input or concerns. For additional questions about the 200 Programming and Planning process please contact Evelyn Lee at lee@mkthink.com
