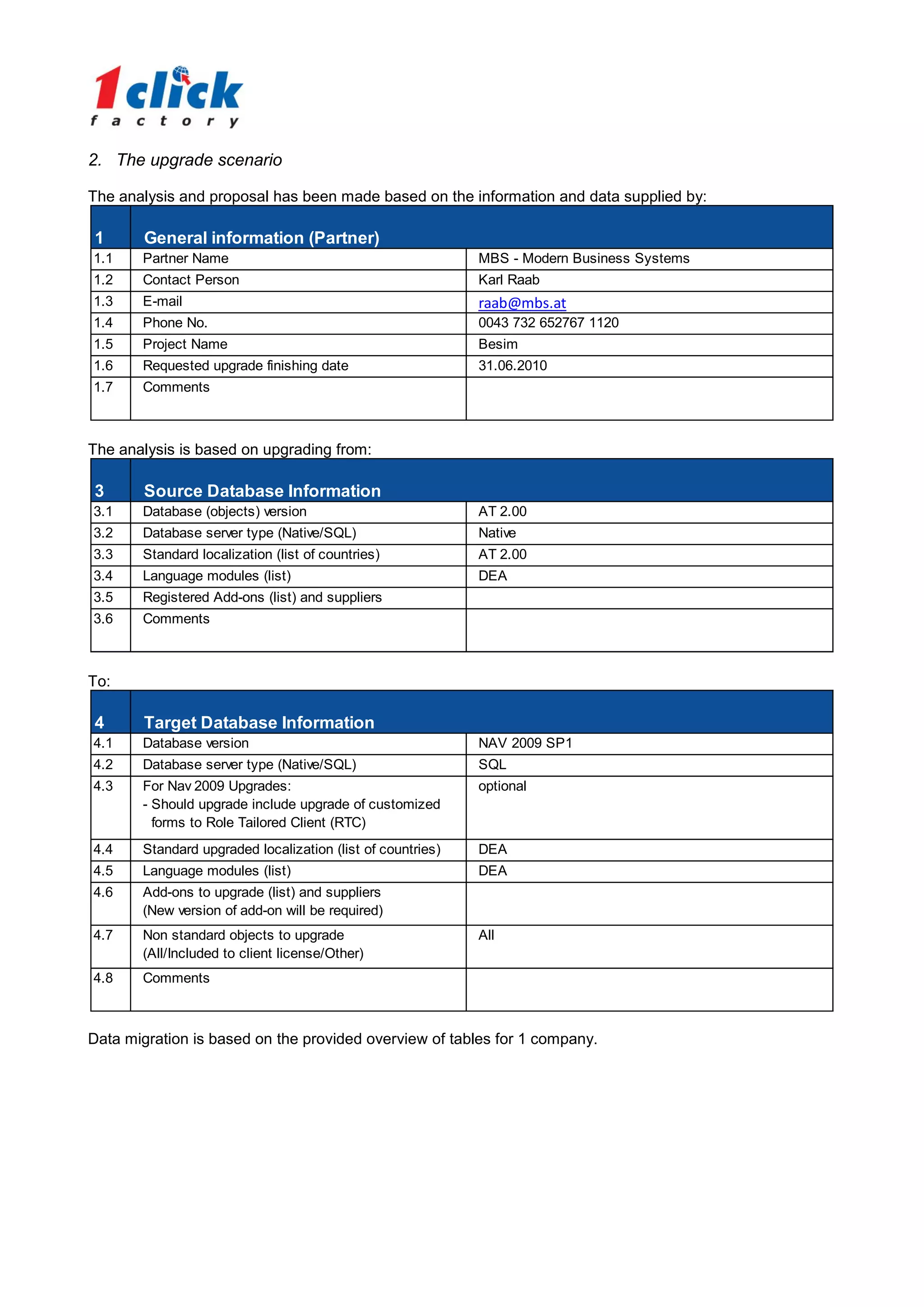

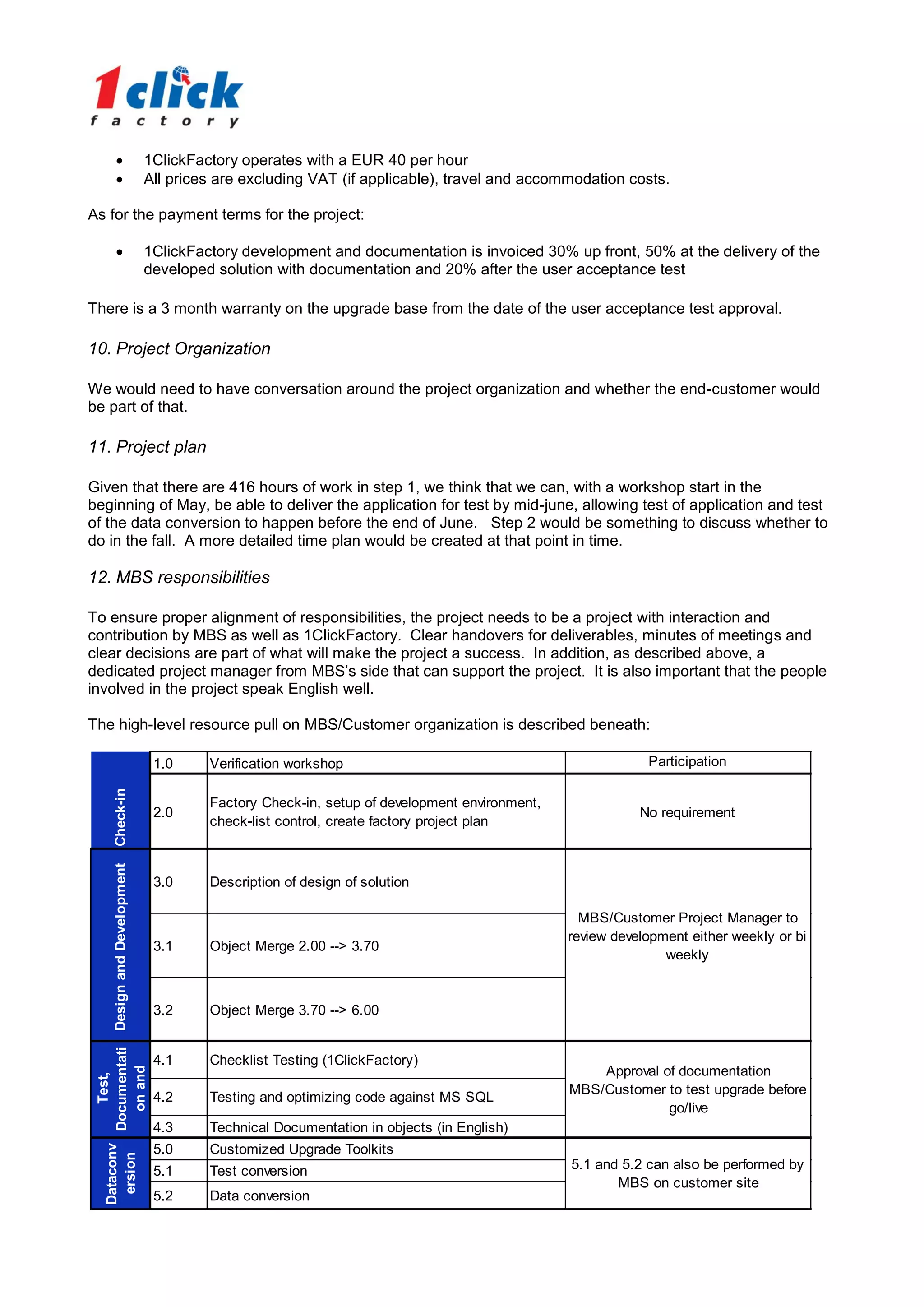

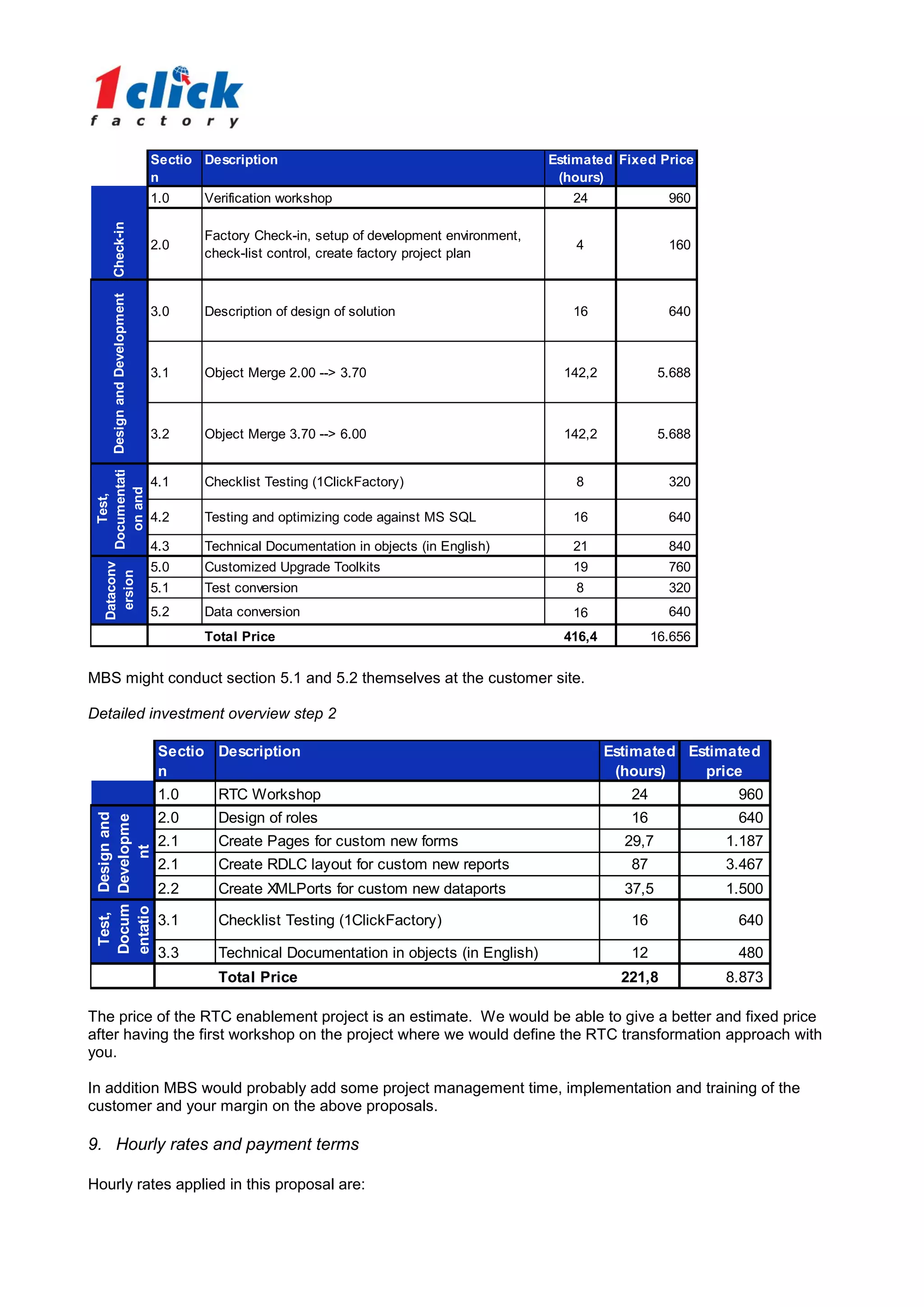

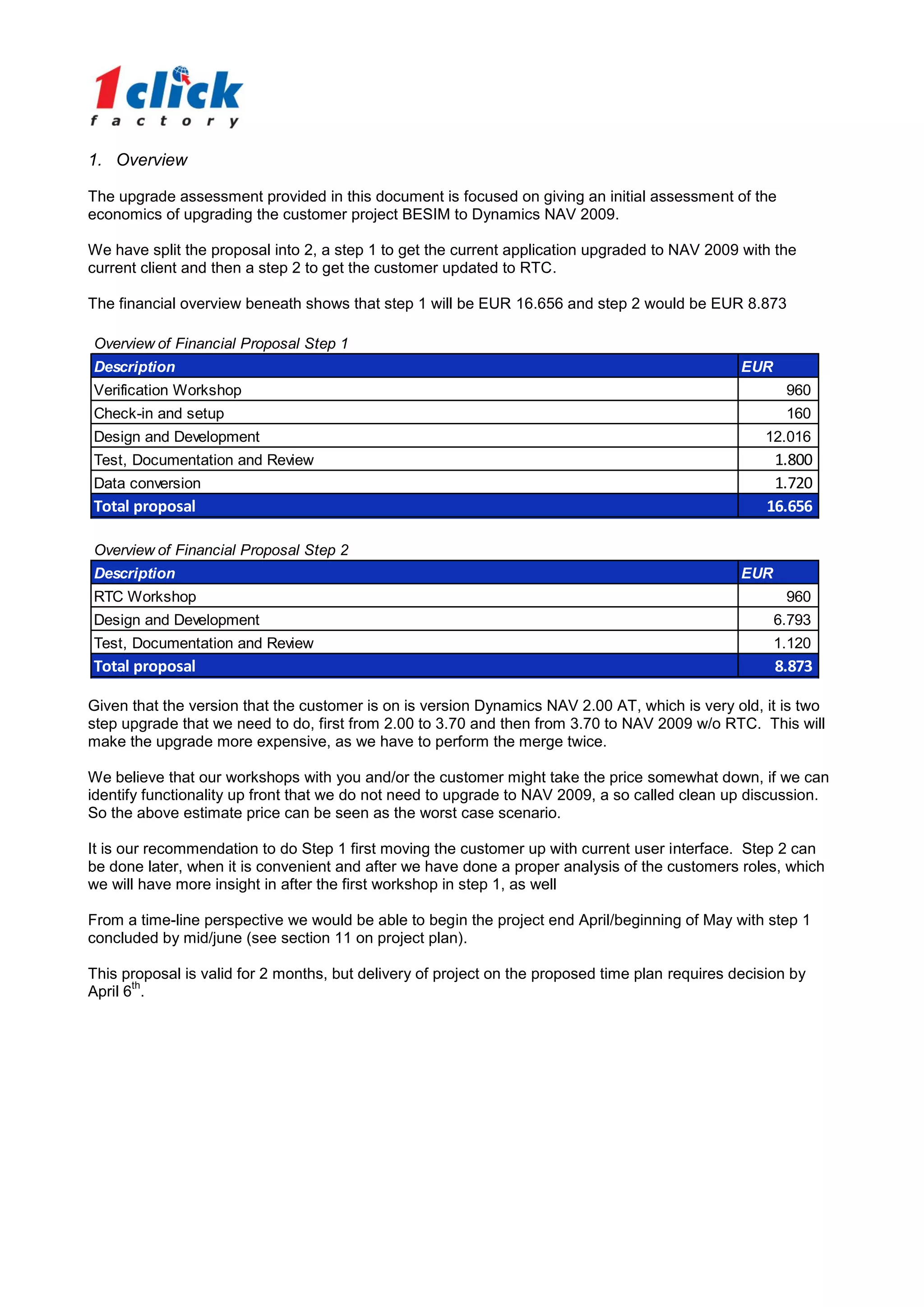

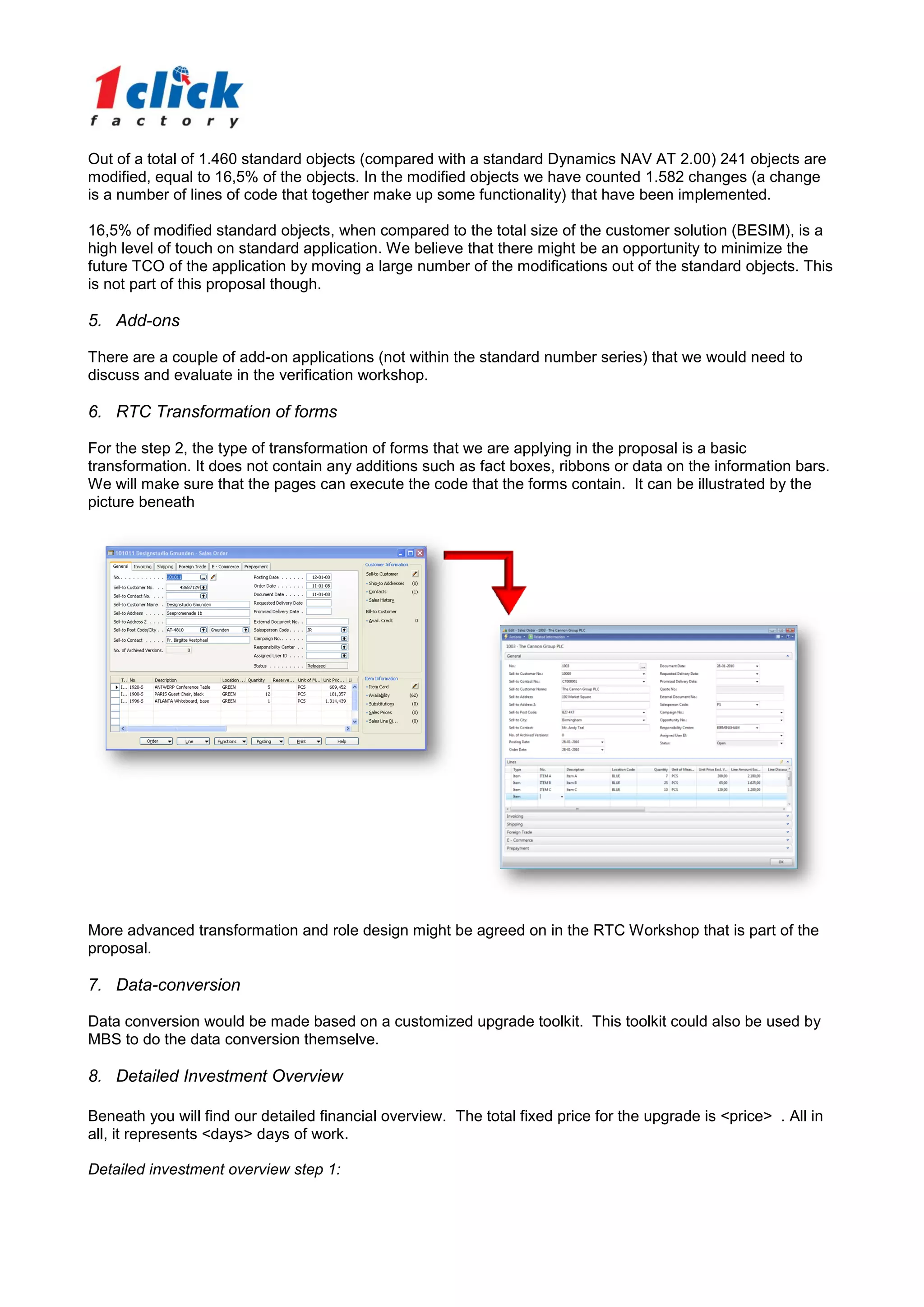

This document provides a proposal for upgrading a customer project called BESIM from Dynamics NAV version 2.00 to 2009. It is recommended to do the upgrade in two steps - first to get the current application upgraded to 2009 with the current client interface, and a second step later to upgrade the interface to the Role Tailored Client. The total estimated price for step 1 is EUR 16,656 and step 2 is EUR 8,873. The proposal outlines the methodology, objects to be upgraded, add-ons, data conversion, payment terms, project plan and responsibilities of the different parties.
