This document is a construction contract between Al Noor Consultants and Zulifiqar Ahmed Architectural and Engineering Private Limited for the construction of a residential development project in Lahore, Pakistan. Key details include:
- The contractor will complete construction of 150 plots of land with houses, a mosque, school, park and infrastructure over 4 years.

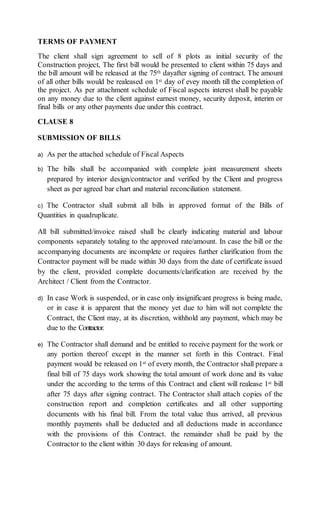

- As a security, the client will sign over ownership of 8 plots to the contractor initially valued at Rs. 1200 per square foot for structures and Rs. 1000 per square foot for finishes.

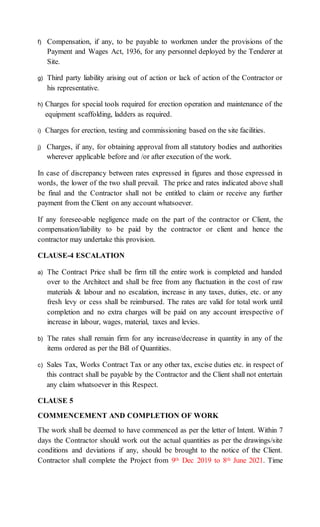

- The contractor must complete the project by June 2021. Liquidated damages of 0.5% per day will be charged for delays beyond this date, up to
