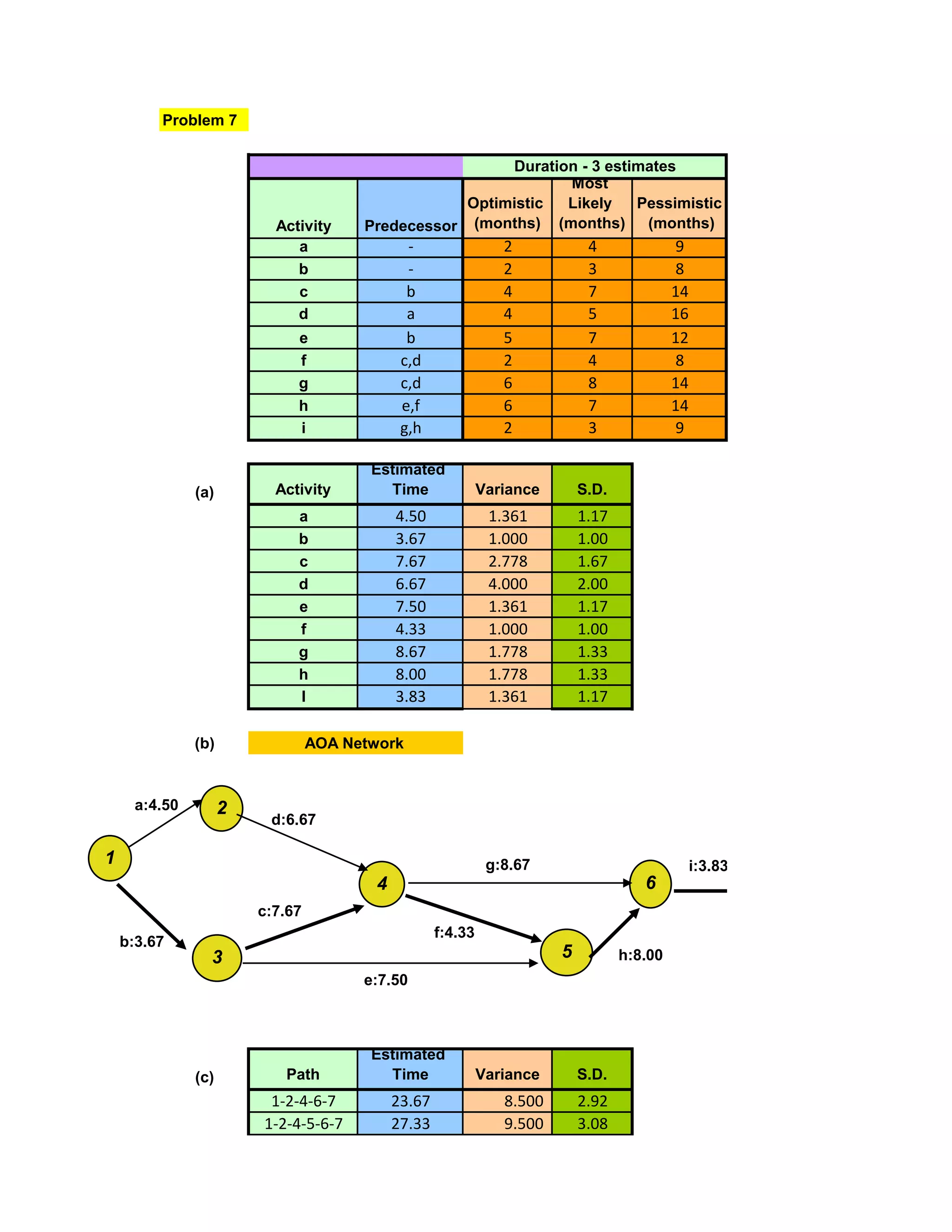

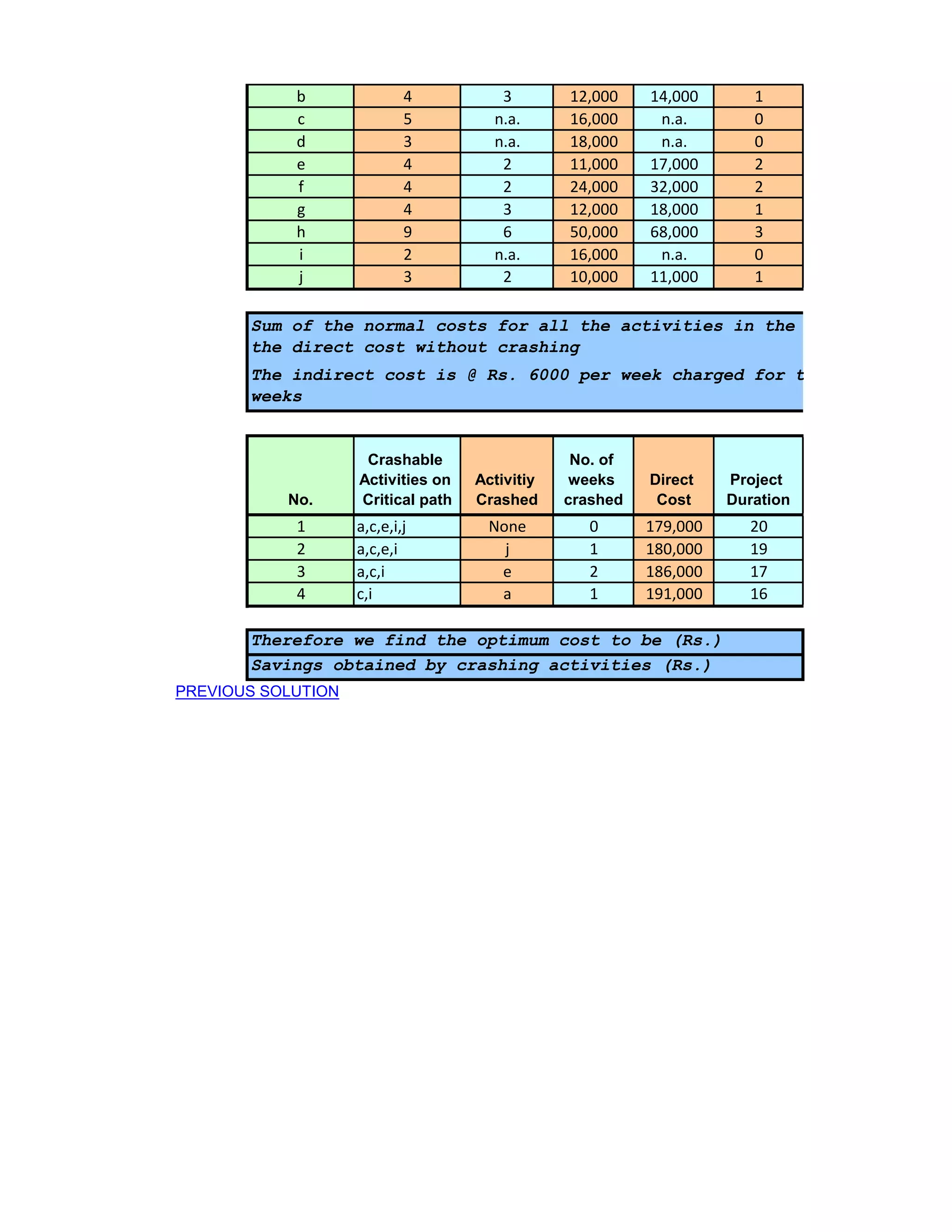

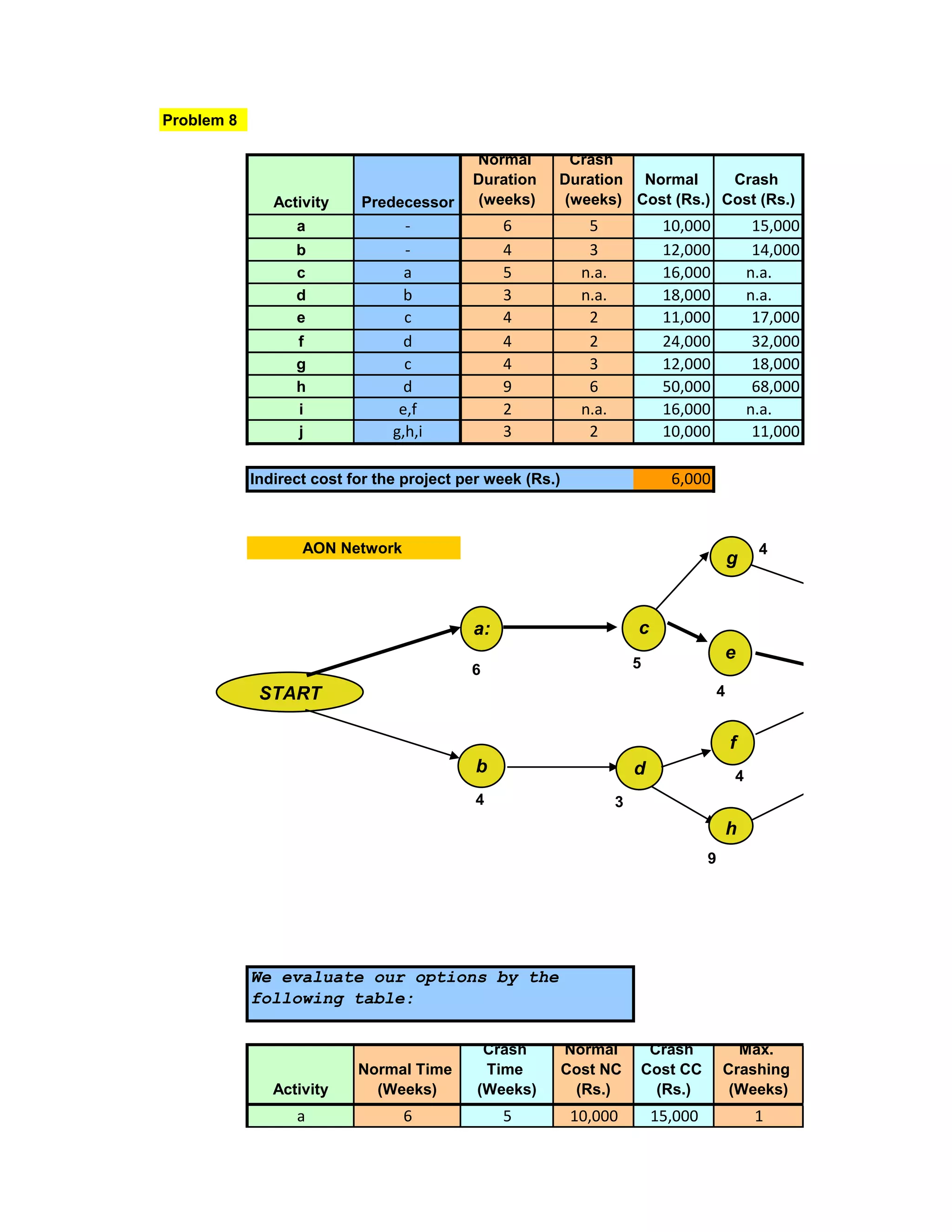

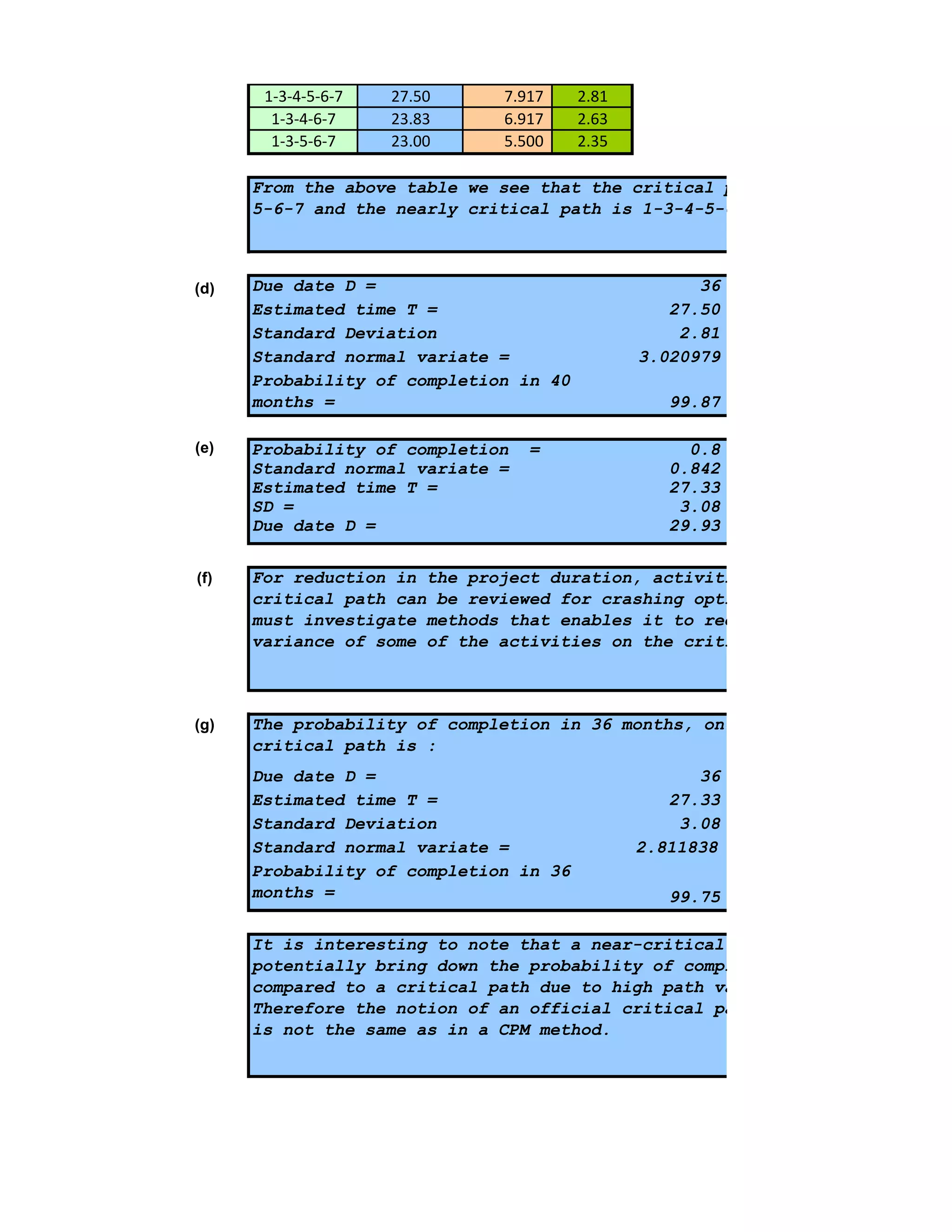

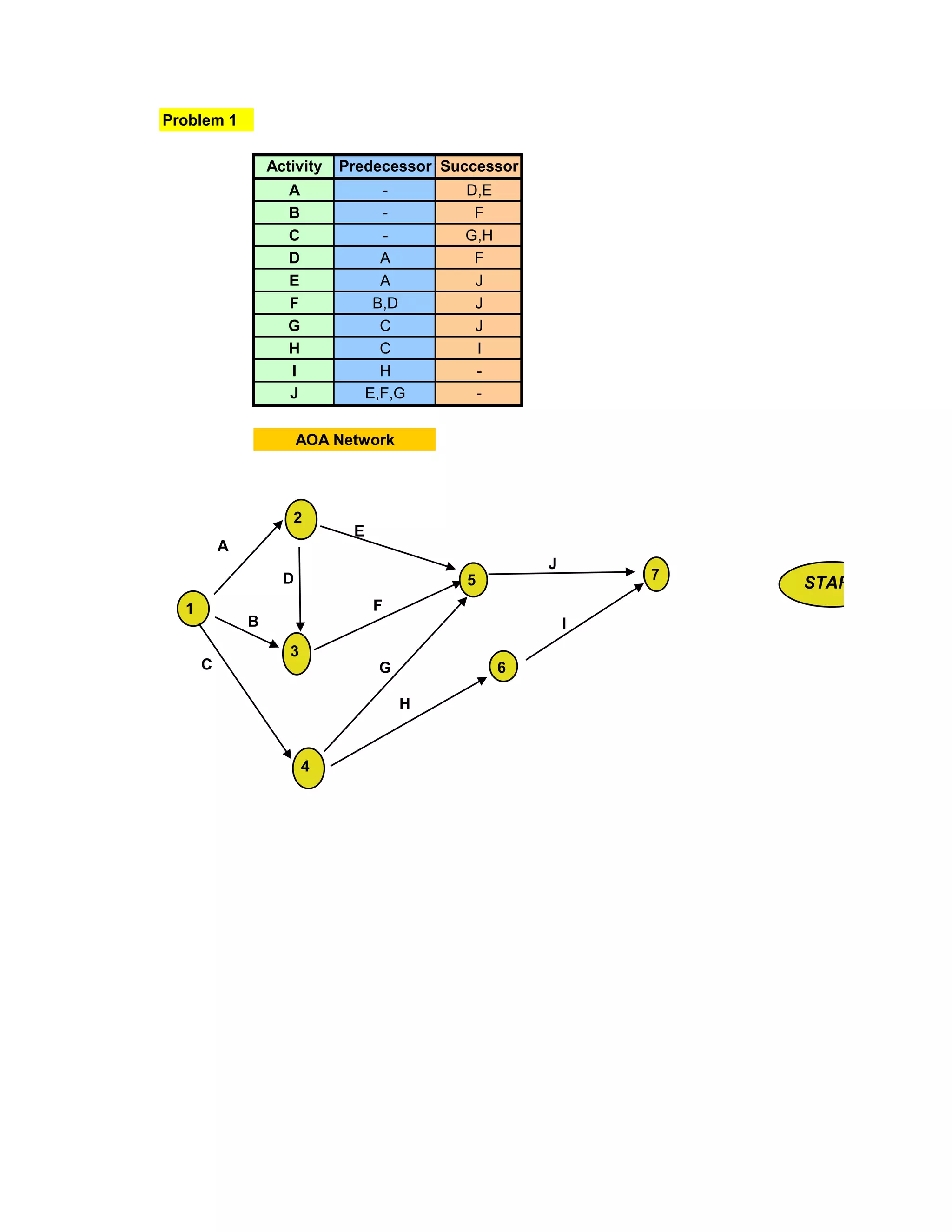

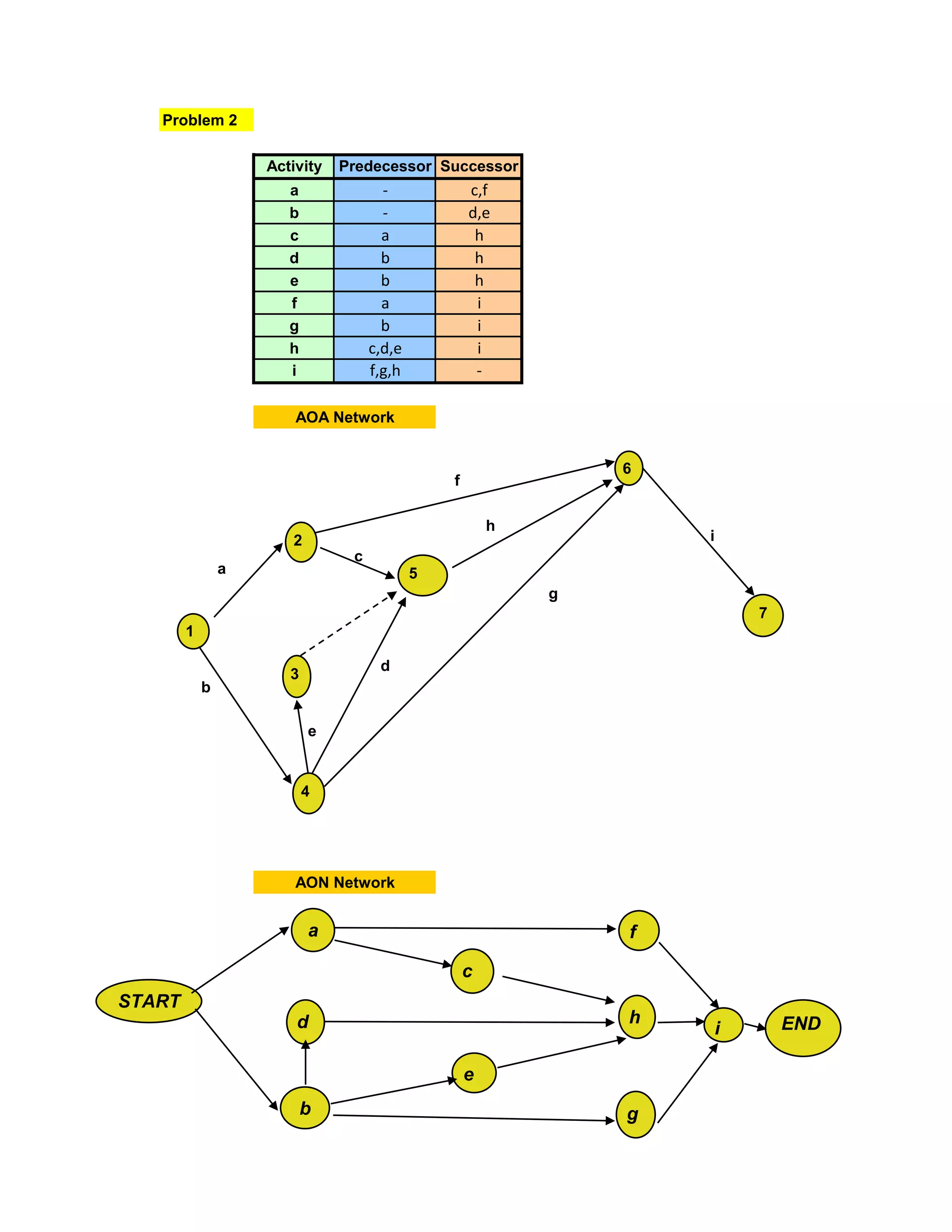

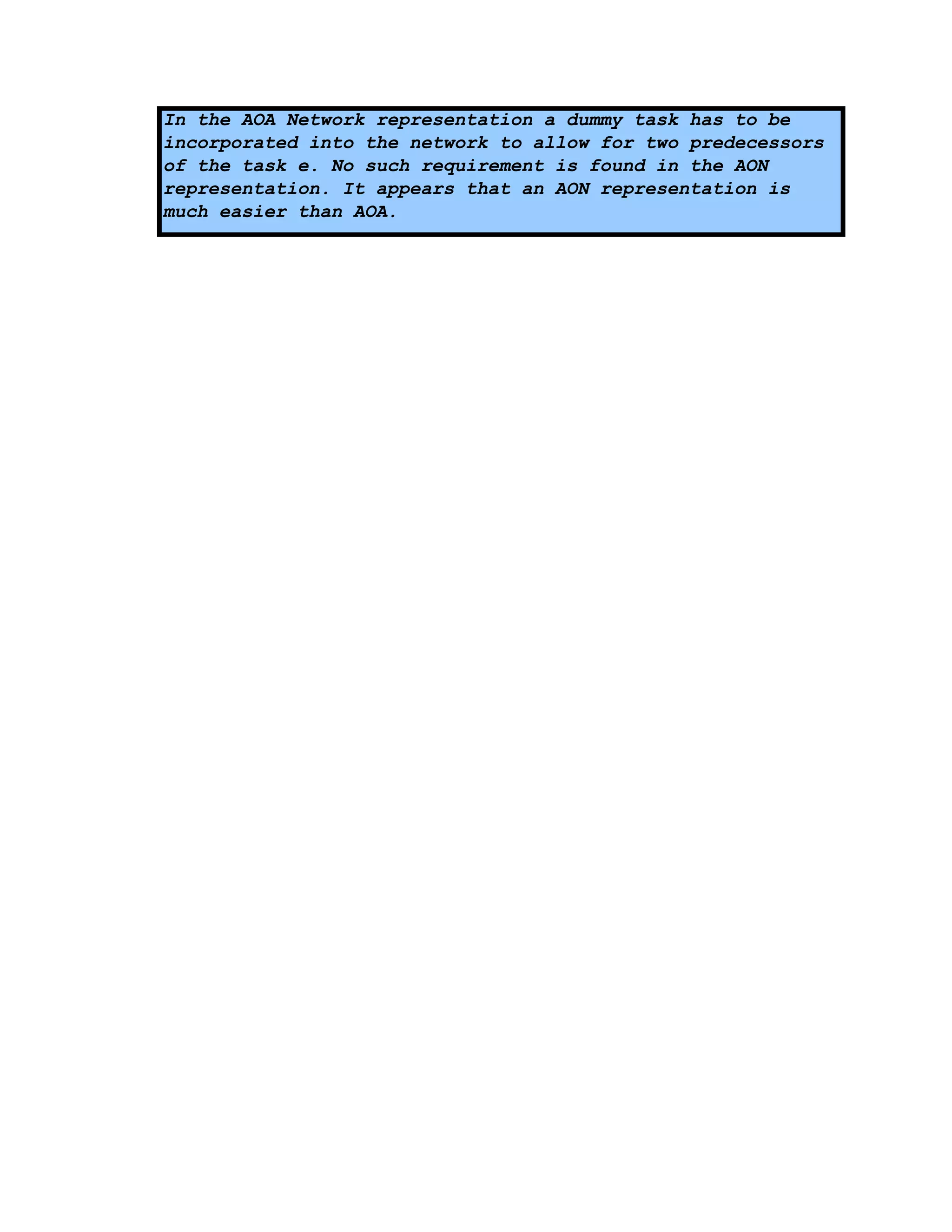

The document contains information about an activity on node (AON) network for a project with multiple activities. It provides the activity names, predecessors, duration estimates (optimistic, likely, pessimistic), expected durations calculated using PERT, variances and standard deviations for individual activities and paths. It also includes information about calculating the probability of project completion by a given due date using the critical path and near-critical path. Options for crashing activities on the critical path to reduce project duration are discussed.
