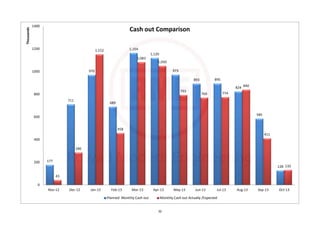

The document provides a cost control report for the Grand Hotel de N'Djamenta project in Chad for CFE Contracting Company through December 2012, detailing payment status, invoices, total costs and quantities, actual costs for shuttering, steel, and concrete work, profit and loss causes, earned value reporting, expected cash outlays, net cash flow updates, store reports, and actual rates. The project is on schedule for the expected finish date of December 29, 2013, with civil works 9.67% completed and a total project budget of €10,582,408 compared to costs to date of €8,374,242.
