4. Kaizen event agenda
Training
• Introduction
• - Kaizen Concepts & Process
• SPACER
• - Lean - Waste
• - Process Flow Analysis

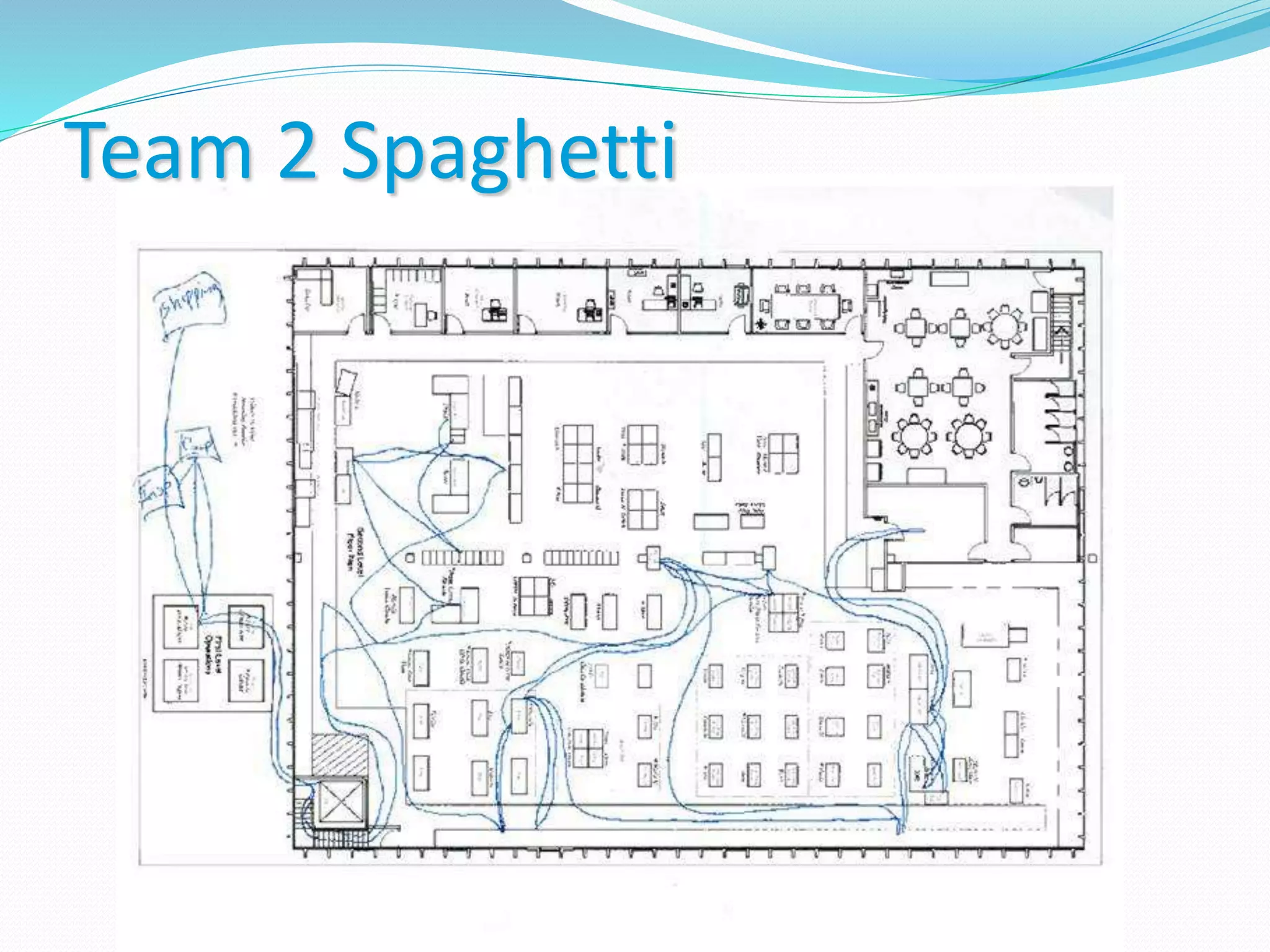

• - Spaghetti Diagrams
• 2 teams
• Walk the process
STEPS
• TIME it takes to
complete a part at each
process
Lunch
• Floor Work
• - Process Flow Analysis
• - Spaghetti Diagrams
• Team Reports
Training
• 5S
• Total Quality
• Pull Systems
• Paper Air Plane
• Batch Process
• One piece flow
Lunch
Floor Work
• Work in your areas
and evaluate how
we can use 5S
• Team Reports
Training
• Takt Time
• Line Balancing
• Cell Design Layout
• 5S Team
• Set-up
• Staging
• Quality Team
• First piece
• In-process
Lunch
Floor Work
• Layout the
workstations
• Evaluate Agree on
the cell design
• Team Reports
Training
• “Implement”
• Create Cell
• Move benches
• Organize area
• Team evaluation
• Re-organize if
necessary
• Prepare line for a
production run on Friday
morning
Training
• TEST RUN
• Make any
adjustments
necessary
• Spaghetti and time
the new process
• Team report out
Learn Lean

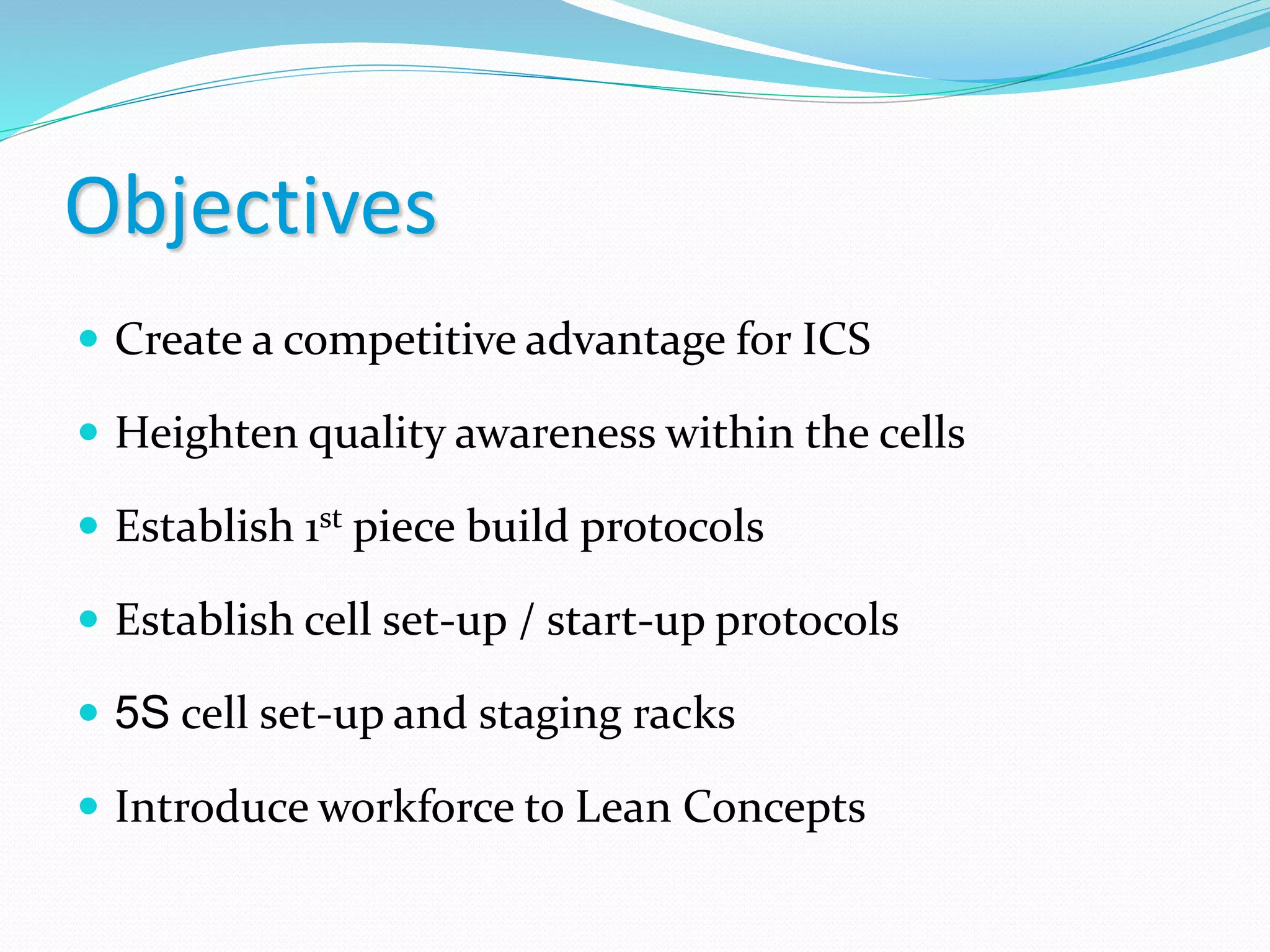

5. Objectives
Create a competitive advantage for ICS
Heighten quality awareness within the cells
Establish 1st piece build protocols
Establish cell set-up / start-up protocols
5S cell set-up and staging racks
Introduce workforce to Lean Concepts

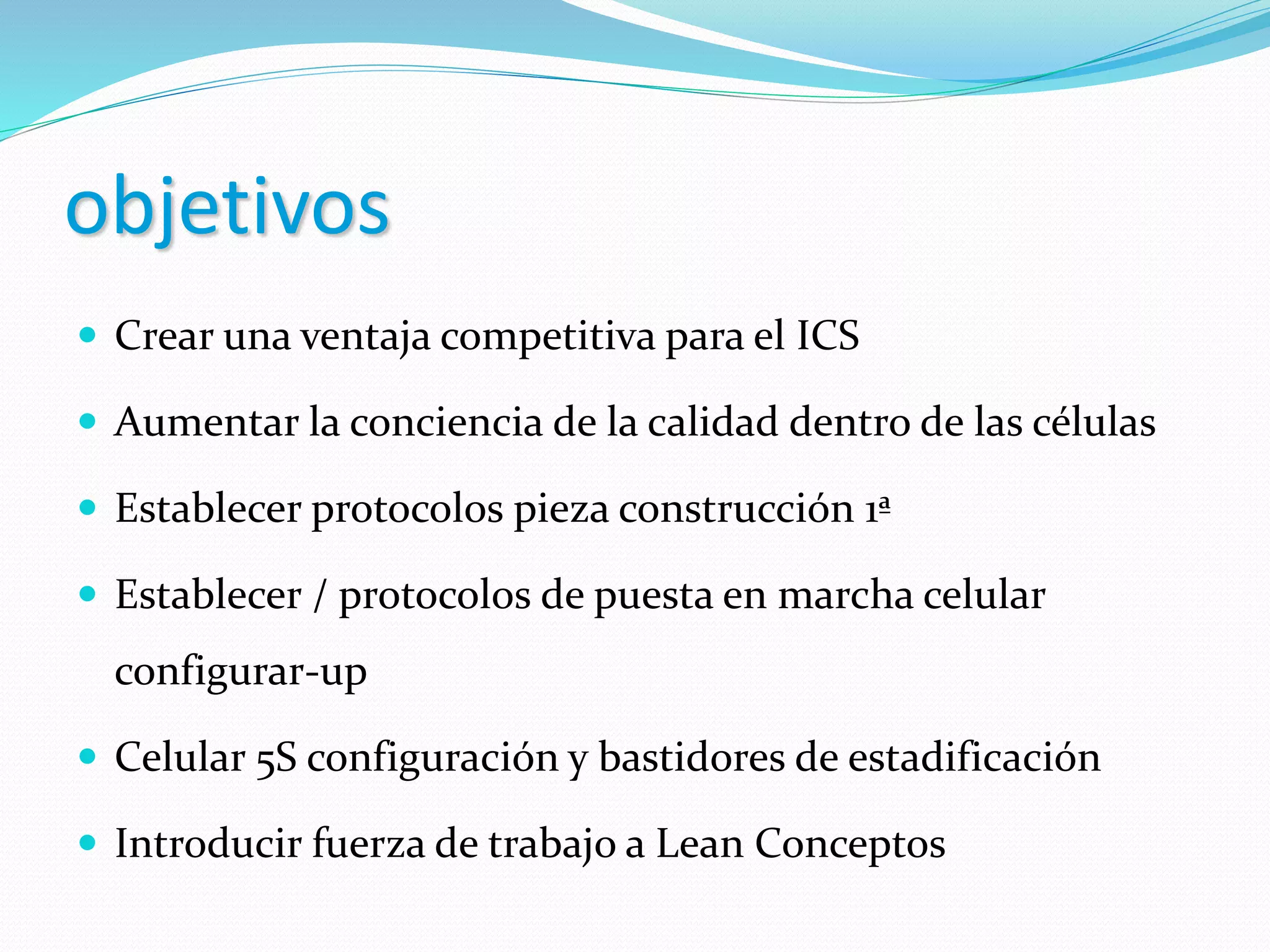

6. objetivos
Crear una ventaja competitiva para el ICS
Aumentar la conciencia de la calidad dentro de las células
Establecer protocolos pieza construcción 1ª
Establecer / protocolos de puesta en marcha celular
configurar-up
Celular 5S configuración y bastidores de estadificación
Introducir fuerza de trabajo a Lean Conceptos
7. Project Goals
Opportunity to increase revenue
Goal Owner
Faster throughput 30% Jeff R
Decreased lead-time
Higher quality yields 30 % Jeff R / Gemalyn
Production capability 30% Jeff R
Parts produced to FG daily

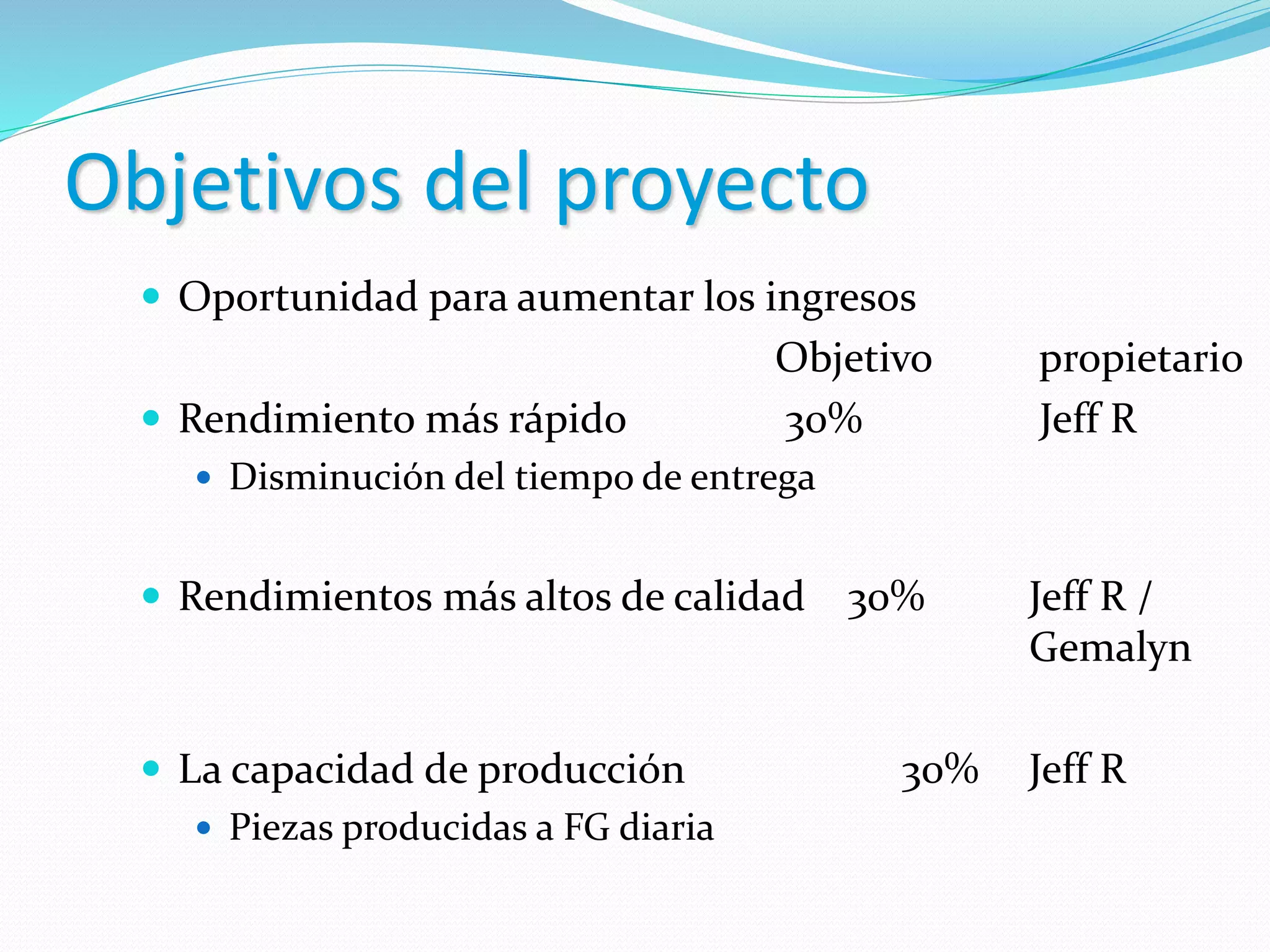

8. Objetivos del proyecto
Oportunidad para aumentar los ingresos
Objetivo propietario
Rendimiento más rápido 30% Jeff R
Disminución del tiempo de entrega
Rendimientos más altos de calidad 30% Jeff R /
Gemalyn
La capacidad de producción 30% Jeff R
Piezas producidas a FG diaria

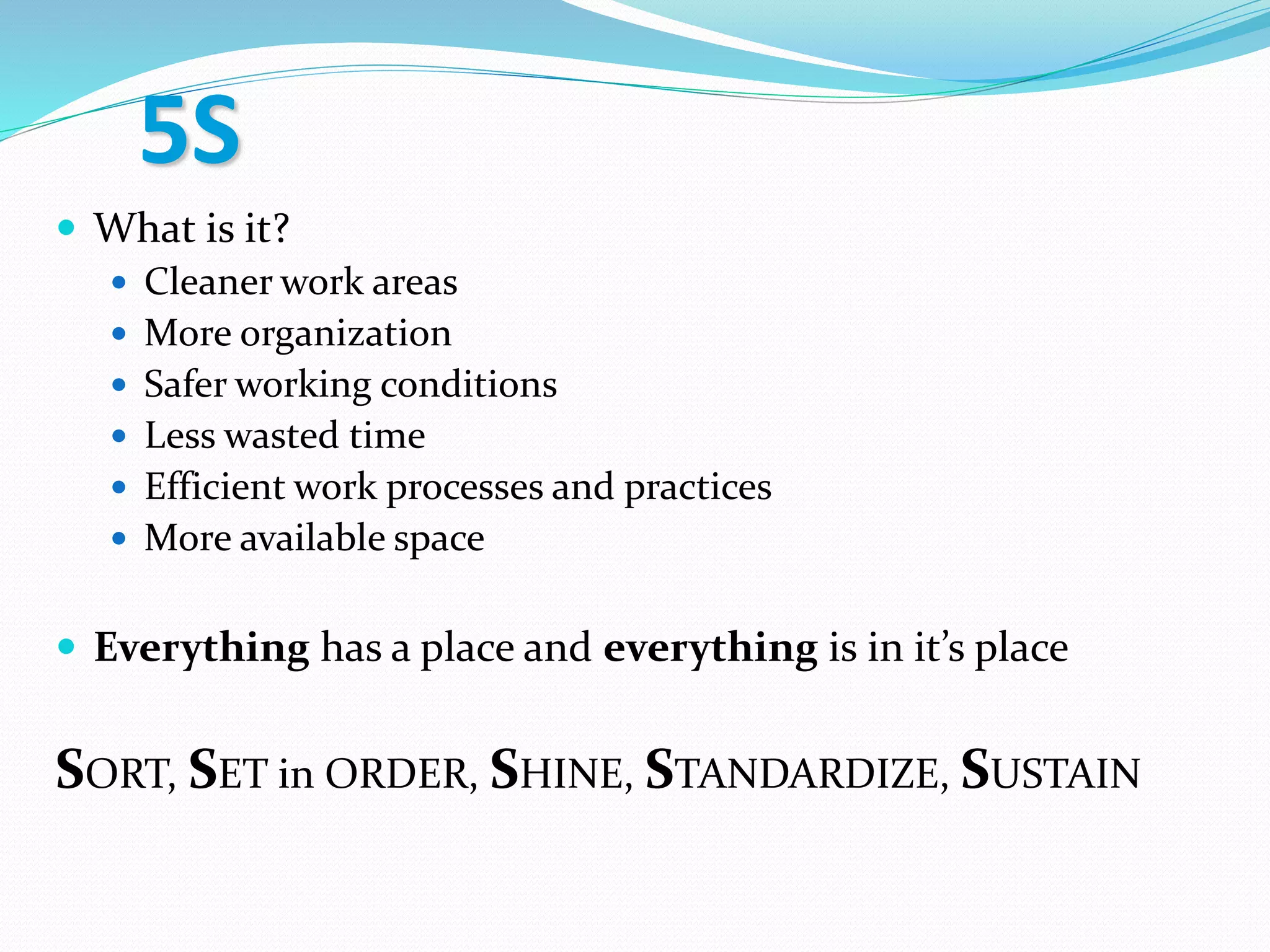

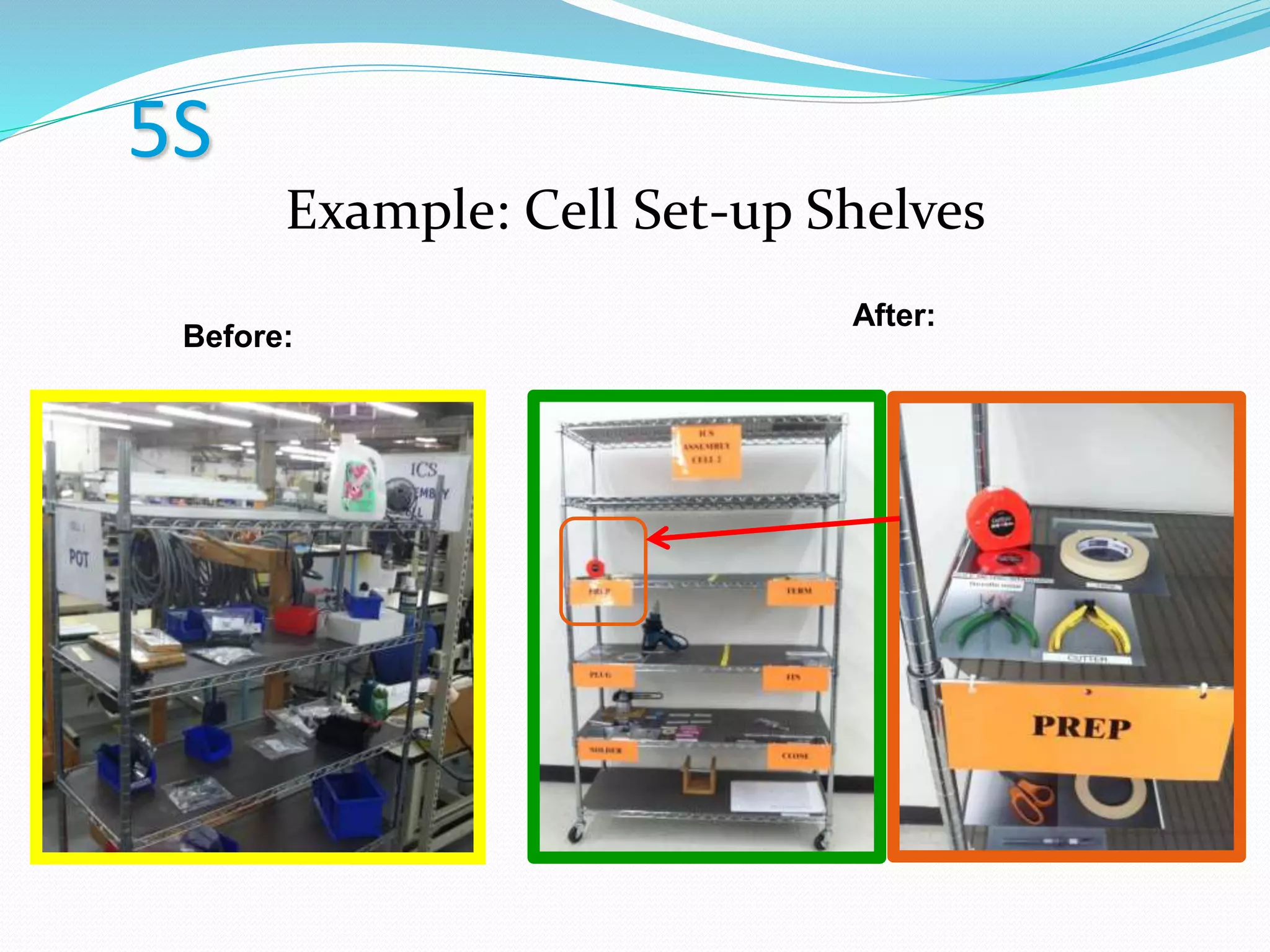

14. 5S
What is it?
Cleaner work areas
More organization
Safer working conditions
Less wasted time
Efficient work processes and practices
More available space
Everything has a place and everything is in it’s place
SORT, SET in ORDER, SHINE, STANDARDIZE, SUSTAIN

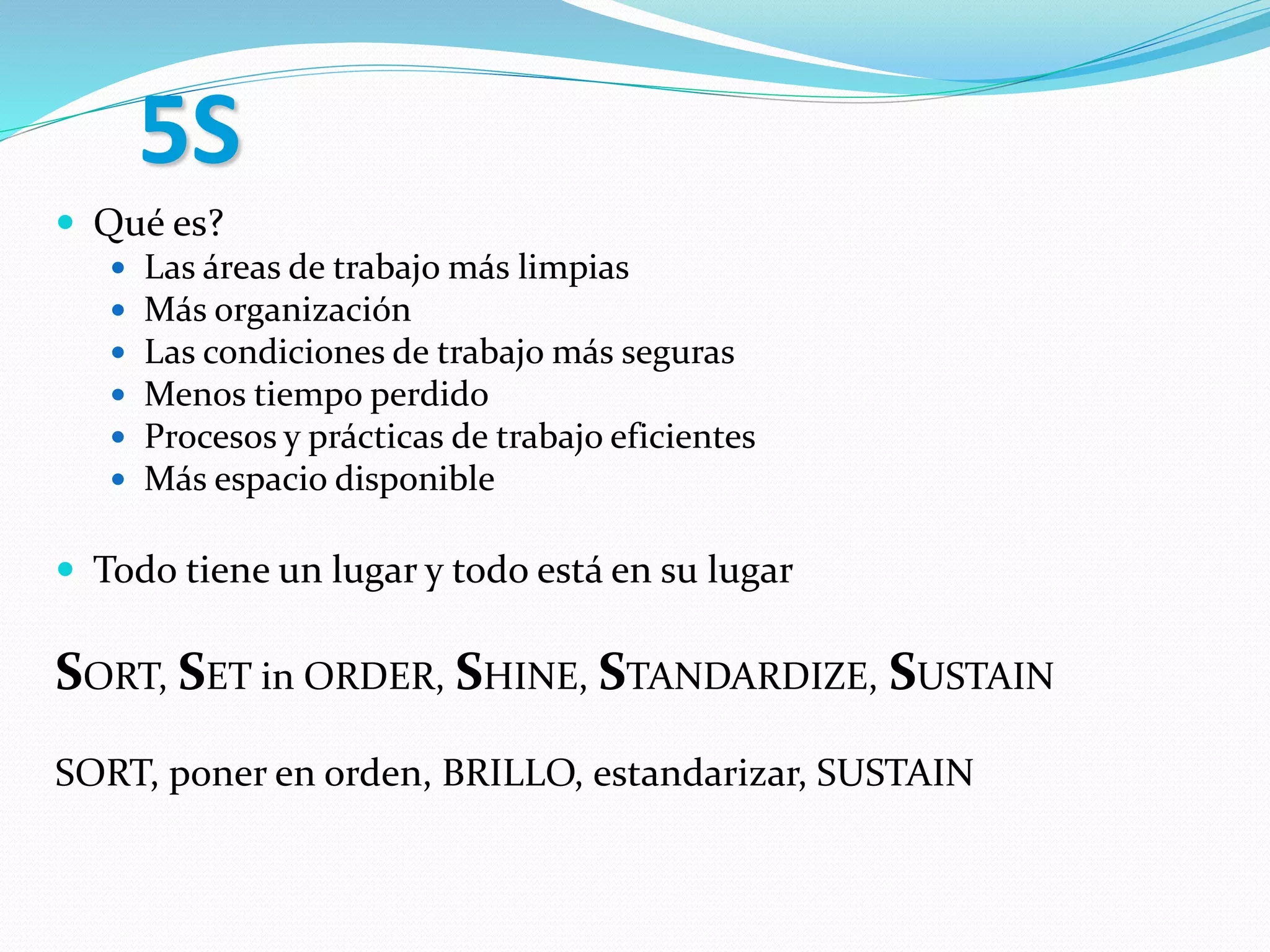

15. 5S
Qué es?
Las áreas de trabajo más limpias
Más organización
Las condiciones de trabajo más seguras
Menos tiempo perdido
Procesos y prácticas de trabajo eficientes
Más espacio disponible
Todo tiene un lugar y todo está en su lugar
SORT, SET in ORDER, SHINE, STANDARDIZE, SUSTAIN
SORT, poner en orden, BRILLO, estandarizar, SUSTAIN

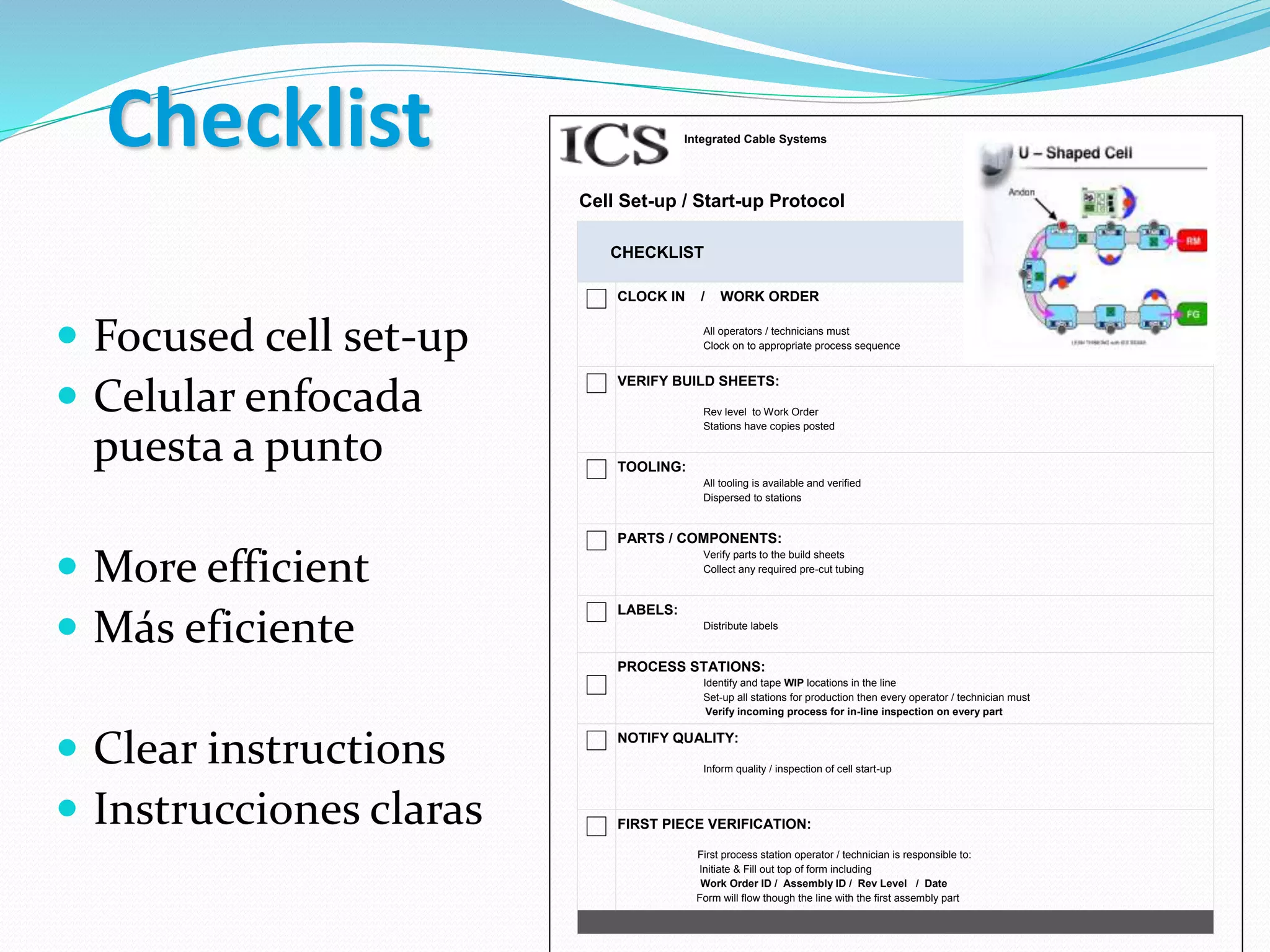

18. Integrated Cable Systems
Cell Set-up / Start-up Protocol
CHECKLIST
CLOCK IN / WORK ORDER
All operators / technicians must
Clock on to appropriate process sequence
VERIFY BUILD SHEETS:
Rev level to Work Order
Stations have copies posted
TOOLING:
All tooling is available and verified
Dispersed to stations
PARTS / COMPONENTS:
Verify parts to the build sheets
Collect any required pre-cut tubing
LABELS:
Distribute labels
PROCESS STATIONS:
Identify and tape WIP locations in the line
Set-up all stations for production then every operator / technician must
Verify incoming process for in-line inspection on every part
NOTIFY QUALITY:
Inform quality / inspection of cell start-up
FIRST PIECE VERIFICATION:
First process station operator / technician is responsible to:
Initiate & Fill out top of form including
Work Order ID / Assembly ID / Rev Level / Date
Form will flow though the line with the first assembly part
Focused cell set-up
Celular enfocada
puesta a punto
More efficient
Más eficiente
Clear instructions
Instrucciones claras
Checklist

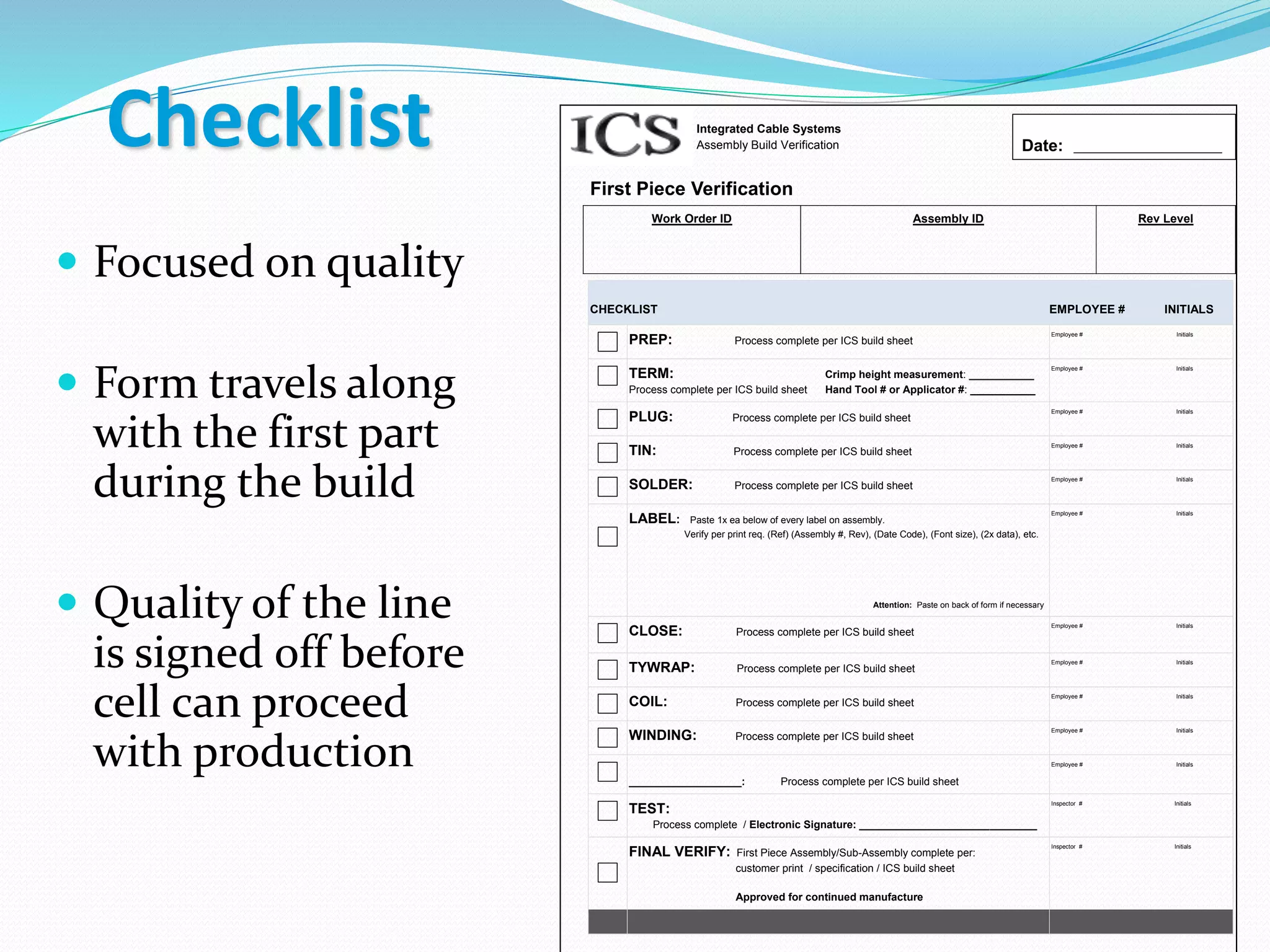

21. Integrated Cable Systems
Assembly Build Verification
First Piece Verification
Work Order ID Assembly ID Rev Level
CHECKLIST EMPLOYEE # INITIALS
PREP: Process complete per ICS build sheet
Employee # Initials
TERM: Crimp height measurement: ___________
Process complete per ICS build sheet Hand Tool # or Applicator #: ___________
Employee # Initials
PLUG: Process complete per ICS build sheet
Employee # Initials
TIN: Process complete per ICS build sheet
Employee # Initials
SOLDER: Process complete per ICS build sheet
Employee # Initials
LABEL: Paste 1x ea below of every label on assembly.
Verify per print req. (Ref) (Assembly #, Rev), (Date Code), (Font size), (2x data), etc.
Attention: Paste on back of form if necessary
Employee # Initials
CLOSE: Process complete per ICS build sheet
Employee # Initials
TYWRAP: Process complete per ICS build sheet
Employee # Initials
COIL: Process complete per ICS build sheet
Employee # Initials
WINDING: Process complete per ICS build sheet
Employee # Initials
___________________: Process complete per ICS build sheet
Employee # Initials
TEST:
Process complete / Electronic Signature: ______________________________
Inspector # Initials
FINAL VERIFY: First Piece Assembly/Sub-Assembly complete per:
customer print / specification / ICS build sheet
Approved for continued manufacture
Inspector # Initials
Date: _________________________
Focused on quality
Form travels along
with the first part
during the build
Quality of the line
is signed off before
cell can proceed
with production
Checklist
22. Integrated Cable Systems
Assembly Build Verification
First Piece Verification
Work Order ID Assembly ID Rev Level
CHECKLIST EMPLOYEE # INITIALS
PREP: Process complete per ICS build sheet
Employee # Initials
TERM: Crimp height measurement: ___________
Process complete per ICS build sheet Hand Tool # or Applicator #: ___________
Employee # Initials
PLUG: Process complete per ICS build sheet
Employee # Initials
TIN: Process complete per ICS build sheet
Employee # Initials
SOLDER: Process complete per ICS build sheet
Employee # Initials
LABEL: Paste 1x ea below of every label on assembly.
Verify per print req. (Ref) (Assembly #, Rev), (Date Code), (Font size), (2x data), etc.
Attention: Paste on back of form if necessary
Employee # Initials
CLOSE: Process complete per ICS build sheet
Employee # Initials
TYWRAP: Process complete per ICS build sheet
Employee # Initials
COIL: Process complete per ICS build sheet
Employee # Initials
WINDING: Process complete per ICS build sheet
Employee # Initials
___________________: Process complete per ICS build sheet
Employee # Initials
TEST:
Process complete / Electronic Signature: ______________________________
Inspector # Initials
FINAL VERIFY: First Piece Assembly/Sub-Assembly complete per:
customer print / specification / ICS build sheet
Approved for continued manufacture
Inspector # Initials
Date: _________________________
Centrado en la
calidad
Forma transportar a
lo largo con la
primera parte
durante la
construcción
Calidad de la línea se
firmó antes de celular
puede proceder con
la producción
Lista de verificación

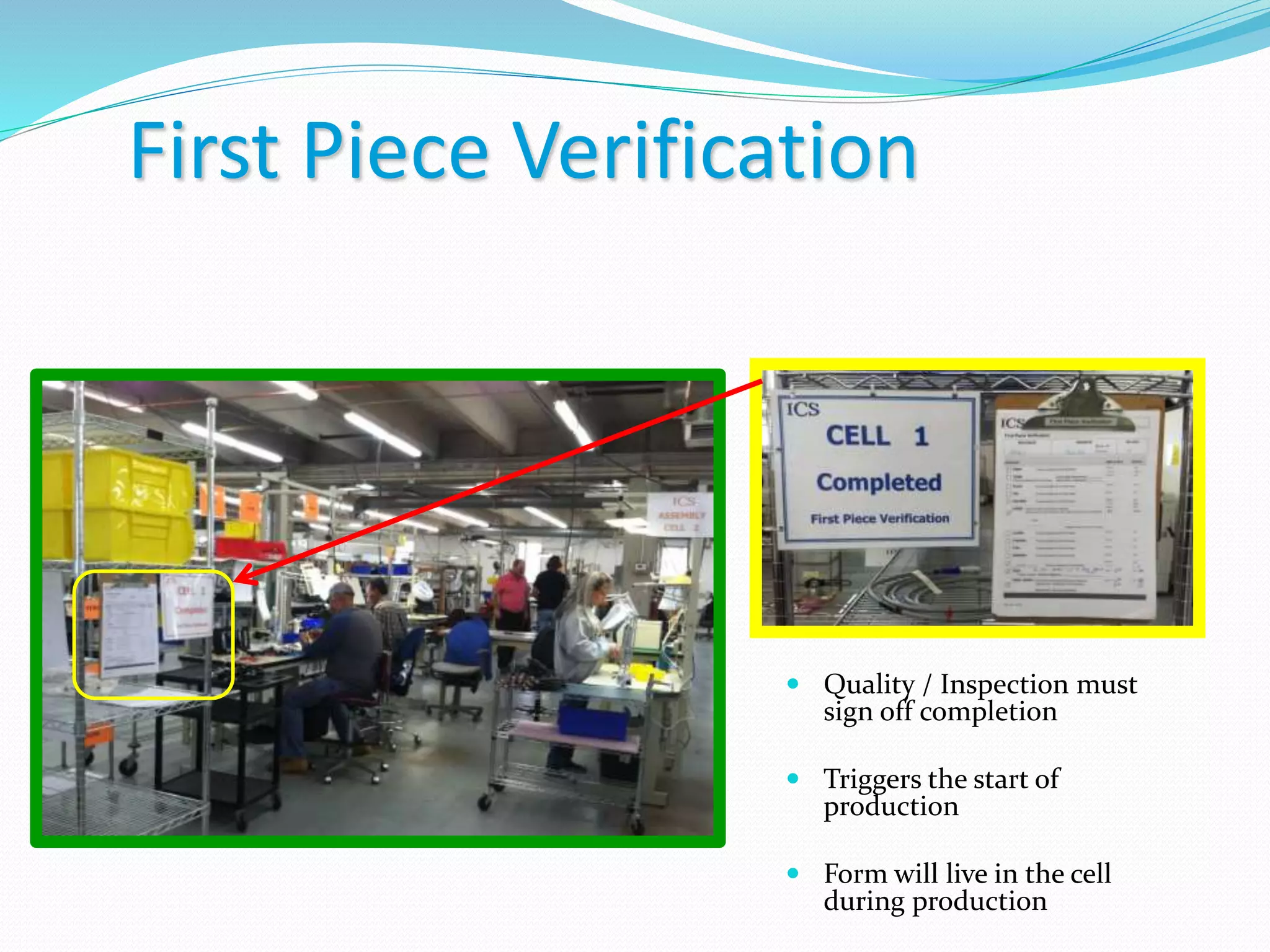

23. First Piece Verification
Quality / Inspection must
sign off completion
Triggers the start of
production
Form will live in the cell
during production

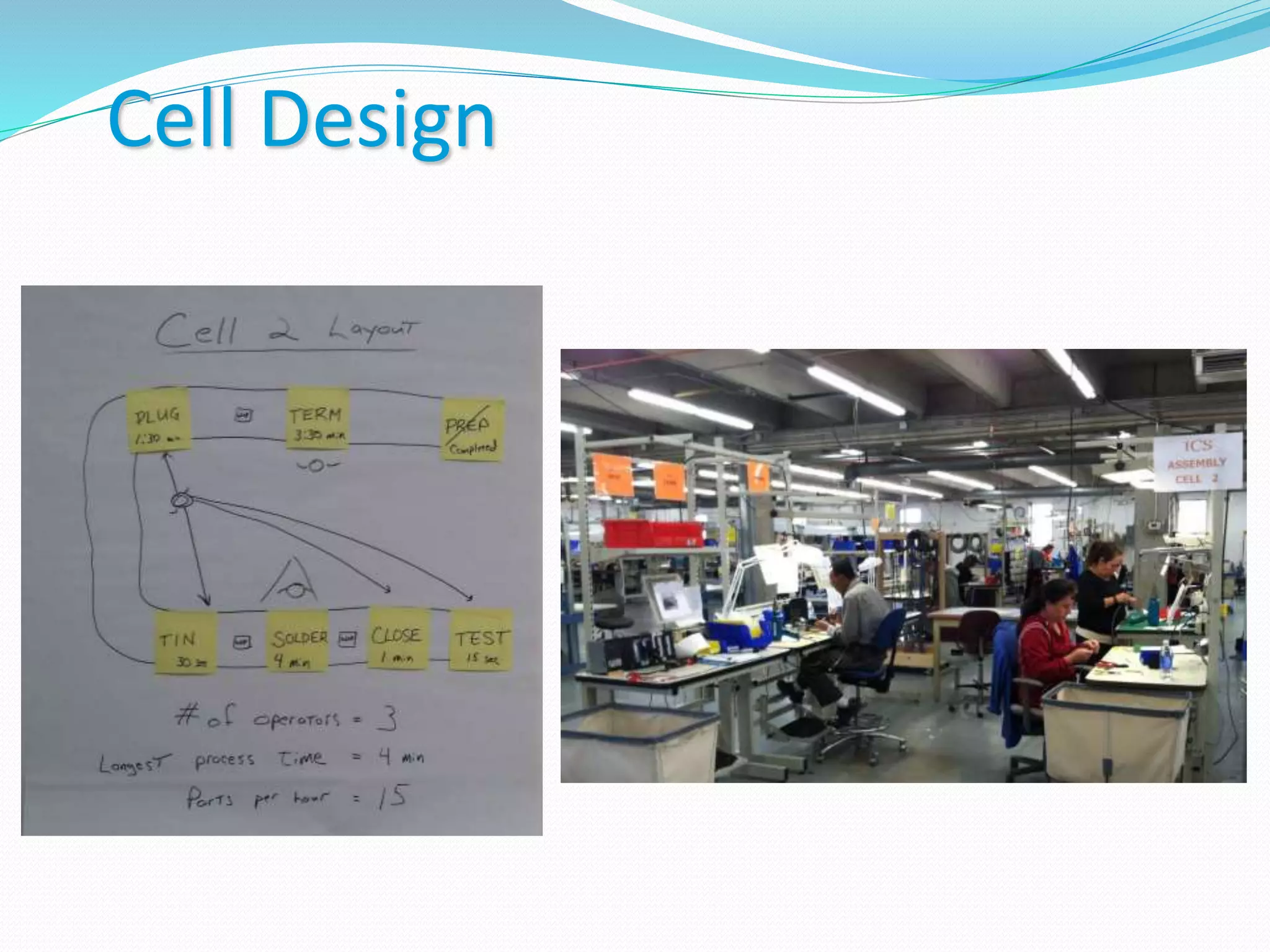

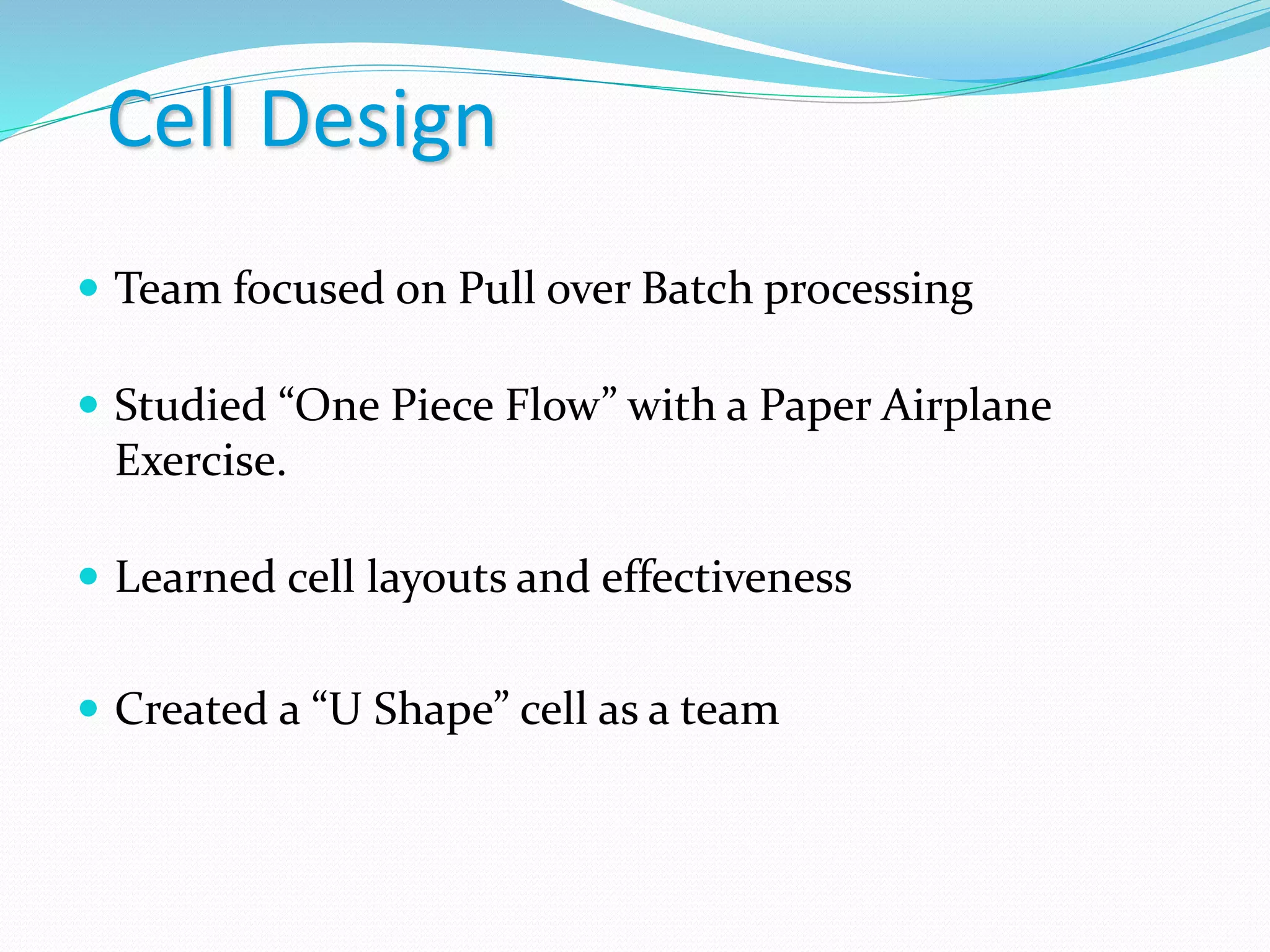

24. Cell Design
Team focused on Pull over Batch processing
Studied “One Piece Flow” with a Paper Airplane
Exercise.
Learned cell layouts and effectiveness
Created a “U Shape” cell as a team

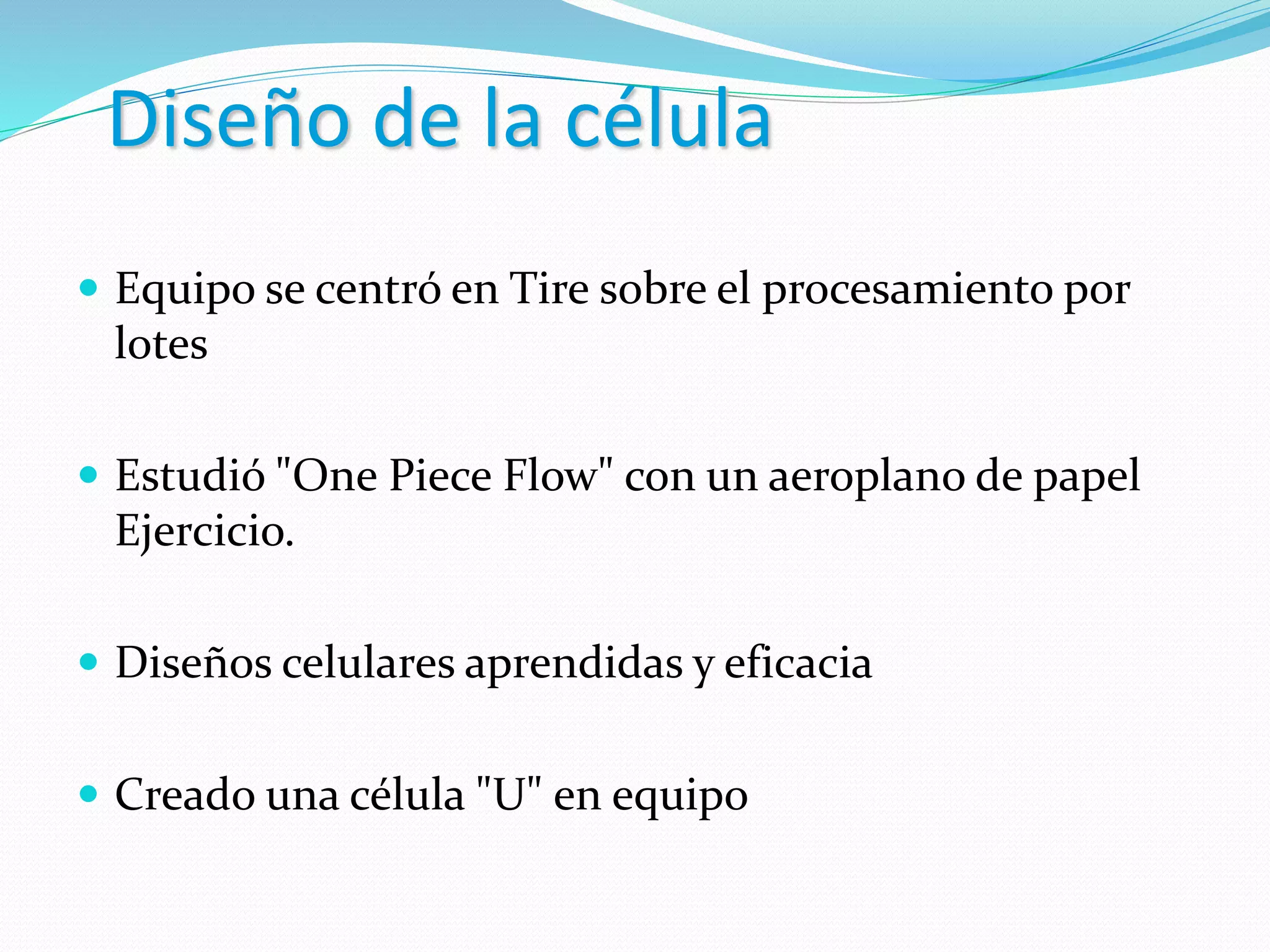

25. Diseño de la célula
Equipo se centró en Tire sobre el procesamiento por
lotes
Estudió "One Piece Flow" con un aeroplano de papel
Ejercicio.
Diseños celulares aprendidas y eficacia
Creado una célula "U" en equipo

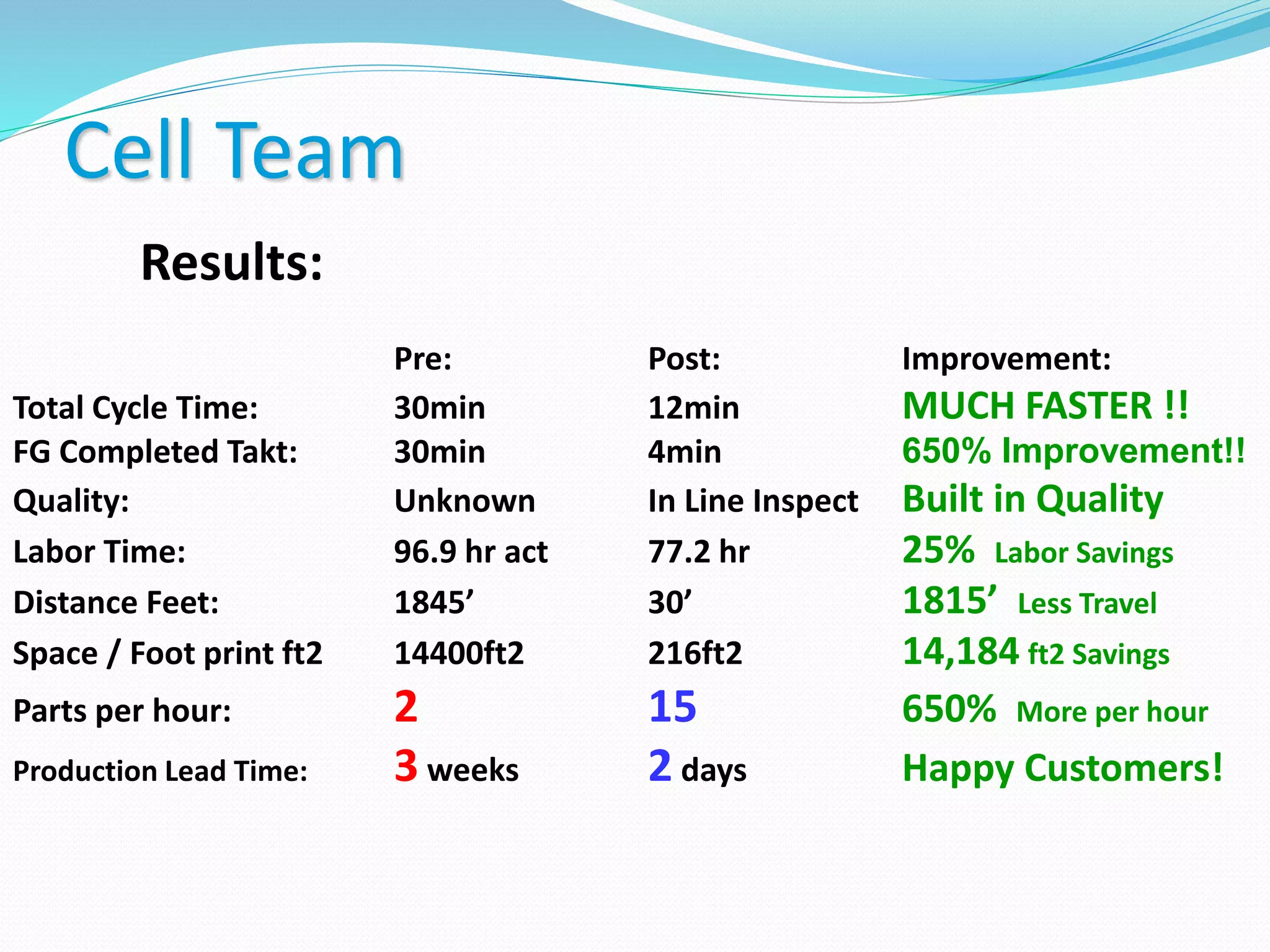

27. Cell Team

Results:
Pre: Post: Improvement:
Total Cycle Time: 30min 12min MUCH FASTER !!
FG Completed Takt: 30min 4min 650% Improvement!!
Quality: Unknown In Line Inspect Built in Quality
Labor Time: 96.9 hr act 77.2 hr 25% Labor Savings
Distance Feet: 1845’ 30’ 1815’ Less Travel
Space / Foot print ft2 14400ft2 216ft2 14,184 ft2 Savings
Parts per hour: 2 15 650% More per hour
Production Lead Time: 3 weeks 2 days Happy Customers!
